- Before
- Reads four reports late at night before a closing, looking for the six things that matter.
- Now
- Opens the reports already marked, most serious first, and accepts each note into the commitment letter with its cost.
A grocery-anchored center’s 744 pages of reports, turned into six loan conditions

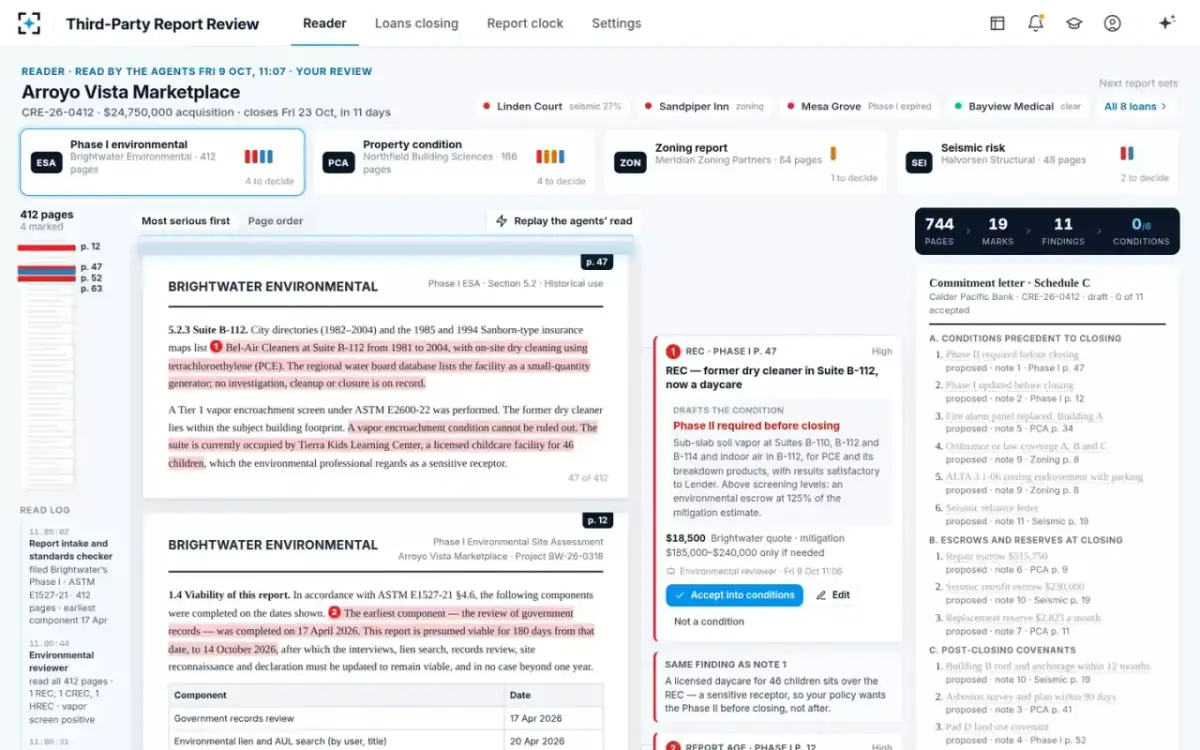

A grocery-anchored shopping center is due to close at the end of the week on a $24,750,000 acquisition loan. Its four third-party reports have just arrived. Here is the review, screen by screen, in the working solution.
A worked example on sample data. Names, IDs and figures on the screens and in this section come from the demo.
- 01Morning

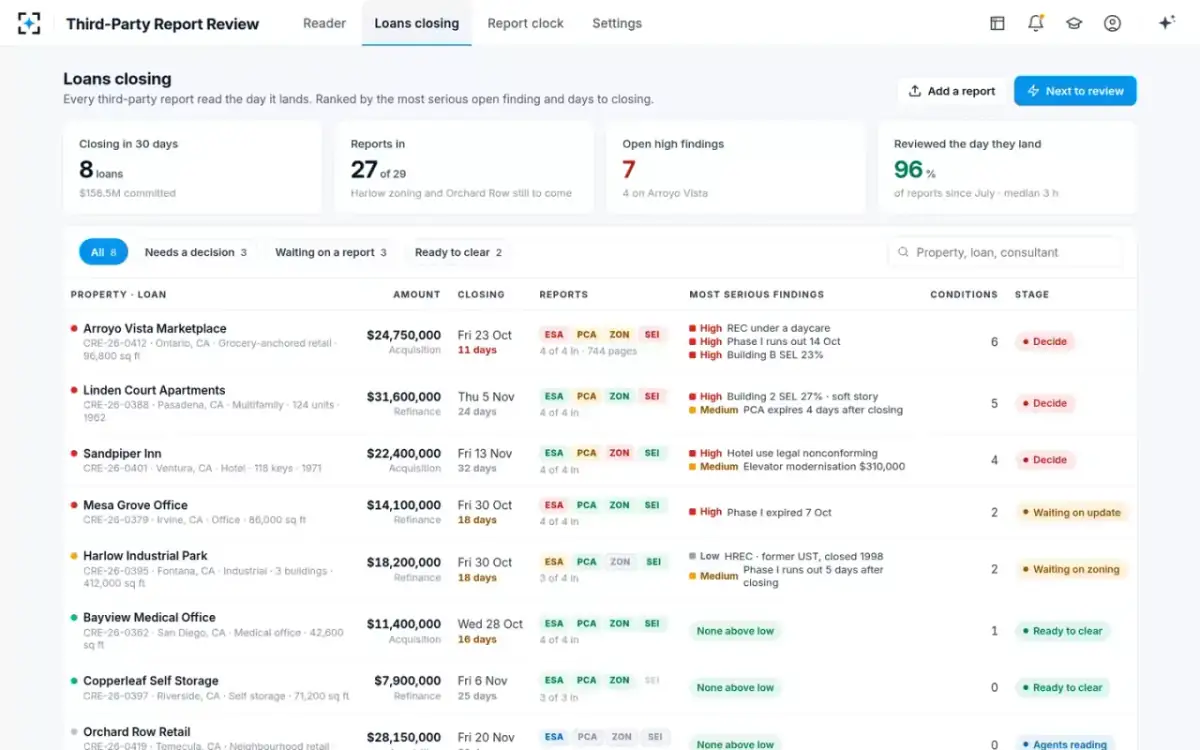

Loans closing in 30 days, worst first
Senior credit officer, CREThe credit officer opens Loans closing. It shows 8 loans and $158.5M committed, with 27 of 29 reports in. There are 7 open high findings, and 4 of them are on this center. The list is ranked by the most serious open finding and days to closing. Each loan has a chip for each report, marked ESA, PCA, zoning and seismic.
On this loan, a REC sits under a daycare and the Phase I runs out nine days before closing. Building B’s seismic loss is 23%.
- 02Two weeks before closing
The reports open as documents, already marked
Senior credit officer, CREThe reports open as documents, with no dashboard in between. The Phase I opens at page 47, where its most serious finding is. The four reports sit across the top. They are the Phase I (412 pages), the PCA (186), the zoning report (64) and the seismic assessment (48). Each shows the notes left to decide. On the right, Schedule C of the commitment letter, the list of loan conditions, waits to be filled.
744 pages, 19 marks, 11 findings, then conditions.
- 03Phase I p. 47
A former dry cleaner under a daycare, and a Phase II before closing

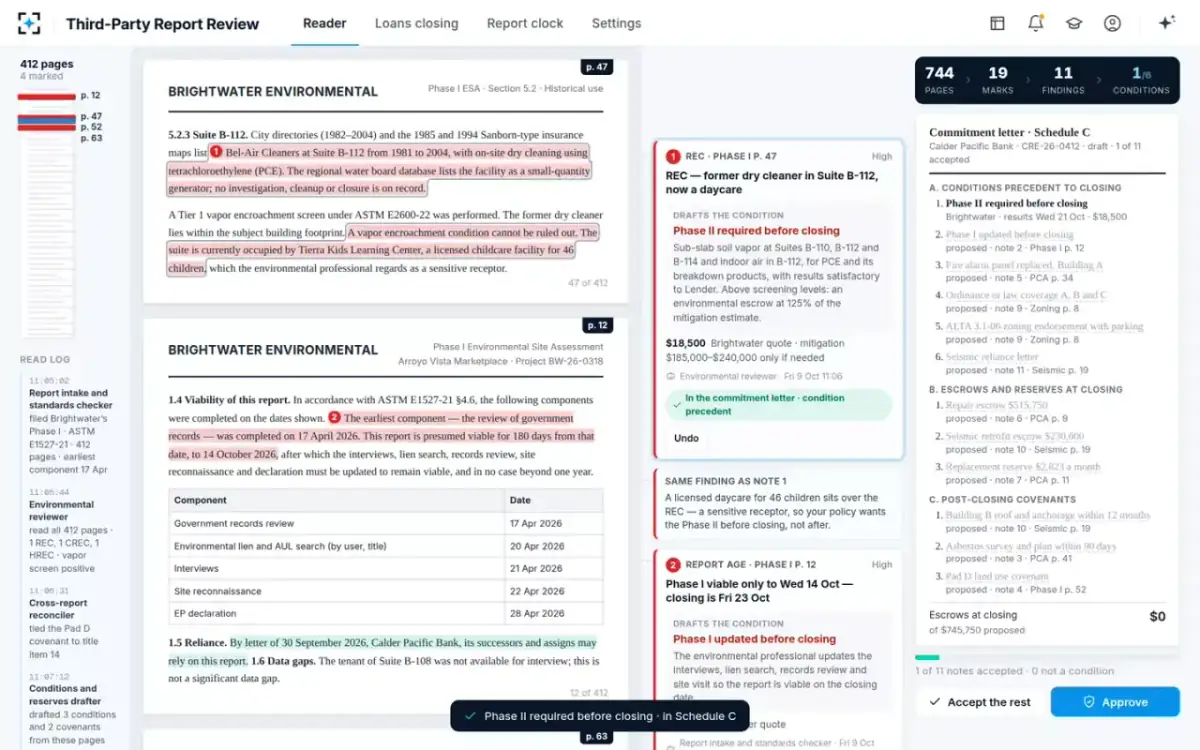

Environmental reviewerFrom 1981 to 2004 a dry cleaner used PCE, a cleaning solvent, in Suite B-112. No investigation or closure of the case is on record. The Tier 1 vapor screen cannot rule out a vapor condition. The suite is now a licensed childcare center for 46 children. The margin note drafts the condition, a Phase II follow-up investigation, at $18,500 on the consultant’s quote. Mitigation of $185,000 to $240,000 follows only if needed. Once accepted, the note lands as condition 1 in Schedule C.
A Phase II is required before closing. It is now in the commitment letter as a condition precedent, which must be met before the loan closes.

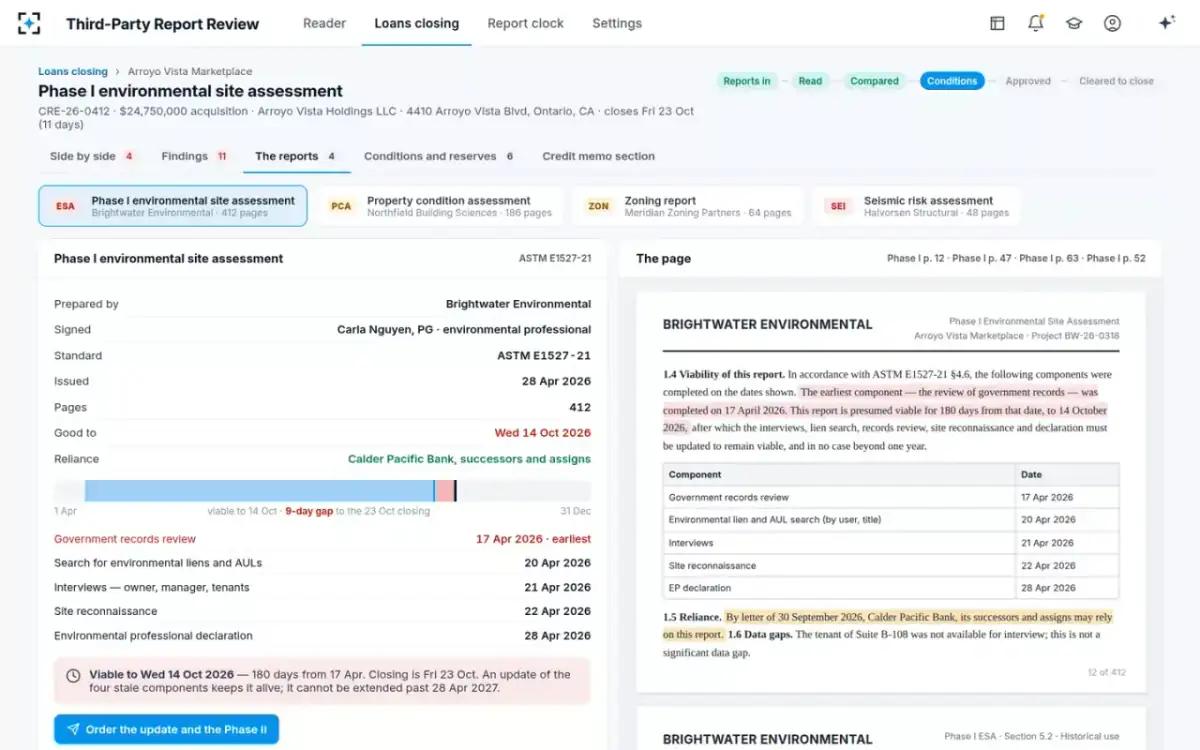

- 04Phase I p. 12

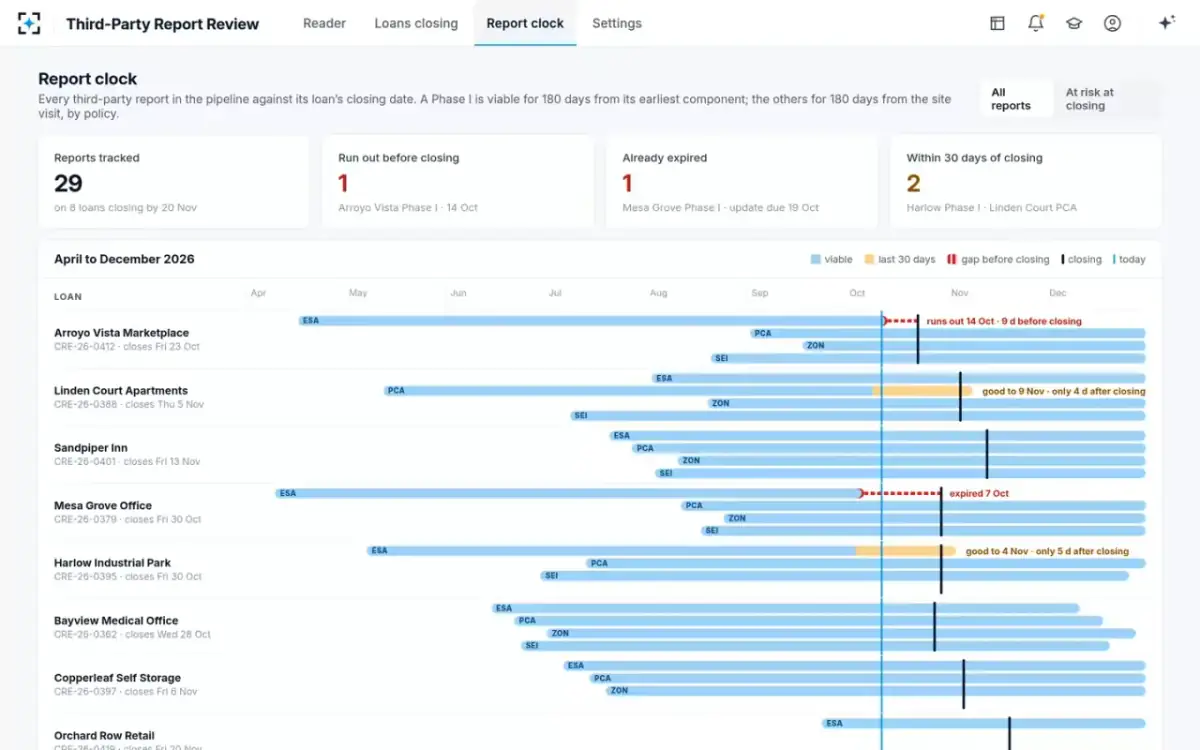

The Phase I runs out nine days before closing
Intake and standards checkerA Phase I is made of several parts, each with its own date. Here the oldest part is the government records review. Under ASTM E1527-21, the report is valid for 180 days from that date. That ends on a Wednesday, nine days before the Friday closing. The checker drafts an update of the interviews, lien search, records review and site visit, at $2,400. It also checks the reliance letter, which lets the bank rely on the report. The letter names the bank, its successors and assigns.
Valid for 180 days from its oldest part, which ends nine days before closing.
- 05PCA p. 34 and Table 1

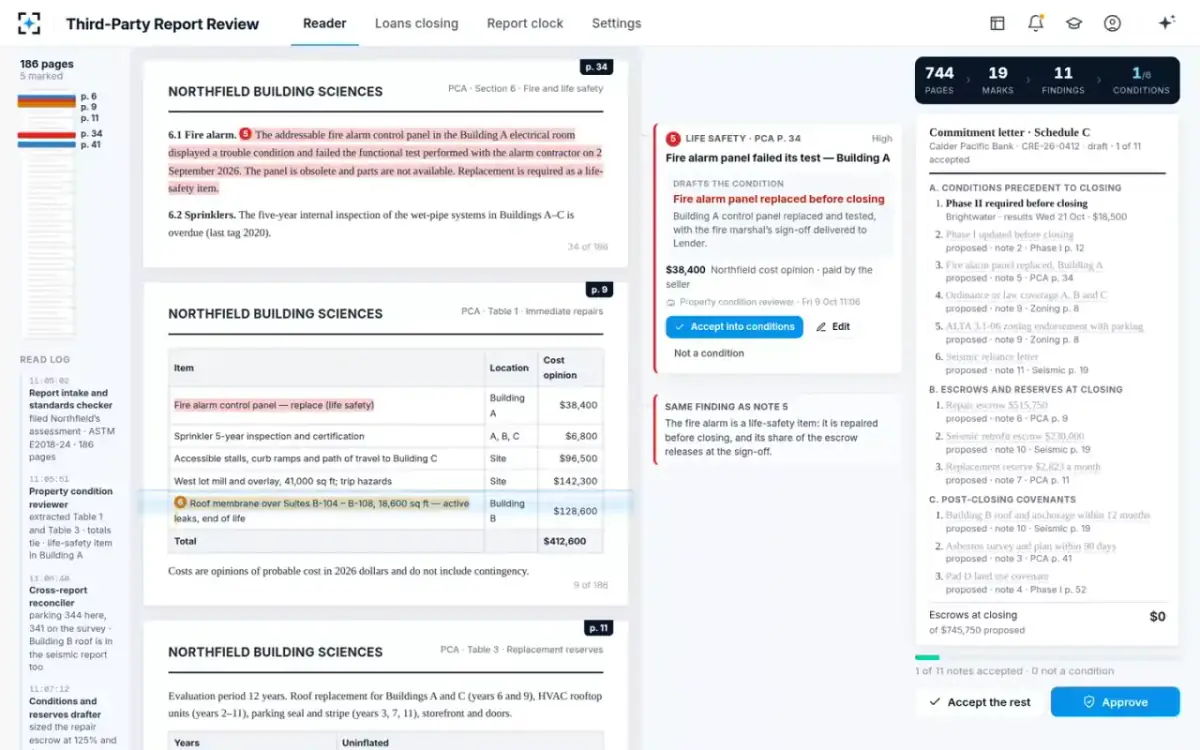

A failed fire alarm and $412,600 of immediate repairs
Property condition reviewerThe fire alarm control panel in Building A is in trouble mode and failed its test. That makes it a life-safety item. The note drafts it as repaired before closing, with the fire marshal’s sign-off ($38,400). Table 1 lists $412,600 of immediate repairs. They are the fire alarm, the sprinkler 5-year certification, and accessible parking and path of travel. They also include the west lot mill and overlay, and the roof membrane over B-104 to B-108.
The reviewer does not change the engineer’s cost opinion, and totals must tie to the report.
- 06Seismic p. 19

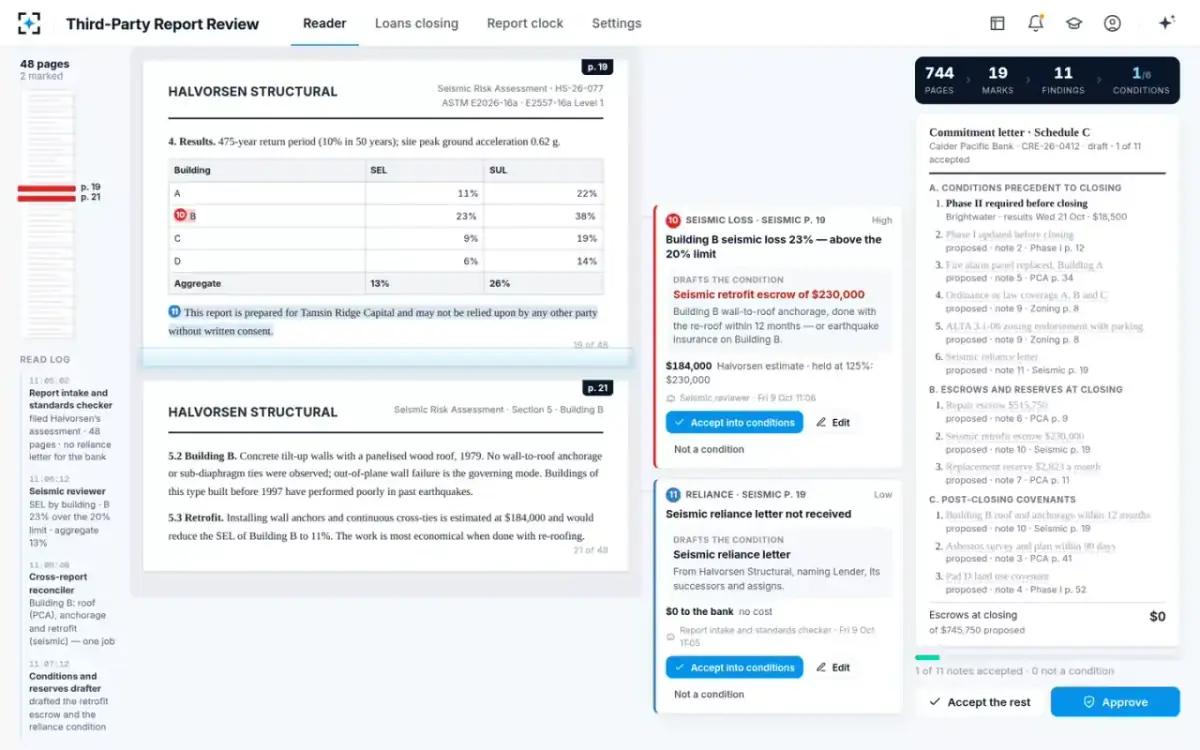

The center passes the seismic limit, but Building B does not
Seismic reviewerAcross the whole center, the scenario expected loss (SEL) from an earthquake is 13%, inside the 20% limit. But Building B is at 23%, with an upper loss of 38%. It is a 1979 tilt-up building with no anchors between its walls and roof. The note drafts a seismic retrofit escrow of $230,000, which is 125% of the engineer’s $184,000 estimate. A second note flags that the seismic engineer’s reliance letter has not arrived.
Each building is tested, as well as the whole center.
- 07Side by side

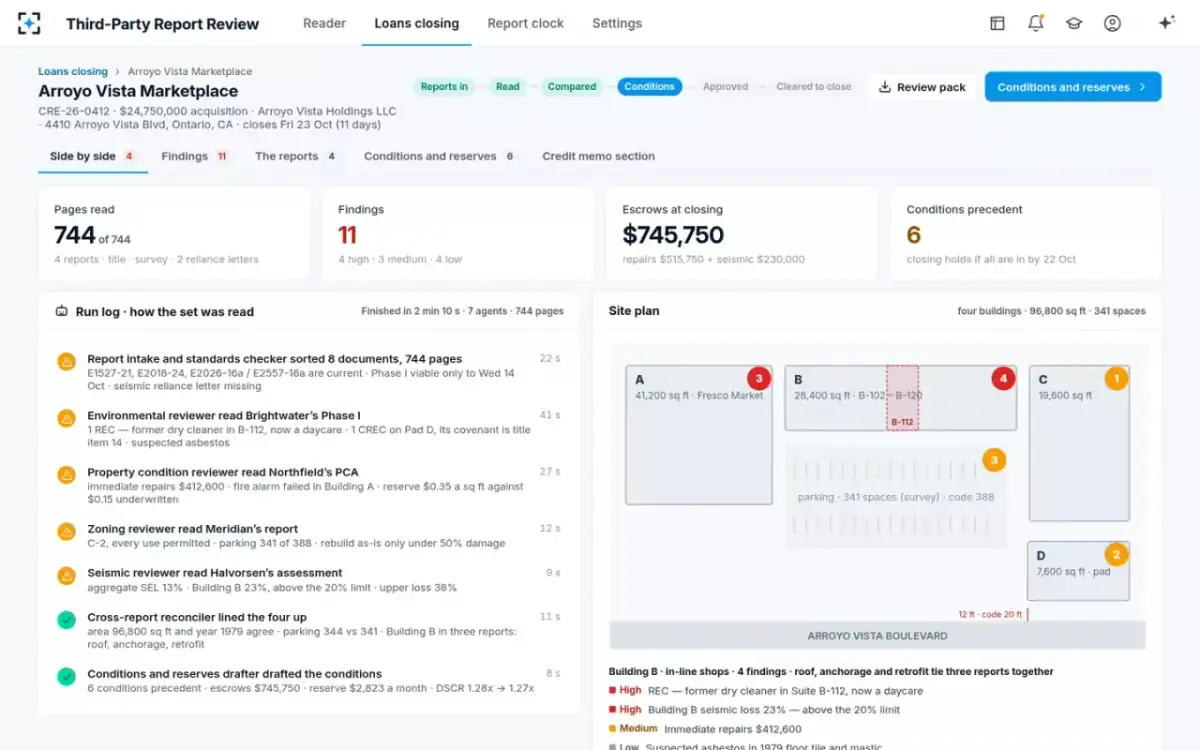

Building B, in three reports

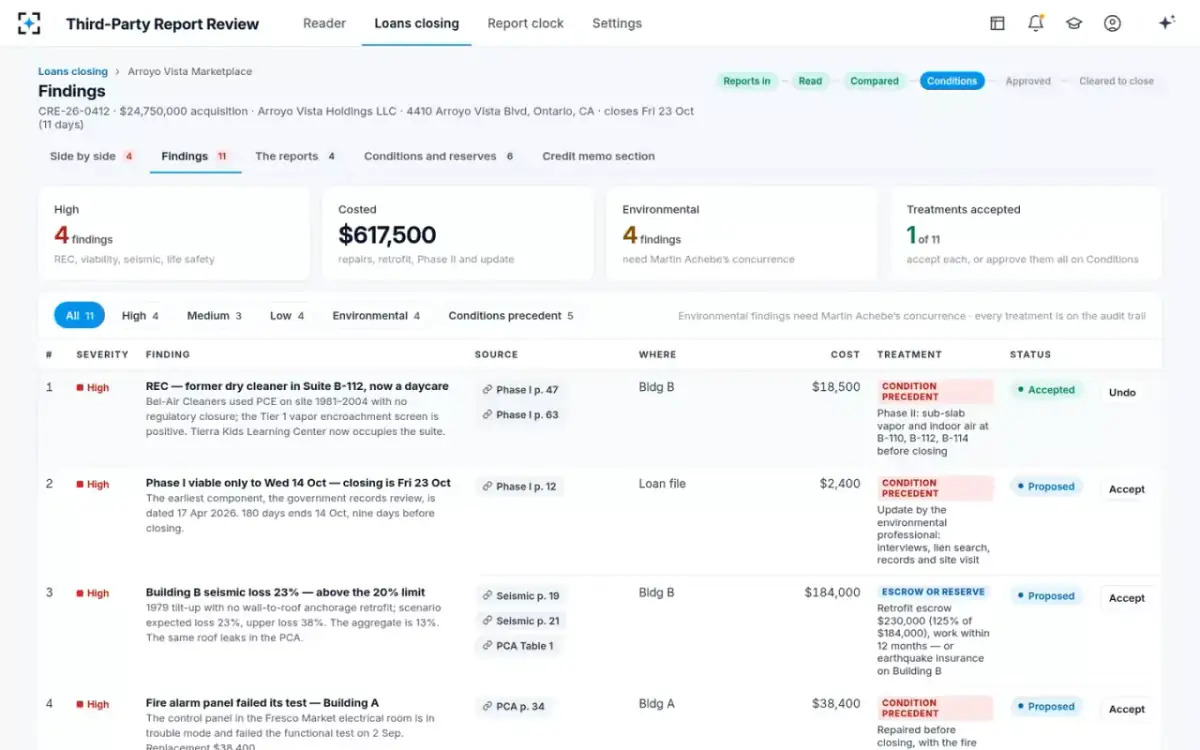

Cross-report reconcilerThe site plan pins each finding to its building. Building B ties three reports together. The PCA says its roof leaks. Its seismic loss is high because the walls were never anchored to that roof. And the retrofit is cheapest when done with the new roof. Where reports disagree, the reconciler flags both values and the survey governs. Here the PCA counted 344 parking spaces, while the survey and zoning report counted 341.
Run log: finished in 2 min 10 s by 7 agents, across 744 pages.
- 08Sized

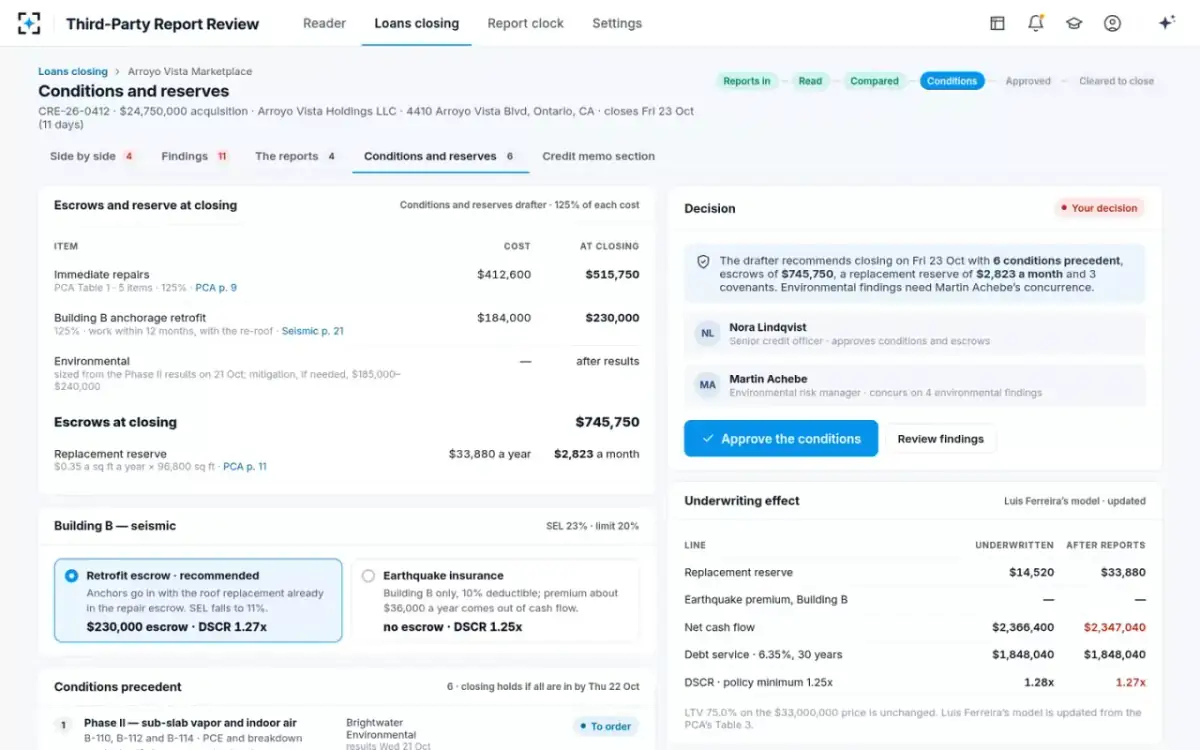

Escrows, the reserve and the effect on debt coverage
Conditions and reserves drafterImmediate repairs of $412,600 become a $515,750 repair escrow at 125%. Add the $230,000 Building B retrofit, and escrows at closing come to $745,750. The PCA’s 12-year table needs $0.35 a sq ft for replacements, against the $0.15 underwritten. So the reserve is $2,823 a month and net cash flow falls to $2,347,040. The debt service coverage ratio (DSCR) shows how many times income covers the loan payments. It moves from 1.28x to 1.27x. Earthquake insurance instead of the retrofit would take it to 1.25x.
- 09Drafted

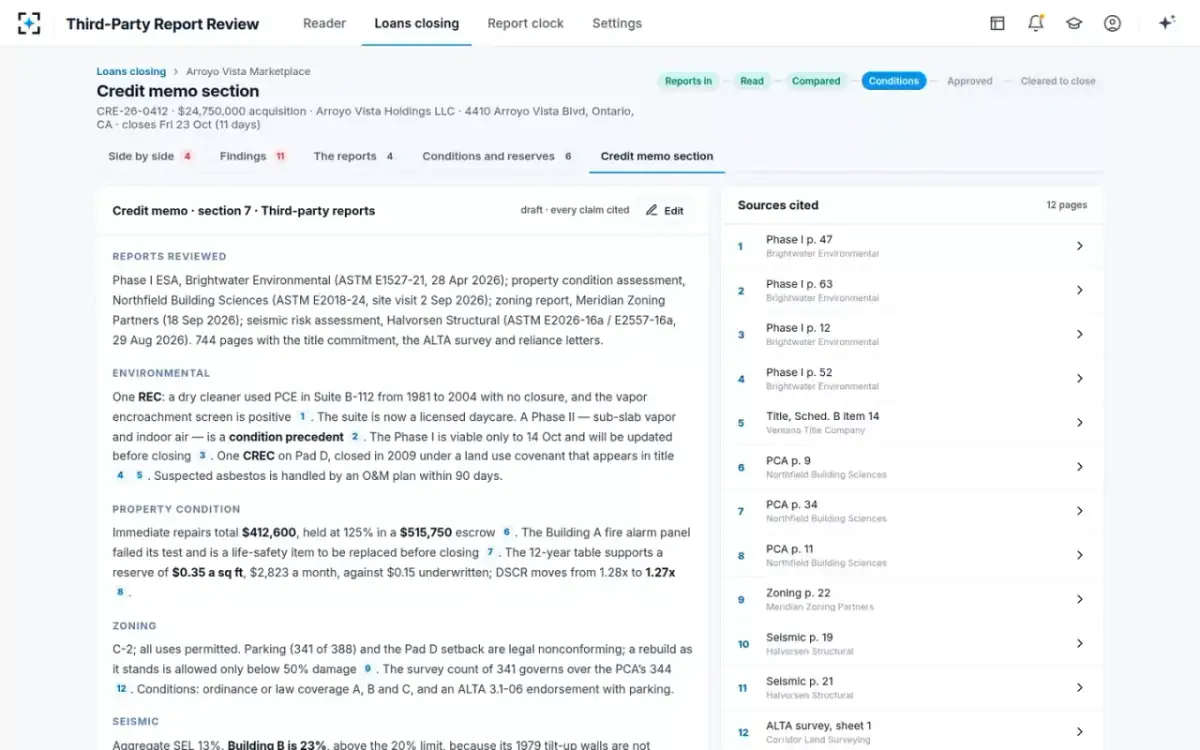

Section 7 of the credit memo, each claim cited
Conditions and reserves drafterThe credit memo’s Third-party reports section is drafted. It lists the reports reviewed, the four sets of findings and a recommendation. It cites 12 pages, from Phase I p. 47 to the ALTA survey. The section stays a draft until the credit officer approves it into the credit memo.

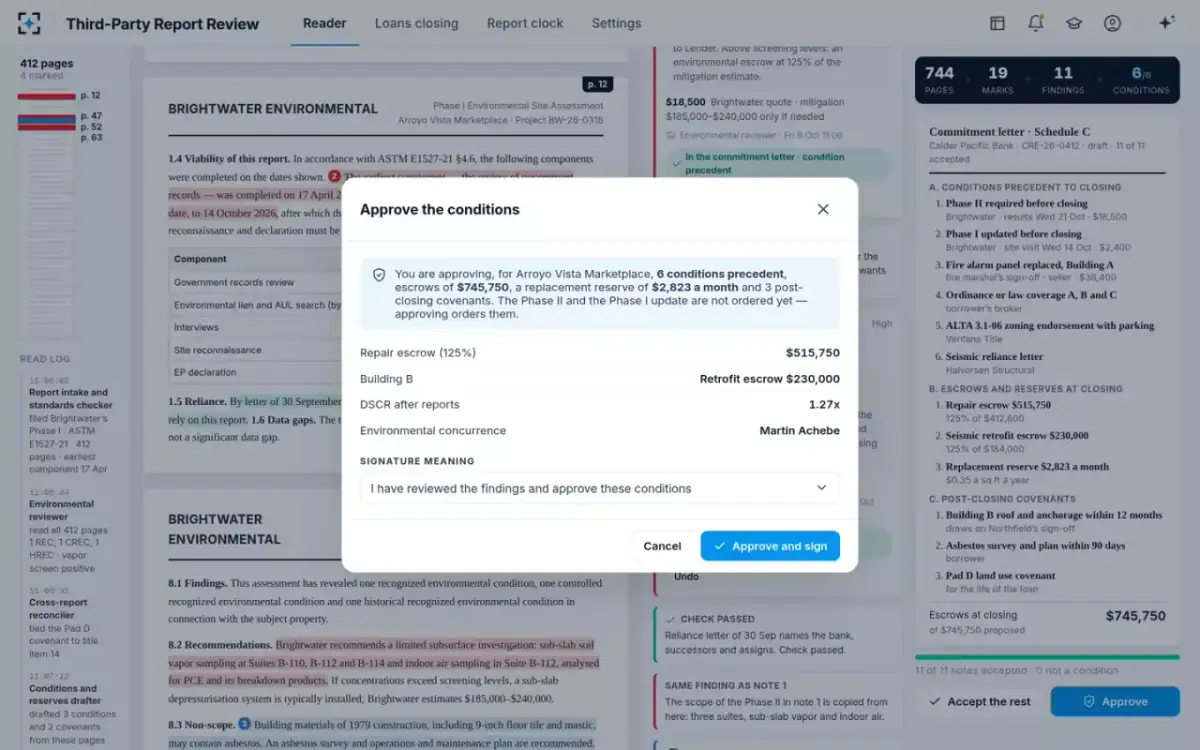

- 10Approved, closing holds
Conditions approved, and environmental risk agrees
Senior credit officer, CREAll 11 notes are now decided. The credit officer approves 6 conditions precedent, escrows of $745,750, a replacement reserve of $2,823 a month and 3 post-closing covenants. The officer also chooses the meaning of the signature. Approving orders the Phase II and the Phase I update too. Once the environmental risk manager agrees with the environmental findings, the loan is cleared to close on its date.
I have reviewed the findings and approve these conditions.
