Construction Loan Monitoring

Construction loan monitoring that projects each loan's interest reserve and contingency to the finish

See one case, screen by screen ↓
Watch with transcript →

Built forLoan administratorsConstruction lendersCRE portfolio managersChief Credit Officers

The Problem Today

Loan administrators test each draw against the approved budget, so an overrun and a draining reserve are found only at the next draw.

76%
of construction schedules finish later than planned published
11.5 h
a month to monitor one construction loan by hand our estimate

Warnings buried in emails and PDFs

  • Site report
  • Schedule
  • Change log
  • Leasing
  • Pending changes go unseenChange orders and delay claims are left out of the draw test
  • The reserve drains quietlySlow leasing and moving rates eat it between draws

The Solution

  1. Each new document read as it landsSite reports, schedule updates, change orders and leasing reports
  2. Progress set against planInspected progress against plan, with the gap broken down by trade
  3. Reserve projected to the finishInterest reserve and contingency run forward to the finish date
  4. The portfolio manager signsActions and a borrower notice drafted. A rating change needs approval

Built-in controls

  • Percent complete stays as the consultant certified it
  • Only a person contacts the borrower
  • Each forecast figure names its source

What You Get

The lender sees months ahead that a project will run short before it is finished, and calls the sponsor while there are still options.

2.75 h
a month to monitor one loan, with no retyping our estimate
  • Early warning on the reserveEach loan forecast again to its finish when a new document lands
  • Ready for the sponsor callShortfall split into change orders, delay claim and interest
  • The committee report draftedThe monthly portfolio report, each figure linked to its loan
In short

What is Construction Loan Monitoring?

It is software that tracks each construction loan between draws. It follows progress against plan, cost to complete, whether the loan stays in balance, the interest reserve and the lease-up. Construction Loan Monitoring adds six agents. They read each site report, schedule update, change-order log and leasing report as it lands, and forecast the loan again to its finish.

How to choose AI solutions for lending →

Updated

The problem

A construction loan can pass its draw test and still be running short

A construction lender needs to know that each loan can still be finished. Two things must hold. The money left in the loan must cover the cost to finish the building. The interest reserve, money set aside to pay interest while the building has no income, must last until the property pays its own way. Both can change between draws, the payments the loan makes as the work goes up. The consultant's site report shows the job falling behind. The contractor's schedule update moves the finish date. Pending change orders, cost changes not yet approved, pile up against the contingency, the money set aside in the budget for surprises. Pre-leasing falls behind the plan, and interest rates move.

The trouble is that the loan is only tested at each draw, against the approved budget. A pending change order or a slipping schedule is not in that budget yet, so the test does not see it. The warning signs arrive in emails and PDFs. Administrators track dozens of projects in spreadsheets and inspector emails, and the credit team hears last. By the time the next draw shows the overrun, the contingency is spent and fewer options are left.

typical76%of construction schedules finish later than planned
Where a loan's monitoring hours go each monthestimated
By hand11.5 hours
With the solution2.8 hours
  • Retyping site reports and schedule updates3 → 0.3 h
  • Pricing pending change orders and claims2 → 0.5 h
  • Projecting the interest reserve and lease-up2 → 0.3 h
  • Running the balance and covenant tests1.5 → 0.3 h
  • Writing the loan's part of the committee report2 → 0.5 h
  • Deciding and signing the actions1 → 1 h

Our estimate for one construction loan in a month, by hand and with the solution.

How it works

Four agent stages between a new site report and a drafted notice

What comes in
New documents inThis week's documents · site reports, schedules, change orders, leasing
Agents at work
Site and schedule readerpercent complete, dates
Then
Change order and cost watcher
Lease-up and sales tracker
Interest reserve forecaster
Then
Balance and covenant tester
Then
Risk and action drafterscore + actions
A person decides
Portfolio managerdecides and signs
What comes out
S-curve to the finish
Balancing notice
Portfolio report
One case, step by step

An apartment loan that passed its last draw test and is forecast to run short

A 248-unit apartment project passed its balancing test at Draw 16. Five documents have arrived since. Here is what happens on a Monday morning in the working solution, screen by screen.

A worked example on sample data. Names, IDs and figures on the screens and in this section come from the demo.

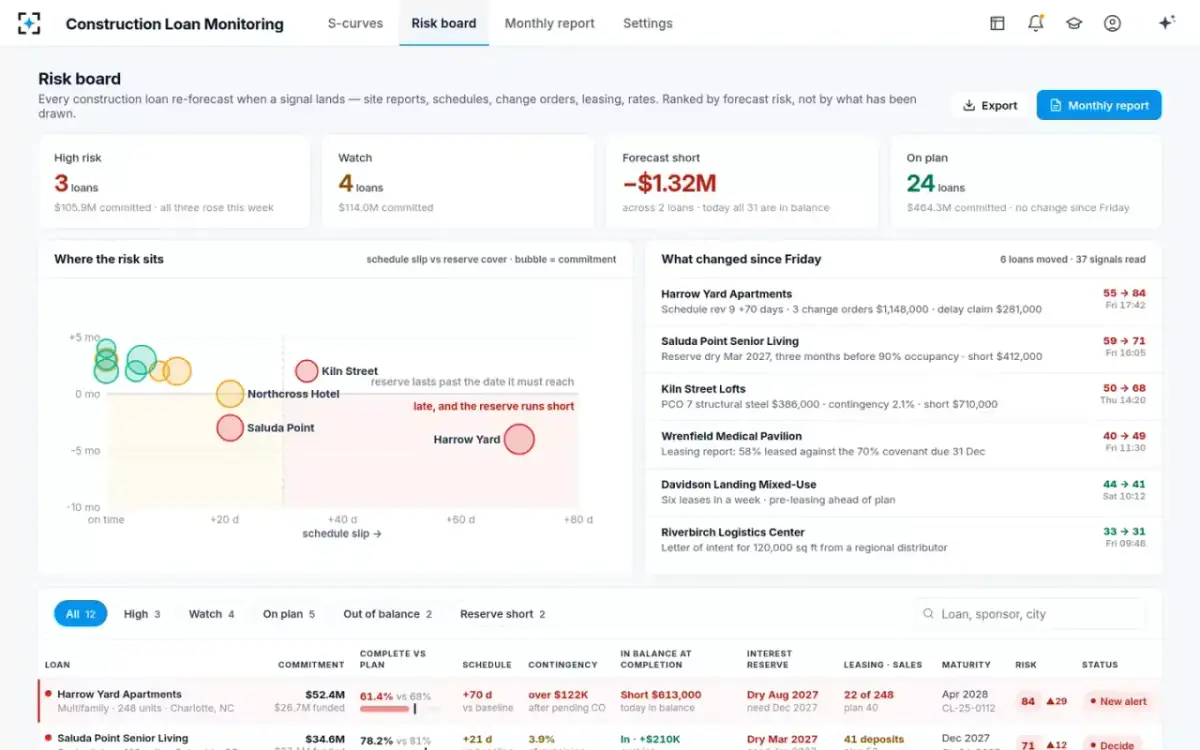

  1. 01Monday morning

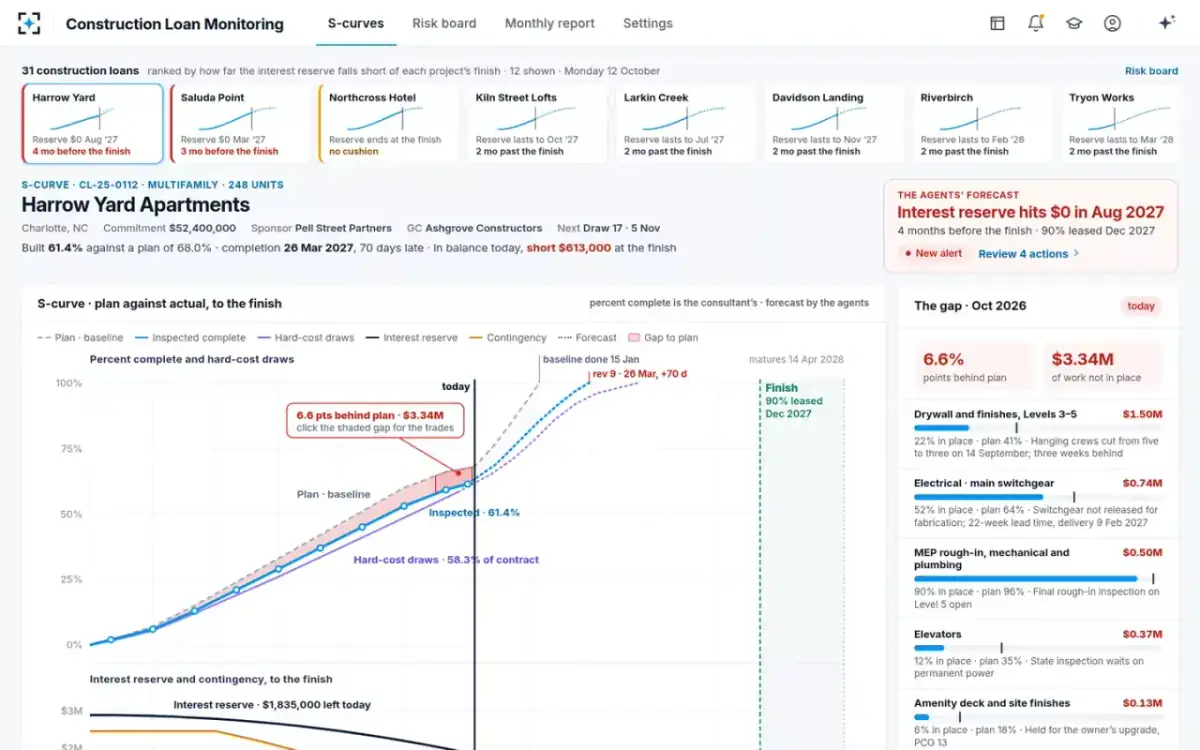

    Thirty-one loans, ranked by how far the reserve falls short

    CRE portfolio manager

    The bank has 31 construction loans. The S-curve screen ranks them by how far each interest reserve falls short of the project's finish, and the apartment loan is first. Its curve has bent below plan. It is 61.4% built against a plan of 68.0%, so 6.6 points and $3.34M of work is not in place. By trade, drywall on Levels 3 to 5 ($1.50M) and the main switchgear ($0.74M) are furthest behind.

    The agents' forecast: “Interest reserve hits $0 · 4 months before the finish at 90% leased.”

  2. 02The new forecast

    A new forecast from the five new documents

    The six agents

    Five documents have landed since Draw 16. They are site report 17, schedule update rev 9, pending change orders 11 to 13, the general contractor's letter and the leasing agent's report. In 1 min 12 s the agents read each one. They price the budget again and project interest to 90% occupancy. Then they run eight tests and score the loan again, from 55 to 84, showing what each step found.

    “Balance and covenant tester ran 8 tests · In balance today · forecast out of balance $613,000 at completion.”

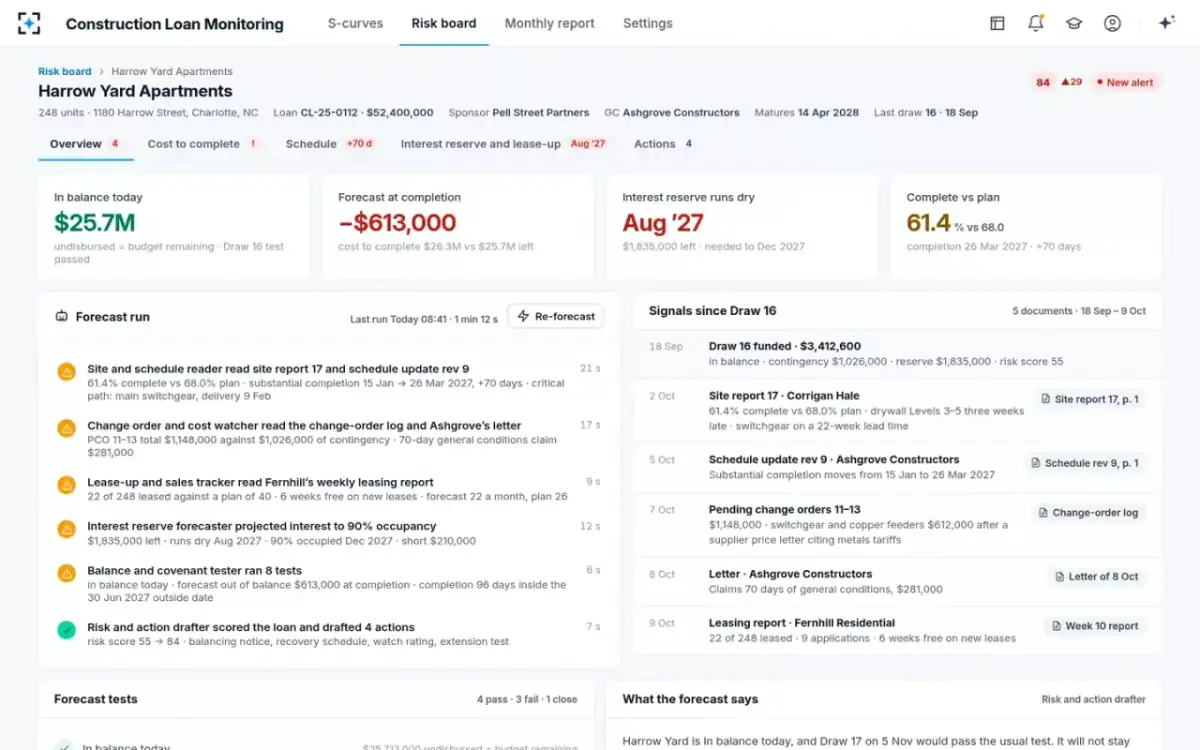

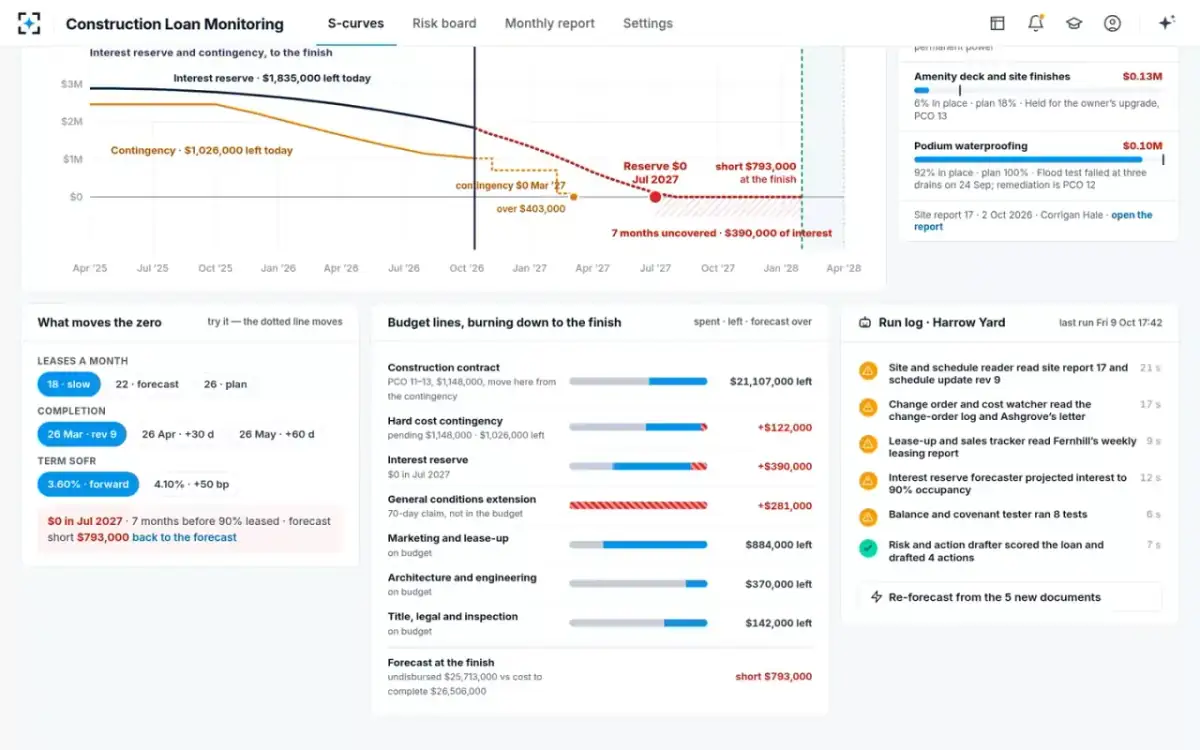

  3. 03To the finish

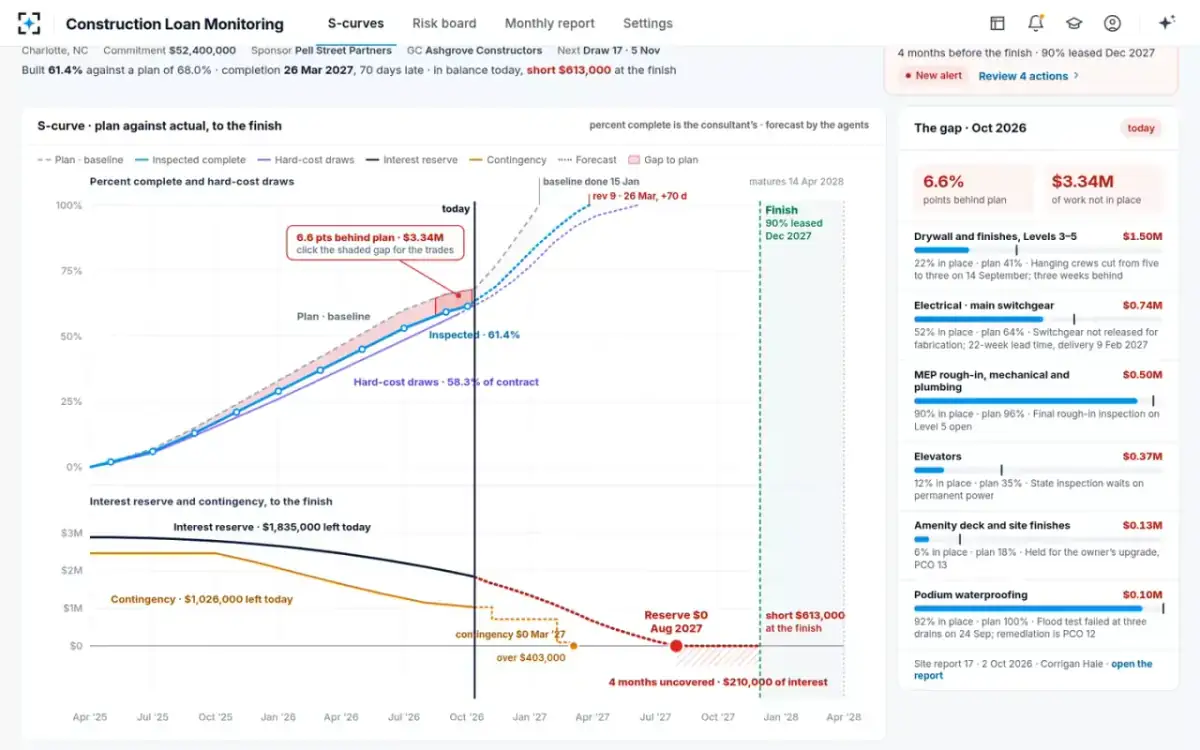

    The money running down, on the same timeline

    Interest reserve forecaster

    Under the S-curve, two lines show the money left. The interest reserve has $1,835,000 and the contingency has $1,026,000. Each line is solid up to today and dotted to the finish. The reserve hits $0 four months before the building is 90% leased. Those months are shaded: $210,000 of interest with nothing to pay it. The contingency runs out sooner still, $403,000 over once the delay claim is counted.

    The forecast reads “short $613,000 at the finish”, while today's test still passes.

  4. 04Trying a scenario

    What moves the date the money runs out

    CRE portfolio manager

    The portfolio manager sets leasing to 18 a month, and the dotted line redraws. The reserve now runs dry a month sooner, seven months before 90% leased, and the loan is short $793,000. Two more buttons move the run-out date the same way. One is completion (rev 9, +30 or +60 days). The other is Term SOFR, the benchmark rate the loan's interest is based on (3.60% forward or +50 bp). Setting leasing back restores the forecast, and the published numbers stay the agents'.

  5. 05Line by line

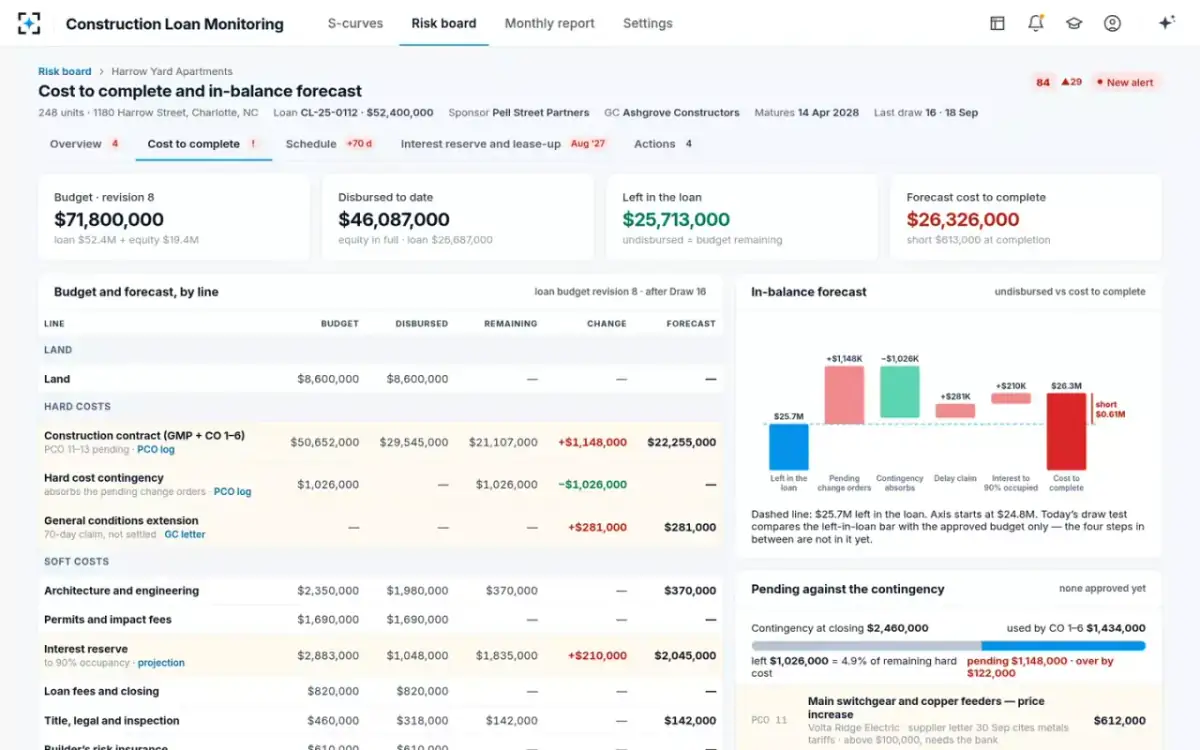

    Cost to complete, and why the draw test cannot see it

    Change order and cost watcher

    Left in the loan is $25,713,000, equal to the budget remaining, so the loan is in balance today. The forecast cost to complete is $26,326,000. A bridge chart shows why. Pending change orders add $1,148K, and the contingency absorbs $1,026K of that. The delay claim adds $281K, and interest to 90% occupied adds $210K. Pending change order 11, the switchgear and copper feeders at $612,000, follows a supplier letter citing metals tariffs.

    “Today’s draw test compares the left-in-loan bar with the approved budget only. The four steps in between are not in it yet.”

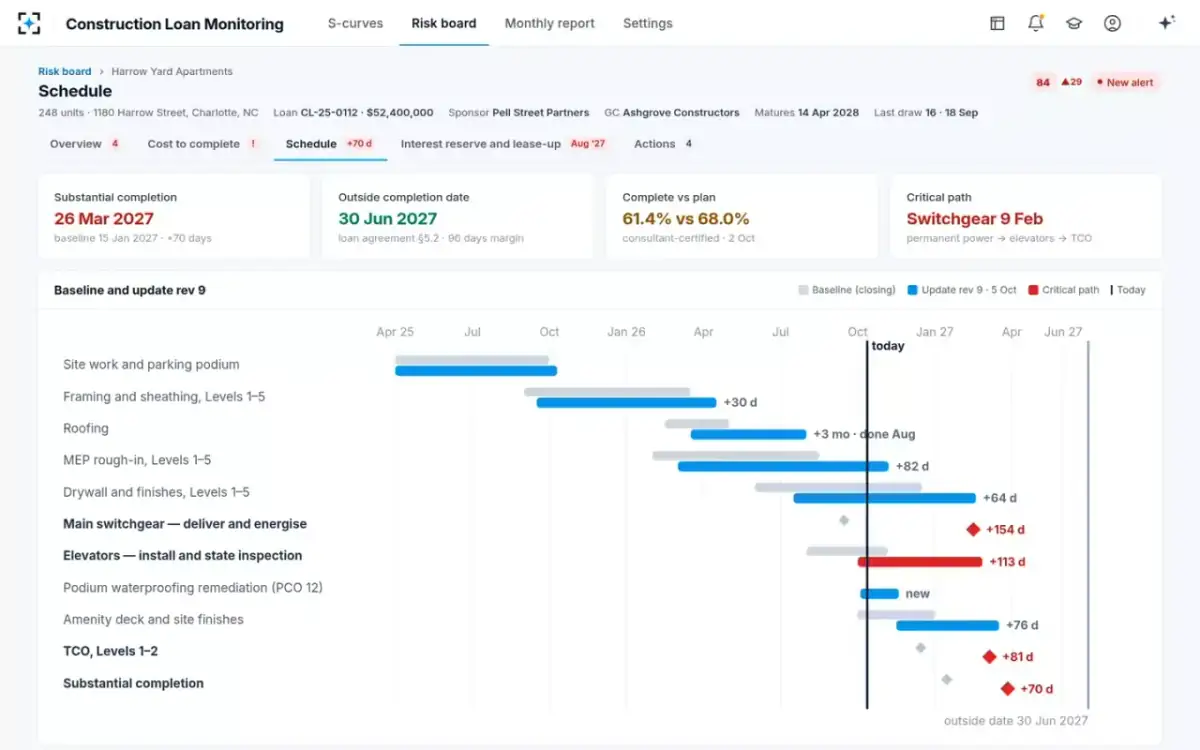

  6. 06The critical path

    The original schedule against rev 9, milestone by milestone

    Site and schedule reader

    Substantial completion moves 70 days later. That leaves 96 days of margin before the outside date in §5.2 of the loan agreement. The critical path, the chain of tasks that sets the finish date, runs through the switchgear delivery. After it come permanent power, the elevators and the temporary certificate of occupancy. The consultant's percentages stay as the consultant wrote them, and each date cites its page.

    The consultant, in site report 17: “Rev 9’s completion date is achievable only if the switchgear date holds; it shows no float on that path.”

  7. 07Each assumption shown

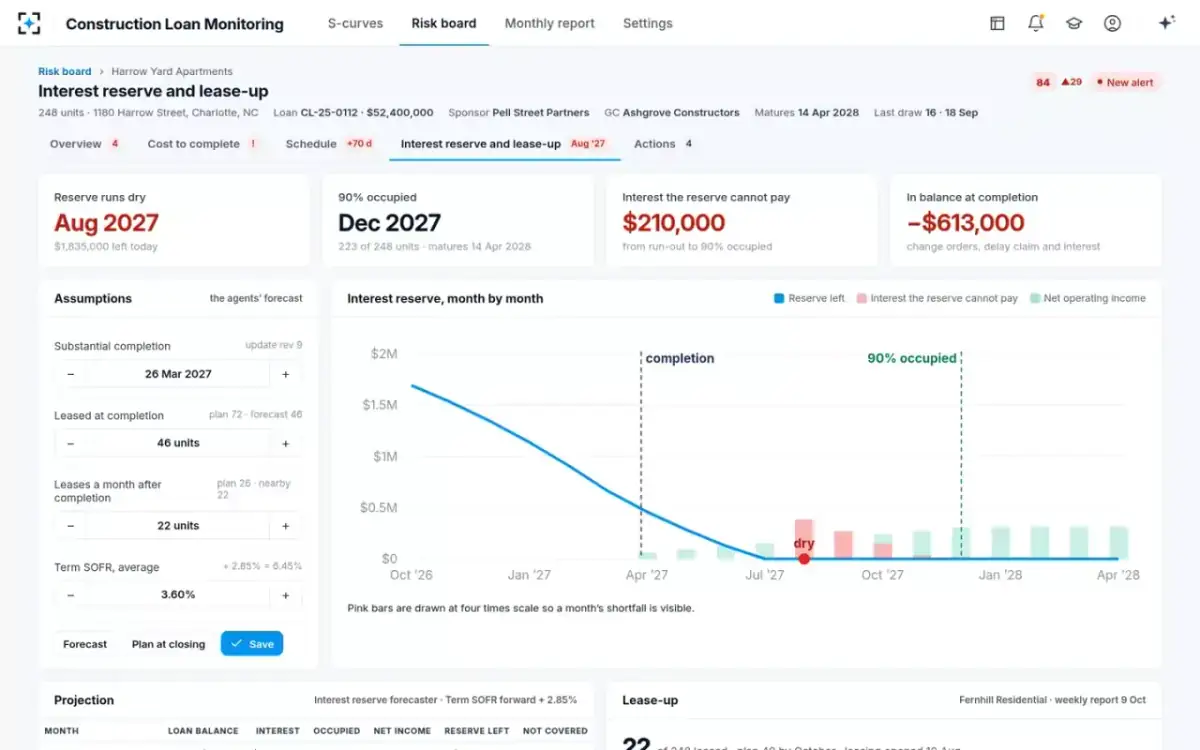

    The reserve, month by month to 90% occupied

    Interest reserve forecaster

    The calculator shows each assumption. Completion is on the rev 9 date. At completion 46 units are leased, against a plan of 72. Leasing runs at 22 a month, against a plan of 26. The rate is Term SOFR 3.60% plus 2.85%, or 6.45%. Net operating income starts the month after completion. Here, 90% occupied means 223 of 248 units.

    “The forecaster uses 22 a month: the three comparable buildings average 22.0, and the closing plan assumed 26.”

  8. 08Drafted

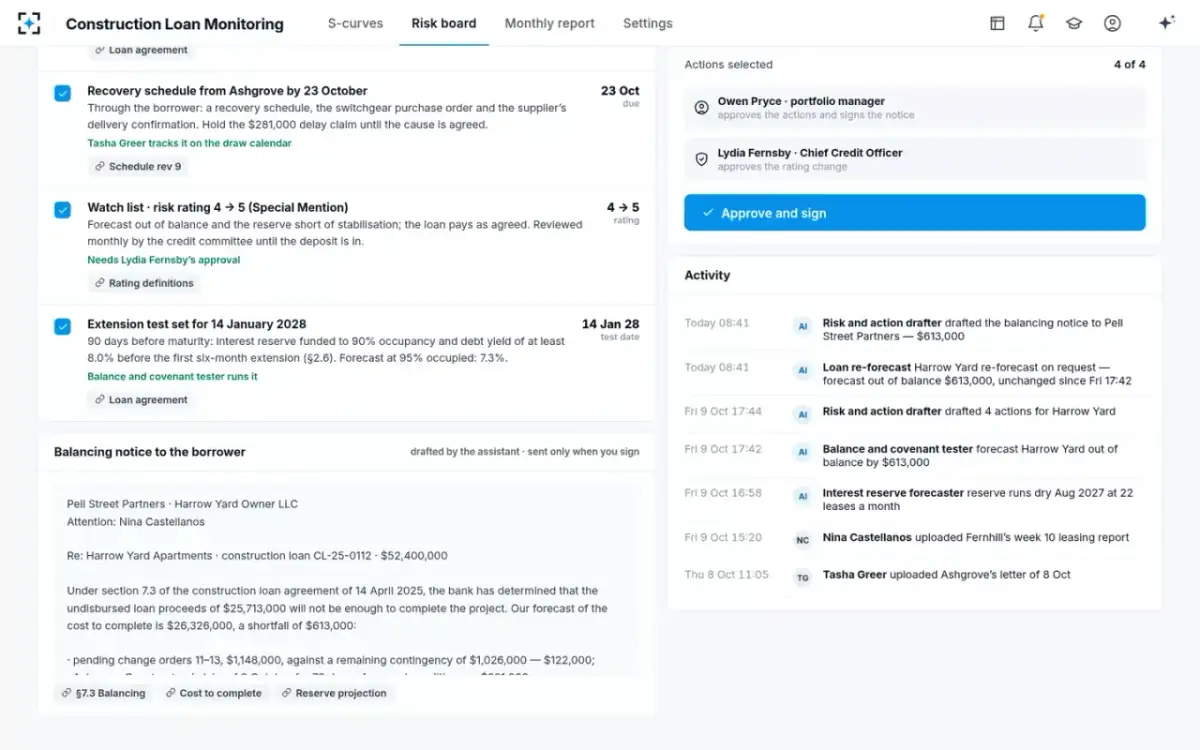

    Four actions and a balancing notice, each figure sourced

    Risk and action drafter

    The drafter recommends four actions. First, a balancing notice to the borrower for $613,000 under §7.3, asking it to pay in the shortfall. Second, a recovery schedule from the general contractor, with the $281,000 claim held. Third, the watch list, with the risk rating moving from 4 to 5 (Special Mention). Fourth, a date for the extension test. The notice splits the shortfall into three parts and says Draw 17 will be funded as usual meanwhile.

    “drafted by the assistant · sent only when you sign”

  9. 09Signed

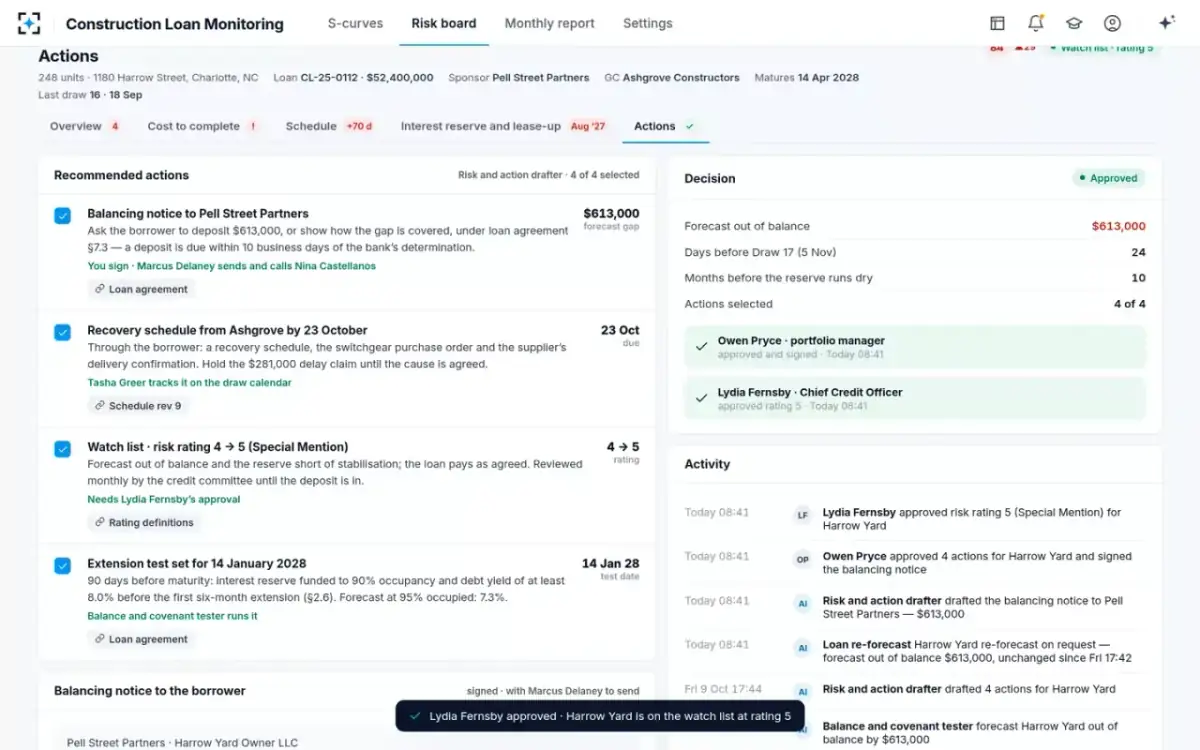

    The portfolio manager approves, and the meaning is recorded

    CRE portfolio manager

    The portfolio manager reviews the four actions and signs. The signature records what it means: “I have reviewed the forecast and its sources and approve these actions”. The rating change goes to the chief credit officer. Nothing reaches the borrower until the lending officer sends it.

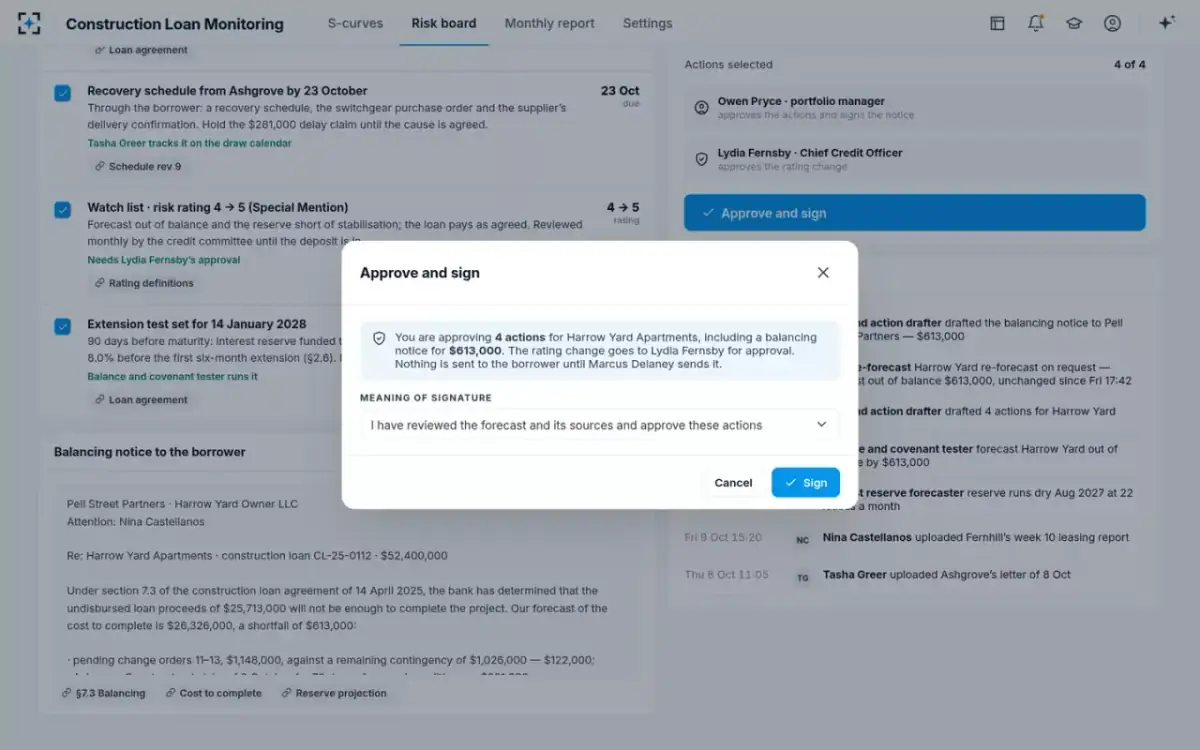

  10. 1024 days before Draw 17

    The rating approved, ten months before the reserve runs dry

    Chief credit officer

    The chief credit officer approves risk rating 5 (Special Mention), and the loan goes on the watch list. That is 24 days before Draw 17 and 10 months before the reserve runs dry. This week's monthly portfolio report for the credit committee picks up the new rating and the signed notice.

Who it’s for

Four people at the bank who work on a construction loan

The same loan, seen by four people. First their month by hand, then their month now.

CRE portfolio manager
Decides the actions and signs
Before
Learns of an overrun only when a draw shows it and the contingency is gone. Retypes site reports, schedules and change-order logs into a spreadsheet for each loan.
Now
Starts the week with loans ranked by how far each interest reserve falls short of its finish. Each has its S-curve, forecast, sources and recommended actions.
Chief credit officer
Approves risk ratings
Before
Owns risk ratings, the watch list and the credit committee. Hears of a troubled loan only when it no longer balances at a draw.
Now
Sees each loan scored again after each new document on the risk board. Approves rating changes with the forecast and its sources in front of them.
Construction lending officer
Owns the sponsor relationship
Before
Needs the shortfall broken down before calling the sponsor.
Now
Calls the sponsor with a signed notice that splits the shortfall into change orders, the delay claim and interest, each figure cited.
Construction loan administrator
Runs the monthly draws
Before
Runs monthly draws against a budget that knows only what has been approved, so pending change orders stay out of sight.
Now
Sees each budget line's remaining, pending and forecast amounts. Tracks the contractor's recovery schedule on the draw calendar.
The agents

Site, cost, reserve and lease-up agents in construction loan monitoring

Each new site report, schedule or change order updates its loan's forecast within the hour. The portfolio manager decides and signs.

Site and schedule reader

Reads the consultant's site reports and the contractor's schedule updates. Pulls out the certified percent complete against plan, each milestone's original and current date, the critical path and the consultant's opinion.

  • Never alters a percentage the consultant certified
  • Cites the page for each date
Change order and cost watcher

Reads pending change orders, contractor letters and construction cost indices. Adds each pending change order and delay claim at the claimed amount, and forecasts each budget line to completion.

  • Never approves or rejects a change order
  • Applies cost indices only to scopes not yet bought
Interest reserve forecaster

Projects the draws, interest on the Term SOFR forward curve plus the spread and net operating income during lease-up. Finds the month the reserve runs dry and the interest still needed to stabilization.

  • Never changes the loan terms or the rate
  • Shows each assumption
Lease-up and sales tracker

Reads leasing and sales reports against the business plan and pre-leasing covenants. Tracks how fast units lease, the concessions given and similar lease-ups nearby.

  • Never contacts tenants, buyers or prospects
Balance and covenant tester

Forecasts whether the loan stays in balance, and runs the contingency minimum and the completion, leasing, maturity and extension tests. Reports pass, close or fail with the figure.

  • Never declares a default
  • Thresholds come from Settings
Risk and action drafter

Scores each loan on schedule, budget, reserve, leasing and maturity, and raises the alert. Drafts the recommended actions and the borrower notice, and writes the monthly portfolio report.

  • Never sends anything
  • Never changes a risk rating. It recommends, and a person approves and sends
Portfolio manager

Approves actions, and the CCO approves ratings.

Ask in plain words

Out-of-balance forecasts, lease-up scenarios and balancing notices, on request

Ask about any loan or reserve, or say what to draft. Each answer cites the site report, schedule, letter or leasing report behind its figures. These answers use the sample data.

Why is this loan forecast out of balance?

It is in balance today, but four things since Draw 16 are not in the budget yet. Pending change orders 11 to 13 add $1,148,000, and the contingency absorbs $1,026,000. The contractor's 70-day delay claim adds $281,000. The reserve also cannot carry $210,000 of interest to 90% occupancy. Cost to complete is $26,326,000, so the loan is forecast $613,000 short at completion.

What if leasing gets back to the plan, 26 a month?

With 46 leased at completion, the reserve still runs dry in the same month. But 90% occupancy comes a month earlier. The interest it cannot carry falls from $210,000 to $83,000, and the forecast gap falls from $613,000 to $486,000. The three nearby lease-ups average 22.0 a month, so I would not plan on 26. The scenario is not saved.

Which loans need a decision this week?

Three are high and one is close. This loan is forecast $613,000 short. A second loan's reserve is short $412,000 before 90% occupancy, with Draw 20 next. A third has 2.1% contingency left and a forecast shortfall of $710,000. A fourth is 58% leased against a covenant of 70% by year end.

Draft the balancing notice to the borrower

Drafted. It cites section 7.3 of the loan agreement, which asks for a deposit within 10 business days of the bank's written notice. It splits the $613,000 into three parts. Change orders over the contingency are $122,000, the delay claim is $281,000 and interest to 90% occupancy is $210,000. It asks for a meeting by a set date and for the contractor's recovery schedule. Nothing is sent until you sign and the lending officer sends it.

The screens

Construction loan screens from the S-curve to the balancing notice

From the working solution, on its sample data. Pick one to see it large.

S-curvesLoans ranked by reserve shortfall, with the selected loan's S-curve, forecast and gap by trade.
The reserve to the finishReserve and contingency running down, dotted to the finish, with the months the reserve cannot cover marked.
What moves the dateLeasing pace, completion and Term SOFR as buttons that move the run-out date and the shortfall.
Risk boardEach loan forecast again when a new document lands, ranked by forecast risk, with what changed since Friday.
The loan monitorIn balance today, the forecast at completion and the reserve run-out, with each agent's step and the documents since the last draw.
Cost to completeEach budget line's disbursed, remaining, pending and forecast amounts, and the in-balance bridge.
ScheduleThe original schedule against the latest update, milestone by milestone, with the critical path and the outside completion date.
Interest reserve and lease-upThe reserve month by month to 90% occupied, with each assumption shown and adjustable.
Actions and the noticeRecommended actions with their figures and sources, and the balancing notice drafted under the loan agreement.
Approve and signThe portfolio manager approves the actions, and the meaning of the signature is recorded with it.
ApprovedBoth approvals on the decision panel and the activity trail, with the time left before the next draw.

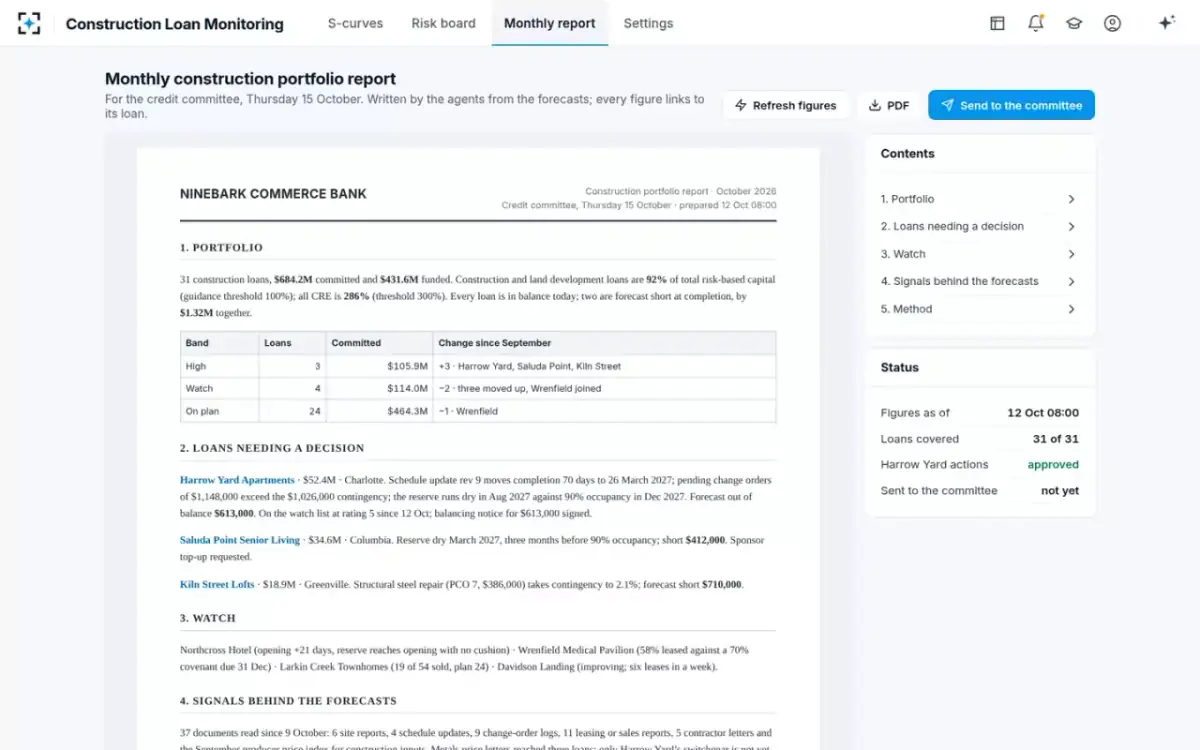

Monthly portfolio reportThe report for the credit committee, written from the forecasts, each figure linked to its loan.
SettingsThe forecast date, rate basis, contingency minimum, alert thresholds, risk bands, signals read and approvers.
Governance

Sourced figures and signed decisions in construction loan monitoring

Each figure names its sourceEach forecast figure links to the site report, schedule update, change-order log, letter or leasing report behind it, at the page.
The consultant's numbers stay as certifiedPercent complete is the figure the consultant certified. The agents compare it with plan and leave it as it is.
The portfolio manager signsThe portfolio manager approves the actions and signs the notice, and the meaning of the signature is recorded. A risk rating change needs the Chief Credit Officer's approval.
Only a person contacts the borrowerThe relationship officer makes all contact with the sponsor, and the agents make none. A signed notice waits for the lending officer to send it.
The agents forecast, and people decideThe agents do not change loan terms, the rate or a risk rating. They do not approve a change order or declare a default. A person decides each action.
Each step on the recordEach agent step, upload and approval is on the loan's activity trail with who, what and when. Threshold changes are versioned and on the audit trail.
Configuration

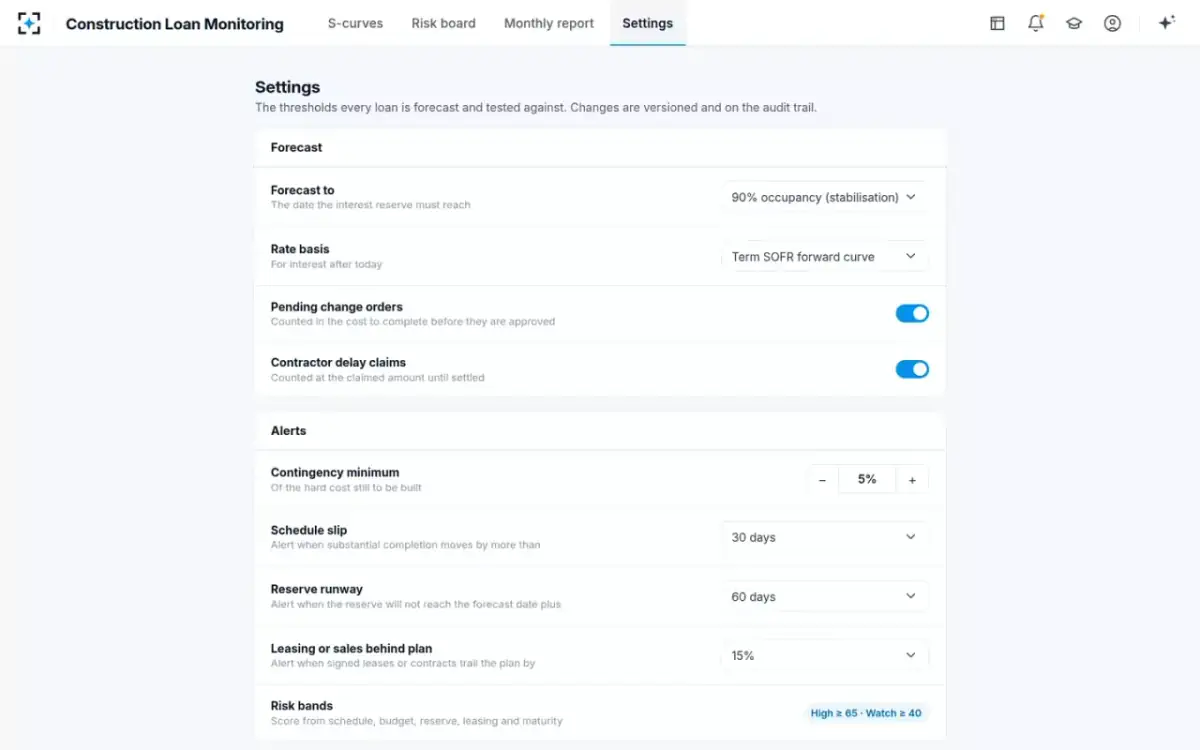

Credit policy settings for the forecast date, contingency and alerts

The thresholds each loan is forecast and tested against are settings, versioned and on the audit trail.

SettingDefaultChoose from
Forecast end: the date the interest reserve must last until90% occupancy (stabilisation)90% occupancy (stabilisation) · Substantial completion + 6 months · Loan maturity
Rate basis for interest after todayTerm SOFR forward curveTerm SOFR forward curve · Today's rate held flat · Forward curve + 100 bp stress
Pending change orders · contractor delay claimsCounted in the cost to complete · at the claimed amount until settledOn · Off, each
Contingency minimum, of hard cost still to be built5%2% to 10%, in one-point steps
Alert when substantial completion moves by more than30 days14 · 30 · 45 · 60 days
Alert when the reserve will not reach the forecast date plus60 days30 · 60 · 90 days
Alert when leases or sales trail the plan by15%10 · 15 · 25%
Who approves actions and notices · rating changesPortfolio manager · Chief Credit OfficerPortfolio manager · Portfolio manager + lending officer. Ratings: Chief Credit Officer · Credit committee
Connections

Documents and data that construction loan monitoring software reads

Loan agreement and approved budgetbudget revision, schedule at closing, loan terms
Consultant site reportscertified percent complete and notes, monthly
Schedule updates and change-order logsfrom the borrower portal, as uploaded
Leasing and sales reportsweekly from the leasing agent or builder
Construction cost indicesproducer price index for construction inputs
Rate curve and draw historyTerm SOFR forward curve, the interest reserve balance
What it changes

What construction loan monitoring changes for a lender

Each figure carries its label: a target the solution is built to, an estimate, a typical published result, or a proven one.

estimated
10months
warning before the interest reserve runs out, in the sample case
Reserve hits $0Aug 2027
SeenOct 2026
target
100%
of construction loans re-forecast within an hour of a new signal
31 of 31 loans
on every signal
typical
76%
of construction schedules finish later than their baseline
76 of 100 schedules
70,000+ schedules studied

“Demo” means seen in the working solution, on its sample portfolio. “Target” means the design goal, measured in the live solution. “Estimated” means our estimate. “Typical” means published figures. The State of Construction Scheduling 2025 study found that 76% of more than 70,000 schedules finished later than their baseline. Names on the screens are sample data.

Questions

Construction loan monitoring software questions from credit teams

What is construction loan monitoring software?

It is software that tracks each construction loan between draws. It follows progress against plan, cost to complete, whether the loan stays in balance, the interest reserve and the lease-up. Construction Loan Monitoring adds six agents. They read each site report, schedule update, change-order log and leasing report as it lands, and forecast the loan again to its finish.

How does it forecast the interest reserve?

The interest reserve forecaster projects month by month to the date the reserve must last until, which is 90% occupancy by default. It counts the draws, interest on the Term SOFR forward curve plus the loan's spread and net operating income as units lease. It reports the month the reserve runs dry and the interest it cannot carry, and it shows each assumption.

How does it know a loan will go out of balance before the next draw?

It counts what the draw test cannot see yet. That means pending change orders and contractor delay claims at the claimed amount, and the interest the reserve cannot carry to stabilization. In the working solution, one apartment loan is in balance today and forecast $613,000 short at completion.

Does it change our loan terms, ratings or the consultant's numbers?

No. The agents do not change loan terms, the rate, a risk rating or a percentage the consultant certified. They do not approve a change order or declare a default. They forecast and recommend.

Who signs the borrower notice and approves a rating change?

The portfolio manager approves the actions and signs any borrower notice. A risk rating change needs the Chief Credit Officer's approval. Only the relationship officer contacts the sponsor. Each agent step and approval is on the activity trail.

Which documents does it read?

The loan agreement and budget, site reports, schedule updates, change-order logs, leasing and sales reports, cost indices and the rate curve. Each signal is switched on or off in Settings.

Can we set our own thresholds and approvers?

Yes. The forecast date, rate basis and contingency minimum are settings. So are the alerts for schedule slips, reserve runway and leasing, the risk bands and the approvers. Each change is versioned on the audit trail.

What do you need from our construction lending team to set it up?

The Agentic Solution Engine builds and deploys it from your requirements. We need your credit policy, loan agreements, budgets and a sample of site reports and draws. It goes live once each quality gate has passed, and we will walk you through it on your own loans first.

Try construction loan monitoring
on your own loans and site reports.

We'll run Construction Loan Monitoring on a sample of your own loans, site reports and draws.
