- Before
- Learns what was missing only at the quarterly QC review. Works a backlog of thousands by hand and keeps the expected-document list in a spreadsheet.
- Now
- Sees what is missing today, site by site and zone by zone. Confirms only the filings the agents were unsure of, and signs each one.
A staff change at one site, found by the morning eTMF quality check
The sample study is a Phase 3 trial of a new drug for moderate-to-severe plaque psoriasis. It is randomized and double-blind, with 46 sites in 12 countries. It runs under a US IND, the application to the FDA to test a drug in people. Here is what its TMF lead sees and does, screen by screen, in the working solution.
A worked example on sample data. Names, IDs and figures on the screens and in this section come from the demo.
- 01Early morning

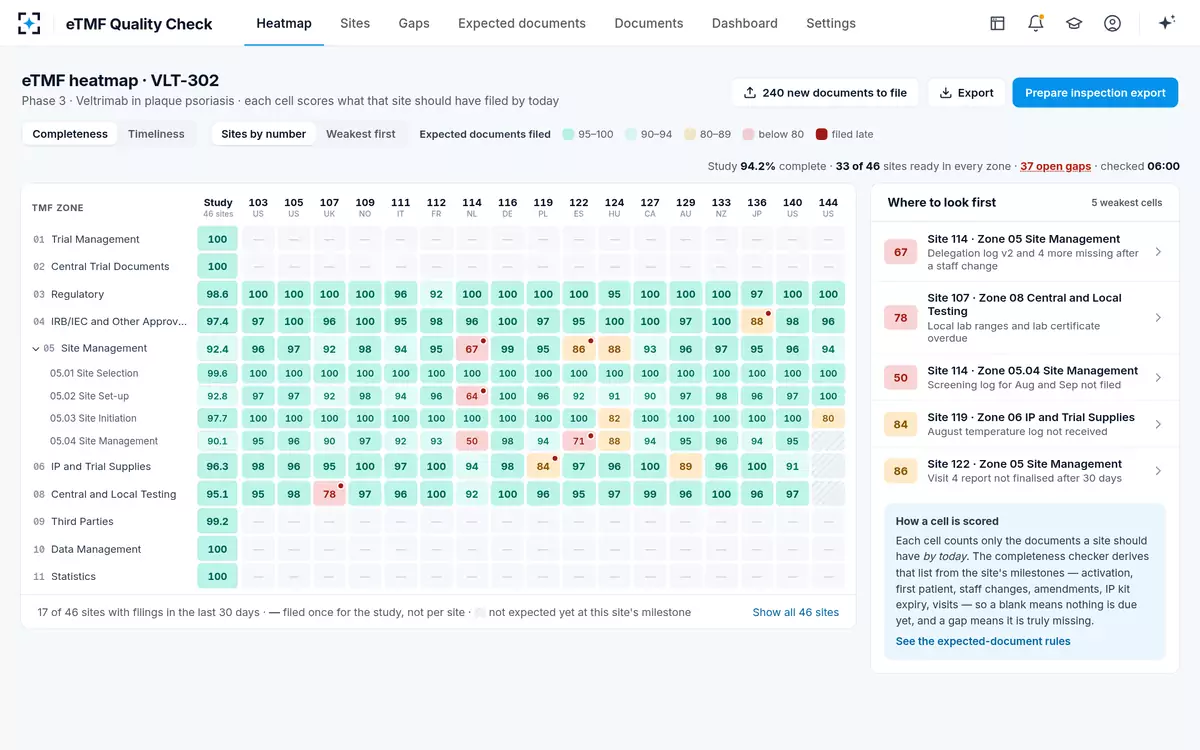

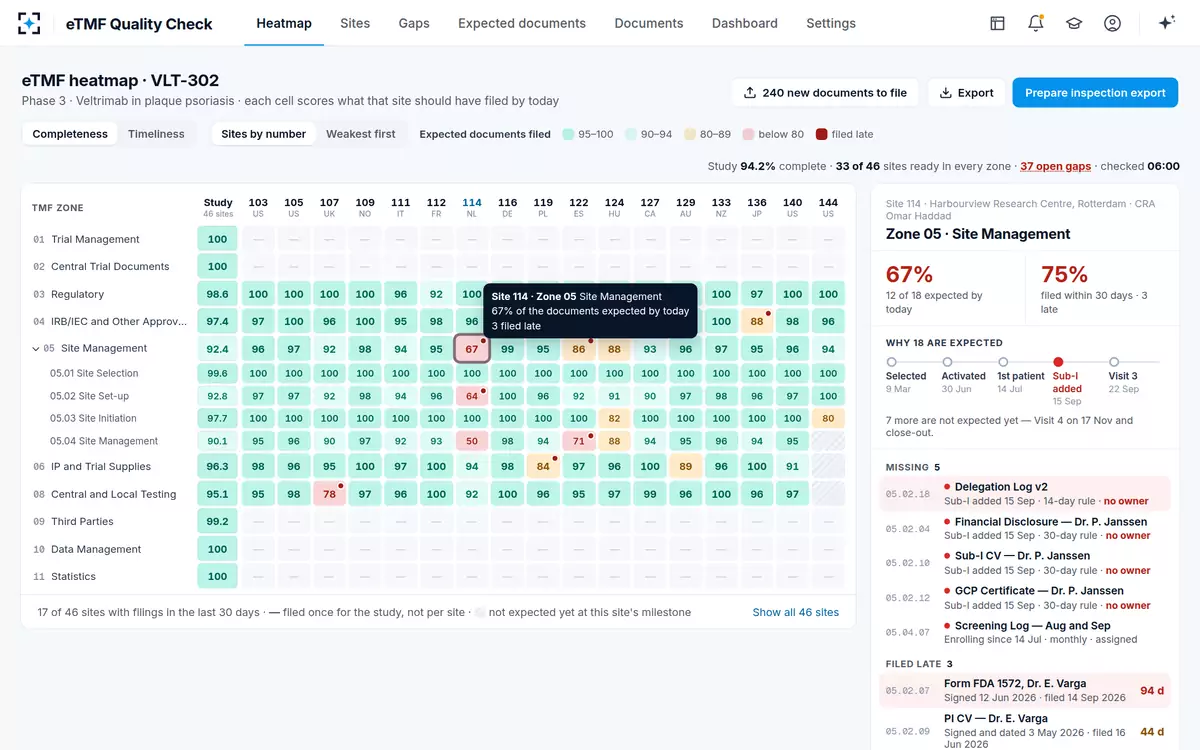

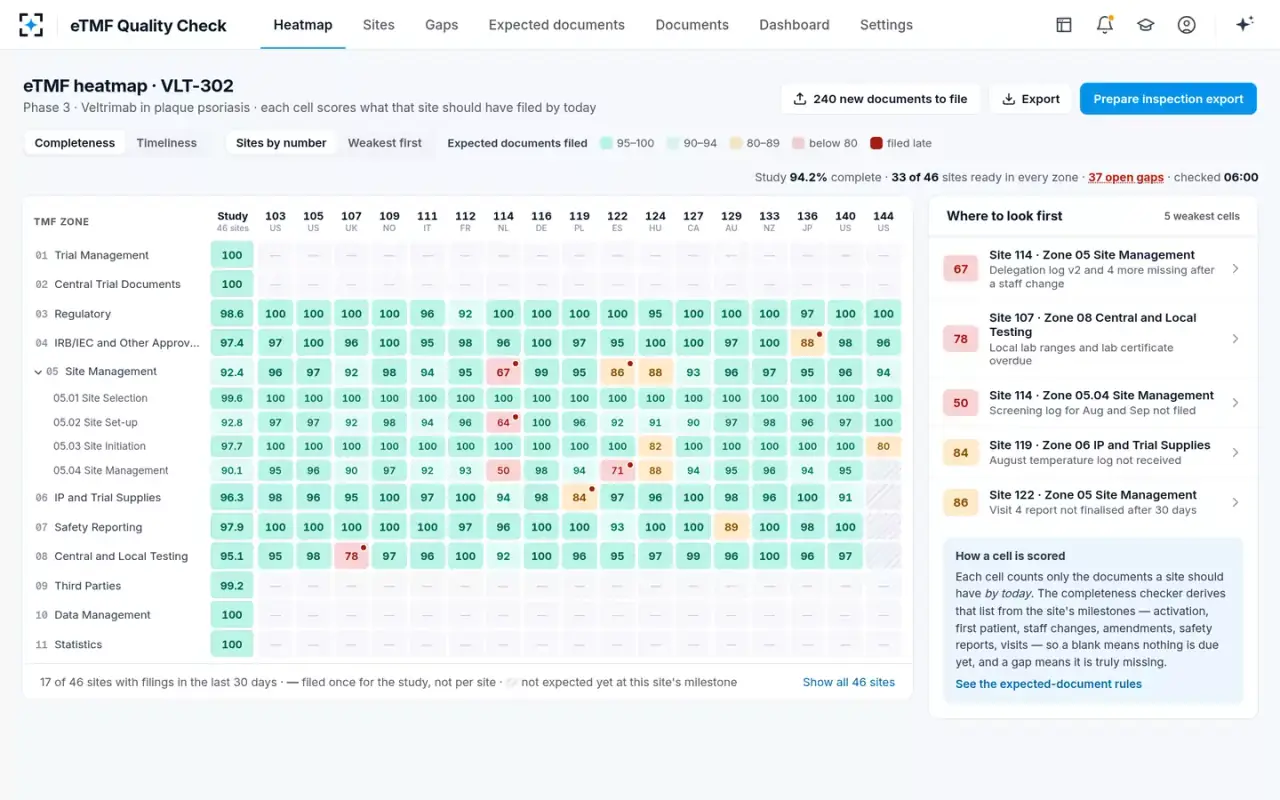

The whole file on one heatmap
TMF lead and QC reviewerThe heatmap shows the file's zones down the side and the sites across. Zones are the main sections of the TMF Reference Model, the industry's standard filing structure. The completeness checker scored each cell before the day began. The study is 94.2% complete. Of 46 sites, 33 are ready in every zone, and 37 gaps are open. Trial-level zones show a dash, because they are filed once for the whole study. Late filings carry a red dot. The side panel lists the five weakest cells. By hand, this study once had 4,820 documents waiting to be filed.
“Each cell counts only the documents a site should have by today.”
- 02Hatched cells

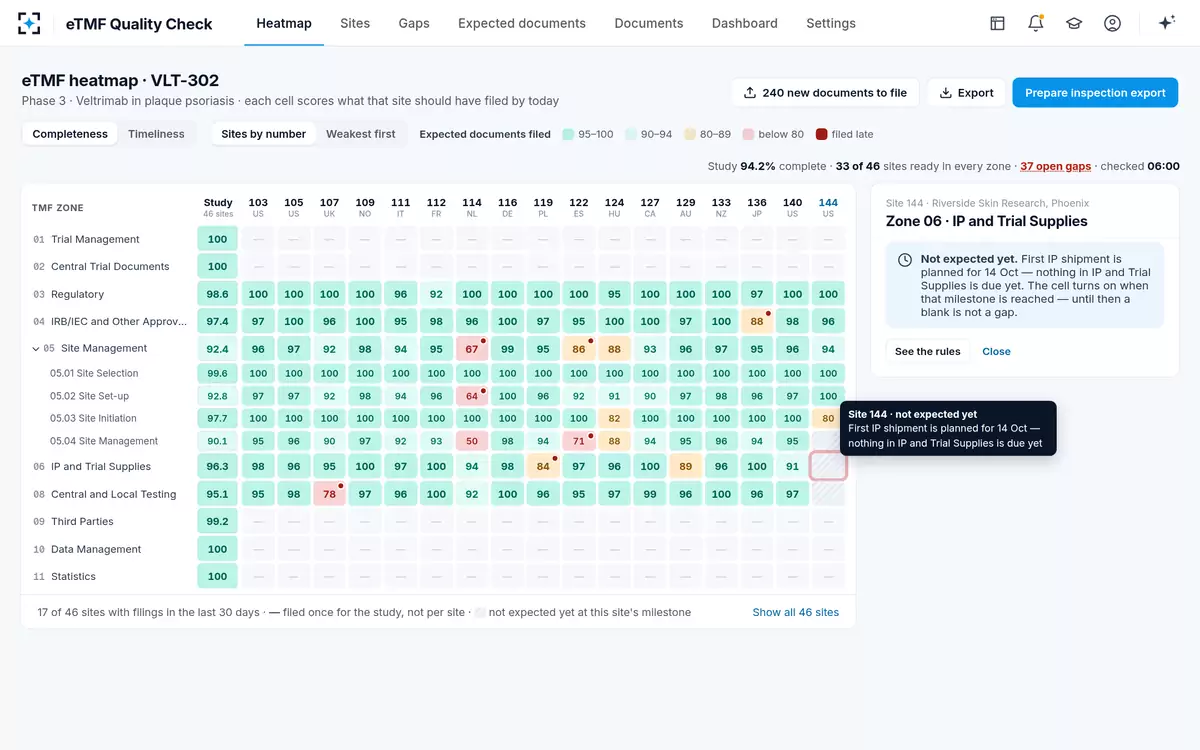

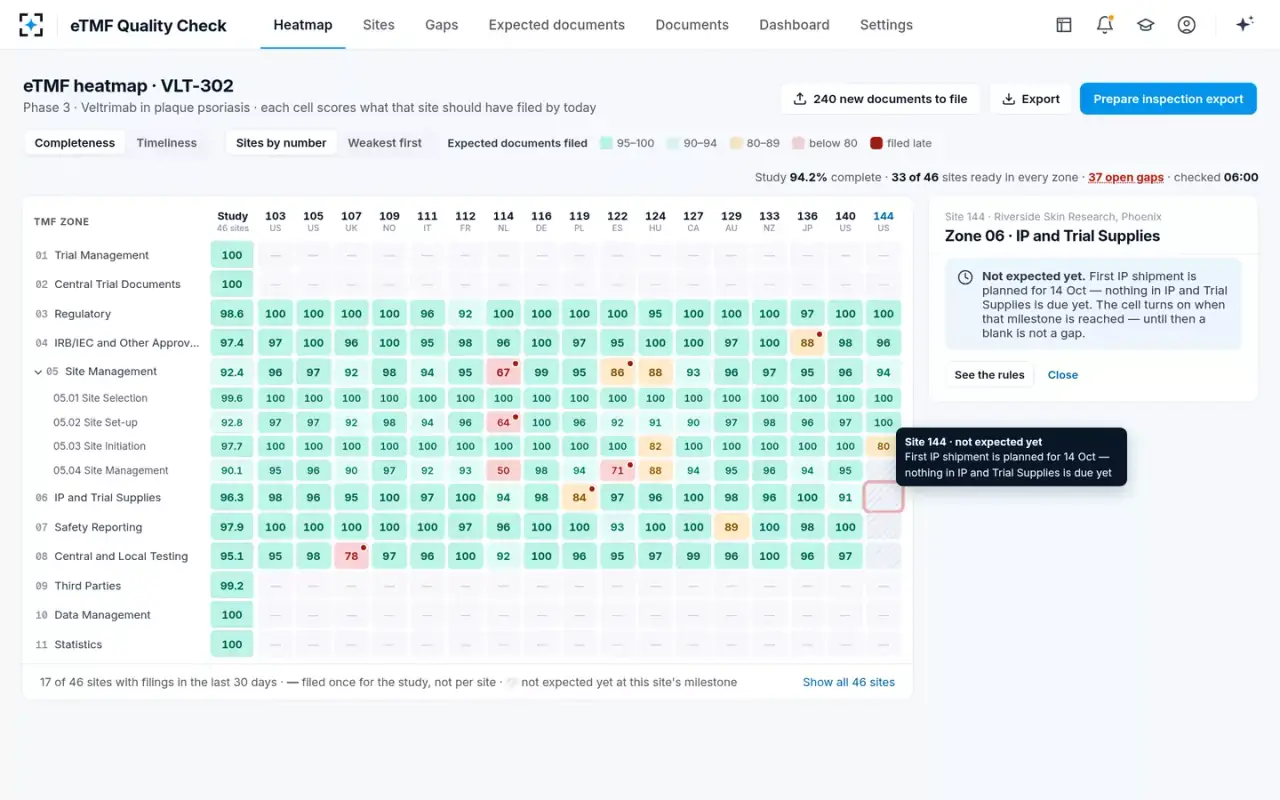

A blank cell is not a gap
Completeness checkerOne site was activated only recently. Its Zone 06 cell is hatched, which marks it as not yet due. The first shipment of the trial drug (IP, the investigational product) has not arrived. So nothing in IP and Trial Supplies is due yet. Local lab documents become due at first patient. Visit reports become due after the first monitoring visit.
“The cell turns on when that milestone is reached. Until then a blank is not a gap.”
- 03One click

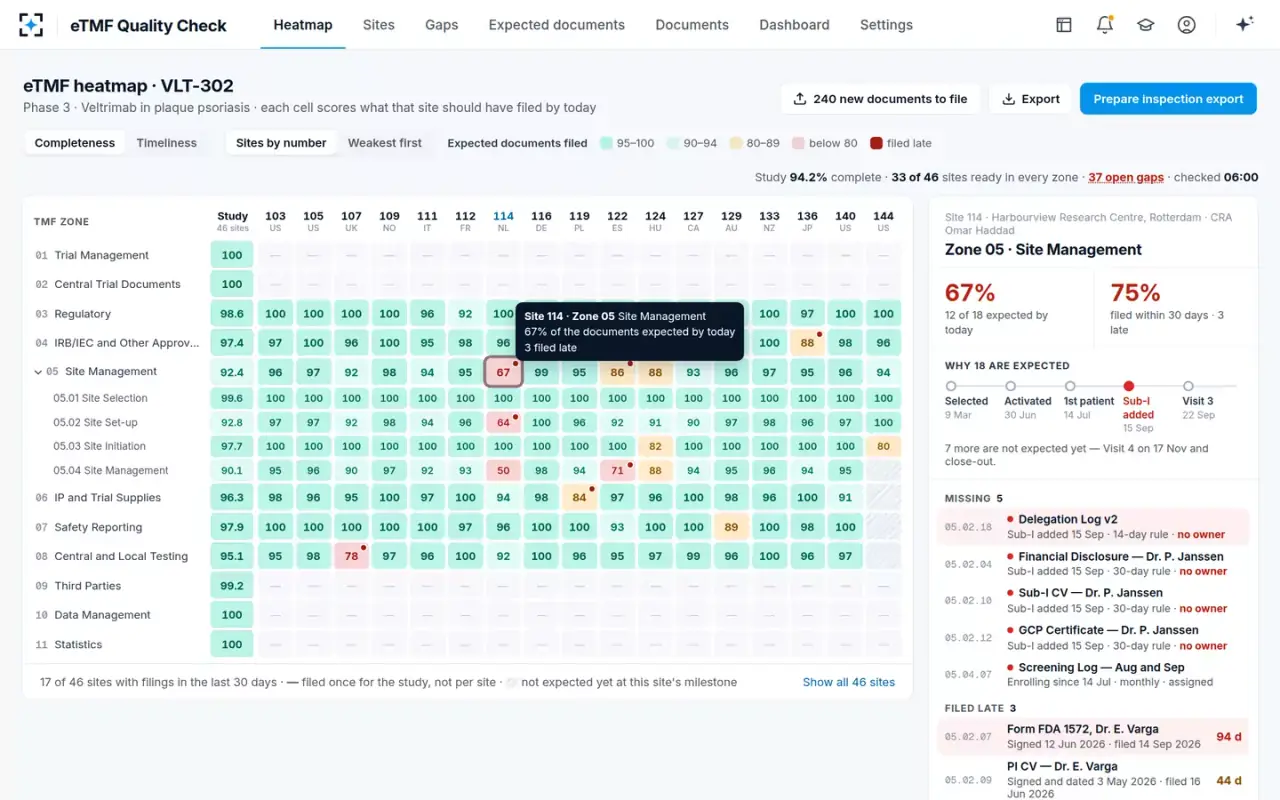

One site's Zone 05: 67% complete, 75% on time
TMF lead and QC reviewerThe weakest site has 12 of the 18 Site Management documents it should have by today. The milestone strip shows why 18 are expected. The site was selected and activated, enrolled its first patient, added a sub-investigator and held Visit 3. The strip also shows 7 more documents that are not due yet. Five documents are missing and three were filed late. The worst is the investigator's Form FDA 1572, filed 94 days after it was signed.
- 04The evidence

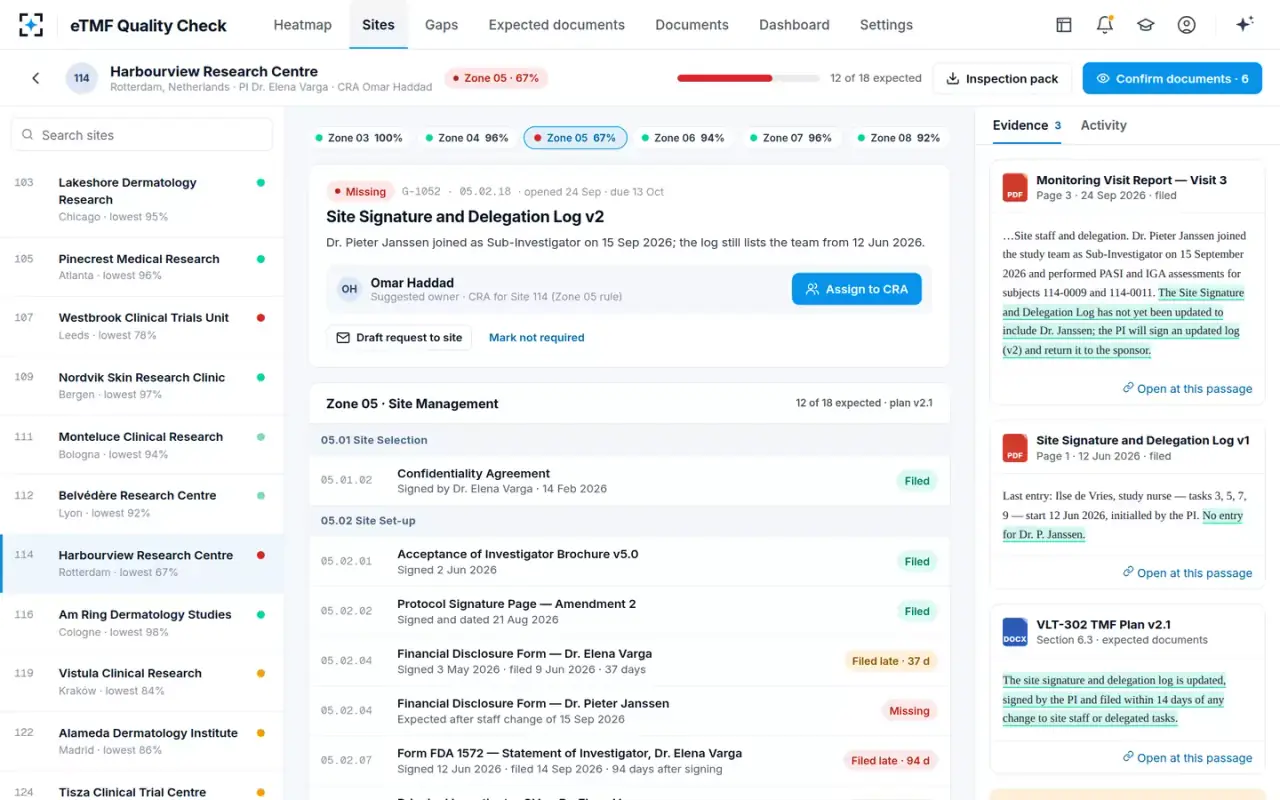

A staff change found inside a visit report
Completeness checkerNo spreadsheet knew that a new sub-investigator had joined. The checker found it on page 3 of the Visit 3 monitoring report. He had joined as Sub-Investigator and already rated psoriasis severity (the PASI and IGA scores) for two subjects. The checker compared this with delegation log v1, which has no entry for him. It also checked section 6.3 of the study's TMF plan v2.1. Then it opened a gap, with each passage one click away.
The Visit 3 report says the Site Signature and Delegation Log has not yet been updated to include him.

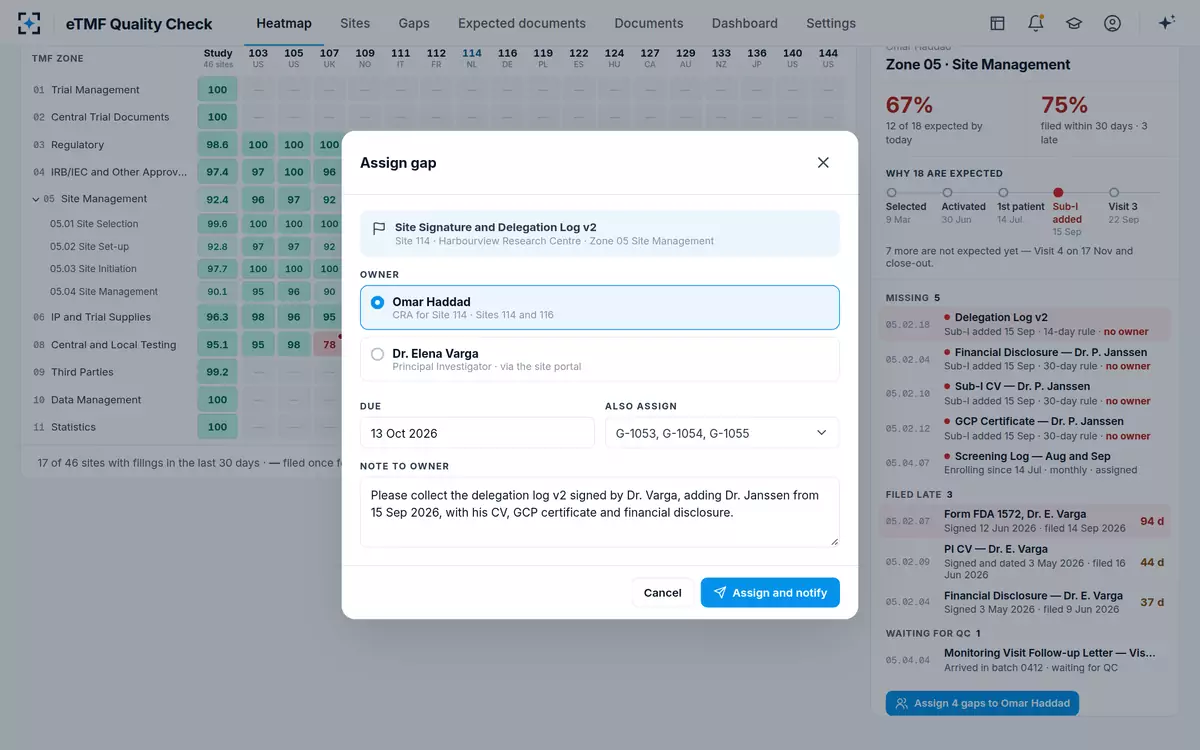

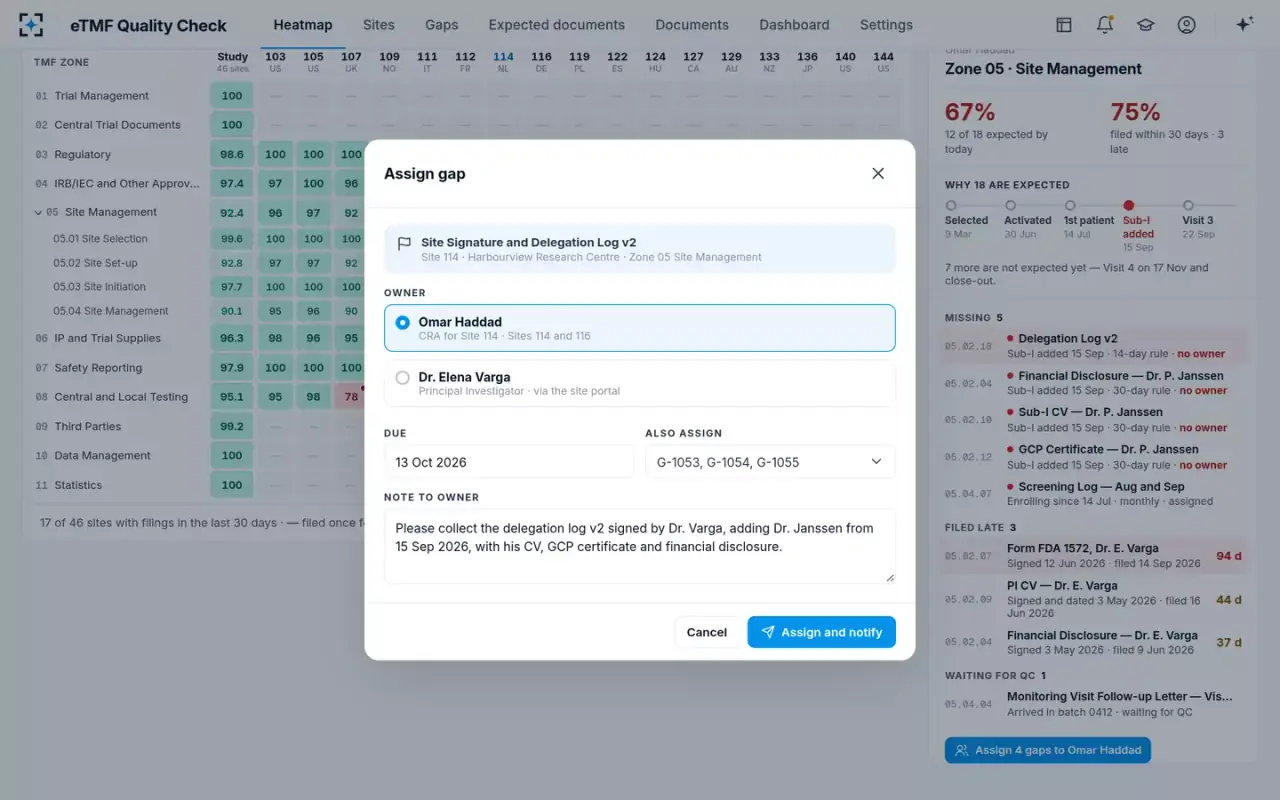

- 05One step
Four gaps go to the site's CRA
TMF lead and QC reviewerThe Zone 05 owner rule suggests the CRA who covers the site, the monitor who visits it. The TMF lead assigns delegation log v2 and the three gaps that go with it: the new sub-investigator's CV, GCP certificate and financial disclosure. Each has a due date and a note on what to collect. For the late 1572, the gap follow-up agent drafts a request to the investigator for a note to file.
“Nothing is sent until you press Send.”
- 06The register

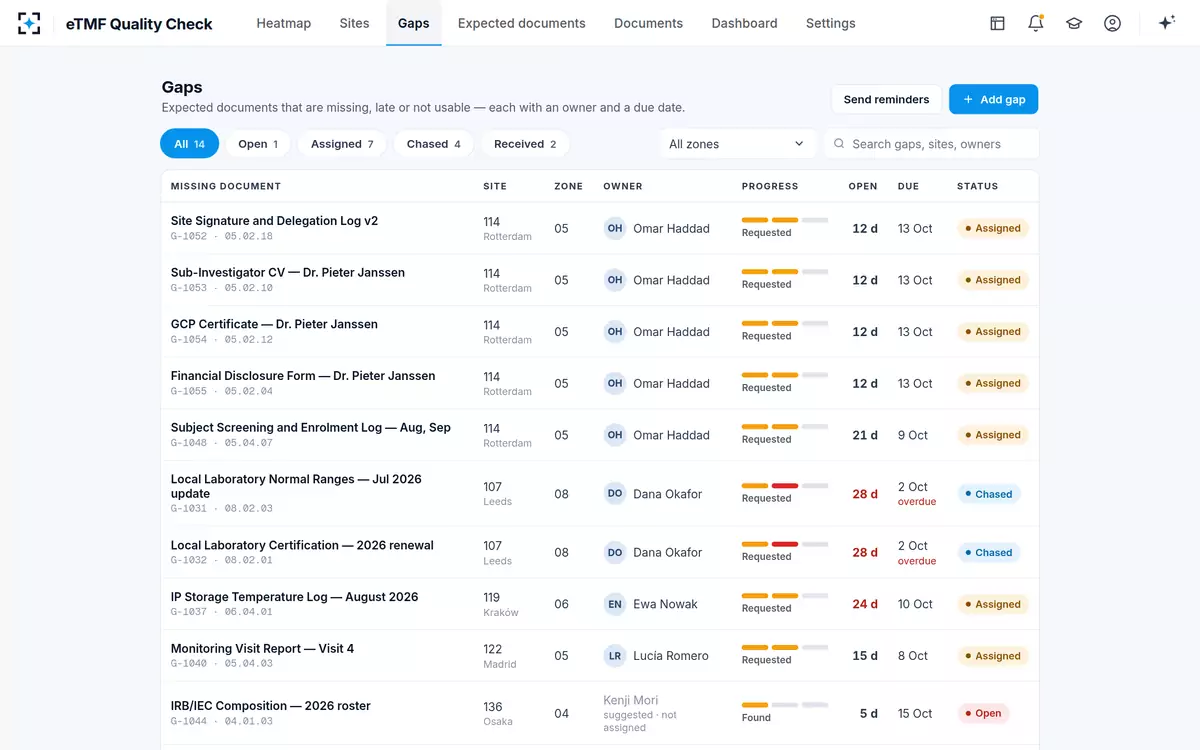

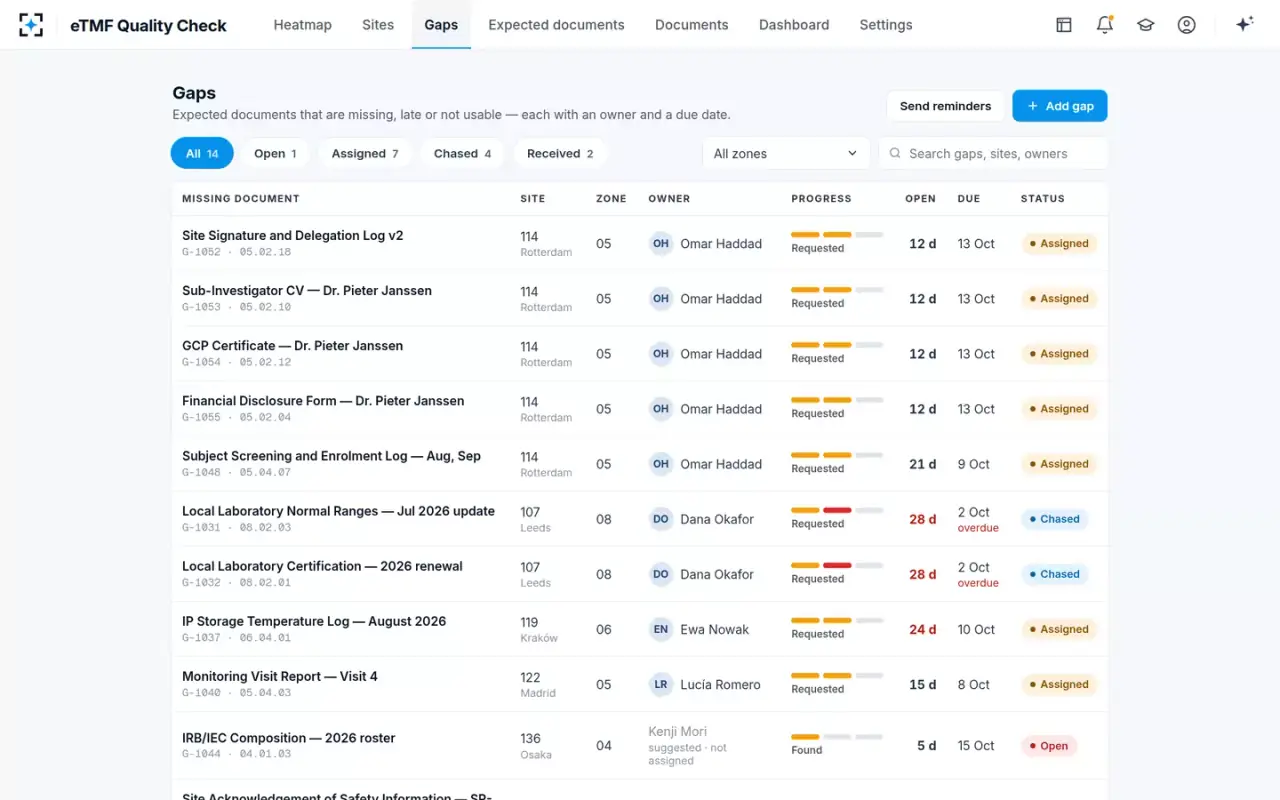

Each gap with an owner, a stage and a due date
CRAThe four gaps now sit with the CRA, marked assigned and requested. The register shows the 14 most urgent of the 37 open gaps. At another site, the local lab's normal ranges and lab certificate are 28 days open and overdue. A second CRA is chasing them. A third site is missing its monthly temperature log. A fourth has no return record for expired IP kits.
- 07Re-derived

Nine rules turn milestones into due dates

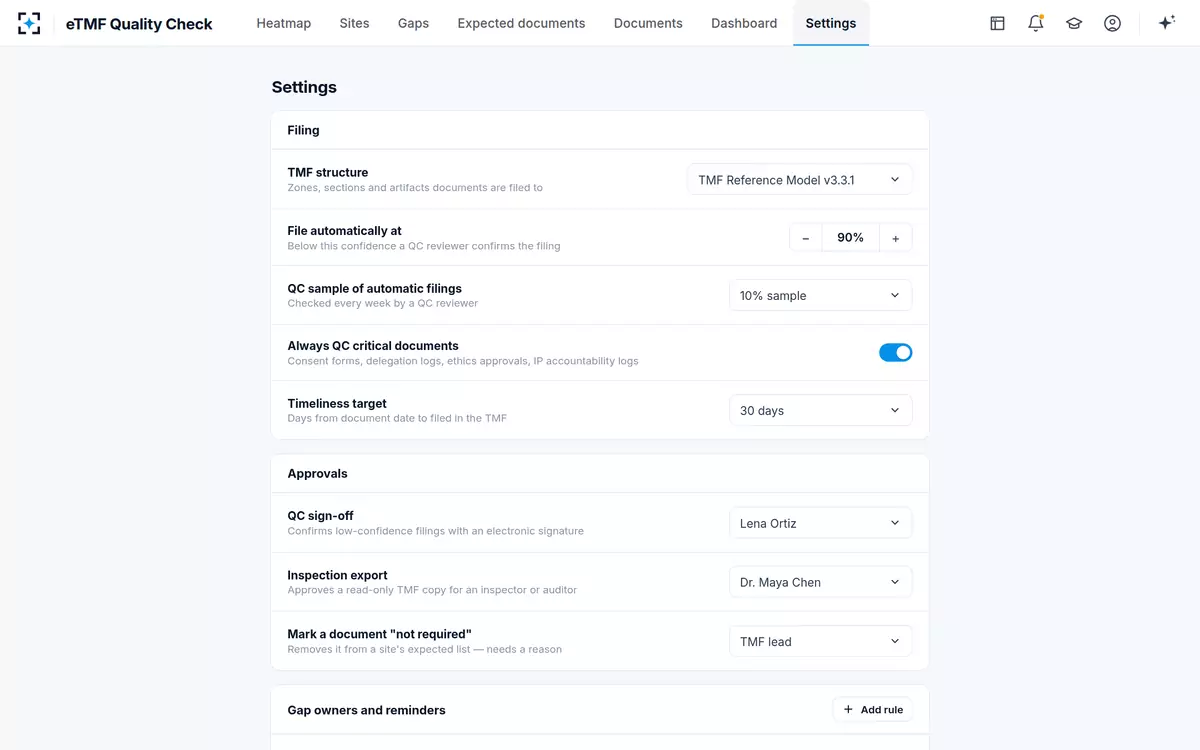

Completeness checkerThe list of expected documents is built from rules in the TMF plan and the TMF SOP. Each rule names an event and the documents due by then. The events include a site activated, a staff member added, a 1572 signed or an amendment approved. They also include IP kits expiring, a visit held, a month of enrollment closing, IP shipped or a site closed out. To rebuild the list for 46 sites, the checker reads the milestones and applies the 9 rules. Then it compares the result with what is filed.
“38,655 documents expected across 46 sites today · 1,214 more will become due at future milestones.”
- 08The morning batch

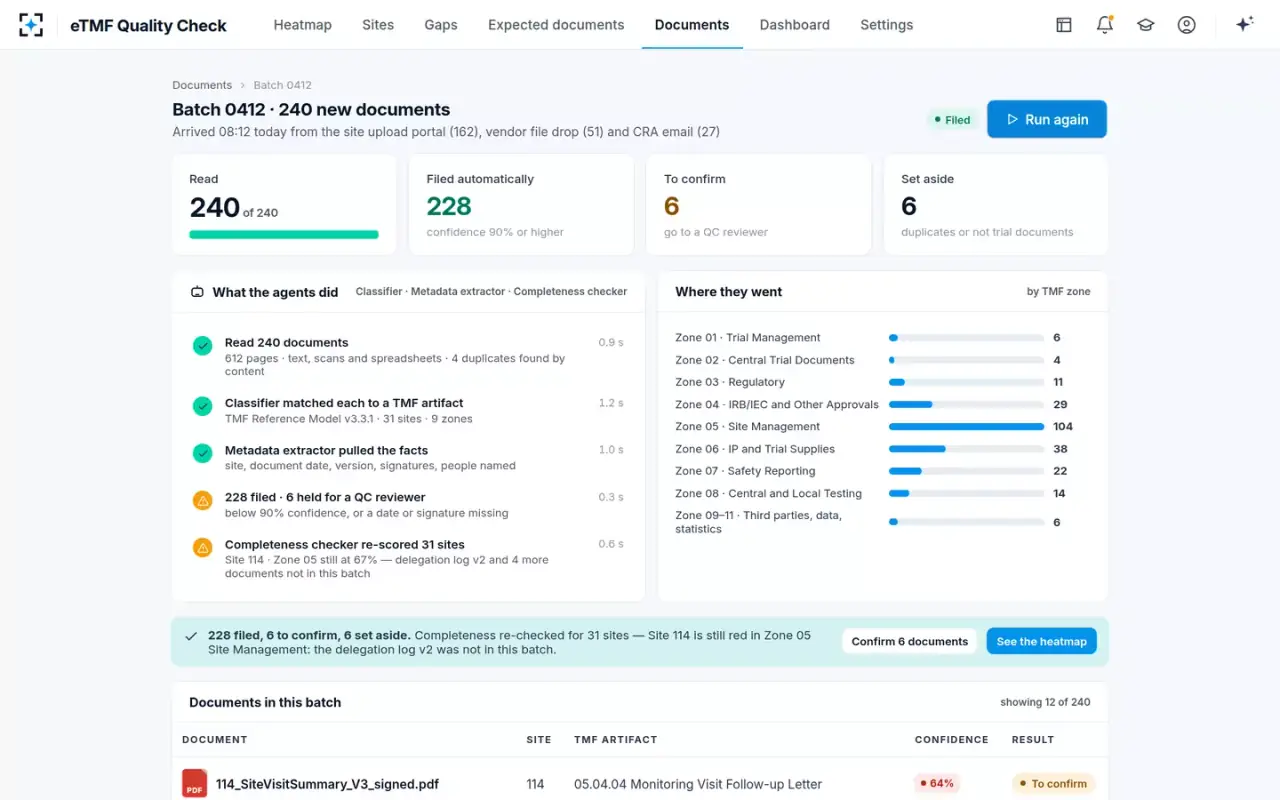

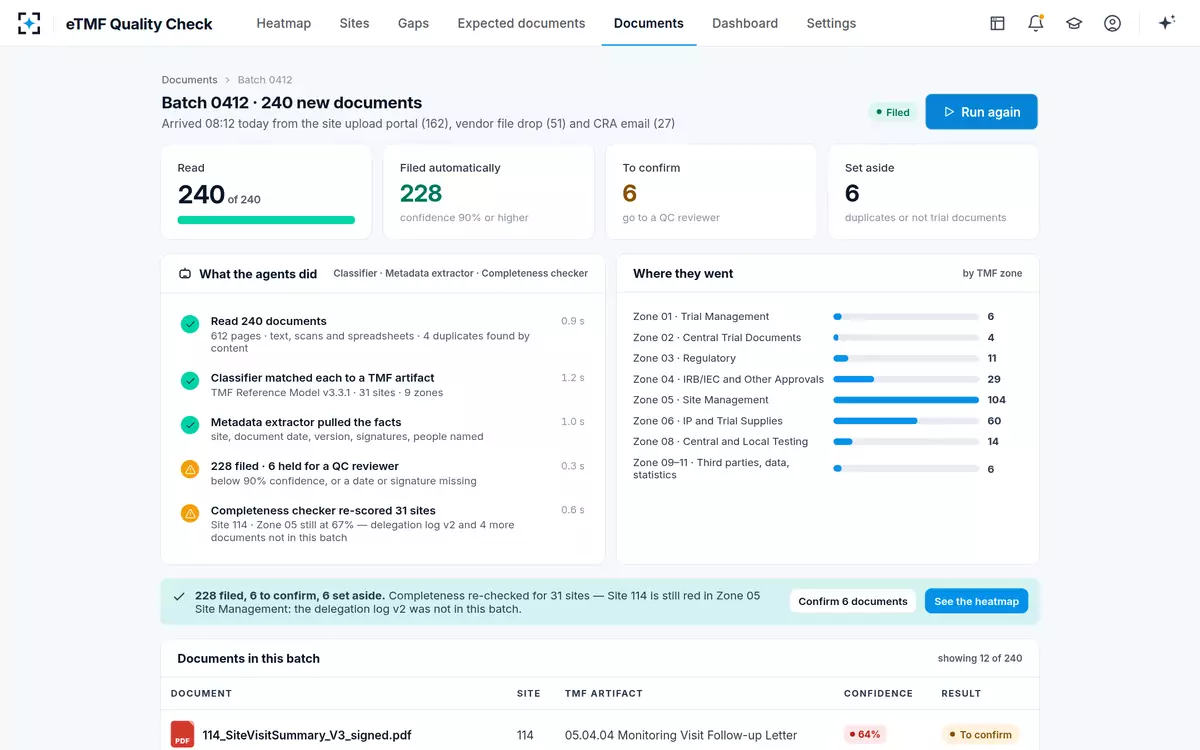

240 new documents, read and filed
Classifier and Metadata extractorThe batch held 612 pages. The site upload portal sent 162 documents, the vendor file drop 51 and CRA email 27. The classifier matched each document to its artifact, its exact slot in TMF Reference Model v3.3.1. The metadata extractor read the site, document date, version, signatures and people named. Of these, 228 were filed at 90% confidence or more. Six were held for a QC reviewer. Another 6 were set aside: 4 duplicates found by their content and 2 that are not trial documents.
The weakest site is still red in Zone 05 Site Management, because the delegation log v2 was not in this batch.
- 09To confirm

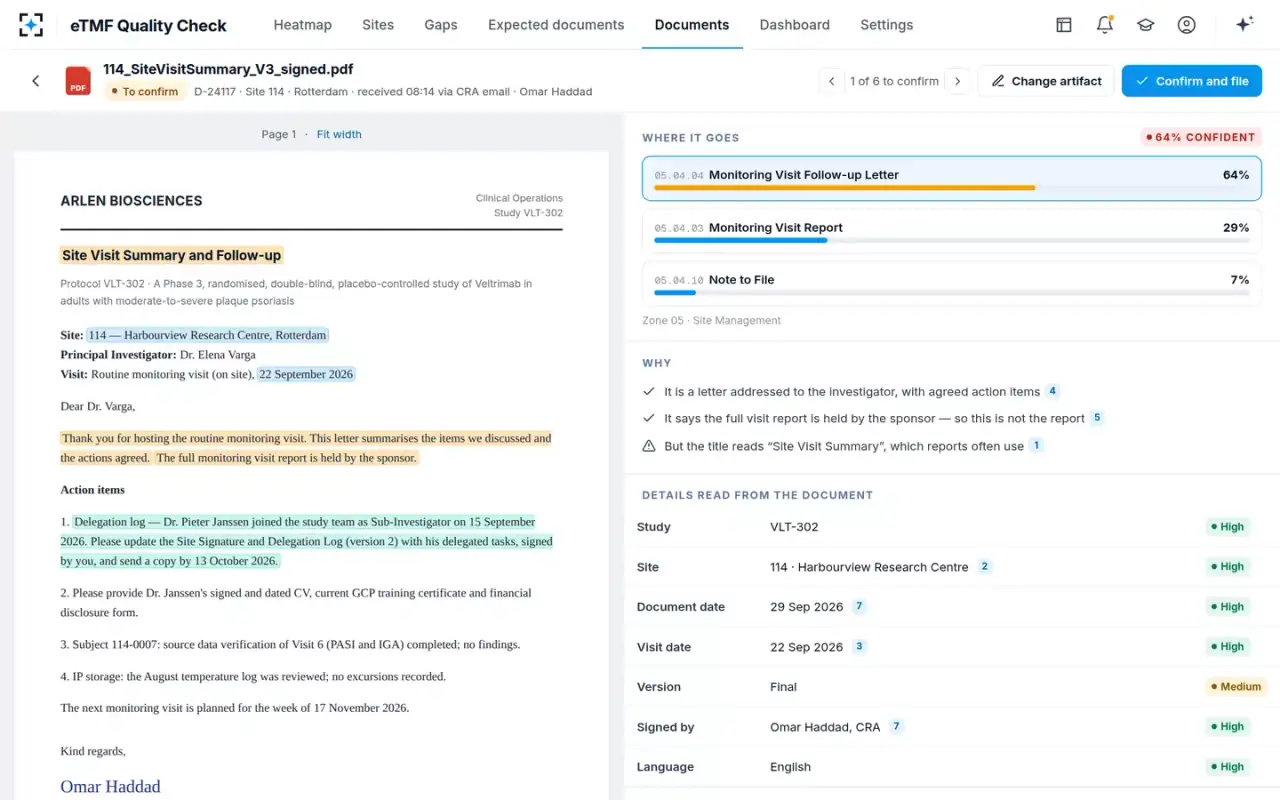

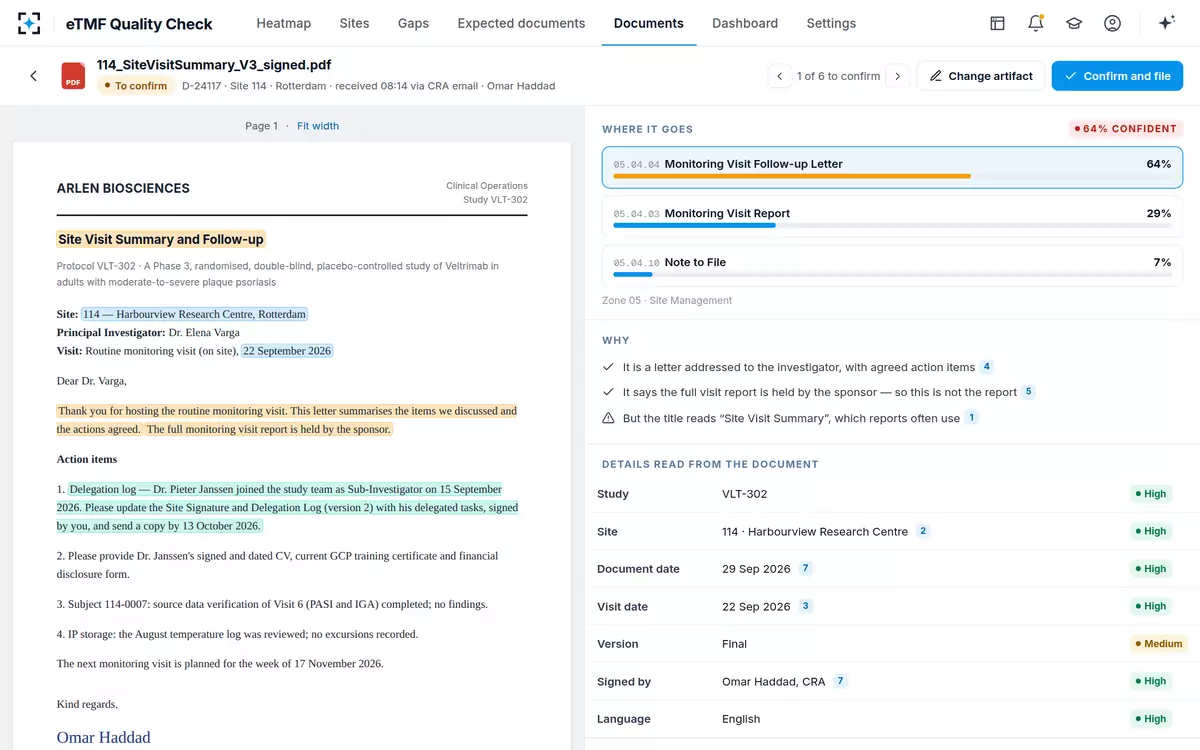

A letter that looks like a report, at 64% confidence
ClassifierThe Visit 3 follow-up letter arrived titled “Site Visit Summary”. Visit reports often use that title, so the classifier gave Monitoring Visit Report a 29% chance. But this is a letter to the PI, the site's lead investigator, listing agreed action items. It also says the sponsor holds the full visit report. So the classifier places it at 05.04.04 Monitoring Visit Follow-up Letter. It highlights the passages it relied on and holds the document for the TMF lead.

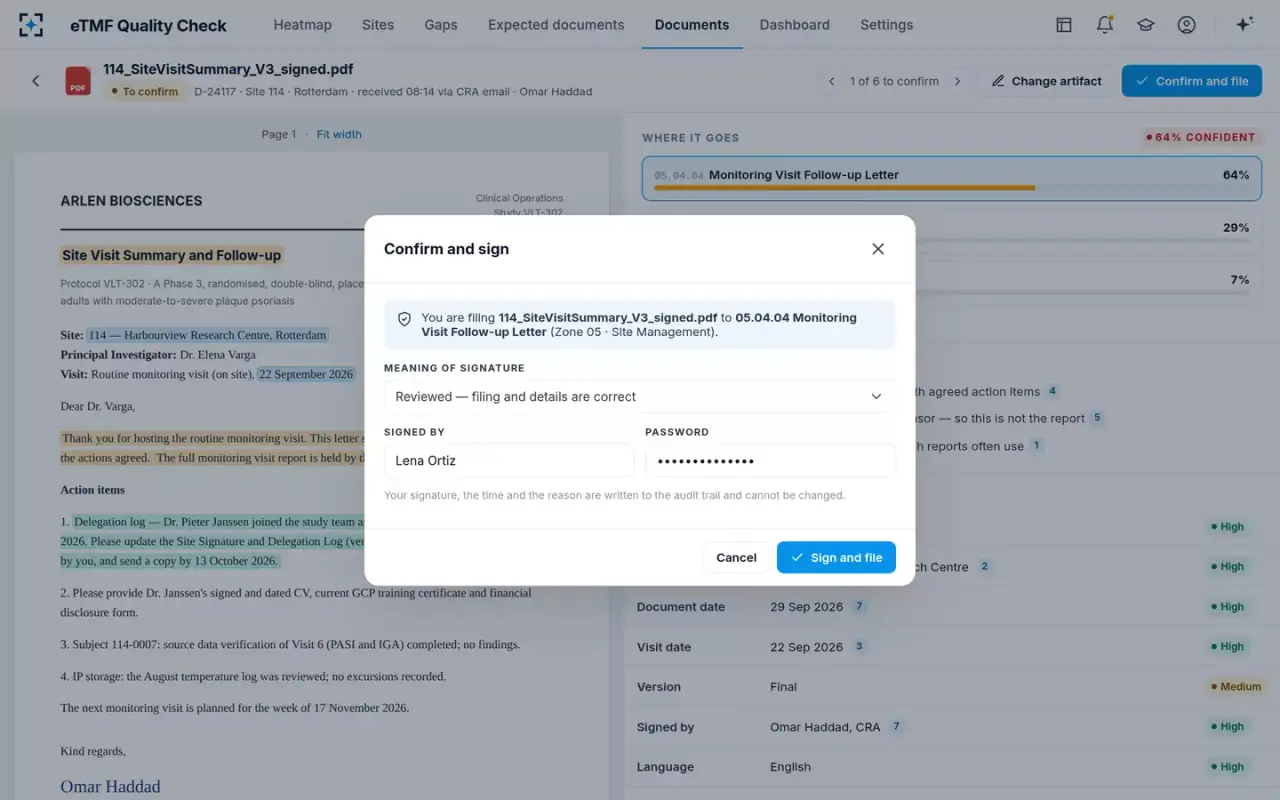

- 10Signed
The TMF lead confirms the filing with a signature
TMF lead and QC reviewerThe TMF lead files the letter at 05.04.04 and signs. The signature records what it means: “Reviewed, filing and details are correct”. The site's Zone 05 moves from 67% to 72%, or 13 of 18 expected documents. Delegation log v2 is still with the CRA. The cell stays red until it arrives and passes QC.
“Your signature, the time and the reason are written to the audit trail and cannot be changed.”
