Construction Draw Management

Construction draw management that proves every line before the bank pays

See one case, screen by screen ↓
Watch with transcript →

Built forLoan administratorsConstruction lendersDraw inspectorsTitle and escrow officers

The Problem Today

Before each draw is paid, administrators match the invoices, lien waivers and inspection by hand, while the contractor waits for cash.

5.5 days
lenders take to process one draw published
9.4 days
borrowers say they wait for one draw published

Proof matched by hand

  • Pay app
  • Invoices
  • Waivers
  • Inspection
  • Paid before the work is builtPaid on what was billed, before the inspector agrees
  • A missing or short waiverPaying without a valid one can cost the bank its lien priority

The Solution

  1. The whole package read at oncePay application, invoices, waivers and title, read as soon as the package is complete
  2. Each line tied to its proofEach G703 line matched to its invoice, its waivers and the inspector's report
  3. What was billed against what is builtA line billed ahead of the inspection is held until the work catches up
  4. The administrator signsThe amount to fund and each holdback. Above the limit, an officer also signs

Built-in controls

  • Waivers checked against the state's required form
  • Each holdback names the document that releases it
  • Each agent step and signature kept on the audit trail

What You Get

A complete package reaches a signed funding decision. Each line is proven, and money for work not yet built is held back.

  • Holdbacks instead of overpayingThe amount for each exception is held until its document arrives
  • Budget kept in balanceContingency and interest reserve checked on each draw
  • Stored materials checkedBill of sale and insurance naming the bank checked first
In short

What is Construction Draw Management?

It is software that takes a construction loan draw from the borrower's request to a paid advance. The pay application, invoices, lien waivers, inspection, budget and title date-down are all checked before money moves. Construction Draw Management adds six agents. They read the package, tie each G703 line to its proof and recommend an amount with each holdback. The loan administrator decides and signs.

How to choose AI solutions for lending →

Updated

The problem

Lenders prove each construction draw by hand, one document at a time

A construction loan pays out in stages as the building goes up. As the work goes on, the contractor asks for each next payment, called a draw. Before the bank pays, a loan administrator has to prove two things. The work billed must really be built, and the people who built it must have been paid. That proof is spread across many documents. There is the contractor's pay application, made up of the AIA G702 summary and its G703 line-by-line sheet. There is each subcontractor's invoice. There are lien waivers, a sub's written promise not to claim against the property once it is paid. Each draw needs a conditional waiver for this payment and an unconditional one for the last. Then come the inspector's percent complete for each line and the budget and change orders. Last is the title company's date-down, a search for new liens since the last draw. The administrator puts this proof together by hand, in spreadsheets and email, while the contractor and its subs wait for cash.

When time runs short, some lines go unchecked, and that is where the risk sits. A G703 may not add up to the G702. Framing may be billed ahead of what the inspector saw. A sub may be paid again before last month's payment is proven received. A waiver may be short of the payment, or not on the state's required form. In Texas, a waiver on the wrong form cannot be enforced. Paying a line before the work is built, or without a valid waiver, is how a lender loses money. It can also lose its lien priority, its place first in line on the property.

typical5.5dayslenders take to process a draw
typical9.4daysborrowers say they wait for a draw
typical5-7daysfor a draw reviewed by hand
Where a draw's business days goestimated
By hand5.5 days
With the solution1 day
  • Logging the package and chasing missing documents1 → 0.1 d
  • Matching G703 lines to the G702 and the invoices1 → 0.1 d
  • Checking lien waivers by party, amount and form1 → 0.1 d
  • Checking the inspection and stored materials1 → 0.2 d
  • Budget, in-balance test and title date-down0.8 → 0.1 d
  • Recommendation, signatures and the borrower notice0.8 → 0.4 d

Our estimate for a typical draw on a mid-size construction loan, by hand and with the solution.

How it works

The draw review path: package, line proof, holdbacks and signature

What comes in
Draw package inThe draw package · pay app, invoices, waivers, inspection, title
Agents at work
Pay application readerG702 / G703 tie-out
Then
Invoice and waiver matcher
Inspection reconciler
Title date-down checker
Then
Budget and balance checker
Then
Funding recommenderamount + holdbacks
A person decides
Loan administratordecides and signs
What comes out
Signed funding
Holdbacks with releases
Borrower notice
One case, step by step

Draw 14 on a mixed-use construction loan, with four exceptions and two signatures

A mixed-use project has 186 units above 14,200 sq ft of retail. Its contractor sends Draw 14, asking for $4,384,970. Here is what happens next in the working solution, screen by screen.

A worked example on sample data. Names, IDs and figures on the screens and in this section come from the demo.

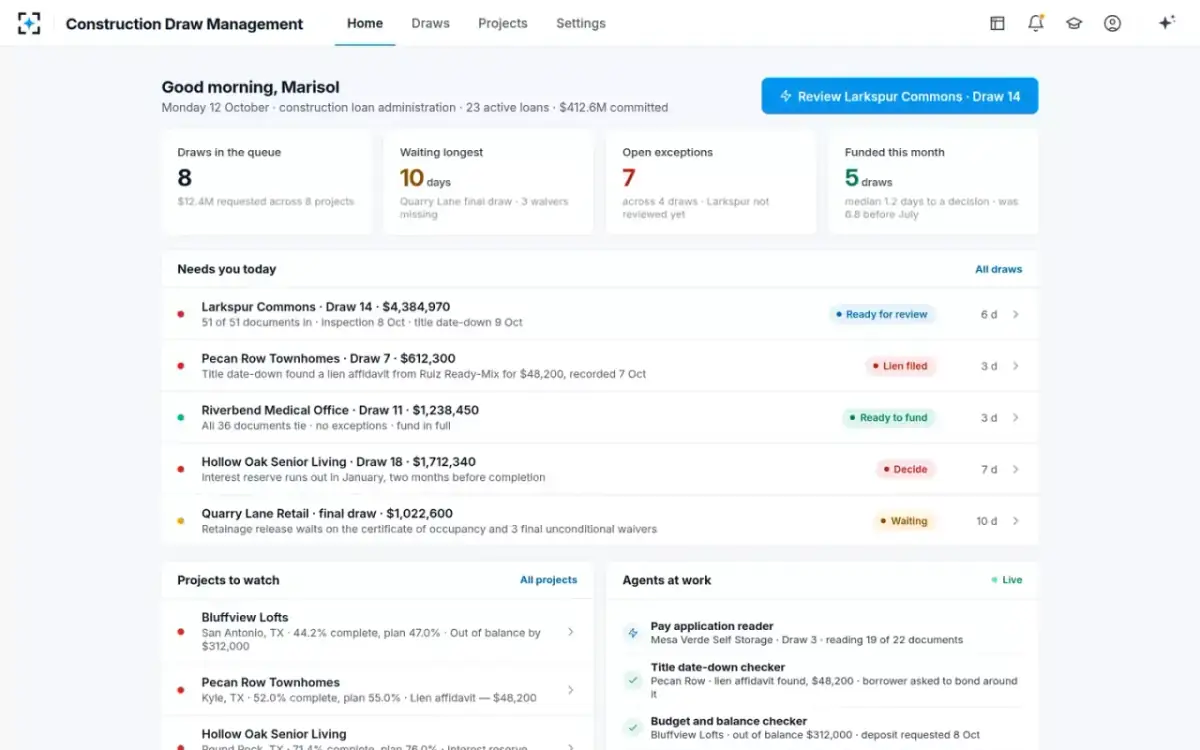

  1. 01Start of the week

    Everything waiting for the administrator, on one screen

    Construction loan administrator

    The administrator runs 23 active construction loans, with $412.6M committed. The home screen shows 8 draws in the queue, worth $12.4M. The oldest has waited 10 days on 3 missing waivers. There are also 7 open exceptions, problems that hold up payment. The agents found two of them on other projects. One is a lien affidavit, and the other is a loan out of balance.

    Agents at work: the title date-down checker found a $48,200 lien affidavit, and the borrower was asked to bond around it.

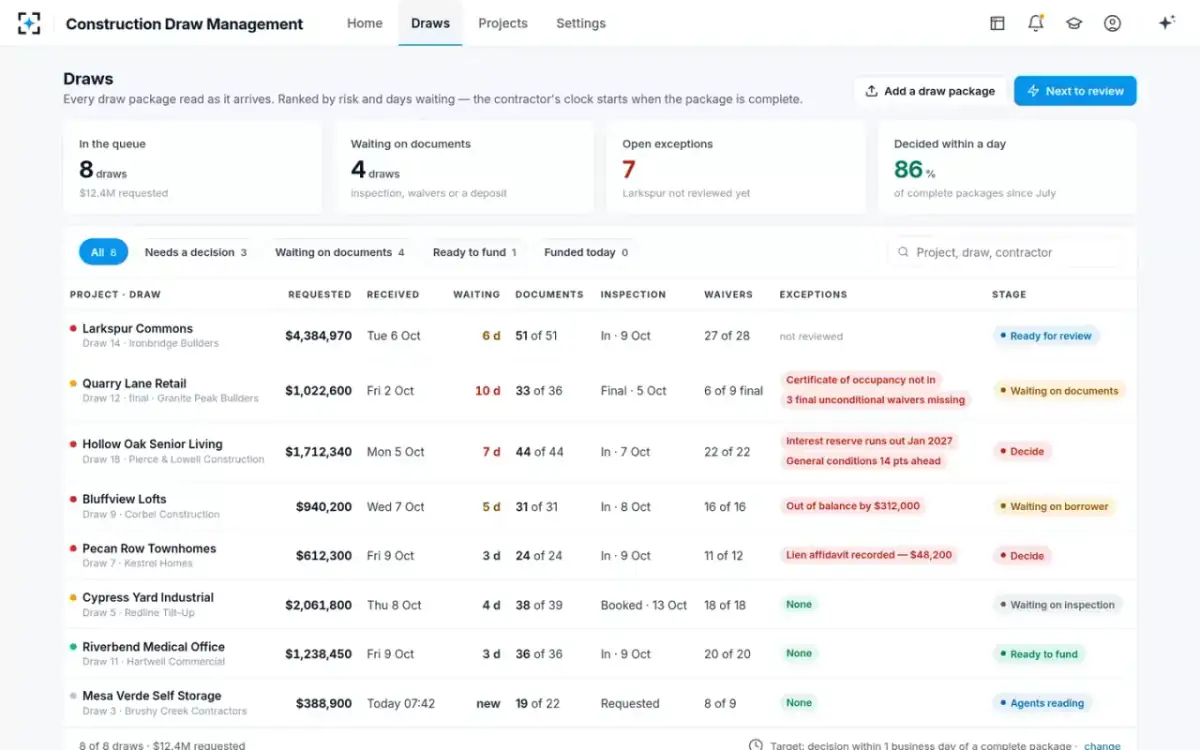

  2. 02The queue

    Draws ranked by risk and days waiting

    Construction loan administrator

    Each draw shows the amount asked for, when it arrived and its stage. It also shows its documents, inspection, waivers and exceptions. Draw 14 has 51 of 51 documents in and 27 of 28 waivers, so it is ready for review.

    The contractor's clock starts when the package is complete.

  3. 03One click

    After Start review, six agents read the 51 documents

    The agents

    First, the pay application reader checks the G702 and G703. It finds 20 lines and a contract sum to date of $50,048,900. The G703 ties to G702 line 4. Retainage, the share of each payment kept back until the job is done, is 10%. Then the invoice and waiver matcher ties 13 invoices and 27 waivers. The inspection reconciler compares the inspector's report with what was billed. Next, the budget and balance checker runs the in-balance tests. Last, the title date-down checker reads the title search since the last draw.

    Each step is shown as it runs, with what it found.

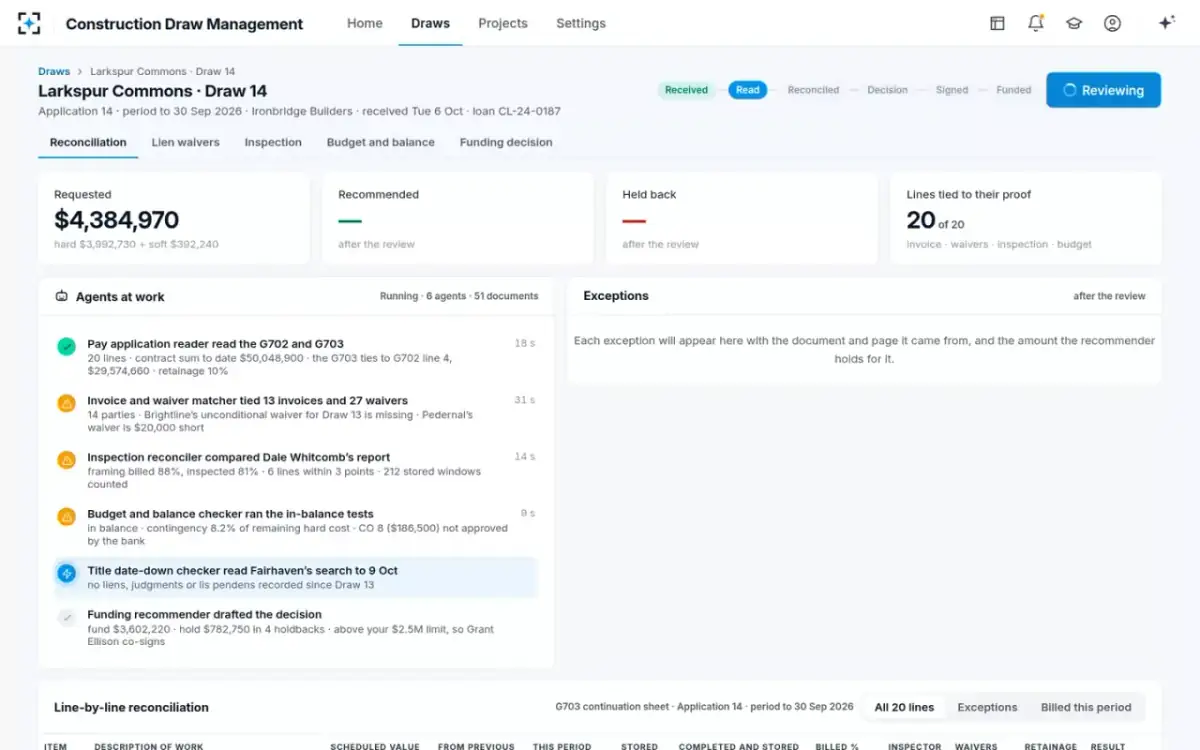

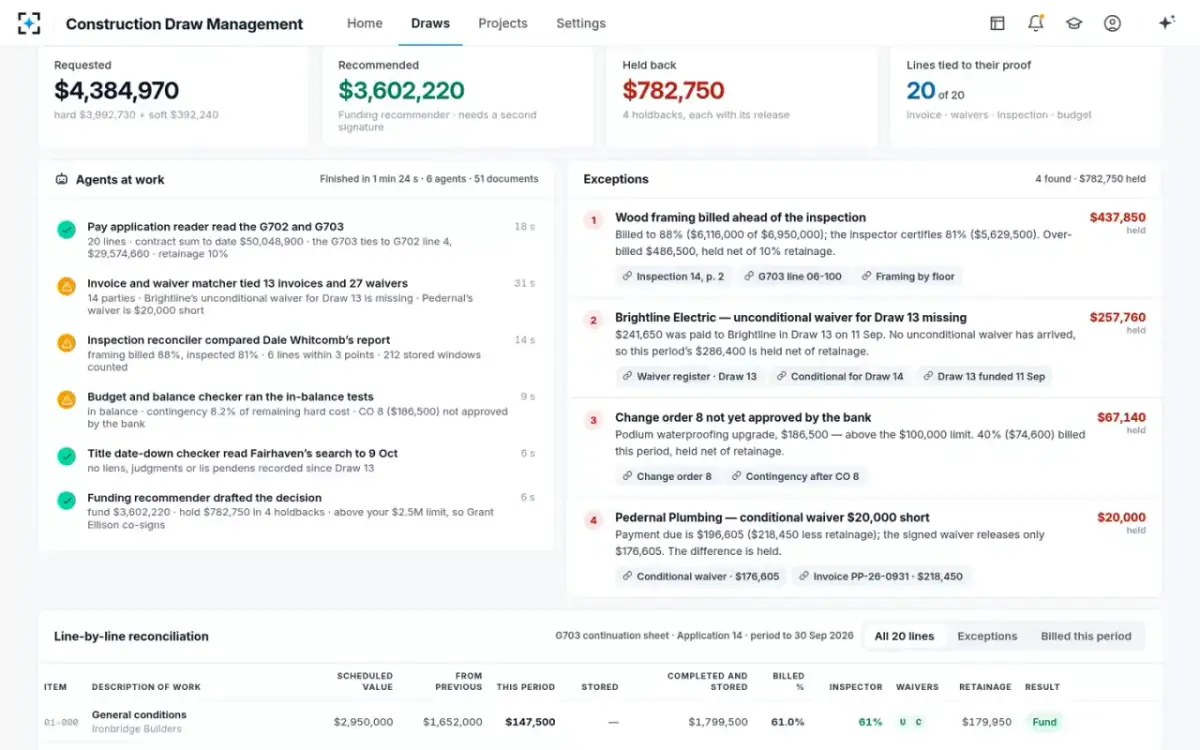

  4. 041 min 24 s later

    Four exceptions, each with its proof

    Funding recommender

    All 20 lines are tied to their proof. There are four exceptions, with $782,750 held. Framing is billed ahead of the inspection. The electrical sub's unconditional waiver for Draw 13 is missing. Change order 8 is not yet approved by the bank. The plumbing sub's conditional waiver is $20,000 short. Each exception links to the page it came from. The recommended amount is $3,602,220.

    Recommended $3,602,220 by the funding recommender. Needs a second signature.

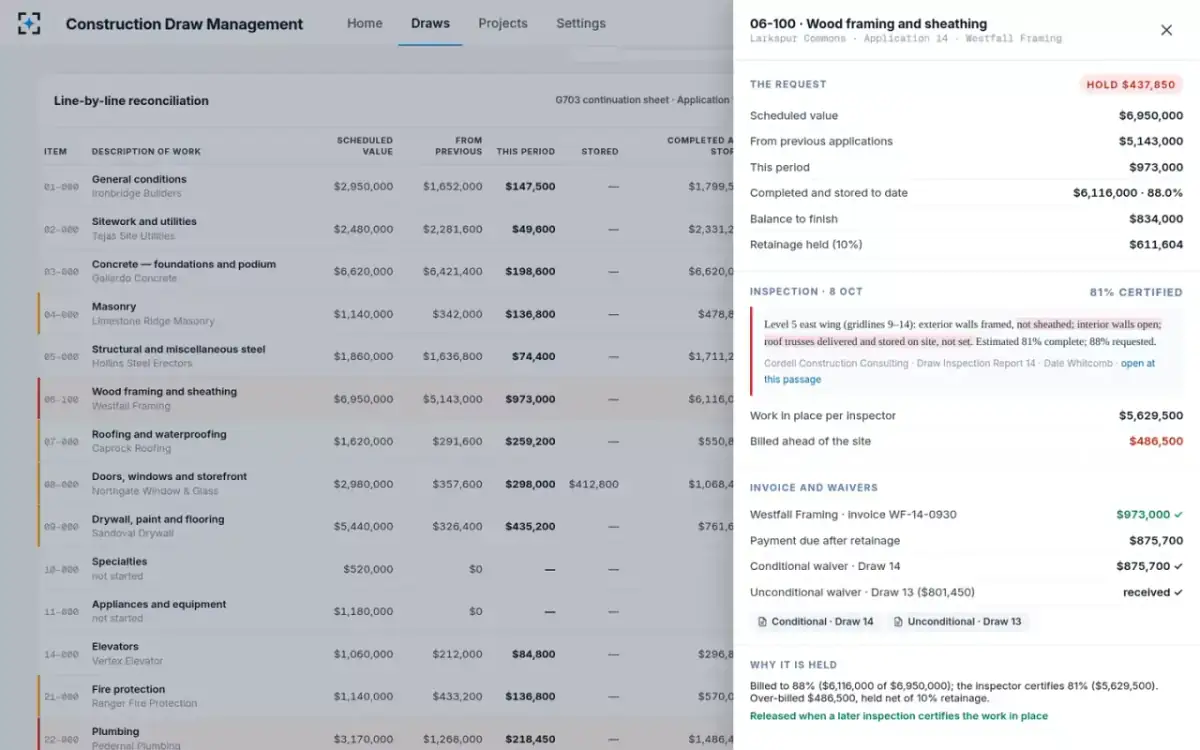

  5. 05The framing line

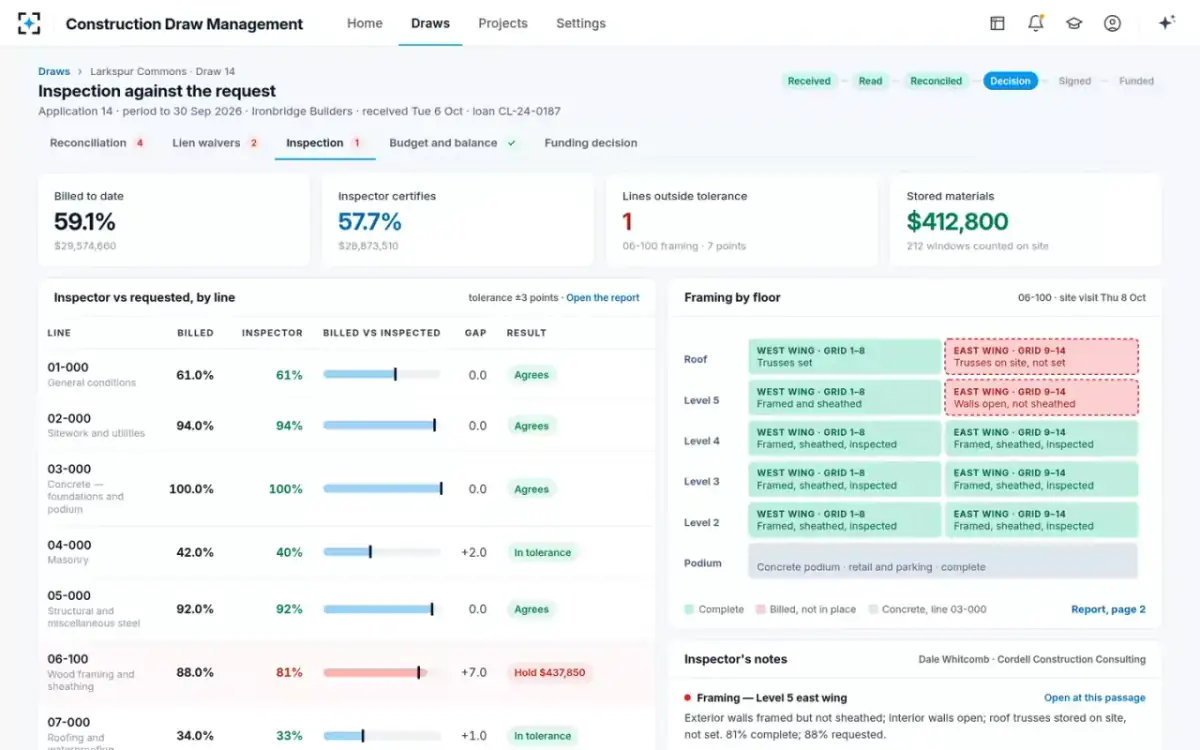

    Framing billed at 88% and inspected at 81%, so the gap is held

    Inspection reconciler

    The G703 bills the framing sub's wood framing line to 88%, or $6,116,000 of $6,950,000. The inspector certifies 81%. On Level 5, the east wing walls are framed but not sheathed. The roof trusses are on site but not set. So the $486,500 billed ahead of the work is held, or $437,850 after retainage. It stays held until a later inspection certifies it. The other lines are within the 3-point tolerance, and the 212 stored windows are counted on site.

    The inspection reconciler never changes a percentage the inspector certified.

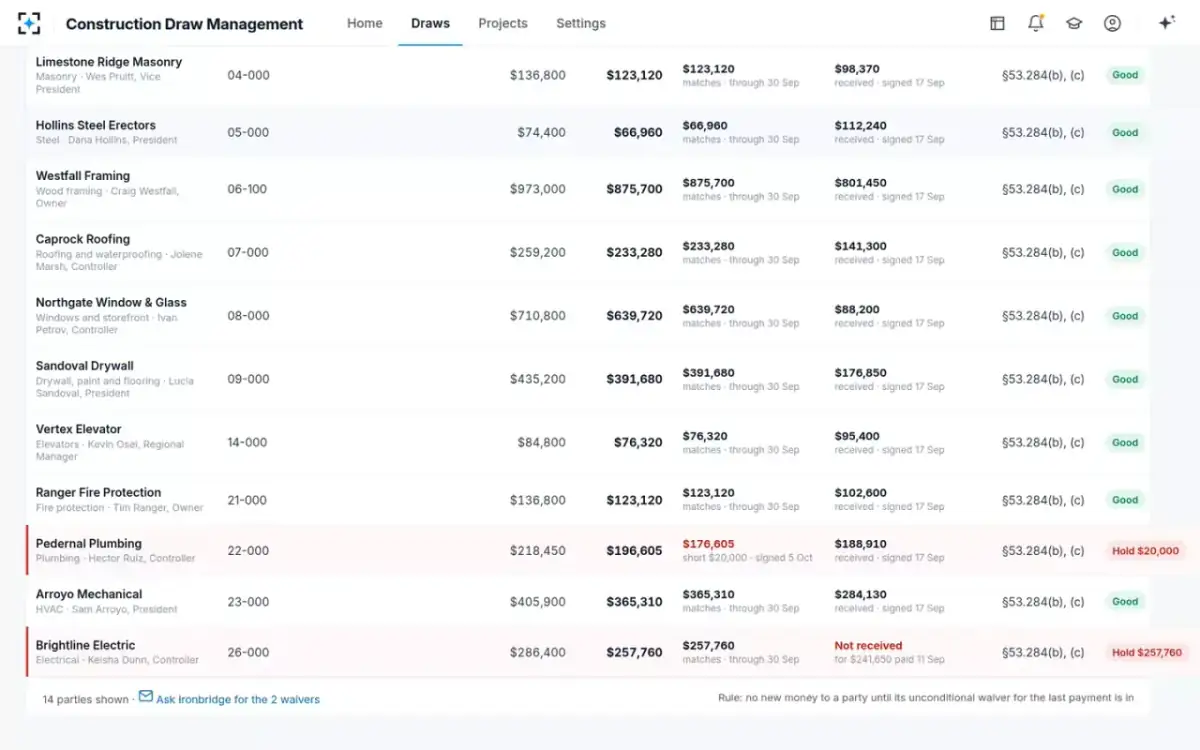

  6. 06Waivers

    A missing waiver and a short one

    Invoice and waiver matcher

    Each waiver is read for its type, amount, through date and signer, and whether it is on the Texas statutory form. The electrical sub's unconditional waiver for the $241,650 paid in Draw 13 has not arrived. So the $257,760 due to it this period, after retainage, is held. The plumbing sub's conditional waiver releases $176,605, but $196,605 is due, so $20,000 is held. One click asks the contractor for both.

    Rule: no new money to a party until its unconditional waiver for the last payment is in.

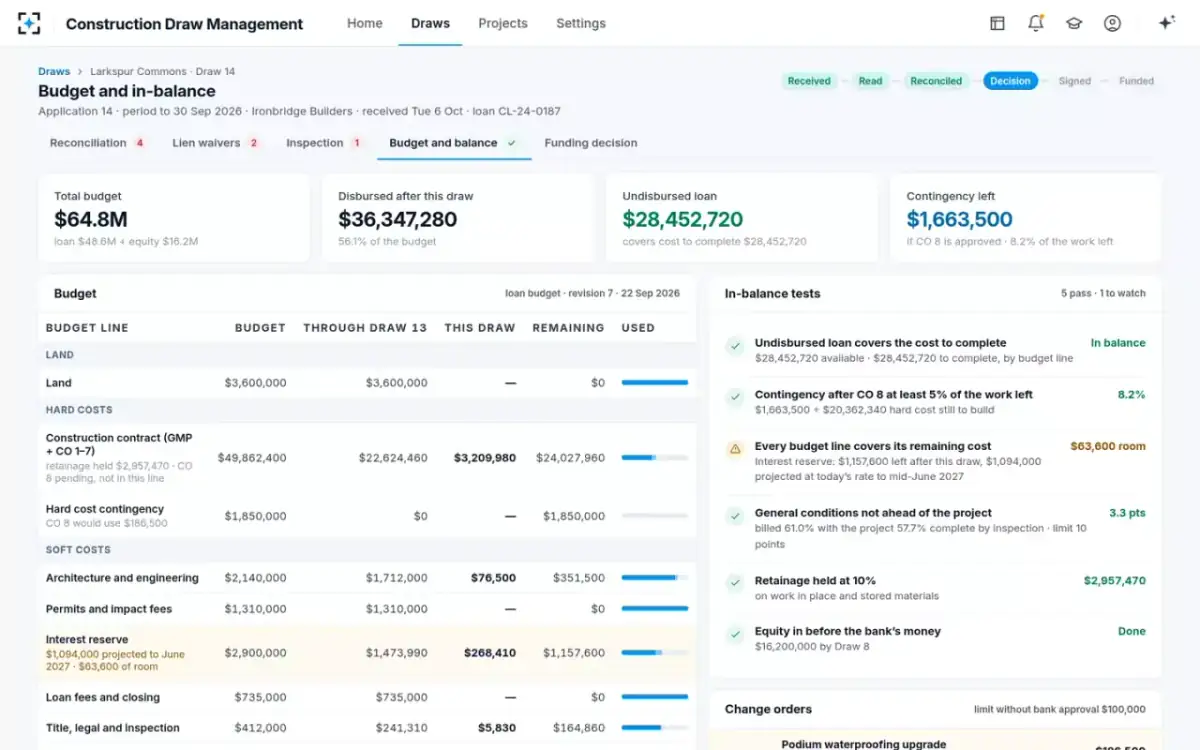

  7. 07Budget

    Still in balance, with the interest reserve to watch

    Budget and balance checker

    After this draw, the loan money not yet paid out is $28,452,720. It still covers the cost to finish. Contingency, the budget kept for surprises, would be $1,663,500 after change order 8. That is 8.2% of the work left, above the 5% minimum. General conditions, the contractor's site overhead, are 3.3 points ahead of the project. That is inside the 10-point limit. One thing to watch is the interest reserve, the money set aside to pay interest during building. It has $1,157,600 left against $1,094,000 of projected interest.

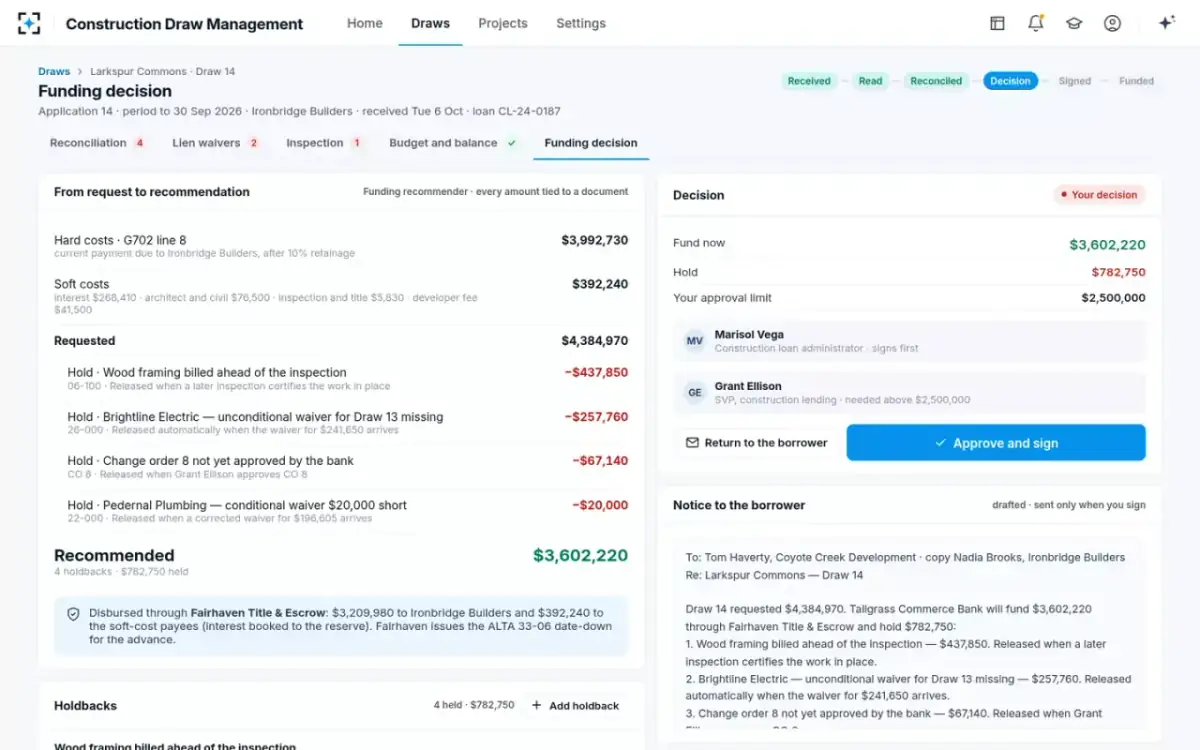

  8. 08The recommendation

    From the request to the amount to fund

    Funding recommender

    The $4,384,970 request is $3,992,730 of hard costs after retainage plus $392,240 of soft costs. Four holds come off, each with the document that releases it. That leaves $3,602,220 to fund through the title and escrow company, which issues the ALTA 33-06 date-down for the advance. The borrower notice goes out only once the administrator signs.

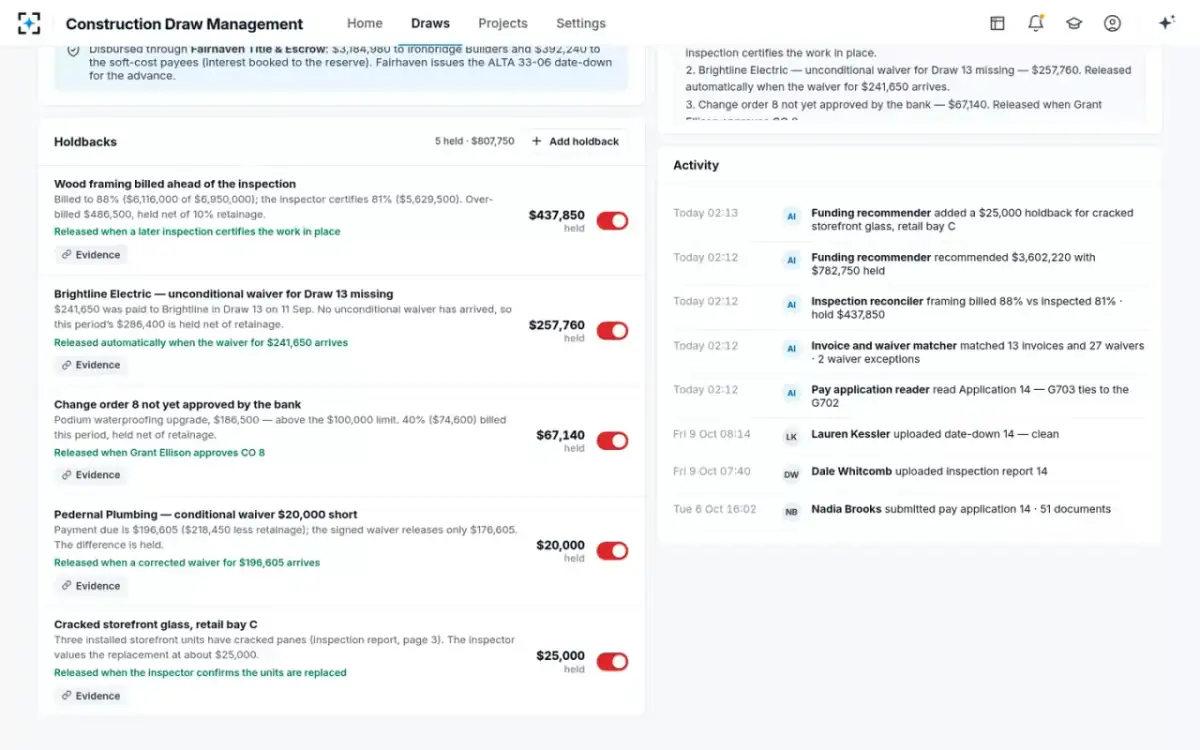

  9. 09One more hold

    A $25,000 hold, asked for in plain words

    Construction loan administrator

    The inspector's report also notes three storefront units in retail bay C with cracked panes. They will cost about $25,000 to replace. The administrator asks the assistant to hold that amount. A fifth holdback appears, released when the inspector confirms the units are replaced. The draw now funds $3,577,220 and holds $807,750.

    Activity: the funding recommender added a $25,000 holdback for cracked storefront glass in retail bay C.

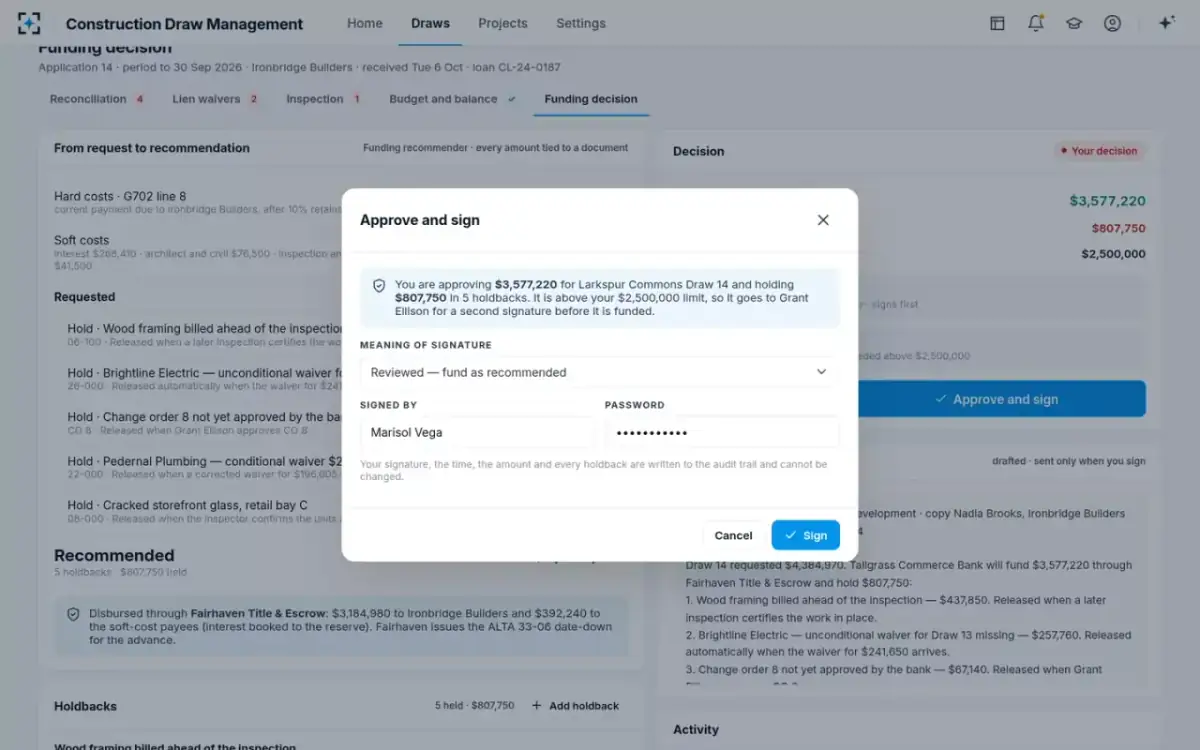

  10. 10Signed, funded in a day

    Above the administrator's limit, the officer also signs

    Administrator and lending officer

    The administrator approves, and the meaning of the signature is recorded as “Reviewed, fund as recommended”. Because the draw is above the $2,500,000 limit, it goes to the senior construction lending officer for a second signature. Then $3,577,220 goes to the title company to pay out, one business day after the package was complete.

    The signature, the time, the amount and each holdback are written to the audit trail and cannot be changed.

Who it’s for

Four roles that review, inspect and sign a construction draw

The same draw, seen by the four people who handle it. First their month by hand, then with the solution.

Construction loan administrator
Signs draws to $2.5M
Before
Gathers the proof for each draw by hand, in spreadsheets and email, while the contractor calls for cash.
Now
Opens a draw already checked line by line, with four exceptions and their sources, and spends the time on the decision.
Construction lending officer
Second signature to $10M
Before
Co-signs each draw above $2.5 million, and wants to see what was held and why on one page.
Now
Sees each holdback with its reason and release on one screen, then adds the second signature.
Draw inspector
Certifies percent complete
Before
Counts what is built on site. Then someone checks the report against the G703 by hand.
Now
Each line is funded on the inspector's certified percentage. The inspector's notes become holdbacks.

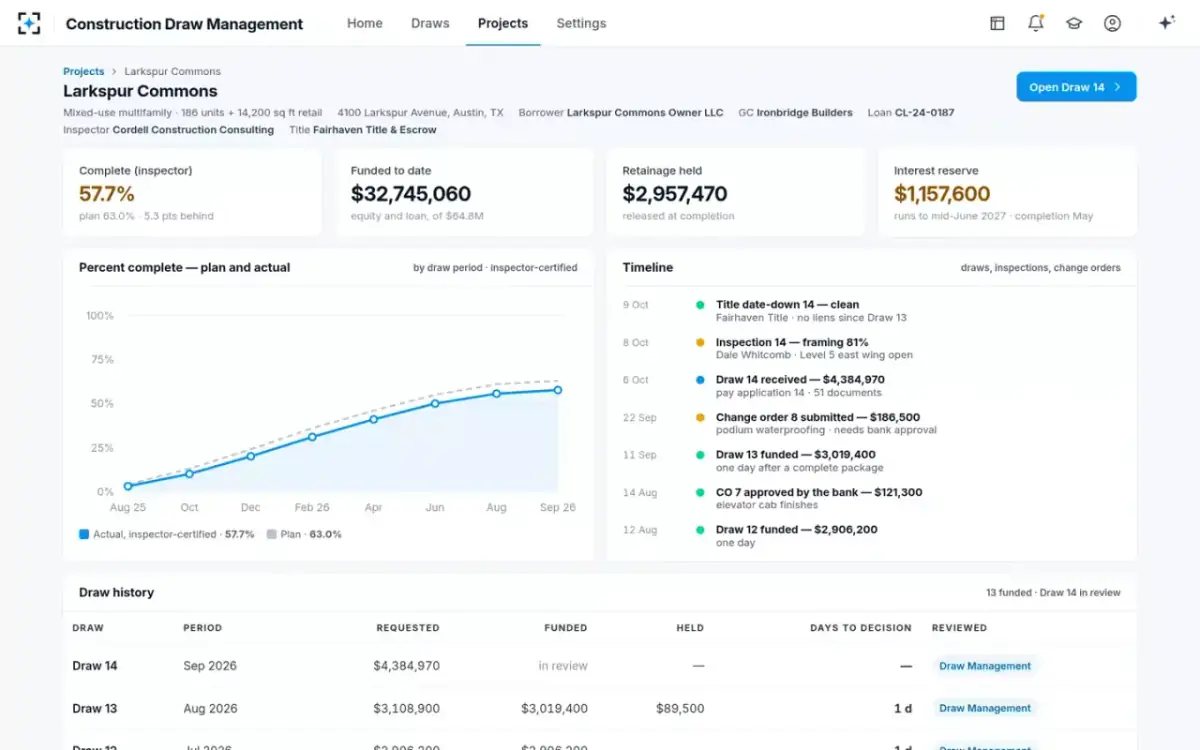

Construction loan administration manager
Sets the rules
Before
Answers for how long draws take, and for any line paid ahead of what the inspector saw.
Now
Sets tolerances, limits and waiver rules once, and sees each project's progress, draws and holds against plan.
The agents

Pay application, waiver and inspection agents in construction draw management

Before money moves, each G703 line is tied to its invoice, waivers and inspection. The loan administrator decides and signs.

Pay application reader

Reads the AIA G702 and G703, or the lender's own form, and recomputes each column. Checks that the line sheet ties to the summary, that billed change orders are approved and that retainage matches the loan agreement.

  • Never alters a submitted figure. It reports the difference
  • Cites page and cell for each value
Invoice and waiver matcher

Ties each subcontractor invoice to its G703 line. Reads each waiver's type, amount, through date, signer and statutory form. Checks both the conditional waiver for this payment and the unconditional one for the last.

  • Never accepts a waiver that is not on the statutory form
  • A missing unconditional for the last payment always holds new money
Inspection reconciler

Compares the inspector's percent complete and stored-materials count with what is billed, line by line. A line beyond the tolerance is held at the difference, after retainage.

  • Never changes a percentage the inspector certified
  • The tolerance comes from Settings
Budget and balance checker

Tests the budget lines, change orders, contingency and interest reserve after the draw. Checks that the loan is still in balance.

  • Never moves money between budget lines
  • Out of balance stops the recommendation
Title date-down checker

Reads the title company's date-down for liens, judgments and notices recorded since the last draw.

  • Never recommends funding past a recorded lien
Funding recommender

Turns the findings into a recommended amount. Sets a holdback for each exception, naming the document that releases it. Sends draws above the administrator's limit to a second signer, and drafts the borrower notice.

  • Never approves or moves money
  • Each holdback names its release
Loan administrator

Decides and signs, and an officer co-signs above the limit.

Ask in plain words

Ask the assistant about a draw, a G703 line or a lien waiver

Ask about a draw, a line, a waiver or a test, or say what to hold. Each answer points to its source. These answers use the sample data.

Why is the framing line held back?

The contractor billed wood framing to 88%, or $6,116,000 of $6,950,000, with $973,000 this period. The inspection certifies 81%. On Level 5 the east wing walls are framed but not sheathed, and the roof trusses are not yet set. So the $486,500 billed ahead of the work is held, or $437,850 after retainage. It stays held until a later inspection certifies it.

Which subcontractors are missing lien waivers?

Two of the 14 parties have money held. The electrical sub's unconditional waiver for the $241,650 paid in Draw 13 has not arrived, so $257,760 is held. The plumbing sub's conditional waiver for Draw 14 reads $176,605, but $196,605 is due, so $20,000 is held. The other 26 waivers are on the Texas statutory forms and match.

Is the project still in balance after this draw?

Yes. After funding, the loan money not yet paid out covers the cost to finish. Approving change order 8 leaves contingency at $1,663,500. That is 8.2% of the $20,362,340 still to build, above the 5% minimum. The one thing to watch is the interest reserve. It has $1,157,600 left against $1,094,000 of projected interest.

Hold $25,000 for the cracked storefront glass in retail bay C

Added. The inspector found three storefront units in retail bay C with cracked panes, about $25,000 to replace. The recommendation is now $3,577,220, with $807,750 held across 5 holdbacks. This one is released when the inspector confirms the units are replaced.

The screens

Draw queue, line evidence, waivers and the signing screen

From the working solution, on its sample data. Pick one to see it large.

HomeDraws in the queue, the oldest waiting, open exceptions, projects to watch and what the agents are doing.
The draw queueDraws ranked by risk and days waiting, with documents, inspection, waivers, exceptions and stage.
Agents at workEach agent's step as it runs: the pay application checked, invoices and waivers matched, the inspection compared.
Exceptions and the recommendationFour exceptions with their amounts and sources, the recommended amount and what is held back.
One line, all its proofThe G703 line, the inspector's passage, the invoice and both waivers, and why the line is held.
Inspection against the requestInspected and billed percent for each line, framing floor by floor, stored materials and the inspector's notes.
Lien waivers by partyWaivers by party, amount against payment due, statutory form, and the two that hold money.
Budget and in-balanceBudget lines through this draw, the in-balance tests, contingency and how long the interest reserve will last.
The funding decisionFrom the request to the amount to fund, each hold with its release and the drafted borrower notice.
Holdbacks and activityEach holdback with its evidence and release, and each agent step and upload on the activity trail.
Approve and signThe meaning of the signature, the signer, and the second signature above the administrator's limit.
The project dashboardCertified percent complete against plan, funded to date, retainage, interest reserve and the draw history.
Draw rulesTolerances, retainage, contingency, waiver forms, stored materials, change-order and approval limits, all as settings.
Governance

Holdbacks, signatures and the audit trail in construction draw management

Each exception cites its sourceEach exception links to the page it came from, such as the inspection report, a G703 line, a waiver or a change order. It also shows the amount held for it.
The administrator decides and signsThe agents recommend. The construction loan administrator decides and signs, and records what the signature means. Above $2,500,000, a construction lending officer also signs.
Each holdback names its releaseA holdback is released by the document that clears it, such as a waiver, a later inspection or a change-order approval. Otherwise it needs a reason and a second person.
Waivers checked against the state formWaivers are checked against the state's statutory form. No party gets new money until its unconditional waiver for the last payment is in.
Certified numbers stay certifiedThe agents do not change the contractor's submitted figures or the inspector's certified percentages. They do not move money between budget lines or fund past a recorded lien.
Each step on the audit trailEach agent step, upload, holdback and signature is recorded with who, what and when. A signed decision cannot be changed, and changes to the rules are versioned.
Configuration

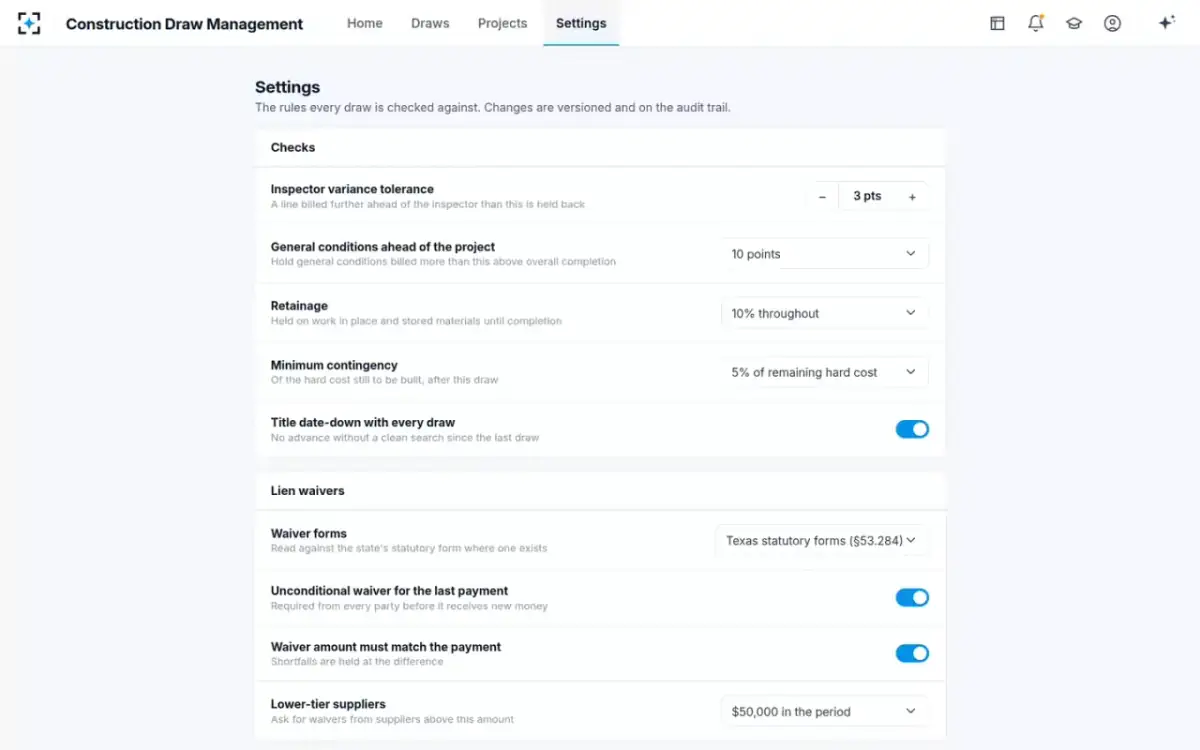

Inspector tolerance, retainage, waiver forms and signing limits for each draw

The rules each draw is checked against are settings, versioned and on the audit trail.

SettingDefaultChoose from
Inspector variance tolerance3 pointsStep up or down, one point at a time
General conditions ahead of the project10 points5 · 10 · 15 points
Retainage10% throughout10% throughout · 10% to 50% complete, then 5% · 5% throughout
Minimum contingency5% of remaining hard cost3% · 5% · 7.5% of remaining hard cost
Waiver formsTexas statutory forms (§53.284)Texas (§53.284) · California (§§8132 to 8138) · Arizona (§33-1008)
Stored materialsOn site or bonded warehouseOn site or bonded warehouse · On site only · Not funded until installed
Change orders the bank must approveAbove $100,000 or 25 daysAbove $100,000 or 25 days · Above $50,000 · Every change order
Construction loan administrator signs alone up to$2,500,000$1,000,000 · $2,500,000 · $5,000,000
Connections

Pay applications, lien waivers, inspections and title records each draw is checked against

Pay applicationsAIA G702 and G703, or your own draw request form
Invoicescontractor, subcontractor and soft-cost invoices
Lien waiversconditional and unconditional, progress and final
Inspection reportspercent complete per line, photos, stored-materials count
Loan budgetbudget lines, change orders, contingency, interest reserve
Title and county recordsthe date-down and liens recorded since the last draw
What it changes

Construction draw review time and holdbacks, before and after

Each figure carries its label: a target the solution is built to, an estimate, a typical published result, or a proven one.

target
1day
from a complete package to a signed decision
By hand5 to 7 days
With agents≈ 1 day
target
100%
of lines tied to invoice, waivers and inspection before money moves
20 of 20 lines
on every draw
typical
5.5days
lenders take to process a draw today
TodayWith agents

“Demo” means seen in the working solution, on its sample loan data. “Target” means the design goal, measured in the live solution. “Estimated” means our estimate. “Typical” means published figures. The Rabbet construction loan administration survey found a draw takes 5.5 business days as lenders report it, and 9.4 as borrowers experience it. Land Gorilla puts a draw reviewed by hand at 5 to 7 days. MightyBot has written on G703 lines that do not tie to the G702. Texas Property Code §§53.281 to 53.284 sets the statutory waiver forms. Names on the screens are sample data.

Questions

Construction draw management software questions from loan administrators

What is construction draw management software?

It is software that takes a construction loan draw from the borrower's request to a paid advance. The pay application, invoices, lien waivers, inspection, budget and title date-down are all checked before money moves. Construction Draw Management adds six agents. They read the package, tie each G703 line to its proof and recommend an amount with each holdback. The loan administrator decides and signs.

How does it track lien waivers?

The invoice and waiver matcher reads each waiver's type, amount, through date, signer and statutory form, for this payment and the last. If the unconditional waiver for the last payment is missing, that party's new money is held. If a waiver is short of the payment due, the difference is held. One click drafts the request to the contractor.

What happens when a line is billed ahead of the inspection?

The inspection reconciler compares the inspector's certified percent with the billed percent on each G703 line. The tolerance is 3 points by default. If a line is billed further ahead than that, the difference is held, after retainage. It is released when a later inspection certifies the work.

Does it check that the loan stays in balance?

Yes. After each draw, the budget and balance checker tests the loan. The loan money not yet paid out must cover the cost to finish, line by line. Contingency must stay above its minimum share of the hard cost left. General conditions must not run ahead of the project, and the interest reserve must last to completion. If the loan is out of balance, the recommendation stops.

Does the AI change the contractor's numbers or the inspector's percentages?

No. The agents report differences. They do not alter a submitted figure or a certified percentage, and they do not move money between budget lines. They never recommend funding past a recorded lien.

Who signs the funding amount, and who can release a holdback?

The construction loan administrator decides and signs, and records what the signature means. Above the administrator's limit, a construction lending officer also signs. The agents only recommend. A holdback is released only by its document, or with a reason and a second person.

Can we set our own tolerances, approval limits and waiver rules?

Yes. The inspector tolerance, the general conditions limit, retainage and the minimum contingency are all settings. So are the statutory waiver forms by state, the lower-tier supplier threshold and the stored-materials rule. The change-order limit and the approval limits are settings too. Each one is versioned and on the audit trail.

What does a lender provide to run it on its own draws?

We need your credit policy, your loan agreement and a sample of past draw packages. The Agentic Solution Engine builds and deploys the solution from those requirements and documents. It goes live once each quality gate has passed.

Run construction draw management software
on your own past draw packages.

We'll run Construction Draw Management on a sample of your own past draw packages.
