- Before
- Knows the company deadline, but not which country will miss its own.
- Now
- Sees each market on its own clock the day the CCDS is approved, decides deviations and pull-forwards, and e-signs each local draft.
CCDS label change management on two safety changes in 16 markets
In the sample, one product's CCDS 15.0 is already cascading through 16 markets, and at 08:10 the labeling committee approves a second product's CCDS 23.0 with a new warning for severe skin reactions. Here is what happens next, screen by screen, in the working solution.
A worked example on sample data. Names, IDs and figures on the screens and in this section come from the demo.
- 01Morning

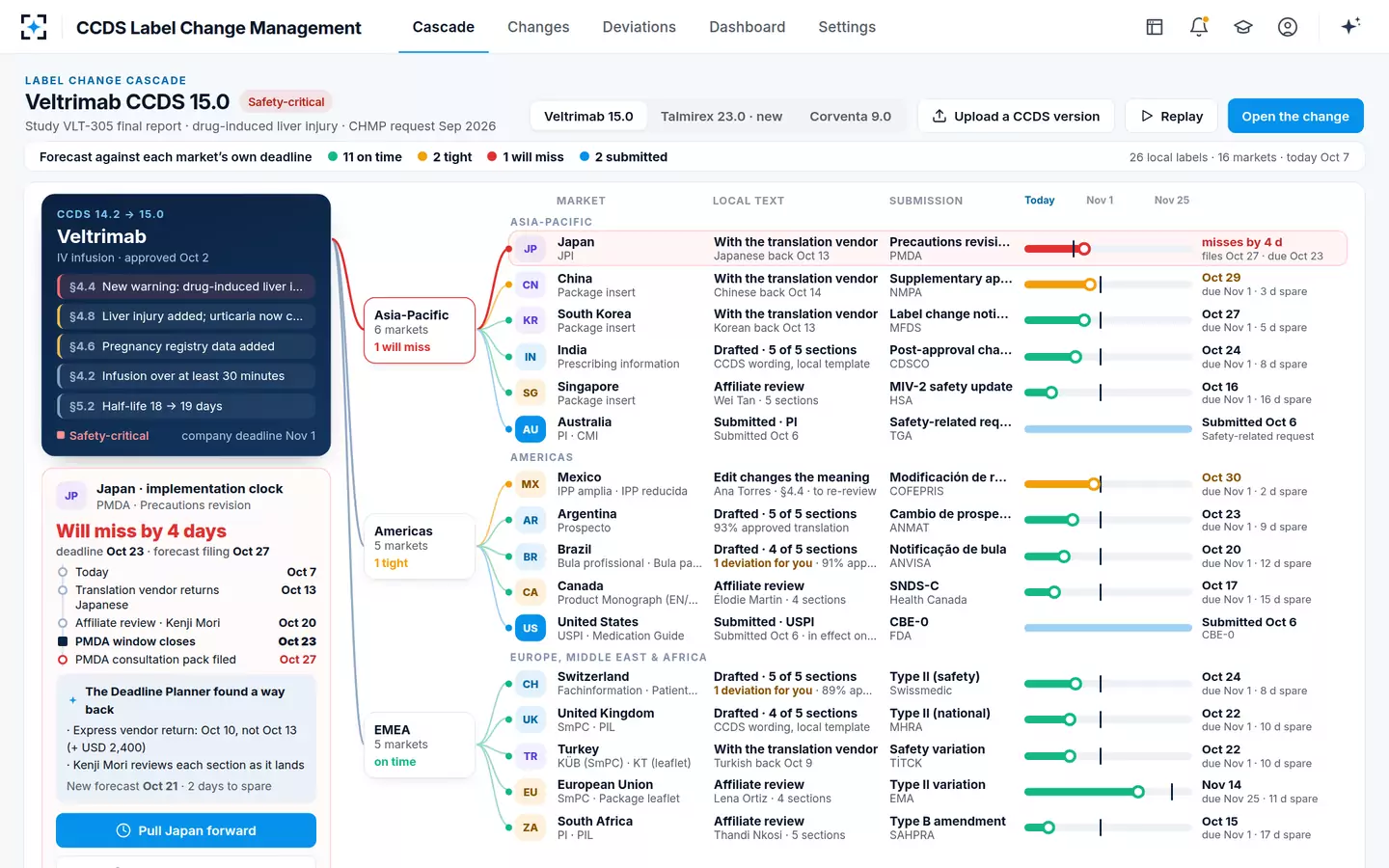

CCDS 15.0: 16 markets, one already red
Global labeling leadThe labeling lead opens the cascade for CCDS 15.0, approved five days earlier after the final study report on drug-induced liver injury. The change sits at the root (a new §4.4 warning, §4.8, §4.6, §4.2 and §5.2) and branches to 26 local labels in 16 markets. The forecast line reads 11 on time, 2 tight, 1 will miss, 2 submitted. Japan is red: its PMDA window closes first, and at today's pace it files 4 days after it.
“Forecast against each market’s own deadline.”
- 0208:10 · one click

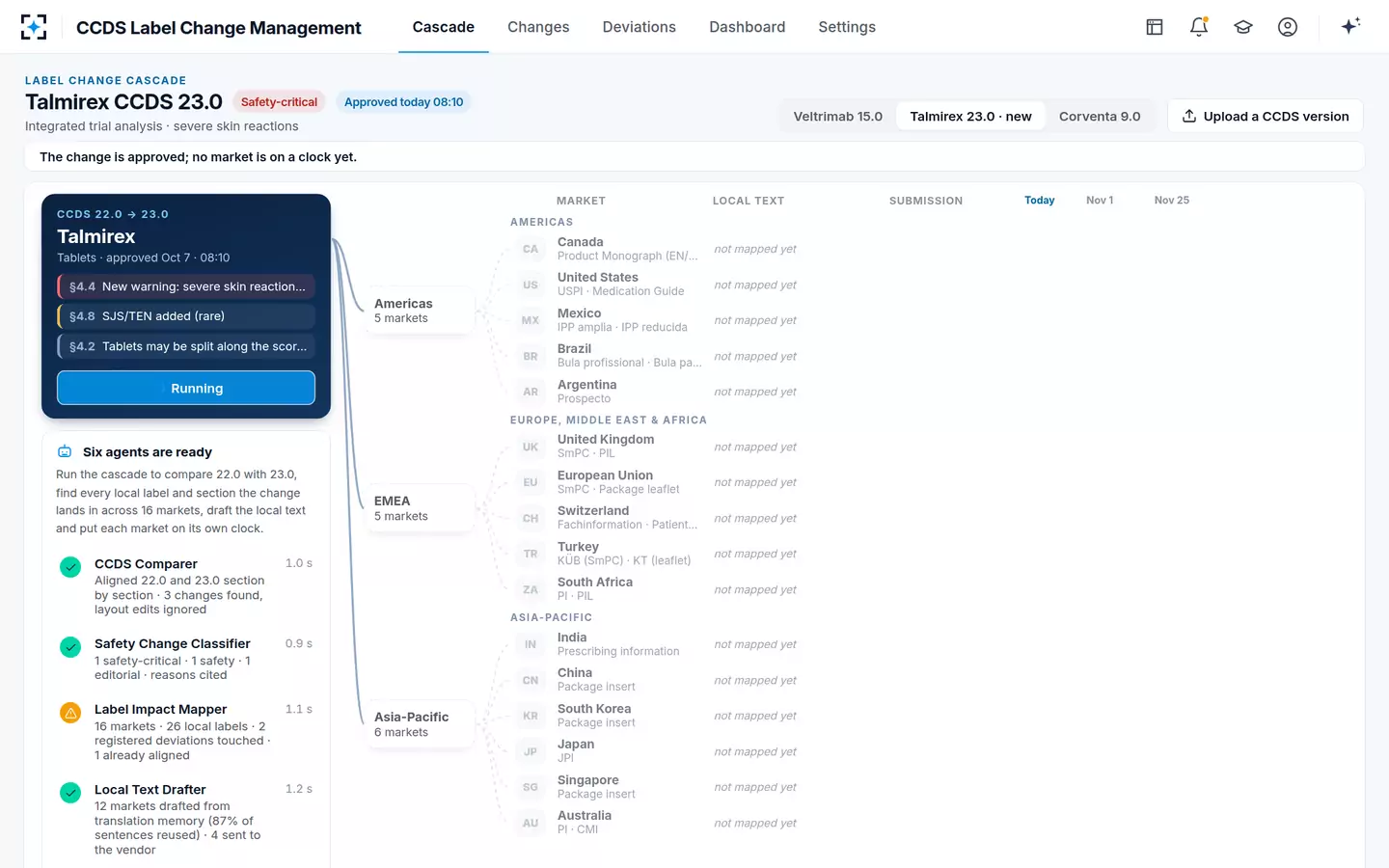

CCDS 23.0 arrives: “Run the cascade”
The agentsCCDS 23.0 adds a §4.4 warning for Stevens-Johnson syndrome and toxic epidermal necrolysis, SJS/TEN as rare in §4.8, and an editorial §4.2 change. No market is on a clock yet. The lead runs the cascade: the CCDS Comparer aligns 22.0 and 23.0 and finds 3 changes; the Safety Change Classifier marks 1 safety-critical, 1 safety, 1 editorial, with reasons cited; the Label Impact Mapper finds 26 local labels and 2 registered deviations touched; the Local Text Drafter drafts 12 markets from translation memory and sends 4 to the vendor.
Each agent step runs in view, with its result and how long it took: about a second each.
- 03Seconds later

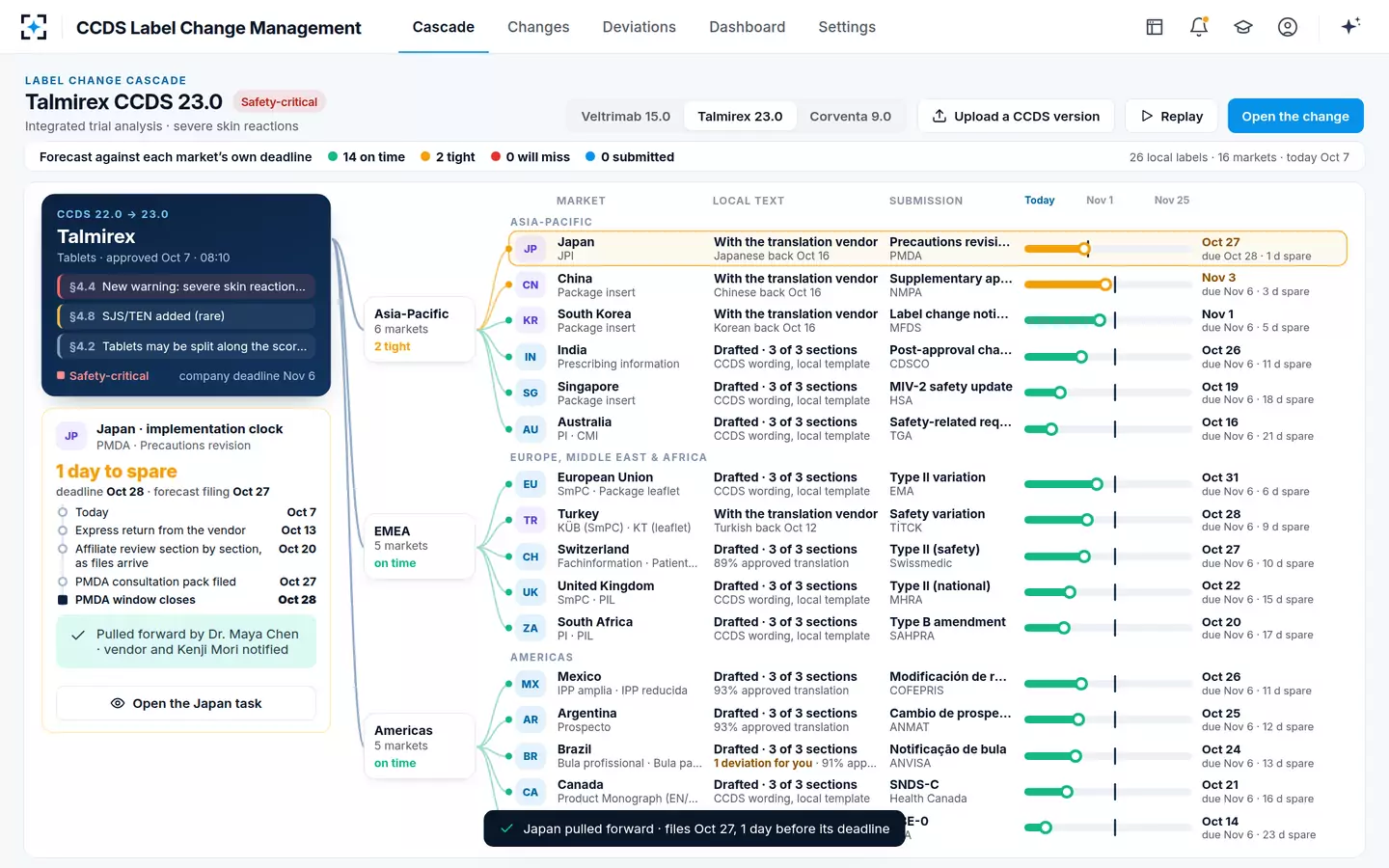

Japan will miss its own window by 5 days
Deadline PlannerSixteen country tasks are open against the 30-day company deadline: 14 on time, 1 tight, 1 will miss. Japan's PMDA consultation has its own, earlier filing date. With the Japanese text back from the vendor and then the affiliate's review, the consultation pack would be filed 5 days after it. China is tight: 3 days inside the company deadline.
“Will miss by 5 days · forecast filing after the PMDA deadline.”
- 04One click
A costed way back, accepted by the lead
Global labeling leadThe Deadline Planner has found a way back: express vendor return 3 days sooner, for USD 2,100, with the Japan affiliate manager reviewing each section as it lands. The lead clicks “Pull Japan forward”. The row turns amber, Japan now files one day before its window, and the vendor and affiliate are notified. The planner spends nothing until the lead clicks.
“Pulled forward by the global labeling lead · vendor and Japan affiliate notified.”
- 05Brazil

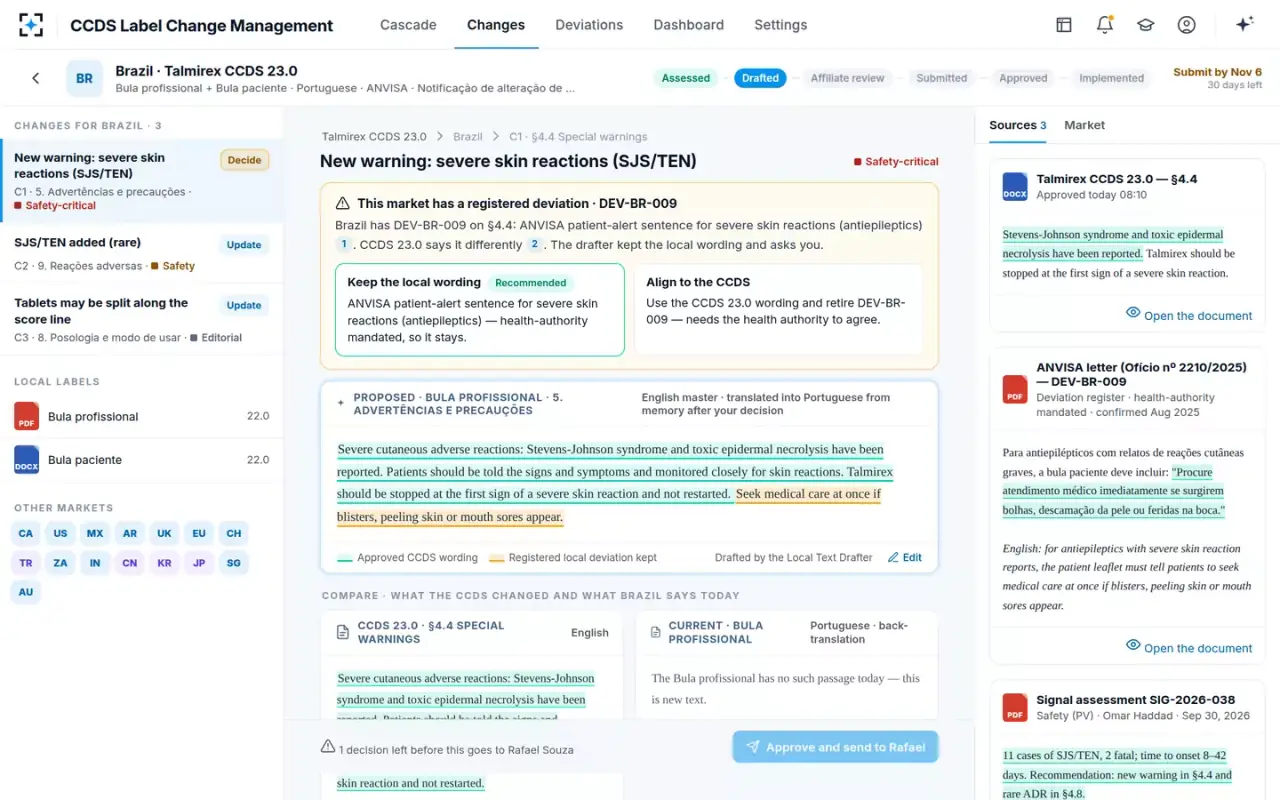

ANVISA's wording kept as registered

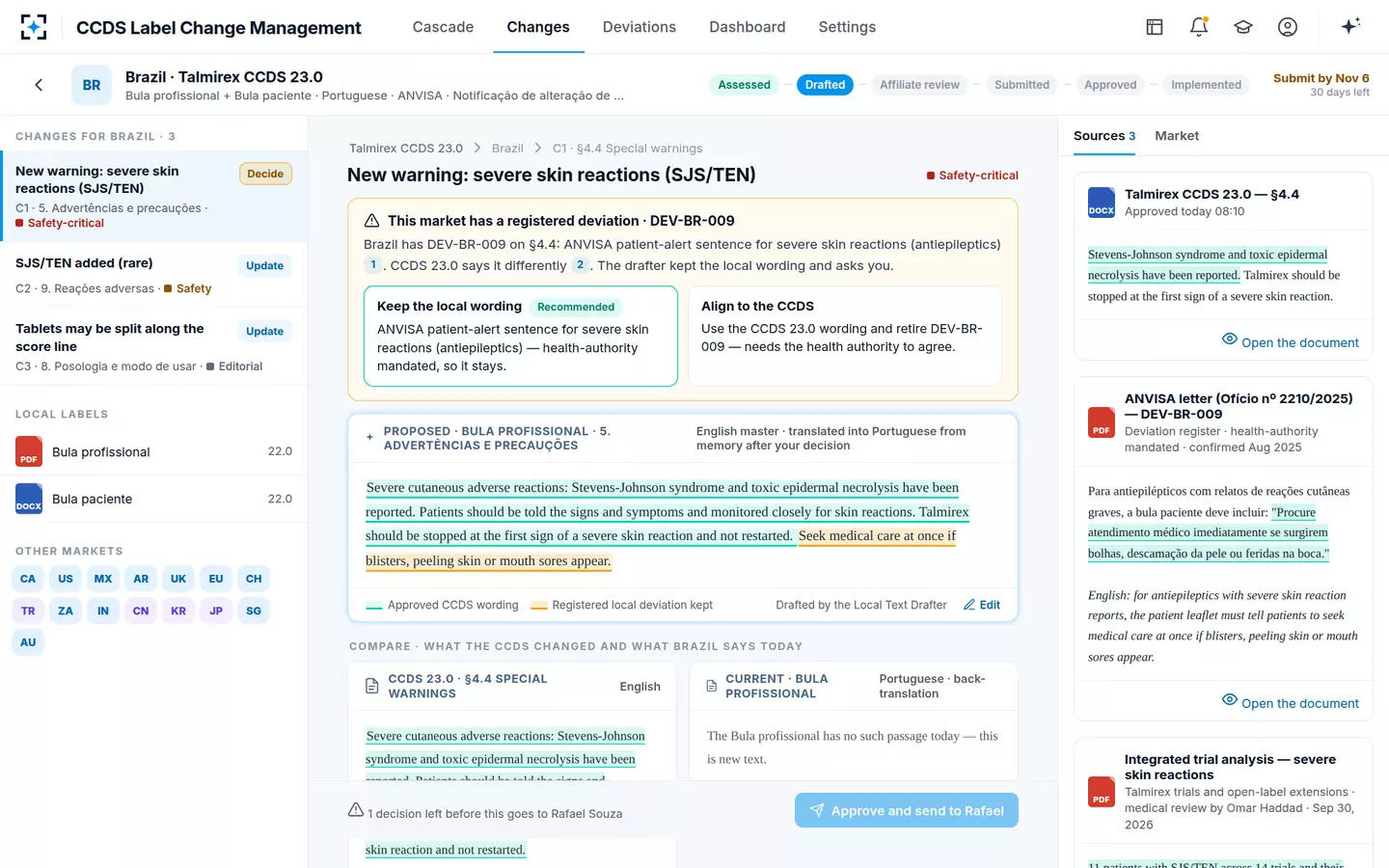

Local Text DrafterBrazil's bula profissional draft opens as an English master, each sentence marked as approved CCDS wording or registered local deviation, to be translated into Portuguese from memory once the lead decides. A registered deviation from an ANVISA letter, requiring a patient alert for severe skin reactions with antiepileptics, covers the new §4.4 warning. The drafter kept it and asks: keep the local wording (recommended) or align to the CCDS? The lead keeps it in one click.
The Local Text Drafter keeps a registered deviation unless the lead decides otherwise.
- 06Signed

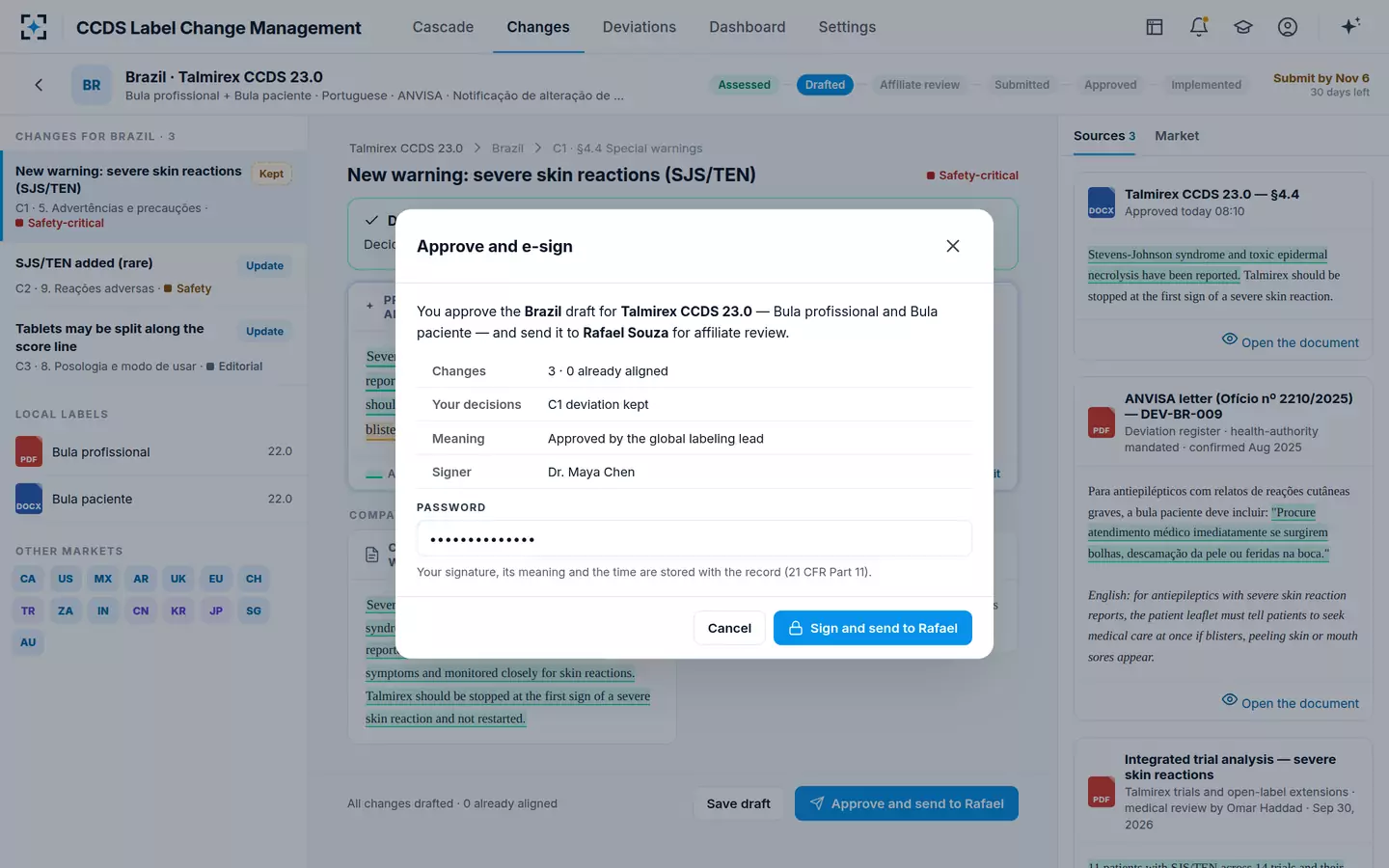

Approve and e-sign, then on to the affiliate
Global labeling leadThe labeling lead approves the Brazil draft for CCDS 23.0 (bula profissional and bula paciente) and sends it to the Brazil affiliate manager for review. The dialog shows the changes, the decision taken (the deviation kept), the meaning “Approved by the global labeling lead” and the signer.
“Your signature, its meaning and the time are stored with the record.”
- 07CCDS 15.0

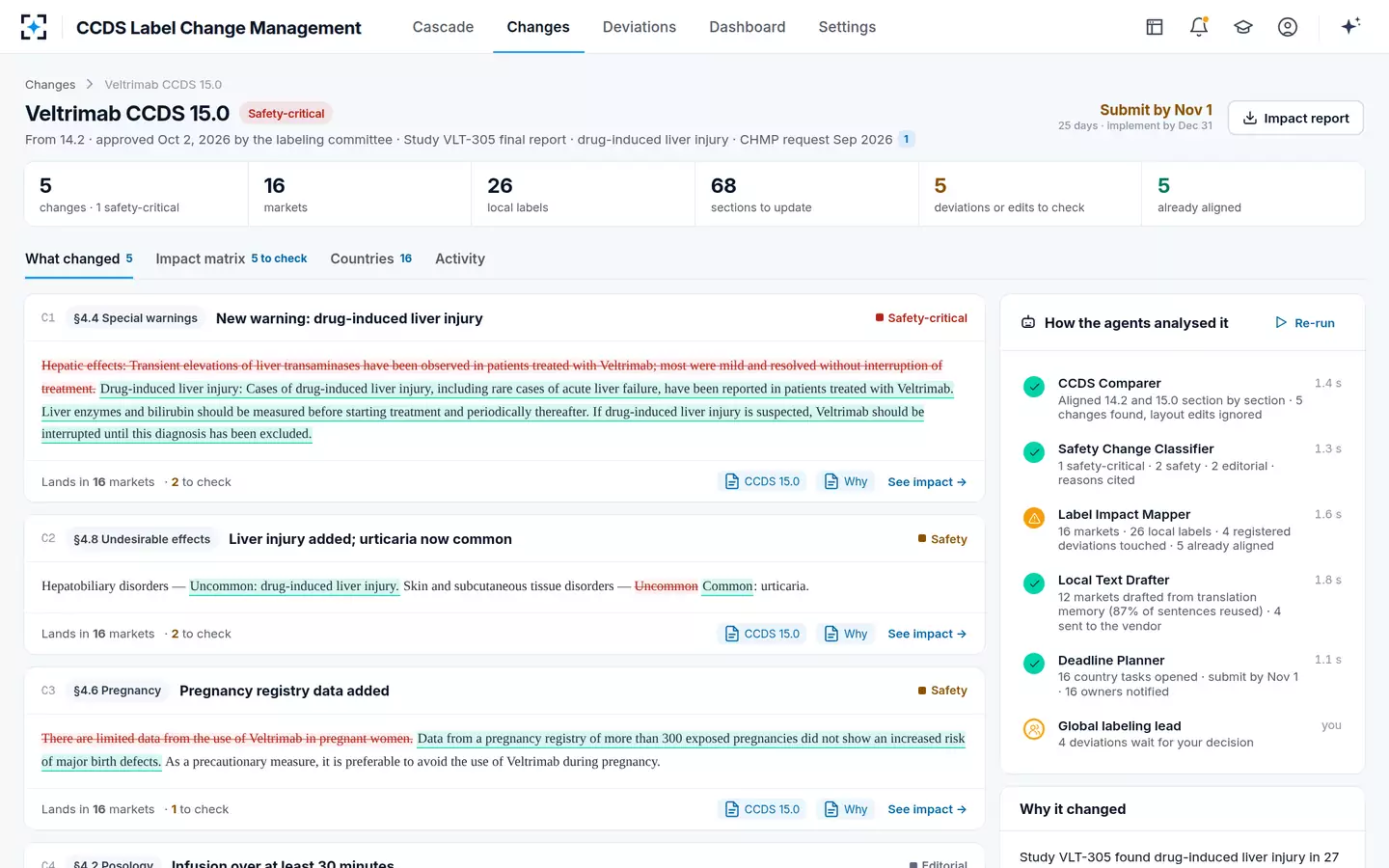

Each change redlined, with why it changed
CCDS Comparer · Safety Change ClassifierOpening the CCDS 15.0 change shows each section as a redline against 14.2 and the markets it lands in. The summary reads 5 changes, 1 safety-critical, 16 markets, 26 local labels, 68 sections to update, 5 deviations or edits to check and 5 already aligned. The global medical lead confirmed the safety-critical class.
The classifier does not settle a safety-critical class without the global medical lead's confirmation.
- 08Impact matrix

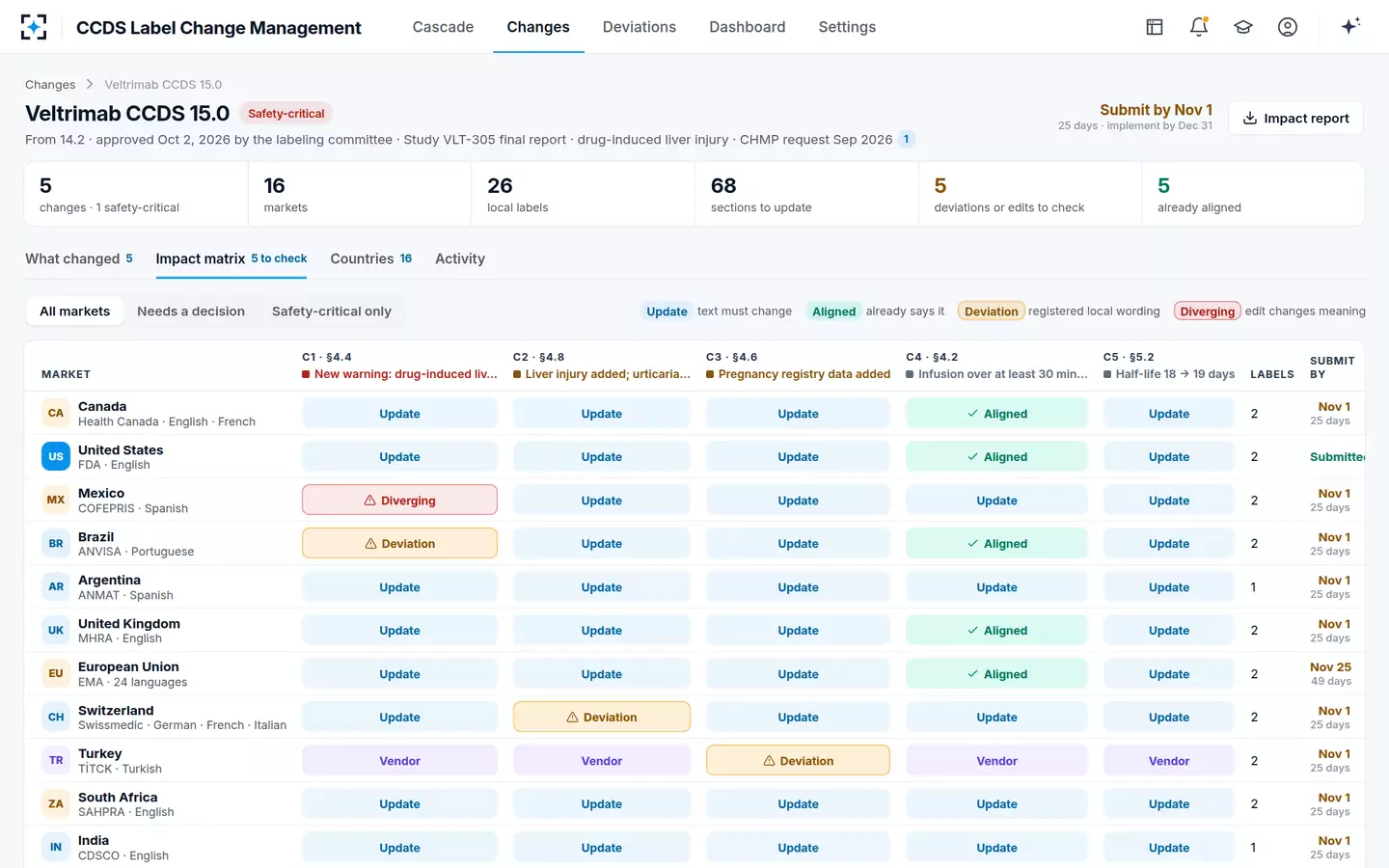

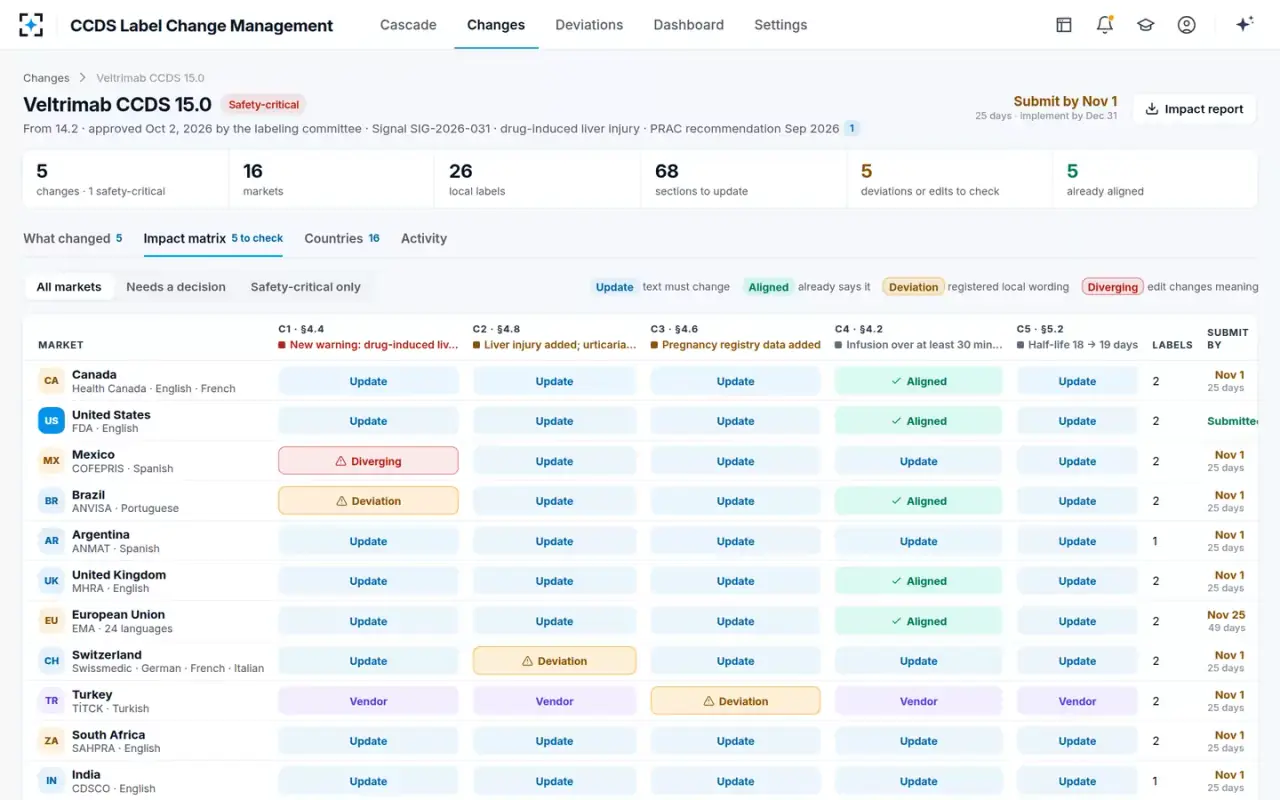

Market by change: update, aligned, deviation, diverging
Label Impact MapperEach cell says what the local text needs: Update, Aligned, Deviation, Diverging or Vendor. Brazil's §4.4 meets a registered deviation from an ANVISA letter: liver tests every 3 months. Switzerland's §4.8 and Turkey's §4.6 have their own deviations. Mexico's §4.4 is marked Diverging.
The mapper marks a passage aligned only with a cited local sentence.
- 09Mexico

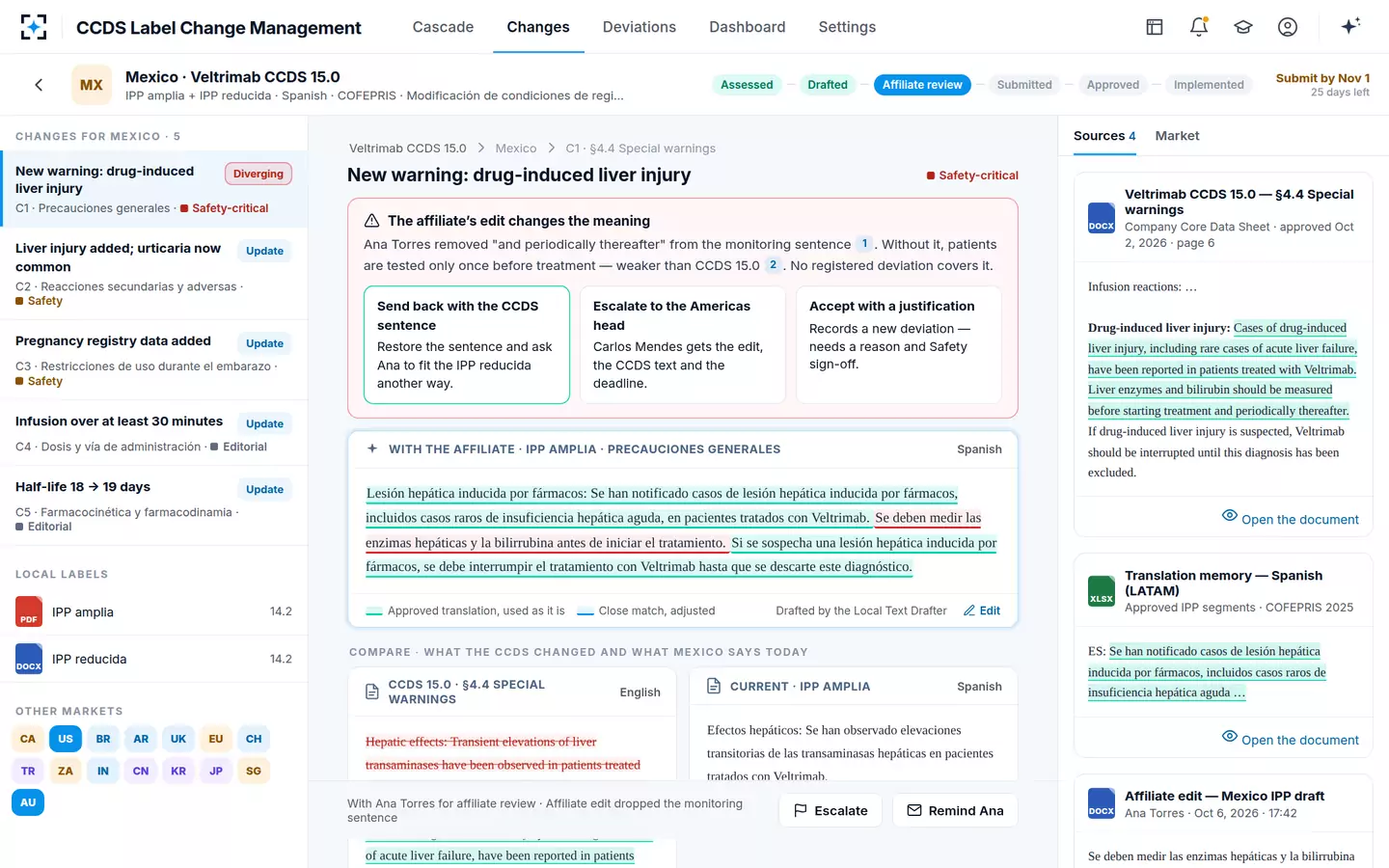

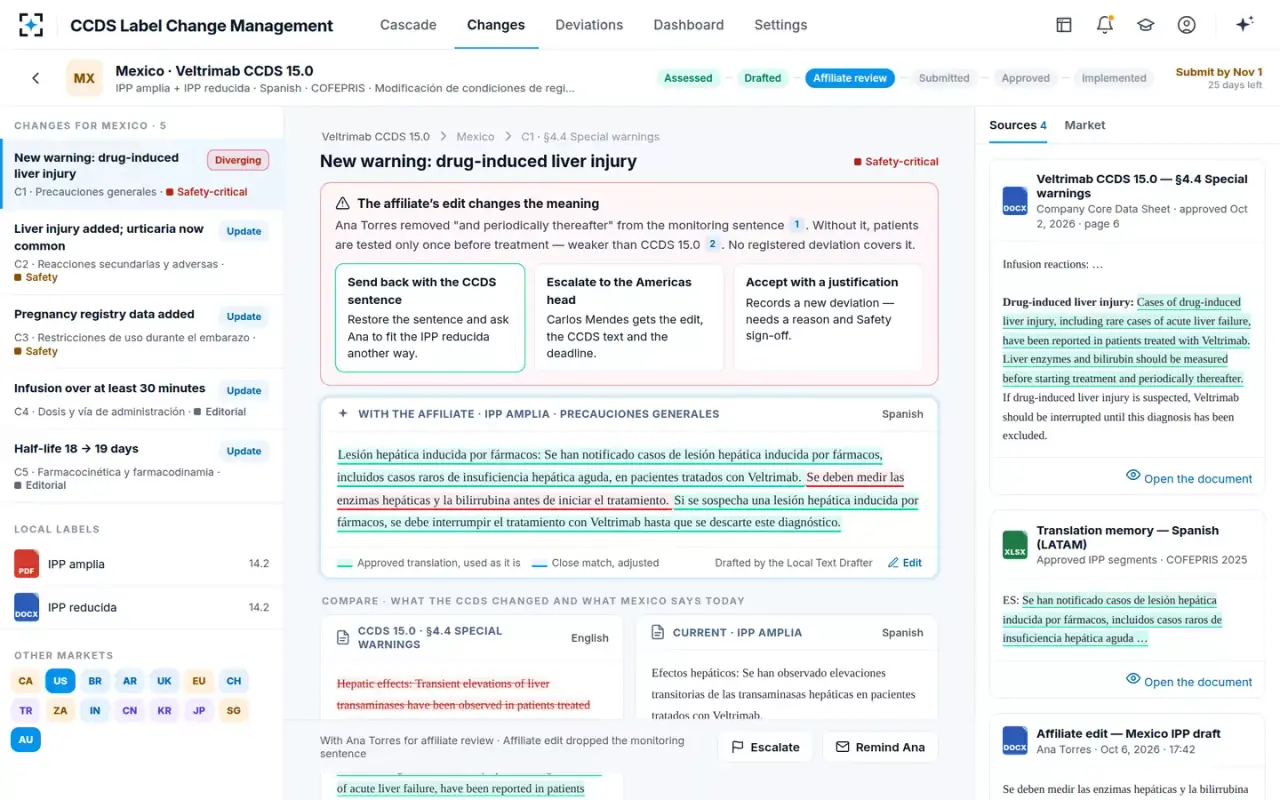

An affiliate edit that weakens the warning
Meaning CheckerThe Mexico affiliate manager shortened the Mexico IPP the day before, removing “y periódicamente después” from the monitoring sentence. The Meaning Checker back-translated it: without it, patients are tested only once, before treatment, which is weaker than CCDS 15.0, and no registered deviation covers it. The lead can send it back with the CCDS sentence, escalate it to the Americas regional head, or accept it with a justification that needs Safety sign-off.
“The affiliate’s edit changes the meaning.”
- 10Each morning

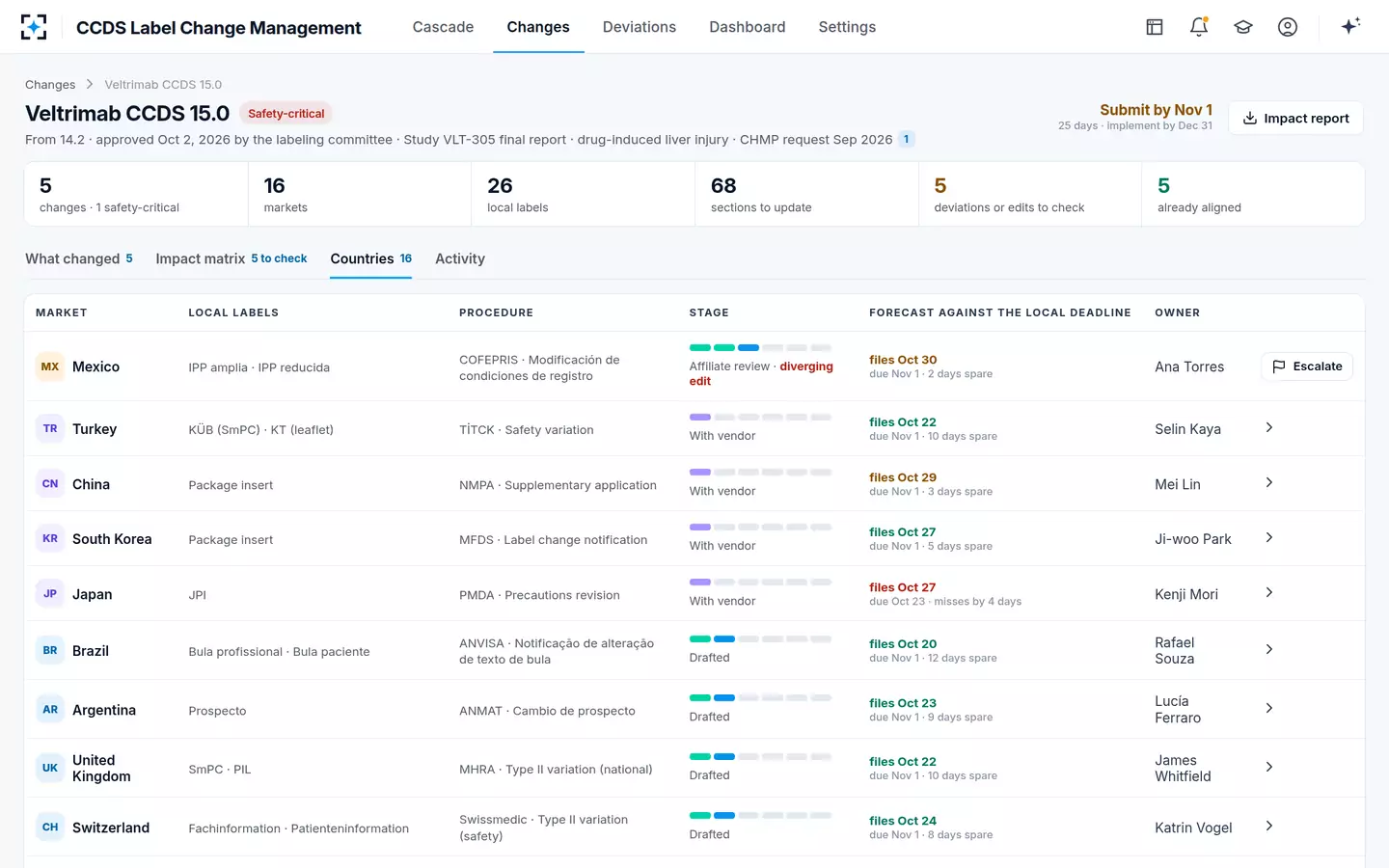

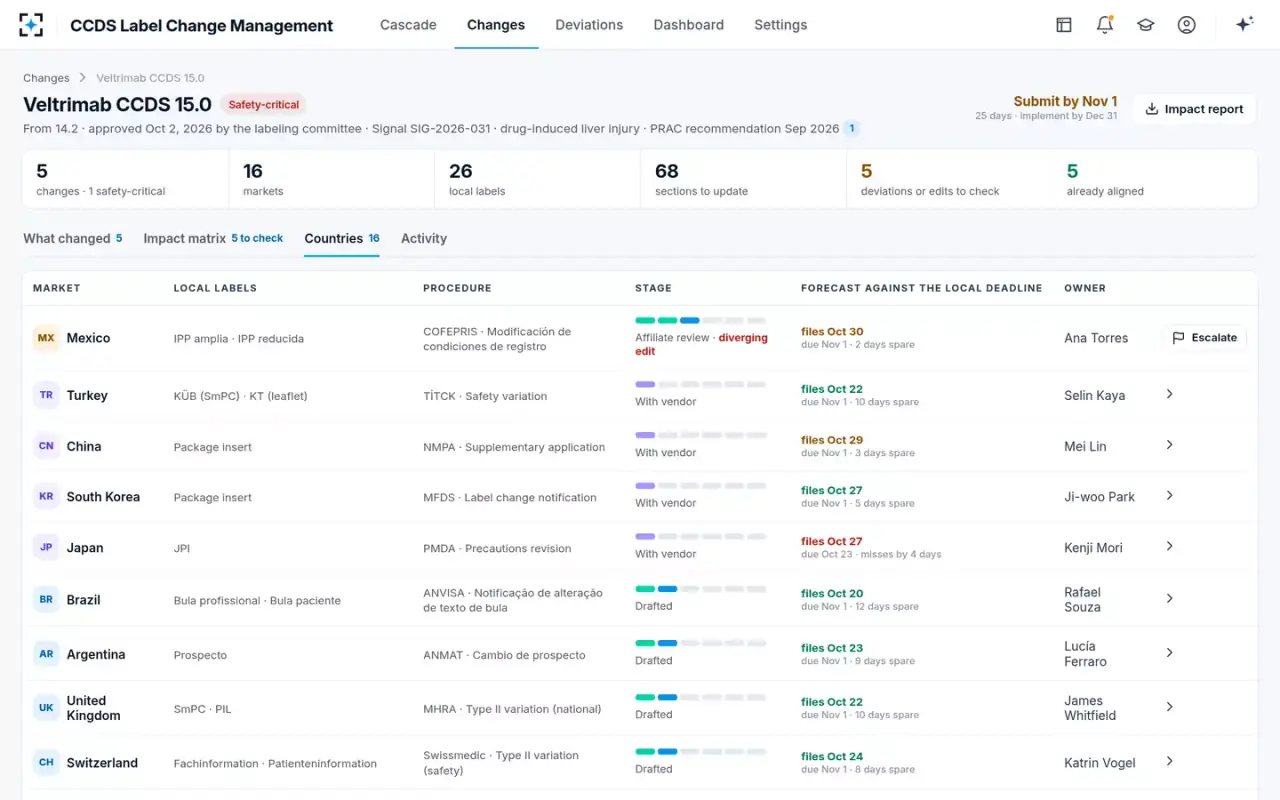

Each market against its local deadline, with its owner
Deadline PlannerThe Countries tab lists every market's local labels, procedure, stage and forecast against its own deadline, with the affiliate owner: Mexico in affiliate review with a diverging edit, Japan filing 4 days after its window, Brazil drafted and filing ahead of its date. Late markets escalate to the regional head, with the task and sources.
The planner escalates only to named people, and its dates follow the clock rules in Settings.
