WorkflowCredit Risk & Portfolio Management

Regulatory Capital Calculation

Regulatory capital calculation that reads each loan file for the facts behind its risk weight

See one case, screen by screen ↓
Watch with transcript →

Built forCapital planning analystsChief Risk OfficersCFOs and treasurersRegulatory reporting teams

The Problem Today

Capital teams need facts from appraisals and memos to measure the new rule, but the core lacks them, so they sample and guess.

35 days
to measure the new rule’s effect on the whole book, by hand our estimate
8.6%
lower risk-weighted assets for covered banks, by agency estimate published

What the rule needs from the file

  • Appraisal
  • Occupancy
  • Equity
  • Commitment
  • No value, full weightUnder the proposal, a home loan with no proven value at origination takes the full weight
  • No page behind the weightExaminers pull a loan and ask for the source

The Solution

  1. The whole book mappedEach loan and commitment sorted into its exposure class, from the core
  2. The facts read from the filesValue at origination, occupancy and borrower capital, each with its page
  3. Each loan weighted twiceUnder the current rule and the proposal, loan by loan, with the rule paragraph
  4. Lead signs, risk approvesThe capital planning lead signs and the chief risk officer approves

Built-in controls

  • Each override needs a second person
  • Only approved rule versions are used
  • The core system and filings stay unchanged

What You Get

The capital effect of the proposal is added up from each loan, with a page an examiner can open behind each weight.

  • Today’s coding errors foundMiscoded HVCRE loans and modifications found, with accepted fixes sent to reporting
  • Capital effect by segmentA CET1 bridge under the proposal, added up from the loans
  • Unproved loans listedEach with the document to find and the weighted assets at stake
In short

What is Regulatory Capital Calculation?

Regulatory capital calculation software gives each exposure its risk weight under the capital rules. It totals risk-weighted assets and works out the capital ratios. Regulatory Capital Calculation does this loan by loan, under the current rule and the March 2026 proposal side by side. Its agents read each loan file for the facts the weights depend on.

How to choose AI solutions for lending →

Updated

The problem

Banks cannot measure the new capital rule's effect because the facts behind each weight sit in loan files

A bank must hold capital against its loans. How much depends on each loan's risk weight, set by the capital rules. In March 2026 the US banking agencies re-proposed those rules. The capital planning team has to measure what the change means for the bank. Under the proposal, a first-lien home loan is no longer weighted at a flat 50%. Its weight depends on the loan-to-value (LTV) at origination, whether the owner lives there and whether rents repay it. A construction loan's weight depends on how much capital the borrower put in. A commitment's weight depends on whether the agreement lets the bank cancel it at any time.

Those facts sit in appraisals, applications, credit memos and loan agreements. Very often they are missing from the core banking system. So the impact estimate becomes a spreadsheet project. The team pulls the core, samples some files and extrapolates. Loans with no value get an assumed one, or stay at the penalty weight. Errors in the core stay hidden too. Origination values can be lost in an acquisition. Occupancy may be coded once at boarding and never checked again. A loan can carry a high-volatility commercial real estate (HVCRE) flag with no worksheet behind it. None of it shows until an examiner pulls a loan and asks for the page.

typical8.6%lower risk-weighted assets for covered banks in the agencies' estimate, though each bank must measure its own
Where the days on a whole-book impact run goestimated
By hand35 days
With the solution5 days
  • Pulling the book into spreadsheets5 → 0.5 d
  • Finding appraisals for loans with no value15 → 1 d
  • Checking HVCRE, occupancy and modification coding6 → 1 d
  • Weighting loans under both rules4 → 0.5 d
  • Writing the committee summary3 → 1 d
  • Review and sign-off2 → 1 d

Our estimated split of the days for one whole-book impact run, by hand and with the solution.

How it works

The risk-weight tree, answered from each loan file

What comes in
The book inThe whole loan book · core data, appraisals, memos, the rules
Agents at work
Exposure mapperexposure classes
Then
Appraisal reader
Occupancy and repayment checker
Construction and commitment reviewer
Then
Risk weight calculatorboth rules
Then
Capital impact writerbridge + summary
A person decides
Capital planning leadaccepts and signs, then the CRO approves
What comes out
Weight per loan, with its page
CET1 effect
Missing-data list
One case, step by step

The month-end book, weighted under both rules for Thursday’s capital committee

The agents work through a sample bank’s month-end book at 06:12 on a Monday, when the core closes. The capital committee meets on Thursday. The quarterly Call Report, the bank’s filing to regulators, is due later in the month. Here is the day, screen by screen, in the working solution.

A worked example on sample data. Names, IDs and figures on the screens and in this section come from the demo.

  1. 0106:12 · core close

    The whole book runs through the risk-weight tree

    The agents

    When the core closes, six agents get to work. They map 74,926 loans and 2,904 commitments to exposure classes. They read 11,354 documents in 8,416 loan files. Then they weight each loan under the current rule and under the proposal of 19 March 2026. Each branch of the tree shows its loan count and balance. Each leaf shows its risk-weighted assets (RWA) today and proposed. For example, 31,640 owner-occupied home loans land in Table 5 of the proposal, and 218 have an LTV that cannot be calculated.

    “6 agents · 11,354 documents in 8,416 files · 06:12 to 07:31”

  2. 02Morning

    One loan, and the path it took

    Capital planning lead

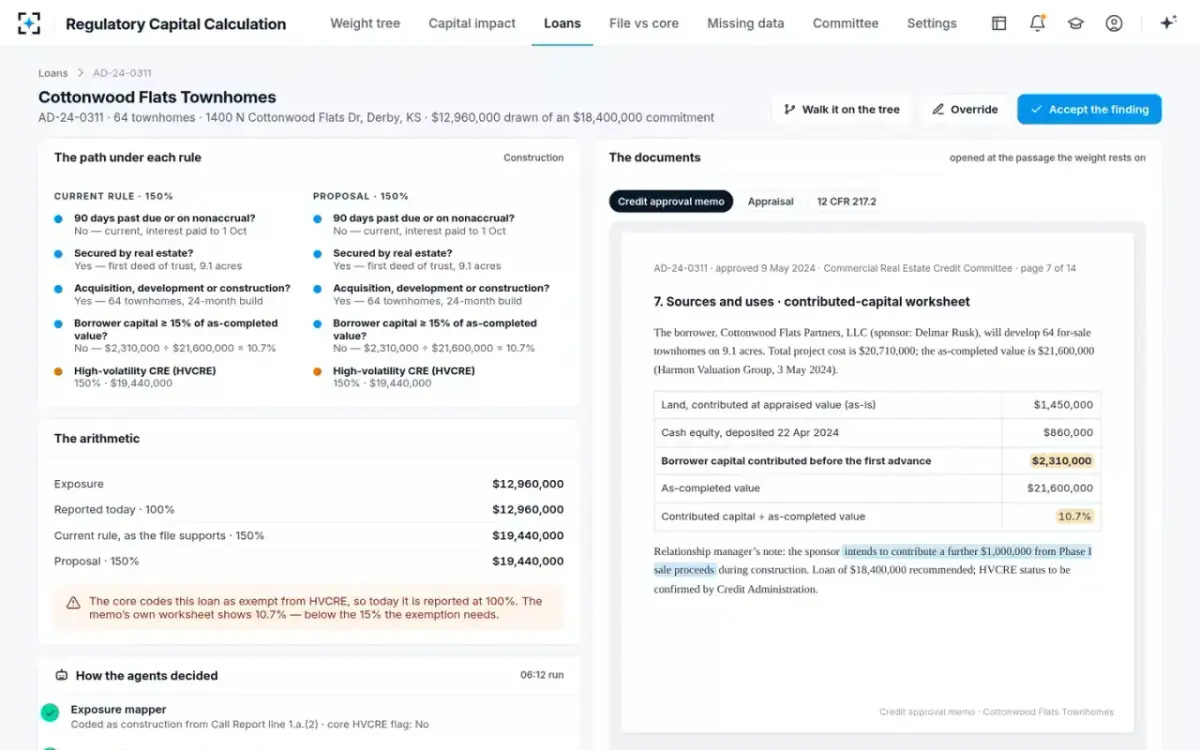

    The capital planning lead picks one construction loan for 64 townhomes. It has $12,960,000 drawn of an $18,400,000 commitment. The tree sends it to high-volatility commercial real estate, at 150%. A dashed orange branch shows where the core would have sent it: other construction, at 95%. That is because the core codes the loan as exempt.

    “The core codes this loan exempt from HVCRE, so today it is reported at 100%. The memo’s own worksheet shows 10.7%, below the 15% the exemption needs.”

  3. 03One click

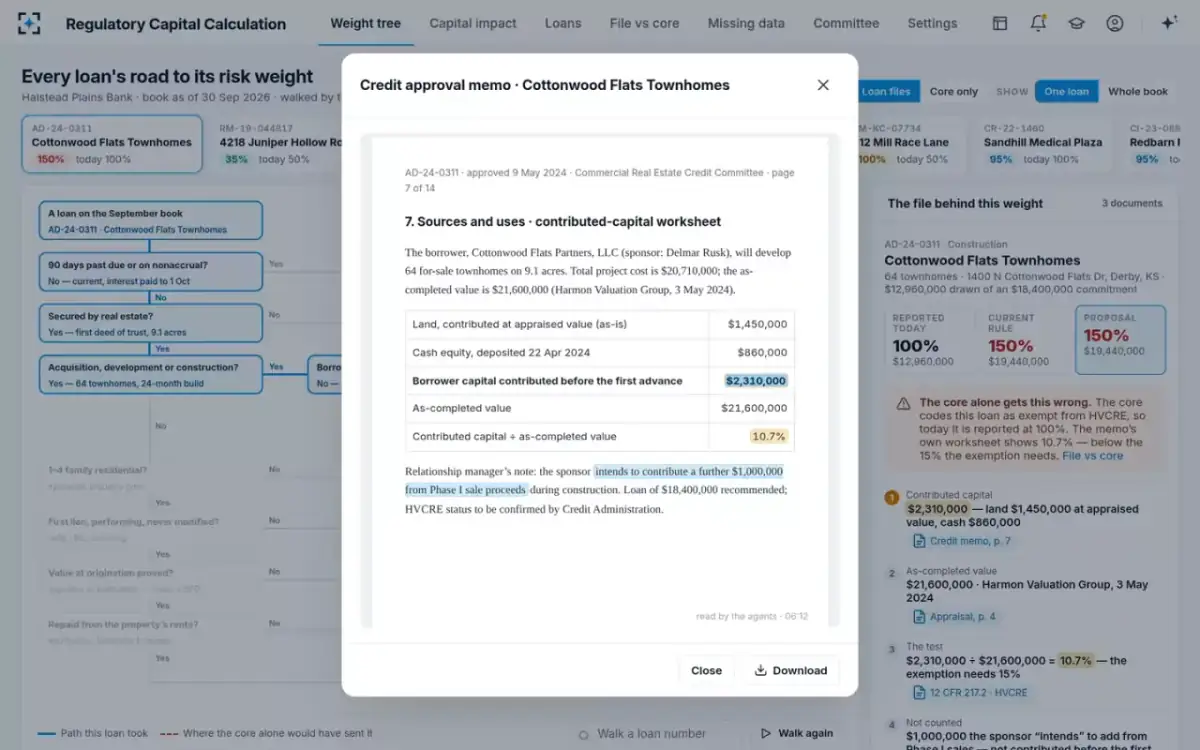

    The page behind the weight

    Capital planning lead

    Each fact in the right rail names its document and page. The credit approval memo opens at page 7. Before the first advance, the borrower put in land worth $1,450,000 and $860,000 of cash. That is $2,310,000, against an as-completed value of $21,600,000 from the appraisal, or 10.7%.

    Not counted: “$1,000,000 the sponsor ‘intends’ to add from Phase I sales”. It was not contributed before the first advance.

  4. 04Next loan

    An origination appraisal the core never had

    Appraisal reader

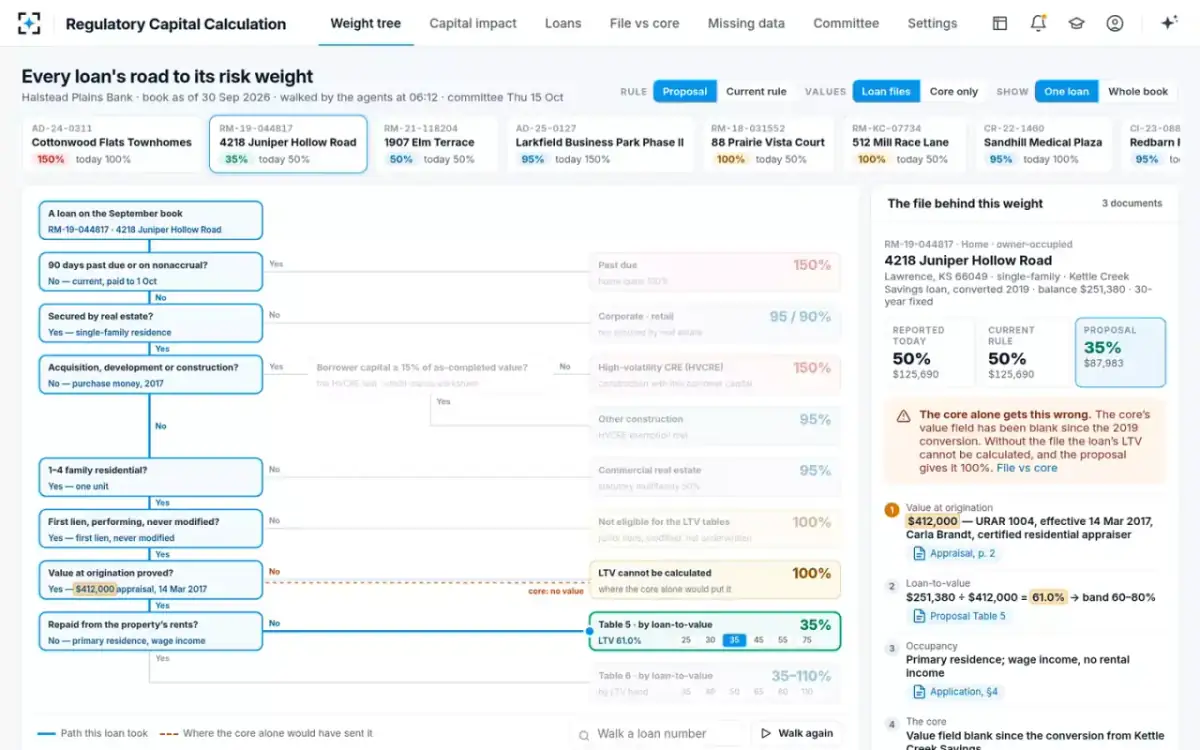

    This home loan came from an acquired savings bank. Its value field has been blank since the core conversion. The appraisal reader finds the standard home appraisal form (URAR 1004) from a certified residential appraiser, at $412,000. A loan of $251,380 against $412,000 is an LTV of 61.0%. That puts it in Table 5 at 35% under the proposal, against 50% today.

  5. 05Core only

    What the same loan costs without its file

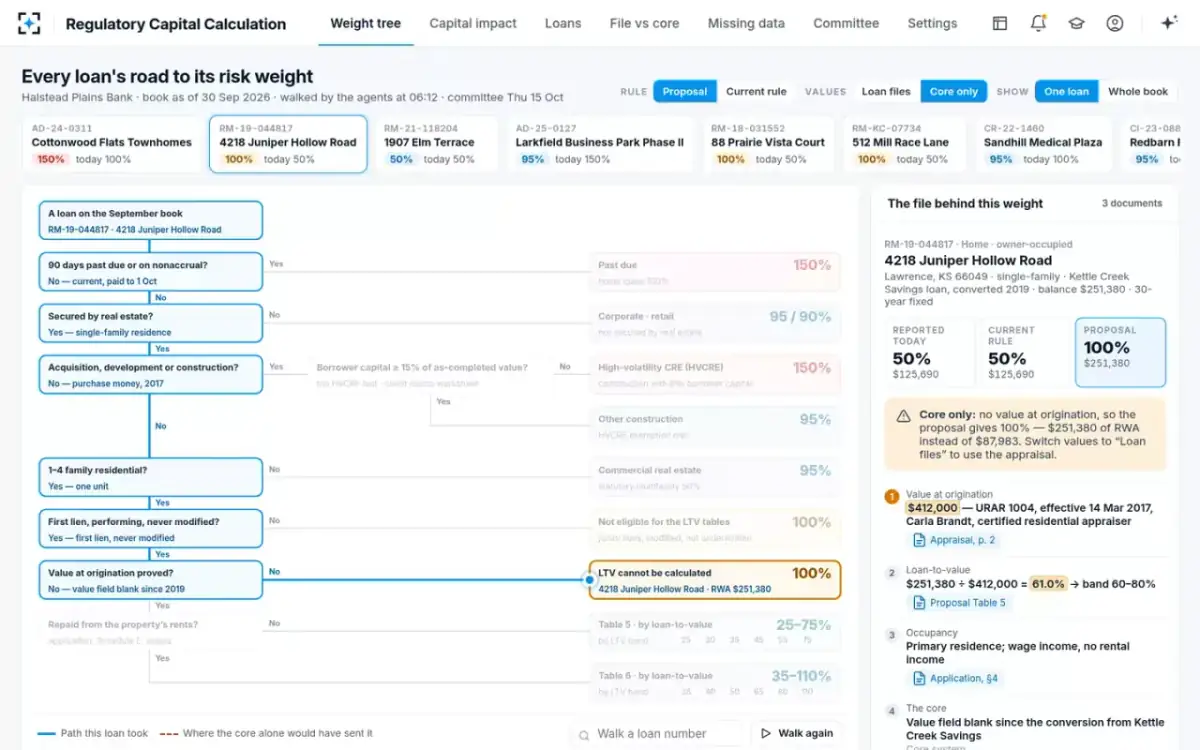

    Capital planning lead

    Switch the values to “Core only”, and the same loan becomes “LTV cannot be calculated”. It then takes 100%, so its RWA is $251,380 instead of $87,983. Across the book, 3,912 home loans have no value at origination in the core. The agents found a valid appraisal or evaluation for 3,694 of them.

  6. 06The total

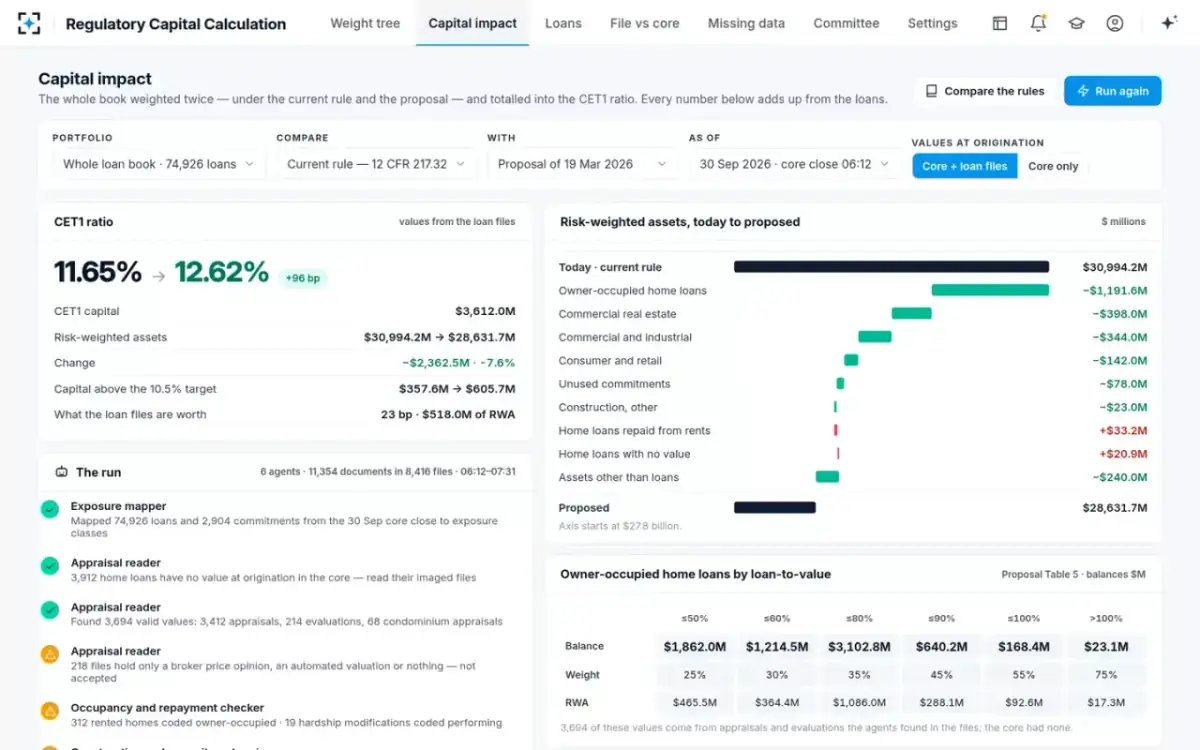

    The capital effect, added up from the loans

    Capital impact writer

    Under the proposal, risk-weighted assets fall from $30,994.2M to $28,631.7M. The CET1 ratio, the bank’s core capital measure, rises from 11.65% to 12.62%. That is 96 basis points on $3,612.0M of CET1 capital. The bridge shows where the change comes from. It shows drops for owner-occupied home loans (−$1,191.6M), commercial real estate (−$398.0M) and business loans, or C&I (−$344.0M). Home loans repaid from rents add $33.2M.

    “What the loan files are worth: 23 bp · $518.0M of RWA.”

  7. 07Before the filing

    Where the file disagrees with the core

    Capital planning lead

    Some findings change today’s reported numbers, as well as the proposal’s. Seven construction loans ($104.6M) coded exempt are in fact HVCRE. That adds $52.3M of RWA on the Call Report. Five loans coded HVCRE meet the exemption. Another 312 home loans coded owner-occupied are repaid from rents. And 19 carry hardship modifications but are coded performing. The capital planning lead accepts the seven and sends them, with their pages, to the regulatory reporting manager.

    Any correction to Schedule RC-R, the capital part of the Call Report, is the regulatory reporting manager’s decision.

  8. 08On a disagreement

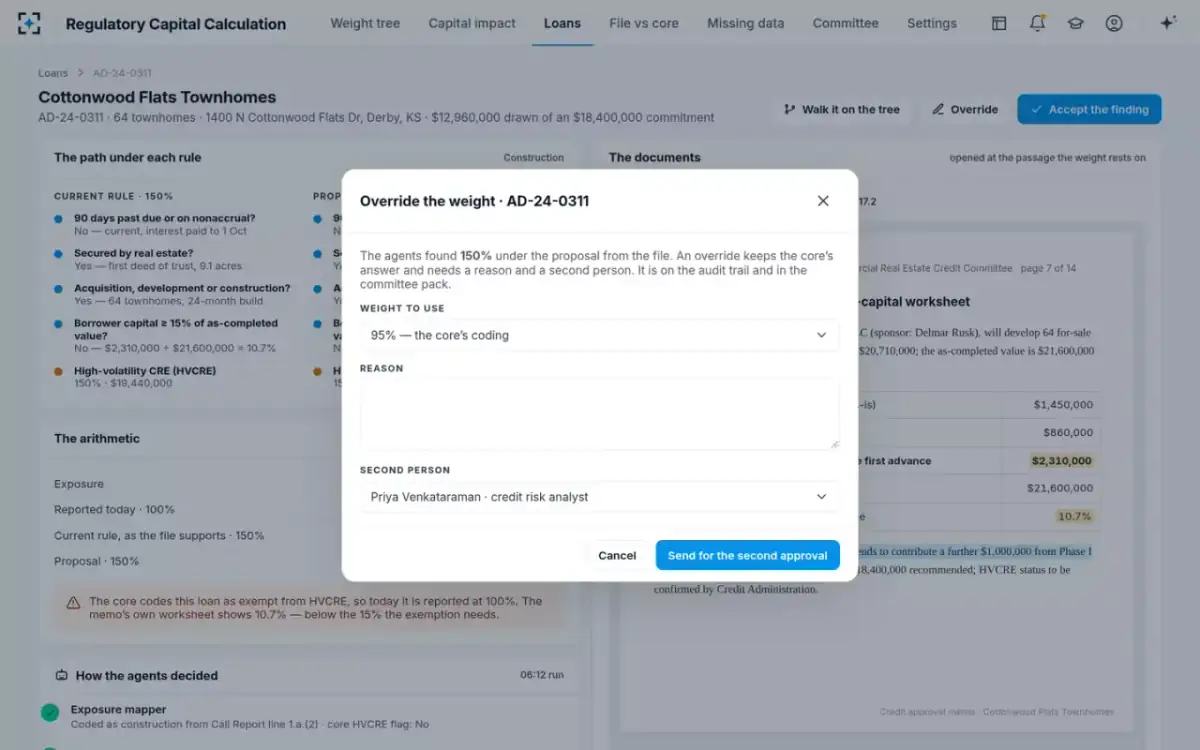

    An override needs a reason and a second person

    Capital planning lead

    On any loan, the lead can accept the finding or override it. An override keeps the core’s answer. It needs a written reason and a credit risk analyst’s approval before it counts. It goes on the audit trail and to the committee with the summary.

    “Sent to the credit risk analyst · the agents’ weight stands until approval.”

  9. 09Still missing

    Loans the agents could not prove

    Loan operations specialist

    After all that, 218 loans ($41.7M) still have no valid value at origination. Of these, 191 came from the acquired bank and have only a broker price opinion. They stay at 100% for now. Finding their values would lower RWA by $27.1M. Fourteen commitments have no agreement on file, so they take the 40% conversion factor. Three construction memos without the worksheet are treated as HVCRE.

    The appraisal reader accepts no broker price opinion or automated valuation, and estimates no value.

  10. 10Signed · for Thursday

    The lead signs and the CRO approves

    Chief risk officer

    The capital impact writer drafts the committee summary. It covers what moves the ratio, what the loan files are worth, the corrections to today’s reporting and the method. The capital planning lead signs it. The Chief Risk Officer approves it for Thursday’s capital committee.

    “Agents drafted this summary. They cannot sign, approve or send it.”

Who it’s for

Regulatory capital calculation for everyone who answers for CET1

One month-end book and five desks. Here is how each one’s week went by hand, and how it goes now.

Capital planning lead
Accepts findings, signs the summary
Before
Can calculate any rule, but cannot find 3,912 appraisals by hand.
Now
Starts from each loan already weighted under both rules, with the page behind each weight, and spends the week on the findings.
Chief risk officer
Approves the summary
Before
Wants the weight and the page it came from whenever an examiner pulls a loan.
Now
Approves a summary in which any loan can be traced down the tree to its fact, its page and its rule paragraph.
Chief financial officer
Chairs the capital committee
Before
Wants to know how much capital the proposal frees, and how sure the bank can be.
Now
Sees capital above the 10.5% target move from $357.6M to $605.7M, and what part of it rests on the loan files.
Regulatory reporting manager
Decides the Call Report filing
Before
Needs to know before the filing deadline if today’s coding is wrong.
Now
Gets the accepted coding corrections for Schedule RC-R, each loan with its page, and decides the filing.
Loan operations specialist
Keeps collateral records and imaged files
Before
Knows the appraisals exist, somewhere in 40,000 boxes.
Now
Gets a list of exactly which loans still need a document, and what each one is worth in RWA if found.
The agents

The mapper, the readers and the calculator behind each risk weight

The facts behind each risk weight come from the loan file, branch by branch. The capital planning lead accepts and signs, and the CRO approves.

Exposure mapper

Maps each loan and commitment from the core to an exposure class, using the Call Report codes and collateral records. It records the core field each answer came from.

  • Never changes a core record
Appraisal reader

Finds the value at origination in the loan file: an appraisal, an evaluation or a condominium appraisal. It reads the value, the date and the appraiser. Then it computes the loan-to-value the way the proposal defines it.

  • Never accepts a broker price opinion or an automated valuation
  • Never uses a current value or estimates one
  • With no valid value, lists the loan as missing
Occupancy and repayment checker

Reads the application, underwriting and servicing file. It finds occupancy, reliance on rents, and past-due, nonaccrual and modification status.

  • Never decides eligibility without a document
Construction and commitment reviewer

Reads construction memos for the HVCRE contributed-capital test. Only capital put in before the first advance counts, measured against 15% of the as-completed value. It also reads loan agreements to see whether a commitment can be canceled.

  • Never treats a loan as exempt without the worksheet
Risk weight calculator

Applies the current rule and the proposal loan by loan, citing the rule paragraph. Then it totals RWA by segment.

  • Uses only rule versions approved in Settings
Capital impact writer

Builds the CET1 bridge, the findings where the file and the core disagree, the missing-data list and the committee summary.

  • Never changes the core, the capital plan or a regulatory filing
  • Never signs or sends
Capital planning lead and CRO

Accept, sign and approve.

Ask in plain words

Any loan, weight or rule in regulatory capital, explained from its page

Capital, risk and reporting teams ask in plain words. Each answer cites the page it rests on. These examples use the sample data.

Why is the townhome construction loan at 150%?

It is high-volatility commercial real estate. Before the first advance, the borrower contributed $2,310,000: land at $1,450,000 and $860,000 in cash. Against an as-completed value of $21,600,000, that is 10.7%, and the exemption needs 15%. The $1,000,000 the sponsor “intends” to add later does not count. The core codes the loan exempt, so today it is reported at 100%.

What are the loan files worth in capital?

23 basis points of CET1. In the core, 3,912 home loans have no value at origination. In their imaged files the agents found valid values for 3,694. These are 3,412 appraisals, 214 evaluations and 68 condominium appraisals. With the core alone the proposal shows 12.39%. With the files, it shows 12.62%.

Which loans still have no value at origination?

218 loans, $41.7M. Of these, 191 came from the acquired savings bank, and their files hold only a broker price opinion. That is not accepted as a value at origination. They sit at 100% under the proposal. Finding their appraisals would lower RWA by about $27.1M.

Draft the note to regulatory reporting on this quarter’s coding corrections

Three coding corrections from the month-end files affect Schedule RC-R for the quarter. First, 7 construction loans ($104.6M) coded exempt are HVCRE, adding $52.3M of RWA. Second, 5 loans ($38.2M) coded HVCRE meet the exemption, removing $19.1M. Third, 19 home loans ($5.2M) carry hardship modifications coded as performing, adding $2.6M. The net is +$35.8M. The filing decision is yours. The draft is not sent until the capital planning lead accepts the findings.

The screens

Book totals, one loan’s path and the page behind its weight

From the working solution, on its sample data. Pick one to see it large.

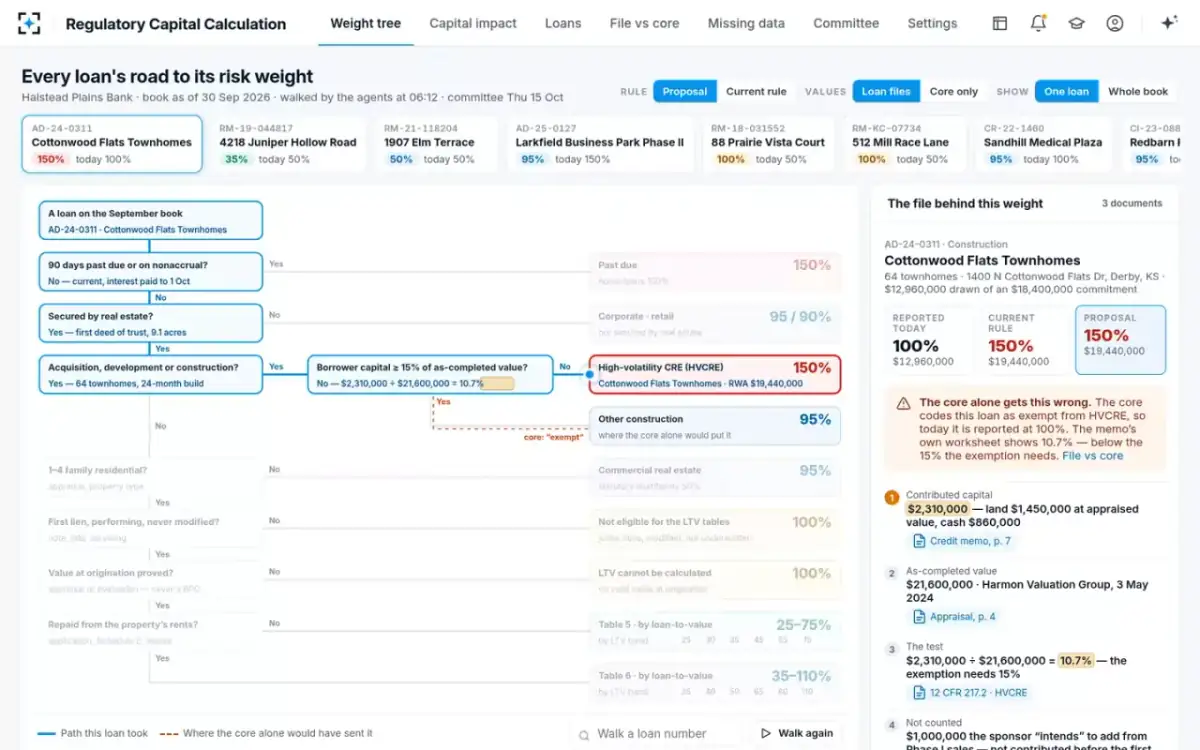

The risk-weight treeEach loan’s road to its risk weight, with the file behind the weight and where the core alone would have sent it.

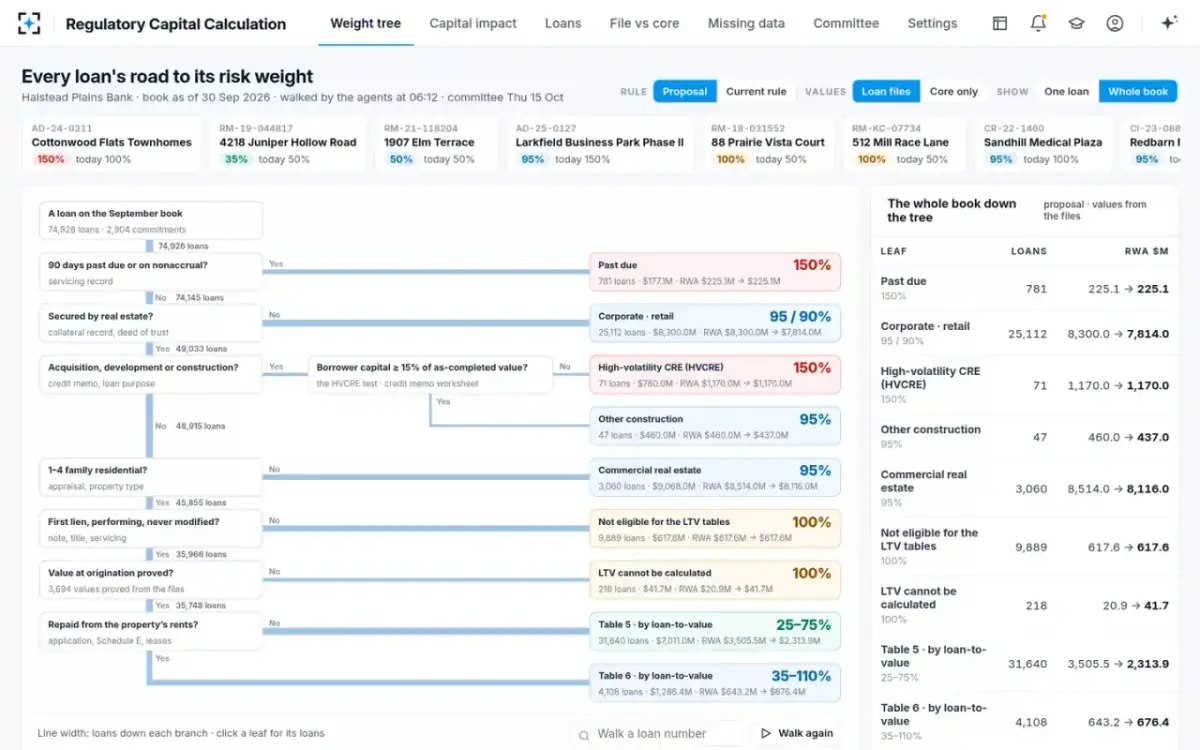

The whole book down the treeLoan counts and balances on each branch. RWA today and proposed on each leaf.
The page behind the weightThe credit memo opened at the contributed-capital worksheet, the deciding numbers highlighted.
A value found in the fileAn origination appraisal proves an LTV of 61.0%, which puts the loan in Table 5 at 35% under the proposal.
The same loan, core onlyWith the core’s blank value field, the loan falls to “LTV cannot be calculated” and 100%.
Capital impactCET1 moves from 11.65% to 12.62%. The view shows the RWA bridge by segment, the agents’ run and the LTV bands, each number added up from the loans.

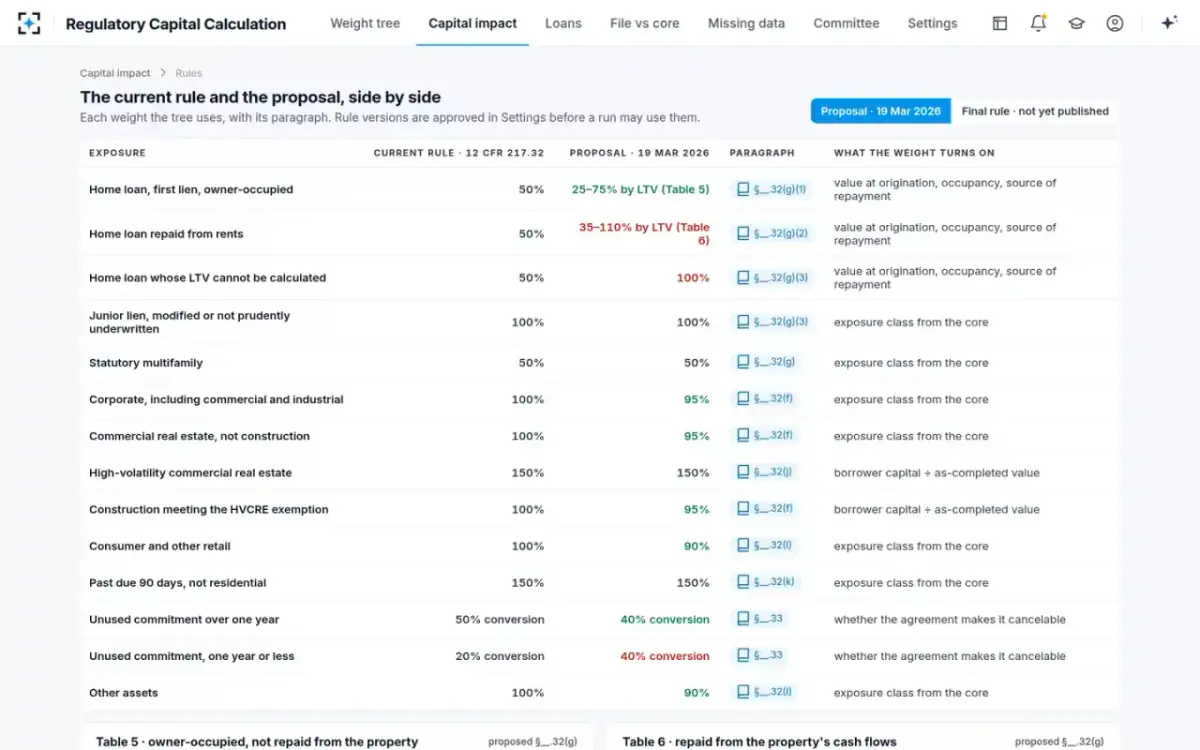

The rules side by sideCurrent rule and proposal by exposure, with the paragraph and what each weight turns on.
One loanThe path under each rule, the arithmetic, how the agents decided, and the document open at the passage.
Override with a second personAn override keeps the core’s answer only with a reason and a second person’s approval.

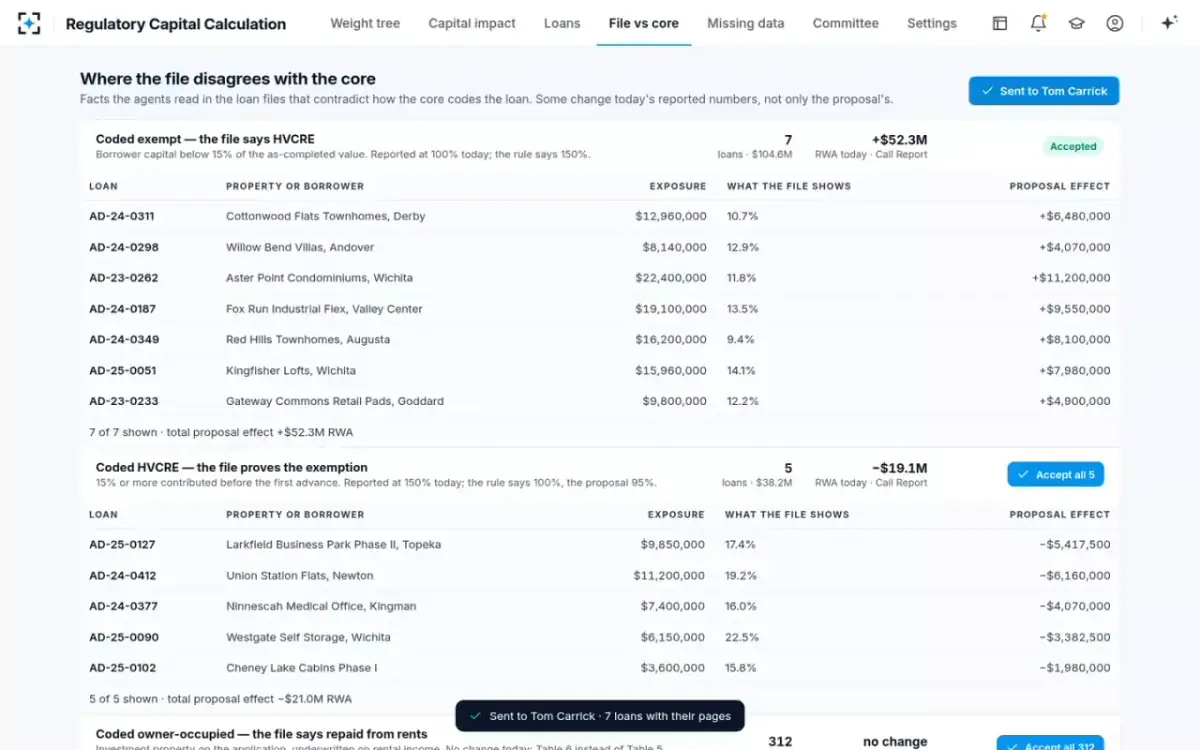

Where the file and core disagreeWhere the file contradicts the core coding, with today’s effect and the proposal’s. Accepted corrections go to regulatory reporting.

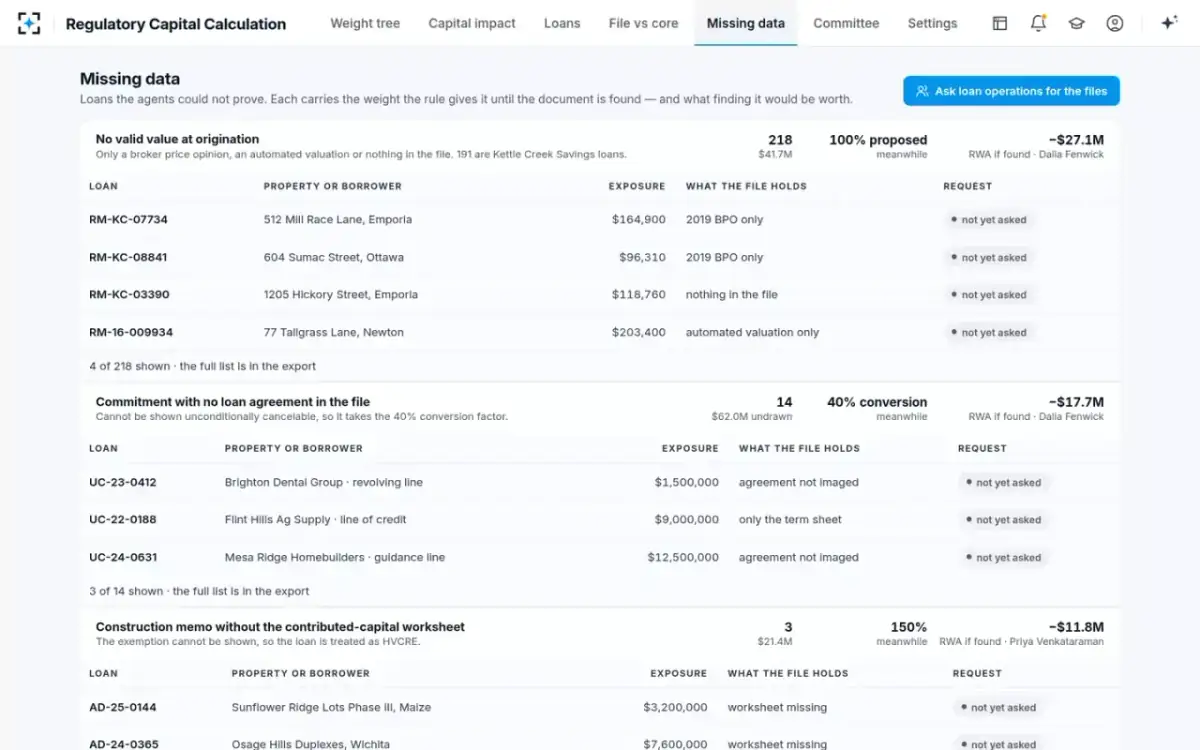

Missing dataLoans the agents could not prove, the weight used meanwhile, and the RWA at stake if the document is found.

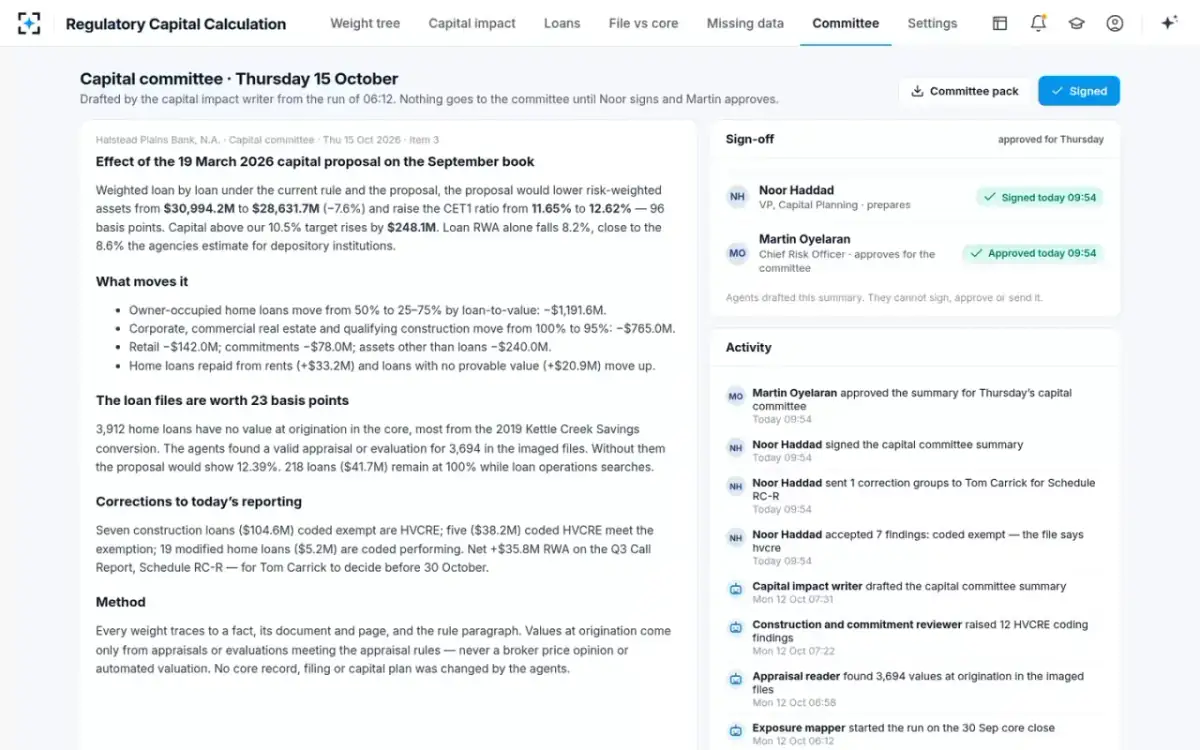

The committee summaryDrafted by the agents, signed by the capital planning lead and approved by the CRO.
Rules and evidence standardsRule versions, re-runs, what may prove a value at origination, which fact wins when file and core disagree, and materiality.
Governance

Controls that keep regulatory capital calculation software examiner-ready

Each weight cites its pageEach weight carries the fact that set it, the document and page it came from, and the rule paragraph. Each one opens from the loan.
Agents recommend, people decideThe capital planning lead accepts each finding and signs the summary. The Chief Risk Officer then approves it for the capital committee.
Overrides need a second personAn override of a weight needs a written reason and a second person’s approval. Until then, the agents’ weight stands.
Only approved rule versionsA rule version must be approved in Settings before any run can use it. The proposal is approved for impact runs only. A final rule is loaded as a new version, then approved.
The core, the filings and the plan stay unchangedAgents do not change a core record, the Call Report or the capital plan. Corrections to Schedule RC-R are the regulatory reporting manager’s decision.
Each step on the recordEach run, finding, override and signature is on the audit trail, with who did what and when.
Configuration

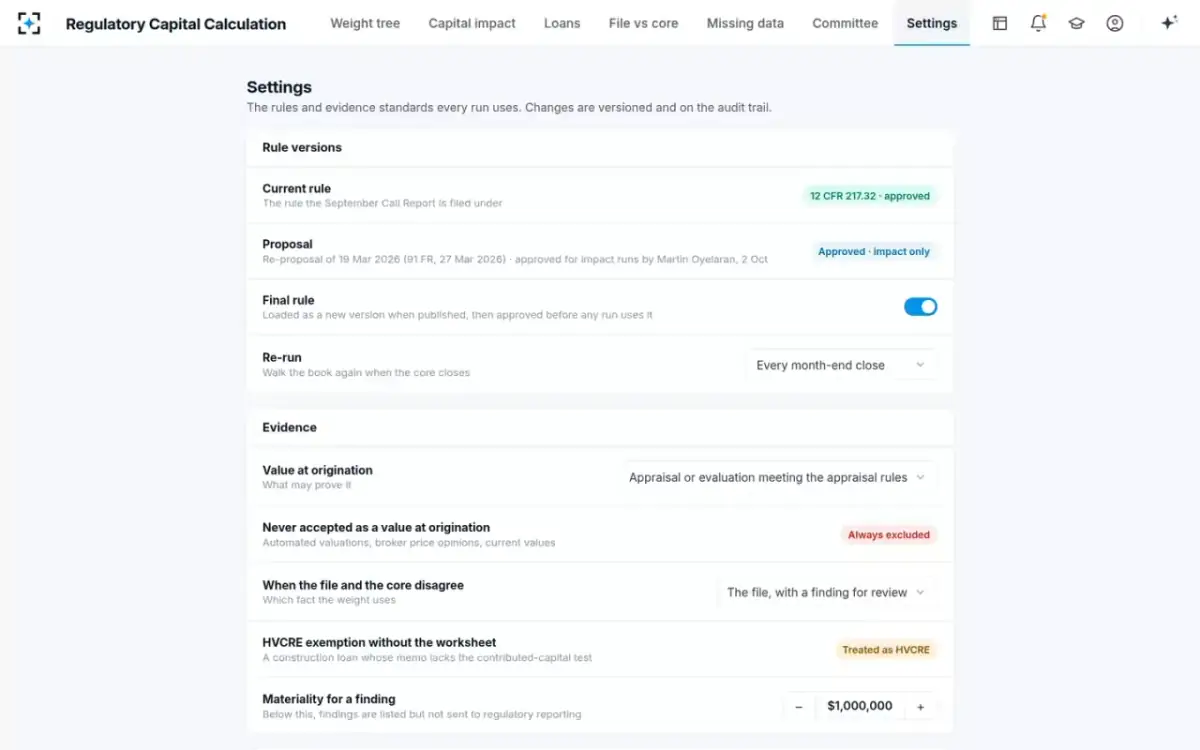

Which evidence proves a value, and which rule version each run uses

The rules and evidence standards each run uses. Changes are versioned and on the audit trail.

SettingDefaultChoose from
Rule versionsCurrent rule 12 CFR 217.32 · proposal of 19 Mar 2026 for impact runsFinal rule loaded when published and approved before use. The book is re-run once it is approved.
Re-runEvery month-end closeEvery month-end close · every week · only on request
What may prove a value at originationAppraisal or evaluation meeting the appraisal rulesAppraisal or evaluation · appraisal only
When the file and the core disagreeThe file, with a finding for reviewThe file · the core, each with a finding for review
HVCRE exemption without the worksheetTreated as HVCREFixed. The exemption must be shown from the worksheet.
Materiality for a finding$1,000,000. Below it, findings are listed but not sent to regulatory reporting.$250,000 to $5,000,000, in $250,000 steps
Internal CET1 target10.5%10.0 · 10.5 · 11.0%
Who signs and who approvesCapital planning lead signs · CRO approvesNamed people. An override needs an analyst and the capital planning lead.
Connections

Regulatory capital inputs from the core, the imaged files and the rule text

Your core systemloan, collateral and commitment data at each close
Imaged loan filesappraisals, evaluations, applications and modifications
Credit memos and loan agreementscontributed-capital worksheets and cancelability
Rule textthe current rule and the proposal, paragraph by paragraph
General ledgerCET1 capital as of the quarter end
Regulatory reporting systemRWA for assets other than loans
What it changes

Regulatory capital measured loan by loan, with corrections to today’s filing

Each figure carries its label: a target the solution is built to, an estimate, a typical published result, or a proven one.

typical
8.6%
lower risk-weighted assets the agencies estimate for covered banks
Current rule100
Proposal91.4
estimated
23bp
of CET1 found in the sample loan files: 3,694 values the core lacked
3,694 of 3,912 found
home loans with no value in the core
target
100%
of weights traced to a fact, its page and the rule paragraph
every weight defensible to an examiner

Tags: “demo” means seen in the working solution, on its sample bank data. “target” means the design goal, measured in the live solution. “estimated” means our estimate. “typical” means published figures. The source is the Fed, FDIC and OCC proposal of 19 Mar 2026 (91 FR, 27 Mar 2026). Its impact analysis shows −8.6% RWA for covered depository institutions. The HVCRE exemption is in 12 CFR 217.2 and 12 U.S.C. 1831bb (15% contributed capital). Names on the screens are sample data.

Questions

RWA and HVCRE questions on regulatory capital calculation software

What is regulatory capital calculation software?

Regulatory capital calculation software gives each exposure its risk weight under the capital rules. It totals risk-weighted assets and works out the capital ratios. Regulatory Capital Calculation does this loan by loan, under the current rule and the March 2026 proposal side by side. Its agents read each loan file for the facts the weights depend on.

How does it calculate risk-weighted assets under the proposal?

Every loan goes through the same tree of questions to reach a weight under each rule. The questions cover past due status, real estate security, construction, the HVCRE test, first lien, value at origination and repayment from rents. The risk weight calculator uses only approved rule versions and cites the paragraph. It totals RWA by segment and feeds the CET1 ratio.

What happens when the core has no value at origination?

The appraisal reader searches the imaged file for an appraisal or evaluation made at origination. On the sample data, 3,912 home loans had no value in the core, and it found valid values for 3,694. Sometimes it finds only a broker price opinion, an automated valuation or nothing. Then the loan stays at 100% and goes on the missing-data list.

Does it check HVCRE coding?

Yes. The construction and commitment reviewer reads the credit memo’s contributed-capital worksheet. It compares the capital contributed before the first advance with 15% of the as-completed value. A loan is never treated as exempt without the worksheet. Miscoded loans are raised as findings, with their effect on today’s Call Report.

Does the AI change our core system or the Call Report?

No. Agents do not change a core record, the Call Report or the capital plan. Accepted corrections are sent to the regulatory reporting manager, who decides any change to Schedule RC-R.

Who signs off before the numbers reach the capital committee?

The capital planning lead accepts each finding and signs the summary. The Chief Risk Officer approves it for the capital committee. An override needs a reason and a second person, and each step is on the audit trail.

What happens when the final rule is published?

It is loaded as a new rule version and approved before any run uses it. With the default settings, the book is run again once the final rule is approved, and at each month-end close. So the capital effect is measured again under the final rule.

What must we provide for a first run on our loans?

Your rule versions, evidence standards, approvers and a sample of loans with their files. The Agentic Solution Engine builds and deploys it from those requirements. It goes live once every quality gate has passed. We will walk you through it on your own loans first.

Run regulatory capital calculation
on a sample of your own loans.

We’ll run Regulatory Capital Calculation on a sample of your own loans and their files.
