- Before
- Checks premium for the batch as a whole. A wave can match in total and still have a hundred customers paying the wrong amount.
- Now
- Starts from each policy re-rated and compared step by step, with differences grouped by cause. Approves one rule per cause and signs first.

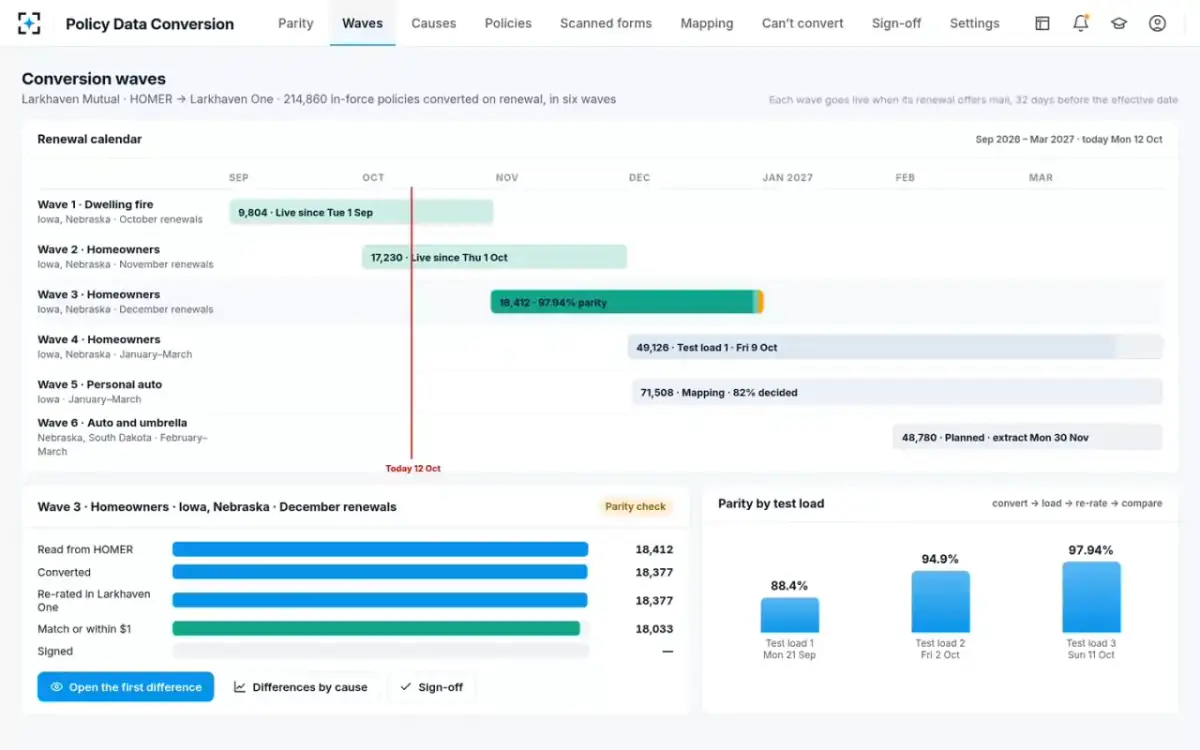

Wave 3 of a conversion done one renewal at a time, from test load to signature
The carrier is moving 214,860 in-force policies onto a new policy system. Today they sit on its in-house mainframe, in service since 1994. The move happens one wave of renewals at a time. Wave 3 is 18,412 Homeowners policies in two states, renewing in December. Renewal offers mail in under three weeks, and the wave freezes five days before that. Here is a Monday morning in the working solution, screen by screen.
A worked example on sample data. Names, IDs and figures on the screens and in this section come from the demo.
- 01Monday morning

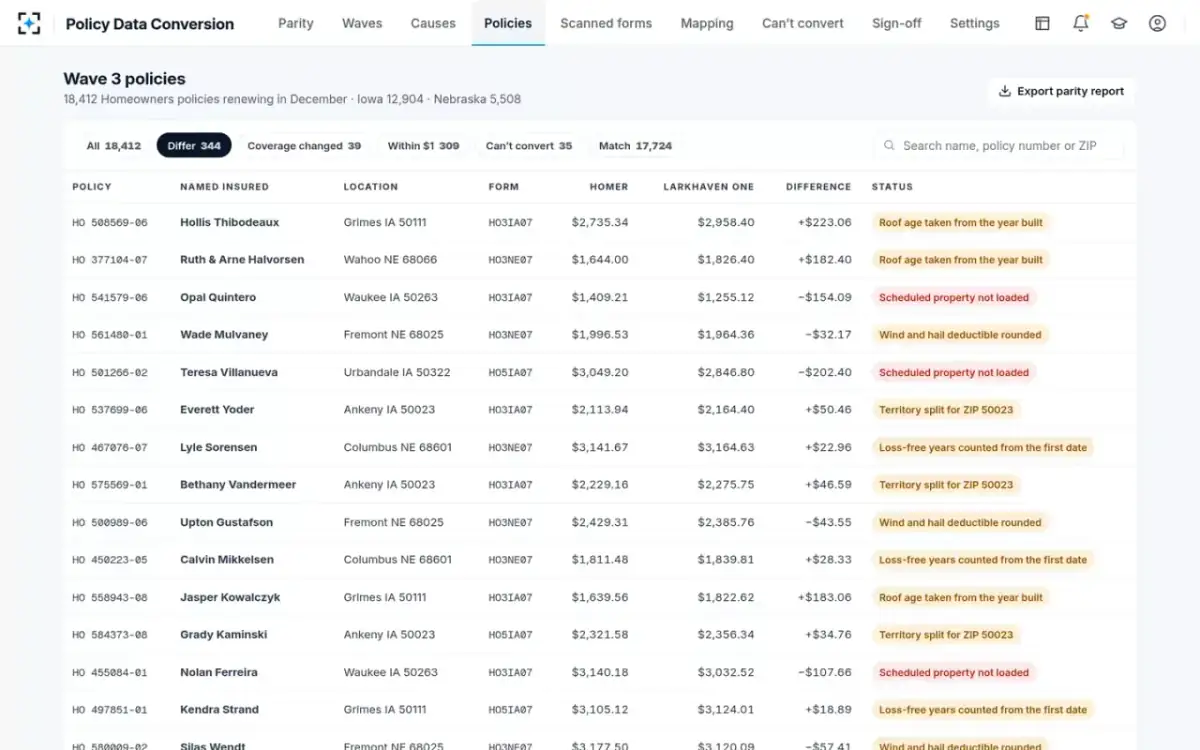

Test load 3, policy by policy

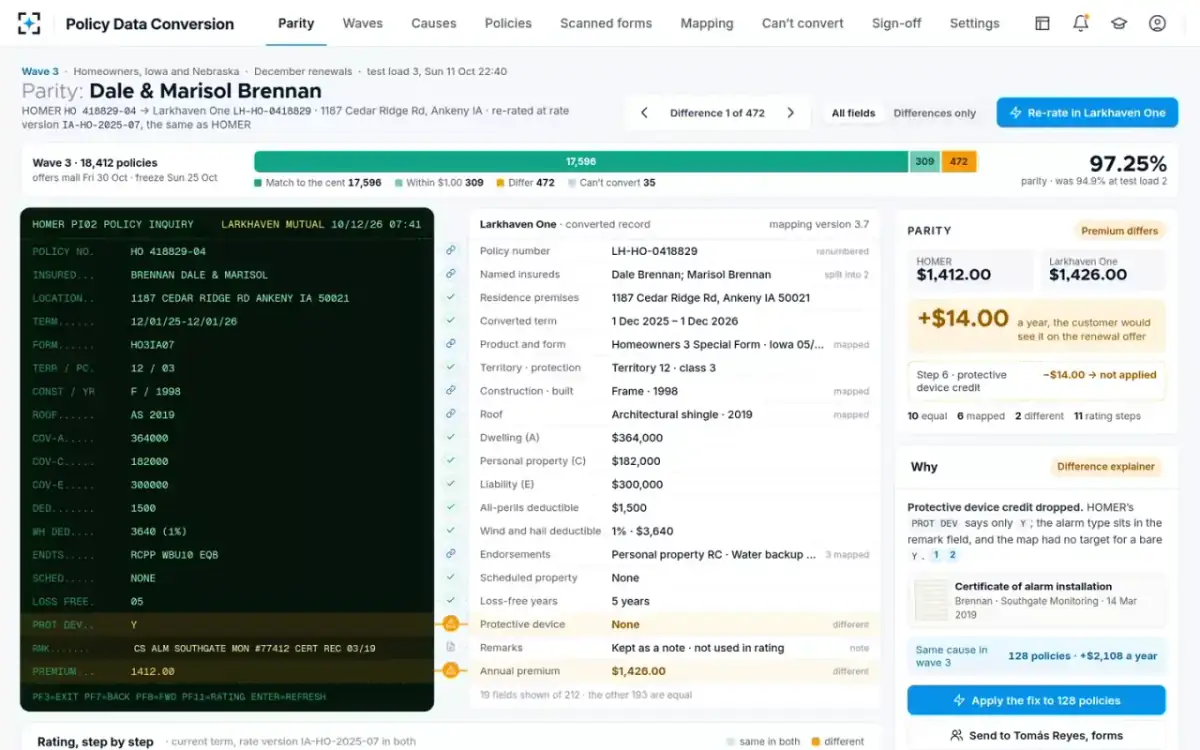

Conversion leadTest load 3 ran Sunday at 22:40. The wave ribbon sorts all 18,412 policies. Of these, 17,596 match to the cent, 309 are within the $1.00 rounding tolerance, 472 differ and 35 can’t convert. That is 97.25% parity, up from 94.9% at test load 2. The net difference is +$11,207 a year, and that small total hides the 472 policies that do not match. One family’s home is the first difference. The old green screen is on the left and the new system’s record is on the right, lined up field by field.
“+$14.00 a year, the customer would see it on the renewal offer.”
- 02One click
Re-rated in the new system, step by step

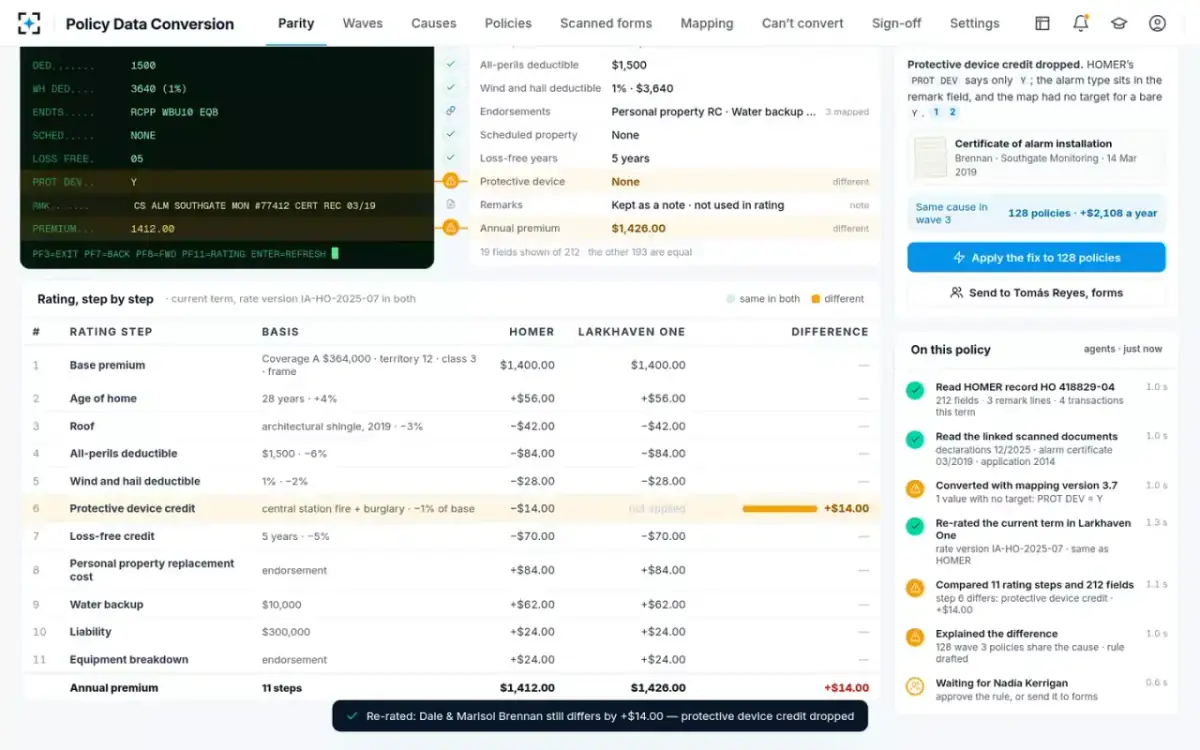

Parity checkerThe conversion lead presses “Re-rate in the new system”. The current term is rated again at the same rate version the old system used. All 11 rating steps are compared. Ten are equal. Step 6, the protective device credit, is −$14.00 in the old system and missing in the new one. The run log says why. The policy was converted with mapping version 3.7, and one value had no target: PROT DEV = Y.
The comparison runs only at the same rate version, so a rate change is not mistaken for a conversion error.
- 03Traced

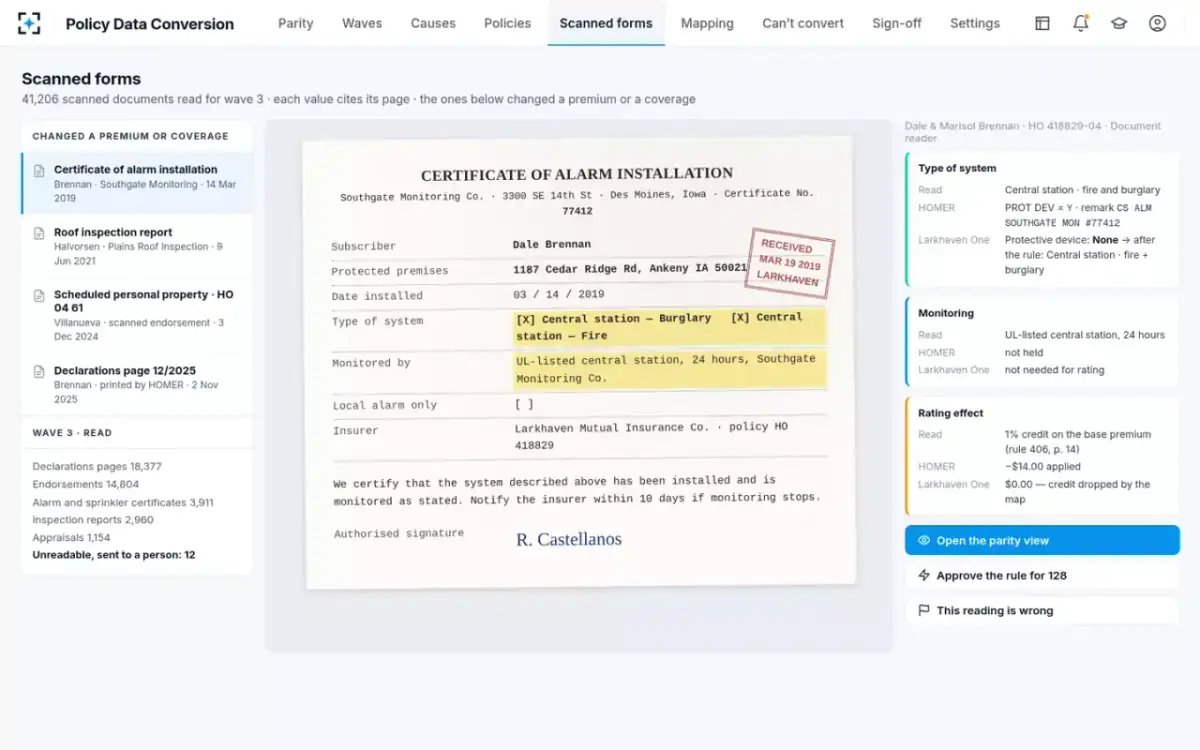

The credit was in a remark and on a scan
Difference explainer · Document readerThe old PROT DEV field says only Y. The alarm type is in a remark line instead. That line names a central-station monitoring company and says a certificate was received. The scanned certificate of alarm installation shows central-station burglary and fire monitoring. Under rule 406 of the rule manual, that earns a 1% credit on the $1,400.00 base premium.
“Protective device credit dropped. The legacy PROT DEV says only Y; the alarm type sits in the remark field, and the map had no target for a bare Y.”
- 04Decided
One rule for each policy with the same cause

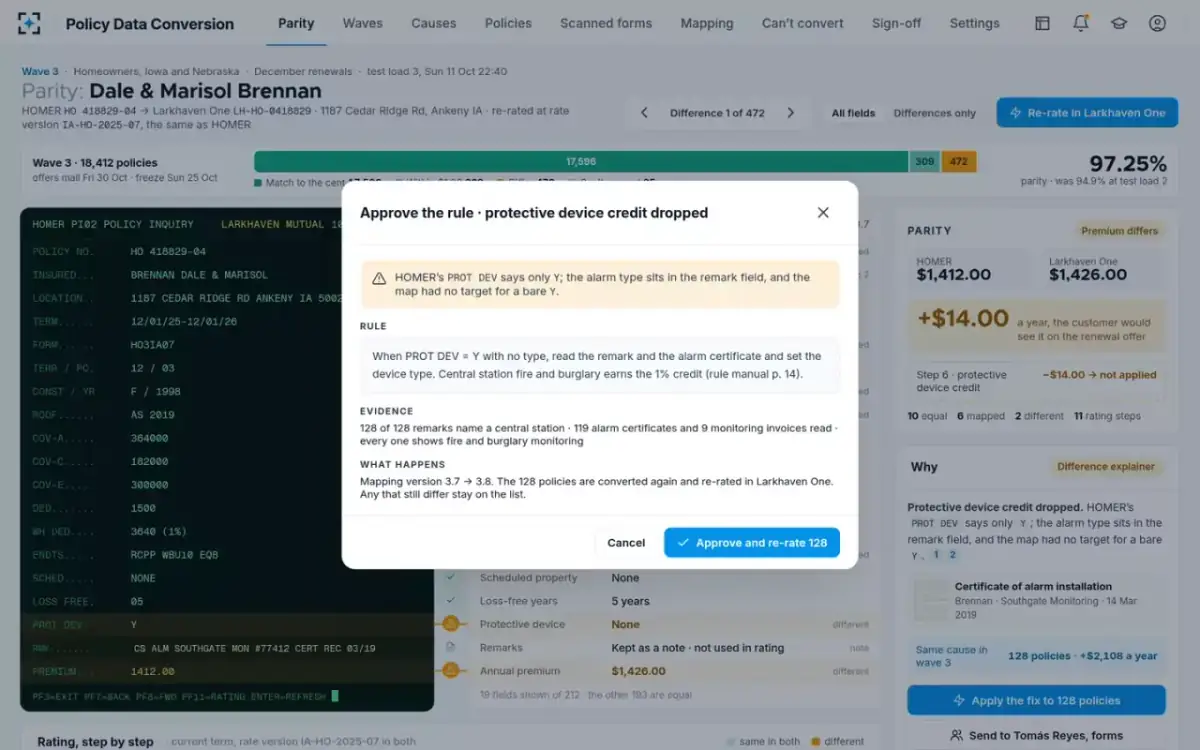

Conversion leadThe same cause runs through 128 wave 3 policies, worth +$2,108 a year. The proposed rule shows its evidence: all 128 remarks name a central station. The 119 alarm certificates and 9 monitoring invoices all show fire and burglary monitoring. Approving the rule moves the map from version 3.7 to 3.8. Any policy that still differs stays on the list.
“When PROT DEV = Y with no type, read the remark and the alarm certificate and set the device type.”
- 05Re-rated
128 of 128 match to the cent

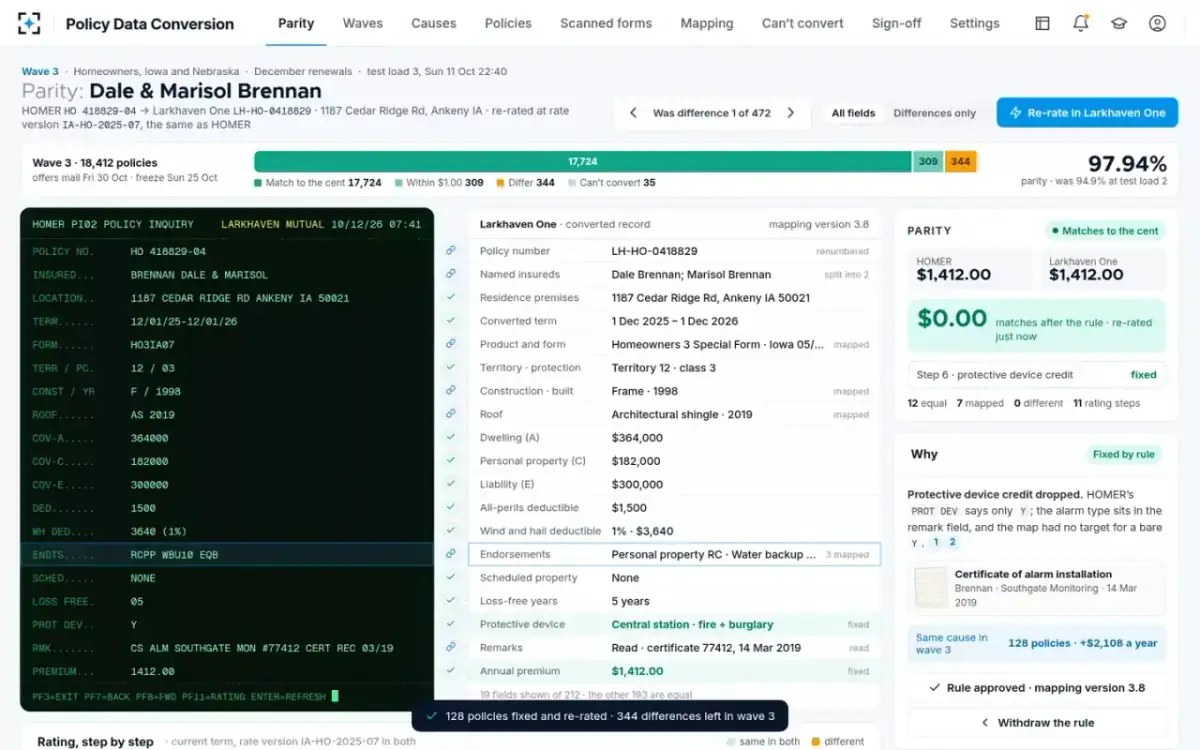

Parity checkerAll 128 policies are converted again and re-rated at the old rate versions. The first home now reads $1,412.00 on both sides. Its protective device reads “Central station · fire + burglary”. Wave 3’s differences fall from 472 to 344, and parity moves to 97.94%.
“128 policies fixed and re-rated · 344 differences left in wave 3.”
- 06Next

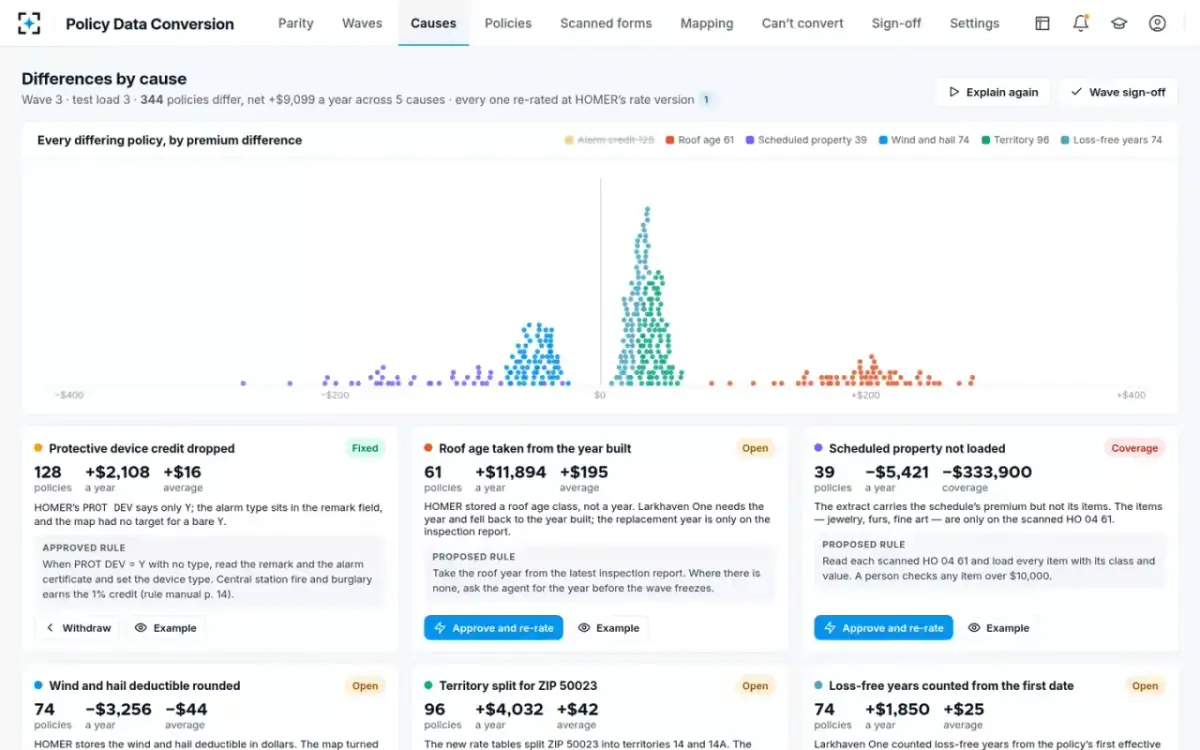

The other differences, by cause
Difference explainerThere are still 344 policies that differ, net +$9,099 a year, under five causes. Each cause has a count, an average, an example policy and a drafted rule. One is roof age taken from the year built: 61 policies, about +$195 each. On one of them the roof had been replaced. But the age came from the year the house was built, so $1,644.00 became $1,826.40. Another is a 1.5% wind and hail deductible rounded to 2%. A third is one ZIP code split into territories 14 and 14A, which moved 96 homes.
A rule changes the conversion and leaves the rate alone, and a person approves each rule.
- 07Coverage

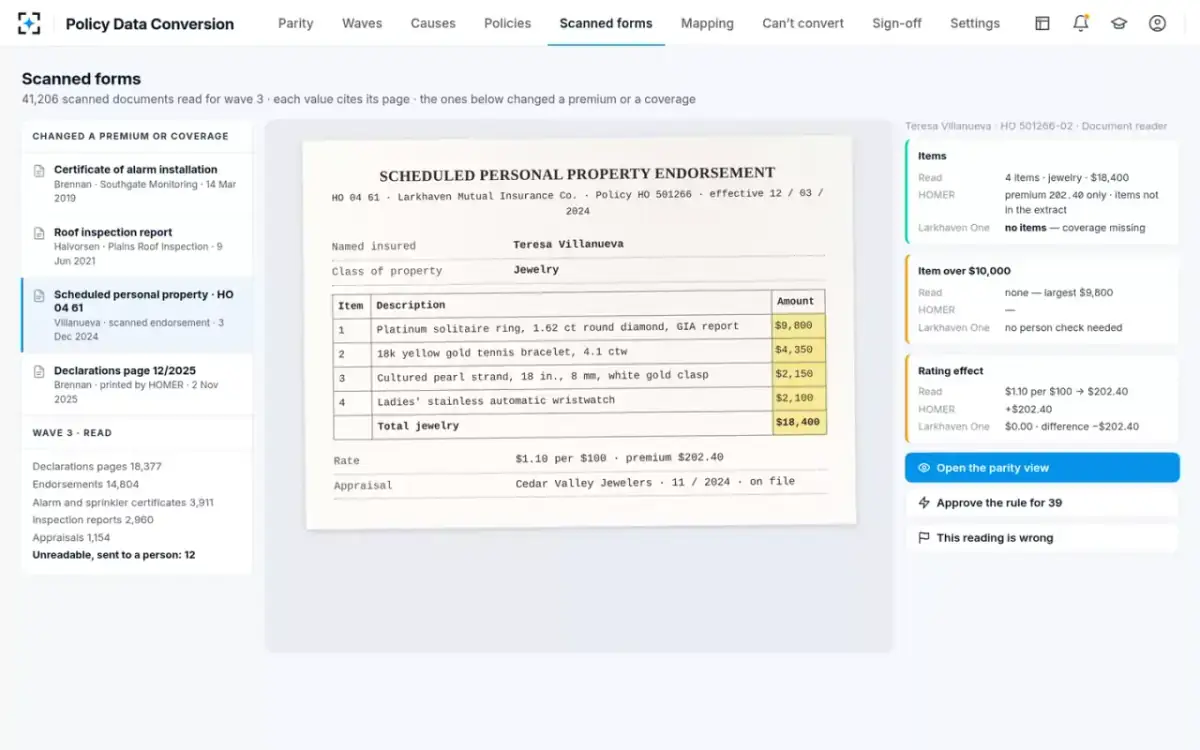

A jewelry schedule missing from the extract
Document readerOne insured’s HO 04 61, the form that lists valuables covered item by item, shows four jewelry items worth $18,400. The extract carried the schedule’s $202.40 premium but not the items. So the new system has no items, and the coverage is missing. The same is true on 39 policies, with $333,900 of scheduled property in all. The rule reads each scanned HO 04 61 and loads each item. A person checks any item over $10,000.
“Coverage differs. It cannot be accepted; approve the rule.”
- 08Doubtful
The map, with unclear values left to people

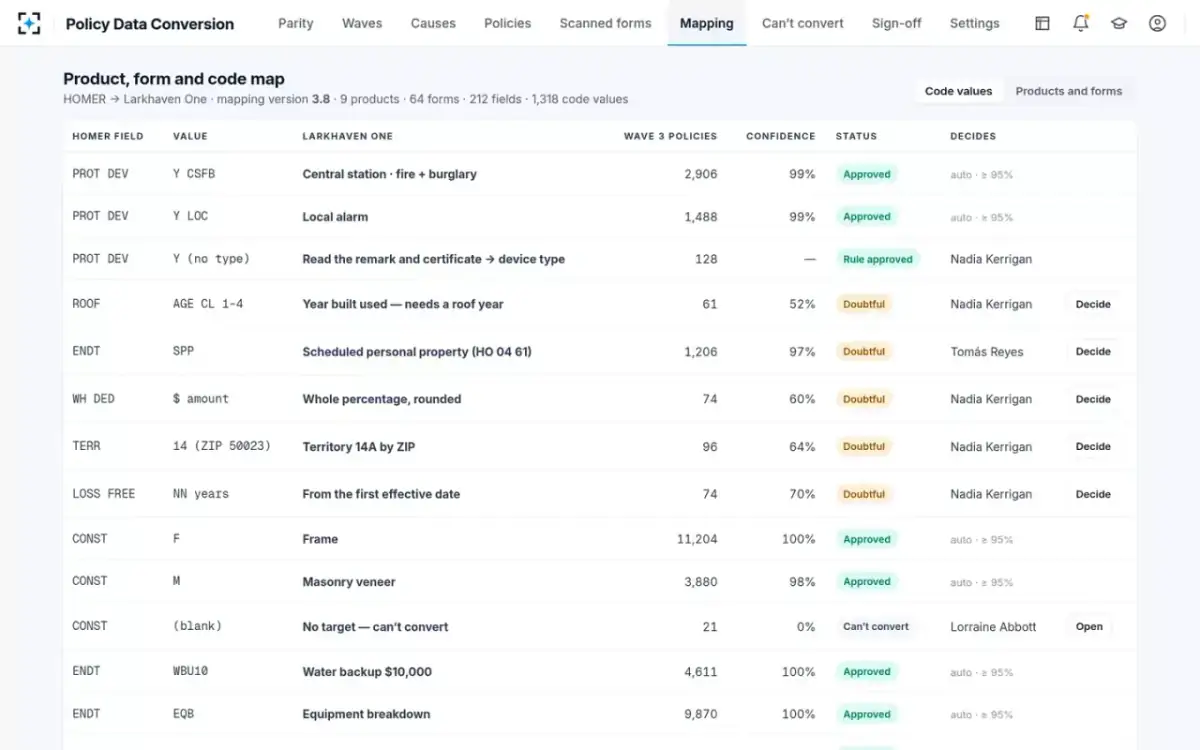

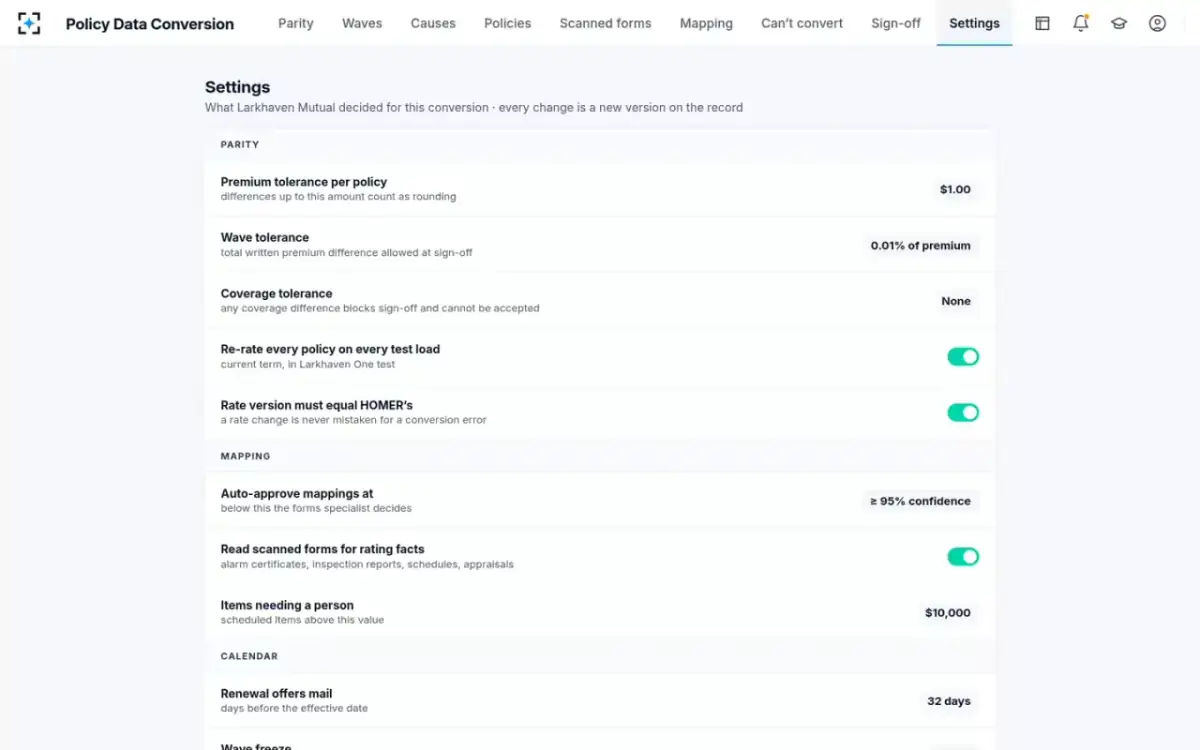

Product and forms specialistMapping version 3.8 covers 9 products, 64 forms, 212 fields and 1,318 code values. Values at 95% confidence or more are approved on their own. The rest wait for a named person. ENDT SPP to Scheduled personal property (HO 04 61) waits for the forms specialist. The roof age class, the wind and hail deductible, the split territory and the loss-free years wait for the conversion lead. Each decision is versioned.
- 09Exceptions

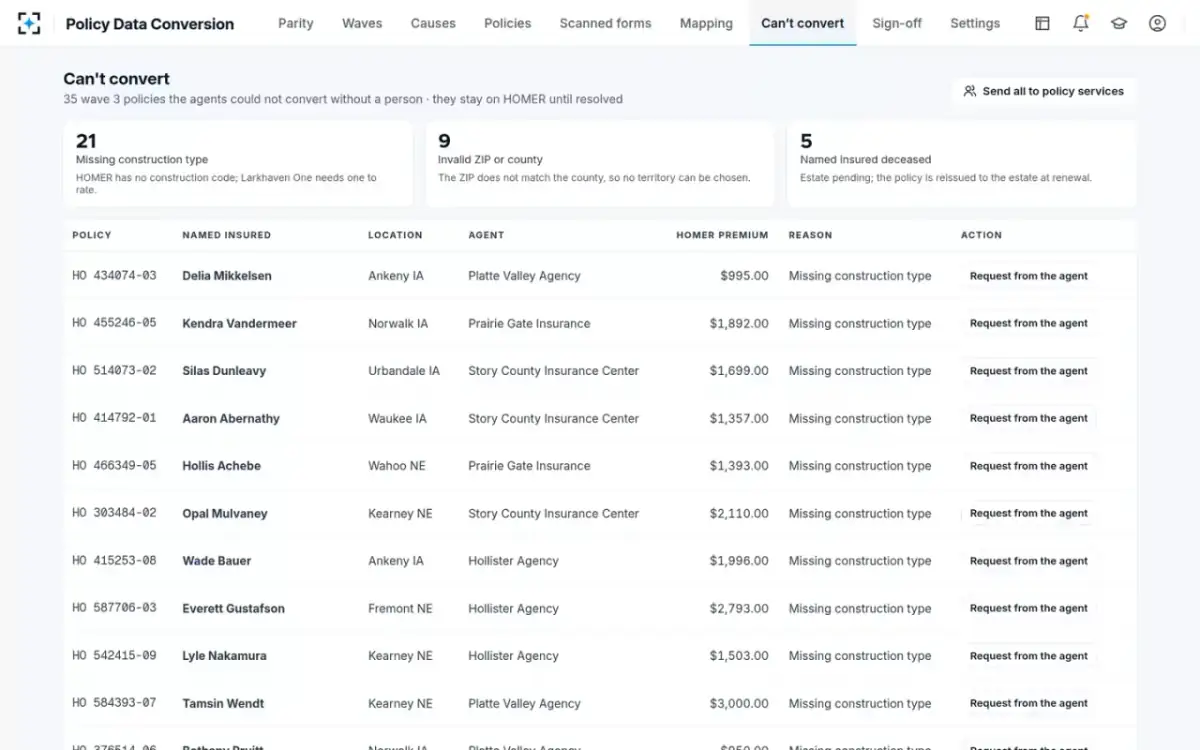

35 policies that need a person
Policy services leadOf the policies that can’t convert, 21 have no construction type and 9 have a ZIP code that does not match the county. On 5, the named insured has died and the estate is pending. These policies stay on the old system until resolved. Each one shows its agency and an action. The action is to ask the agent, correct the address, or convert by hand at renewal.
- 10Before the freeze
The wave signs only when it ties out

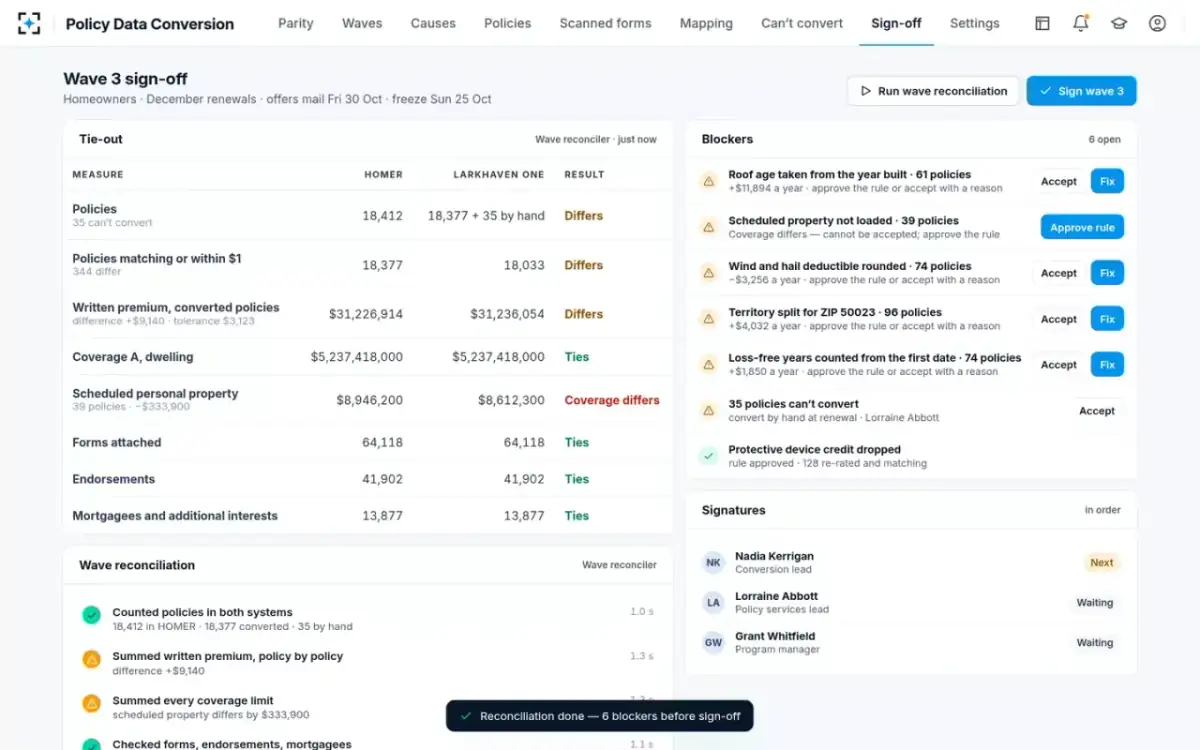

Program managerThe Wave reconciler checks wave 3 measure by measure. Coverage A (the house itself, $5,237,418,000), forms, endorsements and mortgagees all match. Written premium is +$9,140 against a $3,123 tolerance, and scheduled property is $333,900 short. Six blockers are listed, each with its owner. The signatures go in order. First the conversion lead signs, then the policy services lead, then the program manager.
“Wave 3 signs when each policy ties out, or each open item is accepted with a reason. Coverage differences cannot be accepted.”
