- Before
- Builds each pack by hand from the job plan library, the drawing store, GIS, the permit portal, the one-call center and stores. Can spend a day on a pack, then learn on the morning that the permit ran out.
- Now
- Opens a pack the agents built overnight and sees each dated item against the job day. Fixes only what is flagged, then releases it.
Work package preparation for one ring main unit replacement
A utility has to replace an old 11 kV ring main unit with a condition score of 2 out of 10. One crew is booked for a Tuesday, 07:00 to 15:00. The work cuts power to 212 customers from 08:00 to 14:00. Two of them are on the priority services list, for customers who need extra help in an outage. Here is what happens, screen by screen, in the working solution.
A worked example on sample data. Names, IDs and figures on the screens and in this section come from the demo.
- 01Approved for planning

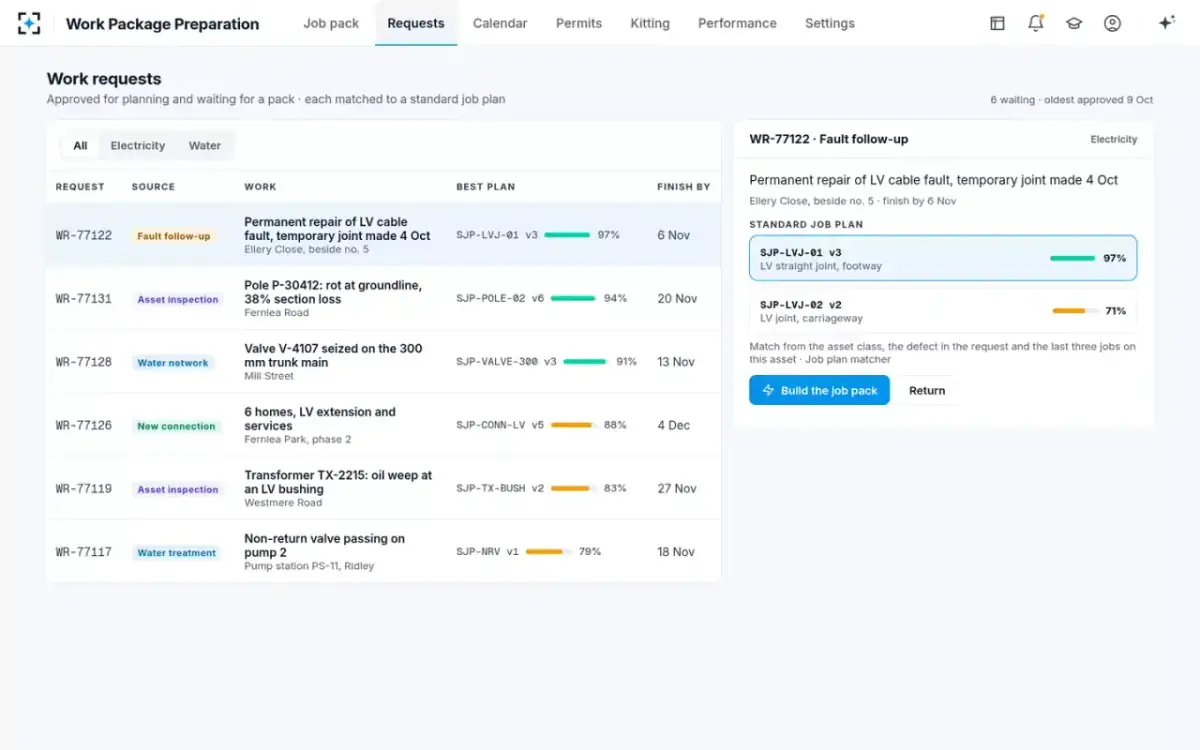

Each request arrives matched to a standard job plan
Job plan matcherThe head of work planning approved the work request for planning at 16:40. The Requests screen lists each request waiting for a pack: fault follow-ups, asset inspections, new connections, and water network and treatment jobs. Each one already shows its best standard job plan and a match score. For one LV cable fault, the best match is the plan for a straight joint in the sidewalk, version 3, at 97%. The roadway joint comes second at 71%.
“Match from the asset class, the defect in the request and the last three jobs on this asset · Job plan matcher”

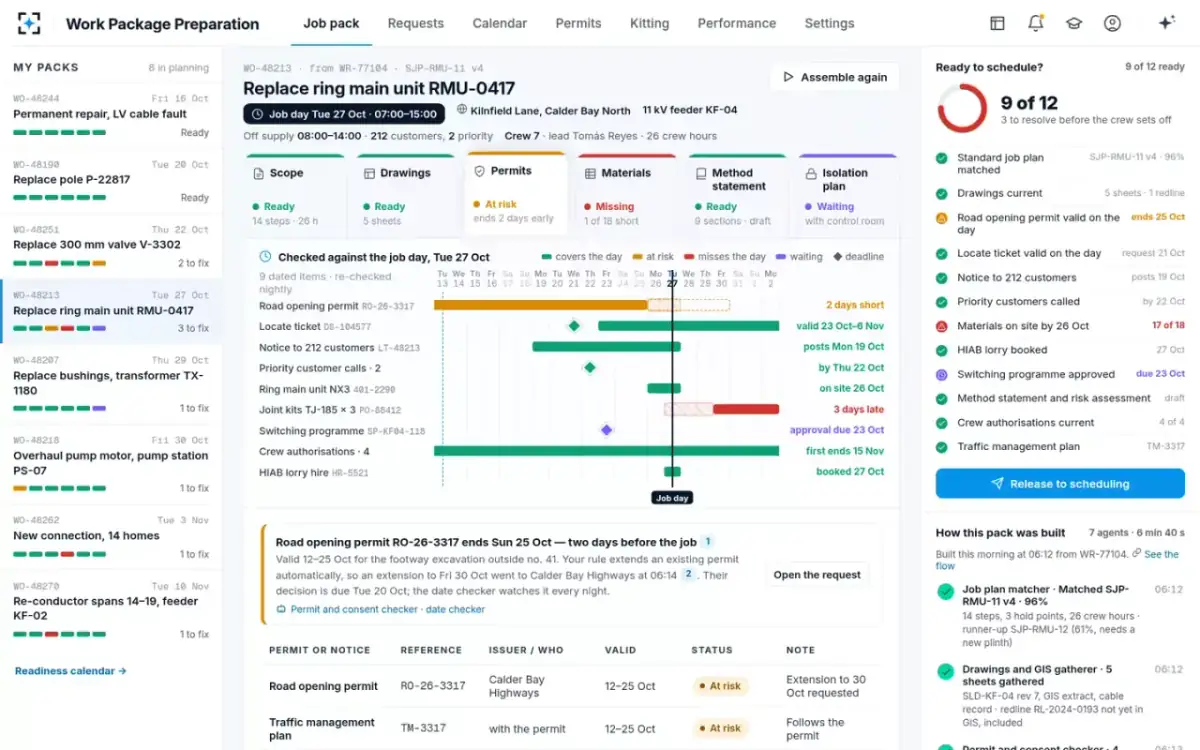

- 0206:12

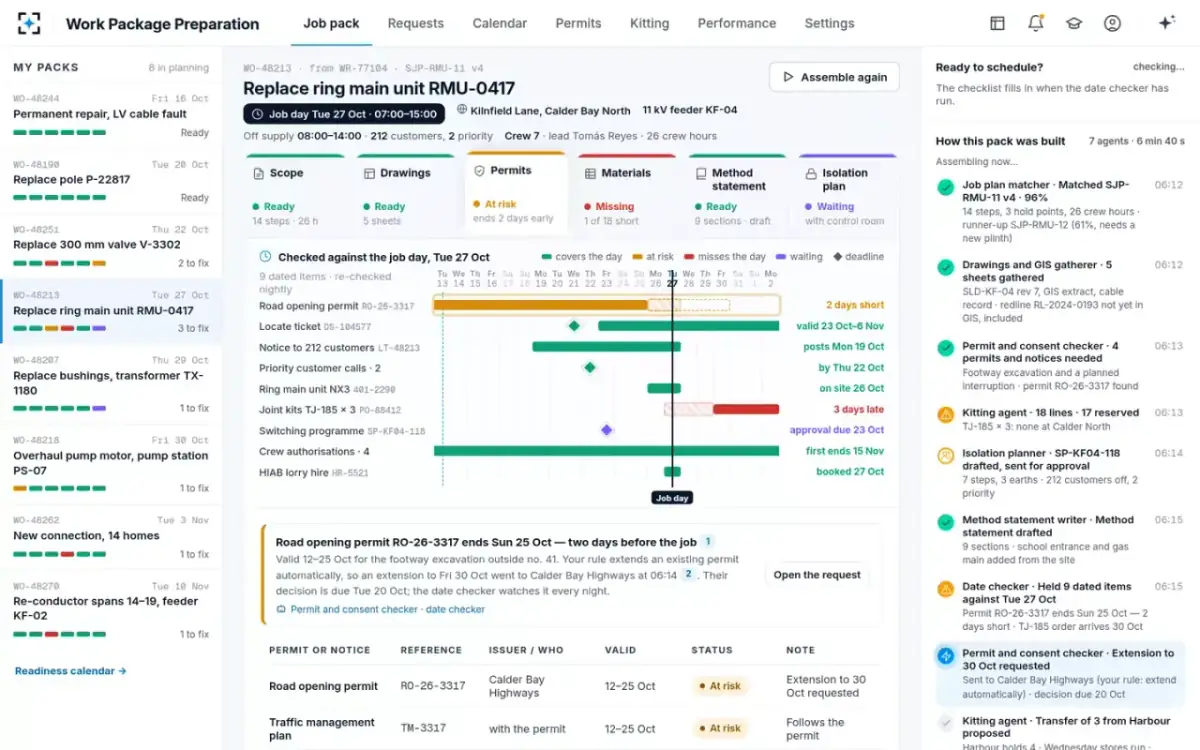

Seven agents build the pack at 06:12
Seven agentsThe agents put the pack together from the work request in 6 min 40 s, and the run log shows each step as it happens. The job plan matcher takes the ring main unit plan, version 4, at 96%. The drawings gatherer collects five sheets. The permit and consent checker finds four permits and notices. The kitting agent reserves 17 of 18 lines. The isolation planner drafts the switching program and sends it to the control room. Then the date checker tests nine dated items against the job day.
“Date checker. Held 9 dated items against the job day. Road opening permit ends 2 days short. Joint kit order arrives after the job”
- 0309:05

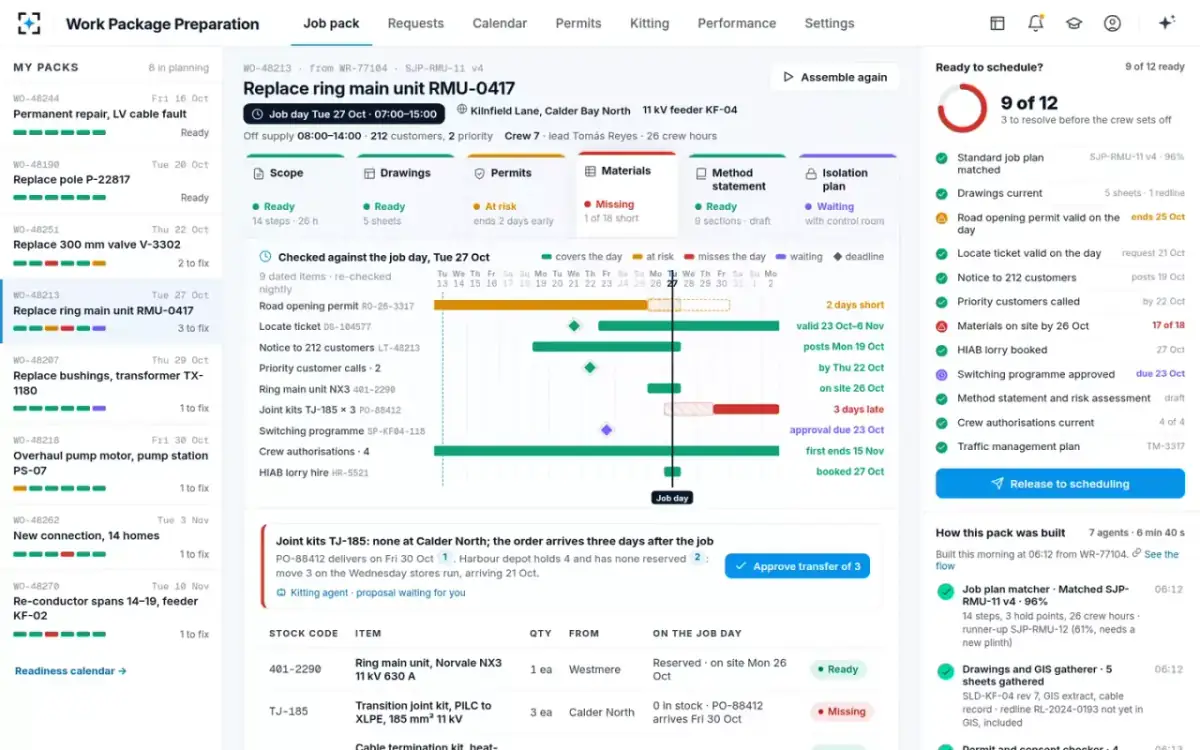

Six tabs and a date line, checked against the job day

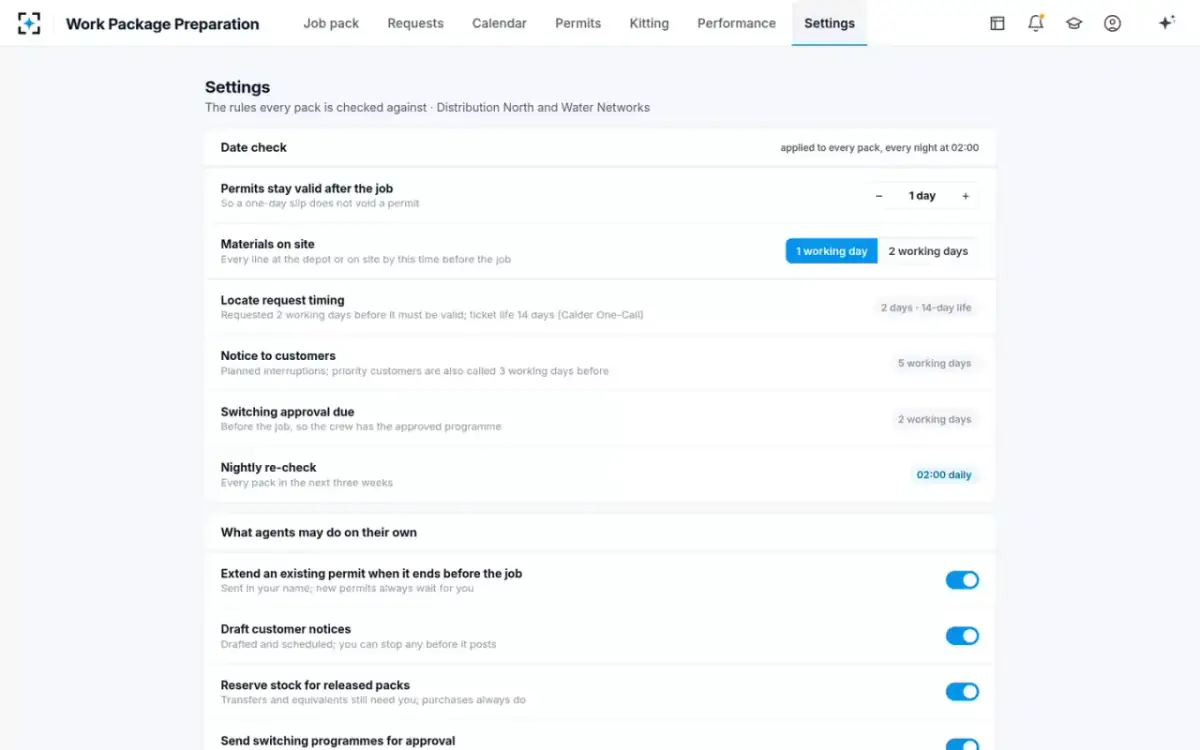

Work plannerThe pack opens as six tabs: Scope, Drawings, Permits, Materials, Method statement and Isolation plan. Each is marked ready, at risk, missing or waiting. Below them, a date line runs from today to past the job, with the job day marked. The road opening permit ends two days before the job, so its bar stops short. The planner's rule extends an existing permit automatically. So a request to extend it to three days after the job went to the highways department at 06:14. A decision is due a week before the job.
9 of 12 ready · “3 to resolve before the crew sets off”
- 04Scope tab

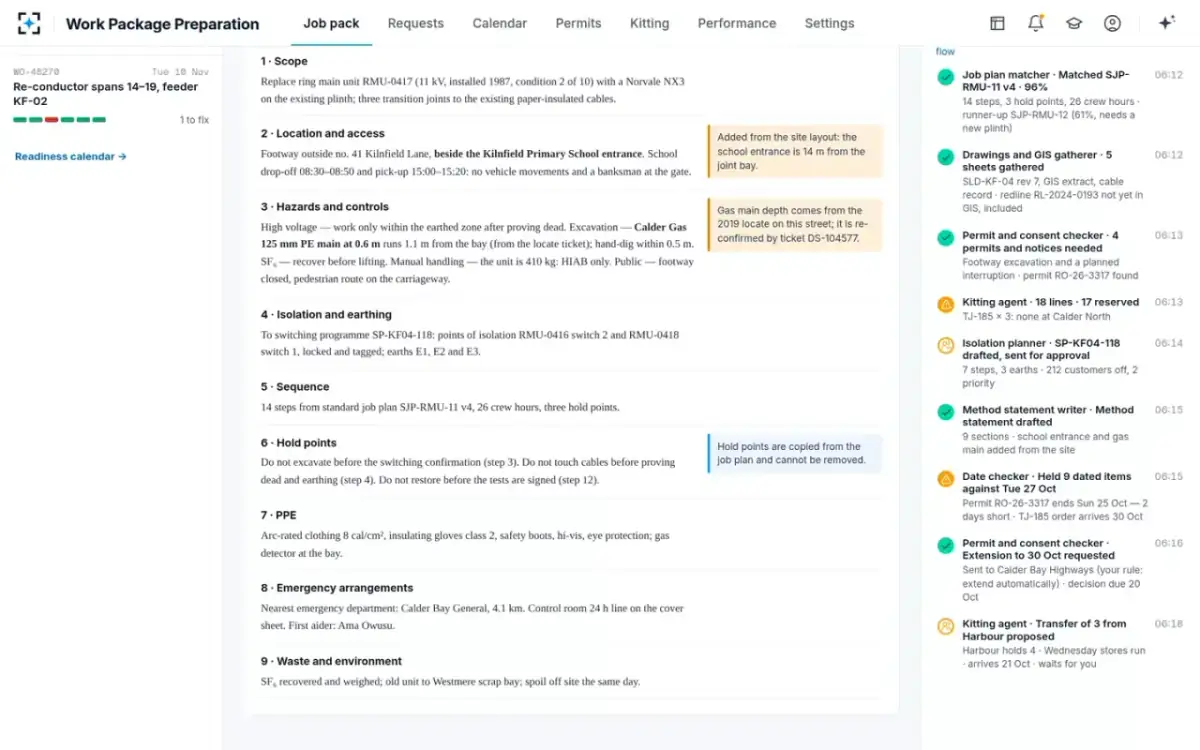

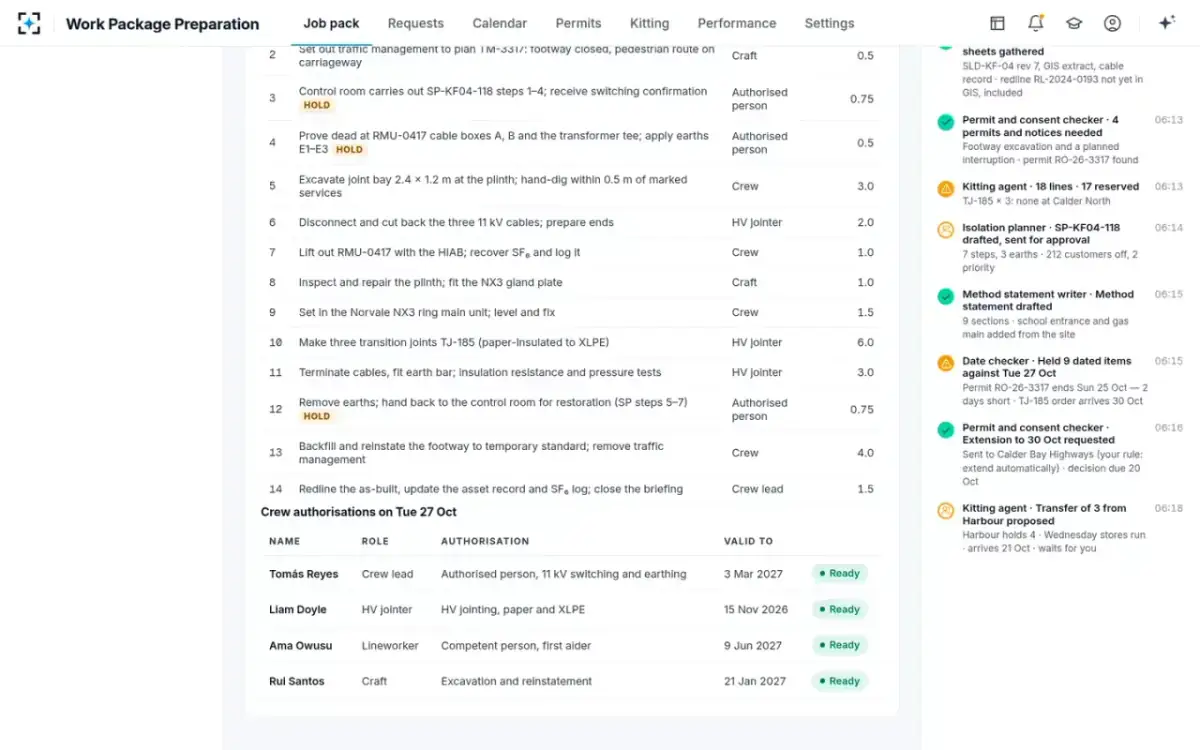

14 steps, three hold points and four authorizations checked
Job plan matcherThe scope comes from the ring main unit job plan: 14 steps and 26 crew hours. It runs from the pre-job briefing to marking up the as-built drawing and logging the SF₆ gas. Three hold points, where work must stop for a check, are marked. They are switching confirmation, proving dead and earthing, and signed tests before power goes back on. Each crew member's authorization is checked for the job day. The crew lead is authorized for 11 kV switching and earthing, and the jointer for HV jointing. Both are valid past the job.
“Copied from the job plan; hold points cannot be removed”
- 05Materials tab
Three joint kits short, and three at another depot
Kitting agentThe new ring main unit is reserved and will be on site the day before the job. But the home depot has no transition joint kits, and the purchase order arrives three days after the job. Another depot holds four with none reserved. The kitting agent proposes moving three on the Wednesday stores run, but it cannot do this alone. The planner approves, and the transfer arrives six days before the job.
“Transition joint kits: none at the home depot; the order arrives three days after the job”
- 06Method statement
The site's hazards, written into the method
Method statement writerThe method statement comes in the utility's template, with nine sections, as a draft for the crew lead to review. The writer adds what only this site shows. The joint bay is 14 m from a primary school entrance. So no vehicle moves during drop-off and pick-up, and a spotter stands at the gate. A 125 mm plastic gas main runs 0.6 m deep, 1.1 m from the bay. The crew digs by hand within 0.5 m of it.
“Hold points are copied from the job plan and cannot be removed.”
- 07With the control room

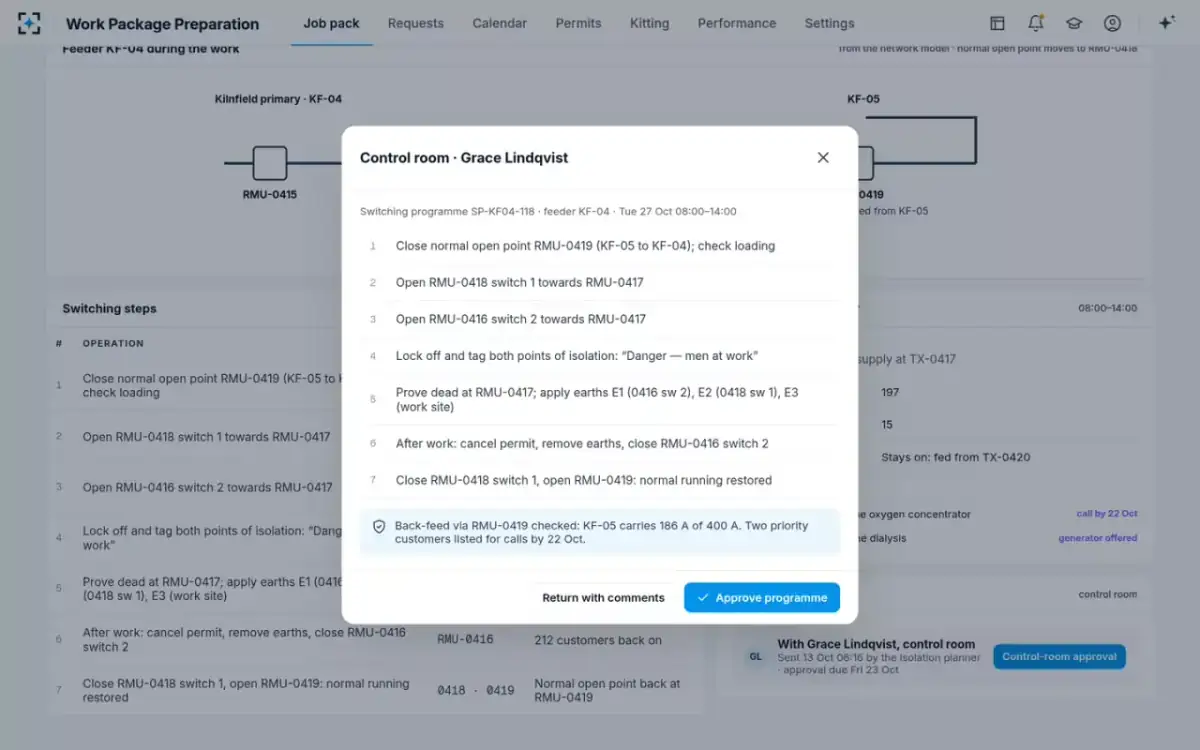

The authorized engineer approves the switching

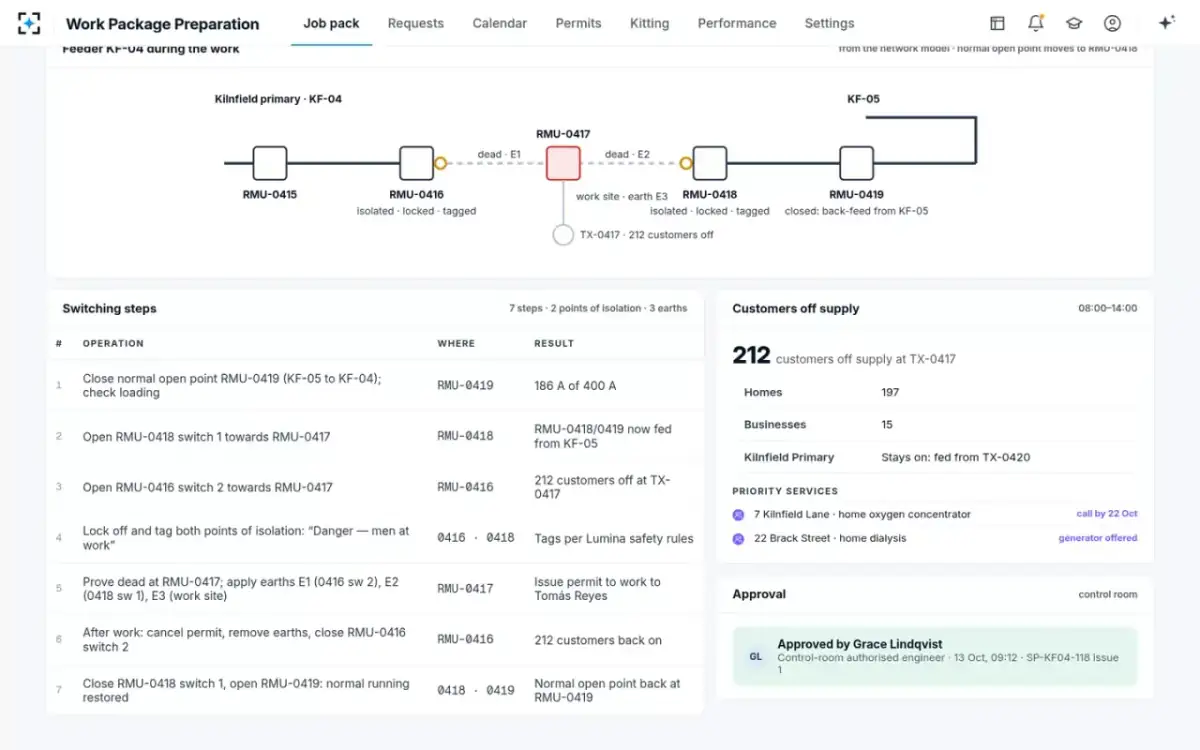

Control-room authorized engineerThe isolation planner drafted the switching program from the network model. It closes the normal open point at the next ring main unit and opens the units on each side of the work. It locks off and tags both points of isolation, proves the equipment dead and applies earths E1, E2 and E3. The engineer sees the back-feed already checked, with the neighboring feeder carrying 186 A of 400 A. Both priority customers are listed for calls five days before the job. The engineer approves, or returns it with comments.
The isolation planner does not issue a switching program. Only the control-room authorized engineer approves it.
- 08Approved · 09:12
Who loses power, and who is called first
Isolation plannerThe isolation plan shows the feeder during the work and the 212 customers off at the transformer: 197 homes and 15 businesses. The school stays on, fed from a neighboring transformer. Two priority services customers are listed by address. One uses a home oxygen concentrator and one has home dialysis. Each has a call booked and a generator offered. The planned outage letter to all 212 goes out five working days ahead.
“Approved by the control-room authorized engineer · 09:12 · issue 1”
- 09Release

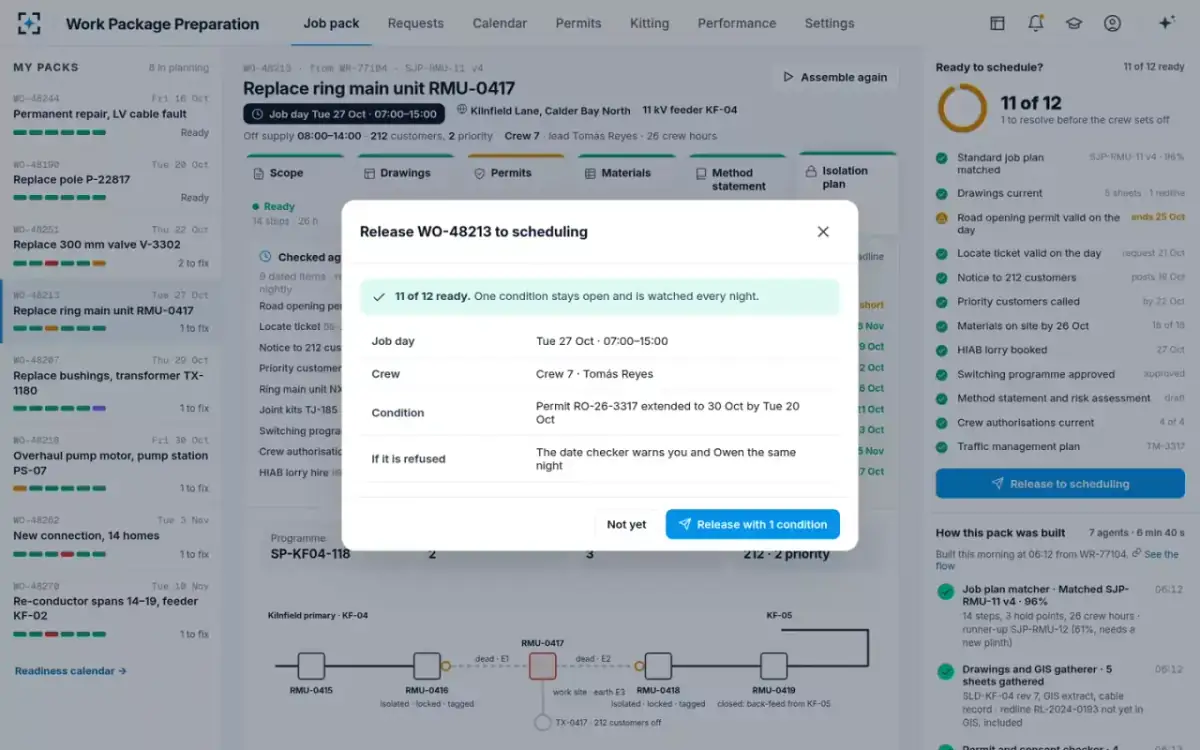

Released to scheduling with one open condition, checked each night
Work plannerEleven of 12 checks are ready. The permit extension is still open. So the planner releases the work order to the scheduler for the job day with one condition: the road opening permit must be extended. The answer is due a week before the job. If the highways department refuses, the date checker warns the planner and the scheduler that same night. That still leaves a week before the crew sets off.
“If it is refused, the date checker warns you and the scheduler the same night”
- 10The evening before

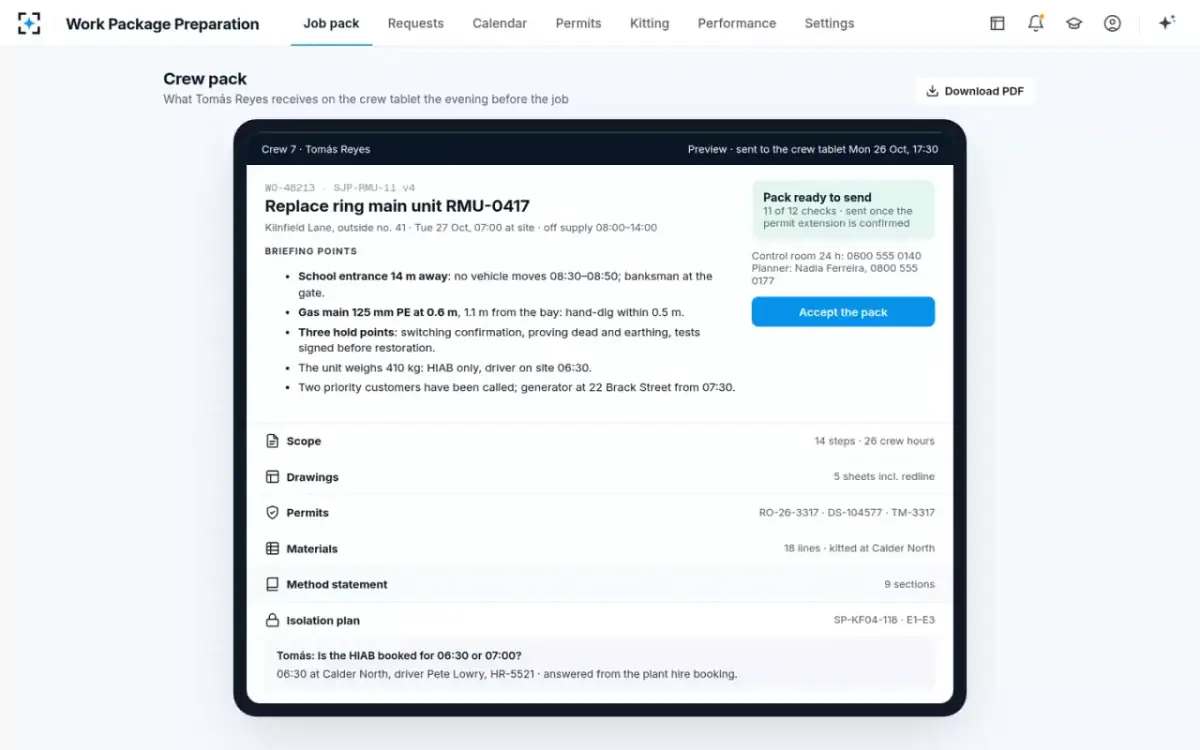

The crew lead gets the whole pack on the tablet
Crew leadThe crew lead gets the crew pack the evening before. It has the cover sheet, five briefing points and the six sections behind them. The points cover the school entrance, the gas main and the three hold points. They also cover the 410 kg unit, lifted only by HIAB crane, and the priority customers already called. The crew lead asks whether the HIAB is booked for 06:30 or 07:00. The answer comes from the plant hire booking, and the crew lead accepts the pack.
“06:30 at the depot, with a named driver · answered from the plant hire booking.”
