WorkflowField Service & Work Management

Locate Request Screening

Locate request screening that clears the no-conflict tickets and puts a standby on every machine dig over a 33 kV+ cable or trunk main

See one case, screen by screen ↓
Watch with transcript →

Built forDamage prevention teamsLocate techniciansCable engineersWater network engineers

The Problem Today

Coordinators check each dig ticket on a map by hand, so locators drive to digs that touch nothing of theirs.

221,717
damages to buried utilities reported in the US in 2025 published

Read by hand, ticket by ticket

  • Ticket
  • Dig area
  • Dig method
  • Asset depth
  • Dig and cable depths not comparedA deep dig over a high-voltage cable gets paint only
  • A legal clock per ticketA deadline to answer each one, with hundreds on the board at once

The Solution

  1. Each dig drawn on the mapThe dig area and a buffer laid over buried cables and mains
  2. Risk scored from depthDig method and depth weighed against each asset's recorded depth
  3. Clear tickets answeredNo-conflict replies sent with the reason, and a share checked by a person
  4. The engineer approvesThe coordinator confirms standbys, and a cable engineer approves work near high voltage

Built-in controls

  • Standby floors that no score can lower
  • Each outcome cites its inputs
  • Risk rules versioned and approved

What You Get

Locators spend more of the day on digs where a strike could happen, and fewer trucks go to empty ones.

  • Replies inside the response clockNo-conflict replies go back in minutes
  • Repeat strikers flaggedAn excavator's strike history adds to each new score
  • Locators matched by skillHigh-voltage work goes only to qualified locators
In short

What is Locate Request Screening?

Locate request screening is the check a utility makes on each one-call (811) excavation ticket before it answers. It checks whether anything of the utility's is inside the dig, and how dangerous the work is. Locate Request Screening does that check with five agents. They send the no-conflict replies and rank the rest by risk. They draft a standby crew and pre-dig meeting for each machine dig within 3 m of a 33 kV+ cable or 300 mm+ trunk main. The damage prevention coordinator decides.

How to choose AI solutions for utilities →

Updated

The problem

Dig tickets are checked by hand, so trucks go to empty digs and risky ones look routine

Before anyone digs in a utility's service area, they file a ticket with the one-call center. The ticket says who is digging, where, how and how deep. The utility must answer each ticket before a legal deadline. At the sample utility's one-call center, that is two working days. The answer is either “clear, nothing of ours here” or “we will mark it”. At a large utility, a coordinator still opens most tickets by hand. They find the dig on the GIS viewer, the utility's digital map of its assets, and check each layer. With 700 tickets on the board, nobody can look at each one closely. So any doubt becomes a truck roll, a locator sent out to find and paint the buried lines. The utility sends a locator to 61% of tickets, but only 29% have one of its assets within the safe-dig buffer.

Meanwhile, the digs that could kill someone look routine. The ticket says “tracked excavator, 1.8 m”. The asset record says “132 kV, 1.1 m”. Nobody reads the two together, so the dig gets paint marks and nobody on site. Britain's safety guidance, HSE's HSG47, says power tools should stay 500 mm or more from a buried line's marked position. The line should first be found by careful hand digging and trial holes. In CGA's DIRT data for 2023, 41% of damage root causes came down to three things. Excavators did not keep clearance, locators made errors, or crews dug before potholing, the small test hole that shows where a line really is.

typical196,977reportsunique reports of damage to buried facilities in CGA's DIRT data for 2024, and the industry is not on track to halve damages
typical41%of damage root causes in 2023 were clearance not kept, locator error or digging before potholing
estimated$250-500a visitthe cost of one truck dispatch, in a vendor's figure
Where the working days go, for each 1,000 ticketsestimated
By hand46 days
With the solution20.6 days
  • Reading each ticket and checking it on the map4 → 0.5 d
  • Writing and sending no-conflict replies1 → 0.1 d
  • Locator visits to digs with nothing of ours in the buffer21 → 0 d
  • Mark-outs where a cable or main is in the buffer19 → 19 d
  • Arranging standbys, pre-dig meetings and trial holes1 → 1 d

Estimated coordinator and locator working days per 1,000 tickets, by hand and with the solution. Today the sample utility visits 61% of tickets, and 29% have an asset in the buffer. A locator does about 15 mark-outs a day.

How it works

Each one-call ticket read, mapped, scored and answered by agents

What comes in
Tickets inone-call feed · the day's board
Agents at work
Ticket readermethod, depth, extent
Then
Asset overlaydig area + 3 m buffer
Then
Risk scorerscore + rule floors
Then
Clear responder
Locator dispatcher
A person decides
Damage prevention coordinatorconfirms every standby
What comes out
No-conflict replies
Risk-ranked locates
Standby on site
One case, step by step

One morning's tickets screened, and a standby put on the riskiest dig

A depot on a Tuesday morning. At 16:18 the day before, a civil contractor filed a ticket to renew a storm drain along one road with a tracked 21 t excavator. Here is what happens next, screen by screen, in the working solution.

A worked example on sample data. Names, IDs and figures on the screens and in this section come from the demo.

  1. 01Morning

    704 tickets on the board, 38 new since yesterday

    Damage prevention coordinator

    The coordinator owns the response to each ticket in the utility's area. The dig map opens on the depot. It shows 704 tickets on the board and 89 replies due today, none late. Of these, 7 need a standby, 36 carry raised risk, 161 need a locate and 500 are clear. Thirty-eight new tickets have come in from the one-call center since 16:05 yesterday. They wait to be screened over the buried cables and mains, drawn in the colors field crews know.

    With 700 maps to read by hand, any doubt becomes a truck roll.

  2. 0207:42 · one click

    Five agents screen the 38, in order

    Ticket reader, Asset overlay and Risk scorer

    The coordinator presses Screen 38 new tickets. The ticket reader reads the work, method, depth and extent from each description. Four gave no depth, so the method's worst case is used. The asset overlay draws 38 dig areas with a 3 m buffer and finds 61 of the utility's assets inside. It holds back one area where as-builts, the drawings of what was actually built, are not yet posted. The risk scorer scores 37: 27 clear, 7 locate, 2 raised risk and 1 standby over a 600 mm trunk main.

    Clear responder: “sent 27 no-conflict replies · code 10 to the one-call center and an email to each excavator · 07:43”

  3. 0307:43

    The storm drain dig turns red: standby required

    Risk scorer

    The last dig area draws along the road and crosses the 132 kV cable route. The contractor plans to dig to 1.8 m with a tracked 21 t excavator. According to the as-laid survey, the 132 kV circuit lies at 1.1 m. So the bucket would go 0.7 m below the cable. The score is 94 of 100. On the right, the depth section draws the trench to its depth. Each asset sits at its recorded depth, with its 0.5 m safe margin.

    “Rule: a mechanical excavator within 3 m of a cable of 33 kV or more always gets a standby.”

  4. 04What if

    Switch to vacuum excavation, and the score falls to 69

    Damage prevention coordinator

    The coordinator tries the other methods on the depth section. With vacuum excavation to the same 1.8 m, the method adds 6 points instead of 22. The safe-margin points fall from 18 to 9. So the score falls to 69, and the outcome becomes raised risk. That means the locator marks out, then meets the excavator on site before work starts. The standby rule for machine digs no longer applies. This is a what-if only, and the ticket still says mechanical excavator.

    “What-if: the ticket says mechanical excavator to 1.8 m (score 94). Not saved.”

  5. 05The ticket

    Each value read from the ticket, each asset inside the dig

    Ticket reader and Asset overlay

    The ticket appears as received. The start, location, depth and method are highlighted where the ticket reader found them. Six assets lie inside the dig area and its 3 m buffer. The 132 kV circuit crosses at chainage 76 m, the distance along the dig, with its protection signaling fiber at 78 m. A 150 mm main lies at 104 m and an 11 kV feeder at 120 m. There are six 25 mm service pipes. A 450 mm ductile iron trunk main runs 2.1 m beside the trench. Its depth, 1.4 m ±0.4, is estimated from an old drawing.

    Why 94: 132 kV cable +35 · mechanical excavator +22 · dig reaches the 0.5 m safe margin +18. Other points: 2 crossings +8 · excavator history +7 · depth uncertain +4

  6. 06Who is digging

    The contractor carries +7 for its strike history

    Risk scorer

    The excavator history adds points for strikes in the last 24 months. One strike adds 4, two add 7, and three or more add 10. The contractor has 412 tickets in 12 months and 2 strikes. One was an 11 kV cable, hit by a mini excavator that did not keep clearance. The other was a 100 mm main. The coordinator can send a safe-dig briefing before Thursday's job.

    “Strikes in the last 24 months add to each new ticket's risk score.”

  7. 07Decide

    The precautions, drafted and confirmed

    Damage prevention coordinator

    The locator dispatcher has drafted what the dig needs. An HV-qualified (high-voltage) locator marks out the next morning, before the reply is due. A pre-dig meeting is set on site at 07:00 on the dig day, with the contractor's site foreman. From 07:00 to 15:30, a standby crew stays on site. Trial holes are dug by hand at chainage 76 m and 120 m. Safe-dig instructions go to the contractor. The coordinator signs the plan, and it goes to the cable engineer.

    “No machine within 0.5 m of the indicated line until the asset is exposed.”

  8. 08Approved

    The cable engineer approves, and the reply goes back

    Third-party works engineer, transmission cables

    Any work within 3 m of a 33 kV or 132 kV cable needs this engineer's approval. Once it is approved, code 30 goes to the one-call center. It means marked, with a site meeting and a standby. The contractor gets the safe-dig instructions, with asset plans, depths, the 0.5 m margin and the standby contact.

    “Approved by the cable engineer · code 30 sent to the one-call center”

  9. 09The field day

    Locators by qualification, standbys against the dig start

    Locator dispatcher

    The locator board shows 8 locators and 113 mark-outs in route order, with travel time from each depot. HV work goes only to HV-qualified locators. One of them carries 16 jobs and is 79% booked. Standby crews are booked against each dig start. A two-person crew covers the storm drain dig on Thursday, and the trunk mains crews cover the big water mains.

    “HV work goes only to HV-qualified locators. Standbys are booked against the dig start.”

  10. 10Later

    A person checks 5% of the clears

    Damage prevention coordinator

    Each clear says why it was clear. It names the nearest asset and its distance, against the 15 m clear distance, with the reply time and code 10. Today's sample is 26 of 527 clears. The coordinator marks each one Agree or Should have been located. Three tickets on a new housing estate were held instead of cleared. Their phase 2 as-built drawings for low-voltage (LV) and water are not posted yet, so they went to a locator.

    “Any area with as-builts still to post is held and sent to a locator.”

Who it’s for

The coordinator, locator and two engineers who answer each locate request

The same storm drain ticket, seen by the four people at the utility who answer for it, and how each one's day changes.

Damage prevention coordinator
Confirms standbys and owns the screening rules
Before
Starts at 07:00 with 700+ tickets on the one-call feed and a 2-working-day clock on each. Sends people to anything uncertain, since nobody can look at 700 maps.
Now
Opens a map where the clears have already gone back with their reasons. Decides only the tickets near a cable or main, with the depth section, the score and the drafted precautions in front of them.
Locate technician
Marks out buried assets, HV-qualified
Before
Does 14 to 20 mark-outs a day and drives to many that touch nothing. Spends half the day painting no-assets marks on a sidewalk.
Now
Gets a route of mark-outs where something of the utility's is in the buffer. HV work is kept for HV-qualified locators, and the standby and site meeting are already booked.
Third-party works engineer
Approves works within 3 m of 33 kV and 132 kV cables
Before
Approves any work near the transmission cables, where a tracked excavator over a 132 kV joint is the call to dread.
Now
Gets each dig near a 33 kV or 132 kV cable already signed by the coordinator. It comes with the method, the depth against the cable's recorded depth, the standby crew and the trial-hole positions.
Water network engineer
Approves works near mains of 300 mm or more
Before
Protects the 300 mm and larger mains, where one burst floods a street. Wants a trial hole where old drawings give a depth of 1.4 meters.
Now
A machine dig within 3 m of a trunk main of 300 mm or more always gets a standby. The trunk mains crew stands by, and trial holes are dug by hand. An uncertain depth adds to the score.
The agents

Ticket reading, asset overlay and risk scoring for each locate request

Five agents carry each ticket from the one-call feed to a clear reply or a locator; the coordinator confirms each standby.

Ticket reader

Reads each one-call ticket and the excavator's markup. It picks out the work type, dig method, maximum depth, length and width, start date and duration. Draws the dig area on the map from the location text, and cites the sentence each value came from.

  • Never invents a depth. If none is stated, it uses the method's worst case and flags it.
  • Never guesses a method that is not written
  • Cites the ticket sentence for every value
Asset overlay

Puts the dig area and a 3 m buffer over the utility's electricity and water records. Lists each asset inside, with its recorded depth, depth source and uncertainty. Shows whether it crosses or runs beside the dig, its distance and its chainage.

  • An area with as-builts still to post is never treated as empty
  • The depth source is always shown
Risk scorer

Scores each ticket from 0 to 100. It weighs the dig method and depth against each asset's recorded depth, less the 0.5 m safe margin. Asset class, crossings, excavator history and depth certainty add points. Then it applies the standby floors, the fixed rules no score can go below.

  • Never scores below a standby floor. A floor can raise an outcome, never lower it.
  • Every point has a reason
Clear responder

Sends response code 10 (clear, no conflict) to the one-call center and an email to the excavator. It does this only when nothing of the utility's is within 15 m and the area is not held. Records why it was clear, and puts 5% into the daily audit sample.

  • Never clears inside the buffer of any asset
  • Never clears a held area
Locator dispatcher

Assigns each locate to a qualified locator in the area, inside the response clock. For standby and raised-risk tickets, drafts the standby crew, pre-dig meeting, trial holes and safe-dig instructions.

  • HV work only to HV-qualified locators
  • A standby is never confirmed without the coordinator
Damage prevention coordinator

Confirms every standby.

Ask in plain words

A ticket, a dig or an excavator, answered with the rule behind it

Coordinators ask about any ticket, dig or excavator in plain words, or say what to change. Each answer points to the ticket, the asset record or the rule behind it. These answers use the sample data.

Why does the storm drain ticket need a standby?

The contractor plans a tracked 21 t excavator to 1.8 m along the road. A 132 kV circuit crosses the trench at chainage 76 m. The as-laid survey puts it at 1.1 m, so the bucket would go 0.7 m below it. It scores 94, and a mechanical dig within 3 m of a 33 kV+ cable always gets a standby. The standby is drafted for the dig day, 07:00 to 15:30, and needs your sign-off.

How has this contractor done on past tickets?

The contractor has 412 tickets in 12 months, and 2 strikes in 24 months. One hit an 11 kV cable. A mini excavator did not keep clearance, and 212 customers lost power for 3 h 40 min. The other hit a 100 mm main. That adds +7 to each of their tickets. One dig without a ticket was reported. A safe-dig briefing before Thursday's job would be worth it.

Add a rule: vacuum digs within 1 m of a 132 kV cable need a site meeting

Added as a draft rule. Vacuum excavation within 1 m of a 132 kV cable is always at least raised risk, with a site meeting before work. Today it would change one ticket, for signal ducting 1.0 m from the cable. That ticket is already raised risk, so nothing moves. The transmission cable engineer has been asked to approve it.

The screens

The dig map, the depth section and the standby sign-off

From the working solution, on its sample data. Pick one to see it large.

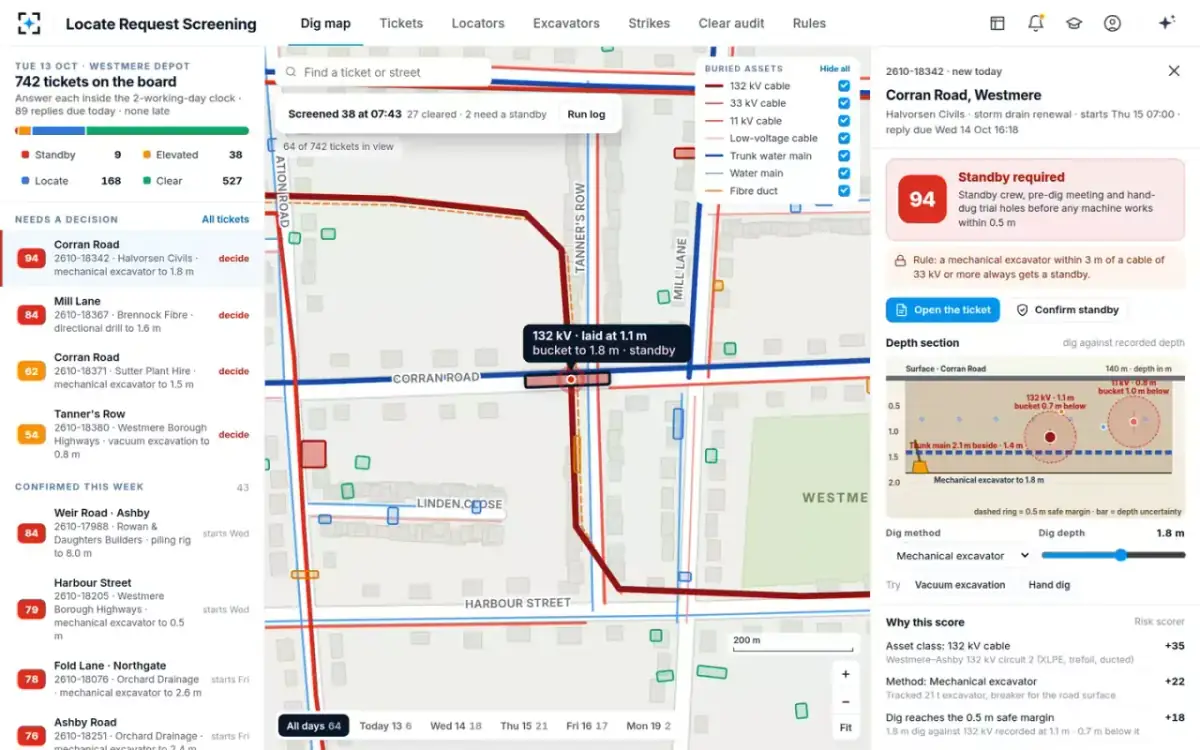

The dig mapEach ticket's dig area over the buried cables and mains, and the stream ranked by risk. The storm drain ticket shows its depth section: 94, standby required.

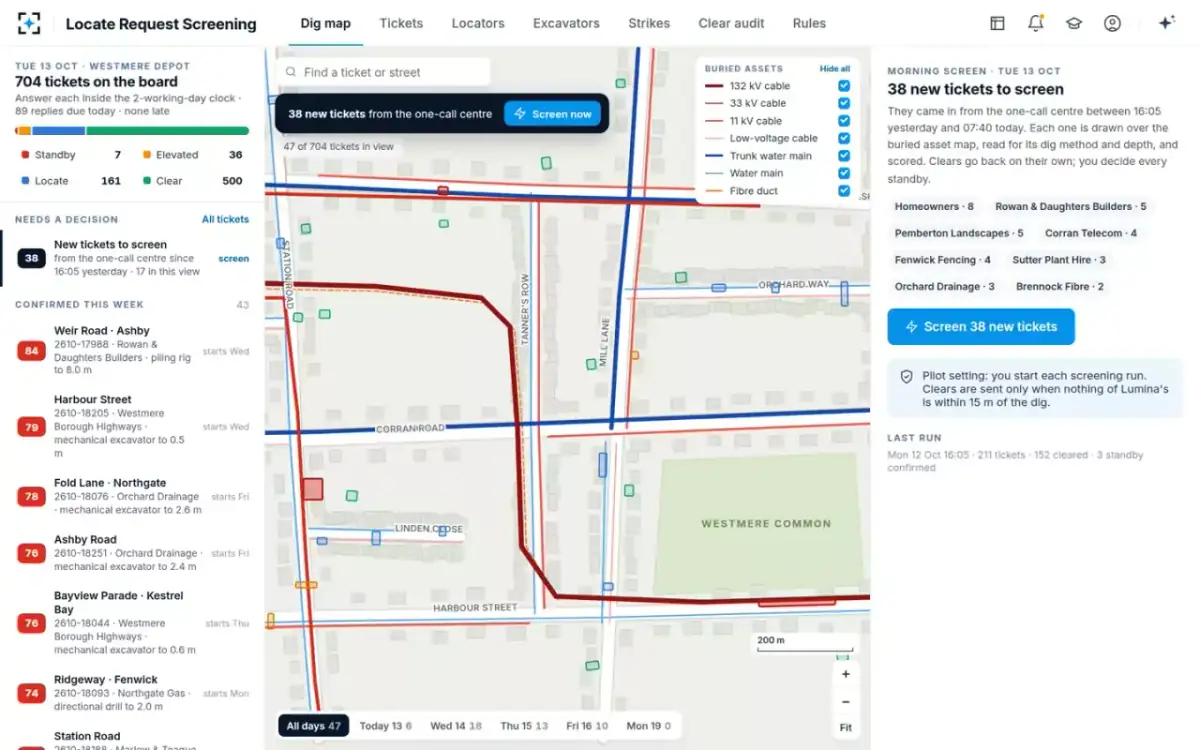

The morning board704 tickets on the board, 89 replies due today and none late, and 38 new from the one-call center waiting to be screened.

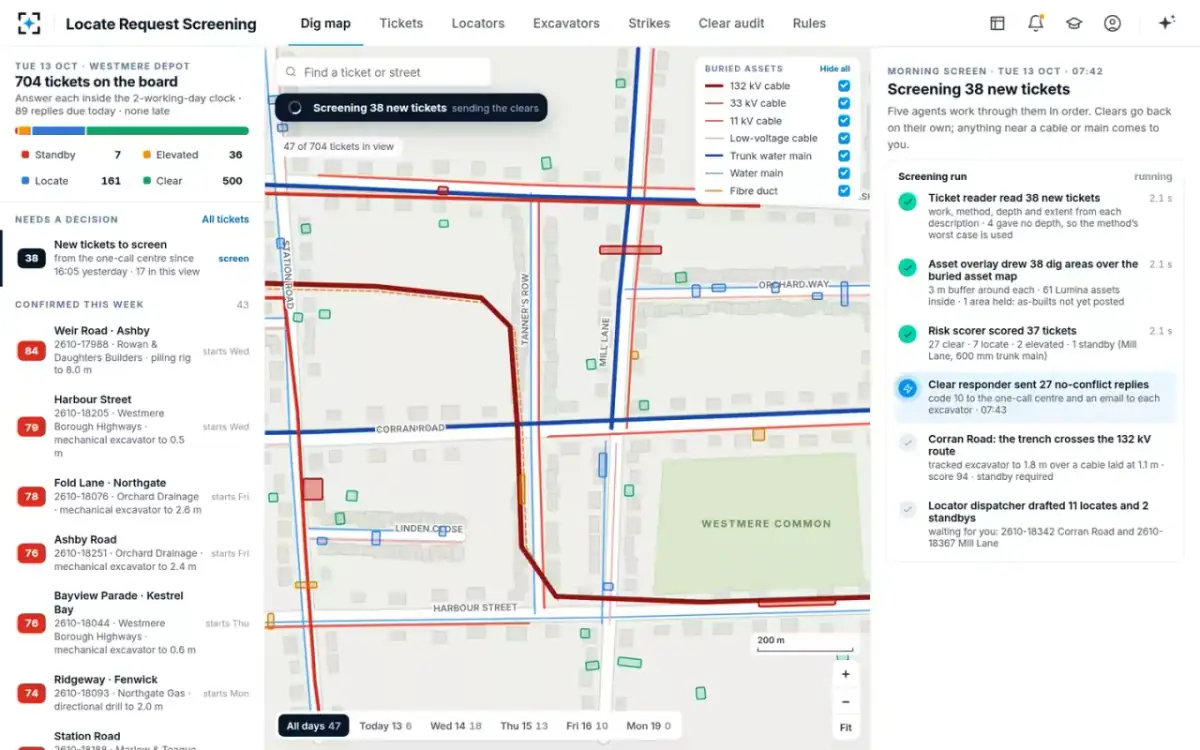

Screening runThe agents read, draw, overlay and score the 38 new tickets in order. Then 27 no-conflict replies go back at 07:43.

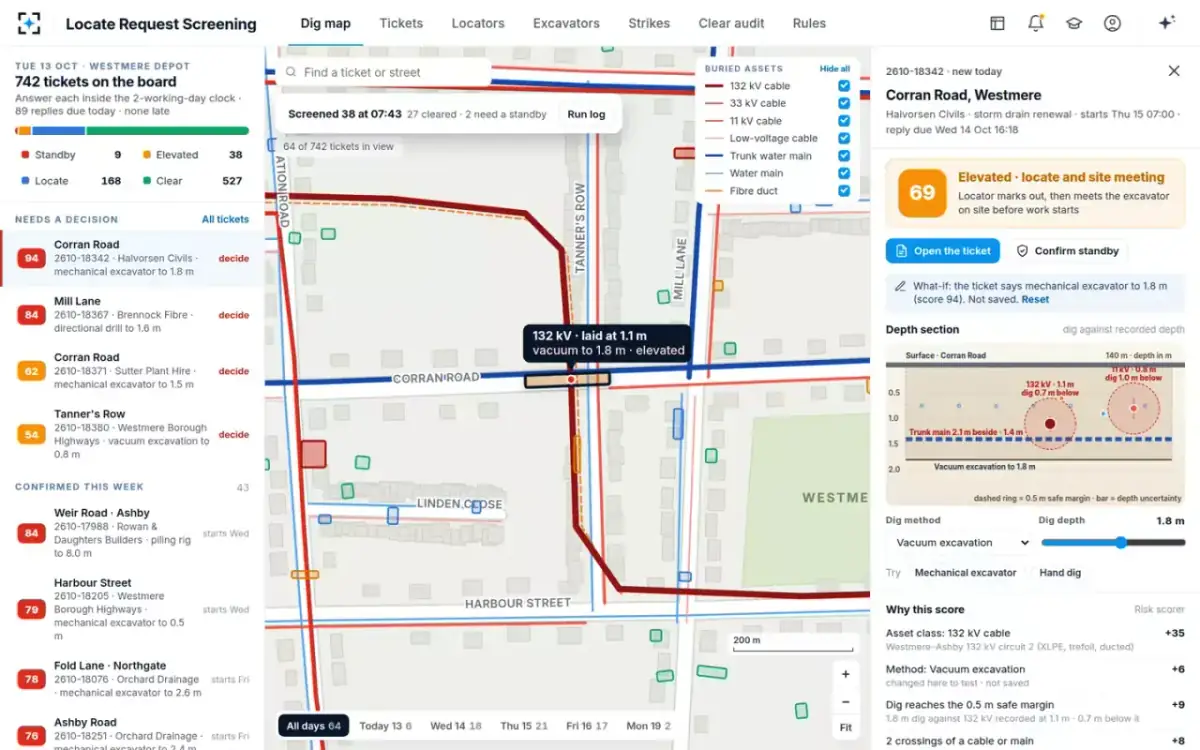

What if the method changesSwitch the dig to vacuum excavation and the score falls from 94 to 69. That makes it raised risk, with a locate and a site meeting and no standby.

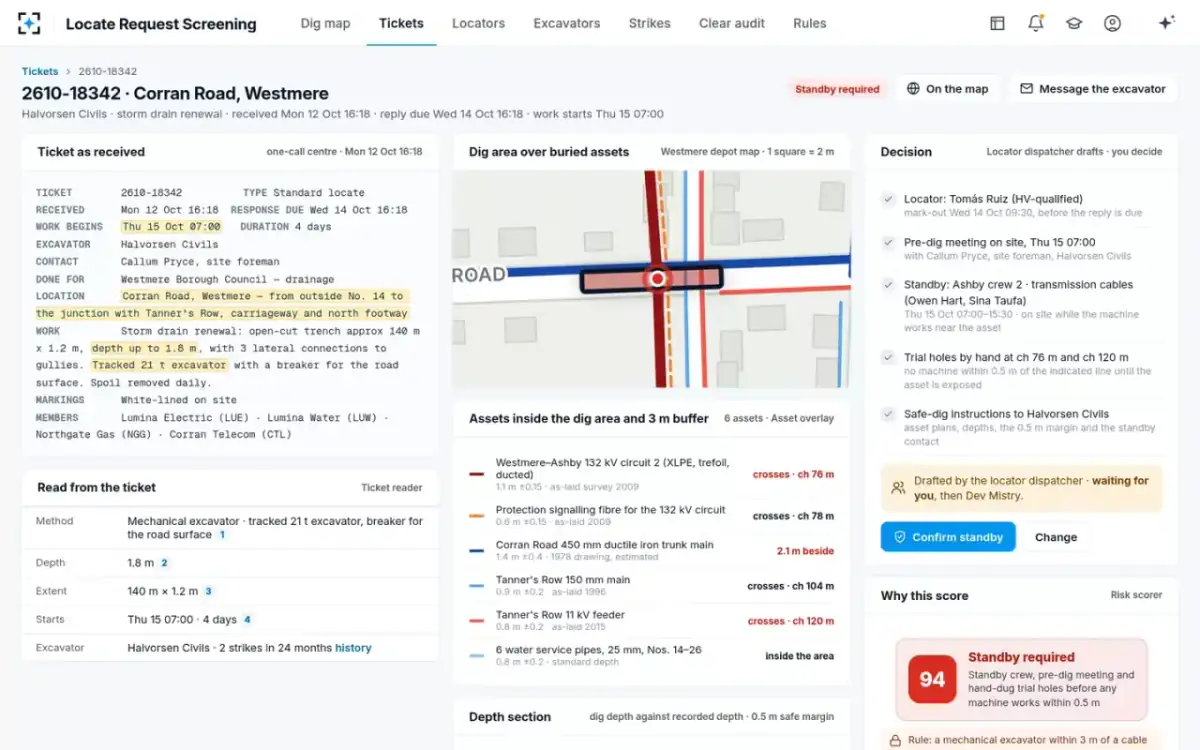

The ticketThe ticket as received with each value highlighted, the six assets inside the dig area and buffer, the drafted precautions and the score.

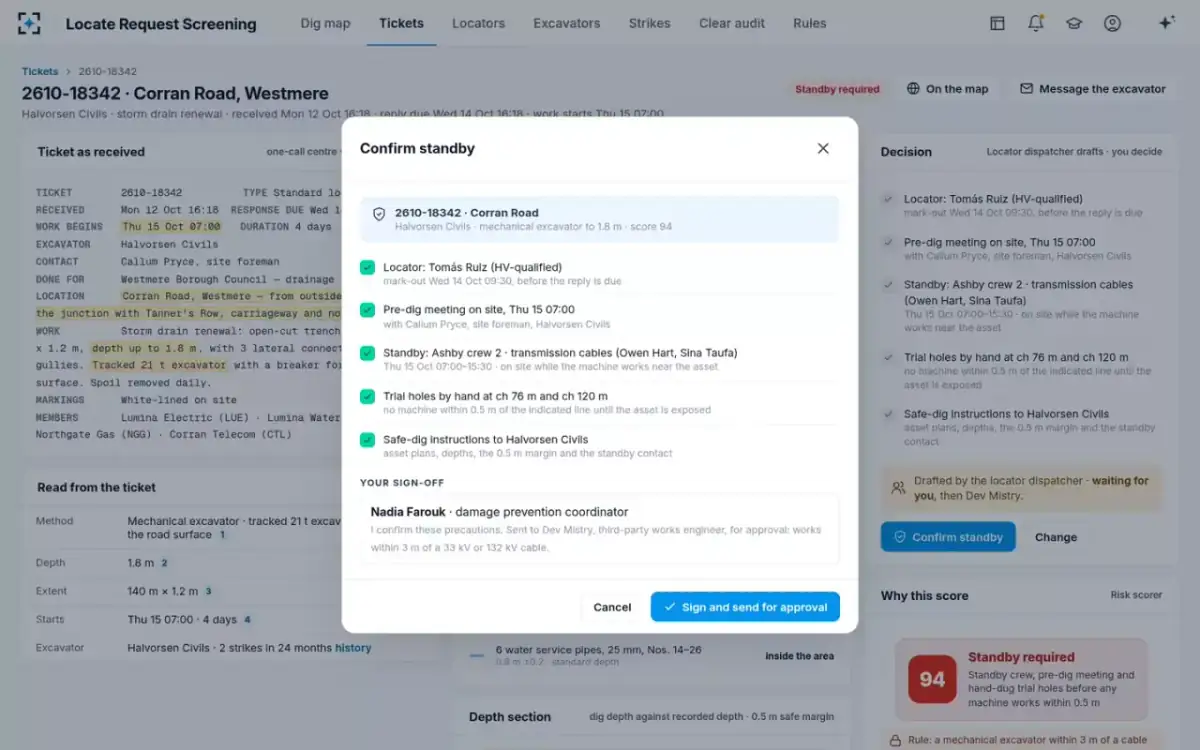

Confirm the standbyLocator, pre-dig meeting, standby crew, trial holes and safe-dig instructions, signed by the coordinator and sent to the cable engineer.

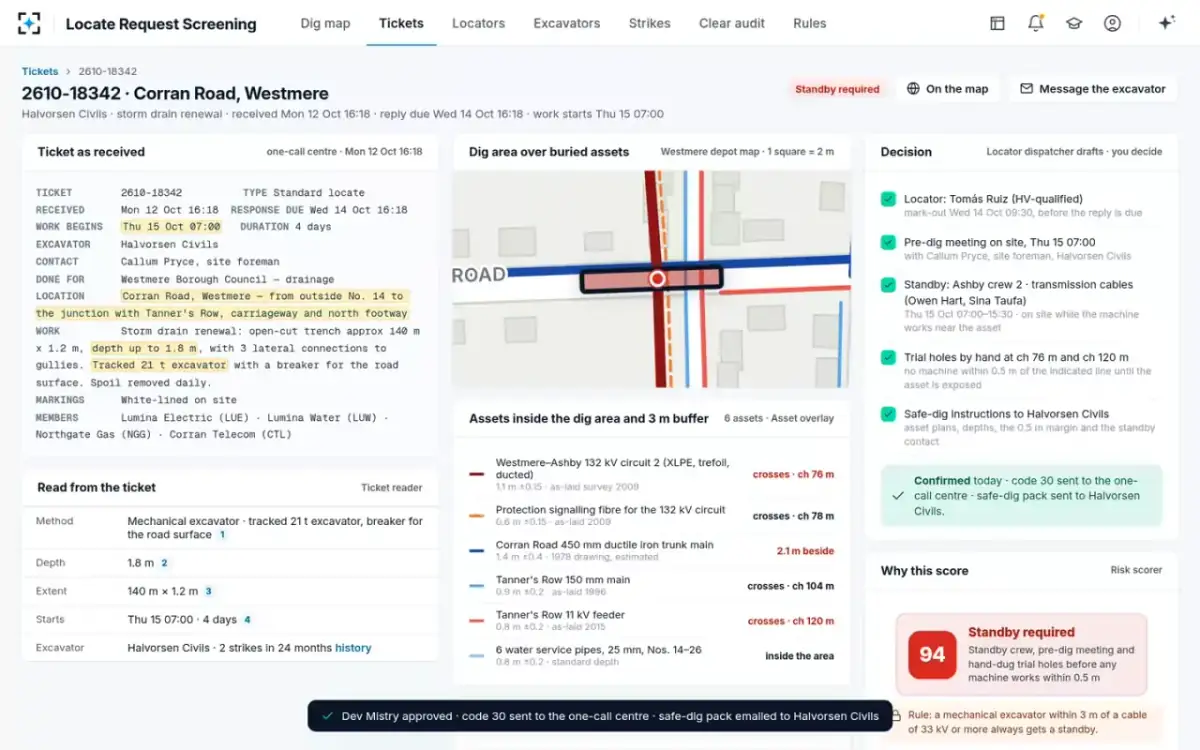

Approved and answeredThe cable engineer approves. Code 30 goes to the one-call center, and the safe-dig instructions go to the excavator.

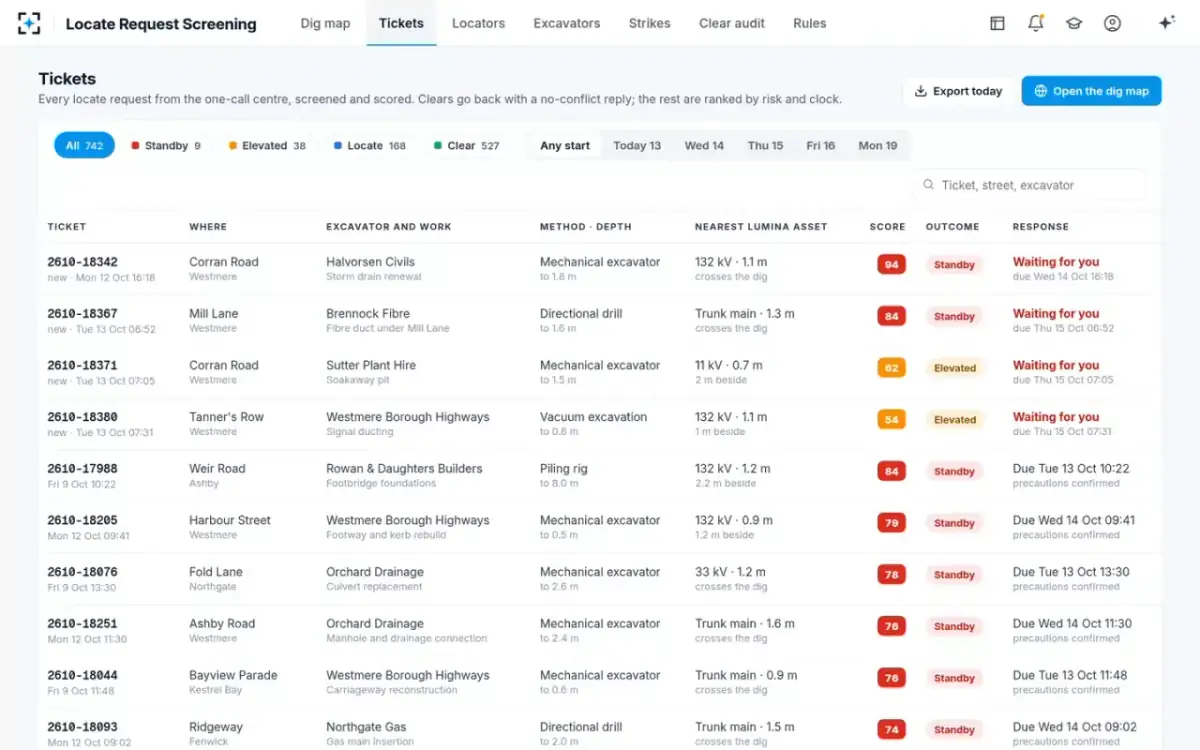

All tickets742 tickets by outcome and dig start, with method and depth, the nearest asset, the score and the response due.

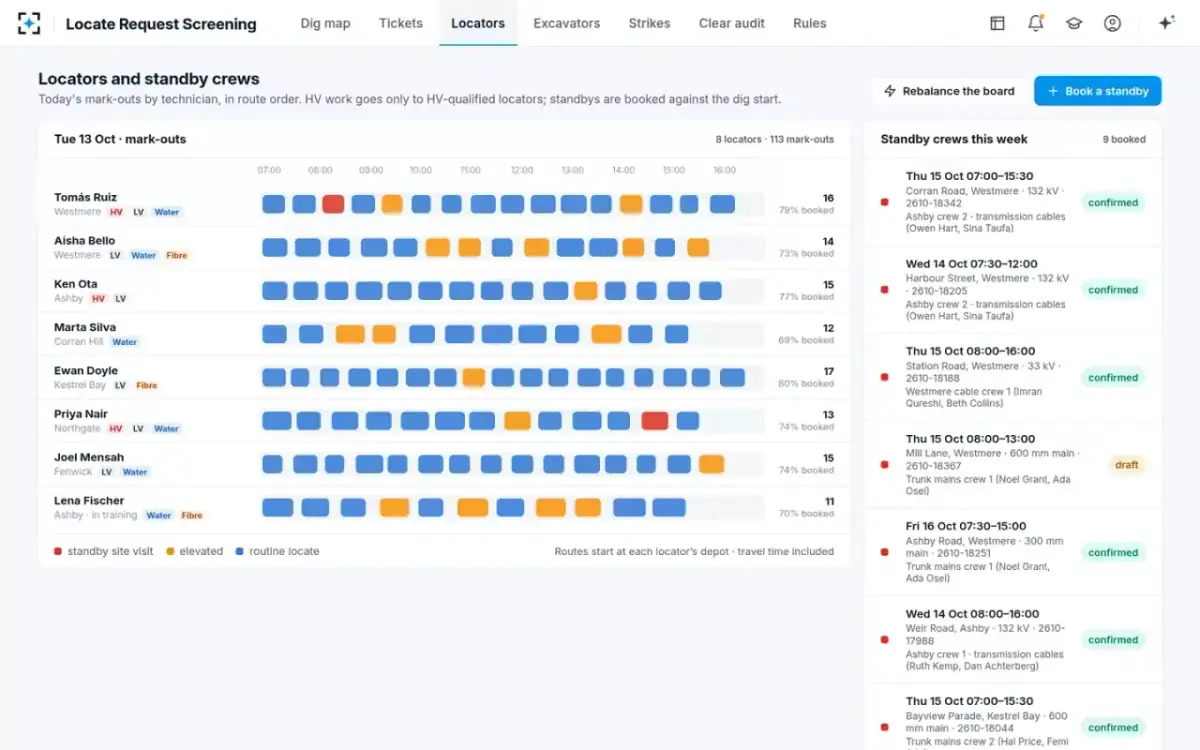

Locators and standby crewsToday's mark-outs by technician in route order, HV work only for HV-qualified locators, and the standby crews booked this week.

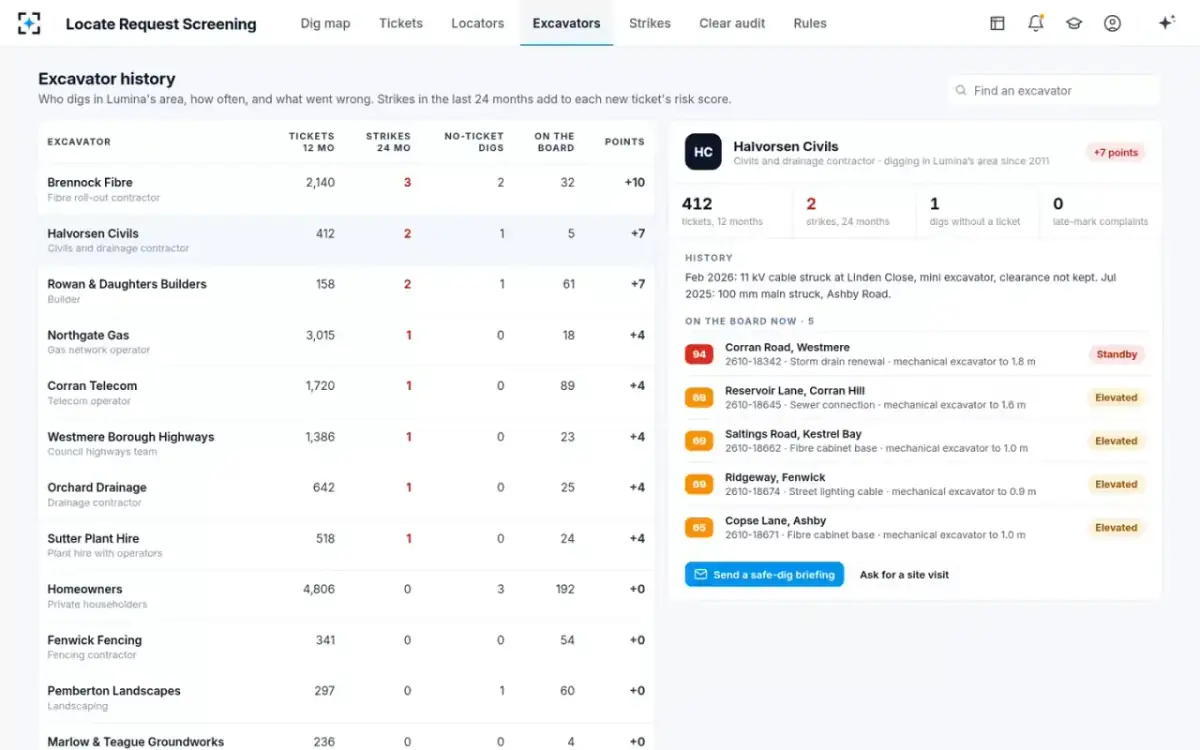

Excavator historyWho digs in the utility's area, with their tickets, strikes and no-ticket digs. It shows the points each excavator adds to a new ticket's score.

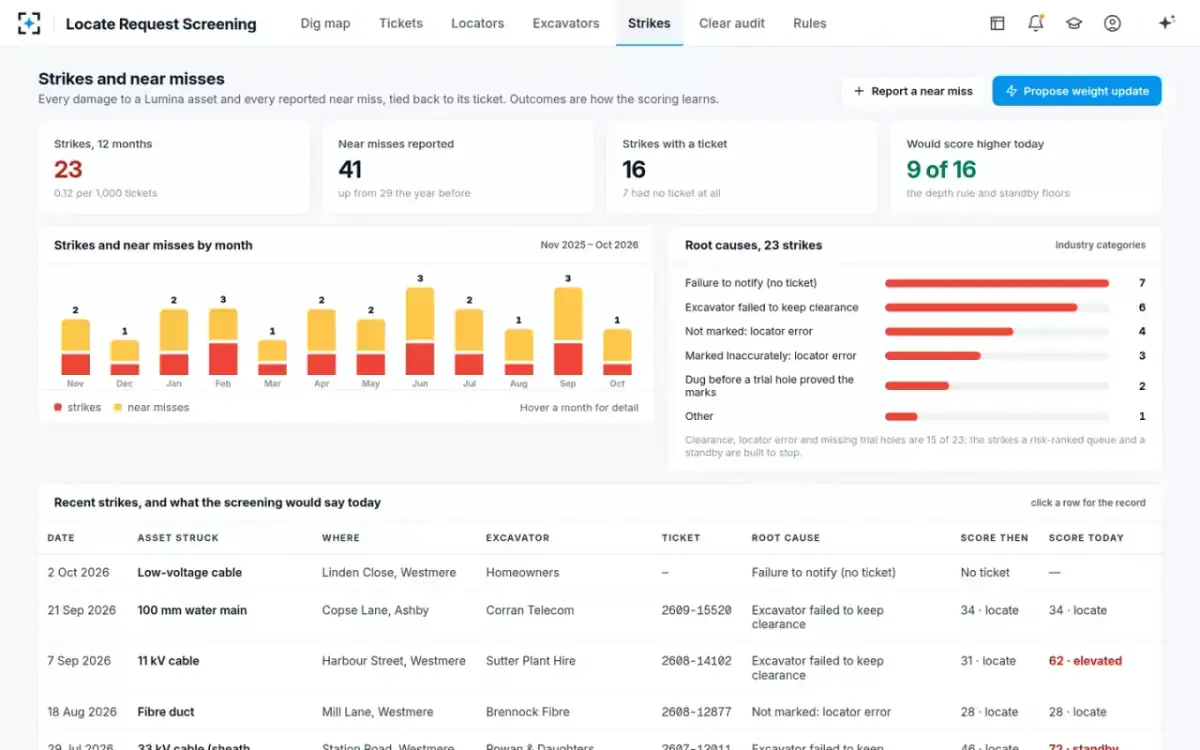

Strikes and near misses23 strikes in 12 months by root cause, and each recent strike with its ticket, the score then and the score today.

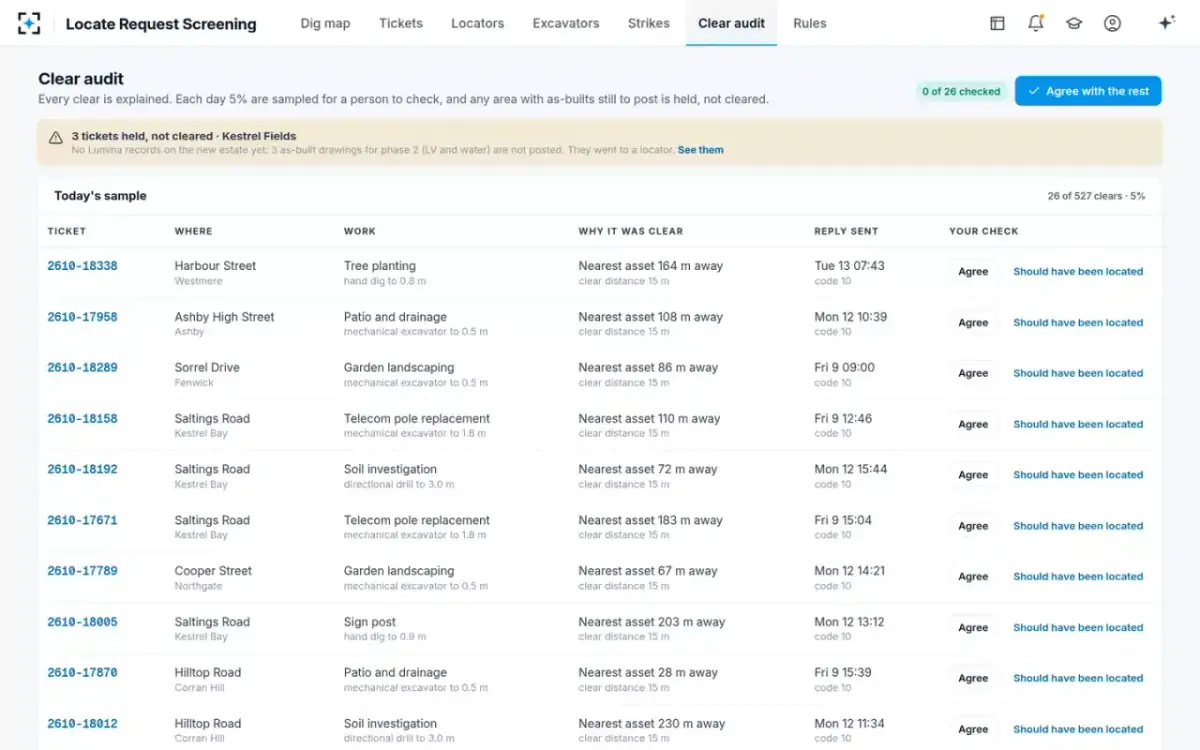

Clear auditToday's 5% sample of clears with the reason each was clear, and the new-estate tickets held until the as-builts are posted.

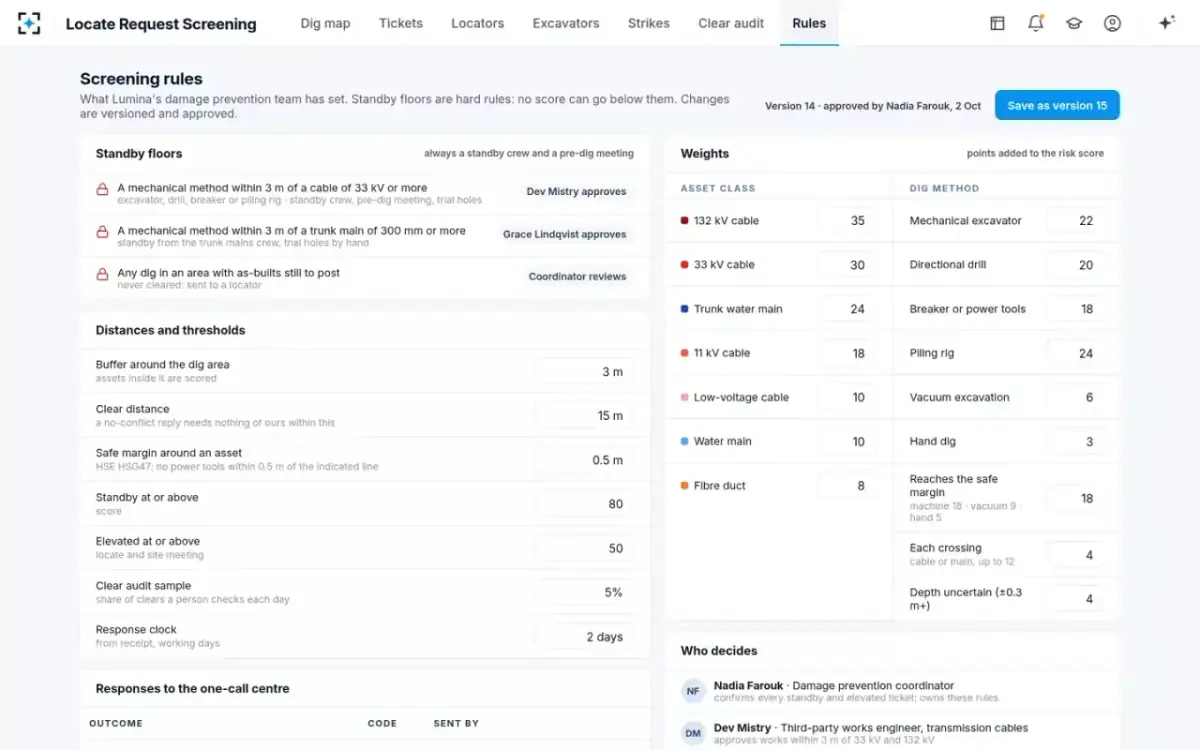

Screening rulesStandby floors, distances and thresholds, weights, response codes and who decides, versioned and approved.
Governance

Sampled clears and signed standbys in locate request screening

Each outcome cites its inputsEach score shows its points and their reasons. You see the ticket sentence behind the method and depth, and the asset record with its depth source and uncertainty. You also see the rule that applied.
Standby floors no score can go belowSome digs always get a standby crew, a pre-dig meeting and trial holes, whatever the score. These are machine digs within 3 m of a cable of 33 kV or more, or of a trunk main of 300 mm or more. A floor can raise an outcome but not lower it.
People confirm, engineers approveThe coordinator signs each standby and raised-risk ticket before a reply goes back. Works near 33 kV and 132 kV cables need the transmission cable engineer's approval. Works near the big mains need the trunk mains engineer's approval.
Each clear explained and sampledEach no-conflict reply says why it was clear. Each day, 5% of clears are sampled for a person to check. Any area with as-built drawings still to post is held and sent to a locator instead of cleared.
Rules versioned and approvedBuffers, margins, thresholds, weights and floors are the damage prevention team's own rules. Changes are saved as a new version and approved. Version 14 was approved by the coordinator.
Strikes teach the score, with approvalEach strike and near miss is tied back to its ticket. It shows what the score said then and would say today. Weight changes learned from outcomes are only proposed, and they wait for approval. Each response sent to the one-call center stays on the record.
Configuration

Buffers, safe margins, weights and standby floors the damage team sets

The buffer, the clear distance, the safe margin, the thresholds, the weights and the standby floors are the damage prevention team's settings, versioned and approved.

SettingDefaultChoose from
Standby floorsMechanical within 3 m of a 33 kV+ cable or a 300 mm+ trunk mainAlways a standby crew, a pre-dig meeting and trial holes. Approved by the transmission cable engineer or the water network engineer. A dig where as-builts are still to post is never cleared.
Buffer around the dig area3 mEvery asset inside the buffer is scored
Clear distance15 mA no-conflict reply needs nothing of the utility's within this distance
Safe margin around an asset0.5 mFrom HSE HSG47: no power tools within 0.5 m of the indicated line
Outcome thresholdsStandby at 80 · raised risk at 50Score at or above which a ticket gets a standby, or a locate and site meeting
Asset class weights132 kV 35 · 33 kV 30 · trunk main 2411 kV cable 18 · low-voltage cable 10 · water main 10 · fiber duct 8
Dig method weightsPiling rig 24 · mechanical excavator 22Directional drill 20 · breaker or power tools 18 · vacuum excavation 6 · hand dig 3
Clear audit sample and response clock5% · 2 working daysShare of clears a person checks each day · the clock from receipt, in working days
Connections

One-call tickets, cable and main records and the strike history it reads

One-call (811) ticketstickets as they arrive, the excavator's markup, and response codes 10 to 40 sent back
Electric network records132 kV, 33 kV, 11 kV and low-voltage cables and fiber, with recorded depth and source
Water network recordstrunk mains, distribution mains and service pipes, with recorded depth and uncertainty
As-built registerdrawings still to post, so a new estate is held instead of cleared
Excavator and strike historytickets, strikes, no-ticket digs and near misses, tied back to each ticket
Locator board and crew rosterslocator qualifications, routes and the standby crew calendar
What it changes

Fewer empty truck rolls, and a standby where the dig is dangerous

Each figure carries its label: a target the solution is built to, an estimate, a typical published result, or a proven one.

target
100%
of machine digs over a 33 kV+ cable or trunk main given a standby and trial holes
9 of 9 high-risk digs
with a standby this week
demo
$14.9M
a year of site visits avoided, by not sending trucks to digs that touch nothing (the sample's figure)
Visited today61% of tickets
With screening29%
target
100%
of tickets answered inside the 2-working-day clock, with clears back in minutes
Every ticket on time
on today's board

“Demo” means seen in the working solution, on its sample data. “Target” means the design goal, measured in the live solution. “Estimated” means our estimate of the working days per 1,000 tickets, from the sample utility's inputs. Those inputs are 61% of tickets visited today against 29% with an asset in the buffer. “Typical” means published figures from CGA DIRT reports. The 2023 and 2024 reports cover damages and root causes. The 2025 report counts 221,717 damages reported in the US. “Estimated” also marks the vendor figure of $250 to $500 a dispatch, from S&C Electric, cited by Ventavid. Safe-digging context comes from HSE HSG47, Avoiding danger from underground services. Names on the screens are sample data.

Questions

Locate request screening, as damage prevention teams ask about it

What is locate request screening?

Locate request screening is the check a utility makes on each one-call (811) excavation ticket before it answers. It checks whether anything of the utility's is inside the dig, and how dangerous the work is. Locate Request Screening does that check with five agents. They send the no-conflict replies and rank the rest by risk. They draft a standby crew and pre-dig meeting for each machine dig within 3 m of a 33 kV+ cable or 300 mm+ trunk main. The damage prevention coordinator decides.

How does 811 ticket screening software work?

The ticket reader reads the dig method, depth, extent and start from the ticket, and draws the dig area. Next, the asset overlay lists each cable and main inside the area and a 3 m buffer. It shows each one's recorded depth and how sure that depth is. Then the risk scorer weighs method and depth against each asset's depth, less a 0.5 m safe margin. Asset class, crossings, excavator history and depth certainty add to the score. Last, the standby floors are applied.

Can it auto-clear no-conflict tickets safely?

It clears a ticket only when nothing of the utility's is within the clear distance and the area is not held. The clear distance is 15 m in the sample rules. Each clear records why it was clear. Each day, 5% are sampled for a person to mark Agree or Should have been located. Any area with as-built drawings still to post is held and sent to a locator.

How does it decide when a dig needs a standby?

A score of 80 or more gets a standby. A score of 50 to 79 is raised risk, which means a locate and a site meeting. On top of the score, standby floors are fixed rules. A mechanical method within 3 m of a 33 kV+ cable or a 300 mm+ trunk main always gets a standby. It also gets a pre-dig meeting and trial holes by hand. In the sample, a tracked excavator to 1.8 m over a 132 kV cable at 1.1 m scores 94.

Does it cover water mains as well as electric cables?

Yes. It reads electricity and water records together, from 132 kV down to low-voltage cables, fiber, trunk mains, distribution mains and service pipes. Each asset comes with its depth source and uncertainty. A trunk main recorded from an old drawing at 1.4 m ±0.4 adds points for the uncertain depth. Works near the big mains go to the water network engineer.

Can an agent confirm a standby or clear a ticket inside a buffer?

No. The agents only draft. The coordinator confirms each standby and raised-risk ticket before a reply goes back. Works within 3 m of a 33 kV or 132 kV cable need the cable engineer's approval. The agents cannot clear inside a buffer, lower a standby floor or confirm a standby. Weight changes learned from strikes are only proposed.

Can we set our own buffers, thresholds and standby rules?

Yes. The buffer, clear distance and safe margin are settings. So are the standby and raised-risk thresholds, the asset and method weights and the standby floors. The clear audit sample, response clock, response codes and approvers are settings too. Changes are saved as a new version and approved.

Which records and rules does the screening start from?

We start from your one-call response rules, safe-digging procedures, asset records and a sample of past tickets and strikes. The Agentic Solution Engine builds and deploys the solution from those requirements and documents. It goes live once each quality gate has passed. We will walk you through it on your own tickets first.

Screen a morning's one-call tickets
with locate request screening.

We'll run Locate Request Screening on a sample of your own one-call tickets and asset records.
