- Before
- Runs 62 meter technicians and 31 vans through about 40 exchanges a day. First-time fix is one number, 83 %, with no way to see why or to fix an average.
- Now
- Opens chains ranked by length, under a ribbon of priced causes. Confirms or changes each cause, and approves fixes with the return visits and dollars they would avoid.
Four visits to one home, and the repeat visit cause behind 695 more
The utility is exchanging meters across its residential districts. In twelve months its meter operations team did 9,860 jobs and fixed 83.0 % on the first visit. One home took four visits in 18 days. Here is how the solution explains it and stops the next one, screen by screen.
A worked example on sample data. Names, IDs and figures on the screens and in this section come from the demo.
- 01Morning
The board opens on chains instead of an average

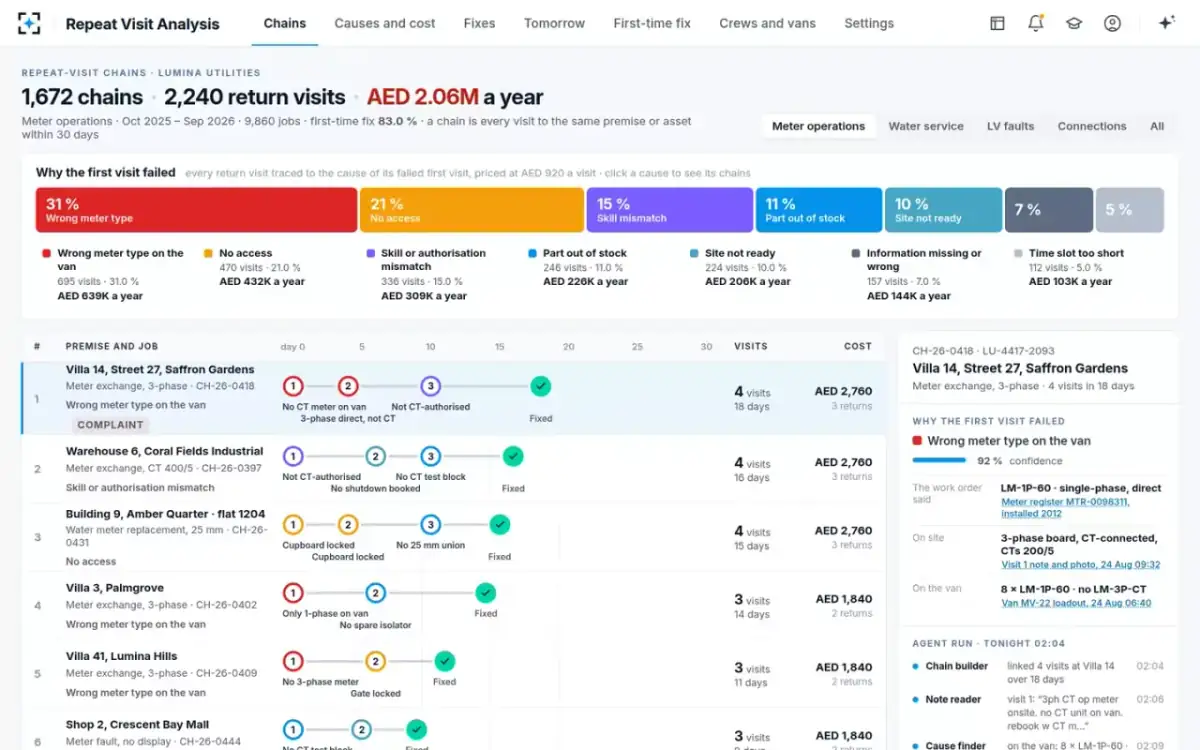

Field service managerThe manager runs meter operations, with 62 technicians and 31 vans. The board shows 1,672 chains, 2,240 return visits and $2.06M a year. A chain links each visit to the same premise or asset within 30 days. Across the top, a ribbon splits the return visits by why the first visit failed. Wrong meter type is 31 %, no access 21 % and skill mismatch 15 %. Part out of stock is 11 % and site not ready 10 %.

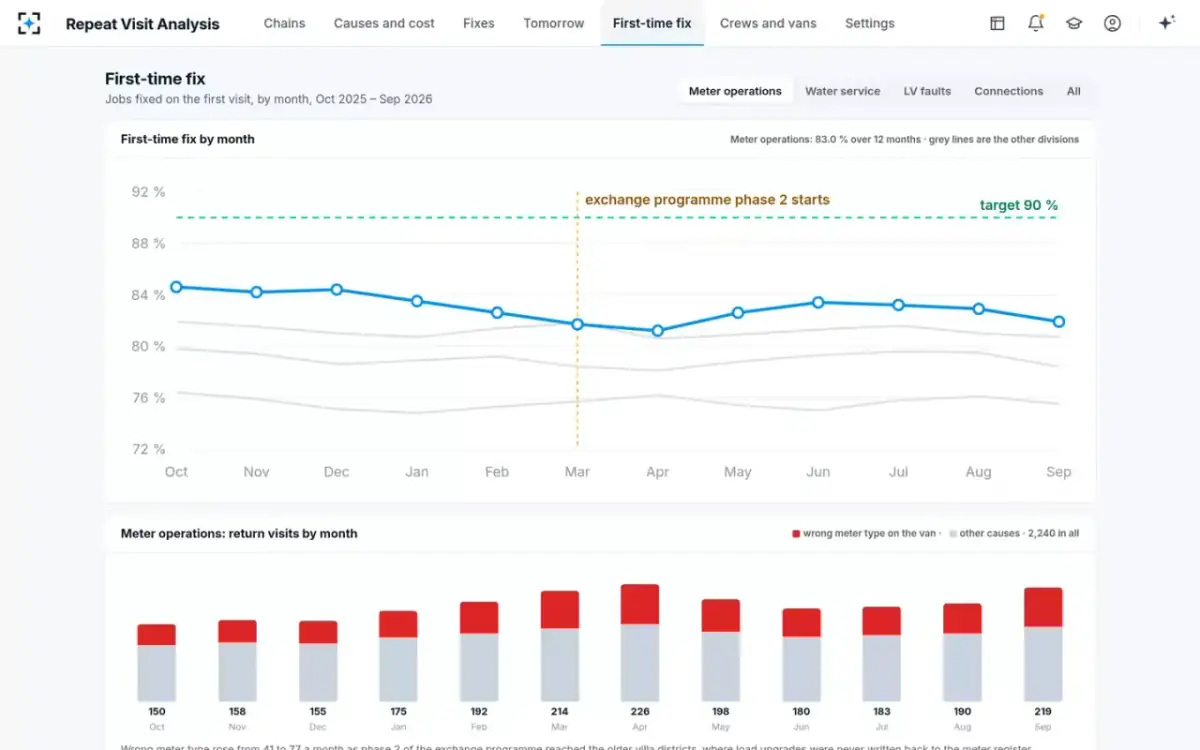

First-time fix at 83 %, split by why the first visit failed
- 02One click
Wrong meter type on the van caused 695 return visits

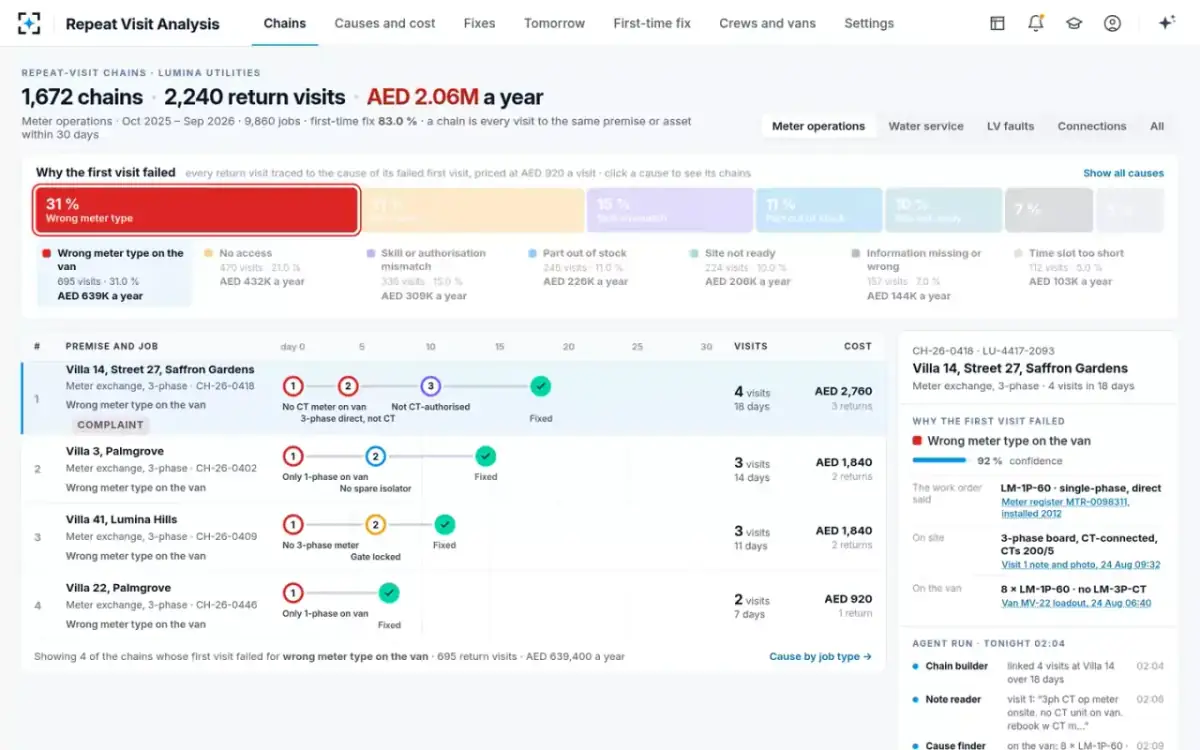

Field service managerThe manager clicks the largest cause, and the board filters to its chains. They are four homes in three districts. All are 3-phase exchanges where the van came out without the meter the board needed. The longest chain ranks first, and it has a complaint against it.
“Wrong meter type on the van · 695 return visits · $639,400 a year”
- 03Overnight, 02:04
Four visits in 18 days, each in the technician's words

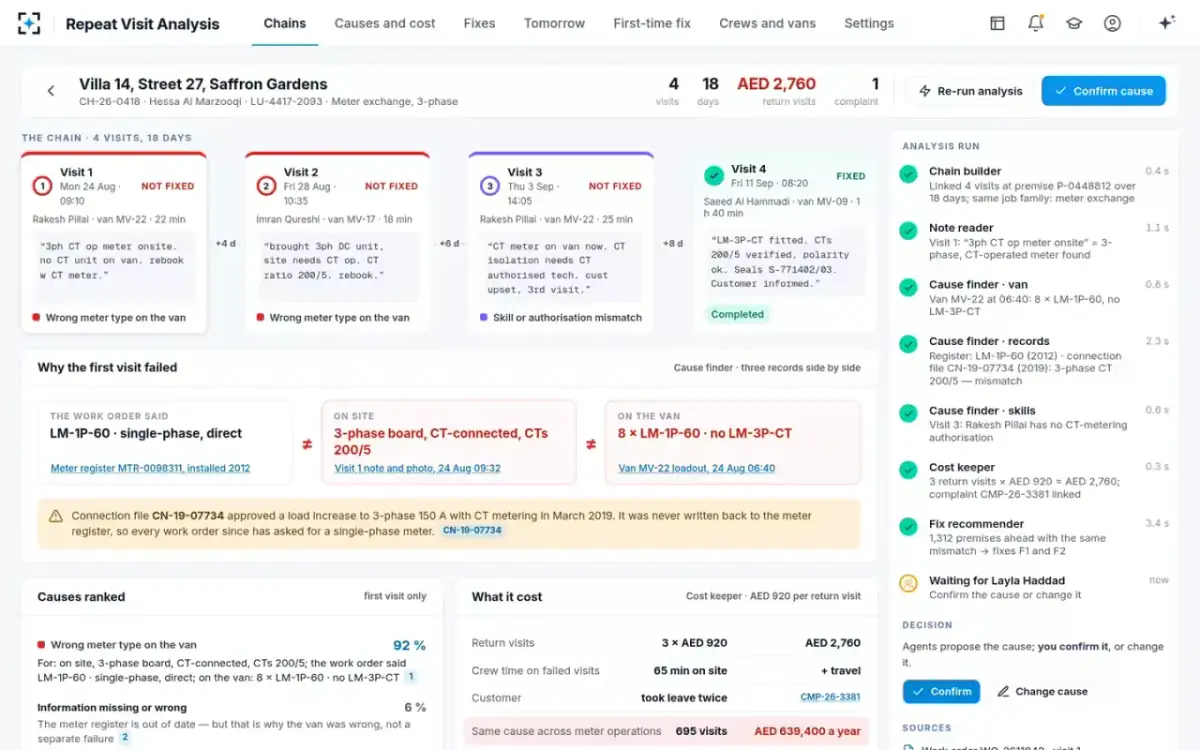

Chain builder and Note readerOn visit 1, the meter technician spends 22 minutes on site. The note reads “3ph CT op meter onsite. no CT unit on van. rebook w CT meter”. On visit 2, a second technician brings a 3-phase direct-connected meter, but the site needs CT. Visit 3 brings the right meter, but isolating the CTs needs a CT-authorized technician. On visit 4, 18 days after the first, a senior technician fits the 3-phase CT meter and checks the CTs, in 1 h 40 min.
The note reader reads “3ph CT op” as a 3-phase, CT-operated meter found on site.
- 0402:11
The work order, the site and the van, side by side

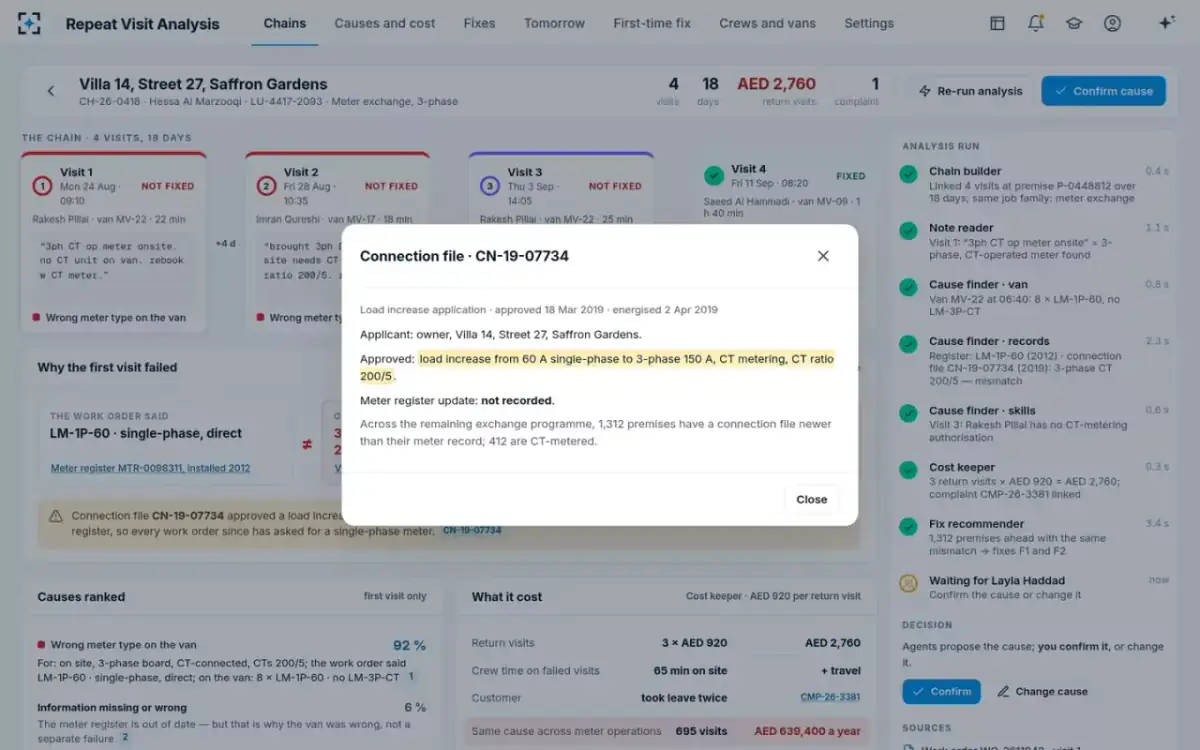

Cause finderThe work order said a single-phase direct meter. That came from a meter register record older than the load upgrade. On site was a 3-phase board, CT-connected, with CTs rated 200/5. At 06:40 the van held 8 single-phase meters and no CT meter. The reason sits in a connection file. It records a load increase to 3-phase 150 A with CT metering, approved and energized years before. The meter register update is marked “not recorded”.
The cause is wrong meter type on the van, at 92 % confidence. Each cause cites the record it rests on.
- 0502:12
What it cost, and what argues against

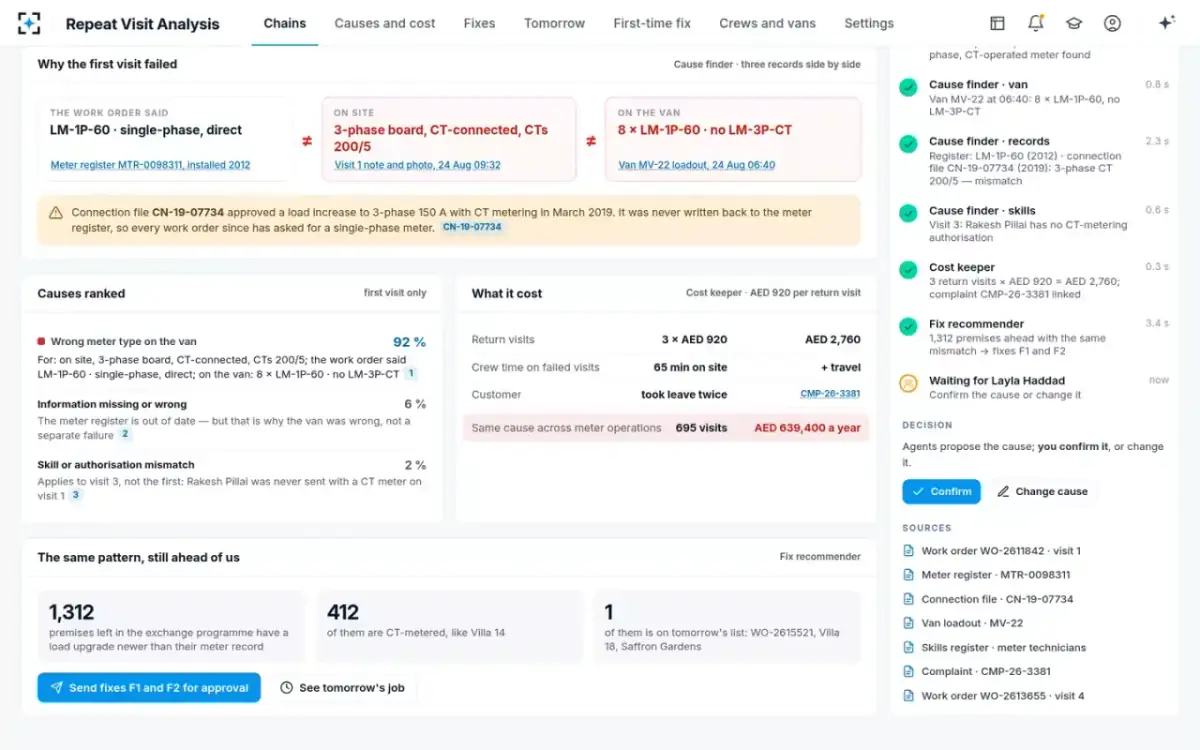

Cost keeper and Fix recommenderThree return visits at $920 each cost $2,760. The visits also meant 65 minutes on site for nothing, a complaint and a customer who took time off twice. The other causes are ranked and answered. Information missing or wrong scores 6 %, but the out-of-date register is why the van was wrong, so it is the same failure. Skill mismatch scores 2 % and applies to visit 3, after the first visit had already failed. The pattern is still ahead. Of the premises left in the exchange program, 1,312 have a load upgrade newer than their meter record, and 412 of them are CT-metered.
“1 of them is on tomorrow's list: another home in the same district”
- 06Causes and cost
Each cause priced by job type, with an owner

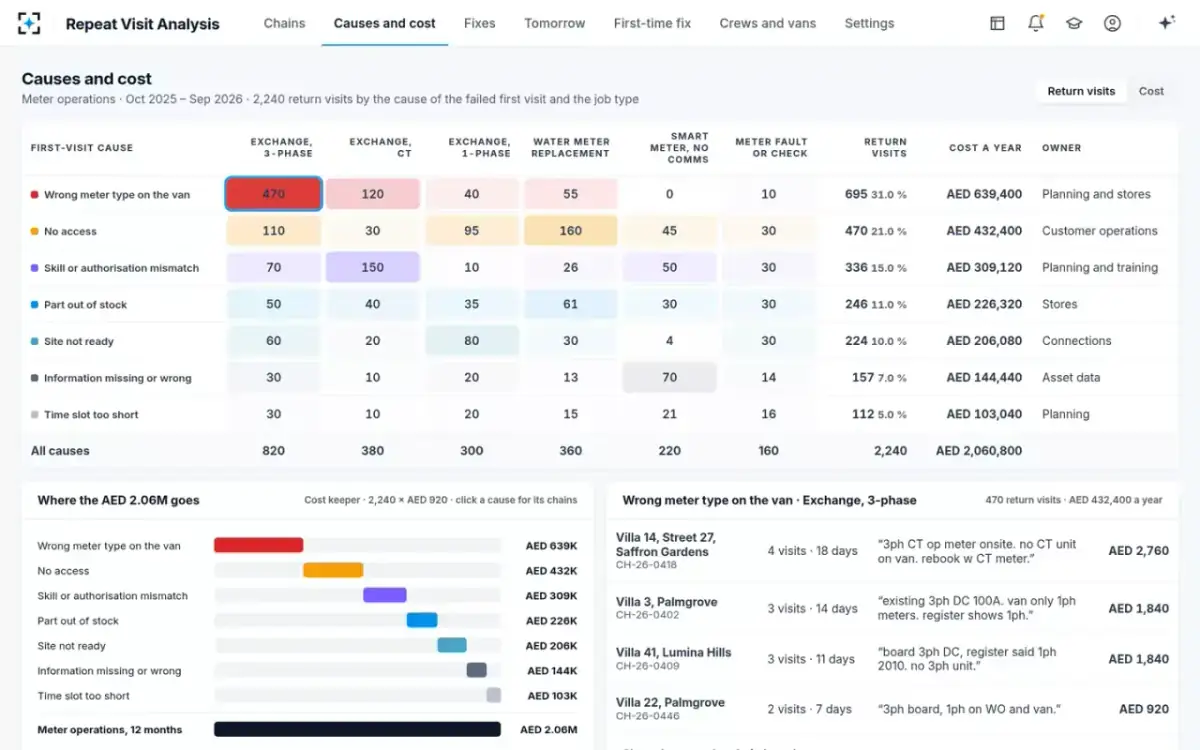

Cost keeperThe heat table splits 2,240 return visits by first-visit cause and job type. Each cause shows the team that owns it. The owners are planning and stores, customer operations, planning and training, stores, connections, asset data and planning. The largest cell is wrong meter type on 3-phase exchanges, with 470 return visits and $432,400. It opens on the chains behind it.
“Where the $2.06M goes · Cost keeper · 2,240 × $920”
- 07The fixes

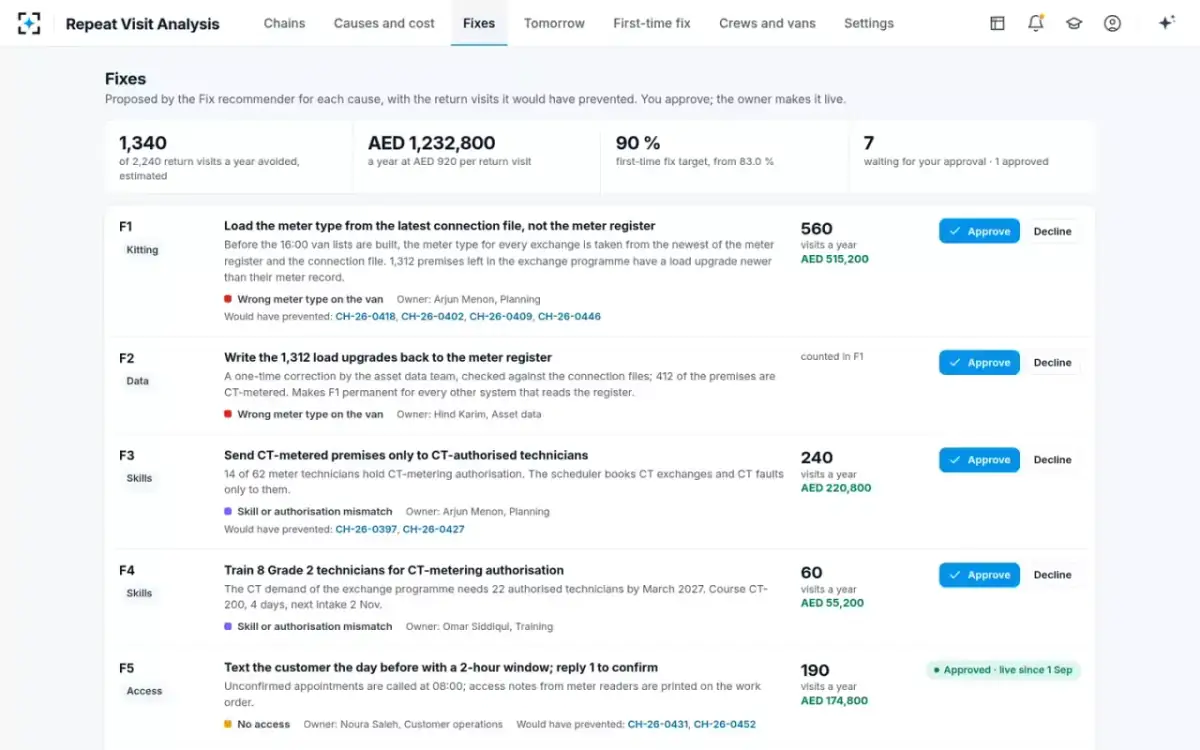

Eight fixes, each with the visits it would have prevented

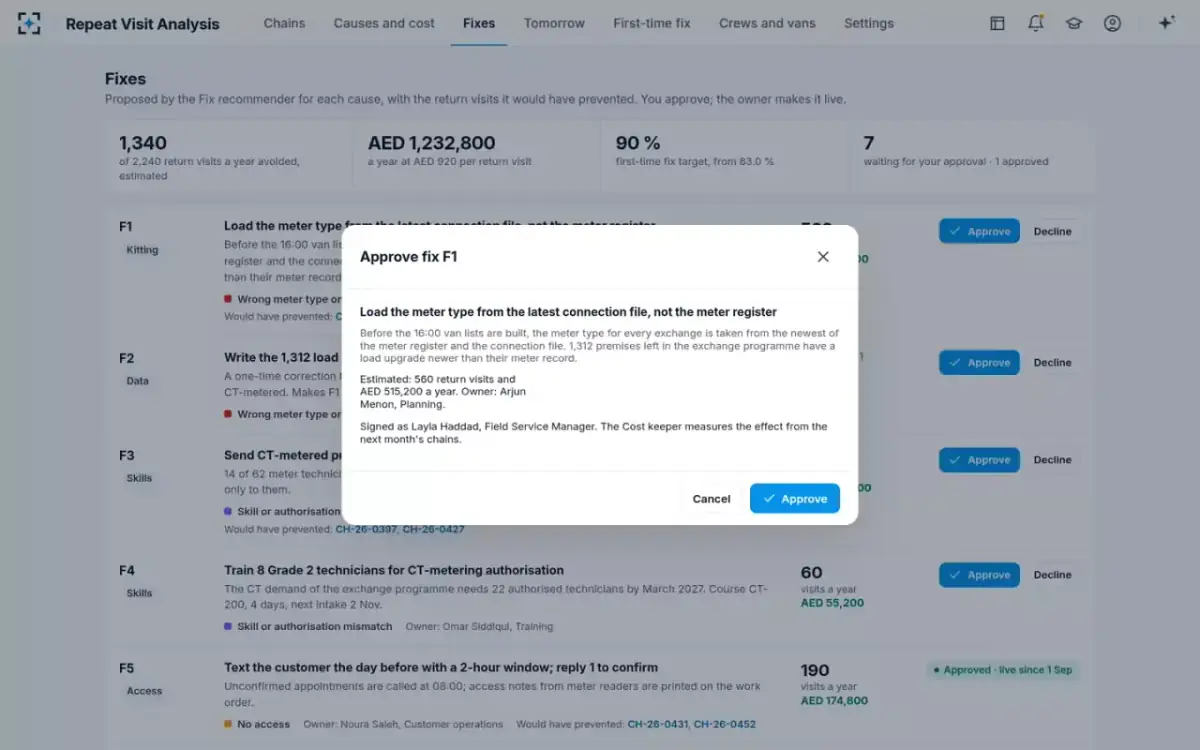

Fix recommenderThe first fix loads the meter type from the latest connection file, instead of the meter register. It would save 560 visits and $515,200 a year. The second fix writes the 1,312 load upgrades back to the register. The third sends CT-metered premises only to the 14 of 62 technicians who hold CT-metering authorization. That would save 240 visits and $220,800. A fifth fix, a text the day before with a 2-hour window, has been live since the start of last month. Each fix names its owner and the chains it would have prevented.
“Proposed by the Fix recommender for each cause … You approve; the owner makes it live.”
- 08Approved
The manager approves the first fix, and its effect will be measured
Field service managerThe approval shows the fix, the estimate and the owner. The estimate is 560 return visits and $515,200 a year, and the owner is the work planner. The manager signs as field service manager. A change to dispatch rules also needs the Head of Field Operations.
“The Cost keeper measures the effect from the next month's chains.”
- 0916:00

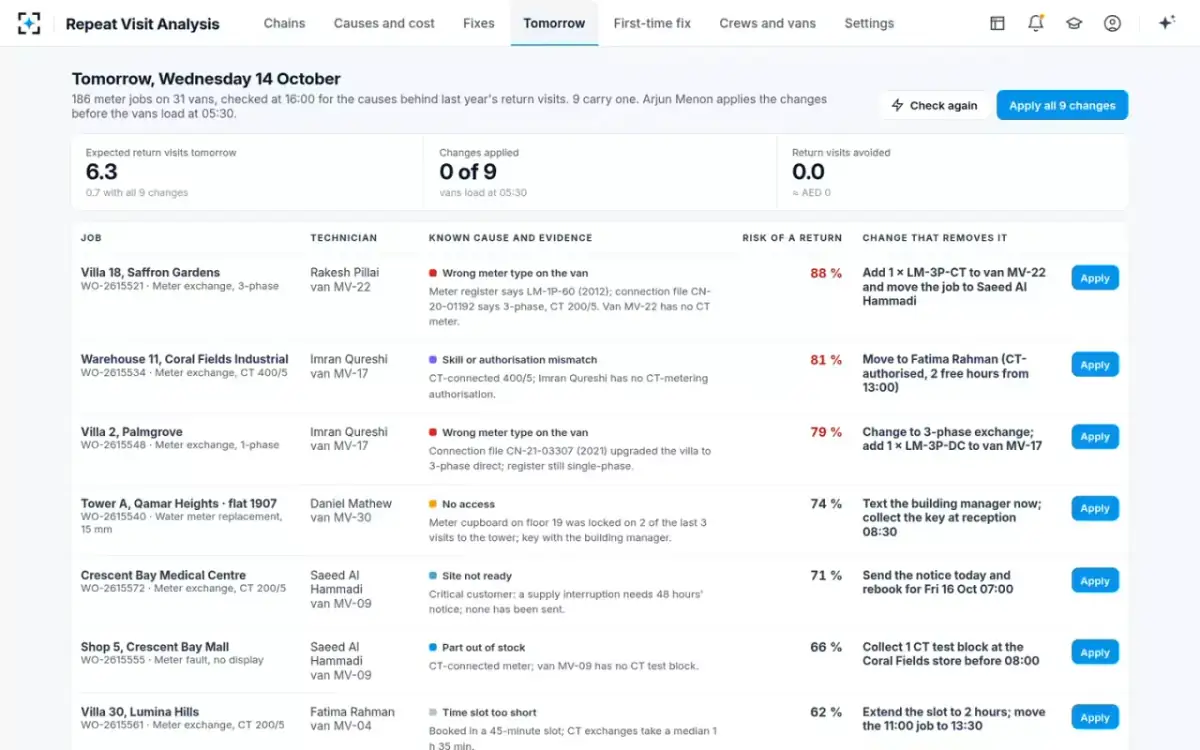

Tomorrow's 186 jobs, checked for the same causes
Tomorrow checkerFor Wednesday, 186 meter jobs on 31 vans are checked against last year's causes. Nine of them carry one. The first is another home in the same district. Its register record says a single-phase meter, but a newer connection file says 3-phase, CT 200/5. With no CT meter on the van, the risk of a return is 88 %. Others include a CT job booked to a technician without authorization. They also include a critical customer who needs 48 hours' notice of a supply interruption.
“Add 1 × 3-phase CT meter to the van and move the job to a CT-authorized technician”
- 10Before 05:30

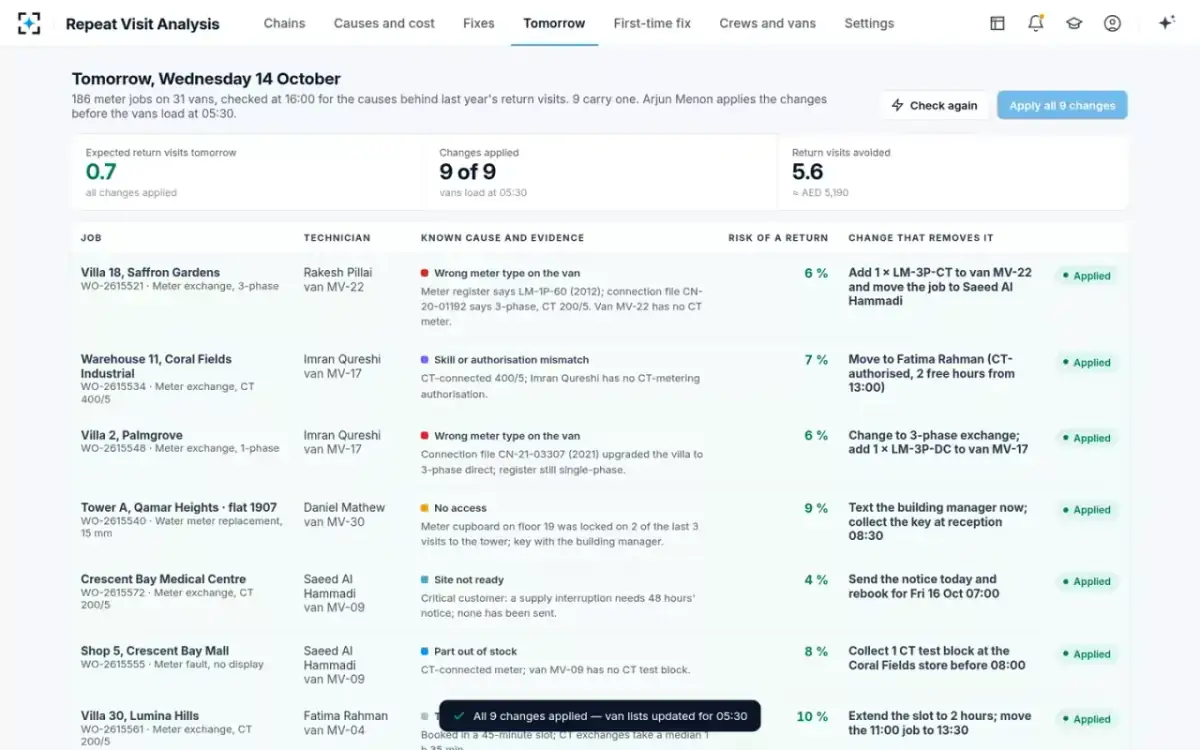

Nine changes applied before the vans load
Work plannerThe planner applies all nine changes. Expected return visits for tomorrow fall from 6.3 to 0.7. The van lists are updated for the 05:30 loadout. The agents proposed each change, and the planner made each one.
“All 9 changes applied: van lists updated for 05:30”
