WorkflowField Service & Work Management

Work Order Closeout Validation

Work order closeout validation that reads each closed job, photos included, before it goes into the asset's history

See one case, screen by screen ↓
Watch with transcript →

Built forMaintenance plannersWork supervisorsReliability engineersCrew leads

The Problem Today

Crews close jobs with blank cause codes and parts left off the job, so the asset's history and job costs can't be trusted.

What a planner checks by hand

  • Codes
  • Photos
  • Timesheets
  • Van stock
  • Parts fitted but never bookedJob costs look too low and van stock records drift
  • Most closeouts go unreadPlanners check a sample and the rest pass unchecked

The Solution

  1. Each job read on closingCodes, notes, photos, readings, hours and van stock checked overnight
  2. Photos read against partsA fuse seen in a photo but missing from the parts list is proposed
  3. Hours matched to timesheetsA crew mate's hours, worked but not booked, found against the plan
  4. Planner accepts or returnsClean jobs accepted in one click. Each gap goes to the crew to confirm

Built-in controls

  • Nothing is booked by an agent
  • Codes only from your own failure code standard
  • Each gap shows its photo, note or timesheet line

What You Get

Reliability engineers get a failure history they can group and track over time, and job costs include the parts and hours used.

5 → 1
hours for a planner to review one night's closeouts our estimate
  • Noted defects become workA crack mentioned in the notes is drafted as follow-up work for approval
  • Repeat failures flaggedThree failures in a year go to the reliability engineer
  • Plans built on real hoursHours worked get booked, so the next plan is long enough
In short

What is Work Order Closeout Validation?

It is the check a planner or supervisor does on a completed work order before it goes into the asset's history. The check confirms that the failure mode, cause and activity are coded, and that the hours and parts are booked. The photos and readings must be there, and each defect the crew saw must be raised. Work Order Closeout Validation runs that check on each closed job with six agents, and the planner accepts or sends back.

How to choose AI solutions for utilities →

Updated

The problem

Closed jobs leave an asset history nobody can plan from

When a crew finishes a job, they close it from the van. That closeout becomes the asset's history. It should say what failed, why, what was done, which parts went in, how long it took and what else the crew saw. Most closeouts say much less. A typical one reads “replaced fuse, supply restored”, with a blank cause code and one person's hours. And a part from van stock went into the asset but was never added to the job. A planner reviews 40 to 60 closeouts before planning the week, and has no time to read each photo and timesheet. So most organizations check a sample, and the rest go through unread.

The cost shows up later. A reliability engineer studies past failures to stop them coming back. A blank cause code is a failure they can't learn from. When the same failure is written five ways in five work orders, no search can group them. So there is no reliable ranking of common failures and no trustworthy average time between failures. Hours left off the job make the next plan too short. Parts left off make job costs look lower than they are and leave stock records wrong. A defect written only in the notes, such as “crossarm cracked, wants changing”, gets no follow-up work order. It comes back as an unplanned truck visit or the next outage.

estimated$250-500per repeat truck visit when a defect the crew wrote down never became follow-up work
Where a planner's morning goes, in hoursestimated
By hand5.2 hours
With the solution0.8 hours
  • Reading notes and checking failure mode, cause and activity codes1.5 → 0.2 h
  • Looking at crew photos against the parts list1 → 0.1 h
  • Matching timesheets and van-stock issues to each job0.8 → 0.1 h
  • Chasing crews for missing hours, parts and readings1 → 0.3 h
  • Raising follow-up work for defects mentioned in the notes0.5 → 0.1 h
  • Accepting the clean jobs into asset history0.4 → 0.1 h

Our estimate of the time to review one night's 46 closeouts, by hand and with the solution, in hours. It is not a measured result.

How it works

From the van's closeout to accepted asset history, check by check

What comes in
Completed job inThe night's closed jobs · notes, photos, readings, timesheets, van stock
Agents at work
Closeout checkerrules by job type
Then
Photo reader
Notes reader and coder
Labour and materials reconciler
Then
Follow-up finder
Repeat failure watcher
A person decides
Maintenance planneraccepts or sends back
What comes out
Coded asset history
Gaps back to the crew
Follow-up work raised
One case, step by step

One overnight fuse job, checked at closeout, screen by screen

At 02:14 one night, 23 properties on one street lose power. A two-person crew, a crew lead and a lineworker, find a blown low-voltage (LV) fuse on phase L2 at a pole-mounted transformer. They restore power at 04:40 and close the job from the van at 05:10. Here is what happens next, screen by screen, in the working solution.

A worked example on sample data. Names, IDs and figures on the screens and in this section come from the demo.

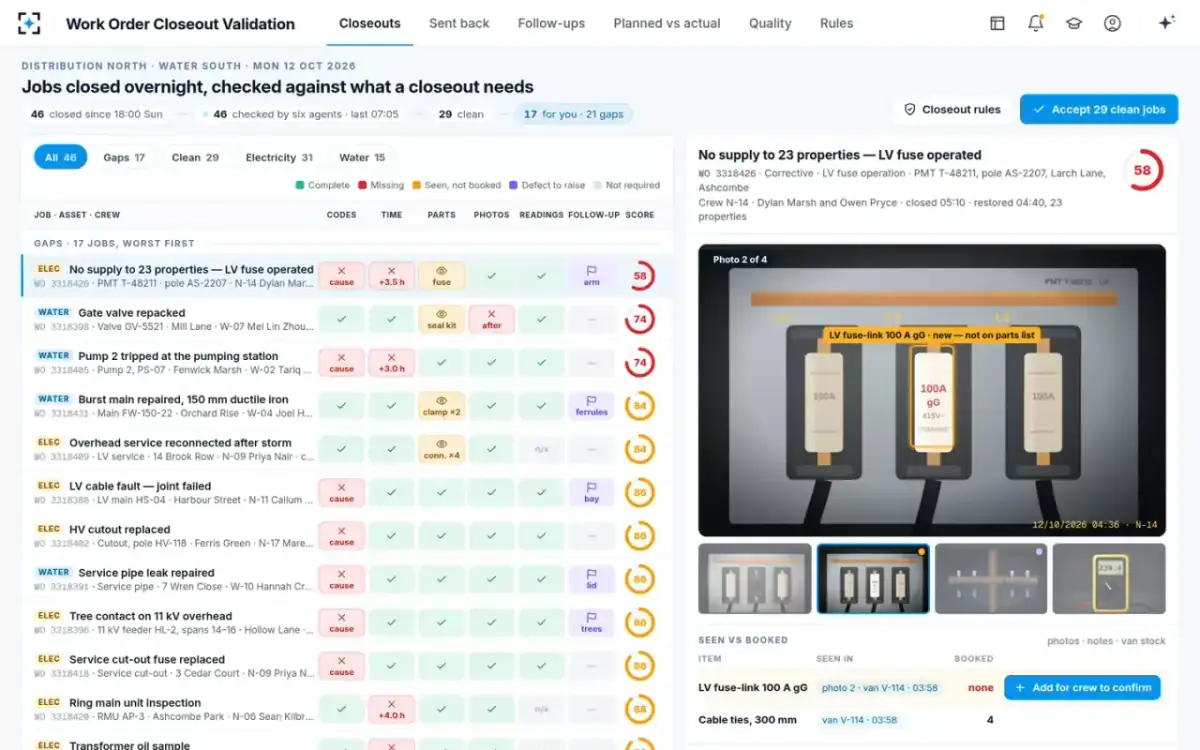

  1. 01The next morning

    The morning starts with a checklist of closed jobs

    Maintenance planner

    Forty-six jobs closed since 18:00 the evening before, across the electricity and water depots. All were checked by 07:05. Each is a row with six marks and a quality score, worst first. The marks are codes, time, parts, photos, readings and follow-up. Of these, 29 are clean and ready to accept in one click. The other 17 have 21 gaps between them. The overnight fuse job sits at the top, with a score of 58.

    “46 closed since 18:00 · 29 clean · 17 for you · 21 gaps”

  2. 02One click

    The crew's notes, read against the codes

    Notes reader and coder

    The crew lead's note reads: “L2 LV fuse blown at PMT. Bird strike on LV mains span to the next pole, remains at base. Replaced fuse, supply restored 04:40, all 23 on. Crossarm at the cutouts is cracked, wants changing.” Failure mode and activity are coded, but the cause is blank. Notes in the margin tie each sentence to what it shows. Three flag gaps: the missing cause, a fuse-link not on the parts list and a defect not raised. The fourth matches the fault record.

    “Cause is blank. The notes name a bird strike. Suggested cause: External, wildlife contact.”

  3. 033.8 seconds later

    Four photos, read the way the planner would read them

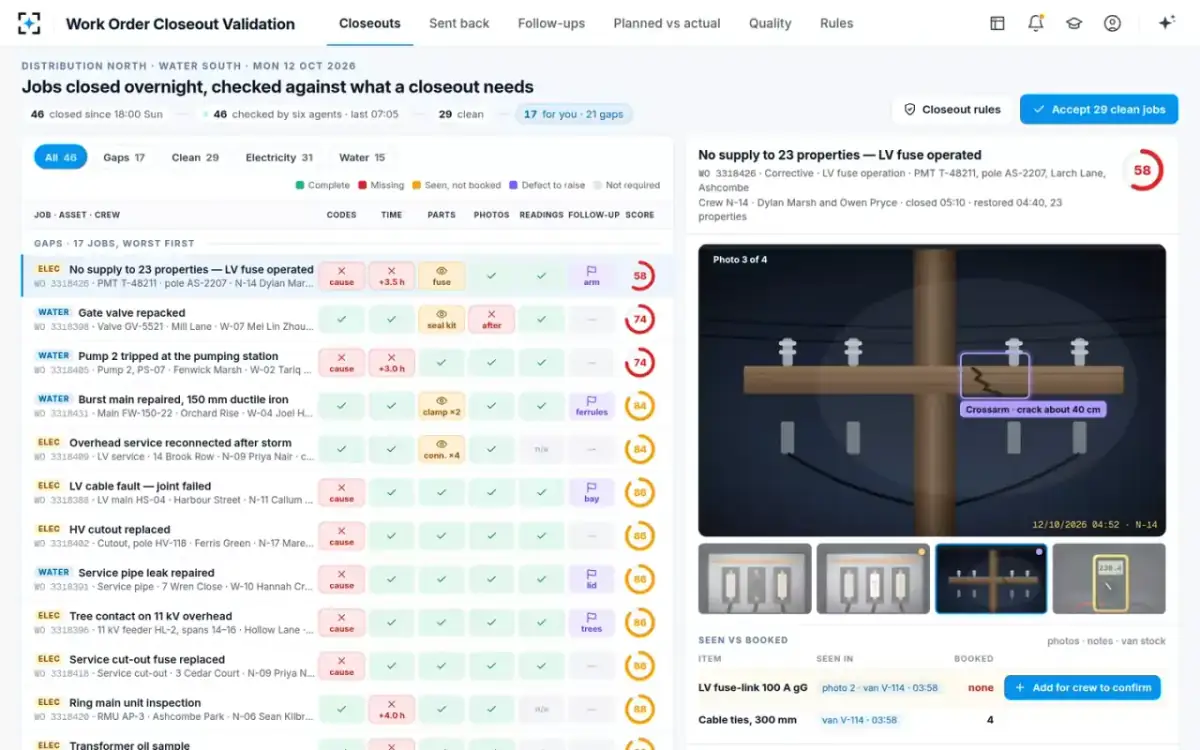

    Photo reader

    Photo 1 shows the blown L2 fuse-link. In photo 2, a new fuse-link has a readable label, “100A gG 415V”, but it is not on the parts list. The third photo catches the crossarm at the cutouts with a crack about 40 cm long. The last one reads 239.4 V between L2 and neutral after power came back. The crew's van issued one LV fuse-link 100 A gG at 03:58. The job's parts list has only four cable ties.

    The photo reader does not book a part. Below 0.85 confidence it asks instead of proposing.

  4. 04Planned vs actual

    The lineworker's hours were worked but never booked

    Labour and materials reconciler

    The timesheets show the crew lead and the lineworker on the job from 02:40 to 06:10, 3.5 hours each. Only the crew lead's 3.5 hours are booked. The plan for a standard LV fuse job is 4.0 hours, so 7.0 hours worked is 75 % over plan. That is outside the ±25 % tolerance, so the work management supervisor sees it too. The closeout summary is already written: issue, diagnosis, action and parts.

    “The lineworker worked 3.5 h on this job and it is not booked.”

  5. 05Each step, timed

    How this job was checked

    Six agents

    The run trace shows each agent's work. The closeout checker applied the rules for Corrective · LV fuse operation in 0.4 s. The notes reader matched “bird strike on LV mains” to the wildlife-contact cause at 0.93 confidence. The follow-up finder found no open work on the pole and drafted “Replace LV crossarm”, P3, 2 × 3.0 h. The repeat failure watcher found three LV fuse operations on the same transformer in seven months.

    “Score 58 / 100 · the planner decides: accept, or send back with the gaps”

  6. 06The history

    The third fuse operation, and the first with a cause

    Repeat failure watcher

    The transformer is a 200 kVA, 11 kV / 415 V unit feeding 23 properties. Its L2 fuse blew twice before in the past seven months. Both jobs closed before closeouts were checked, so they had no cause and no parts. Today's closeout is the first to give a cause: a bird strike on the span to the next pole. The watcher suggests a wildlife guard on that span for the reliability engineer, fitted when the crossarm is changed.

    “Repeat failure · three LV fuse operations in 7 months”

  7. 07Three decisions

    A part proposed, a cause accepted and work raised

    Maintenance planner

    The planner adds the fuse-link for the crew to confirm. The line goes on the parts list as proposed, linked to photo 2 and the van-stock issue. The planner accepts the suggested cause, External, wildlife contact. Then the planner approves the follow-up. “Replace LV crossarm” is raised as a new work order on the same pole, due within 28 days.

    “Follow-up raised · Replace LV crossarm”

  8. 08Sent back

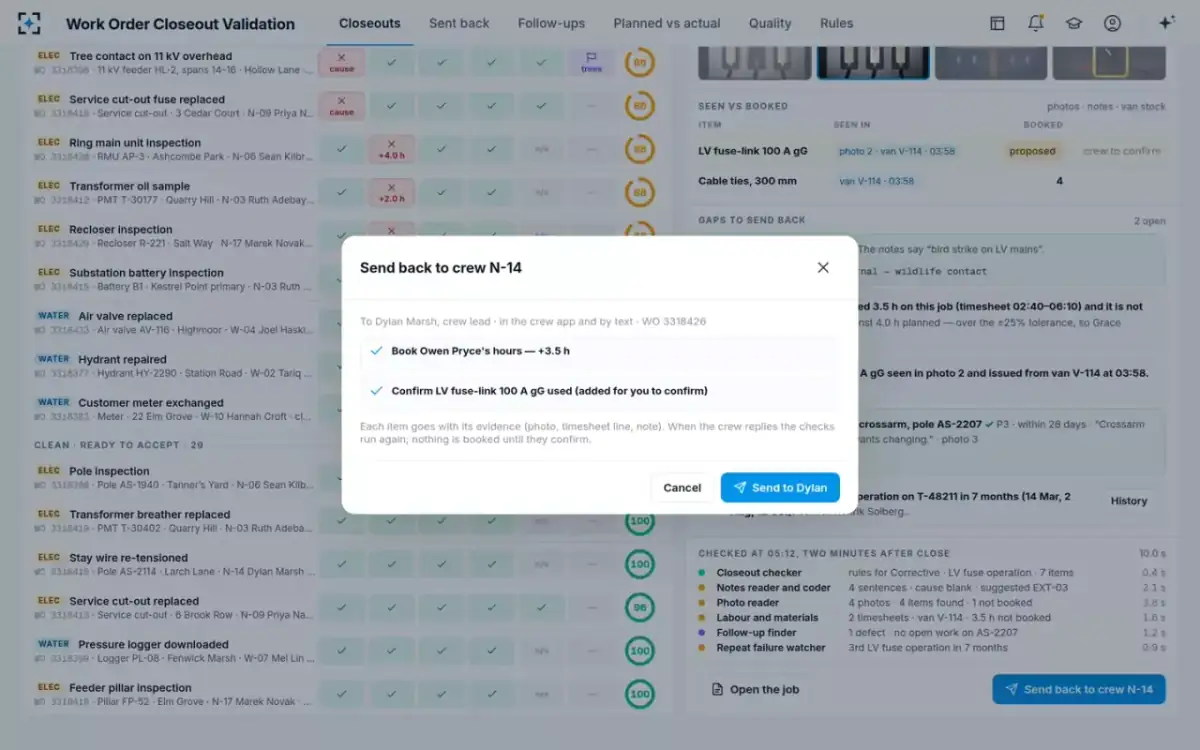

    Back to the crew with the exact gaps

    Maintenance planner

    Two items go to the crew lead in the crew app and by text. One asks them to book the lineworker's hours, +3.5 h. The other asks them to confirm the LV fuse-link 100 A gG used. Each item comes with its evidence: the photo, the timesheet line and the note.

    “When the crew replies the checks run again; nothing is booked until they confirm.”

  9. 09From the van

    Confirmed from the van

    Crew lead

    On the phone, the crew lead sees the planner's request. It shows the timesheet line for the lineworker's hours, and photo 2 with the van issue. Two taps on Yes, and the job shows confirmed at 07:52. The checks run again on the reply, and each gap on the job is closed.

    “4 jobs sent back in the last 24 hours · 3 confirmed · median reply 47 minutes”

  10. 10Clean history

    The part is on the job and the stock list goes to stores

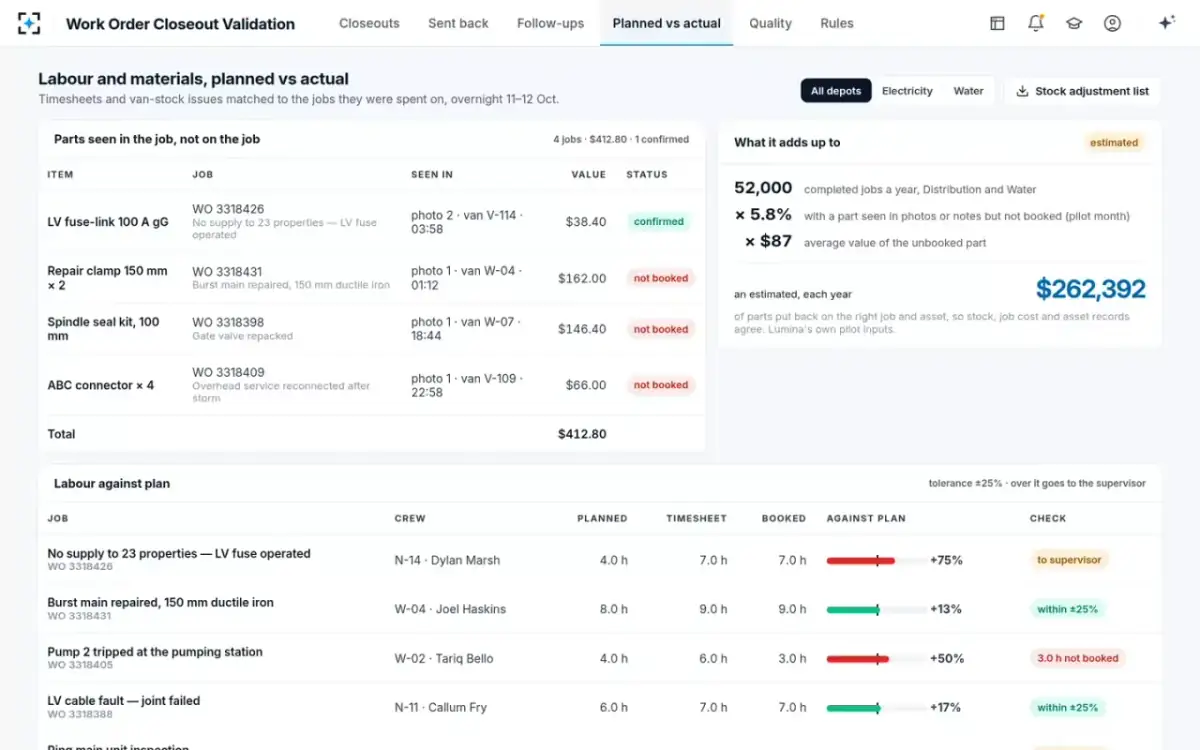

    Labour and materials reconciler

    On planned vs actual, the fuse-link line now reads confirmed. Three more parts seen but not booked overnight are still open: two 150 mm repair clamps, a spindle seal kit and four ABC connectors. With the fuse-link, that makes four lines and $412.80. The stock adjustment list goes to the electricity and water stores. The transformer's history now reads: LV fuse operated · external, wildlife contact · replaced LV fuse-link 100 A gG · 7.0 h · follow-up raised. Over six weeks, the sample has 412 of 2,214 closeouts with a blank cause code and 128 jobs with a part seen but not booked. Parts worth $11,170 are now on the right job, and 141 defects had no follow-up raised.

    Our estimate from sample inputs: $262,392 a year of parts put back on the right job and asset.

Who it’s for

Planners, supervisors, engineers and crews who rely on each closeout

One night fault's closeout, as five people see it. They are the crew lead in the van, the planner, the supervisor, the reliability engineer and the water planner.

Maintenance planner
Accepts or returns each closeout
Before
Reviews 40 to 60 closeouts each morning before planning the week. Can't plan next month from a history that just says fixed.
Now
Opens 46 jobs already checked and accepts the 29 clean ones in one click. Works through the 17 with gaps, each gap shown with its photo, note or timesheet line.
Work management supervisor
Handles labor and crew exceptions
Before
Gets the exceptions, such as crews who keep closing jobs with too little detail and labor over tolerance. Needs to know which crew, which gap and how often.
Now
Sees how many jobs each crew and depot closes clean at the first check, the gaps that keep coming back and a six-week heatmap. Sends a crew a coaching note on their three most common gaps.
Reliability engineer
Owns failure analysis for network assets
Before
Builds failure rankings and the asset health score from cause codes that are often blank. Can't learn from a failure with no cause.
Now
Gets repeat failures with the coded history behind them, such as three LV fuse operations on one transformer in seven months. Gets the suggestion to fit a wildlife guard.
Crew lead
Closes jobs and confirms gaps from the van
Before
Closes jobs from the van at 5 a.m. after a night fault. The gap the crew leaves most often is a crew mate's hours not booked.
Now
Gets the exact gap with its evidence on the phone and fixes it from the van.
Water planner
Sets what water jobs need at closeout
Before
Plans valve, hydrant, main-repair and meter jobs. Treats a main repair with no pressure reading as not done.
Now
Sets what each water job type needs at closeout, such as pressure after a main repair or old and new reads on a meter exchange. Each closeout is checked against it.
The agents

Photo, notes and labor agents behind each work order closeout

Six agents read each closed job, photos included. The planner accepts it or sends it back, and the crew confirms.

Closeout checker

Applies the closeout rules for the job type and scores each completed job. The rules cover failure mode, cause and activity codes, required photos and readings, the timesheet match and parts against van stock.

  • Never accepts, closes or rejects a job. The planner decides
  • Its checks come from the closeout rules the depot sets
Photo reader

Reads each crew photo. It picks out parts and their ratings from labels, before and after views, visible damage and meter or gauge readings. Then it compares what was fitted with the parts list and proposes the missing lines.

  • Never books a part or edits the parts list. It proposes for the crew to confirm
  • Each proposal points to its photo region
  • Below 0.85 confidence it asks instead of proposing
Notes reader and coder

Turns the crew's notes into a structured summary of issue, diagnosis, action and parts. It suggests failure mode, cause and activity codes from the code standard, citing the sentence each comes from.

  • Never writes a code to history without a person accepting it
  • Never makes up a cause the notes don't support. It says so instead
Labour and materials reconciler

Matches timesheets, crew rosters and van-stock issues to the job. It compares planned and actual labor and materials against the tolerances.

  • Never changes a timesheet or a stock record
  • Tolerances come from the closeout rules
Follow-up finder

Finds defects in the notes and photos and checks for open work on the asset. It drafts the follow-up work order with a priority and an estimate.

  • Never raises work without the planner's approval
Repeat failure watcher

Reads the asset's coded history and flags repeat failures, three operations in 12 months, to the reliability engineer.

  • Never changes a maintenance plan
Maintenance planner

Accepts or sends back, and the crew confirms.

Ask in plain words

Plain questions about a closeout, a gap, a part or a crew

Planners ask about any closed job, gap, part or crew, or say what to add or send back. Nothing is written to a job until the planner or the crew confirms. These answers use the sample data.

Why did the overnight fuse job score 58?

Three things are missing and one needs raising. Parts: photo 2 shows a new 100 A gG fuse-link, and the crew's van issued one at 03:58. The parts list has only cable ties. Time: the lineworker's 3.5 h is on the timesheet but missing from the job. Cause: blank, though the notes say “bird strike on LV mains”. And the cracked crossarm in photo 3 has no work raised.

Add the 100 A fuse-link for the crew to confirm

Added 1 × LV fuse-link 100 A gG, $38.40, to the job, marked proposed for the crew to confirm. It is linked to photo 2 and the van-stock issue at 03:58. It goes to the crew lead with the send-back. Nothing is booked until the crew lead confirms.

Which transformers had three fuse operations this year?

Three, from the coded history: one transformer with 4 fuse operations and two with 3. One of the two is the transformer from the overnight job. Today's closeout there is the first to give a cause.

Accept the 29 clean jobs

Accepted 29 closeouts: 21 electricity and 8 water. Each passed all six checks. Its summary, codes, hours and parts are now in the asset history. One of them carries a proposed follow-up for you to approve.

The screens

The closeout checklist, the photo reader and the send-back to the crew

From the working solution, on its sample data. Pick one to see it large.

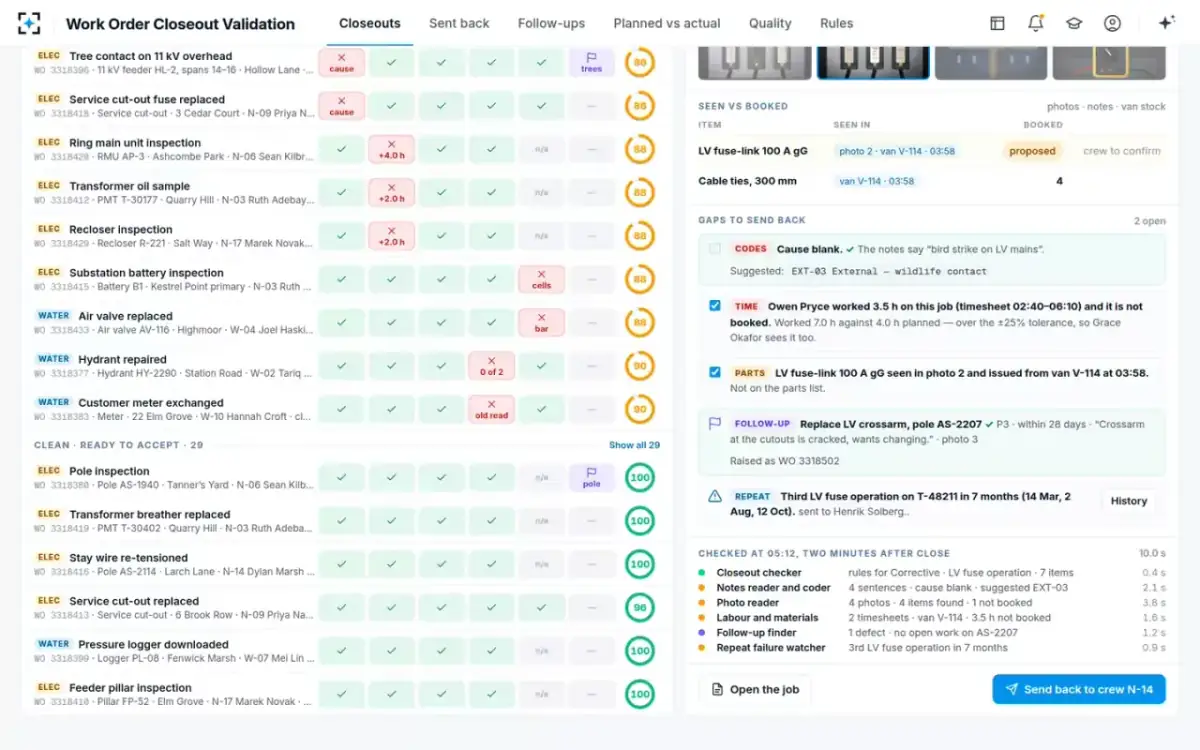

The closeout checklist46 jobs closed overnight, each checked for codes, time, parts, photos, readings and follow-up, then scored, worst first. Beside them are the selected job's photos and what was seen against what was booked.
The photo readerThe crew's photo of the crossarm, with the crack about 40 cm long boxed. The defect was in the notes but was never raised.

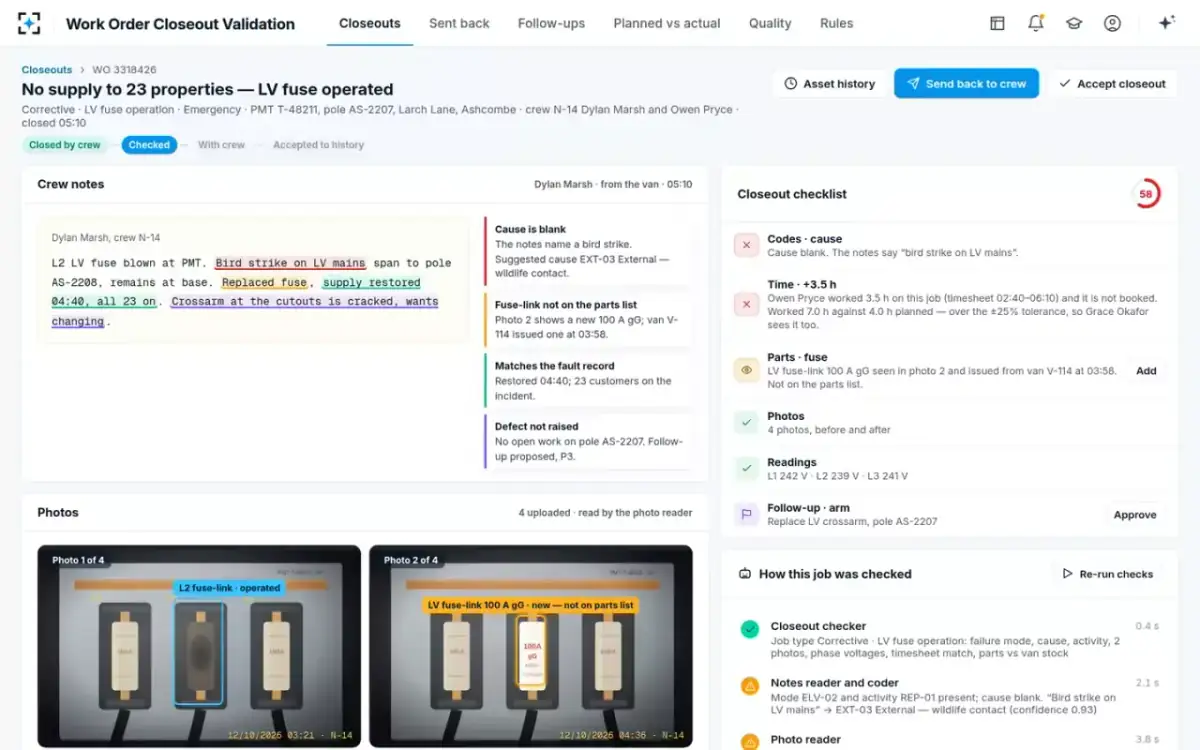

The job reviewThe crew's notes with each sentence tied to a gap, the photos read by the photo reader and the closeout checklist with its score.

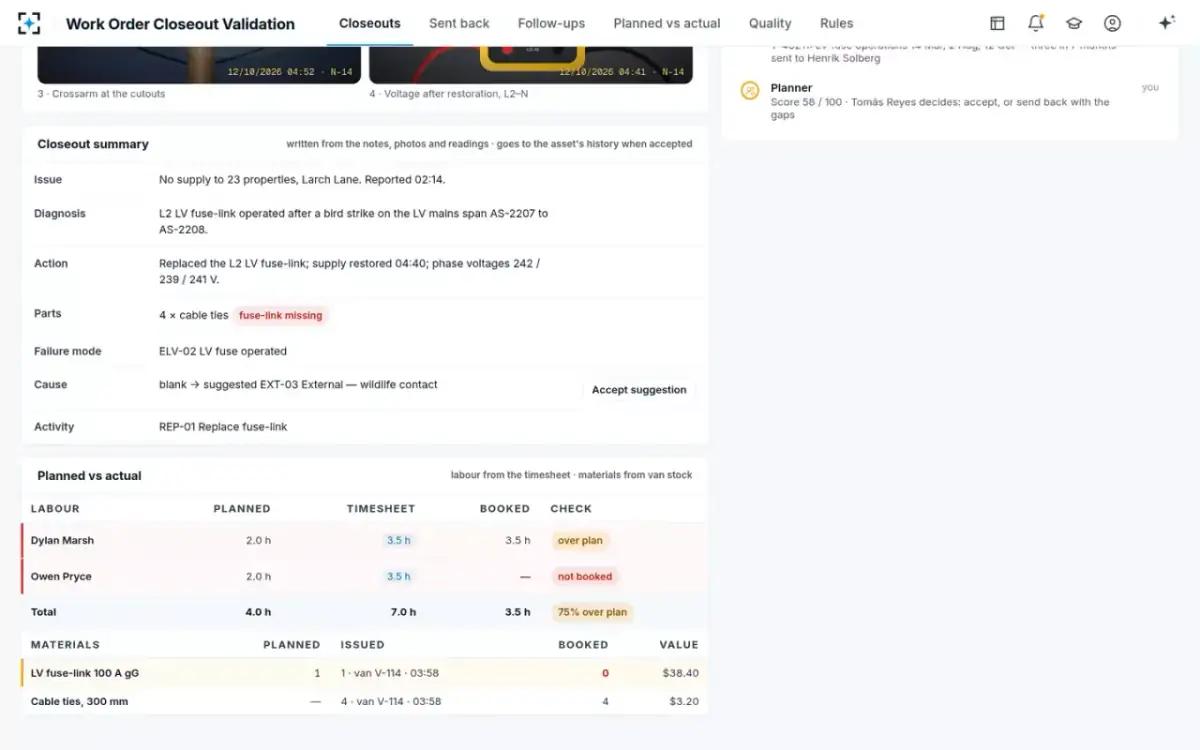

Summary and planned vs actualIssue, diagnosis, action and parts written from the notes, photos and readings, with the suggested cause. Below are labor and materials as planned, worked and booked.

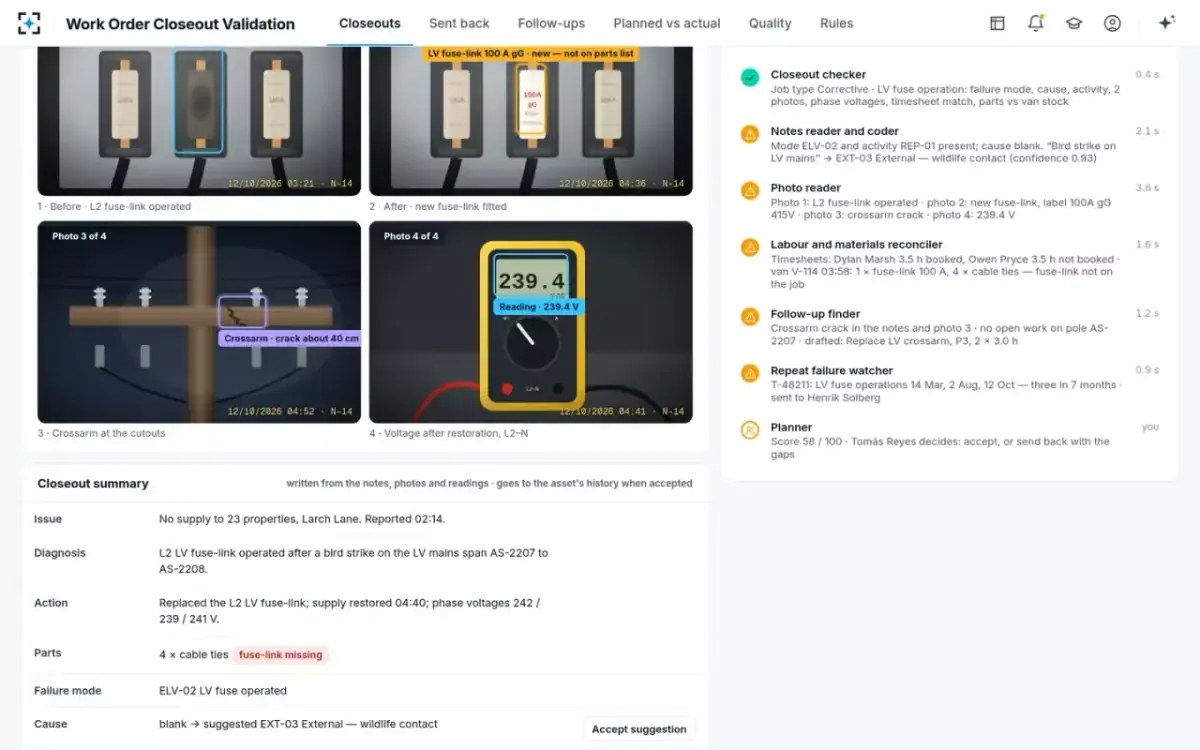

How the job was checkedAll four photos read, and each agent's step with what it found and how long it took.

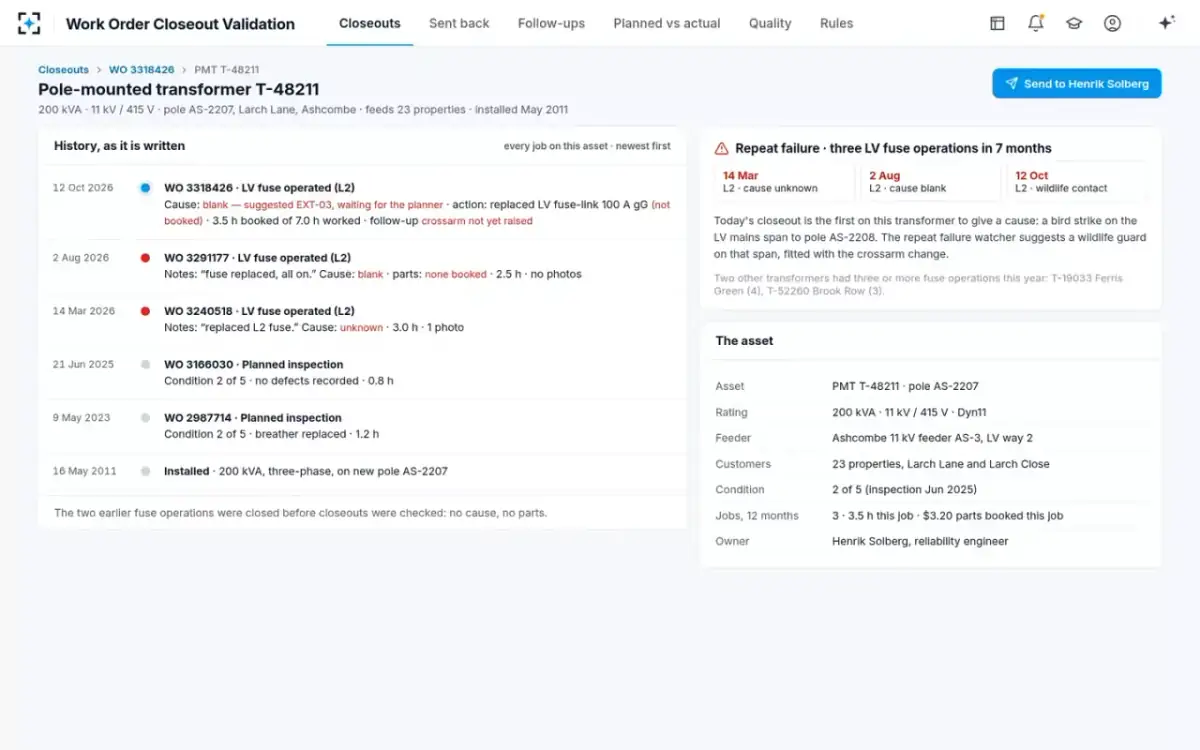

The asset's historyEach job on the transformer, newest first, with the repeat failure flag and the asset's rating, feeder and customers.
Gaps to send backThe fuse-link proposed for the crew to confirm, the cause accepted and the follow-up raised as a new work order. Two gaps are left for the crew.

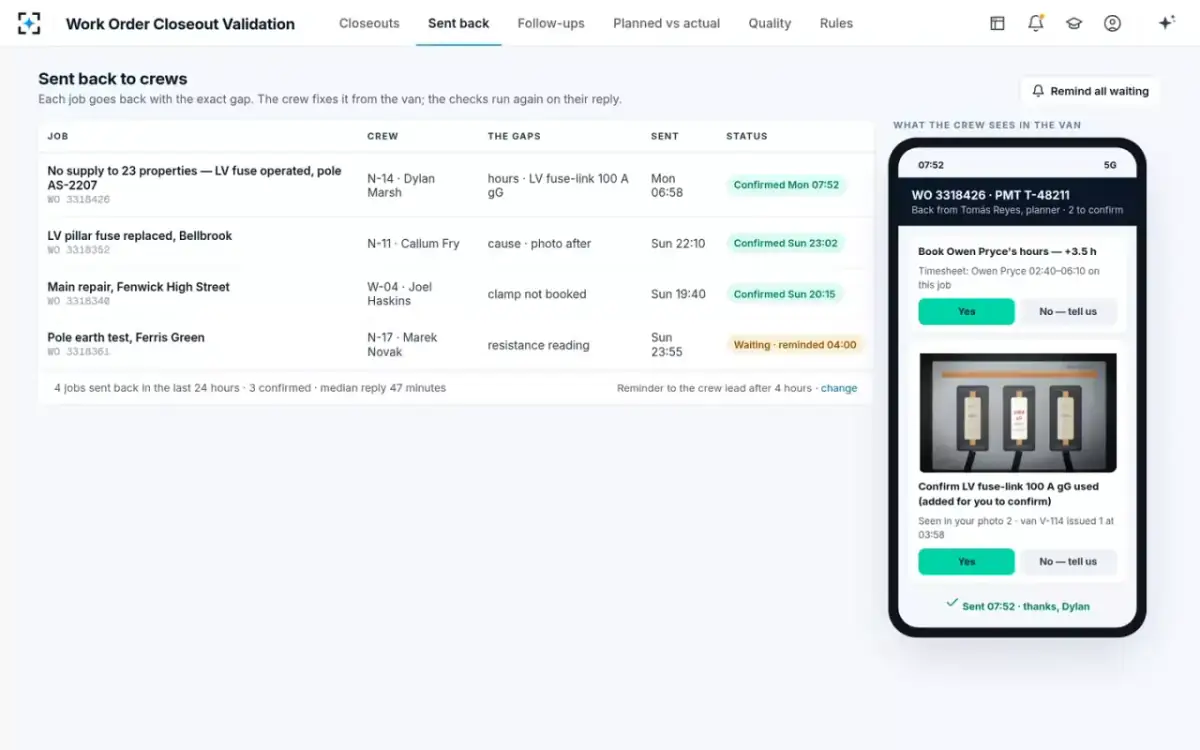

Send back to the crewThe exact gaps to the crew lead in the crew app and by text, each with its evidence.
Sent back to crewsEach job sent back with its gaps and status, and what the crew sees in the van, confirmed at 07:52.

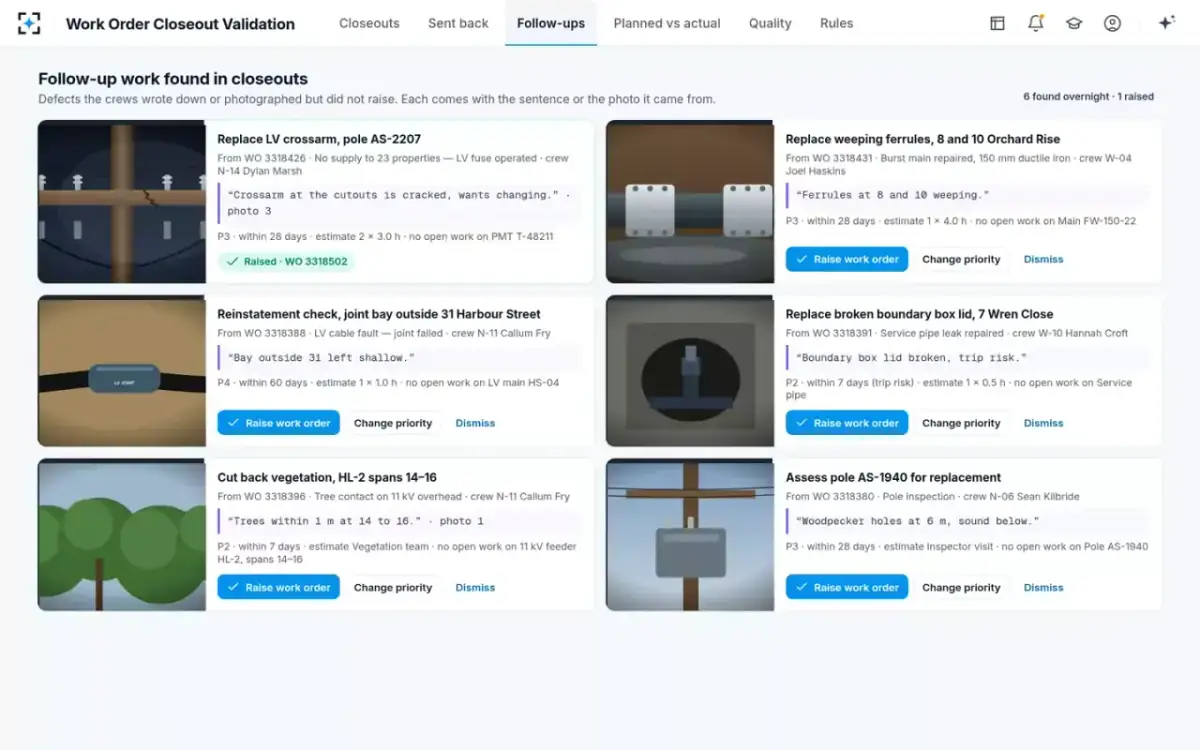

Follow-up workDefects the crews wrote down or photographed but did not raise. Each has its sentence or photo, priority, estimate and any open work on the asset.
Planned vs actualParts seen in the job but not booked to it, the stock adjustment list, the yearly estimate and its working, and labor against plan.

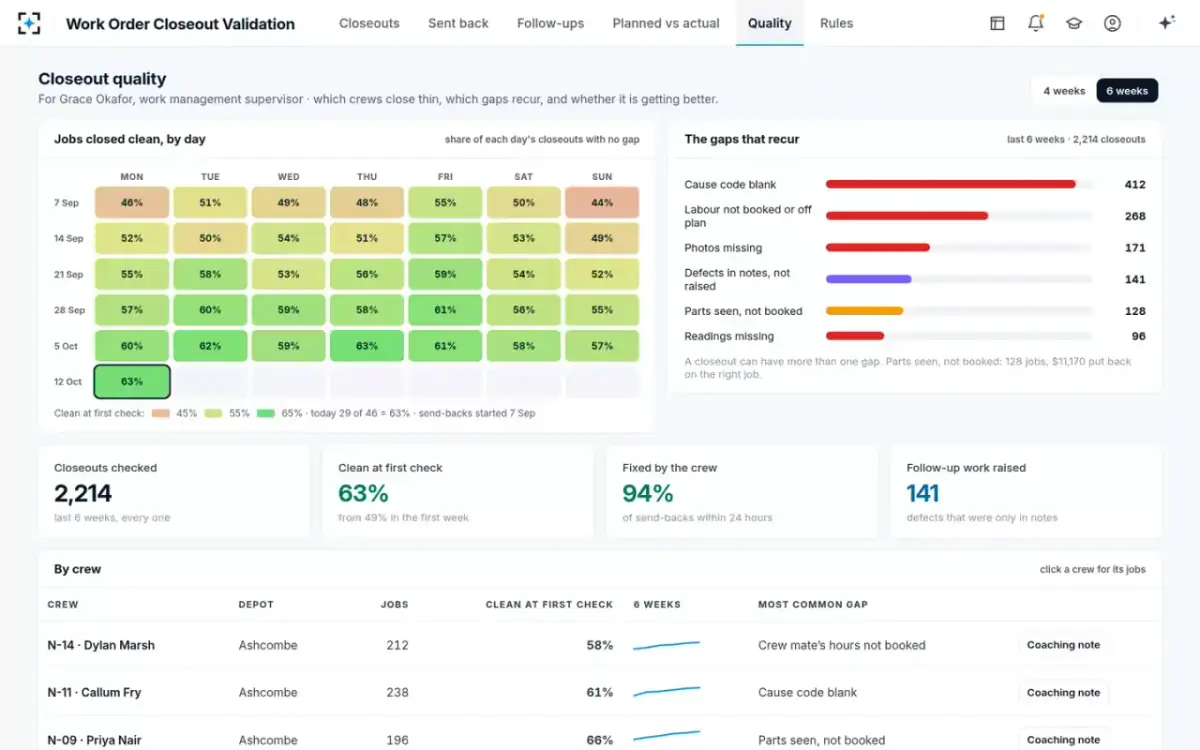

Closeout qualityJobs closed clean by day over six weeks, the gaps that recur, send-back results and first-check results by crew.

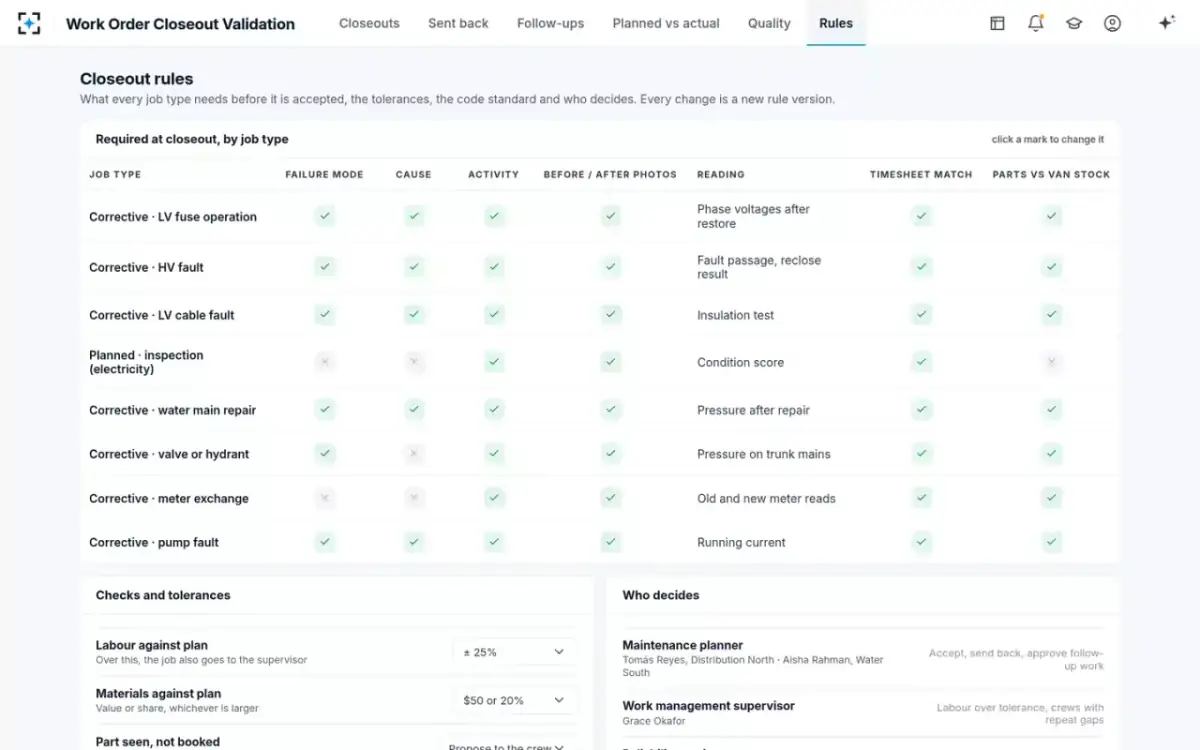

Closeout rulesWhat each job type needs at closeout, the checks and tolerances, and who decides.
Governance

Closeout validation that books nothing without a person

Each gap shows its evidenceEach finding points to where it came from: the box on the photo, the sentence in the notes, the timesheet line or the van-stock issue. It goes back to the crew with that evidence.
The planner decides, the crew confirmsAgents propose. The maintenance planner accepts, sends back or approves follow-up work. The crew lead confirms any part, hour or code an agent proposed before it is booked.
Nothing booked by an agentThe agents do not book a part, change a timesheet or stock record, or close a job. They do not raise a work order or change a maintenance plan. Nothing reaches the asset's history until the planner accepts the closeout.
The right exceptions to the right personLabor over tolerance and crews with repeat gaps go to the work management supervisor. Repeat failures and cause code changes go to the reliability engineer.
Codes from your own standardSuggested codes come from your own failure code standard, version 4 in the working solution. It is mapped to the ISO 14224 standard for failure mode, cause and activity. Each code cites the sentence it came from. Each change to the closeout rules is saved as a new rule version.
Each step on the recordEach agent step is recorded on the job with its timing. So is each human decision: who accepted, who sent back, who confirmed from the van and who approved the follow-up.
Configuration

Closeout rules by job type: codes, photos, readings and tolerances

The depot sets what each job type needs before it is accepted. It also sets the tolerances, the code standard and who decides. Each change is a new rule version.

SettingDefaultChoose from
Required at closeout, by job typeCorrective · LV fuse operation: failure mode, cause, activity, before and after photos, phase voltages after restore, timesheet match, parts vs van stockSet per job type. A water main repair needs pressure after repair. A meter exchange needs old and new meter reads. A pump fault needs running current
Labor against plan± 25 %± 15 % · ± 25 % · ± 40 %. Over this, the job also goes to the supervisor
Materials against plan$50 or 20 %$25 or 10 % · $50 or 20 % · $100 or 30 %. Value or share, whichever is larger
Part seen but not bookedPropose to the crewPropose to the crew · Hold the job until confirmed
Photo reader confidence0.850.75 · 0.85 · 0.95. Below this, the photo reader asks instead of proposing
Code standardFailure codes v4Failure codes v4 · v3 (retired). Mapped to ISO 14224 failure mode, cause and activity
Remind the crewAfter 4 hoursAfter 2 hours · after 4 hours · next morning, if a send-back is not answered
Accept clean jobs automaticallyOffOff (the planner accepts them in one click) · On above a score of 95
Connections

The completed work orders, crew photos, timesheets and van stock it reads

Completed work ordersjob type, asset, crew, failure mode, cause and activity codes, status
Crew notes and photosfree-text notes and before and after photos, sent from the crew app in the van
Timesheets and crew rosterswho worked on the job, from when to when
Van-stock issuesparts scanned out of each van, with the time
Planned labour and materialsstandard job estimates and planned parts
Failure code standardyour failure codes, mapped to ISO 14224 mode, cause and activity
What it changes

Parts booked, causes coded and defects raised after closeout validation

Each figure carries its label: a target the solution is built to, an estimate, a typical published result, or a proven one.

target
100%
of closed jobs checked for codes, time, parts, photos and readings
46 of 46 jobs
checked overnight
demo
$262K/yr
of parts not booked put back on the right job and asset, the sample's figure
Not booked today5.8% of jobs
With agentsseen and confirmed
estimated
$250-500
per repeat dispatch avoided when a defect in the notes is raised

“demo” means seen in the working solution, on its sample data. “target” means the design goal, measured in the live solution. “estimated” means our arithmetic or estimate. The $262K figure is a large utility's yearly jobs × 5.8 % with a part seen but not booked × $87 average, from sample inputs. The split of the planner's morning is our estimate, and 5 → 1 is its total in hours, by hand and with the solution. “estimated” also marks vendor figures. A truck roll costs $250 to $500 per dispatch, a conservative estimate (S&C Electric, cited by Ventavid). Context: IFS Closeout and Improvement Manager, Siemens Asset Essentials work order auto-summarization and ISO 14224 failure codes. Names on the screens are sample data.

Questions

Work order closeout questions from planners and reliability engineers

What is work order closeout validation?

It is the check a planner or supervisor does on a completed work order before it goes into the asset's history. The check confirms that the failure mode, cause and activity are coded, and that the hours and parts are booked. The photos and readings must be there, and each defect the crew saw must be raised. Work Order Closeout Validation runs that check on each closed job with six agents, and the planner accepts or sends back.

How does work order closeout automation work?

The moment a crew closes a job, the agents read it against the rules for that job type. They read its codes, notes, photos, readings, timesheets and van-stock issues. Each job becomes a row of six marks with a quality score. Clean jobs are accepted in one click. For the rest, the planner sees each gap with its evidence and sends it back to the crew, who confirm from the van.

Can it find parts that were used but not booked?

Yes. The photo reader reads part labels in the crew's photos, and the reconciler matches van-stock issues to the job. In the sample case, a new LV fuse-link 100 A gG was readable in photo 2. It was issued from the crew's van at 03:58, but it was not on the parts list. The line is proposed for the crew to confirm. The agent does not book it.

Does it work with ISO 14224 and our own failure codes?

Yes. Codes are suggested from your own code standard, mapped to ISO 14224 failure mode, cause and activity. In the working solution, that is a utility's failure codes, version 4. The notes reader cites the sentence behind each code. When the notes don't support a cause, it says so. It does not write a code to history until a person accepts it.

How does it raise follow-up work from technician notes?

The follow-up finder reads the notes and photos for defects and checks for open work on the asset. It then drafts the work order with a priority and an estimate. In one night it found six, from a cracked crossarm to a boundary box lid that could trip someone. Nothing is raised until the planner approves it.

Is it built for electricity and water utilities?

Yes. The working solution checks electricity jobs, such as LV and HV faults, cable faults and inspections. It checks water jobs too, such as main repairs, valves and hydrants, meter exchanges and pump faults. Each has its own required codes, photos and readings. Examples are phase voltages after power is restored, or pressure after a main repair.

Can an agent book a part or close a job on its own?

No. Agents propose. They do not book parts, change timesheets, close jobs or raise work on their own. The planner accepts, sends back and approves follow-up work. The crew lead confirms anything an agent proposed. Labor over tolerance goes to the supervisor, and repeat failures go to the reliability engineer.

Which of our records does the setup need?

Your closeout procedure, failure code standard, job types and a sample of completed work orders. The Agentic Solution Engine builds and deploys the solution from those requirements and documents. It goes live once each quality gate has passed. We will walk you through it on your own closed jobs first.

Try work order closeout validation
on your own closed jobs.

We'll run Work Order Closeout Validation on a sample of your own completed work orders, photos and timesheets.
