SystemField Service & Work Management

Work Order Backlog Management

Work order backlog management that shows when the backlog will clear, and which compliance deadlines are at risk before they are missed

See one case, screen by screen ↓
Watch with transcript →

Built forWork management managersOperations directorsSchedulersStores leadsOutage planners

The Problem Today

Managers count open jobs but can't see the hours they hold. Compliance work that falls behind is found at month end, too late to add a crew.

4-6×
what unplanned work costs against the same work planned ahead published

What a status code doesn't say

  • Materials
  • Outage
  • Permits
  • Design
  • Ready and blocked jobs mixedCrews get sent to jobs still waiting for a pole
  • No date for storm recoveryOnly a planner's spreadsheet can answer it

The Solution

  1. Each open job sized nightlyOpen work orders sized in labor hours and crew-weeks
  2. What each job waits forMaterials, outage, permit and design checked, each with its record
  3. Blockers chased by deadlineBlocked jobs grouped by cause, with a follow-up drafted to each owner
  4. The director approvesThe manager tries a contractor crew and the director approves the spend

Built-in controls

  • Compliance work cannot be deferred in any plan
  • Read-only on the work management system
  • Ready means proven, with a record

What You Get

Fewer compliance deadlines are missed, and more of the region's work is planned ahead, with less done as emergencies.

$1.0M
a year of unplanned-work premium avoided in a 48,000-hour region our estimate
33 → 5.5
hours a week to review a region's backlog our estimate
  • A clearance date each weekThe forecast shows when the backlog reaches target
  • Crews sent to ready workA steady amount of proven-ready work kept on hand
  • The weekly report, draftedSize, blockers, deadlines at risk and the forecast
In short

What is Work Order Backlog Management?

It sizes, ages and ranks a utility's open work. You see how many labor hours and crew-weeks the work holds, and which jobs are ready or blocked. The same view shows which deadlines are at risk and when the backlog will clear. Work Order Backlog Management does this for electricity and water work in one view. Six agents do the work, and a manager and a director make the decisions.

How to choose AI solutions for utilities →

Updated

The problem

Managers count their open jobs but can't see which compliance dates are at risk

A work management manager runs a utility region's open work, which adds up to thousands of open jobs. Some are compliance work with a legal deadline, such as replacing condemned poles before the date in the license. Others are priority defects found on line patrols, substation and pump-station upkeep, and new connections with a date promised to the customer. There is also valve exercising, hydrant work, main repairs and putting roads back after a dig. In the work management system, each job is one row with a status code. The code rarely says what the job is really waiting for. It might be a pole on a late purchase order, a permit to dig up a road or a design pack. Or it might need an outage window, a planned time when the power is off so crews can work, and nobody has asked for one.

So the backlog gets counted, but never sized in hours. Managers know how many jobs they have. They don't know how many crew-weeks of work that is, or when it will be done. Ready and blocked jobs sit in one list, so schedulers send crews to jobs that are still waiting for materials. A compliance program is found to be behind at month end, when it is too late to add a crew. After a storm uses up weeks of crew time, nobody can say when the work will catch up. Answering that takes a planner and a spreadsheet.

typical$2.5Mcitation from California's utility regulator to one utility for nearly 55,000 pole inspections not done (2021)
typical4-6×how much more unplanned work costs than the same work planned and scheduled
typical170,000repairsof power line work in one utility's backlog, which regulators said put safe, reliable service at risk
Where a manager's week of backlog review goes, in hoursestimated
By hand33 hours
With the solution5.5 hours
  • Exporting open work orders and sizing them in a spreadsheet6 → 0.5 h
  • Finding out what each “ready” job is really waiting for8 → 1 h
  • Checking compliance and customer jobs against their deadlines4 → 0.5 h
  • Chasing stores, network control, design and permits6 → 2 h
  • Working out a recovery date and what a contractor crew would gain5 → 0.5 h
  • Writing the weekly backlog report for the director4 → 1 h

Estimated split of one week's backlog review for a region, in hours, by hand and with the solution.

How it works

Open work orders sized, checked and dated toward a clearance date

What comes in
Work in4 sources · work orders, crews, deadlines, stores
Agents at work
Backlog sizerhours · crew-weeks
Then
Readiness checker
Due-date watcher
Then
Burn-down forecasterclearance date · what-if
Then
Blocker chaser
Report writer
A person decides
Operations directorapproves the plan and the spend
What comes out
Clearance date
Blockers cleared
Deadlines met
One case, step by step

A region's open work orders sized, dated and forecast overnight

This utility region runs electricity and water work from three depots with 14 crews. On a Tuesday in October it has 1,940 open work orders. Here is what happens next, screen by screen, in the working solution.

A worked example on sample data. Names, IDs and figures on the screens and in this section come from the demo.

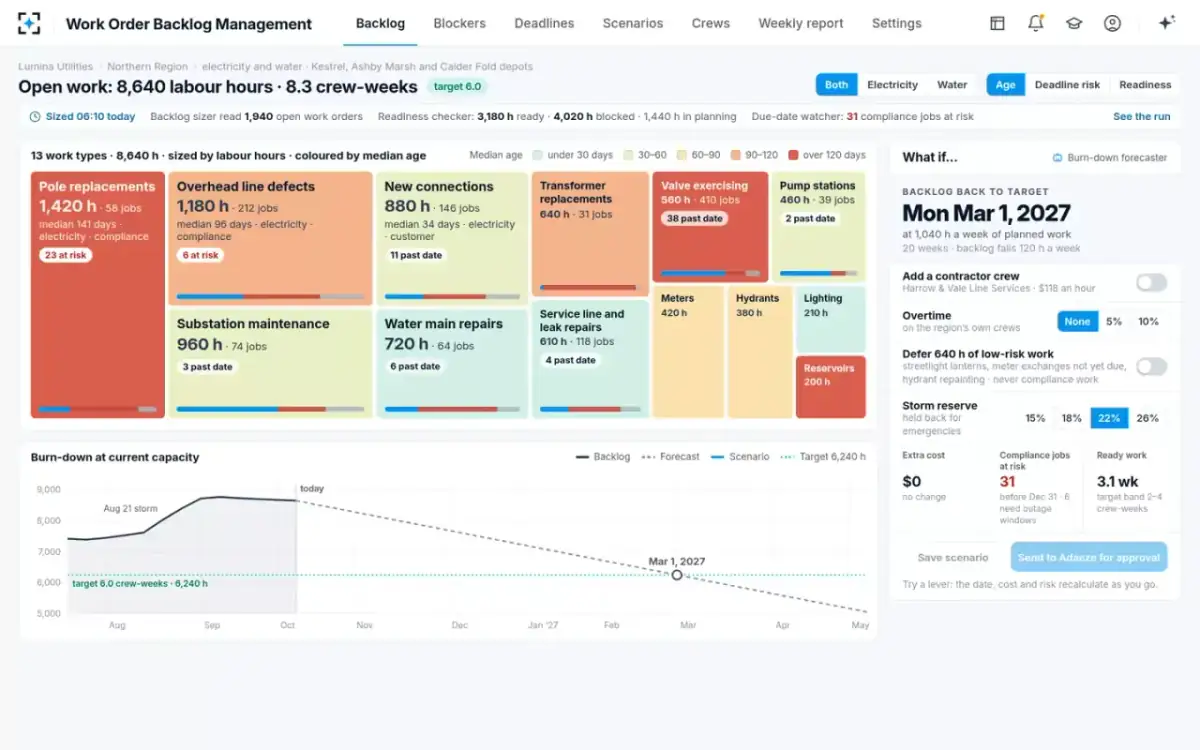

  1. 01Morning

    The whole backlog on one screen, sized in hours

    Work management manager

    The manager owns the region's open work. The backlog is 8,640 labor hours, or 8.3 crew-weeks against a target of 6.0. Thirteen work types appear as tiles, sized by hours and colored by median age. Pole replacements is the biggest red tile: 1,420 h in 58 jobs, a median of 141 days old, with 23 at risk. Below it, a chart shows 12 weeks of history, the late-summer storm and the forecast at current capacity.

    Backlog back to target in 20 weeks, next March. At 1,040 h a week of planned work, the backlog falls 120 h a week

  2. 0206:10

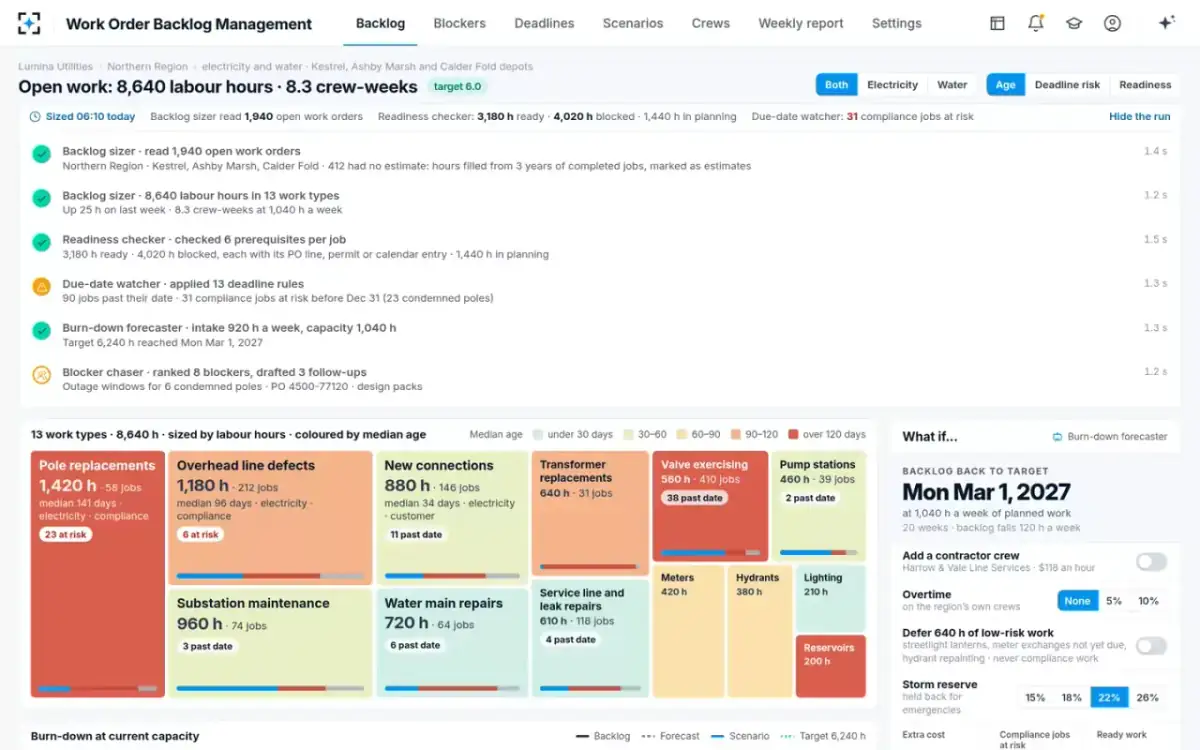

    Each open job sized, checked and dated before the manager arrives

    Backlog sizer, Readiness checker, Due-date watcher

    Overnight, the Backlog sizer read 1,940 open work orders and sized them at 8,640 labor hours in 13 work types. The Readiness checker checked six prerequisites per job. It found 3,180 h ready and 4,020 h blocked, each with its purchase-order line, permit or calendar entry, plus 1,440 h in planning. The Due-date watcher applied 13 deadline rules. It found 90 jobs past their date and 31 compliance jobs at risk before the year end.

    “412 had no estimate: hours filled from 3 years of completed jobs, marked as estimates”

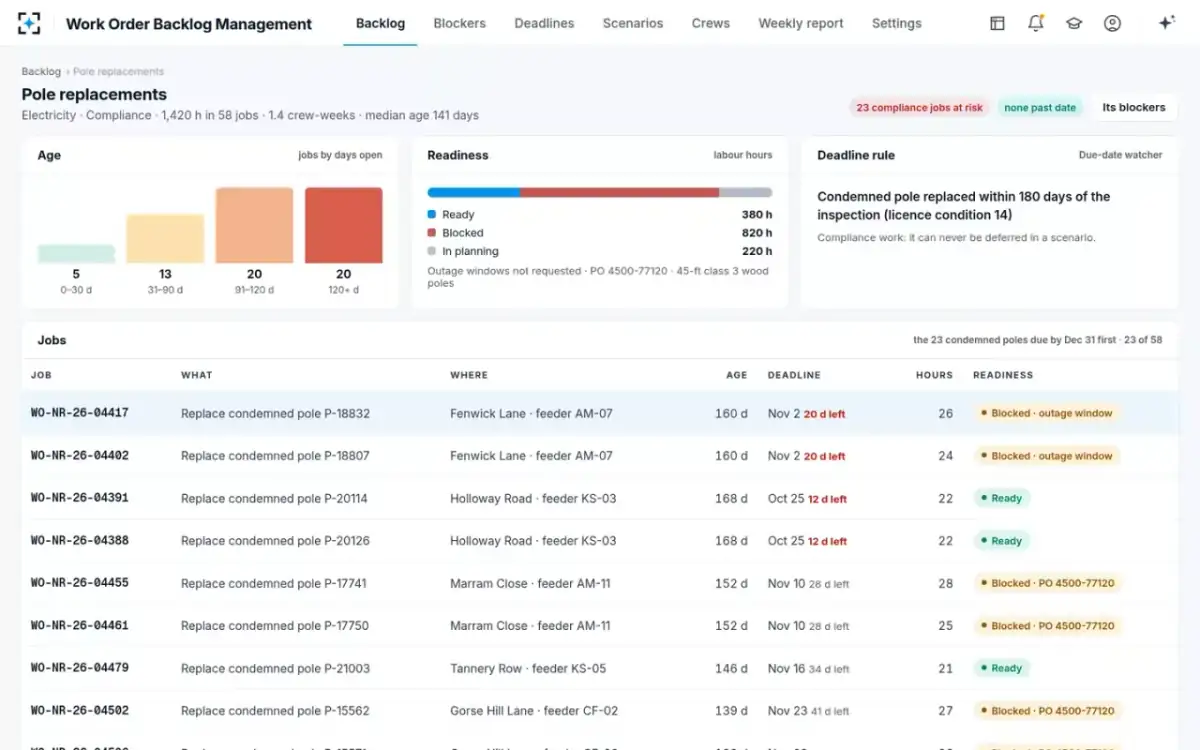

  3. 03One click

    Pole replacements, with 23 condemned poles against the 180-day limit

    Due-date watcher

    Opening the tile shows how old the jobs are and how ready they are: 380 h ready, 820 h blocked and 220 h in planning. It also shows the deadline rule. License condition 14 says a condemned pole must be replaced within 180 days of its inspection. The jobs table lists the 23 condemned poles due by the year end first. Two on one road have 12 days left and are ready. Two on another are waiting for an outage window.

    “Compliance work: it can never be deferred in a scenario.”

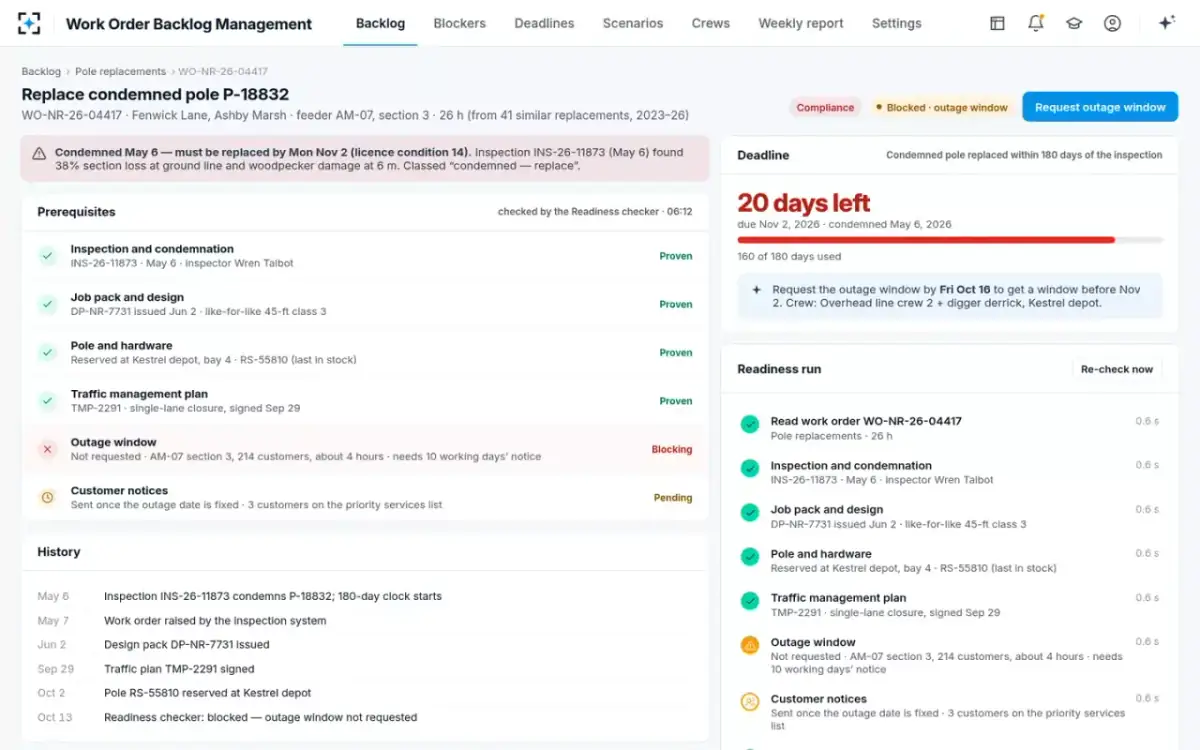

  4. 04The job

    One condemned pole, with everything in place except the outage

    Readiness checker

    The job is to replace a condemned pole on feeder section 3. It will take 26 h, estimated from 41 similar replacements. The inspection found 38% of the pole's cross-section lost at ground line. Four prerequisites are proven, each with its record: the inspection, the design pack, the pole reserved in a depot bay and the traffic plan. The outage window was never requested. There are 214 customers on that section, and 3 of them are on the priority services list.

    “20 days left · 160 of 180 days used.” Request the outage window by Friday to get one before the limit

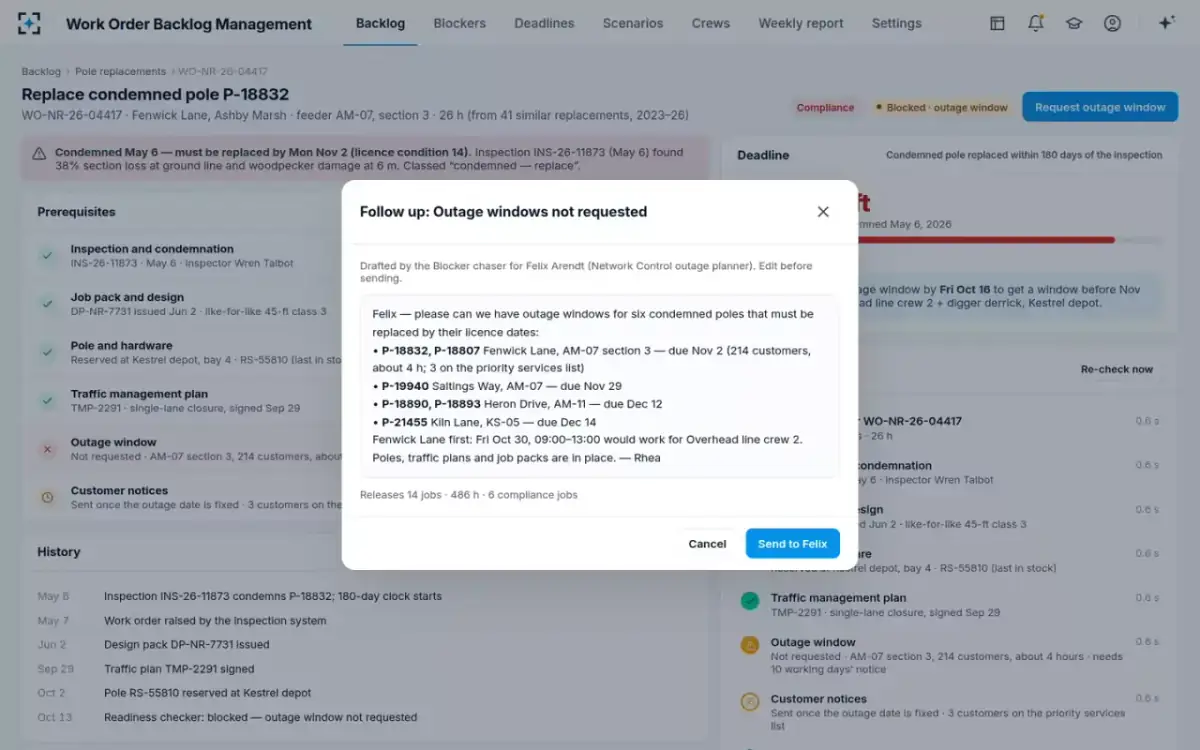

  5. 05Drafted

    Six outage windows, asked for in one note

    Blocker chaser

    The Blocker chaser has already drafted the request to the outage planner in network control. It covers six condemned poles on three feeders and gives each pole's license date. It asks for a first window in the morning, 09:00 to 13:00, for an overhead line crew. The note says the poles, traffic plans and job packs are in place. The manager edits it and presses send.

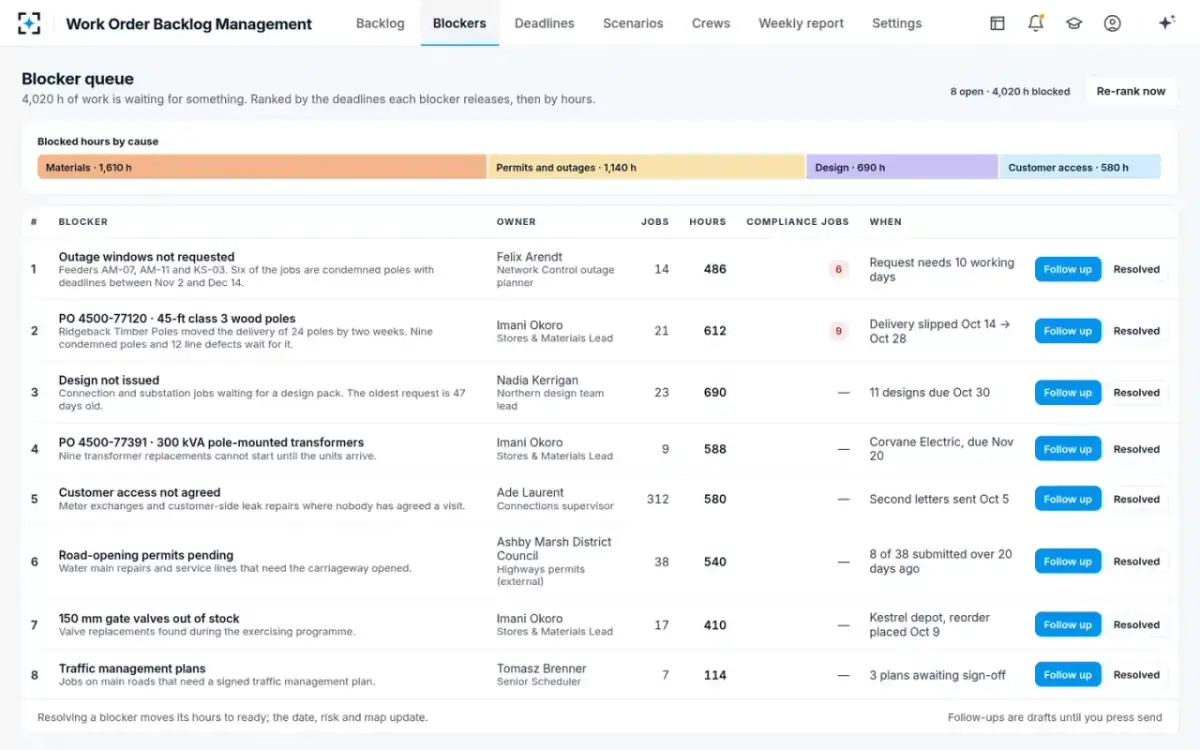

    “Releases 14 jobs · 486 h · 6 compliance jobs”

  6. 06The blockers

    4,020 blocked hours, ranked by the deadlines they release

    Blocker chaser

    There are eight blockers, and each has a named owner. By cause, the blocked hours are materials 1,610 h, permits and outages 1,140 h, design 690 h and customer access 580 h. Second on the list is one purchase order. The pole supplier pushed the delivery of 24 poles back two weeks, and nine condemned poles and 12 line defects wait for it. The stores lead gets a drafted follow-up asking the supplier for a part delivery of 9 poles a week sooner.

    “Resolving a blocker moves its hours to ready; the date, risk and map update.”

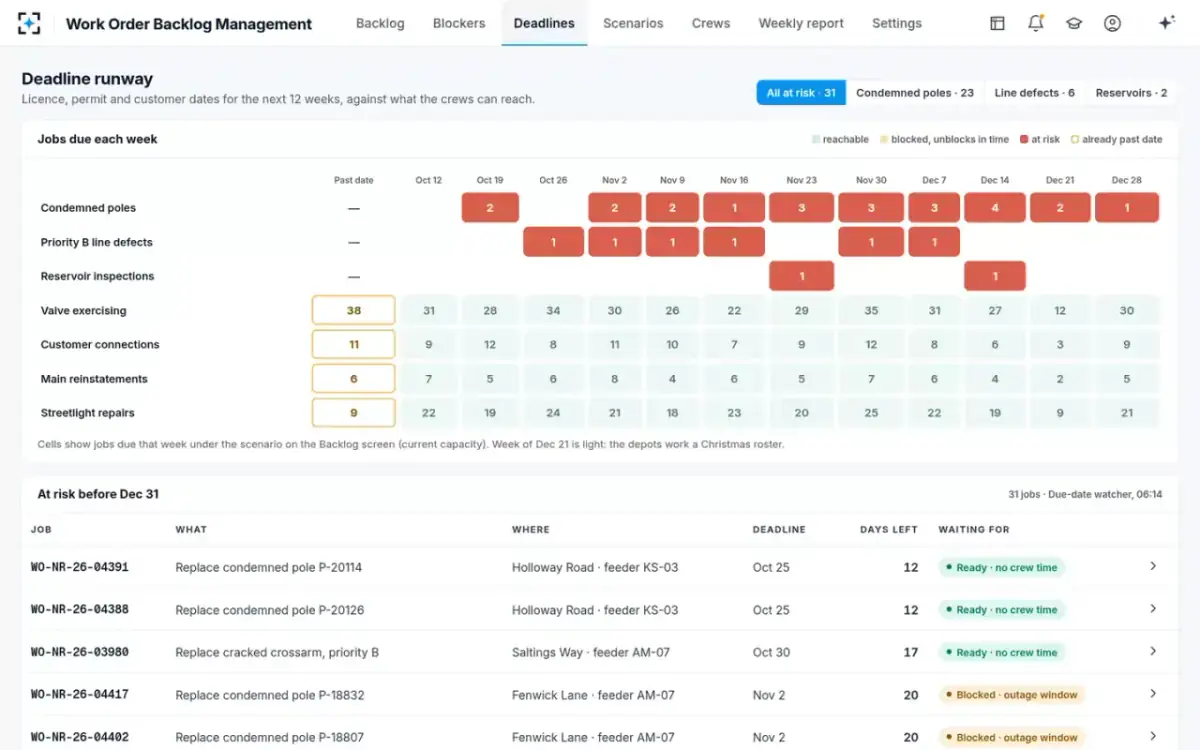

  7. 0712 weeks ahead

    The deadline runway, week by week

    Due-date watcher

    This view sets license, permit and customer dates for the next 12 weeks against what the crews can reach. At risk are 23 condemned poles, 6 priority B line defects and 2 reservoir inspections. The first deadlines are the two ready poles, due within two weeks, with no crew time free before then. Valve exercising already has 38 jobs past their date, and customer connections have 11.

    “The holiday week is light: the depots work a holiday roster.”

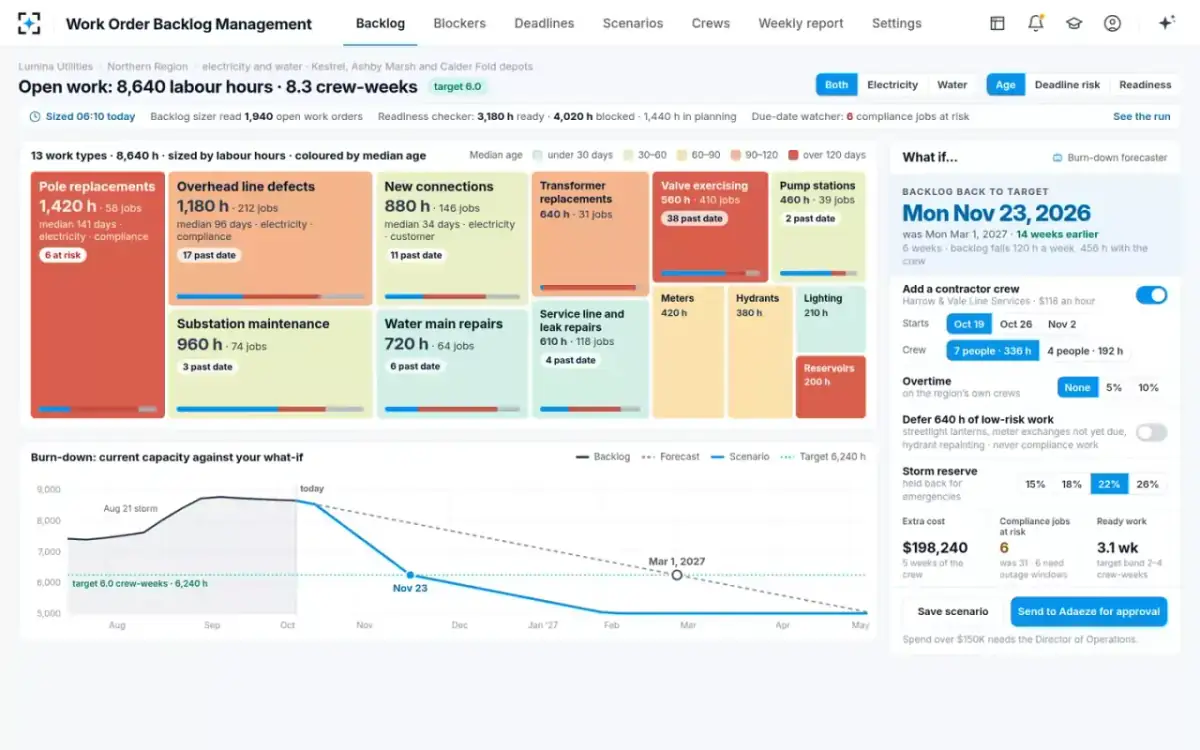

  8. 08What if…

    A contractor crew brings the clearance date 14 weeks closer

    Burn-down forecaster

    The manager adds a 7-person contractor line crew from the following week. It gives 336 h a week at $118 an hour. The backlog now falls 456 h a week and reaches target in November, 14 weeks earlier, for $198,240. Compliance jobs at risk fall from 31 to 6. Ready work stays at 3.1 crew-weeks, inside the 2 to 4 week band.

    “Spend over $150K needs the Director of Operations.”

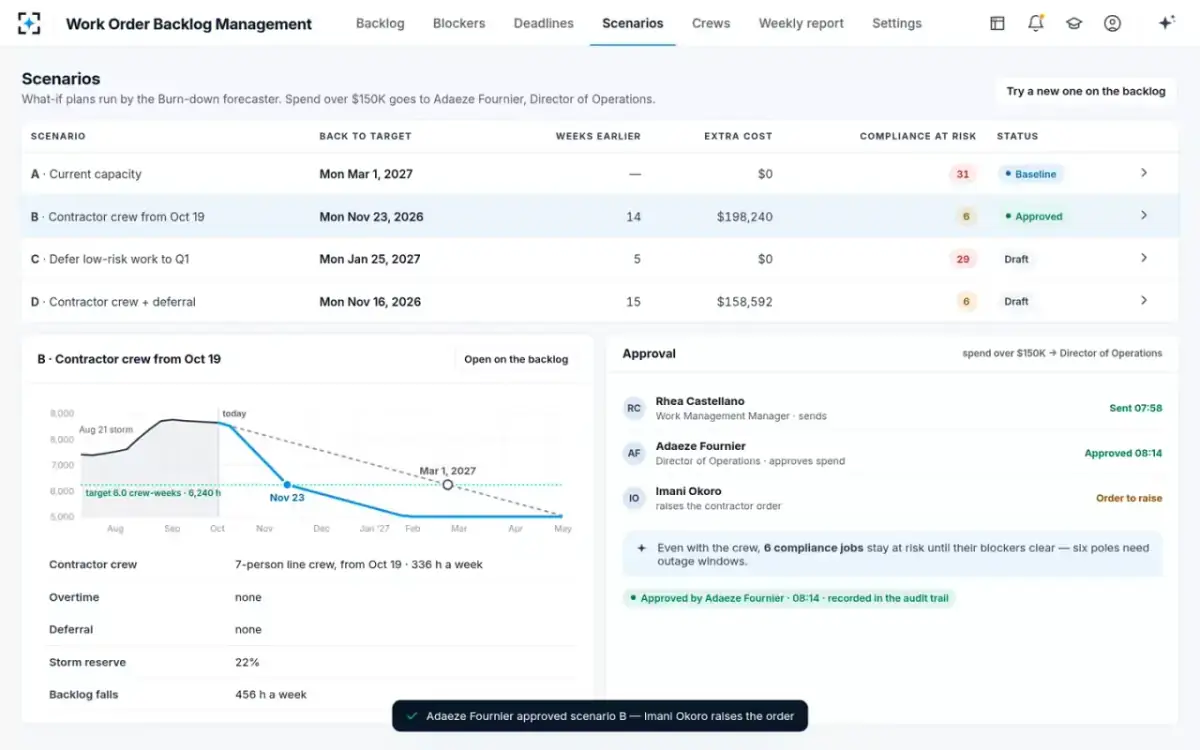

  9. 09Sent 07:58

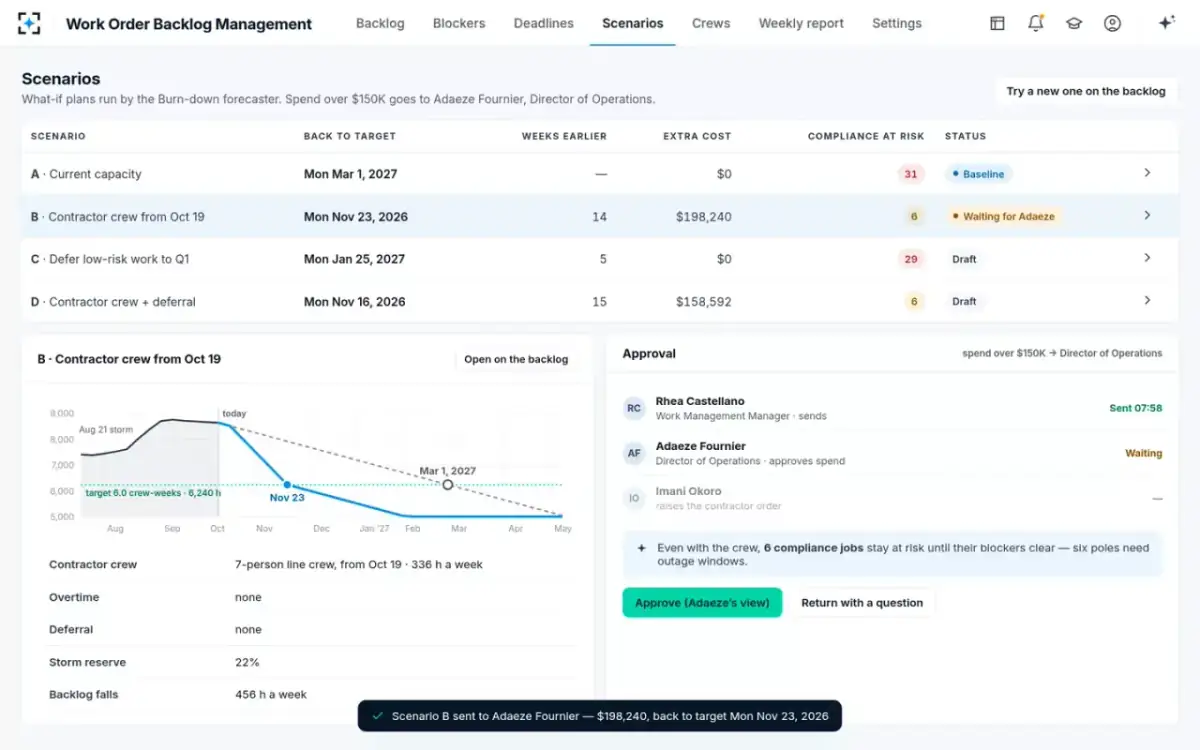

    Four plans side by side, one sent for approval

    Work management manager

    The what-if plans, called scenarios on screen, are compared on date, cost and compliance risk. Plan A, current capacity, clears next March. Plan B, the contractor crew, clears in November for $198,240. Plan C puts off 640 h of low-risk work to the first quarter. It clears in late January at no cost, but 29 jobs stay at risk. Plan D does both and clears a week before B for $158,592. The manager sends B to the director, saying plainly what the crew cannot fix.

    “Even with the crew, 6 compliance jobs stay at risk until their blockers clear: six poles need outage windows.”

  10. 10Approved 08:14

    The director approves the spend and stores raises the order

    Director of Operations

    The director sees the date, the cost and what is still at risk, and approves plan B at 08:14. The stores lead raises the contractor order. The approval is recorded with its name and time. The weekly backlog report was drafted at 06:24, with each figure linked to its screen. It now reads “Scenario B is approved.”

    “Approved by the Director of Operations · 08:14 · recorded in the audit trail”

Who it’s for

The managers, schedulers and planners who clear the work order backlog

The same backlog, seen by the five people who clear it. They cover sizing, scheduling, stores, outages and spend.

Work management manager
Owns the region's open work
Before
Reports the backlog each week from exports and spreadsheets. Knows how many jobs there are, but not when they will be done.
Now
Opens the backlog sized in hours and crew-weeks, with the date it clears. Tries a crew, overtime or putting work off, and sees the date, cost and risk change before spending anything.
Director of Operations
Approves contractor spend
Before
Learns a compliance program is behind when the month closes. Wants the date, the cost and what is still at risk.
Now
Gets a plan with the date the backlog clears, the extra cost and the compliance jobs still at risk. Gets a weekly report where each figure links to its source.
Senior scheduler
Builds next week's schedule from ready work
Before
Schedules from a status code that says ready, then finds half the ready jobs are waiting for a pole.
Now
Sees a job marked ready only when each prerequisite has proof: design, materials, outage window, permits, traffic plan and customer access.
Stores and materials lead
Chases suppliers and depot stock
Before
Chases each late order with the same urgency, without knowing which purchase order holds up the most work.
Now
Sees each purchase order ranked by the compliance jobs and hours it frees up, with the follow-up already drafted. One order holds nine condemned poles.
Network control outage planner
Grants outage windows for line work
Before
Gets outage requests at the last minute, three days ahead when three weeks were needed.
Now
Gets one request for six condemned poles, with each license date, the feeder sections and a proposed first window. It arrives ahead of the 10 working days' notice.
The agents

Agents that size, check, date and forecast, each read-only

Each night the agents size, check, date and forecast all open work. The manager tries the options and the operations director approves.

Backlog sizer

Reads each open work order every night and takes the planner's labor-hour estimate. Where that is missing, it estimates from completed jobs of the same work type, asset class and crew type in the last 3 years. It sorts each job by work type and reports hours, jobs and crew-weeks.

  • Read-only on the work management system
  • Each estimate marked as an estimate, with its basis
  • Never changes a priority or status
Readiness checker

Checks each job's prerequisites: design, materials, outage window, permits, traffic plan and customer access. It looks at the job pack, stock reservations, purchase orders, the outage calendar and permits. Then it marks the job ready or blocked, with proof.

  • Ready only with proof for each prerequisite
  • Never books stock or outage windows itself
Due-date watcher

Applies each work type's deadline rule. A condemned pole is due 180 days from its inspection, a priority B defect in 90 days and a reservoir inspection in 12 months. A connection is due by the date promised. It flags jobs the forecast cannot reach in time.

  • Never extends or waives a deadline
  • Compliance work is never marked deferrable
Blocker chaser

Groups blocked work by what is blocking it. It ranks the causes by the compliance jobs they would free first, then by hours. It drafts a short, specific follow-up to each owner with the jobs, the dates and what is needed.

  • Drafts only. A person presses send
  • Never contacts a supplier or council directly
Burn-down forecaster

Forecasts, week by week, when the backlog reaches target. It uses 12 weeks of new work and the crews' productive hours, minus the storm reserve. It runs what-if plans with contractor hours, overtime and work put off. Each plan shows the date, the cost and the compliance jobs still at risk.

  • Never books a contractor or commits spend
  • Never puts off compliance work in a plan

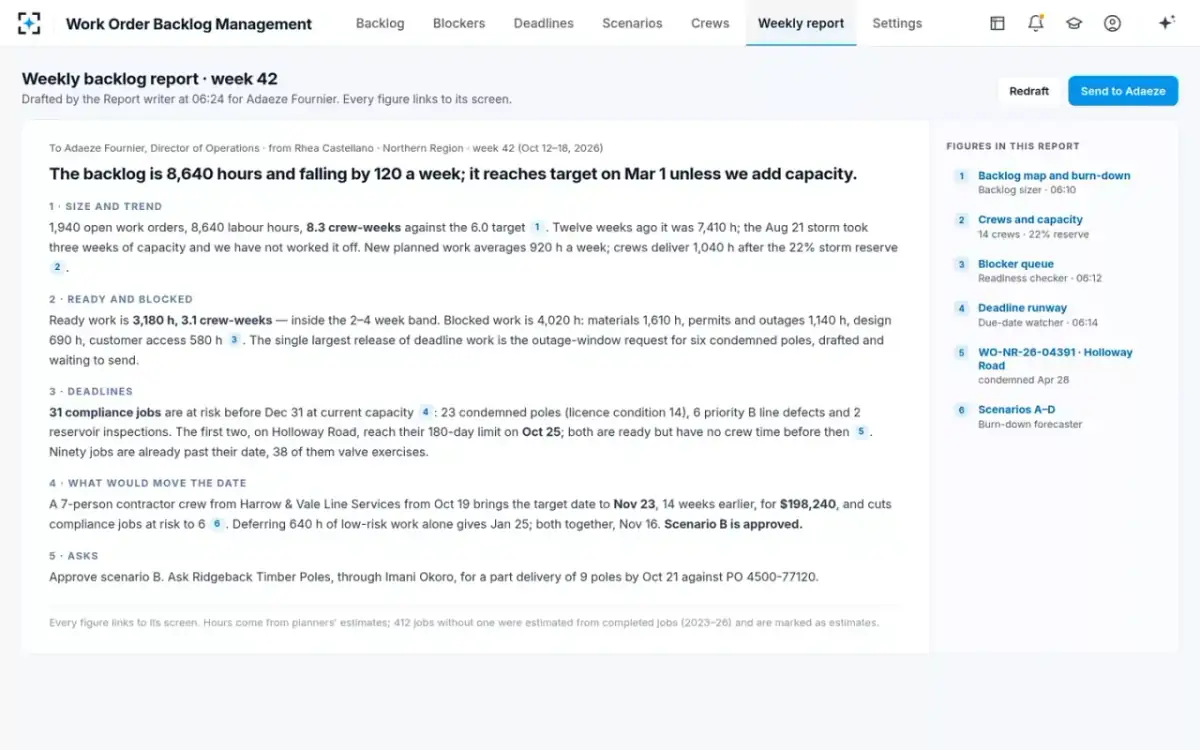

Report writer

Drafts the weekly backlog report for the Director of Operations. It covers size and trend, ready and blocked work, deadlines at risk, blockers, the forecast and any plan waiting for approval. Each figure links to its screen.

  • No figure without its source
  • Sent only by the manager
Operations director

Approves contractor spend.

Ask in plain words

Questions on backlog, blockers and deadlines, answered from the screens

Ask about the backlog, a blocker or a deadline, or try a change to capacity. Each answer points to the screen behind it. These answers use the sample data.

Why does the backlog only reach target in March?

Because it falls by only 120 hours a week. New planned work arrives at about 920 h a week. The 14 crews give 1,333 productive hours, and 22% is held for storms and emergencies, which leaves 1,040 h. The backlog is 8,640 h against a 6,240 h target, so 2,400 h ÷ 120 h = 20 weeks. The late-summer storm added about 1,100 h that has not been worked off.

Which compliance jobs could miss their deadline?

31 jobs are at risk before the year end: 23 condemned poles, 6 priority B line defects and 2 reservoir inspections. Of the poles, 9 wait on one late purchase order and 6 have no outage window requested. Another 8 are ready but not scheduled, and two of those reach their limit within two weeks.

Add a contractor crew from next week

Done in the simulation. A 7-person contractor crew adds 336 h a week at $118 an hour. The backlog then falls by 456 h a week and reaches target in November, 14 weeks earlier. It costs $198,240 over 5 weeks. Compliance jobs at risk fall from 31 to 6, which are the six poles waiting on outage windows. Spend over $150K needs the Director of Operations' approval.

Request the outage windows for the six condemned poles

Drafted for the outage planner in network control: six windows on three feeders, about 4 hours each. The first pole is due within three weeks. Outages need 10 working days' notice, so the request must go by Friday. Review it and press send.

The screens

Backlog tiles, blockers, deadlines and scenarios in the working solution

From the working solution, on its sample data. Pick one to see it large.

The backlogThirteen work types sized by labor hours and colored by age. The burn-down chart against the target, and the what-if panel with the clearance date.
The night runWhat the agents did at 06:10. They sized 1,940 work orders, checked six prerequisites per job, applied 13 deadline rules, ran the forecast and drafted the follow-ups.
A work typePole replacements by age and readiness, the license deadline rule and the 23 condemned poles due by the year end, listed first.
A work orderEach prerequisite with its proof, the 180-day deadline clock, the job's history and each step of the readiness check.
A drafted follow-upThe outage-window request for six condemned poles, drafted for Network Control. It goes only when the manager presses send.
The blocker queueEight blockers holding 4,020 h, each with its owner, jobs, hours and compliance jobs, ranked by the deadlines they free up.
The deadline runwayLicense, permit and customer dates for the next 12 weeks against what the crews can reach. In all, 31 jobs are at risk before the year end.
What if…A contractor crew added from the following week. The clearance date moves to November, with the extra cost and the compliance jobs still at risk.
ScenariosFour plans compared by date, weeks saved, extra cost and compliance risk, with the approval chain for the one sent.
ApprovedThe Director of Operations' approval recorded with its time. Stores is next, to raise the contractor order.

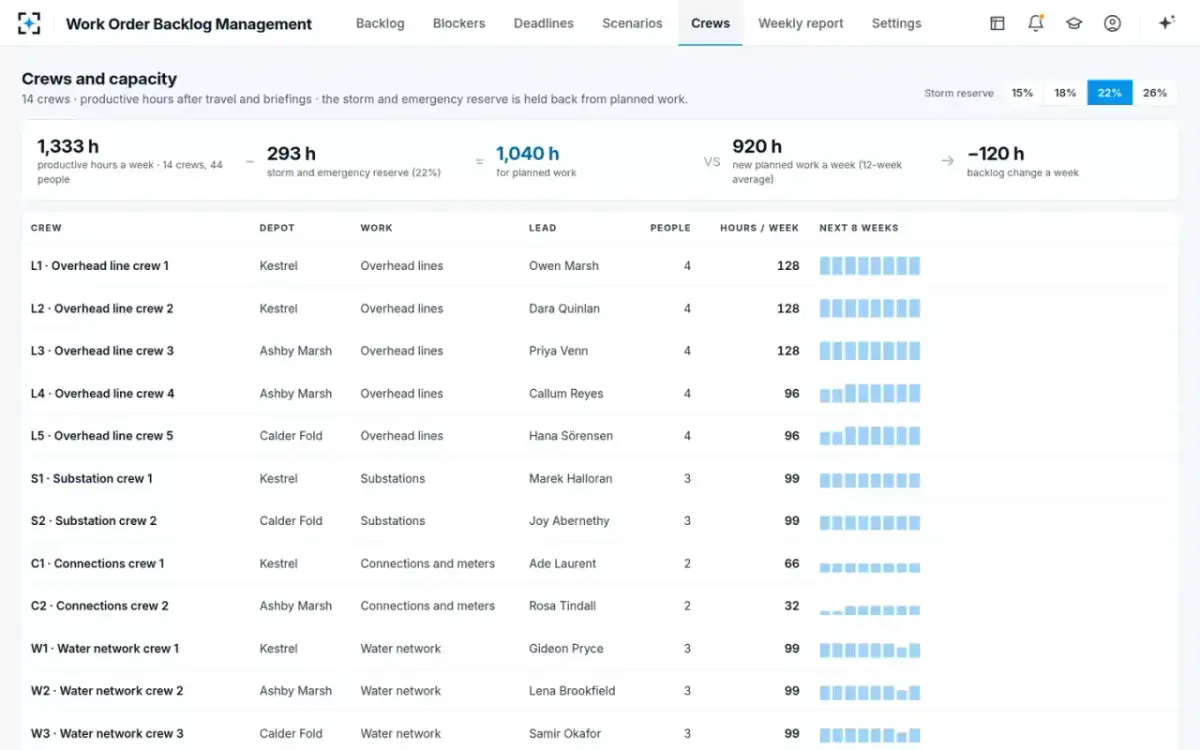

Crews and capacityFourteen crews and their productive hours, the storm reserve held back, and the time left for planned work against new work coming in.
The weekly reportThe weekly backlog report for the director, drafted with each figure linked to the screen it came from.
SettingsTargets, the reserve, approvals, the deadline rule for each work type and what each agent does.
Governance

Proven readiness, protected compliance work and approved spend

Each number traces to its work ordersHours, crew-weeks and risk counts link to the work orders behind them. Each figure in the weekly report links to its screen. Hours estimated from completed jobs are marked as estimates.
Ready means provenA job is ready only when each prerequisite has proof. That means the purchase-order line, the stock reservation, the permit, the traffic plan and the outage calendar entry. Otherwise the job is blocked, and the blocker is named.
Read-only on the work management systemThe agents read the work management system. They do not change a job's priority, status or deadline. Readiness is written to the backlog view, and the work management system stays as it is. Region data stays in the utility's own environment.
Compliance work can't be put offA fixed rule stops anyone putting off compliance work. No plan can delay a condemned pole, a priority defect, valve exercising or a reservoir inspection. No agent can extend or waive a deadline.
People approve the spendPlans are proposals. Contractor spend over $150K needs the Director of Operations. Putting off more than 400 h of planned work needs the work management manager. No agent books a contractor or commits spend.
Runs, chases and approvals on the recordEach night's run, each follow-up sent and each approval is on the audit trail with its name and time. Follow-ups to suppliers, councils and other teams stay drafts until a person presses send.

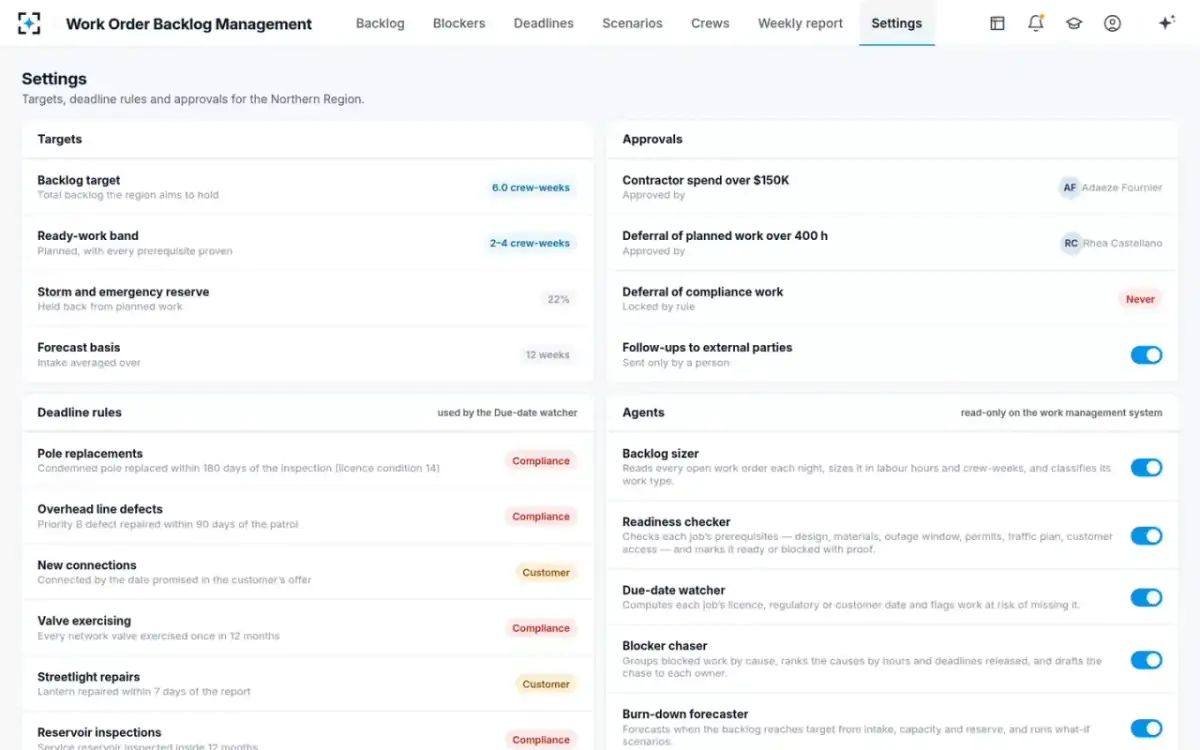

Configuration

Backlog target, storm reserve and deadline rules, set by the region

The region chooses the backlog target, the reserve, the deadline rules and who approves what.

SettingDefaultChoose from
Backlog target6.0 crew-weeksThe total backlog the region aims to hold, set by the Director of Operations
Ready-work band2 to 4 crew-weeksPlanned work with every prerequisite proven
Storm and emergency reserve22%15% · 18% · 22% · 26%, held back from planned work
Forecast basis12 weeksThe weeks of new work the forecast averages over
Contractor spend over $150KDirector of OperationsApproved by the Director of Operations
Putting off over 400 h of planned workWork management managerApproved by the Work Management Manager
Putting off compliance workNeverLocked by rule
Deadline rulesPer work typeCondemned pole within 180 days of the inspection (license condition 14). Priority B defect within 90 days of the patrol. Each network valve exercised once in 12 months. Service reservoir inspected within 12 months. Connection by the date in the customer's offer. Lantern repaired within 7 days.
Connections

The work management, stores and outage systems the backlog is read from

Work management systemopen work orders, statuses and planners' labor-hour estimates, read nightly
Stores and purchase ordersstock reservations at each depot and the delivery dates on open orders
Outage calendaroutage windows requested and granted by Network Control
Permits and traffic plansroad-opening permits and signed traffic management plans
Crew rosterscrews, people, leave and productive hours after travel and briefings
Deadline ruleslicense conditions, permit conditions, customer offers and the asset plan
What it changes

Compliance deadlines, reactive spend and ready work once the backlog is sized

Each figure carries its label: a target the solution is built to, an estimate, a typical published result, or a proven one.

target
100%
of condemned poles and compliance jobs finished inside their deadline
31 of 31 jobs
at risk before year end, all reached
estimated
$1.0M
a year of unplanned-work premium avoided in a region of 48,000 field hours
Unplanned today41%
Target30%
target
2-4weeks
of ready work held, so crews go to jobs that are ready to work

“demo” means seen in the working solution, on its sample region data. “target” means the design goal, measured in the live solution. “estimated” means our arithmetic. $1.0M assumes 48,000 field hours a year at $95 loaded. Cutting the unplanned share from 41% to 30% moves 5,280 h to planned work. We take unplanned work at 3× planned, below the published 4 to 6×. That makes the extra cost 2× planned, so 5,280 × $95 × 2 ≈ $1.0M. The split of the backlog week is also our estimate. Its sums give the 33 hours a week by hand and the 5.5 with the solution. “typical” means published figures. They are California PUC citations for safety code violations (Nov 2021) and NBC Bay Area on a 170,000-repair maintenance backlog. They also include FacilitiesNet (unplanned work costs 4 to 6× planned work). SMRP via Efficient Plant and ClickMaint gives 2 to 4 weeks of ready backlog, secondhand. The utility, its depots, crews, suppliers, contractors and work orders in the worked example are sample data. Names on the screens are sample data.

Questions

Questions on work order backlog management for utilities

What is work order backlog management software for utilities?

It sizes, ages and ranks a utility's open work. You see how many labor hours and crew-weeks the work holds, and which jobs are ready or blocked. The same view shows which deadlines are at risk and when the backlog will clear. Work Order Backlog Management does this for electricity and water work in one view. Six agents do the work, and a manager and a director make the decisions.

How does it calculate crew-weeks of backlog?

It divides the backlog's labor hours by the hours crews can give to planned work. In the working solution, 14 crews give 1,333 productive hours a week after travel and briefings. Of those, 22% is held back for storms and emergencies, which leaves 1,040 h. So 8,640 h of backlog is 8.3 crew-weeks, against a 6.0 target.

How does it tell ready work from blocked work?

The Readiness checker checks six prerequisites for each job: design, materials, outage window, permits, traffic plan and customer access. It checks them against the job pack, stores, purchase orders, the outage calendar and permits. A job is ready only when each one has proof. Otherwise the blocker is named and joins a queue, ranked by the deadlines it would free up.

Can it keep condemned poles and other compliance work inside their deadlines?

It shows which ones are at risk while there is still time to act. The Due-date watcher dates each job against its rule. A condemned pole is due within 180 days of the inspection, a priority B defect within 90 days and a reservoir inspection within 12 months. It flags the jobs the forecast cannot reach. Compliance work can't be put off in a plan, and no agent can extend a deadline.

How does the backlog burn-down forecast and what-if work?

The Burn-down forecaster projects the backlog week by week. It uses 12 weeks of new work and the crews' capacity, minus the reserve, and marks the date the backlog reaches target. The manager can add a contractor crew or overtime, put off low-risk work or change the storm reserve. The date, the extra cost and the compliance jobs at risk then update.

Does it change work orders in our work management system?

No. The agents only read the work management system. They do not change a job's priority, status or deadline. Readiness is written to the backlog view, and the system of record is left alone. Follow-ups to stores, network control, councils and suppliers stay drafts until a person sends them.

Who approves contractor spend and putting off work?

People do. Plans are only proposals. Contractor spend over $150K needs the Director of Operations. Putting off more than 400 h of planned work needs the work management manager. Each approval is recorded with its name and time. No agent books a contractor or commits spend.

Can we try it on our own open work orders first?

Yes. The Agentic Solution Engine builds and deploys it from your requirements and documents. That includes your work order export, crew rosters, deadline rules and approval limits. It goes live once each quality gate has passed. We will walk you through it on your own open work orders first.

Run work order backlog management
on your own open work orders.

We'll run Work Order Backlog Management on an export of your own open work orders.
