- Before

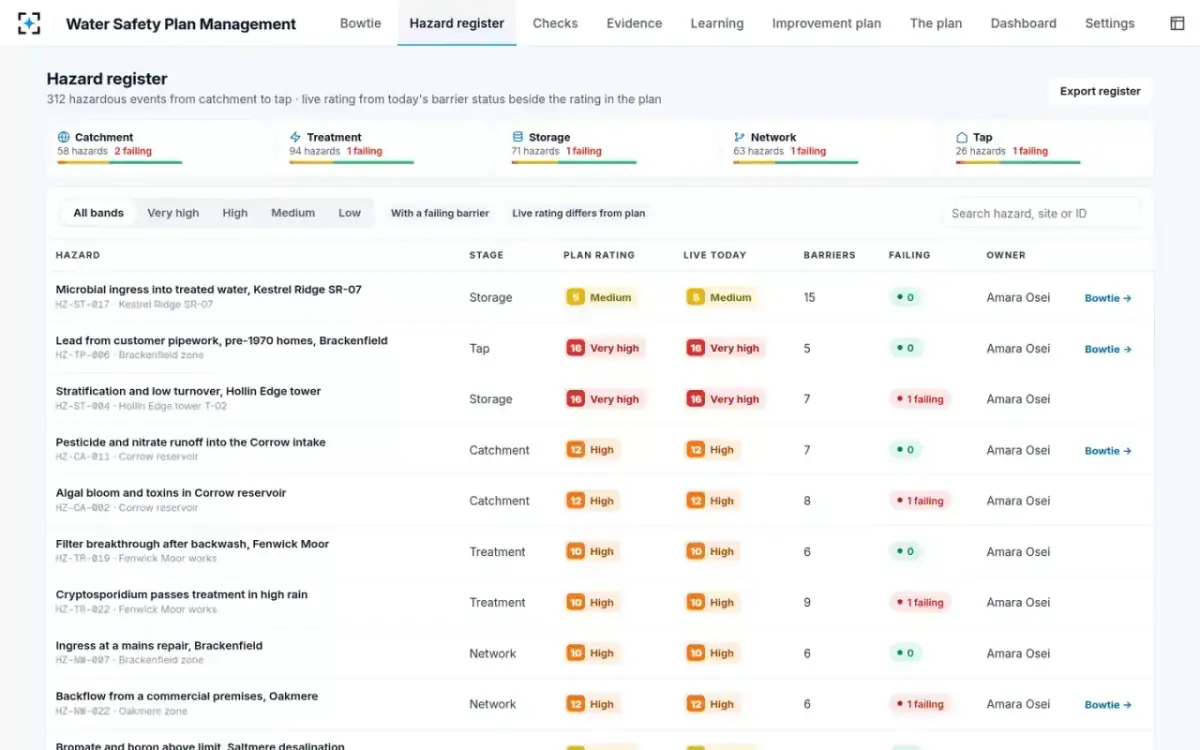

- Owns 312 hazardous events and 1,148 barriers across two treatment works and 46 service reservoirs and towers. The plan says the hatch is checked monthly, but nothing flagged it when the check was missed.
- Now
- Opens the hazard that changed overnight and sees the record that changed it, with the response already drafted. Confirms the new rating or keeps the old one with a reason.
One missed hatch inspection in a live water safety plan
A service reservoir built in 1964 holds 18 ML (million liters) in two cells and supplies 41,200 people. Its monthly hatch inspection was due the day before. Here is what happens on Monday morning, screen by screen, in the working solution.
A worked example on sample data. Names, IDs and figures on the screens and in this section come from the demo.
- 0105:58

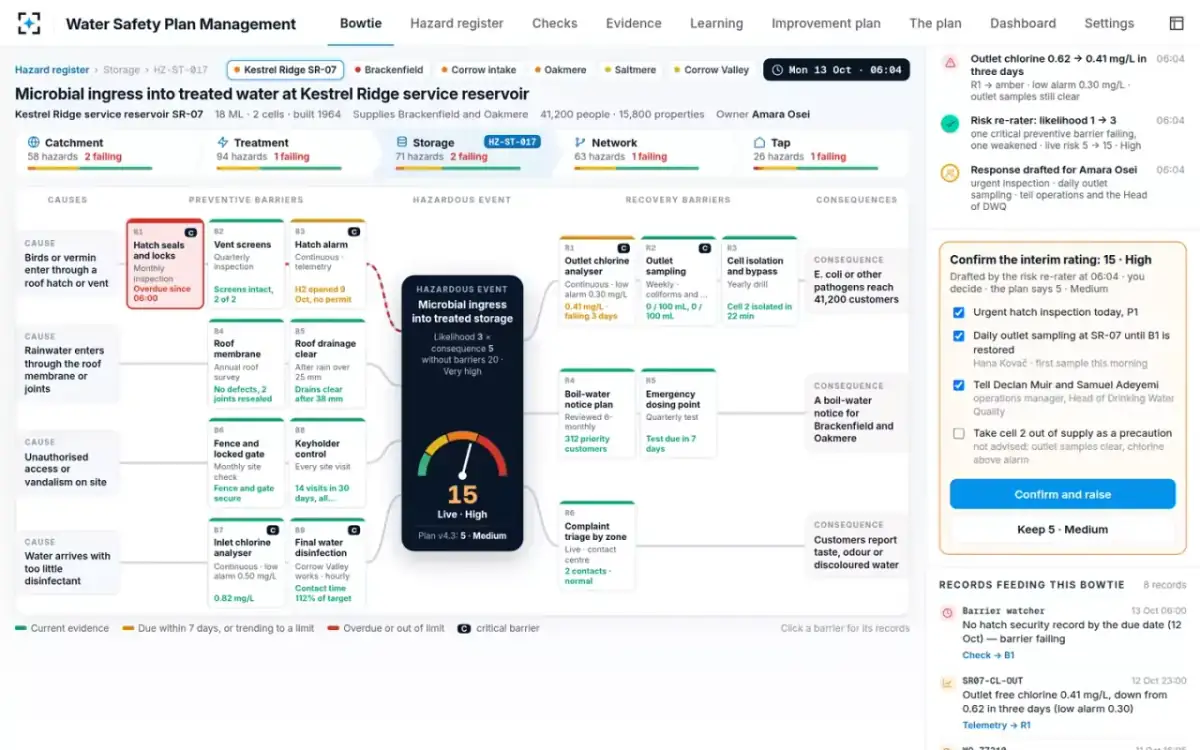

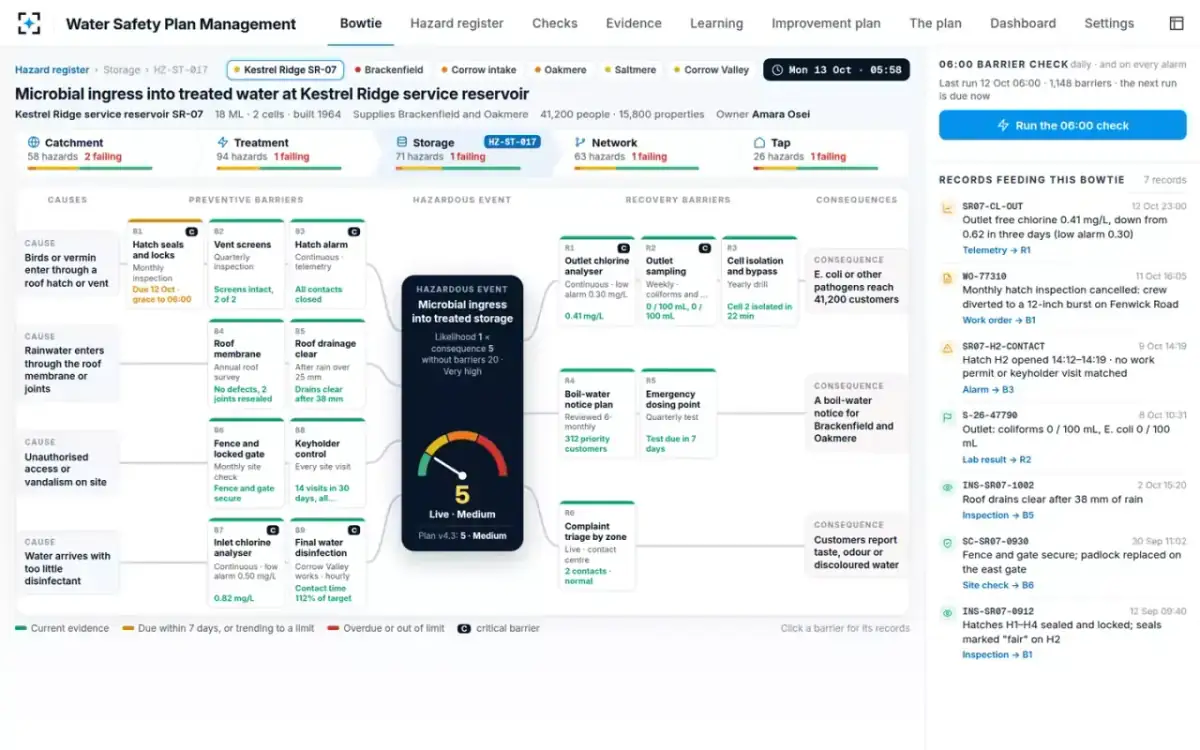

The plan opens on the reservoir's bowtie
Water safety plan leadThe plan lead owns the plan's 312 hazardous events. One of them is microbial ingress at this reservoir, meaning germs getting into the treated water. It is drawn as a bowtie. On the left are four causes and nine preventive barriers. On the right are three consequences and six recovery barriers. The live risk is 5 · Medium, the same as plan v4.3. The first barrier, hatch seals and locks, reads “Due yesterday · grace to 06:00”.
The work order: “Monthly hatch inspection cancelled: crew diverted to a 12-inch burst”
- 0206:00

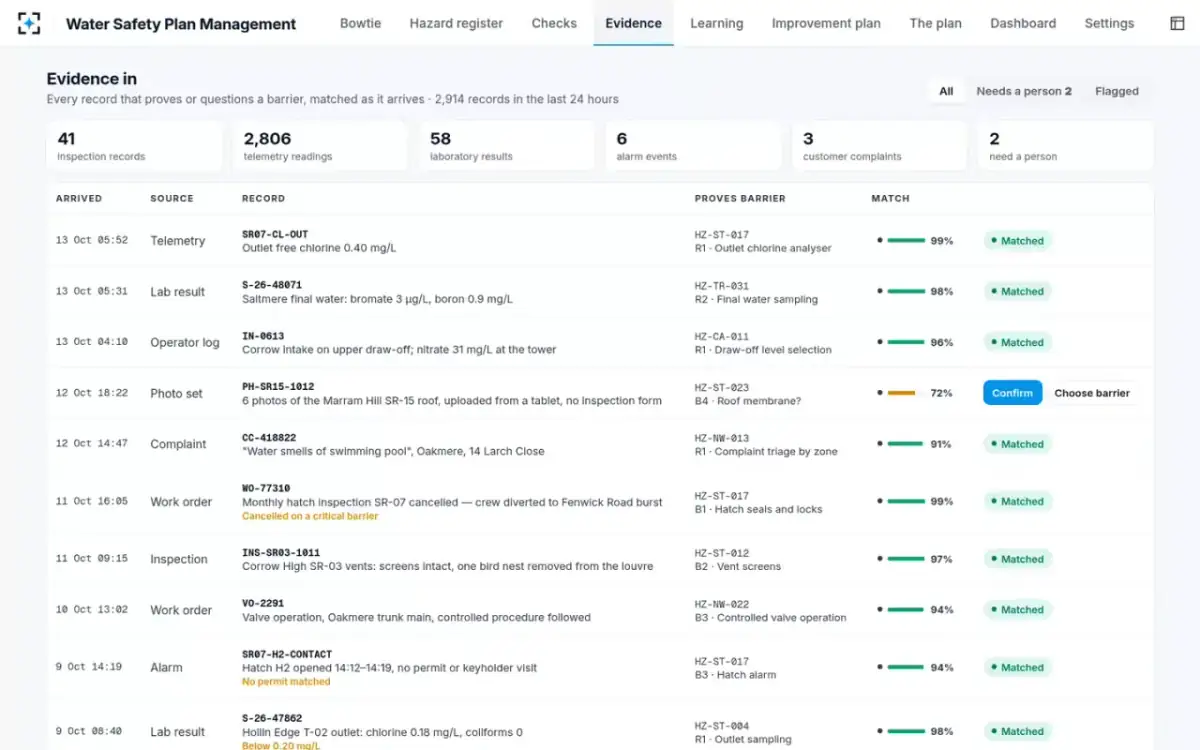

The morning check reads each record and each clock

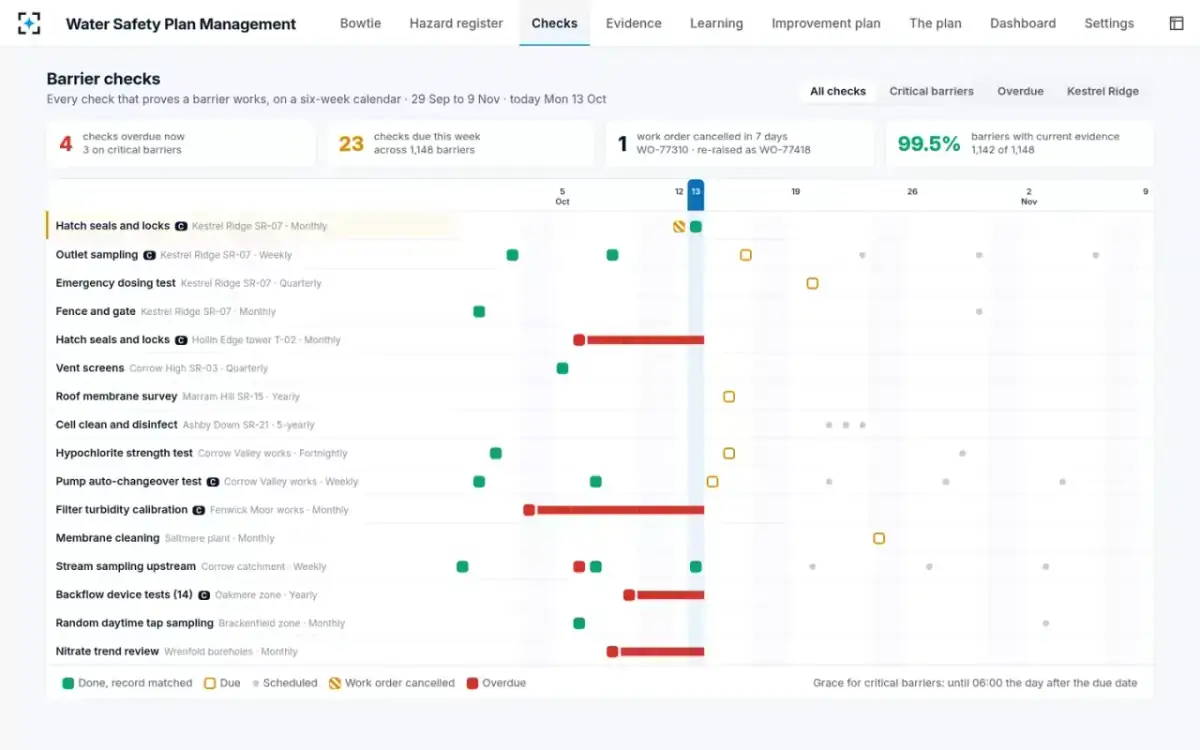

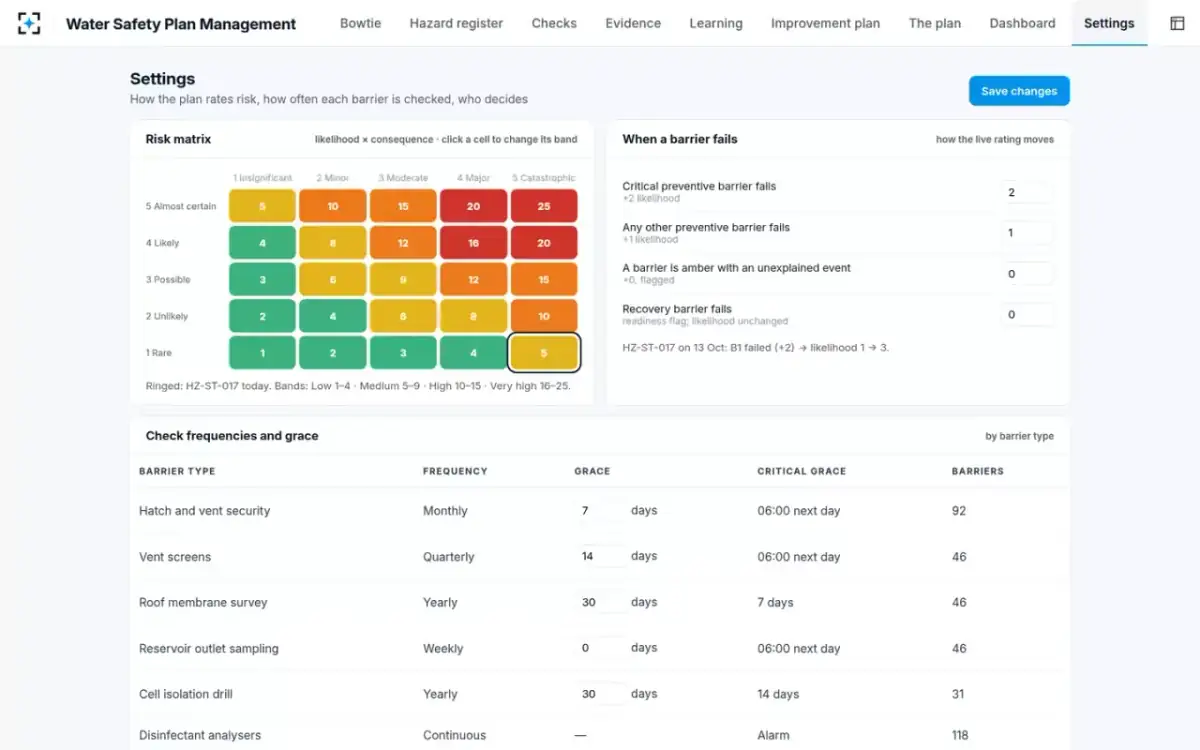

Record matcher and Barrier watcherThe record matcher reads 2,914 new records: 41 inspections, 2,806 telemetry readings, 58 laboratory results, 6 alarms and 3 complaints. The barrier watcher checks 1,148 barrier clocks and 412 limits. With no inspection record by its due date, the hatch barrier turns red. Four days earlier, one hatch opened from 14:12 to 14:19 with no work permit or keyholder visit matched. So the hatch alarm turns amber. Outlet chlorine has fallen from 0.62 to 0.41 mg/L in three days, so the outlet analyzer turns amber too.
“Hatch seals and locks: failing” · “Due yesterday, no record.”
- 0306:04
The live risk rises from 5 to 15, and waits for the plan lead
Risk re-raterOne critical preventive barrier is failing and one is weakened. So the risk re-rater steps the likelihood from 1 to 3, and the dial swings to 15 · High. The plan still says 5 · Medium, because only the plan lead can change it. The re-rater drafts the response. It asks for an urgent hatch inspection today at P1, the top priority, and daily outlet sampling until the hatch barrier is restored. It also drafts a message to the operations manager and the Head of Drinking Water Quality.
Left unticked: “Take cell 2 out of supply as a precaution. Not advised: outlet samples clear, chlorine above alarm”

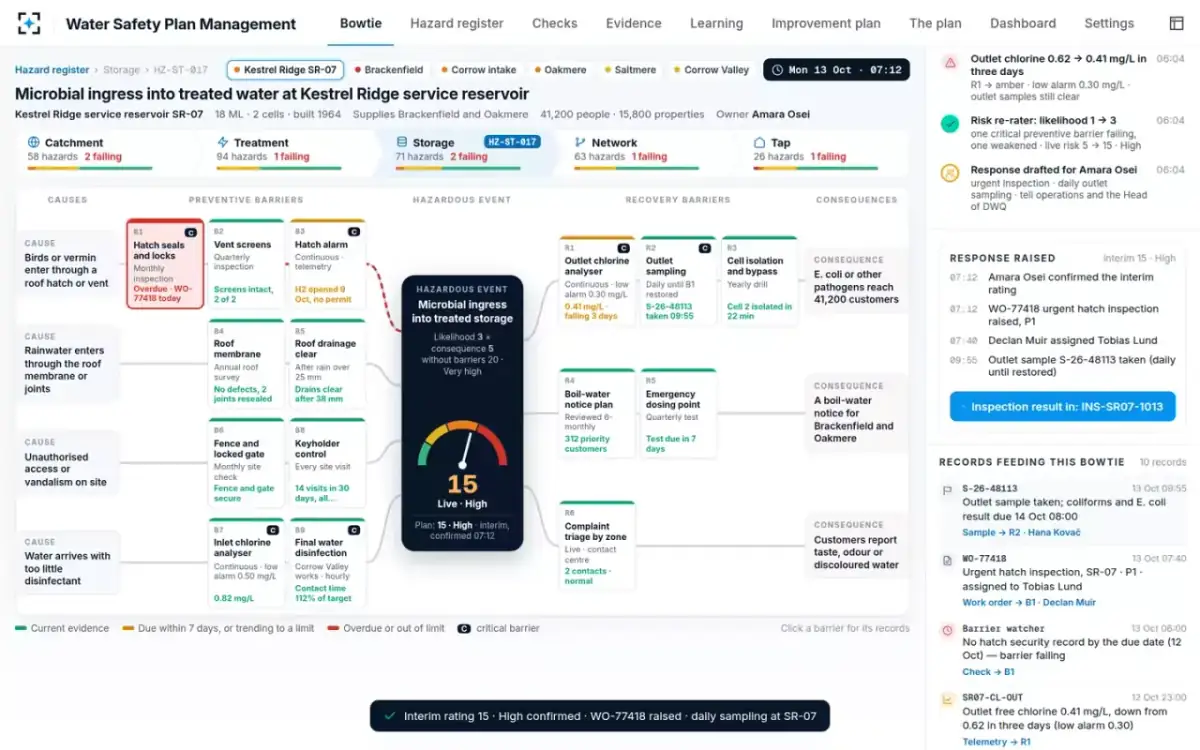

- 0407:12
Rating confirmed, response raised in one step
Water safety plan leadThe plan lead confirms the interim rating of 15 · High, and the urgent hatch inspection is raised at P1. At 07:40 the operations manager assigns a reservoir inspector. At 09:55 the sampling coordinator's first daily sample is taken at the outlet. Each new record joins the feed beside the bowtie.
“Interim rating 15 · High confirmed · urgent inspection raised · daily sampling at the reservoir”
- 0511:40

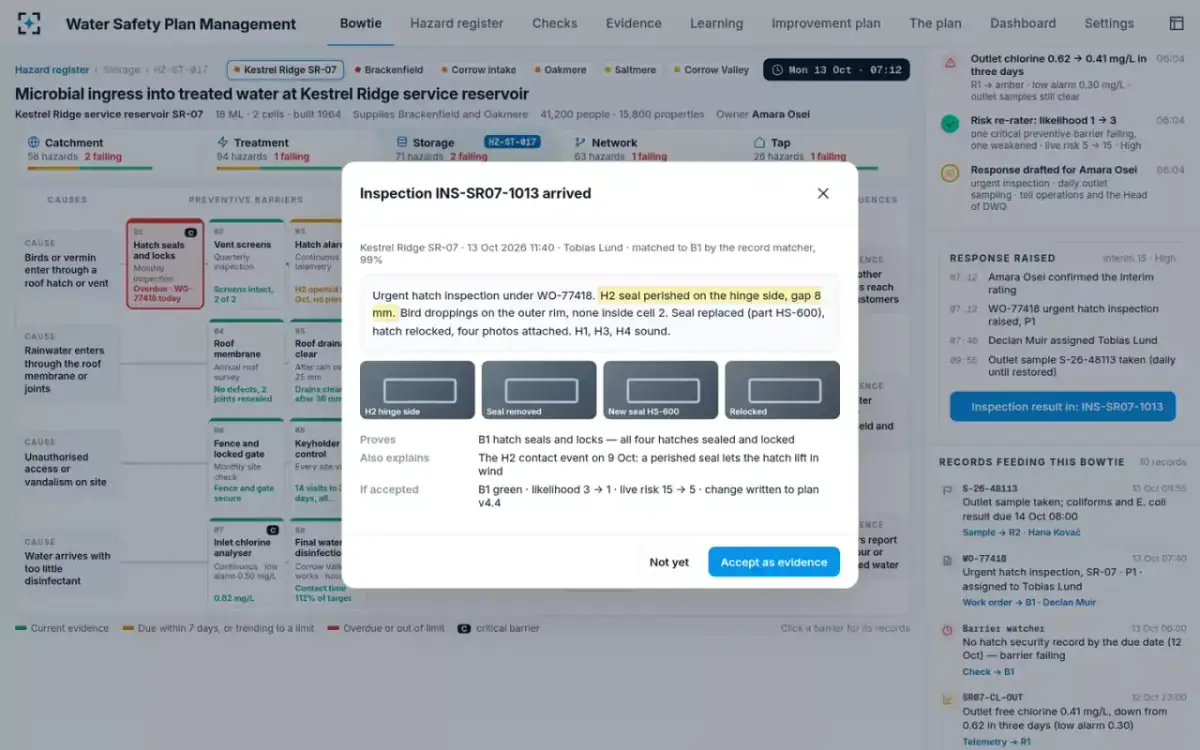

On the roof: an 8 mm gap in a hatch seal
Service reservoir inspectorThe inspection record arrives from the roof. The hatch seal has perished on the hinge side, leaving an 8 mm gap. There are bird droppings on the outer rim, none inside cell 2. The seal is replaced, the hatch relocked and four photos attached. The record matcher ties it to the hatch barrier at 99 %. It also explains the alarm four days earlier.
“Also explains: the hatch contact event four days ago. A perished seal lets the hatch lift in wind”

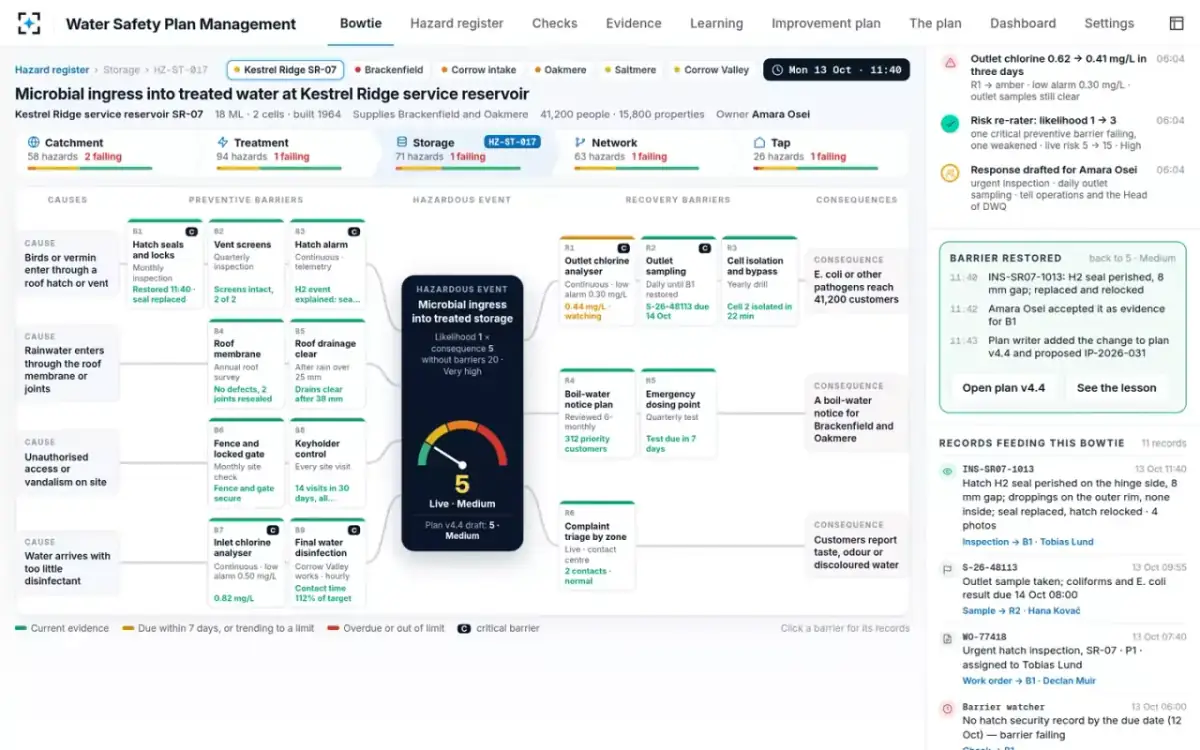

- 0611:42
Barrier restored, risk back to Medium, plan updated
Plan lead and Plan writerOnce the plan lead accepts the inspection as evidence for the hatch barrier, the barrier turns green. The likelihood returns to 1 and the live risk to 5 · Medium. The seal finding stays on the hazard. A minute later the plan writer adds the change to plan v4.4. The writer also proposes an improvement action: seal condition checks and spare seals at the 9 reservoirs whose hatches are over 30 years old.
No barrier turns green without a record that proves it.

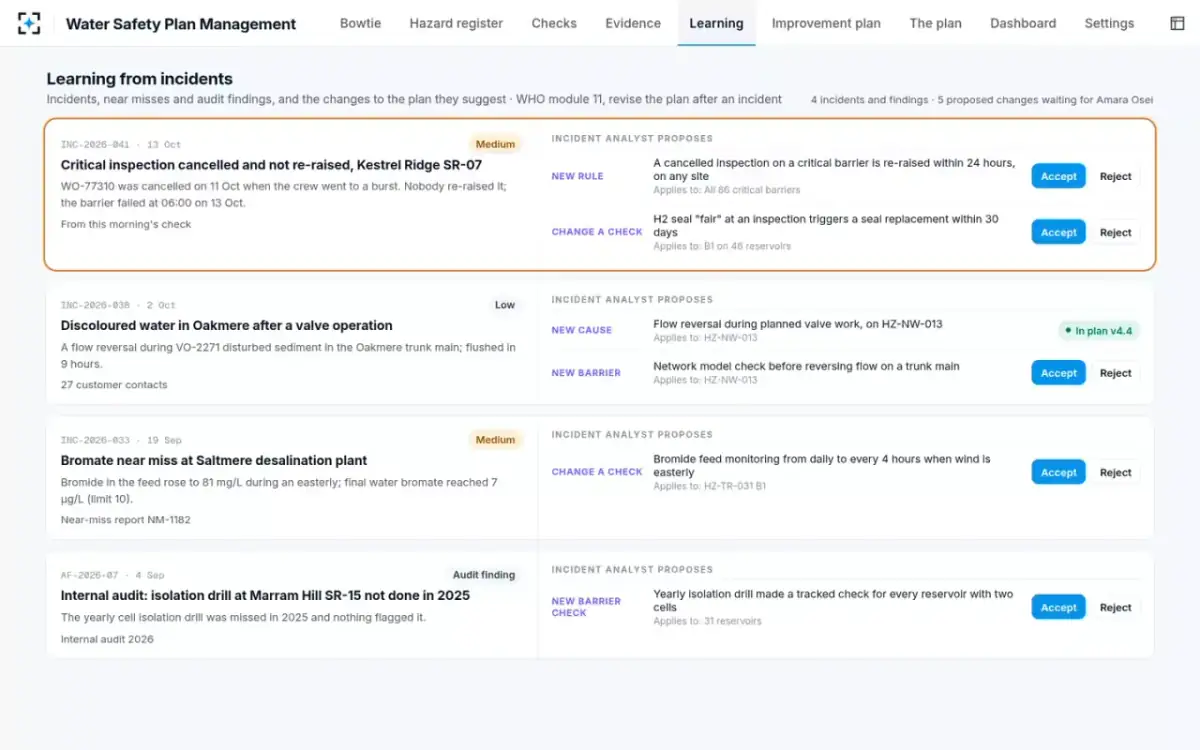

- 07The lesson
A cancelled inspection becomes a rule for each site
Incident analystThe incident analyst opens an incident, “Critical inspection cancelled and not re-raised”. It proposes two changes for the plan lead to accept or reject. One is a new rule for all 86 critical barriers. The other changes the hatch check on 46 reservoirs. A hatch seal marked “fair” at an inspection would then trigger a seal replacement within 30 days. The analyst only proposes. The plan lead decides what reaches the hazard register.
New rule: “A cancelled inspection on a critical barrier is re-raised within 24 hours, on any site”

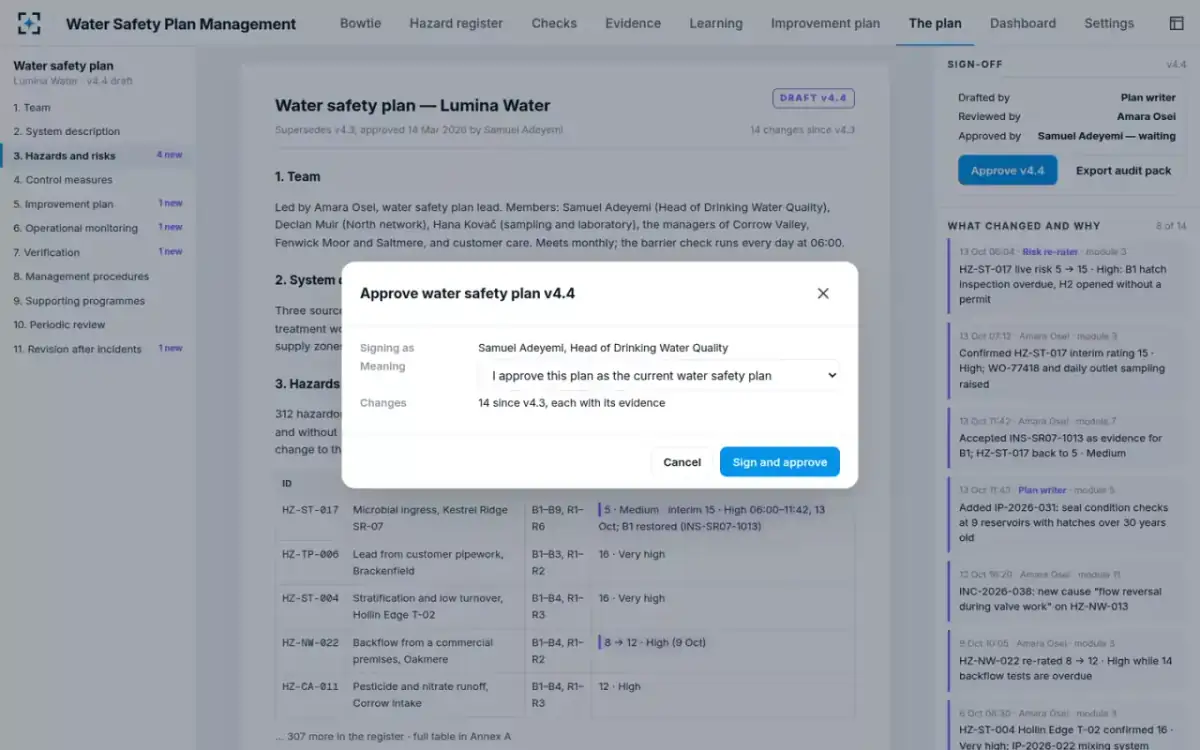

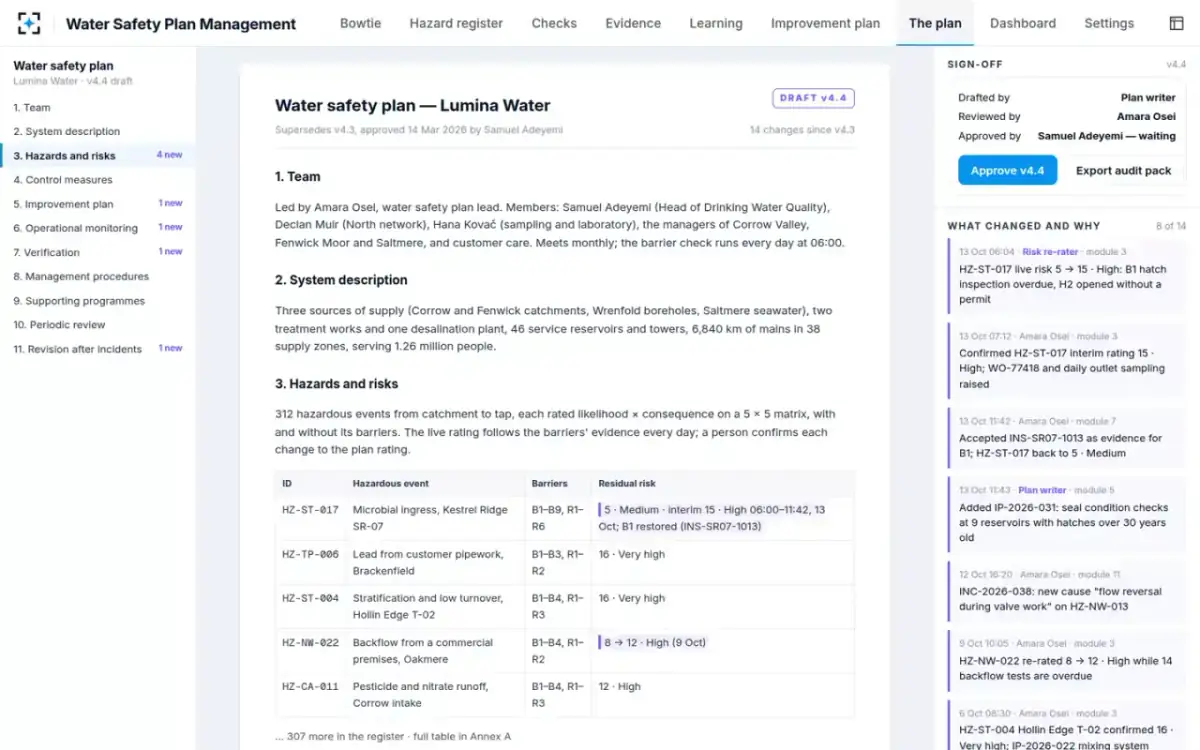

- 08Plan v4.4
The plan document writes its own change log
Plan writerDraft v4.4 follows the plan's 11 modules, from the team to revision after incidents. It replaces v4.3, approved earlier in the year. It lists 14 changes since v4.3, each with who, when, why and the evidence. The reservoir hazard reads 5 · Medium, with an interim 15 · High from 06:00 to 11:42 that day. The hatch barrier was restored by the morning's inspection.
Sign-off: “Drafted by Plan writer · Reviewed by the water safety plan lead · Approved by the Head of Drinking Water Quality: waiting”
- 09Signed
Version 4.4 approved, with the meaning of the signature
Head of Drinking Water QualityThe Head of Drinking Water Quality signs and chooses the meaning: “I approve this plan as the current water safety plan”. Version 4.3 stays readable. The audit pack follows from the same records. It holds the plan document, an evidence index for the 86 critical barriers, the change log, the improvement plan and incident learning.
“Plan v4.4 approved by the Head of Drinking Water Quality · v4.3 kept read-only”

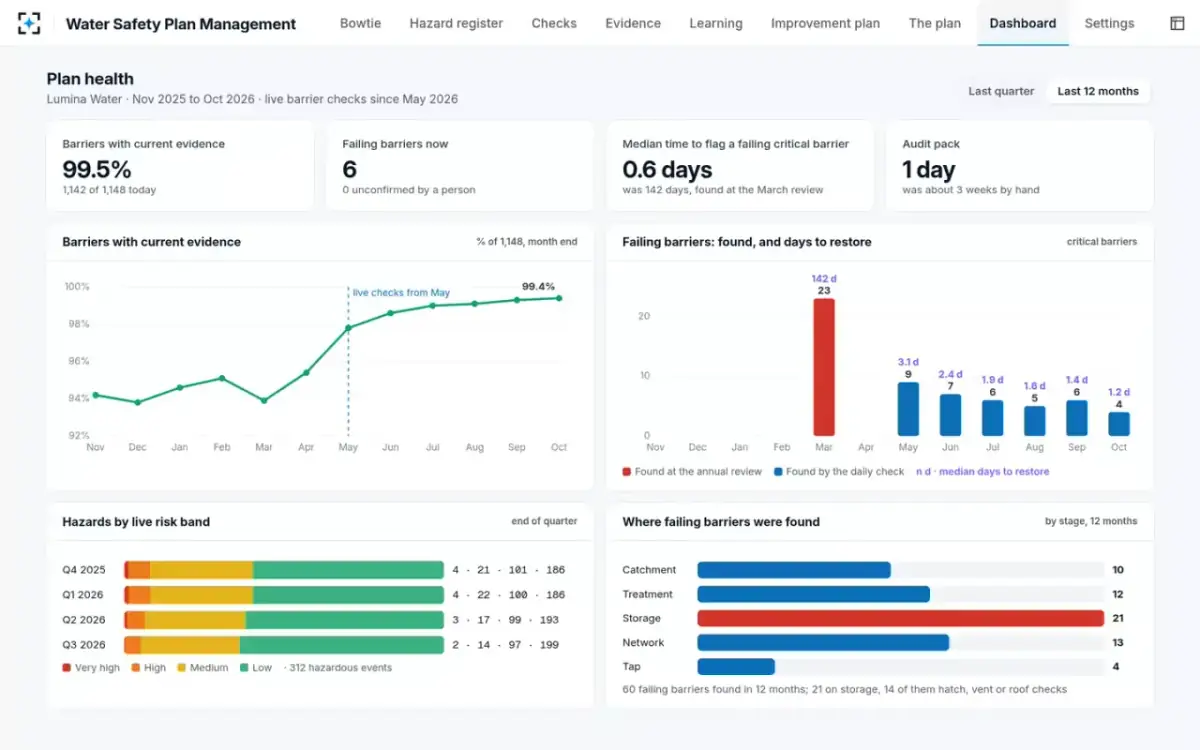

- 10The last 12 months
Plan health, month by month
Head of Drinking Water QualityToday 99.5 % of barriers carry current evidence, 1,142 of 1,148. Since the daily check went live, it finds failing critical barriers in a median of 0.6 days. Last month they were restored in a median of 1.2 days, against 142 days for the 23 found at the annual review. Over the year, hazards rated Very high fell from 4 to 2.
“60 failing barriers found in 12 months; 21 on storage, 14 of them hatch, vent or roof checks”
