One burst main, and how it led to a signed renewal program
It is Monday at a large utility. The capital planner for water distribution is building next year's renewal program for the capital review board. The budget is $64M. This year's program was ranked by age. On Friday, a cast-iron main burst under a shopping street. Here is what happens next, screen by screen, in the working solution.
A worked example on sample data. Names, IDs and figures on the screens and in this section come from the demo.

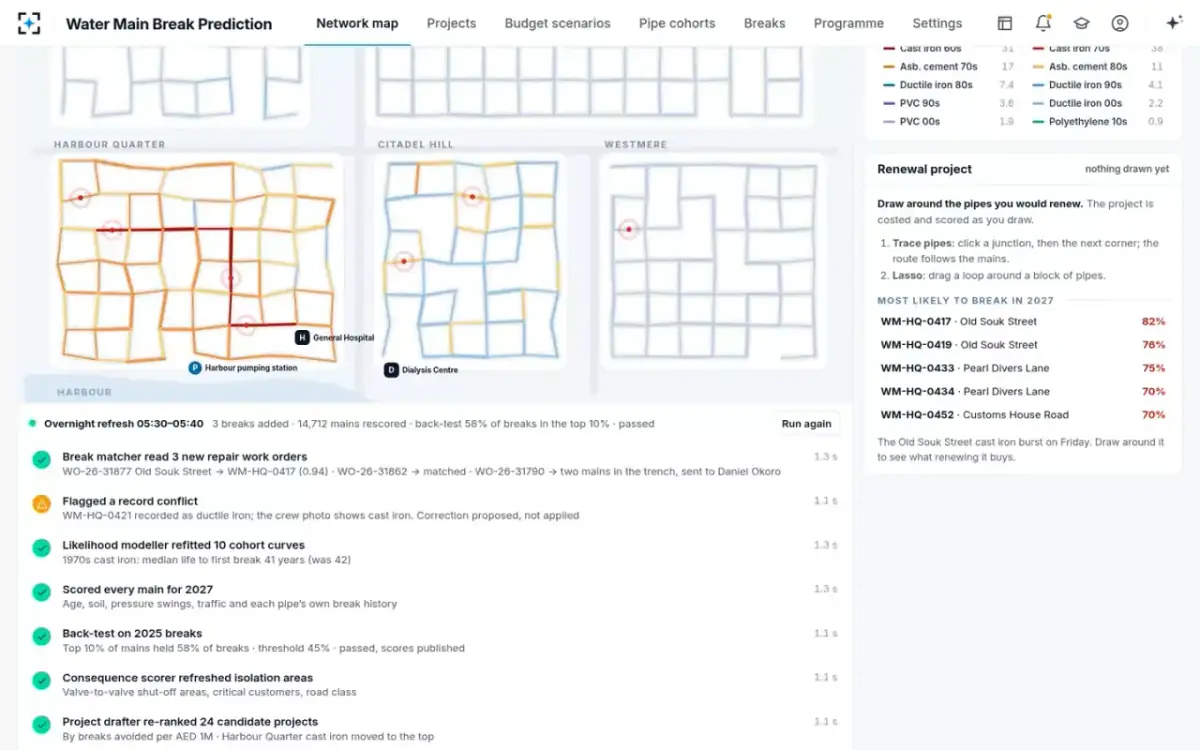

- 0105:30-05:40
The overnight refresh rescores each main
Likelihood modellerThe Break matcher reads 3 new repair work orders. The Likelihood modeller refits the 10 survival curves, one per group of pipes laid in the same material and decade. Cast iron from the 1970s now lasts a median 41 years before its first break, down from 42. Each main is then scored for next year from its age, soil, pressure swings, traffic and own break history. The Project drafter re-ranks 24 candidate projects.
“Back-test on last year's breaks · Top 10% of mains held 58% of breaks · threshold 45% · passed, scores published”

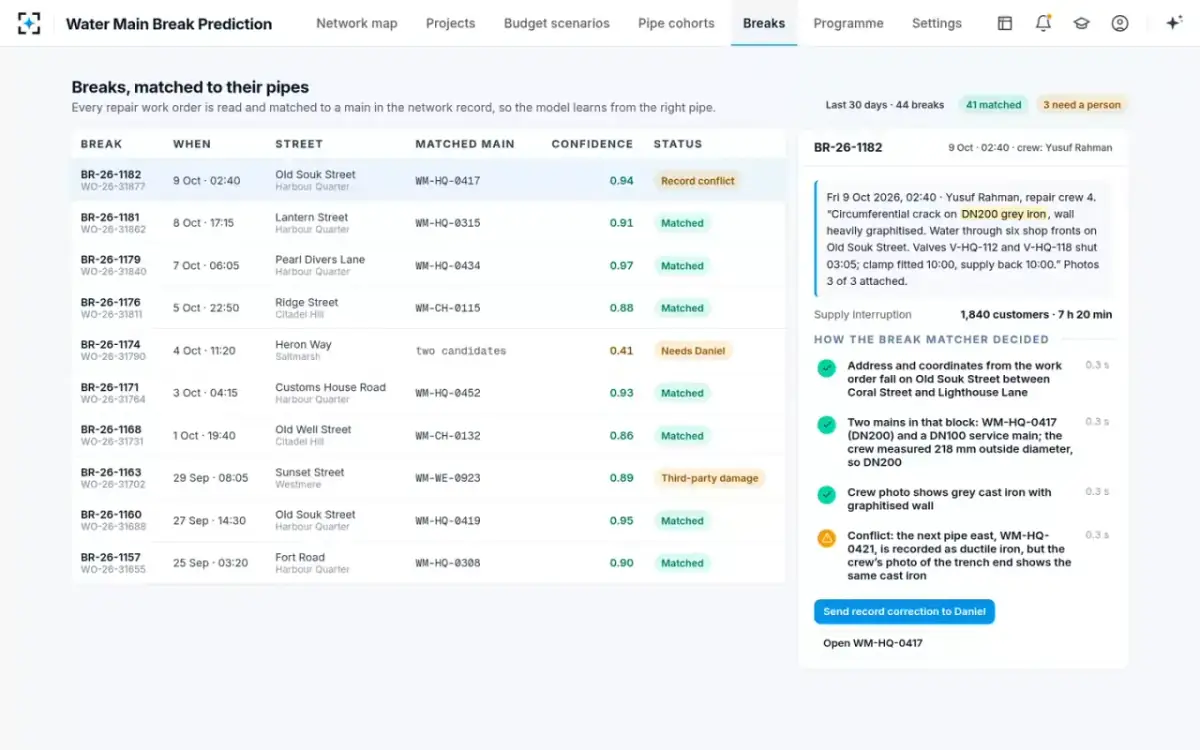

- 02Friday 02:40
Friday's burst, matched to its pipe
Break matcherThe crew supervisor's work order describes a ring crack on a DN200 gray iron main, its wall badly corroded. Water ran through six shops. Two valves were shut at 03:05 and supply came back at 10:00. In all, 1,840 customers were without water for 7 h 20 min. The Break matcher places the break on the street. It picks the DN200 main over a DN100 service main, because the crew measured 218 mm across the outside. It rates the match 0.94.
“Conflict: the next pipe east is recorded as ductile iron, but the crew's photo of the trench end shows the same cast iron”. It is sent to the network engineer to decide.

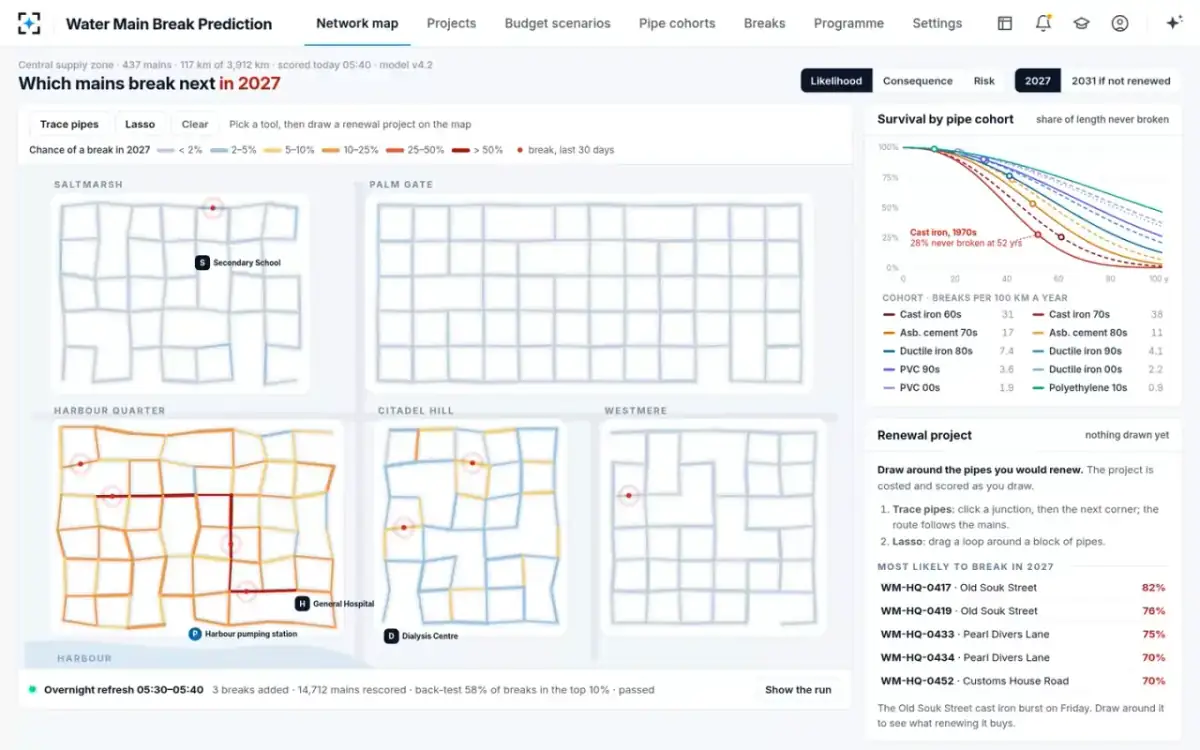

- 03Morning
Which mains break next year

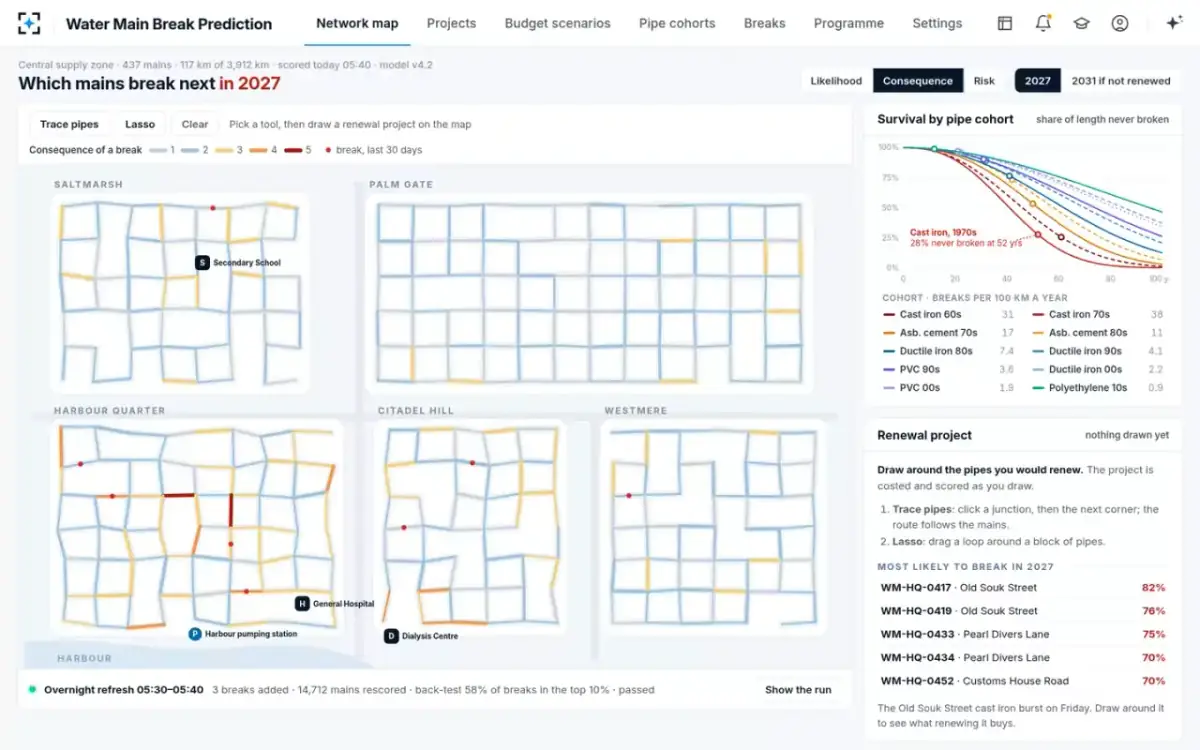

Capital plannerThe capital planner opens the network map. Each main is colored by its chance of a break next year, from under 2% to over 50%. The map marks last month's breaks and shows the general hospital, a dialysis center and a high school. The cast iron in the old town is the darkest red. The list beside the map puts the burst main at 82%, its neighbor at 76% and a main on a nearby lane at 75%.
“The cast iron on this street burst on Friday. Draw around it to see what renewing it buys.”
- 04One click

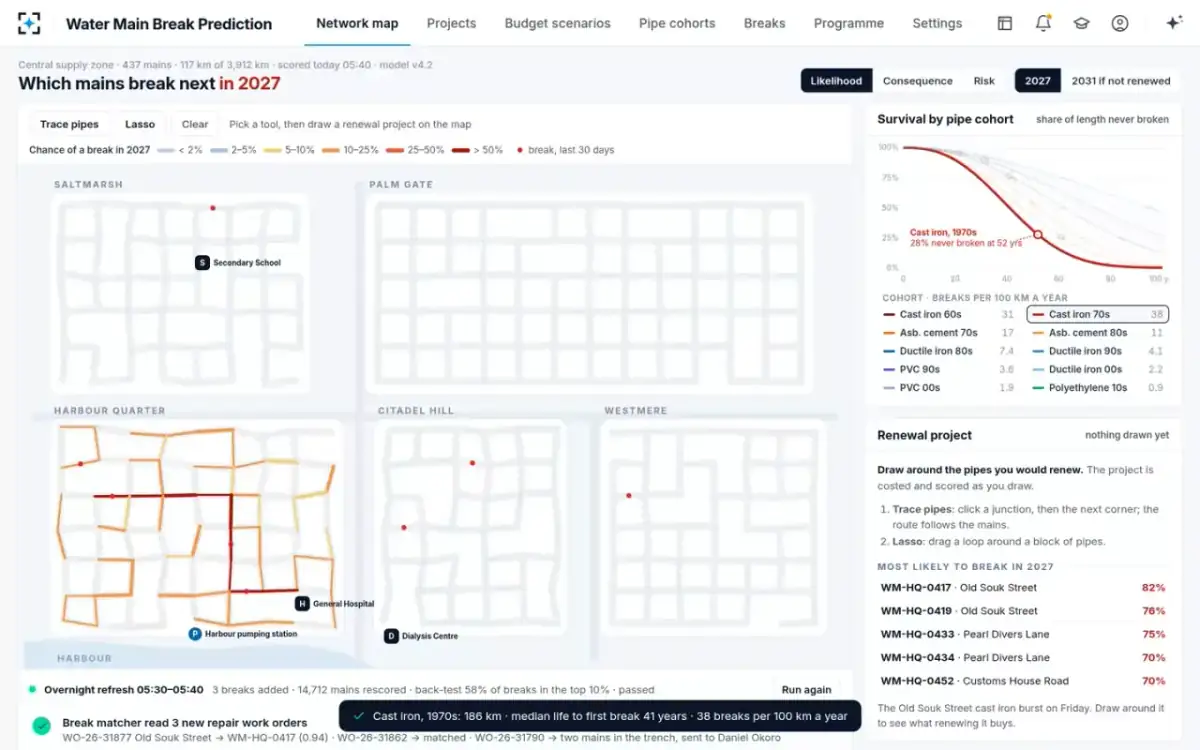

Cast iron from the 1970s breaks first, at 41

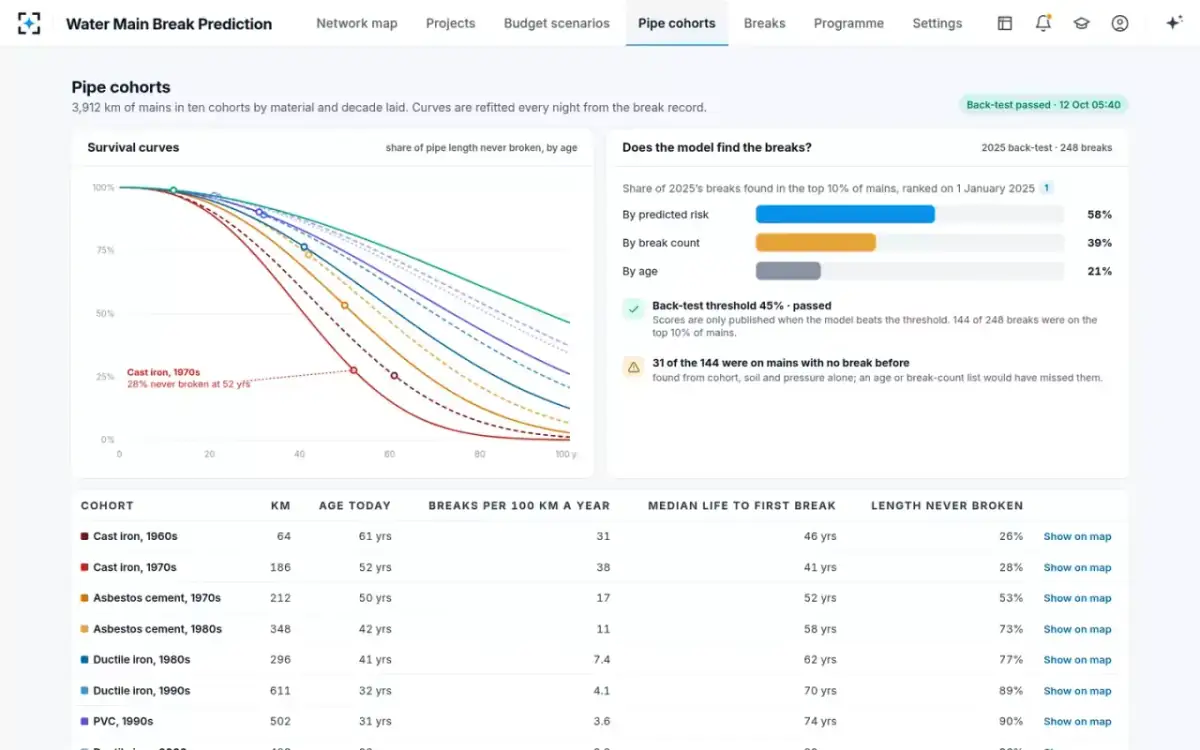

Capital plannerBeside the map are survival curves for each group of pipes, by material and decade laid. Each curve shows the share of pipe length that has not broken, against age. The planner clicks Cast iron, 1970s, and those pipes light up on the map. The network has 186 km of it. It breaks 38 times per 100 km a year. By 52 years, only 28% of its length has never broken.
“Cast iron, 1970s: 186 km · median life to first break 41 years · 38 breaks per 100 km a year”

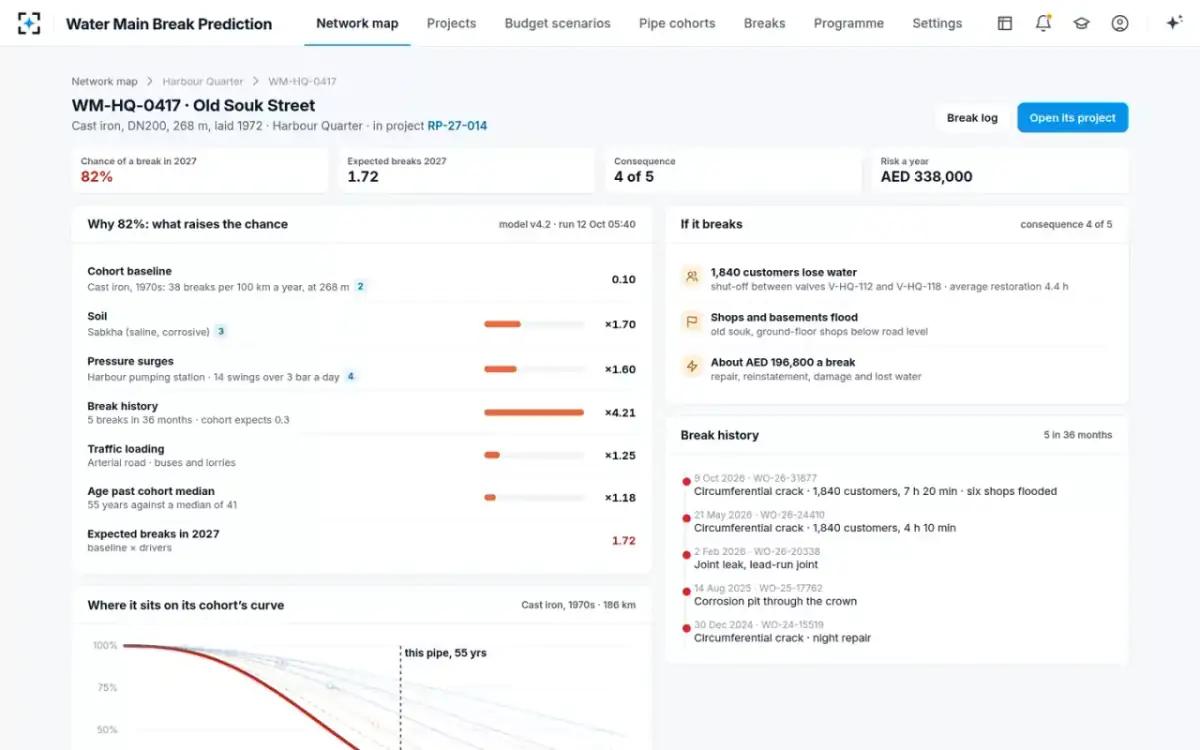

- 05The pipe
Why 82%: each driver, with its weight
Likelihood modeller and Consequence scorerThe burst main is cast iron, DN200, 268 m long, laid in 1972. Its group's starting rate is multiplied for corrosive soil (×1.70) and 14 pressure swings over 3 bar a day from a nearby pump station (×1.60). It is multiplied again for 5 breaks in 36 months (×4.21) and for buses and trucks on a main road (×1.25). Age past the group median adds a last ×1.18. The result is 1.72 expected breaks next year. A break would cut water to 1,840 customers between its two valves and flood the shops and basements along the street.
Consequence 4 of 5 · about $196,800 a break · risk $338,000 a year
- 0610:02

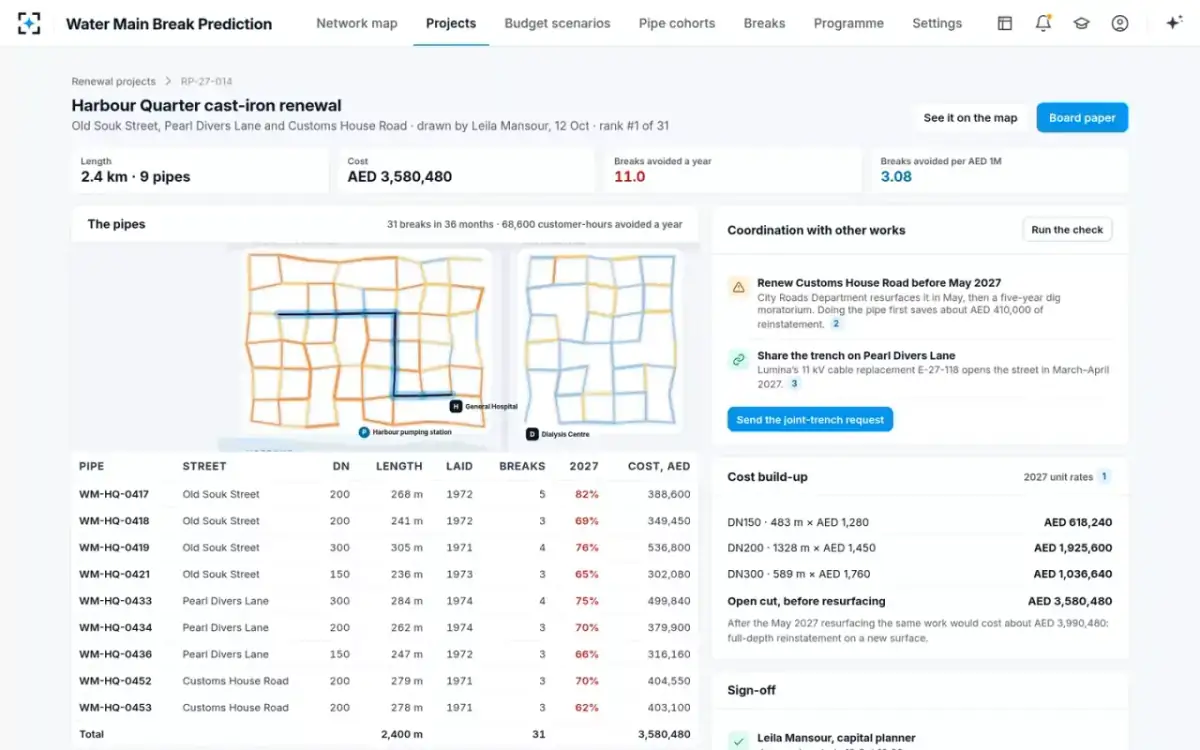

A project drawn, and what it buys

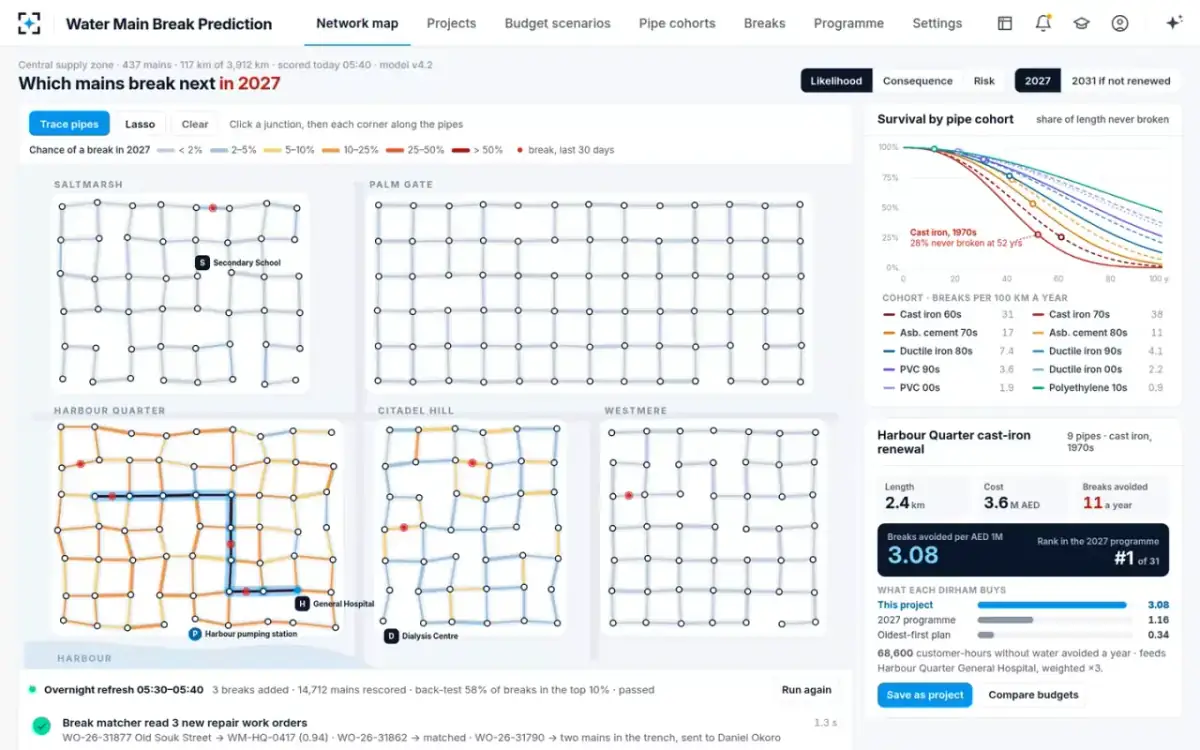

Capital plannerUsing Trace pipes, the planner clicks junctions along three streets, and the route follows the mains. The panel adds up the totals while the planner draws. The project covers 2.4 km and costs $3.6M. It avoids 11 breaks a year and 68,600 customer-hours without water. It also feeds the general hospital, which is weighted ×3.
3.08 breaks avoided per $1M, rank #1 of 31, against 1.16 for next year's program and 0.34 for an oldest-first plan
- 07Saved as a project
Renew before the road is resurfaced
Coordination checkerOnce saved, the cast-iron project costs $3,580,480 for 9 pipes, at next year's open-trench rates. The Coordination checker reads the city's road resurfacing plan and the electric utility's cable program. One road gets resurfaced in May next year, then cannot be dug for five years. Renewing first saves about $410,000 in road repair. On another street, an 11 kV cable job opens the road in March and April, so the trench can be shared.
“Drafted a joint-trench request for the electric utility. Not sent: waiting for the planner”

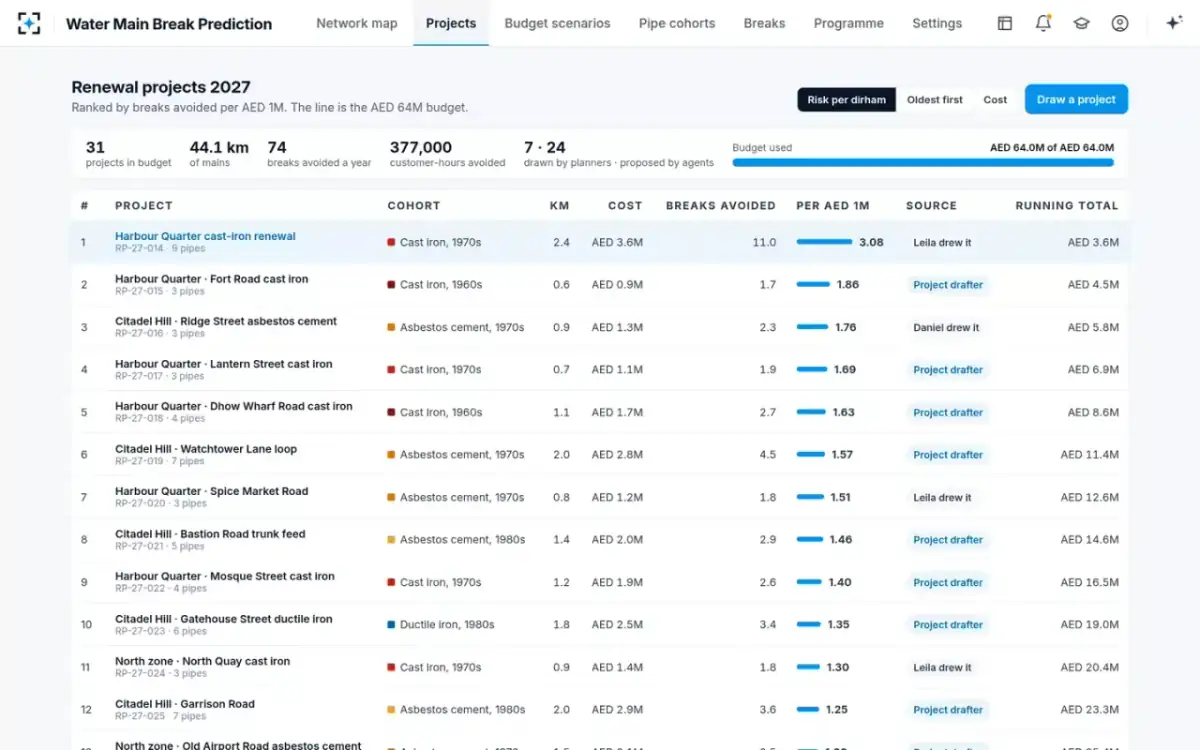

- 08The program
31 projects, ranked by what each dollar buys
Project drafterThe renewal projects are ranked by breaks avoided per $1M, with a line where the $64M budget runs out. Above the line, 31 projects fit. Together they cover 44.1 km of mains and avoid 74 breaks a year and 377,000 customer-hours without water. Planners drew 7 of the candidates and the Project drafter proposed 24. Each is an unbroken run of pipe that can be built valve to valve under one street-works permit.
Projects below the $64M line wait for the following year.
- 09Same budget

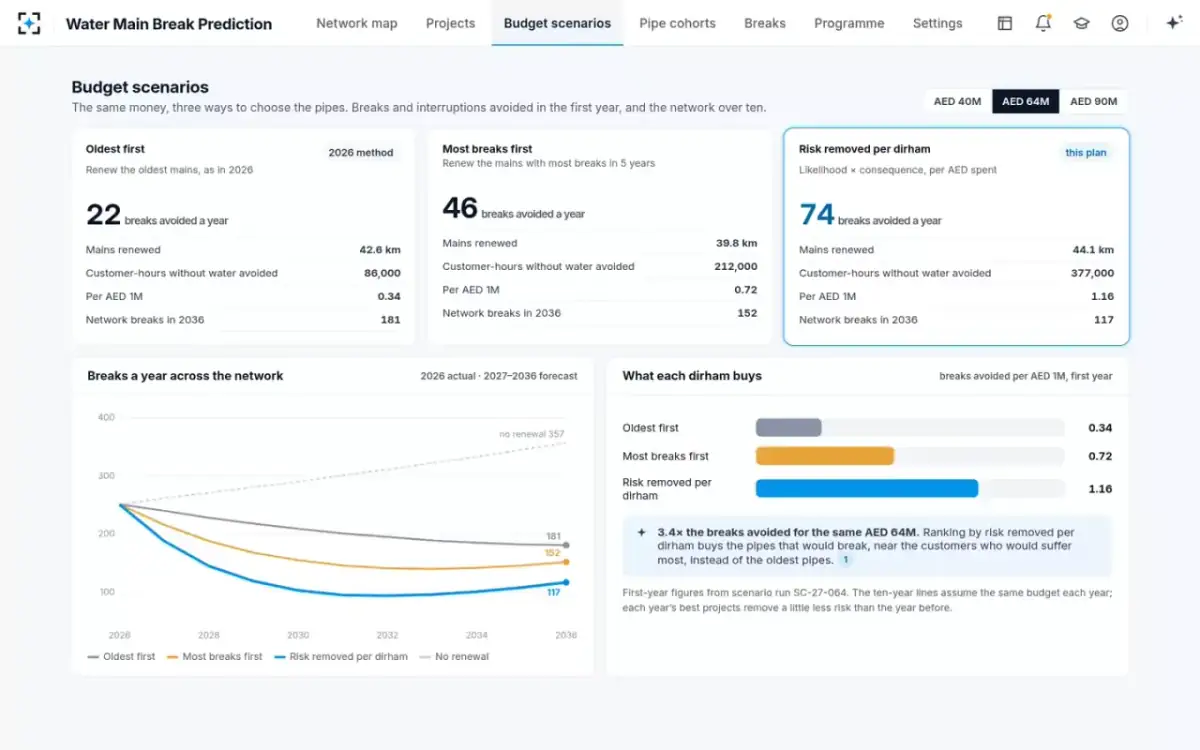

The same $64M, three ways to choose the pipes
Capital plannerOldest first, as this year, renews 42.6 km and avoids 22 breaks a year. Most breaks first avoids 46. Ranking by risk removed per dollar avoids 74, and 377,000 customer-hours without water against 86,000. Over ten years at the same budget, breaks across the network in the tenth year fall to 117. Oldest first ends at 181, and no renewal at 357. The sample utility puts the full cost of a break at $82,000. So the 52 extra breaks avoided a year are worth about $4.3M.
“3.4× the breaks avoided for the same $64M.”

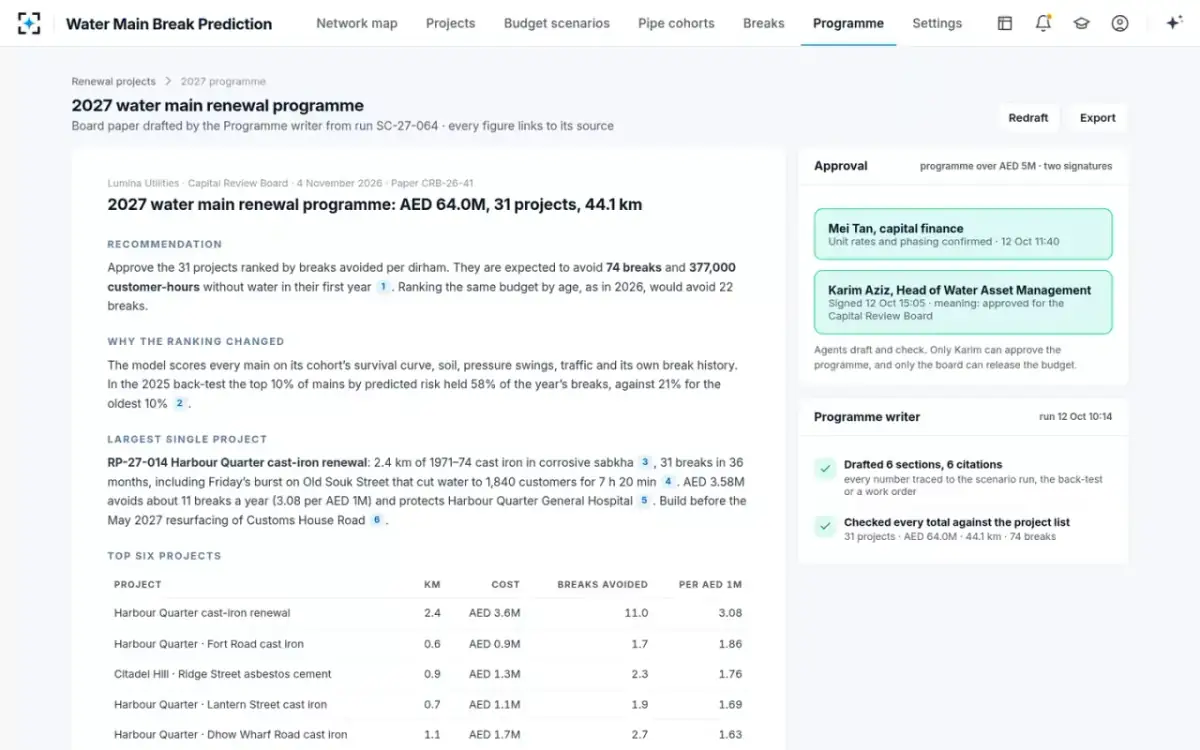

- 10Signed · 15:05
The board paper cites its sources and is signed
Head of Water Asset ManagementThe Programme writer drafts the paper for the capital review board. It covers the recommendation, why the ranking changed, the largest project, the top six and the risks. It has 6 citations to the scenario run, the back-test and the work order, and each total is checked against the project list. The capital finance partner confirms the rates and timing at 11:40, and the planner sends it at 11:52. The Head of Water Asset Management signs it as “approved for the Capital Review Board”.
“Agents draft and check. Only the Head of Water Asset Management can approve the program, and only the board can release the budget.”
