- Before
- Handles 14 applications a day, each on a 2-working-day clock. Spends more time lining up drawings on the map than deciding anything.
- Now
- Opens each application already aligned, measured and drafted, checks the overlay and the clashes, and signs.
A tower site with five clashes, and a letter signed on time
A developer wants to build a residential tower beside an 11 kV cable, a trunk main and a substation. It has two basements, a ground floor and 14 floors above. The developer's engineering consultant sent the no-objection application through the portal on a Monday at 09:14. The utility has 2 working days to decide, so the clock runs to Wednesday at 09:14. Here is what happens, screen by screen, in the working solution.
A worked example on sample data. Names, IDs and figures on the screens and in this section come from the demo.
- 01Tuesday, 10:40
Fourteen applications, each on its own clock
Third-party works officerThe officer's queue shows 14 applications, out of 165 for the whole team. Each one is a bar from the day it arrived to its 2-working-day deadline. The agents' recommendation sits beside it: 9 no objection, 3 with conditions, 1 clarification and 1 objection. Two have under 5 hours left. One is a pump house upgrade with an objection proposed. The other is a housing project waiting for the water network engineer.
“Bar = received → due · line = now · dot = agents finished”
- 02Opened

The site plan, laid over the utility's assets
Third-party works officerThe officer opens the tower application. The applicant's site plan A-101 rev C fills the screen. Drawn over it are the utility's 132 kV, 11 kV and LV cables, the trunk and distribution mains and a substation, each with its buffer. Five numbered clashes are hatched in red. On the right, the no-objection letter is already drafted, with 22 h 34 m left on the clock.
“Aligned to the parcel plan · 4 corners · fit 0.12 m”
- 03Monday, 09:16 · 52 s
Reading the drawing: the agents' run, replayed
Intake checker, Plan aligner and Clash finderThe six agents started two minutes after the application arrived. First, the intake checker found all 6 files in 3.1 s. Next, the plan aligner placed A-101 on the parcel using the four corners on the parcel plan. Then the clash finder measured 8 assets within 30 m and found 5 clashes, while the letter waited for its results. The officer can replay the run step by step.
Clash finder: “11 kV cable at 0.8 m from the north wall (buffer 2.0 m). Trunk main under the plant crossing. Substation access and oversail. LV under storage.”
- 0421.4 s
Each element read, with its sheet and grid
Drawing readerThe drawing reader read 4 drawings and 23 elements. Shoring plan S-110 rev A shows the north wall as secant piles Ø750 at 650 mm centers, running 46 m along the boundary. The pile toe, the bottom of each pile, is at −14.0 m. Four dewatering wells draw the water down to −9.5 m. Each reading cites its sheet and grid, with how confident the reader is.
Not in the submission: “Rig type and expected vibration not stated.” The letter sets a vibration limit (C1) instead of asking for it.
- 05Clash 1
The basement wall is 0.8 m from the 11 kV cable
Clash finderThe north basement wall runs inside the cable's 2.0 m excavation buffer, set by the utility's HV cable rule. According to the as-built record, the map of what was actually laid, the cable is 1.0 m deep. The wall goes down to −14.0 m. The clash shows its drawing, S-110 rev A at grid A to E/1. It links straight to the condition it creates.
“Letter: C1 · Trial pits required · needs the network protection engineer”

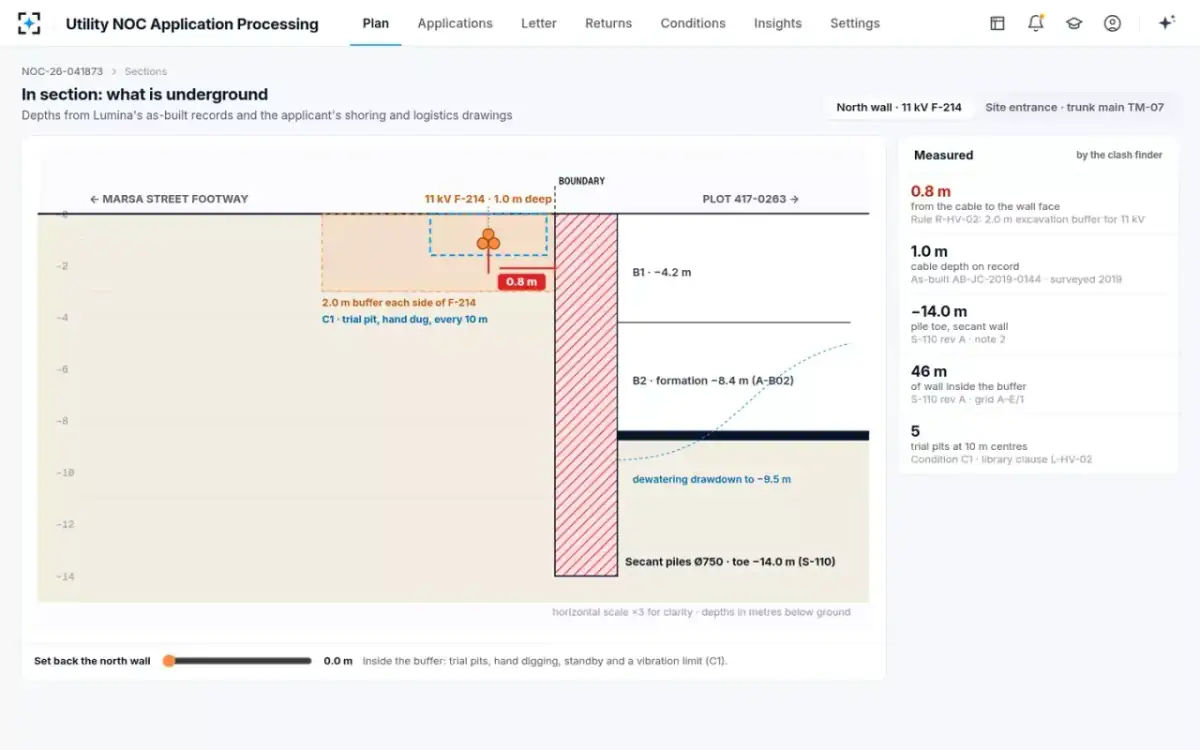

- 06In section
What is underground, from the as-built and the shoring plan
Network protection engineer, HV cablesThe section along the street shows the cable 1.0 m deep with its 2.0 m buffer on each side. It also shows the secant piles down to −14.0 m and the dewatering drawdown to −9.5 m. The clash finder lists what it measured. The wall face is 0.8 m from the cable, and 46 m of wall is inside the buffer. It also lists 5 trial pits at 10 m centers.
A basement inside the buffer means trial pits before the first pile.
- 07The letter
One condition per asset affected, each with its rule and drawing

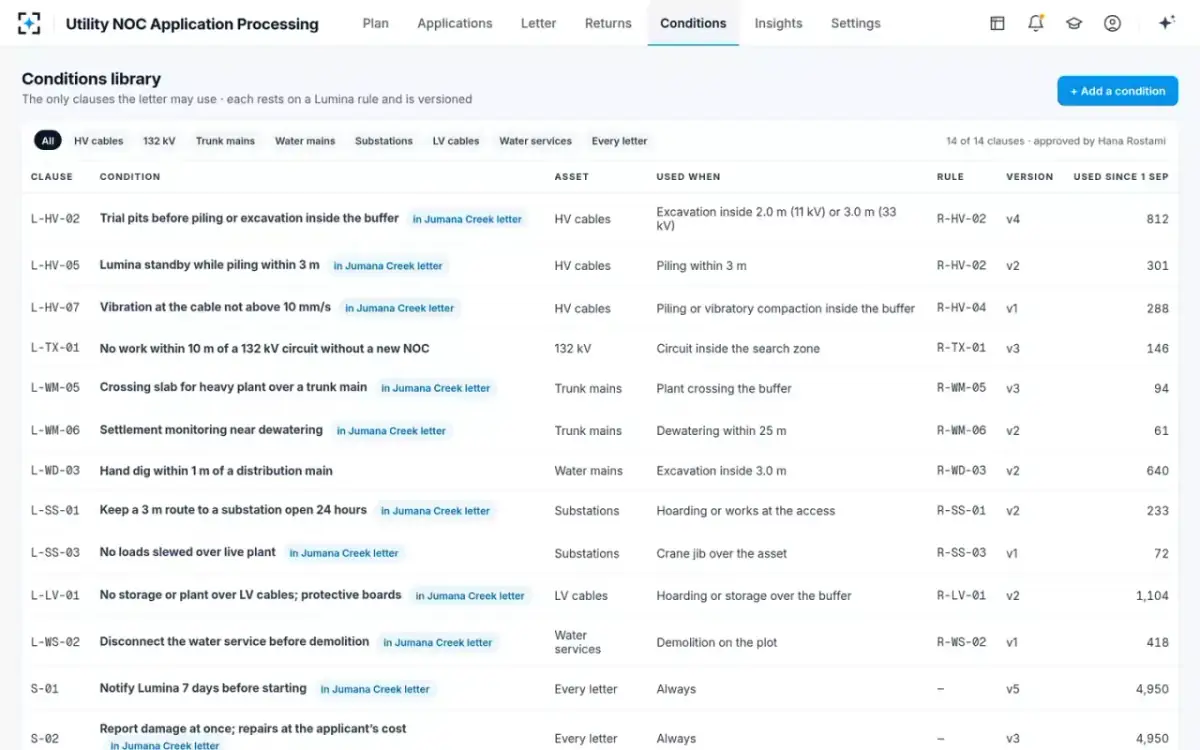

Conditions writerThe letter has six conditions plus three standard ones. C1 asks for trial pits at 10 m centers along the 11 kV cable and hand digging within 0.5 m. It also asks for a utility standby while piling within 3 m, and caps vibration at the cable at 10 mm/s. C2 asks for a crossing slab designed for 45 t over the 600 mm trunk main, with vibration and settlement monitoring. C3 to C6 keep the substation open, stop loads swinging over it, protect the LV cables and disconnect the water service. Each margin note names the clash, the rule, the drawing and the library clause.
For information: “A 132 kV circuit runs 24 m north, outside its 10 m buffer. No work within 10 m of it without a new application.”
- 08Advice
What the consultant could change, tested on the plan

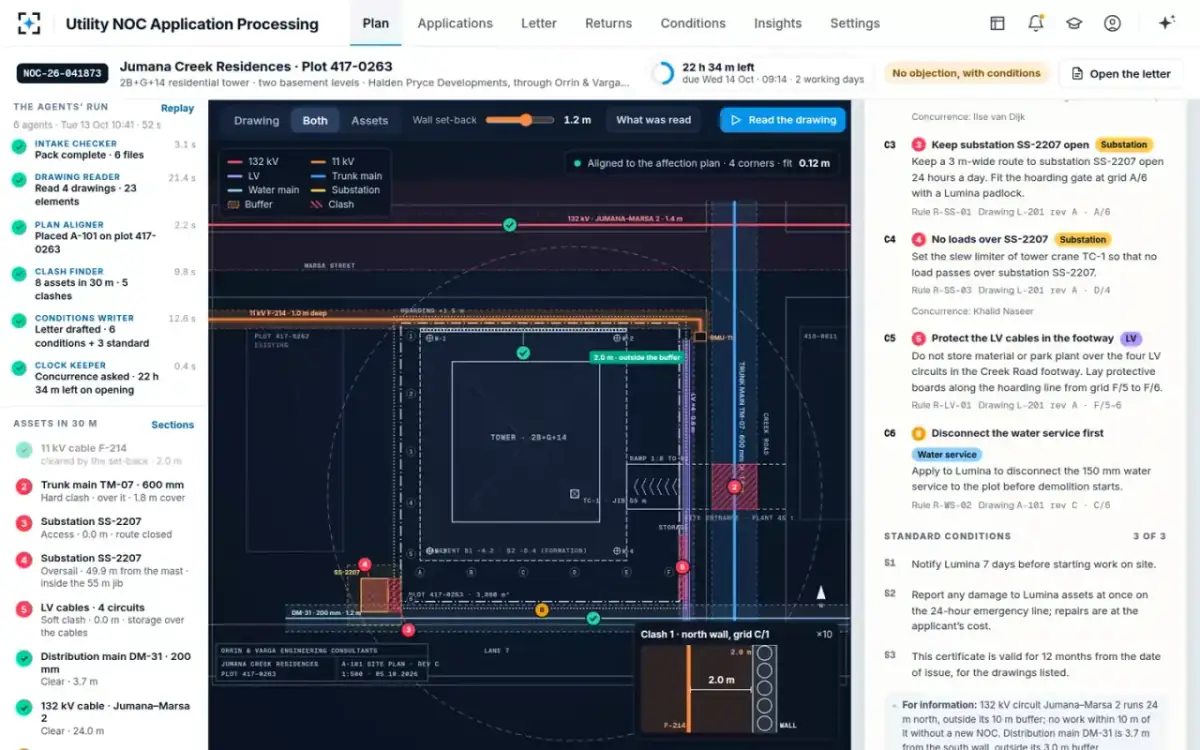

Third-party works officerThe officer drags the wall set-back to 1.2 m. Now the cable sits 2.0 m from the wall, outside its buffer, and shows as cleared. The basement would lose about 55 m² per level. When asked, the assistant adds this to the letter as advice to the consultant. The drafted conditions stay until the consultant resubmits.
The consultant learns exactly what to change in one letter, instead of over three returns in three weeks.
- 09Tuesday, 11:32 · signed
Two engineers concur, the officer signs
Two engineers and the officerOn Monday, the clock keeper had asked both engineers. The network protection engineer concurs, or formally agrees, on C1 and C4 at 11:18. At 11:24 the water network engineer concurs on C2. The officer signs, and the letter goes to the consultant. It lists its conditions and the drawings it covers, and it is valid for 12 months.
“Issued to the consultant · 21 h 42 m inside the 2-working-day standard”
- 10Elsewhere in the queue
A notice, and an objection only the head may make
Intake checker and Clash finderTwo other applications stop short. An office project's shoring plan S-201 is drawn on a local site grid, with a best fit of 6.8 m against a 0.5 m limit. It also gives no pile toe level. So the agents stopped and drafted a clarification notice, and the clock pauses once it is sent. At the pump house, the new foundation is 0.3 m from a joint bay of a 132 kV circuit. The utility's rule keeps 3.0 m clear there. No condition can make that safe.
“3 h 25 m left on the 2-working-day standard · only the head of Third-Party Works may object”
