- Before
- Owns 214 active connections, electricity and water, and takes 30 to 40 status calls a day. Half of them ask why nobody is coming after the inspector passed the job.
- Now
- Opens one rail where a stalled step stands out. Books each ready connection in one press, and sends missing-item letters the checker has already written.
A dental clinic's new service connection, stuck nine days at inspection
One utility district has 214 connections in progress. A dental clinic needs a 400 A, 120/208 V three-phase service before it opens. Here is one day in the working solution, screen by screen.
A worked example on sample data. Names, IDs and figures on the screens and in this section come from the demo.
- 01First thing

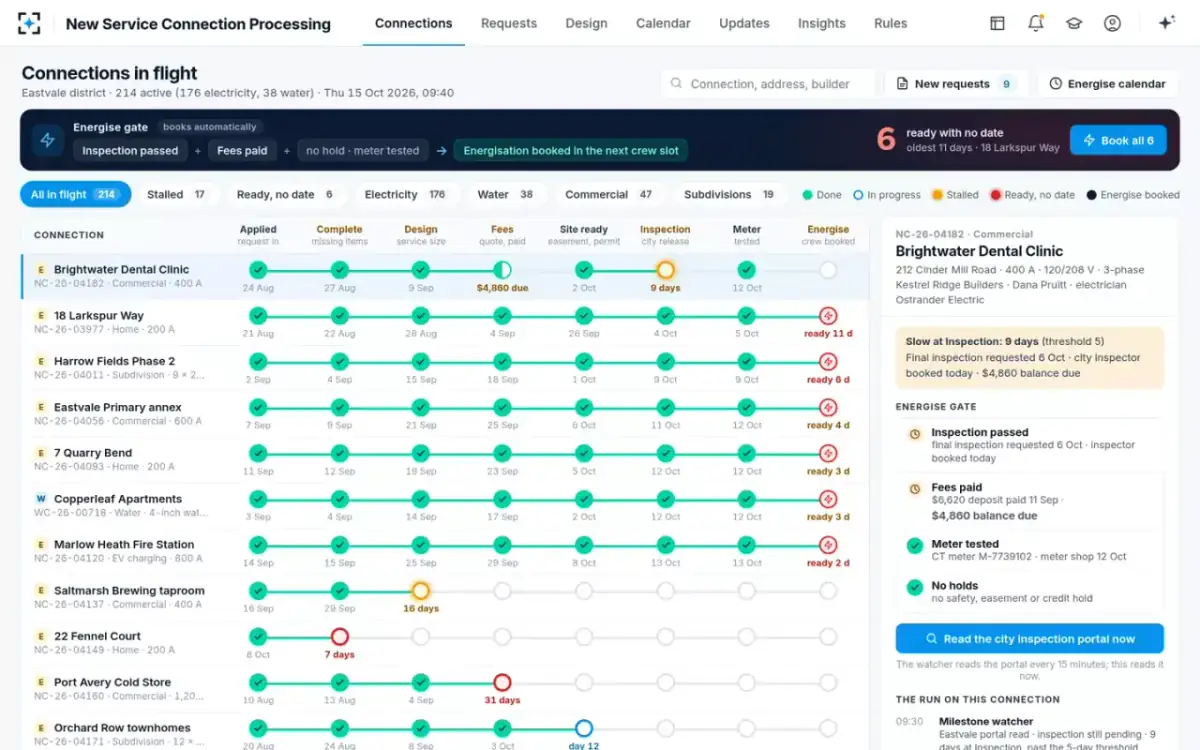

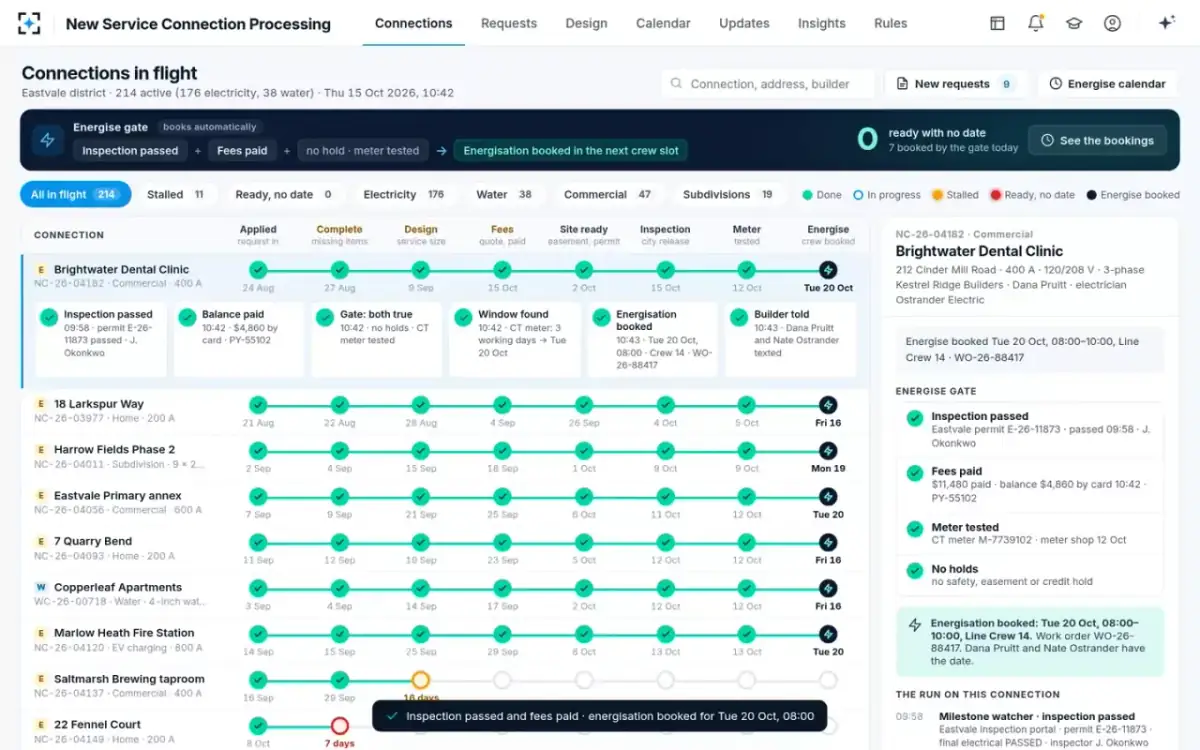

The morning starts on the milestone rail
Connections coordinatorEach connection is one row with eight stations: Applied, Complete, Design, Fees, Site ready, Inspection, Meter and Energize. Each station is updated from the source records. In all, 214 connections are active (176 electricity, 38 water), and 17 are stalled. A station turns amber past its time limit and red past twice that, so stalls stand out down a column. Above the rail, the energize gate counts 6 connections that are ready with no date. The oldest has waited 11 days.
Energize gate: “Inspection passed + Fees paid + no hold · meter tested → Energization booked in the next crew slot”
- 02One press

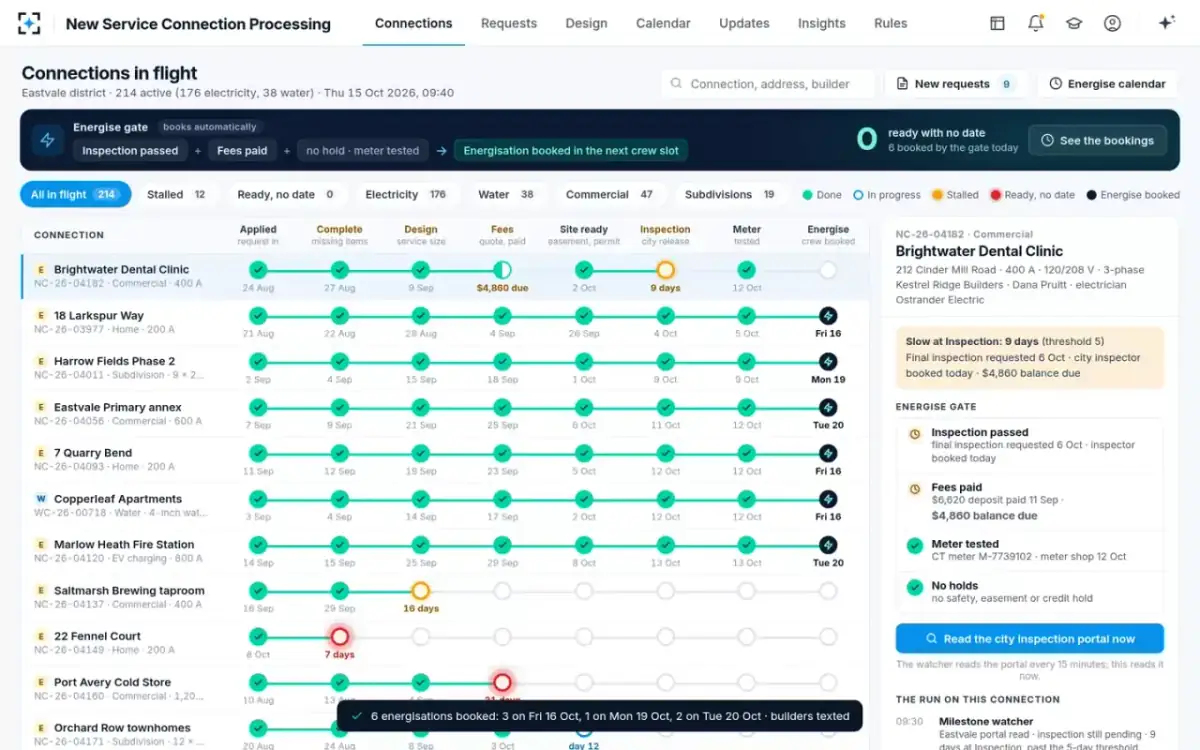

Six ready connections, booked in one go
Energise schedulerOne address passed inspection 11 days ago and its fees were paid long ago, yet it still had no energize date. All 9 lots in one subdivision phase passed 6 days ago. The coordinator presses Book all 6. The scheduler finds the first free window for the crew that covers each address. It allows for the notice the meter shop needs, and the count drops to 0.
“6 energizations booked: 3 tomorrow, 1 on Monday, 2 on Tuesday · builders texted”
- 03The file

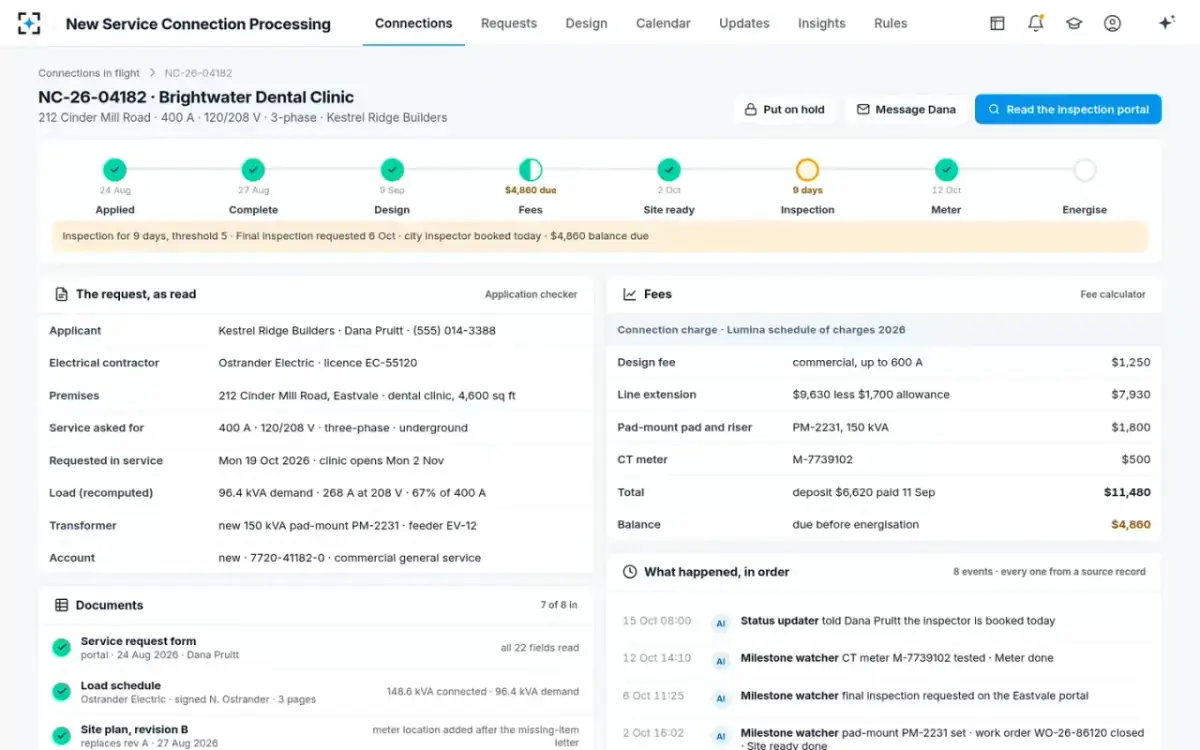

The dental clinic has waited 9 days at Inspection
Connections coordinatorThe connection file shows the request as the application checker read it. The builder and a licensed electrical contractor filed it, asking for service by the following Monday. The load works out at 96.4 kVA demand, or 268 A at 208 V. That is 67 % of 400 A, on a new 150 kVA pad-mount transformer. The fee calculator quotes $11,480 from the schedule of charges. The $6,620 deposit is paid, and $4,860 is due before energization.
“Inspection for 9 days, threshold 5 · Final inspection requested · city inspector booked today · $4,860 balance due”
- 04Later that morning
The city passes the inspection, and the builder pays
Milestone watcherThe watcher reads the city inspection portals every 15 minutes. At 09:58 the city portal shows that the permit's final electrical inspection passed. At 10:42 the builder pays the $4,860 balance by card on the portal. Both stations turn green, each with its own record.
- 05A minute later
Energization books itself for Tuesday

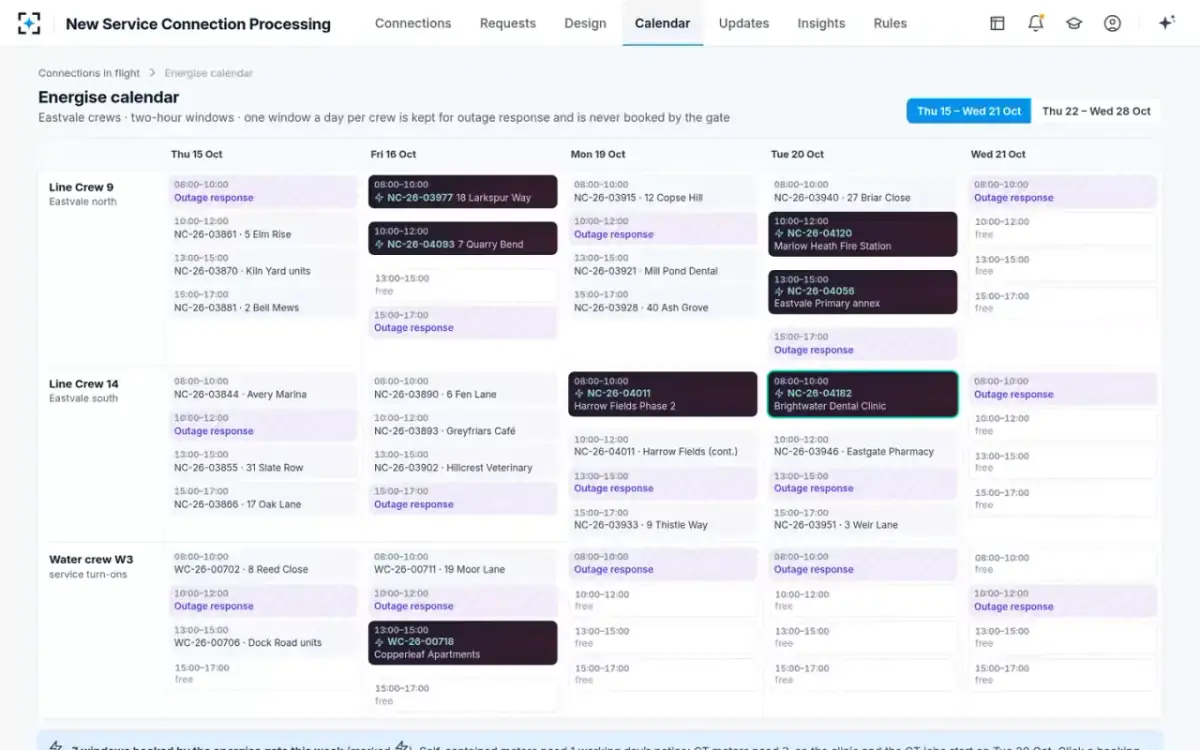

Energise schedulerThe gate checks four things: inspection passed, fees paid, no holds, and the CT meter tested. A CT meter, used on larger services, needs 3 working days' notice for the meter shop. So the earliest date is the next Tuesday. The first free window is 08:00 to 10:00 on one line crew. The scheduler raises the work order and leaves all outage-response windows free.
- 06The same minute

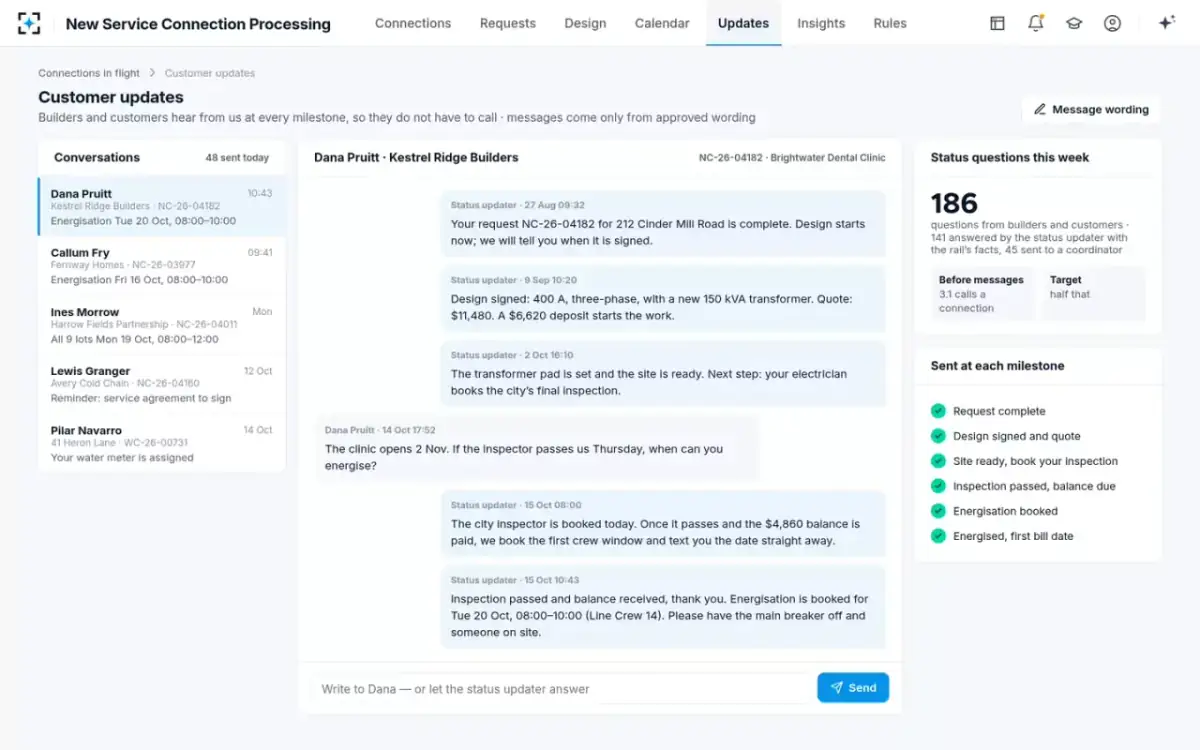

The builder gets the date without calling
Status updater, to the builderThe night before, the builder's project manager had asked when the clinic could be energized if the inspector passed it on Thursday. The status updater has reported each milestone since the request was complete. Now the project manager and the electrical contractor get the date by text.
“Energization is booked for Tuesday, 08:00 to 10:00. Please have the main breaker off and someone on site.”
- 07New requests

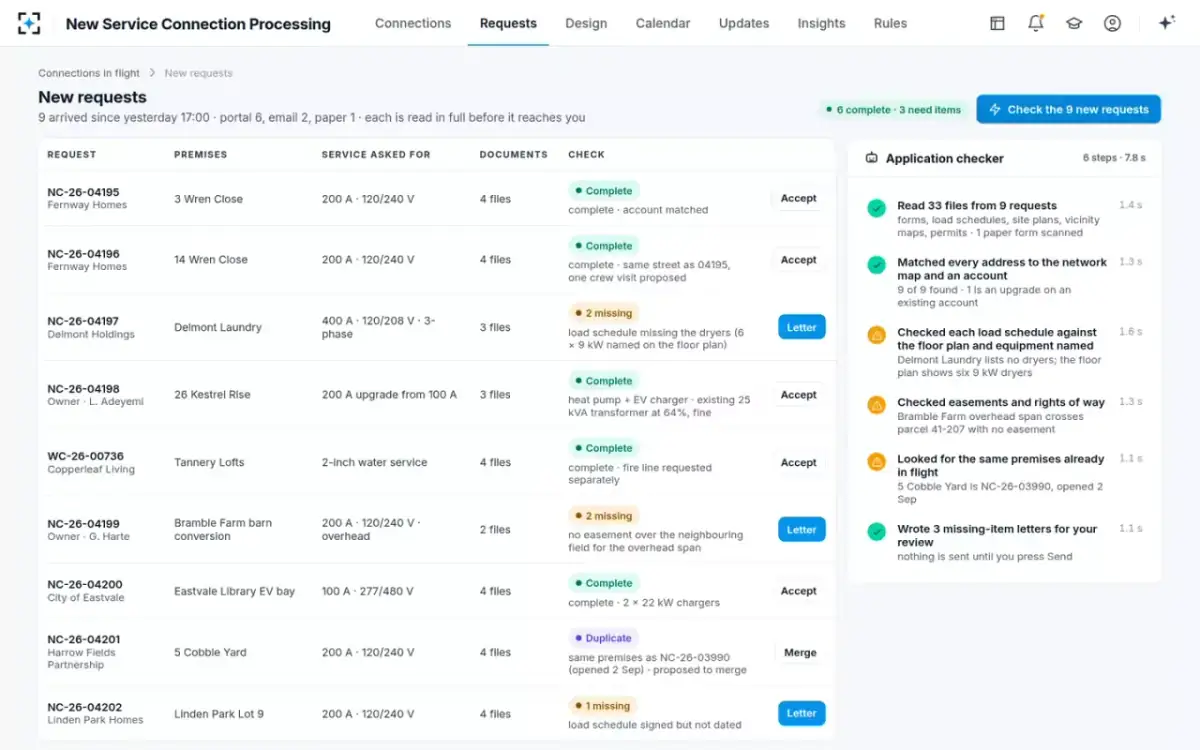

Nine new requests, read before they reach the coordinator
Application checkerNine requests arrived since yesterday evening, with 33 files: 6 by portal, 2 by email and 1 on paper. The checker matches each address to the network map and to an account. It checks each load schedule against the floor plan. A laundry's schedule leaves out the six 9 kW dryers shown on its floor plan. A farm has no easement over the neighbor's field for the overhead line. A third address is the same site as a request already in progress, so the checker proposes merging the two.
“Wrote 3 missing-item letters for your review · nothing is sent until you press Send”
- 08Design queue

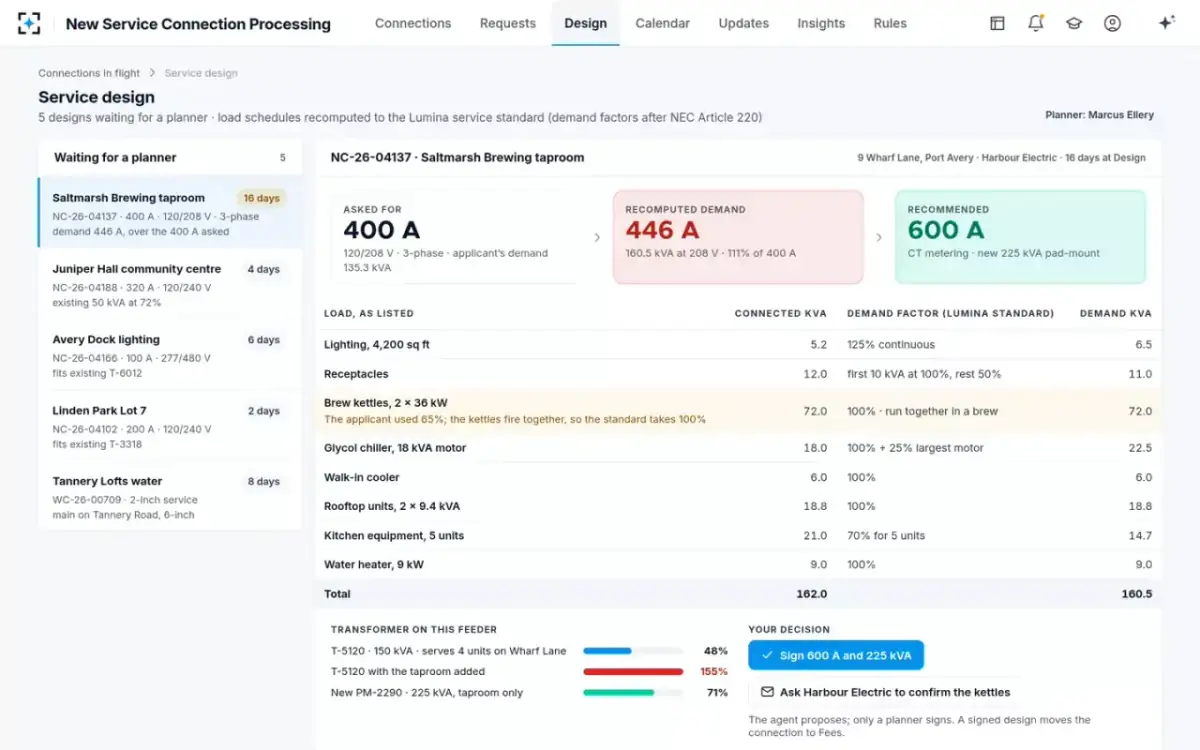

A load schedule that would overload the transformer
Service plannerA brewery taproom asked for 400 A. The load and service sizer works the schedule out again to the utility's service standard, which follows NEC Article 220. The result is 160.5 kVA, or 446 A at 208 V: 111 % of 400 A. The applicant counted the two 36 kW brew kettles at 65 %. They run together during a brew, so the standard counts them at 100 %. The existing transformer would run at 155 %, so the sizer proposes 600 A, CT metering and a new 225 kVA pad-mount.
“The agent proposes, and only a planner signs. A signed design moves the connection to Fees.”
- 09The pattern

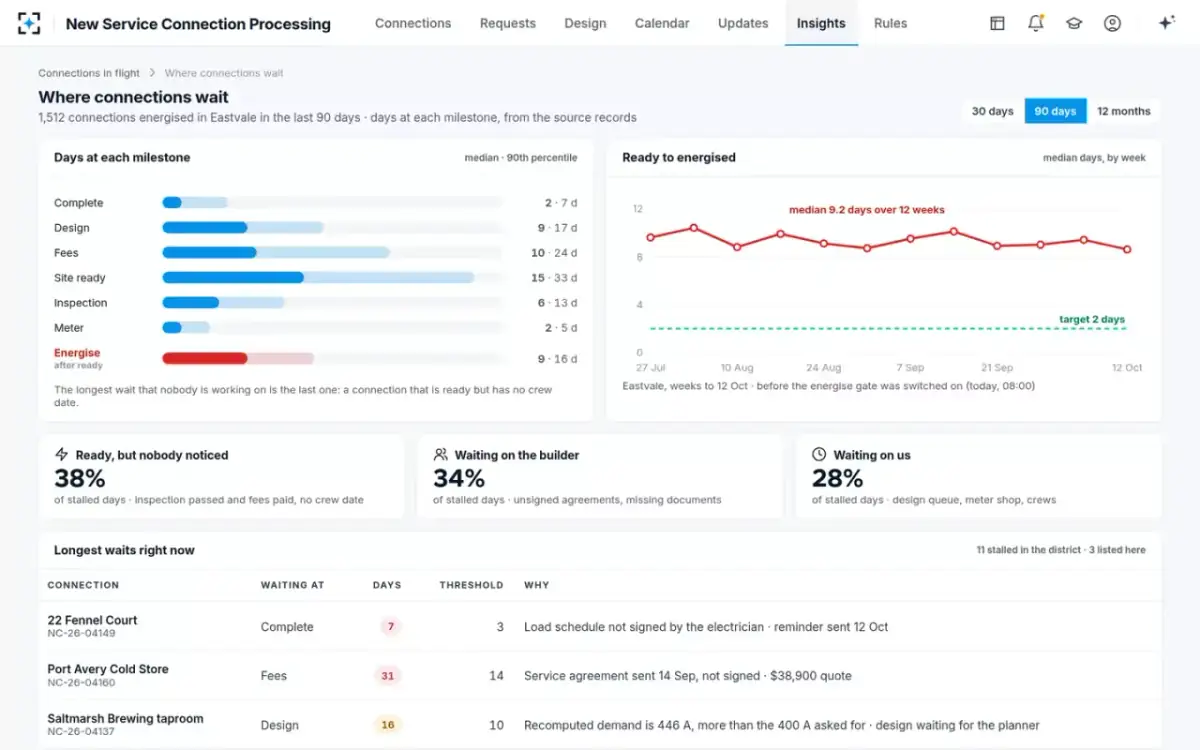

Where the district's connections really wait
Connections coordinatorOver 90 days, the district energized 1,512 connections. Site ready is the longest milestone, at a median of 15 days, but that is the builder's work. The longest wait nobody was working on is the last one. The wait from ready to energized had a median of 9 days, and 9.2 over the last 12 weeks. Of all stalled days, 38 % were connections with inspection passed and fees paid but no crew date. Before milestone messages, builders and customers made 3.1 status calls per connection.
