- Before
- Carries 14 open requests for 3,855 MW. Takes a developer's call every hour asking when, and chases missing documents by email.
- Now
- Screens a complete request in one click and sees which are real from the readiness score. Sends a letter where each missing item cites its clause.
A 300 MW data center request through large load interconnection screening
The utility has 14 open large-load requests, asking for 3,855 MW in total. Next to screen is a developer's request for 300 MW at a 230 kV substation. It has been complete for four days. Here is what happens, screen by screen, in the working solution.
A worked example on sample data. Names, IDs and figures on the screens and in this section come from the demo.
- 01Morning

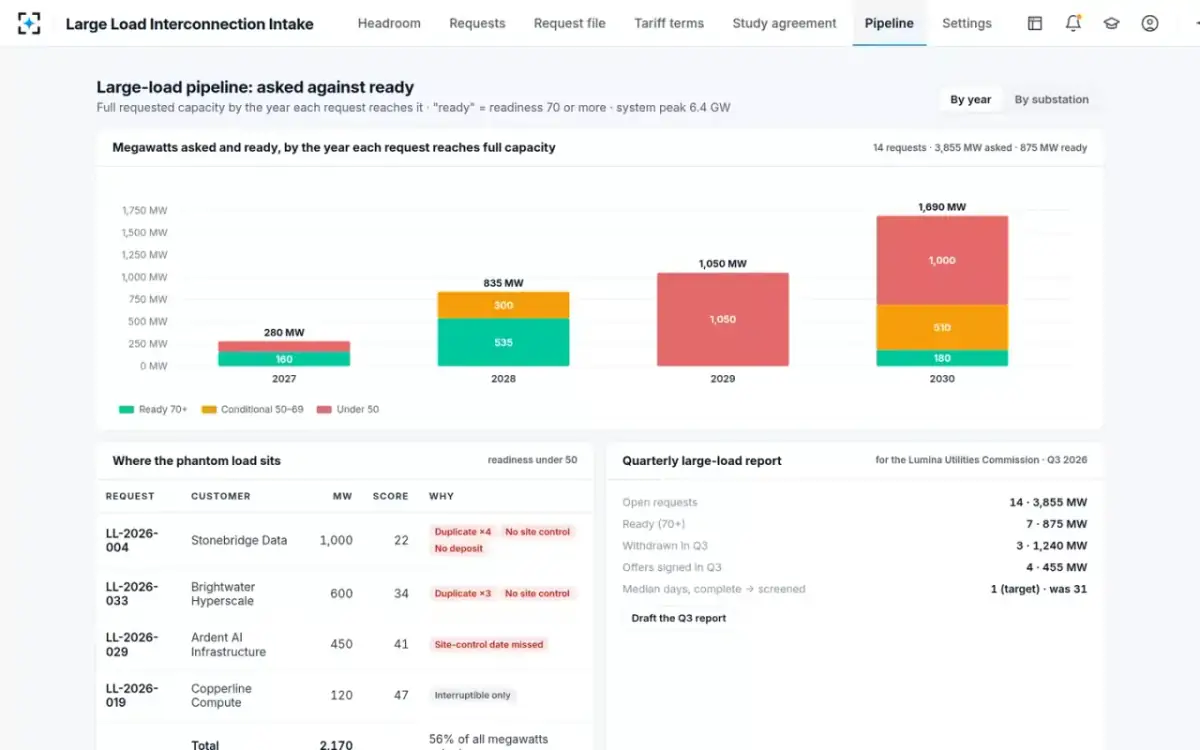

Fourteen requests, 3,855 MW asked, 875 MW ready

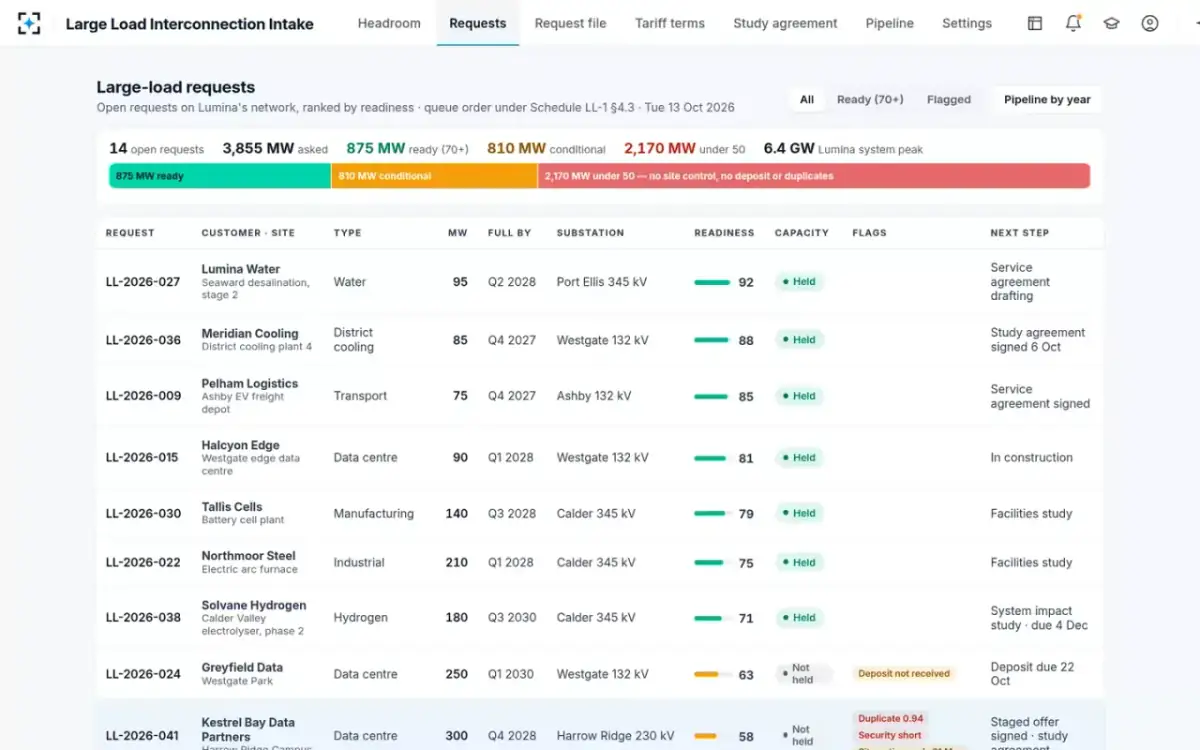

Large-load account managerThe queue is ranked by readiness, in queue order under the large-load tariff. Seven requests score 70 or more, for 875 MW. Another 2,170 MW scores under 50, with no site control, no deposit or duplicates. The developer's data center campus asks for 300 MW by Q4 2028 and is waiting to be screened.
Planning should not spend a month on a request before anyone knows it is real.
- 02One click
The file read, checked and screened in about a minute

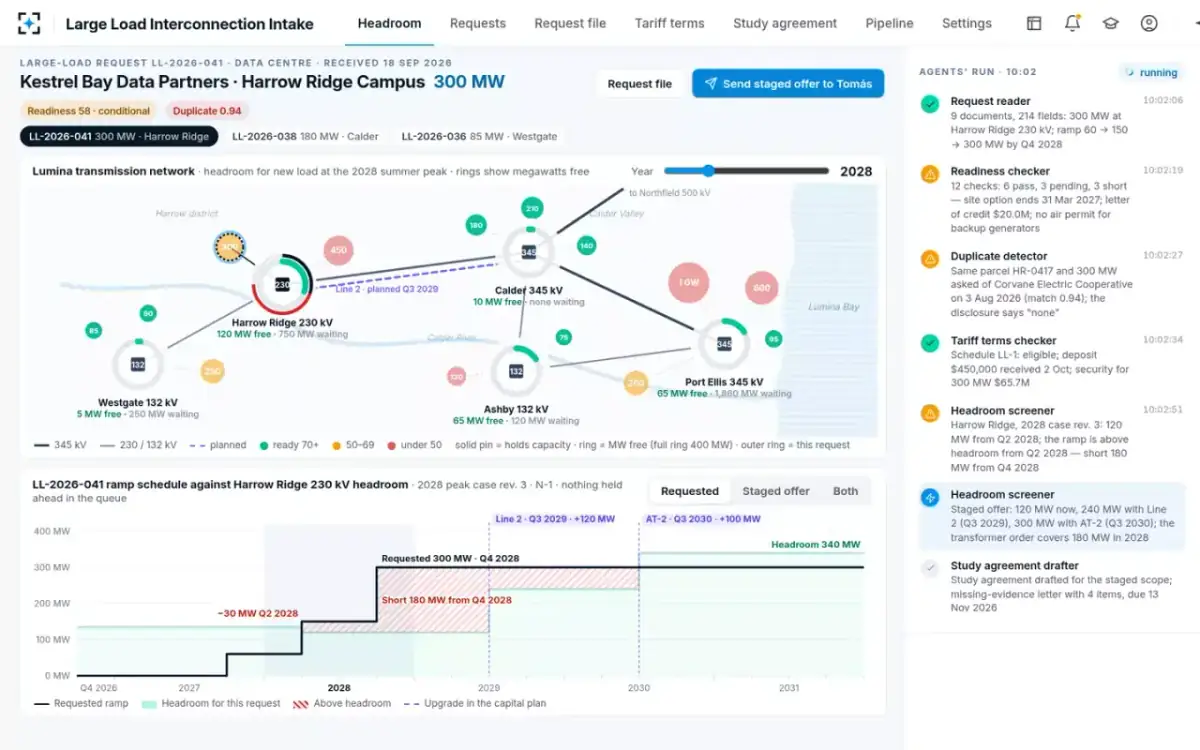

Six agentsThe account manager presses Screen request. The request reader takes in 9 documents and 214 fields. The request is for 300 MW at the 230 kV substation, ramping from 60 to 150 to 300 MW by Q4 2028. The readiness checker finds 6 checks pass, 3 pending and 3 short. The duplicate detector, the tariff terms checker and the headroom screener follow, each step logged with its time.
Readiness checker: “site option ends before the study does; letter of credit $20.0M; no air permit for backup generators”
- 03The headroom screen
180 MW short in 2028, and a staged offer the network can serve

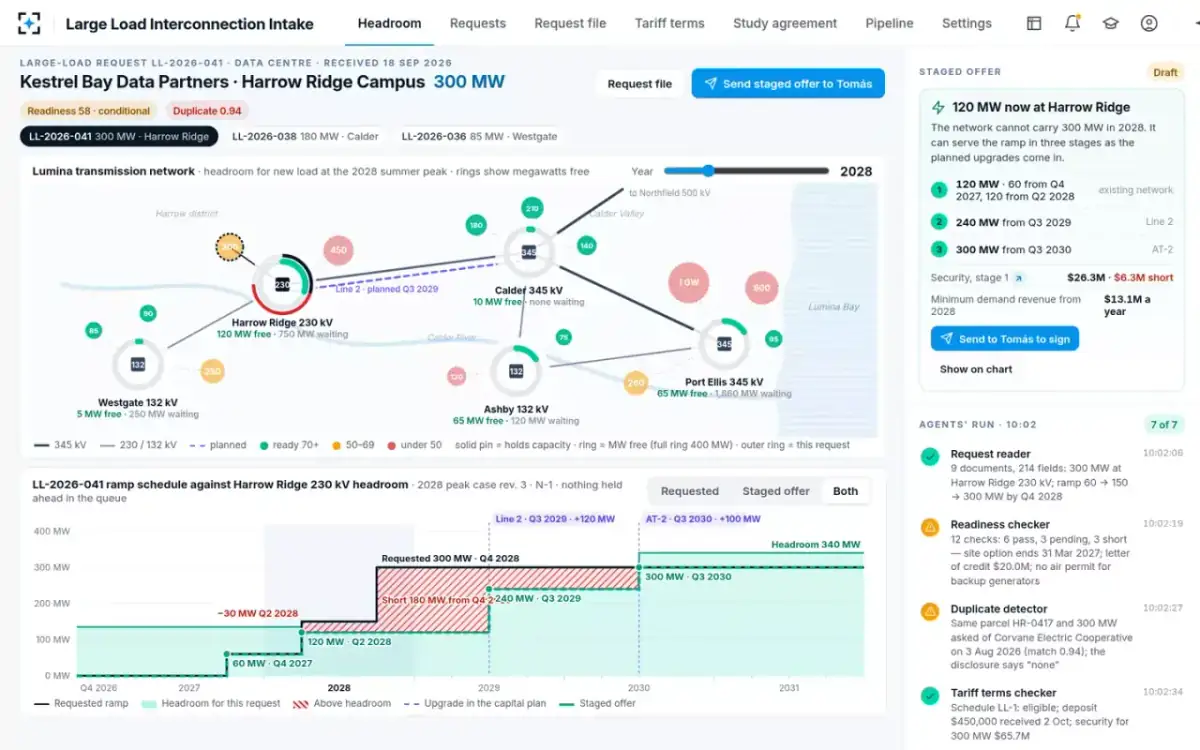

Headroom screenerOn the 2028 summer peak case, rev. 3, the substation has 120 MW of headroom from Q2 2028. That already allows for a contracted hydrogen load and for the N-1 test, which assumes any one line or transformer is out. The ramp is 30 MW over headroom in Q2 2028 and 180 MW short from Q4 2028, hatched red on the chart. The screener proposes three stages that follow the capital plan. They are 120 MW now, 240 MW with a second line in Q3 2029, and 300 MW with a second autotransformer in Q3 2030.
“The network cannot carry 300 MW in 2028. It can serve the ramp in three stages as the planned upgrades come in.”

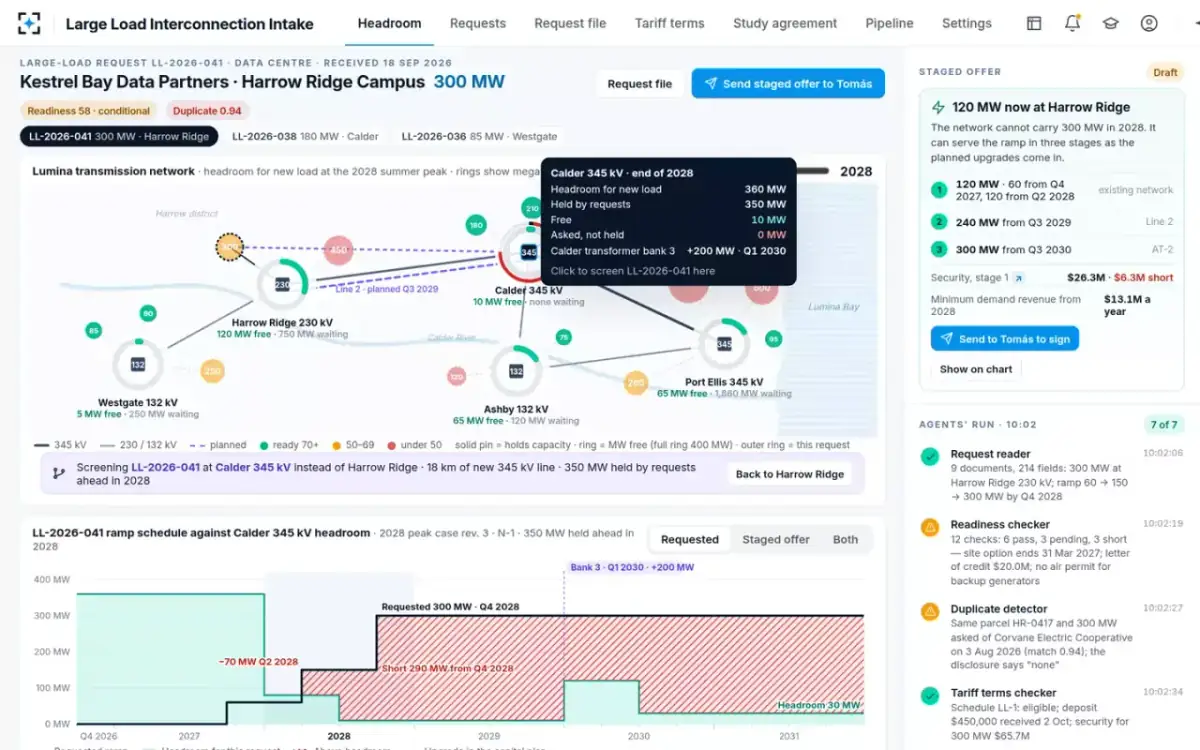

- 04Another substation
The same request, re-screened at a 345 kV substation
Headroom screenerClicking a nearby 345 kV substation on the map re-screens the request there. It has 360 MW of headroom at the end of 2028, but requests ahead hold 350 MW. That leaves 10 MW free, and reaching it needs 18 km of new 345 kV line. Back at the first substation, an earlier 450 MW request missed its site-control date, so it holds no capacity. The developer's own transformer order covers 180 MW in 2028.
“The developer's own transformer order covers 180 MW in 2028: the 300 MW step is ahead of its hardware.”

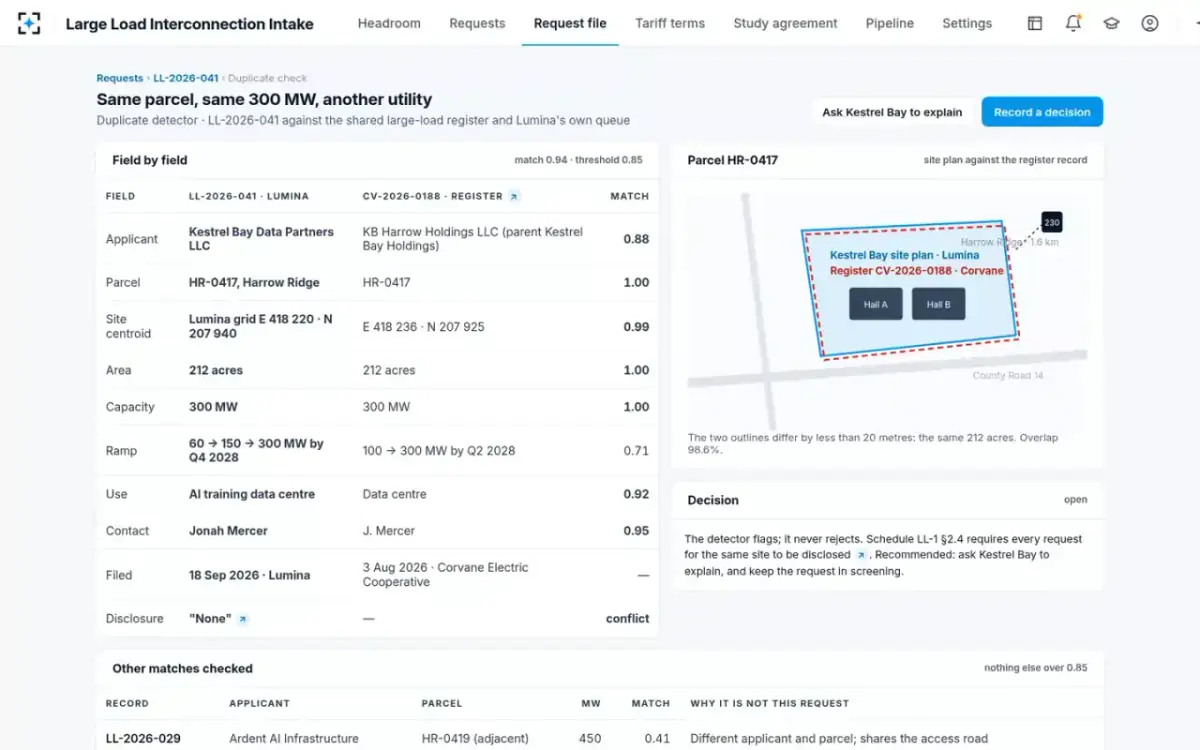

- 05Duplicate check
Same parcel, same 300 MW, another utility
Duplicate detectorThe shared large-load register shows a record for the same 212-acre parcel and 300 MW. It was filed earlier with a neighboring electric cooperative. The match scores 0.94, against a threshold of 0.85. The two site outlines differ by less than 20 meters. Yet Part 7 of the application, where the developer lists other requests, says “none”. The detector recommends asking for an explanation and keeping the request in screening.
“The detector flags. It does not reject.”

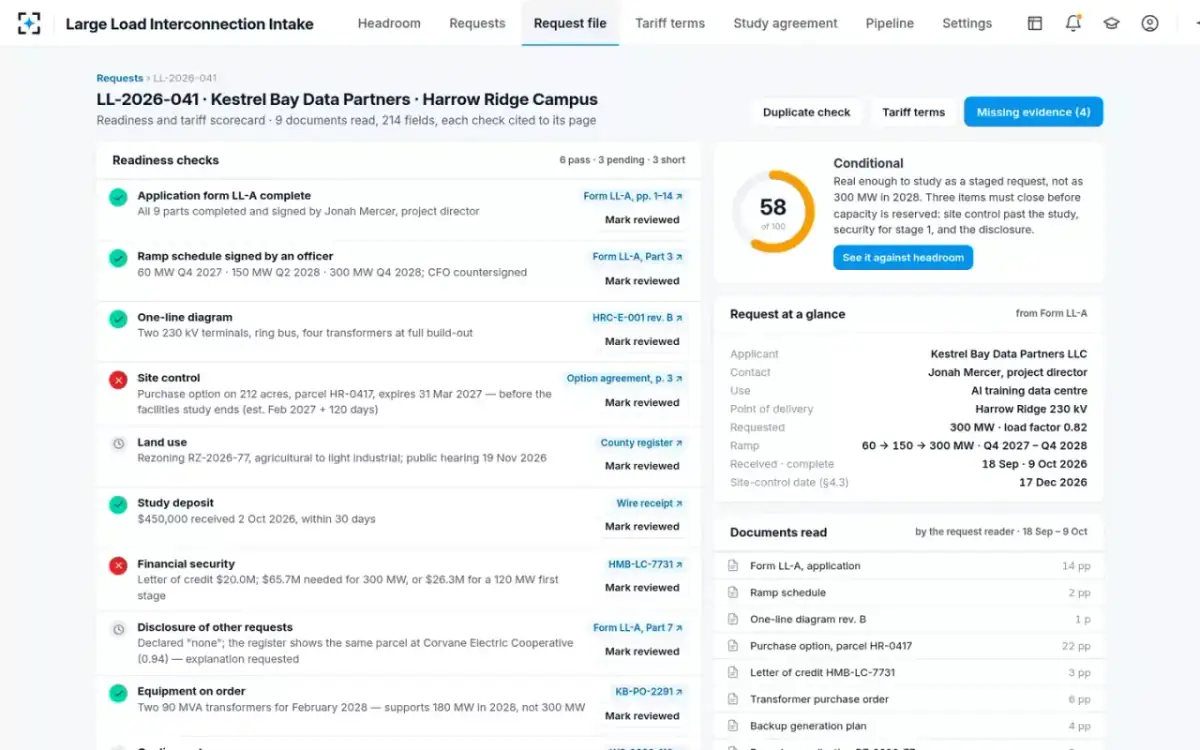

- 06The scorecard
58 of 100: real enough to study in stages
Readiness checkerThe scorecard has twelve readiness checks and six tariff checks, each cited to its document and page. Site control is a purchase option on the parcel that expires before the facilities study ends. Financial security is a $20.0M letter of credit, against $65.7M needed for 300 MW, or $26.3M for a 120 MW first stage. Backup generation is 24 × 2.5 MW diesel sets, with no air permit filed.
“Real enough to study as a staged request. The full 300 MW in 2028 is not.”

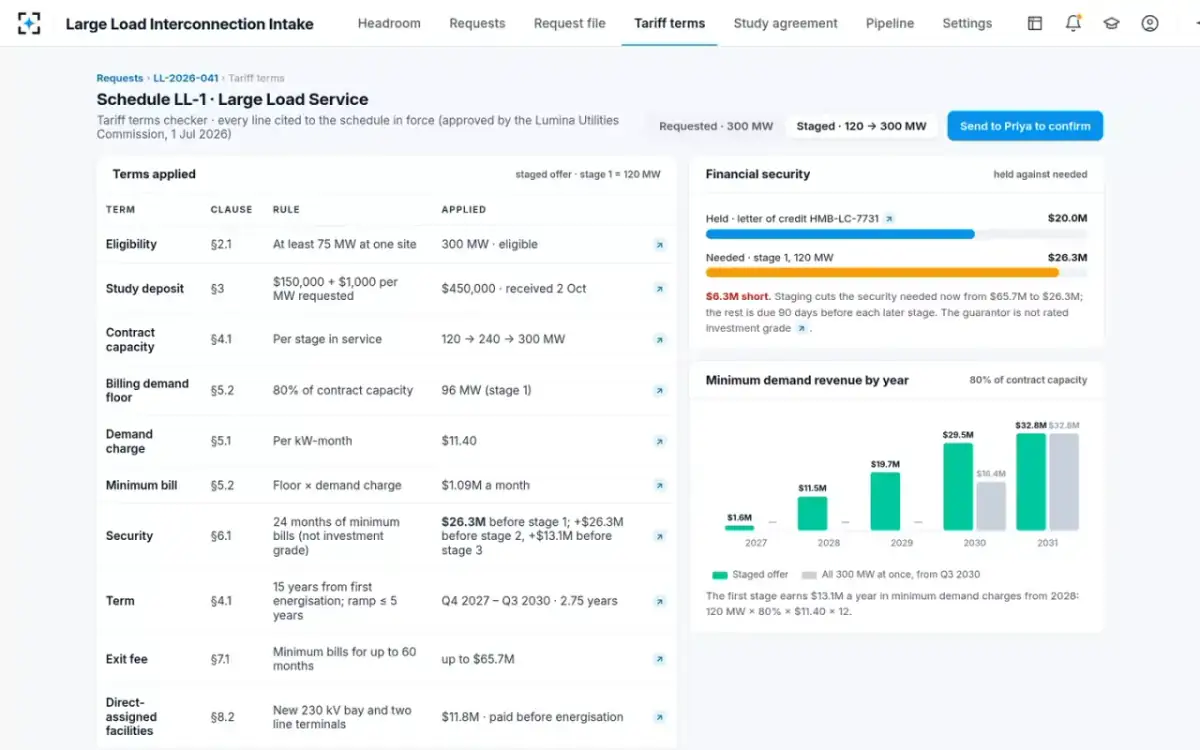

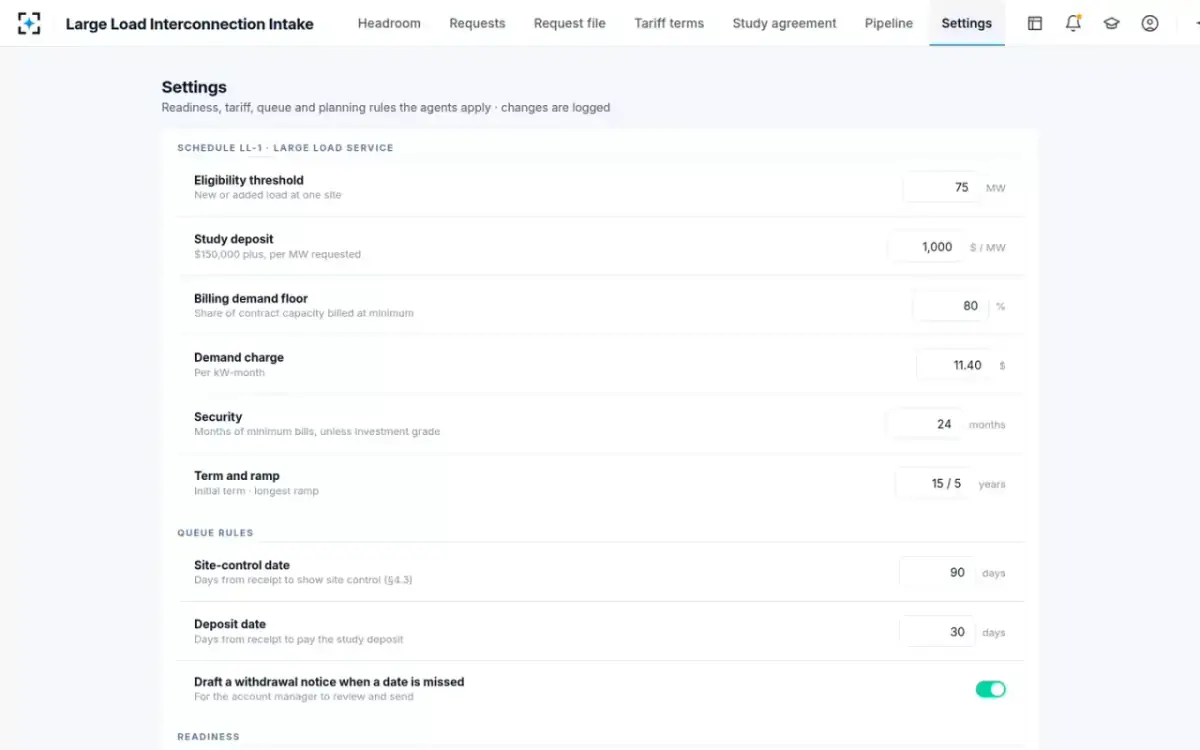

- 07Tariff terms
The large-load tariff applied line by line, for the staged offer
Regulatory and tariff analystThe request is eligible, at 300 MW against the tariff's 75 MW threshold. The study deposit of $450,000 has been received. The tariff bills at least 80 % of contract capacity, at $11.40 per kW-month. For stage 1 that is a minimum bill of $1.09M a month. The guarantor is not rated investment grade, so security is 24 months of minimum bills. That is $26.3M before stage 1, and the developer is $6.3M short. The tariff analyst confirms the terms.
“Staging cuts the security needed now from $65.7M to $26.3M; the rest is due 90 days before each later stage.”

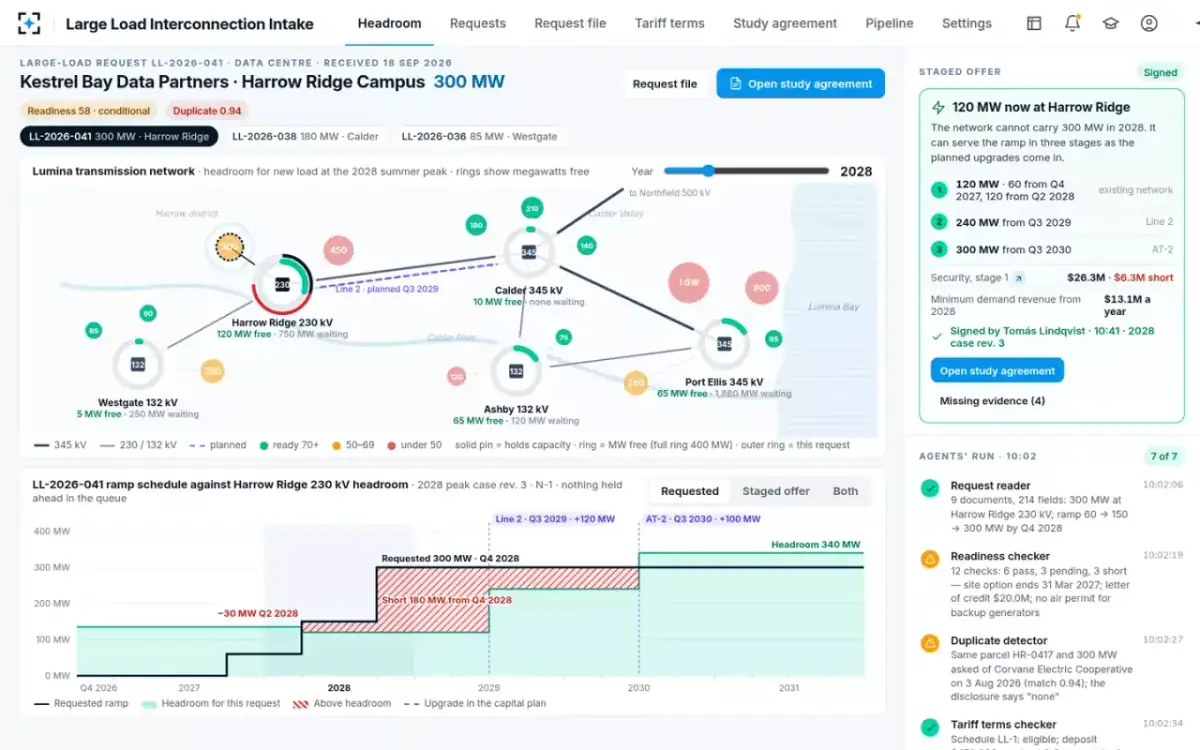

- 08Signed
The planner signs the staged offer

Senior transmission planning engineerThe account manager sends the staged offer to the planner with its basis. That basis is the 2028 summer peak case, rev. 3 (N-1), and the capital plan. A note says the developer asks for 300 MW by Q4 2028 and the substation has 120 MW. The planner signs. The signature does not reserve capacity by itself. Stage 1 is reserved once $26.3M of security is in place.
Only megawatts shown in the planning case go into the offer.

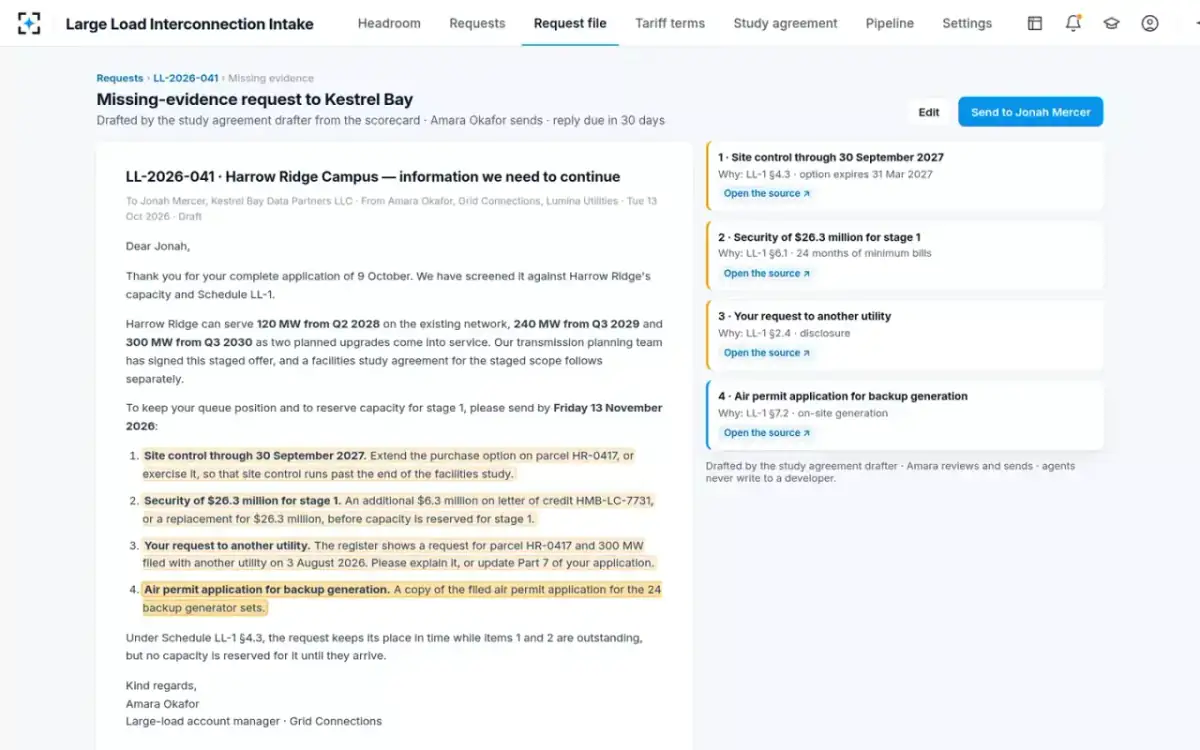

- 09Missing evidence
Four items, each with the clause that asks for it
Large-load account managerThe study agreement drafter has written a letter to the developer's project director. It asks for four items from the short and pending checks. The first is site control through the end of the study. The second is $26.3M of security for stage 1. The developer must also explain the request to another utility and file the air permit application for the backup generators. A reply is due in 30 days. The account manager reviews the letter and sends it.
“Drafted by the study agreement drafter · the account manager reviews and sends · agents do not write to a developer.”
- 10Approved
A study agreement for the staged scope, three signatures in order

Director, grid connectionsThe facilities study agreement is drafted from the utility's template and the signed offer. Each clause that differs from the request is marked. The request for 300 MW by Q4 2028 becomes 120 MW in Q2 2028, 240 MW in Q3 2029 and 300 MW in Q3 2030. Security needed before reservation falls from $65.7M to $26.3M. The planner signed first and the tariff analyst confirmed the terms. Now the director approves.
“This agreement reserves no capacity by itself.”
