- Before
- Chases the utility for a new building while the contractor waits to energize. That meant two reminders and two calls in two weeks. A portal code does not say who has the application or what is wanted.
- Now
- Asks in the portal and gets the seven steps, who holds the step and the expected date. Sees the exact document wanted, and uploads it in the answer.
A missing load schedule, found and fixed inside a connection application
A new building with 214 apartments, 6 shops and 48 EV charging bays comes with a new substation of 2 × 1,500 kVA. The application is in network design. Two weeks ago, the network designer found that the load schedule, the list of what the building will draw, left out the EV bays. Here is what happens today, in the working solution.
A worked example on sample data. Names, IDs and figures on the screens and in this section come from the demo.

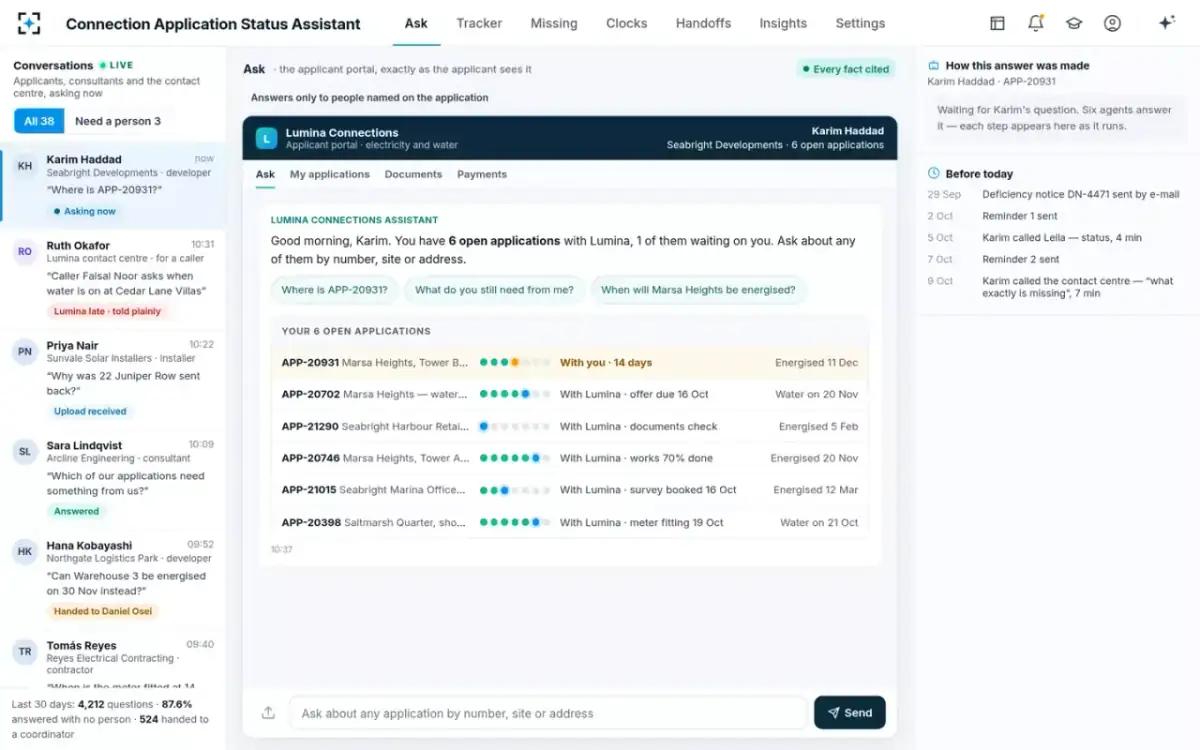

- 01Before today
Two weeks of notices, reminders and calls
Connection coordinatorThe coordinator's screen shows the applicants, consultants and contact center agents asking right now. Each conversation shows its state. It may be answered, upload received, handed to a person, or the utility late and told plainly. For this application the history is a familiar one. A deficiency notice went by email, then two reminders, then two calls from the developer's project manager.
Last week: “The developer called the contact center: ‘what exactly is missing’, 7 min”
- 02Mid-morning

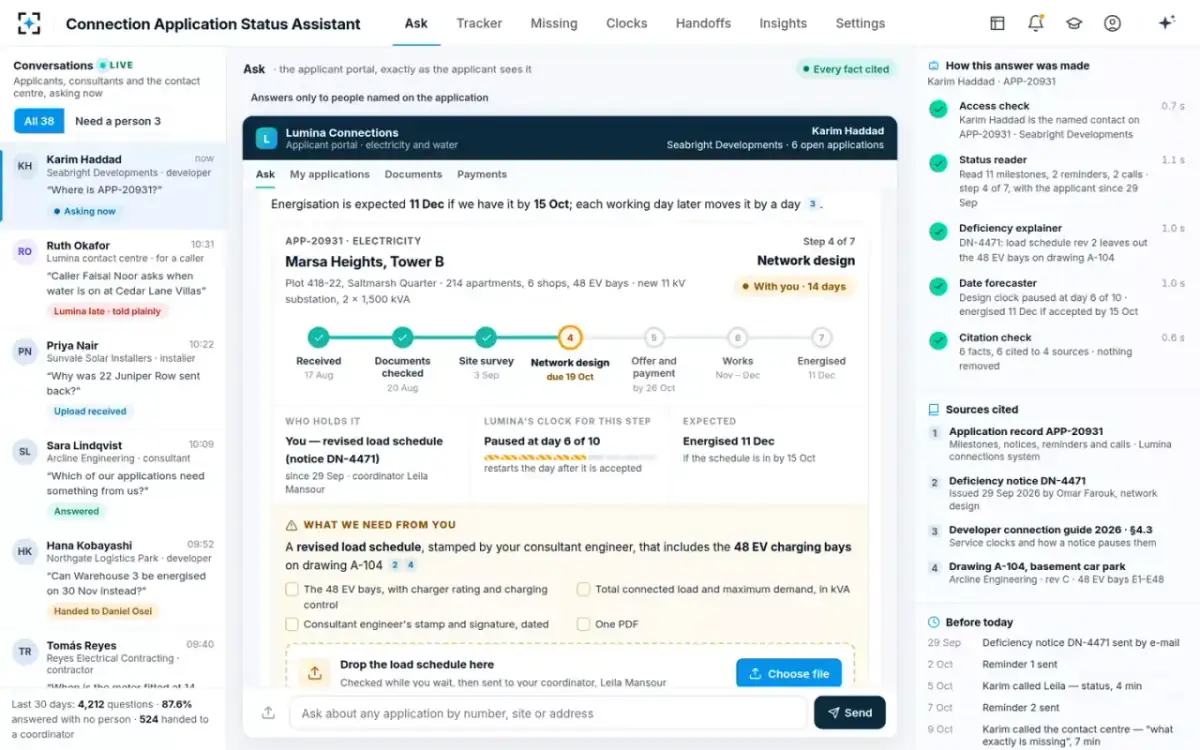

“Where is my application?”, answered as a tracker

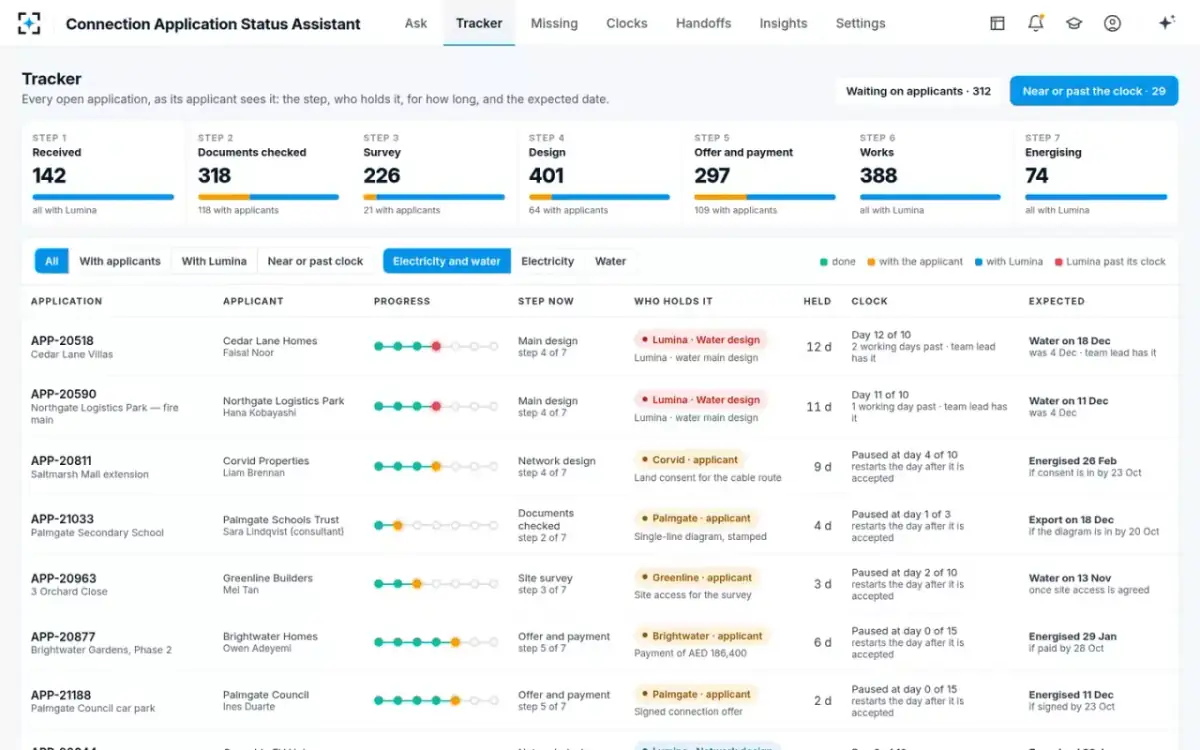

Developer's project managerThe project manager has 6 open applications with the utility, and 1 is waiting on the project manager. Now they ask where the new building is. The answer shows the seven steps with their dates. Received, documents checked and site survey are done, and network design is the step now. The answer also shows who holds the step: “You: revised load schedule”, since the notice went out. The utility's design clock is paused at day 6 of 10.
“Energization is expected on its planned date if we have the schedule within two days. Each working day later moves it by a day.”
- 03In the answer

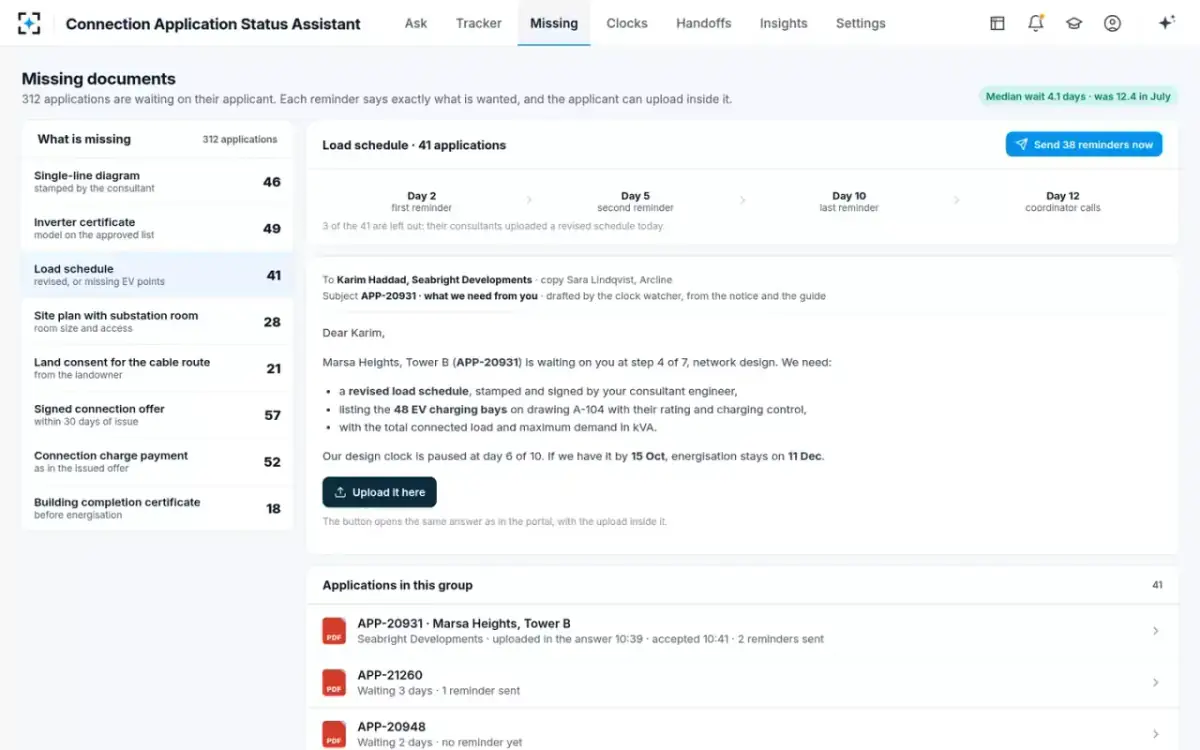

What is missing, from the notice itself

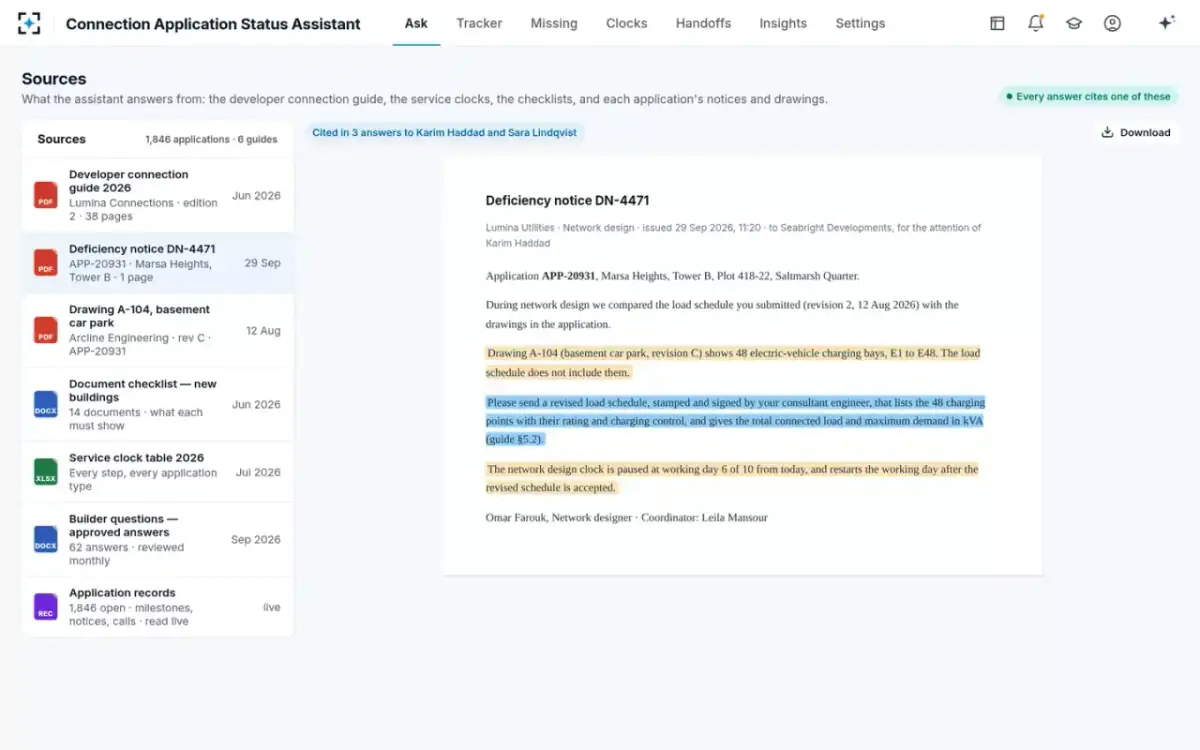

Deficiency explainerUnder the tracker, “What we need from you” leads with the document. It is a revised load schedule, stamped by the consultant engineer, that includes the 48 EV charging bays on drawing A-104. It lists the four things the schedule must show. These are the bays with charger rating and charging control, and the total connected load and maximum demand in kVA. The other two are the stamp and signature, and a single PDF. A citation opens the notice at the passages the answer used. The notice itself points to guide §5.2.
The explainer does not relax or add a requirement. Each item cites the notice or the guide.
- 04A minute later

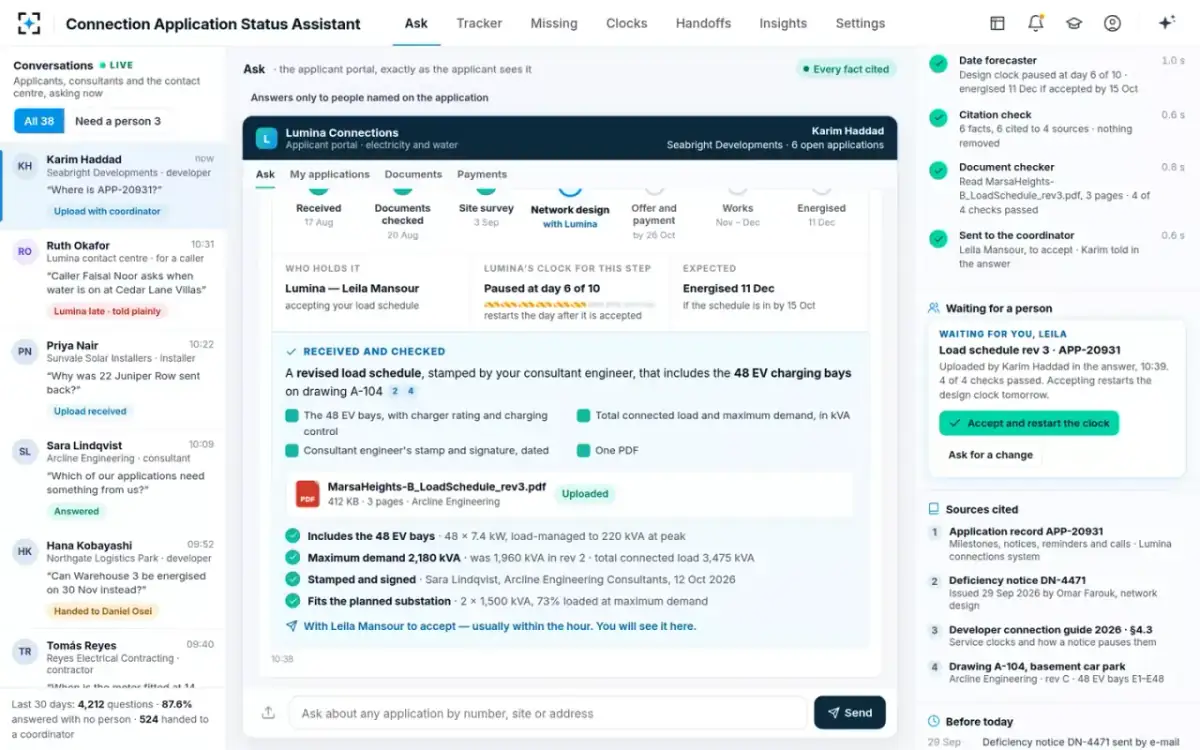

The schedule is uploaded and checked while the developer watches
Document checkerThe project manager drops the revised load schedule, rev 3, a 412 KB PDF, into the answer. Four checks pass on screen. The 48 EV bays are there at 7.4 kW, load-managed to 220 kVA at peak. Maximum demand is 2,180 kVA, up from 1,960 in rev 2. The consultant engineer stamped and signed it the day before. The load also fits the planned 2 × 1,500 kVA substation, at 73% at maximum demand.
“With the coordinator to accept, usually within the hour. You will see it here.”
- 05Two minutes later
Accepted in one click, and the clock restarts

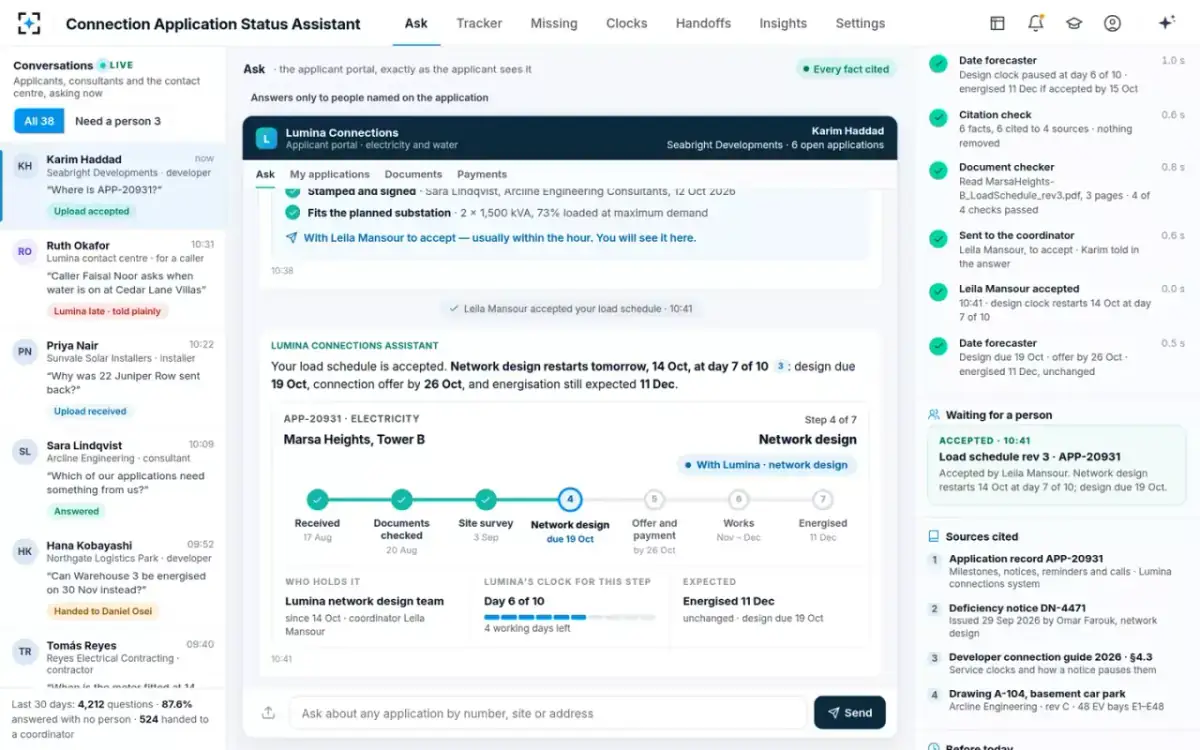

Connection coordinatorOne item reaches the coordinator's queue, load schedule rev 3, with 4 of 4 checks passed. The coordinator accepts it. The assistant tells the developer straight away. Network design restarts tomorrow at day 7 of 10, and the design is due within the week. The connection offer follows a week after that, and energization is still expected on its planned date.
The document checker does not accept a document. The coordinator does.
- 06On the record

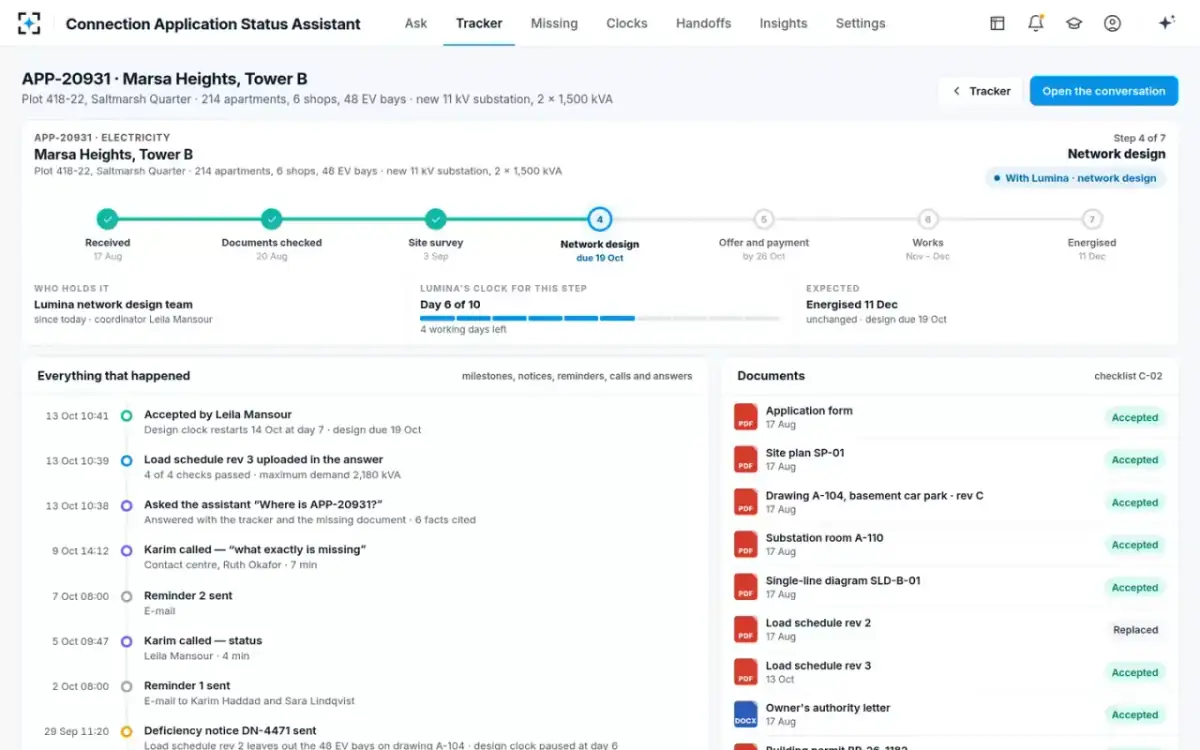

The whole history, on the application
Status readerThe application now carries the whole story in order. It starts with the application, received with 14 documents. Then come the site survey report, the notice, both reminders and both calls. Last come the question, the upload and the acceptance. The documents list marks load schedule rev 2 as replaced and rev 3 as accepted. The step's clock shows day 6 of 10, with 4 working days left.
Questions since the notice: 2 phone calls, 11 min of coordinator and agent time · 1 email · 1 question to the assistant.
- 07Earlier that morning

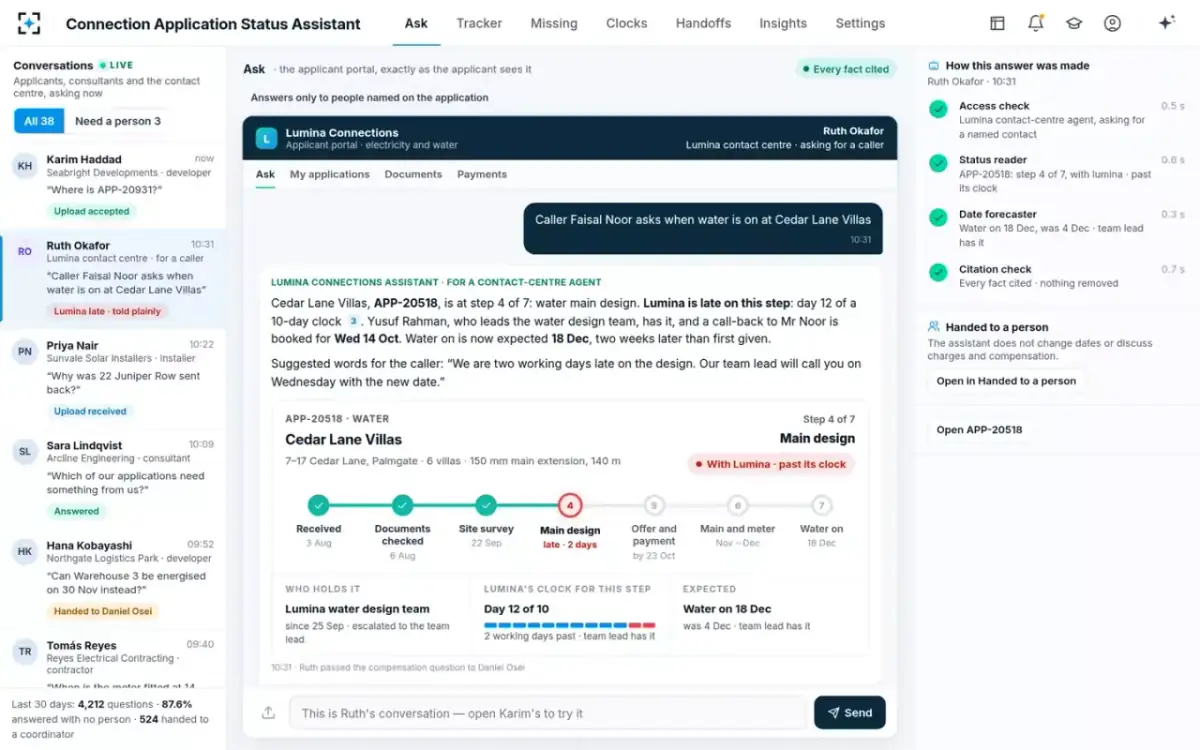

A caller asks, and the late step is said plainly
Contact center agentA builder calls about water for a housing development. The contact center agent sees the same tracker the applicant would. The application is at step 4 of 7, water main design, on day 12 of a 10-day clock. The water design team lead has it, and a call-back is booked for tomorrow. Water on is now expected two weeks later than first given.
Suggested words for the caller: “We are two working days late on the design. Our team lead will call you tomorrow with the new date.”
- 08Before the clock

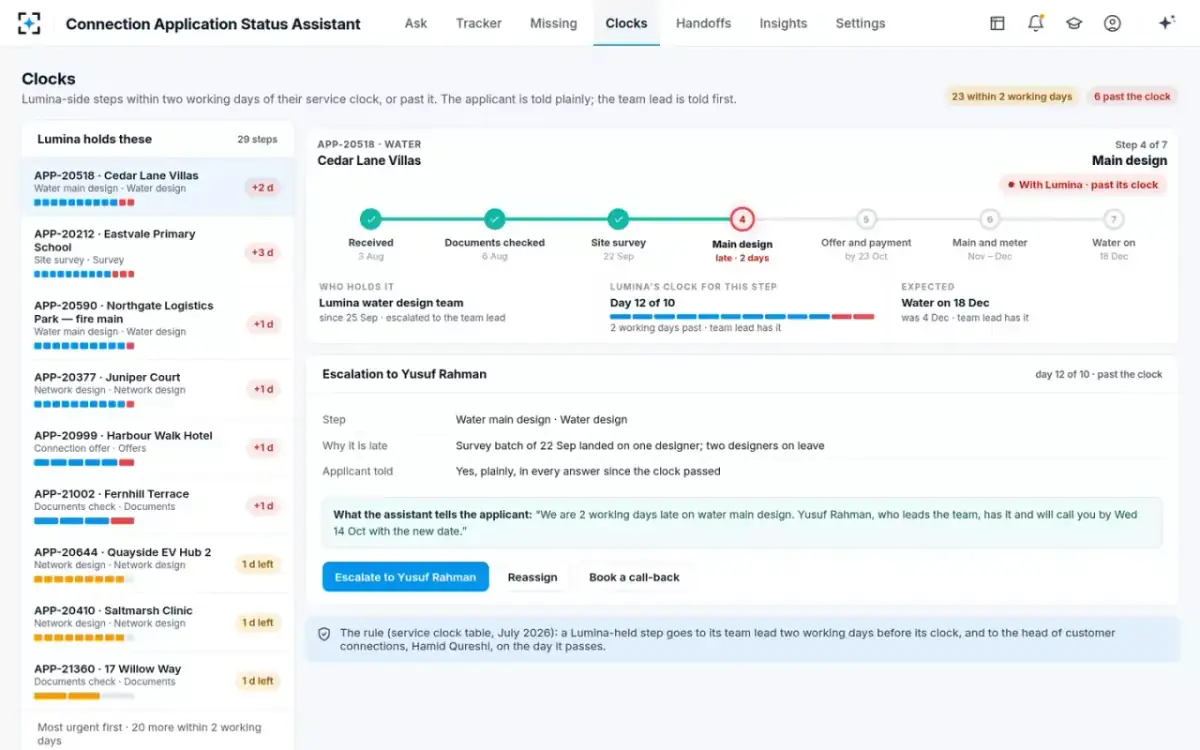

The utility's own delays go to the team lead first
Clock watcherClocks lists the 29 utility-held steps that are within two working days of their service clock or past it. Of those, 23 are near and 6 are past. For the housing development, the escalation to the water design team lead gives the reason. One survey batch landed on one designer, while two designers were on leave. It also confirms the applicant has been told in each answer since the clock passed.

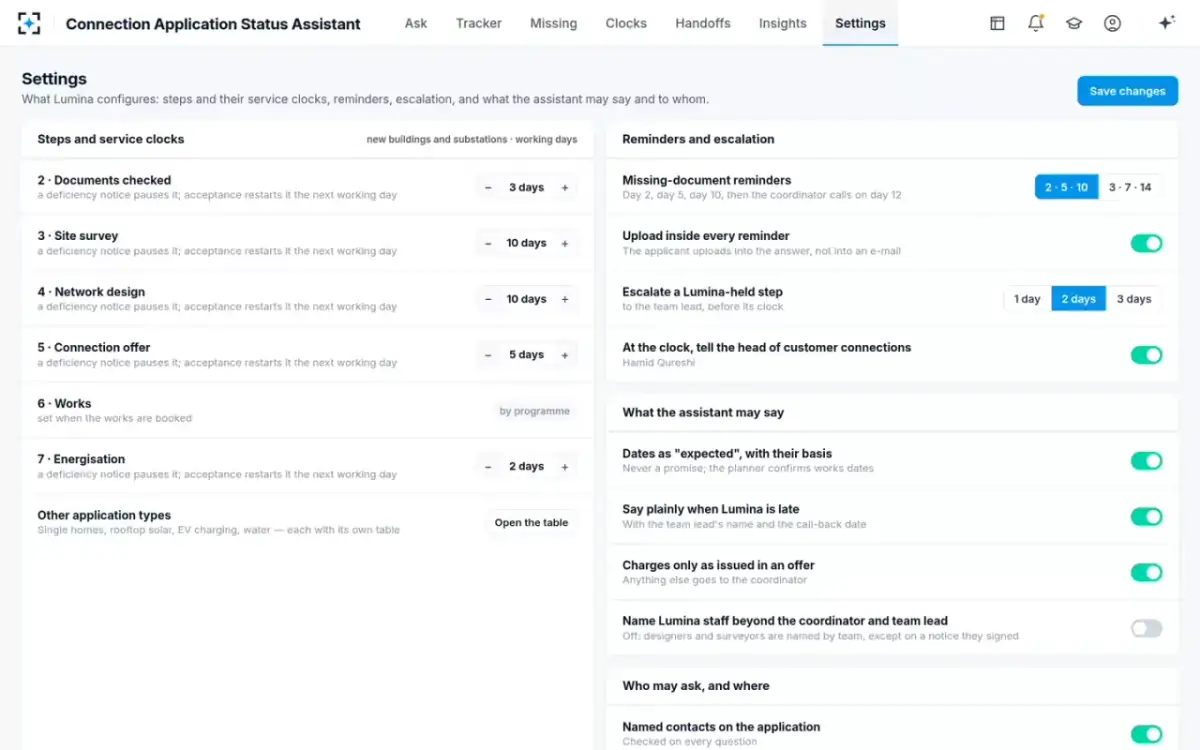

A utility-held step goes to its team lead two working days before its clock. It goes to the head of customer connections on the day it passes.
- 09Earlier that morning
A date change goes to a person, with the facts

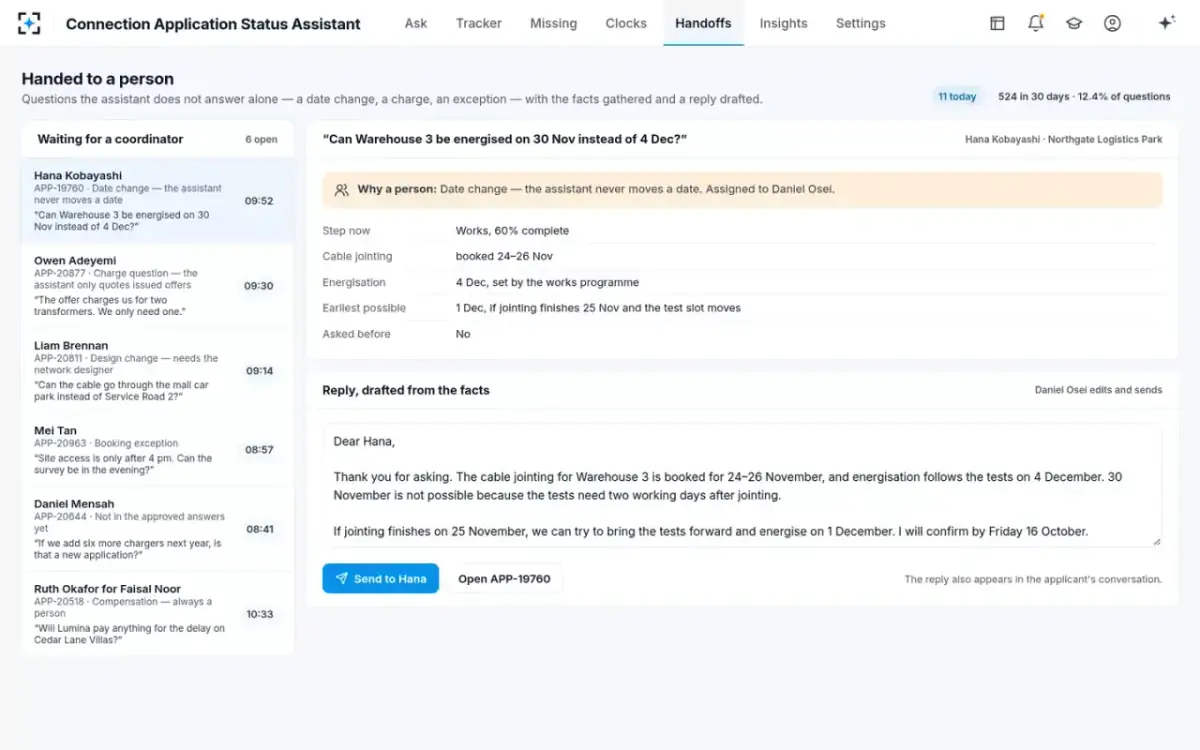

Connection coordinatorA logistics park developer asks whether a warehouse can be energized four days earlier than planned. The assistant does not move dates. So it gathers the facts and hands the question to a coordinator. The works are 60% complete, and cable jointing is booked the week before. The earliest possible date is three days earlier than planned. A reply is drafted for the coordinator to edit and send.
Date changes, charges, exceptions and compensation go to a person.
- 10Across the queue

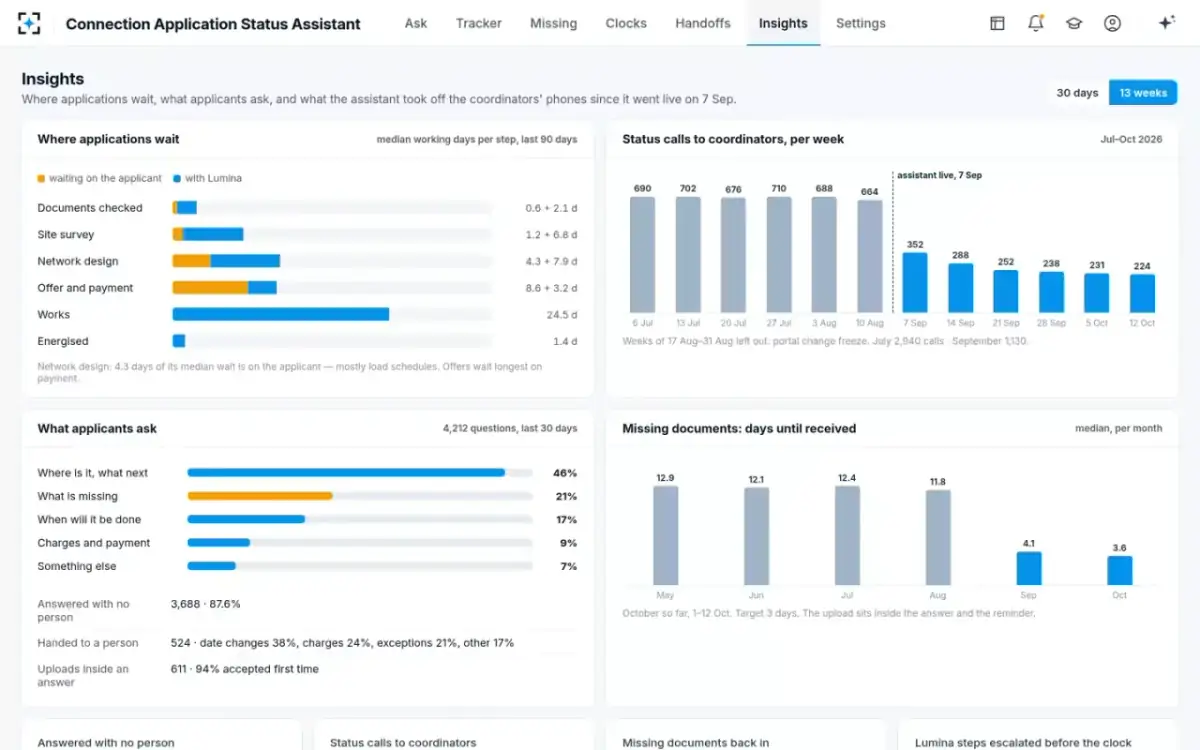

38 reminders that say exactly what is wanted
Connection coordinatorIn all, 312 applications are waiting on their applicant, grouped by what is missing. Of these, 41 are missing a load schedule. Three of those are left out because their consultants uploaded a revised schedule today. The clock watcher drafts each reminder from the notice and the guide. Each one names the items wanted, the paused clock and the date at stake, with the upload inside it.
Reminder cadence: day 2, day 5, day 10, then the coordinator calls on day 12.
