A supplier's 97.8% report, measured again and claimed in time
The utility runs power and water networks. A civil works contractor holds its water network repair and maintenance contract, worth $3,800,000 a month. The contractor must reach Priority 1 bursts and leaks within 2 hours in 98% of cases. Its September report arrived five days ago. Here is what happens next, screen by screen, in the working solution.
A worked example on sample data. Names, IDs and figures on the screens and in this section come from the demo.
- 0106:00 sweep

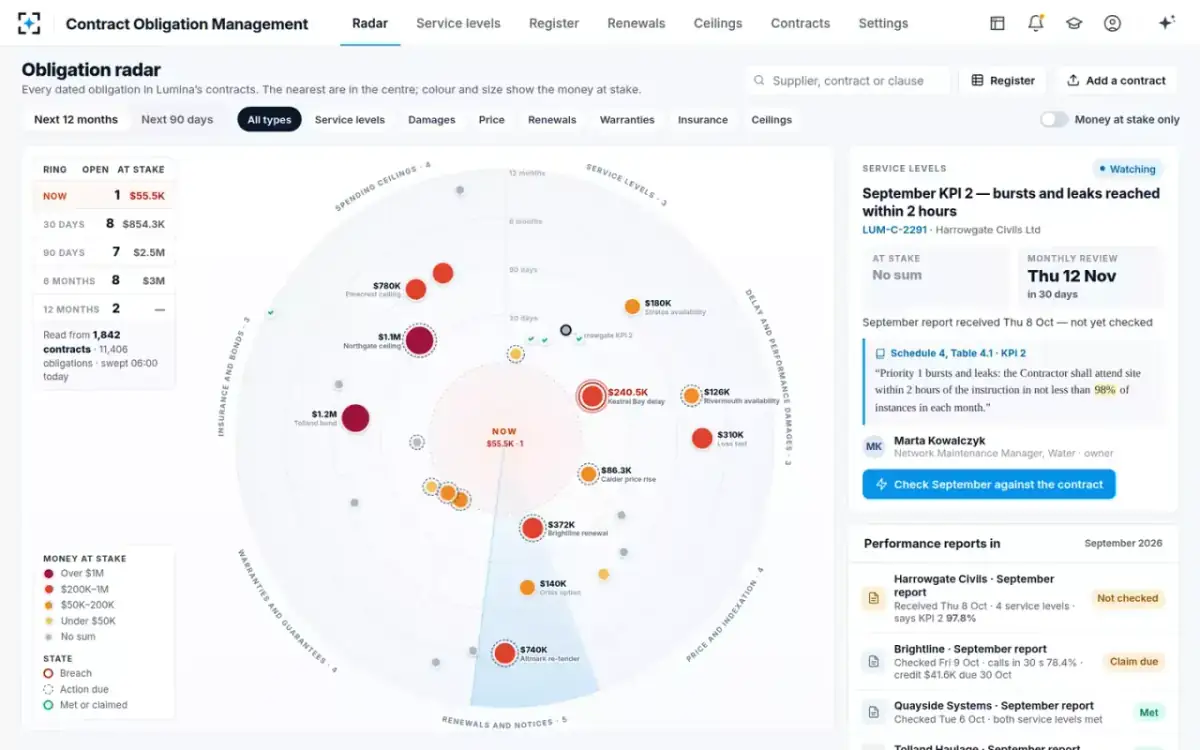

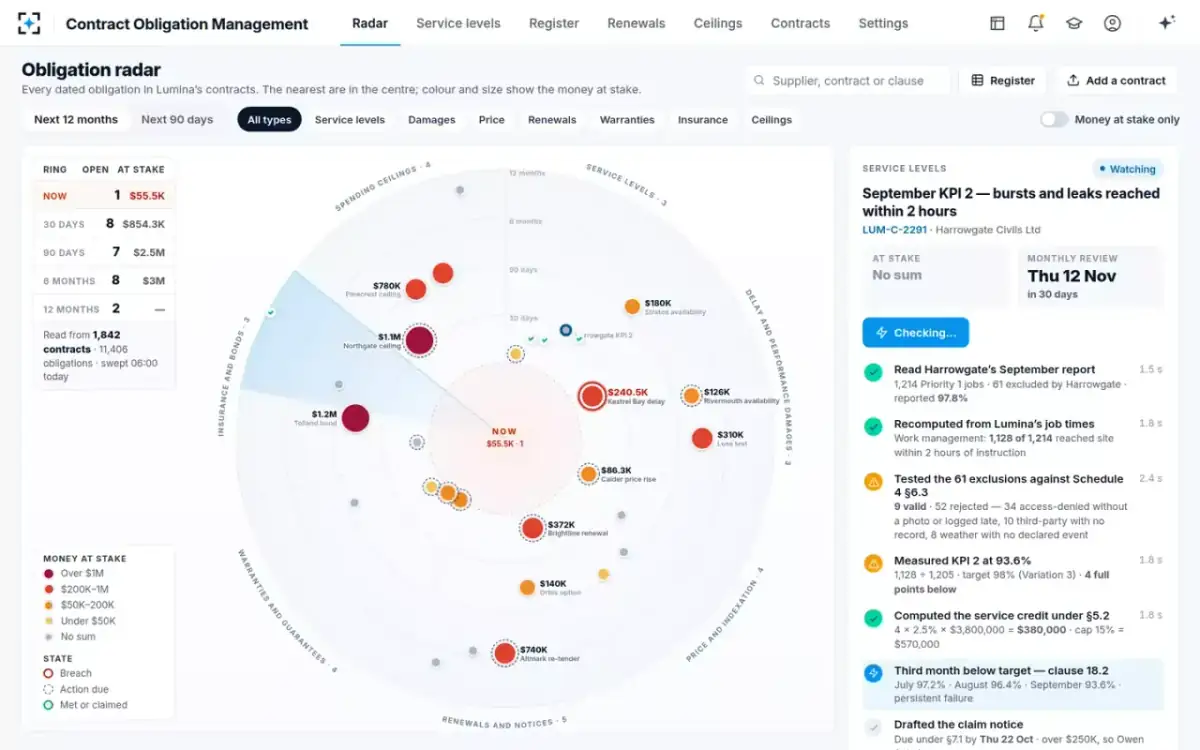

The day opens on a radar of dates instead of a list
Senior contract managerThe contract manager runs 140 contracts. The radar is built from the utility's whole set of contracts, updated at 06:00. The rings show time: Now, 30 days, 90 days, 6 months and 12 months. Seven sectors show the types of obligation. Each dot's color and size show the money at stake. They include a substation project's delay damages at $240.5K, the call-center renewal at $372K and a $1.2M bond. The repair contract's KPI 2 sits in the 30-day ring as “Watching”. Its report has arrived but is not yet checked.
Each dated obligation in the utility's contracts. The nearest are in the center. Color and size show the money at stake.
- 02One click
September, measured again from the utility's own job times
SLA performance trackerThe contract manager clicks “Check September against the contract”. The tracker reads the contractor's report. It lists 1,214 Priority 1 jobs, with 61 excluded by the contractor and 97.8% reported. Then the tracker works out the figure again from the instruction and arrival times in work management. It finds that 1,128 of 1,214 jobs reached site within 2 hours. Each step appears in the side panel as it runs.
Schedule 4, Table 4.1 · KPI 2. “The Contractor shall attend site within 2 hours of the instruction in not less than 98% of instances in each month.”

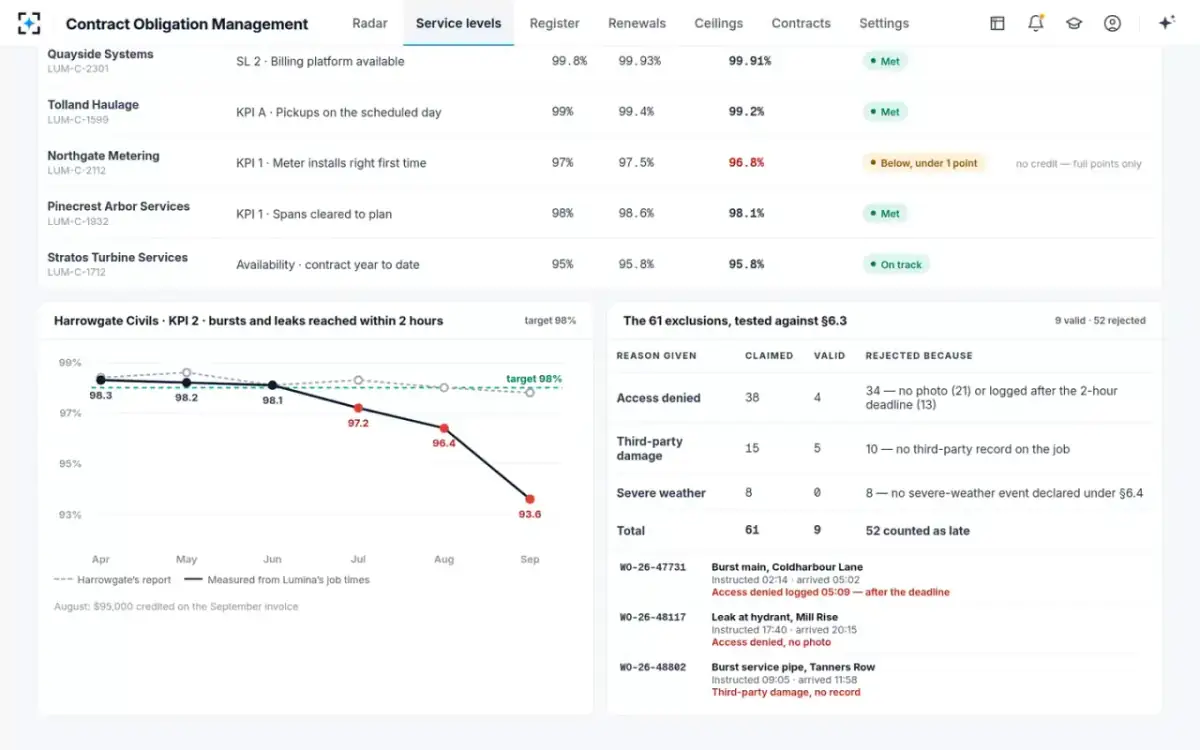

- 03The exclusions
Each of 61 excluded jobs checked against §6.3
SLA performance trackerA job may be excluded only if an access-denied or third-party record, with a photo, is logged before the 2-hour deadline. Only 9 of the 61 pass. Of the rest, 34 access-denied claims had no photo or were logged too late. Another 10 third-party claims had no record on the job, and 8 weather claims had no severe-weather event declared under §6.4. One burst main job was sent to the contractor at 02:14 and reached at 05:02. Access denied was logged at 05:09.
Limit: the tracker works out a supplier's figure again before it accepts it. It only reads the source systems.
- 0493.6%

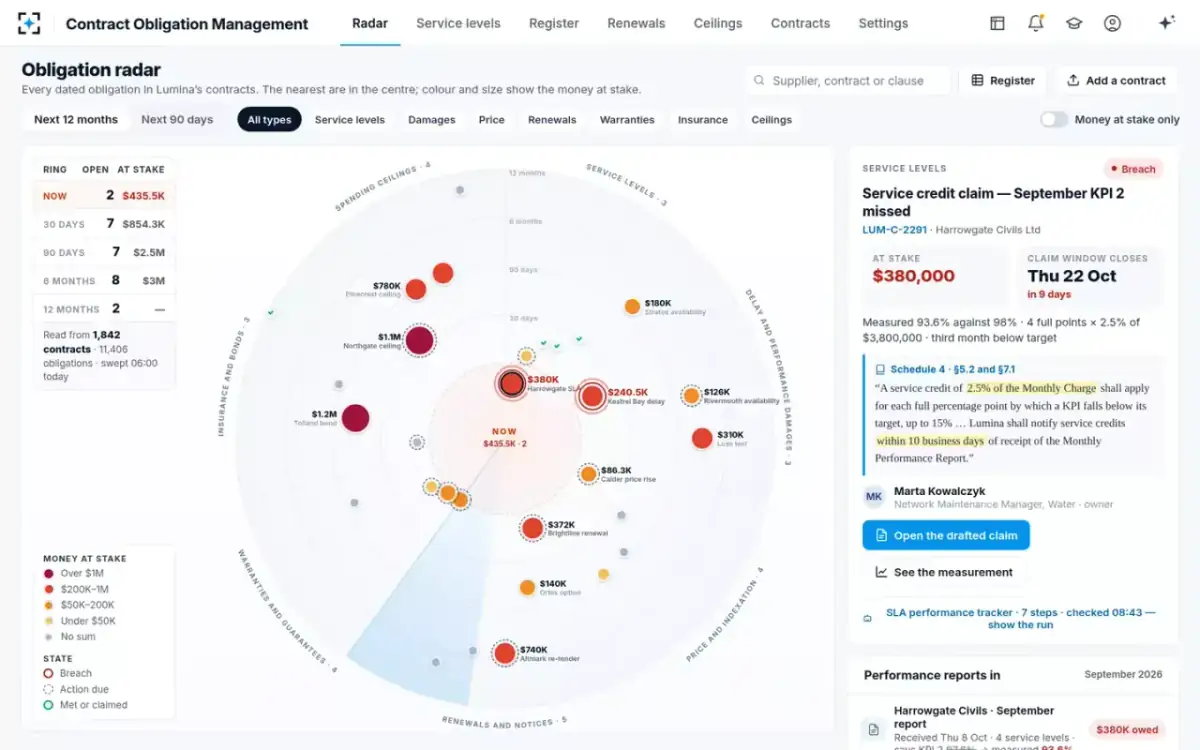

The breach moves to the center of the radar
Claim drafterThe measured figure is 1,128 of 1,205 qualifying jobs, or 93.6%. That is 4 full points below the 98% target set by Variation 3, a later change to the contract. Under §5.2 the credit is 2.5% of $3,800,000 for each of the 4 points. That is $380,000, inside the 15% cap of $570,000. July was 97.2% and August 96.4%. So September is the third month below target, and clause 18.2 applies. The dot turns red, grows and moves into the Now ring, which rises to 2 open items and $435.5K.
“Breach found · $380,000 claim drafted · window closes in nine days”
- 05The claim

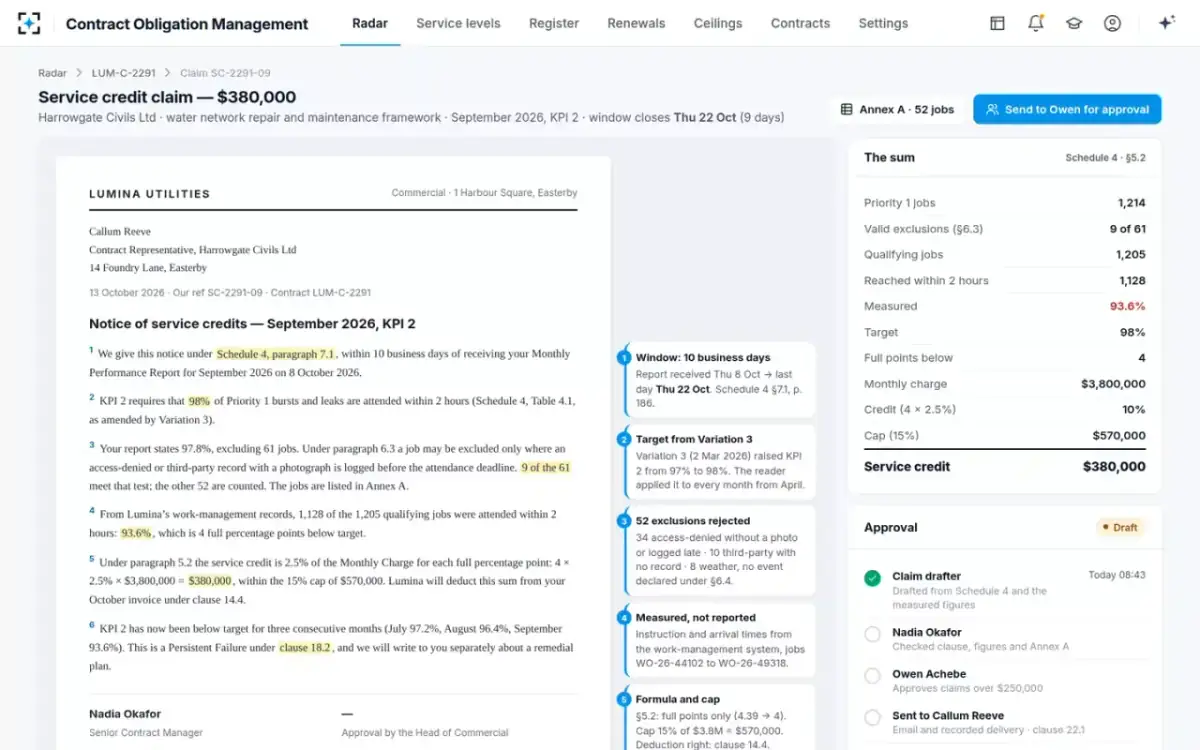

A notice on paper, each sentence tied to its clause
Claim drafterThe claim drafter writes the notice of service credits to the contractor's contract representative. Notes beside each paragraph show the 10-business-day window under §7.1 and the target from Variation 3. They also show the 52 rejected exclusions, the measurement from the month's jobs, and the formula and cap. Only full points count, so 4.39 becomes 4. The sum panel shows the working line by line, and Annex A lists the 52 jobs.
Limit: the claim drafter does not send, and a person signs. It does not claim past a cap, and it cites the clause for each figure.

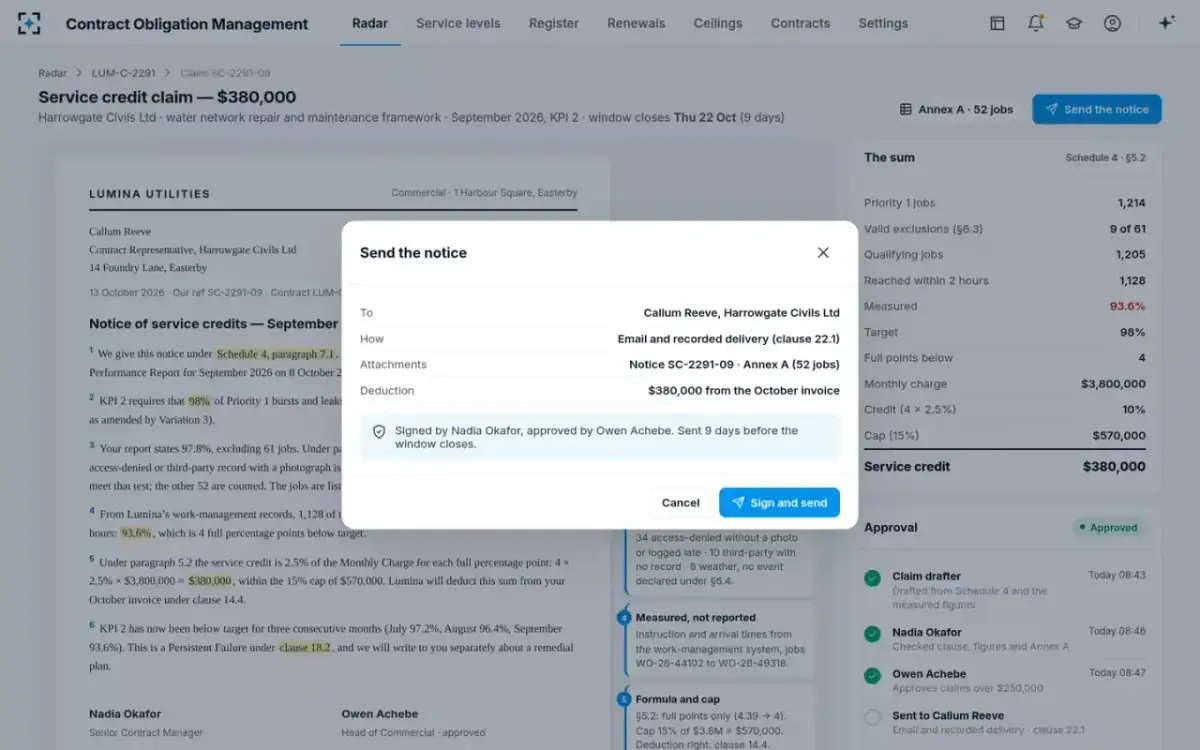

- 06Approved and sent
Over $250,000, so the head of commercial approves first
Head of commercialThe contract manager checks the clause, the figures and Annex A. The claim is over $250,000, so it goes for approval. The head of commercial approves: “Clause and sums agree. Approved.” The contract manager signs and sends it by email and recorded delivery, as clause 22.1 requires, with the notice and Annex A attached. Accounts payable is told to take $380,000 off the October invoice under clause 14.4.
Signed by the contract manager and approved by the head of commercial. Sent 9 days before the window closes.
- 07Same month, each supplier

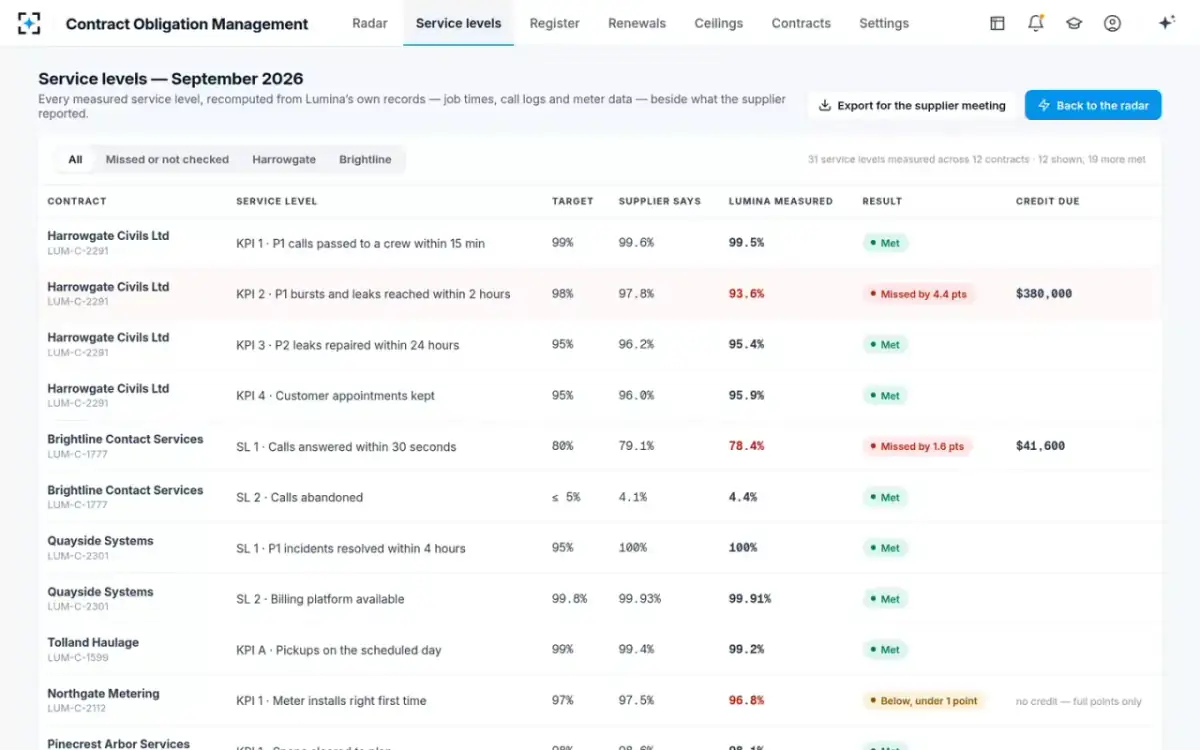

31 service levels, the supplier's figure beside the utility's
SLA performance trackerThe Service levels screen shows each measured KPI for September across 12 contracts. The call-center supplier reported 79.1% of calls answered within 30 seconds. The utility's own call logs say 78.4% against an 80% target. That misses by 1.6 points, so $41,600 is due. The meter installer got 96.8% of jobs right the first time, against a 97% target. That is below target but by less than 1 point, so no credit is due. Only full points count.
Each measured service level, worked out again from the utility's own job times, call logs and meter data, beside what the supplier reported.
- 08Behind each obligation

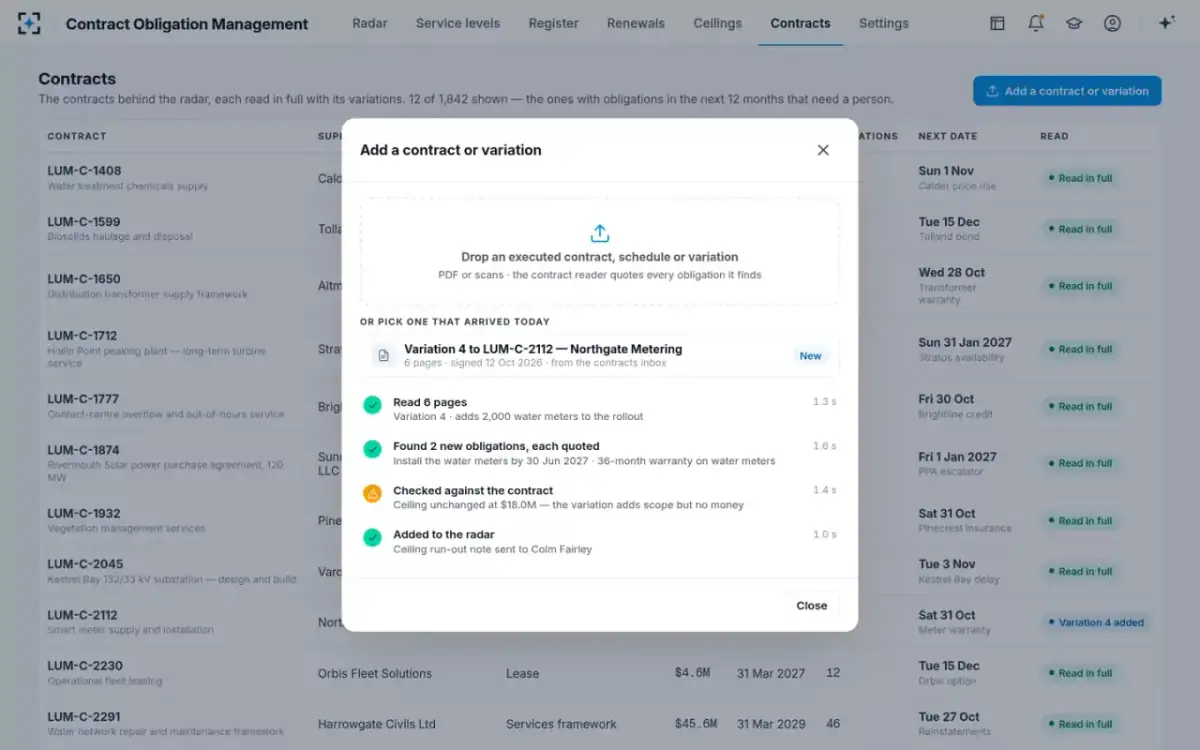

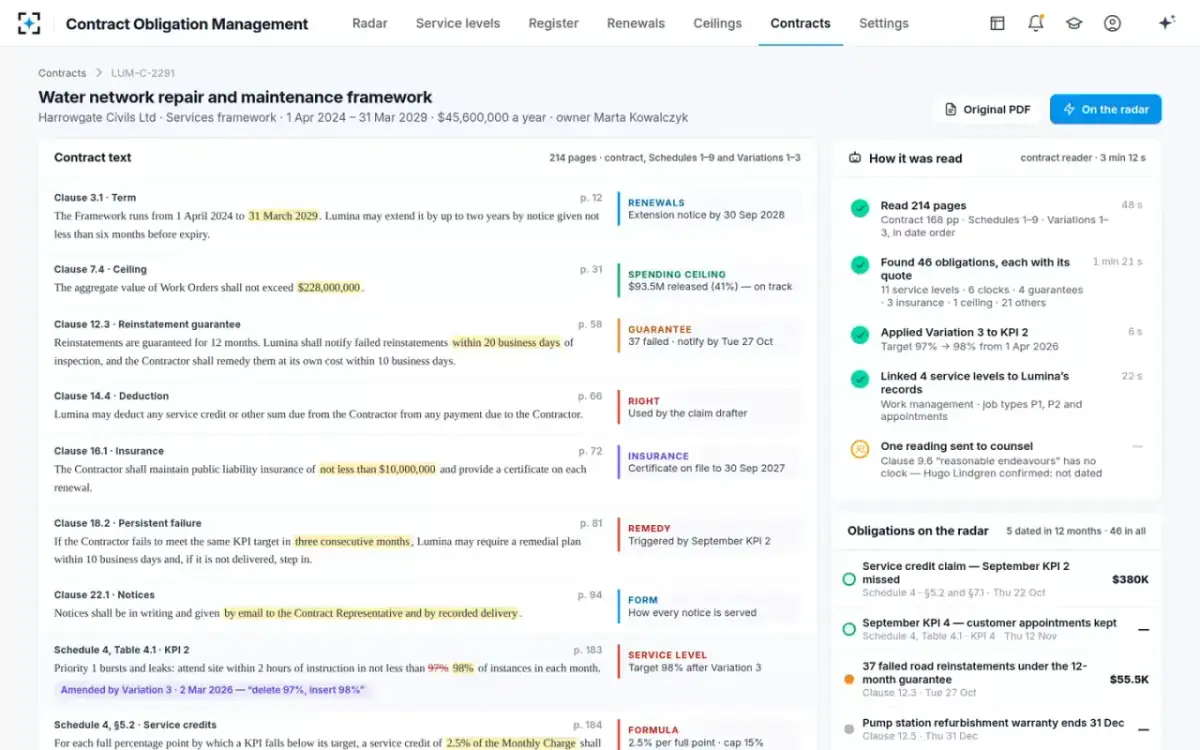

214 pages read, 46 obligations, each with its quote
Contract readerOpen the repair contract, and each obligation is highlighted in the text with a note. They include the term and extension notice, the $228,000,000 spending limit and the 12-month guarantee on road repairs. Others are the right to deduct, the insurance clause, repeated failure and the notices clause. The reader took 3 min 12 s for 214 pages. It applied Variation 3 to KPI 2, which raised it from 97% to 98% from April. It linked 4 service levels to the utility's records.
Sent to counsel: clause 9.6 says “reasonable endeavours” with no deadline, and counsel confirmed it has no date.

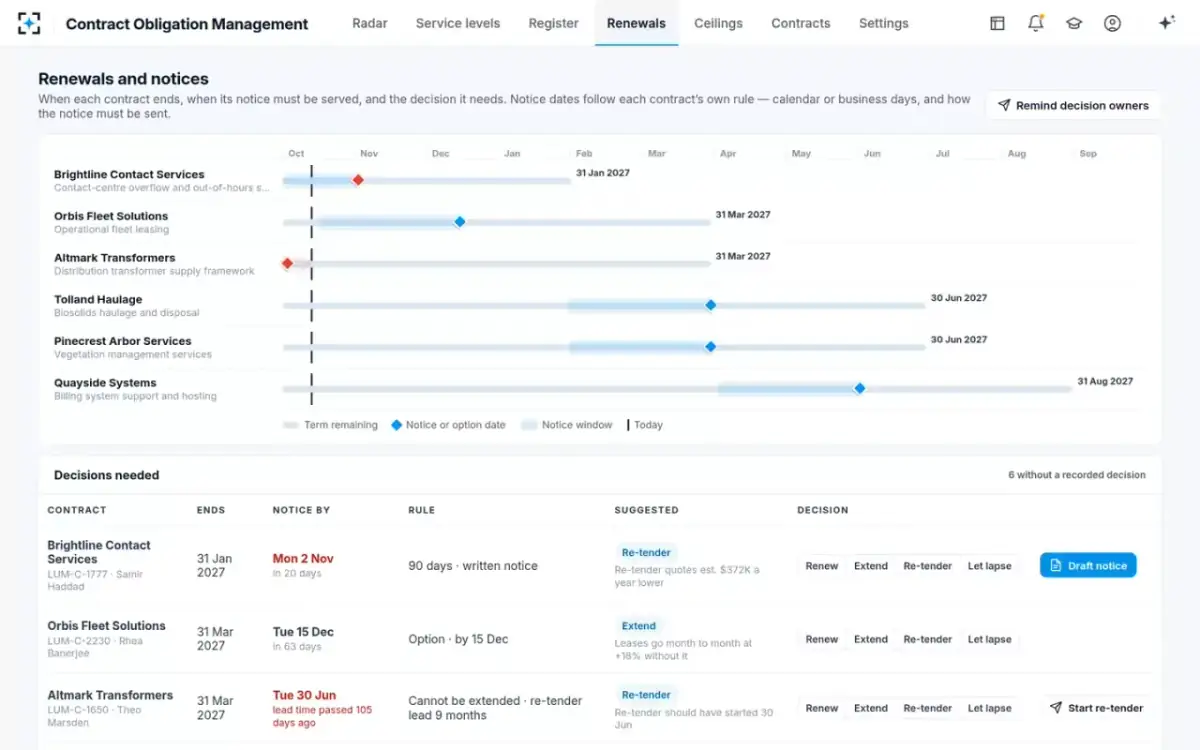

- 09Before the notice date
Renew, extend, re-tender or let lapse, decided in time
Category managerThe call-center contract renews itself in the new year unless written notice goes out within three weeks. Quotes from other suppliers are about $372K a year lower. The fleet leases go month to month at +18% unless the option is used within two months. The transformer contract cannot be extended, and its 9-month lead time for a new tender passed 105 days ago. The watcher drafts the notice to end the call-center contract, and the category manager decides.
The category manager decides. Nothing is served until the decision is recorded and the contract manager signs.

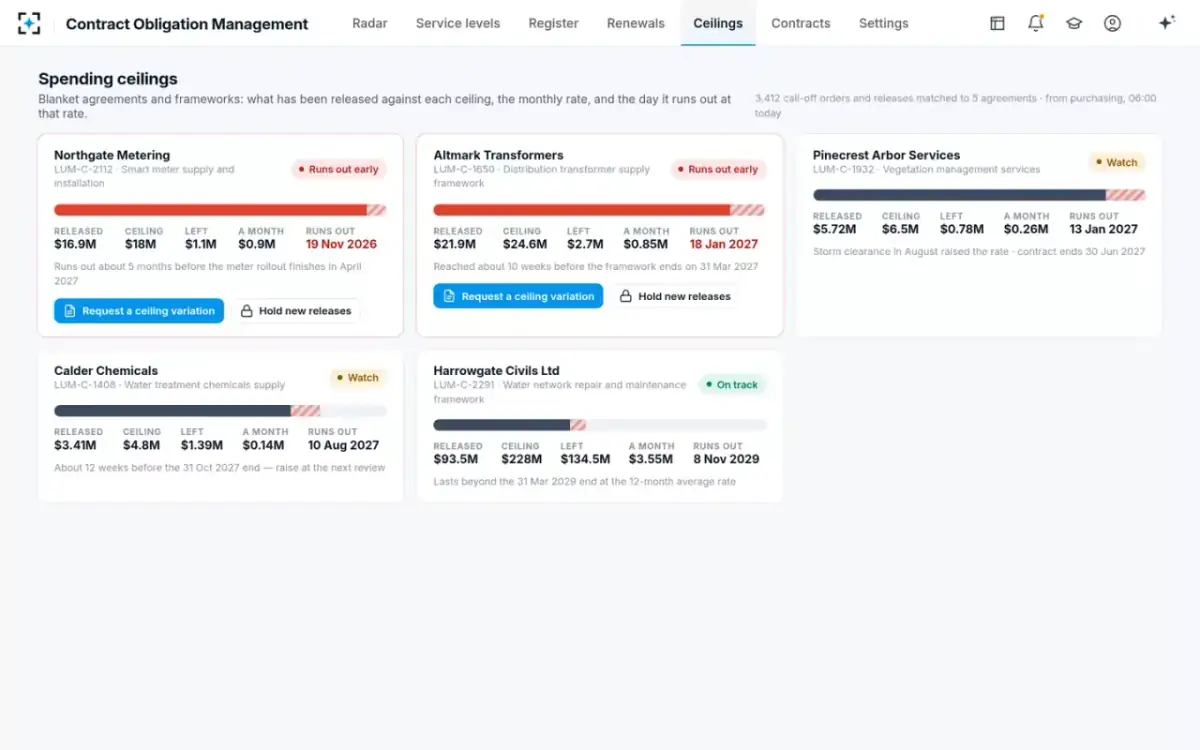

- 10Ceilings
The blanket agreement that runs out before the rollout ends
Spend and ceiling monitorAt 06:00 the monitor matched 3,412 call-off orders and releases from purchasing to 5 blanket agreements. The smart meter agreement has $16.9M ordered against an $18M limit, at $0.9M a month. So it runs out next month, about 5 months before the meter rollout finishes. The contract manager can ask for a higher limit or pause new orders.
Limit: the monitor never raises or cancels an order.
