- Before
- Owns the three-year plan, with 214 requests and one budget. The board paper and the rate filing are weeks apart. Ranking the projects is possible. The hard part is showing the regulator why one sits just below the line and the next just above it.
- Now
- Moves one budget line and sees which projects make the cut, the risk left on the network and the bill impact. Each project's risk is traced to its records.
214 requests, a $1.2B budget and the CFO's question about $1.0B
The sample utility runs an electricity and water network. Its three-year plan has 214 candidate projects. Together they ask for $2,310.0M, against a $1.2B budget set by the board. The board paper and the rate filing are both weeks away. Early in the week, the CFO asks what a $1.0B budget would give up. Here is what happens next, screen by screen, in the working solution.
A worked example on sample data. Names, IDs and figures on the screens and in this section come from the demo.
- 01Tuesday morning

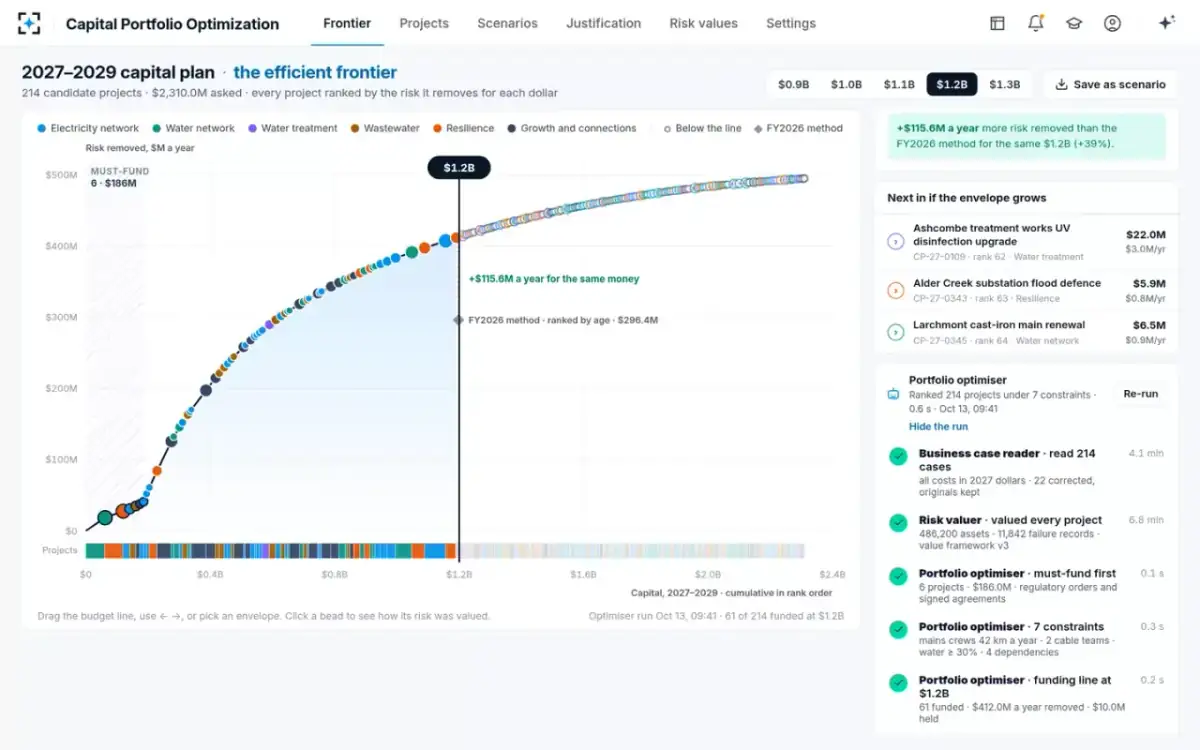

The plan opens on one curve, the efficient frontier

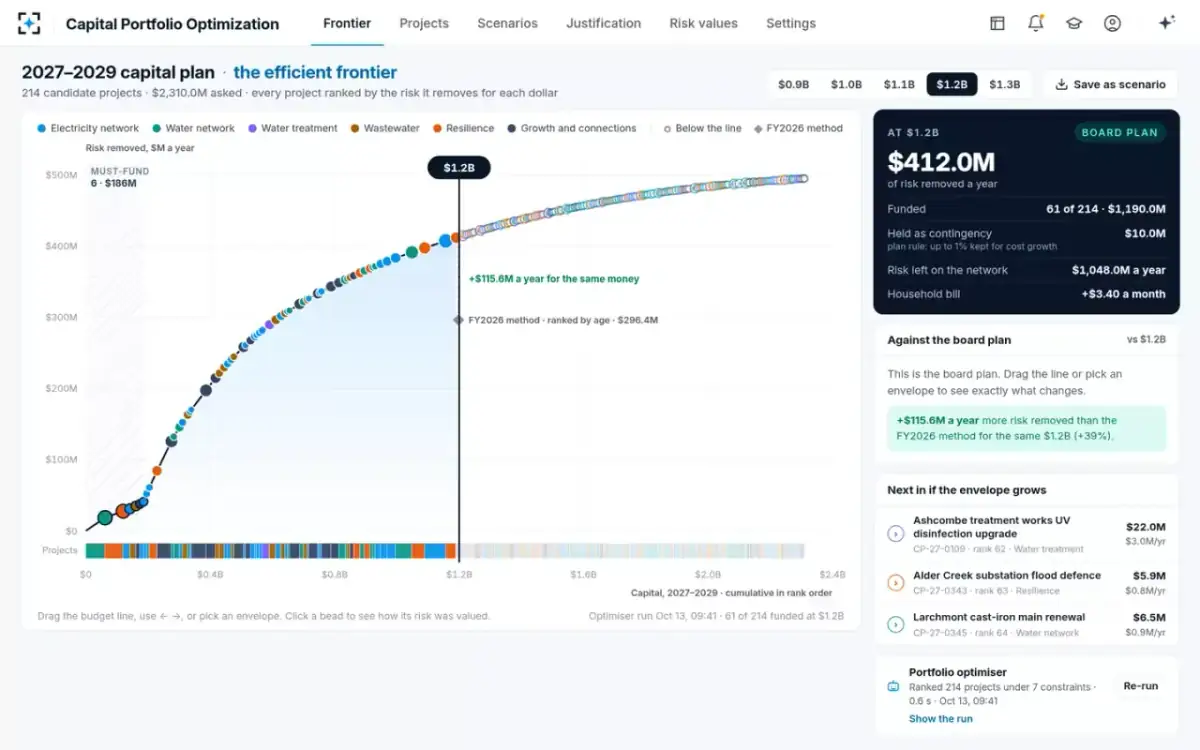

Head of capital planningThe plan opens on one curve, called the efficient frontier. Each project is a bead on it. The curve plots risk removed each year against total capital, with projects in order of risk removed per dollar. At the $1.2B budget line, 61 of 214 projects are funded for $1,190.0M. They remove $412.0M a year of risk, priced in dollars. The remaining $10.0M is held as contingency, and the household bill rises $3.40 a month. The six must-fund projects, $186M, sit shaded at the start. Last cycle's method, ranking by age, removes $296.4M, well below the curve.
On the frontier: “+$115.6M a year more risk removed than last cycle's method for the same $1.2B (+39%).”
- 02The run
214 cases read, valued and ranked under 7 constraints
Business case reader, Risk valuer and Portfolio optimiserThe run log shows each step. The Business case reader read 214 cases in 4.1 minutes. It put each cost in the plan's base-year dollars. The Risk valuer priced each project from the asset register, the failure records and value framework v3. The Portfolio optimiser funded the six must-fund projects first. It ranked the rest within the mains crews' 42 km a year, two cable jointing teams, a 30% floor for water work and four dependencies.
Portfolio optimiser: “Ranked 214 projects under 7 constraints · 0.6 s”. It does not drop a must-fund project or break a dependency.

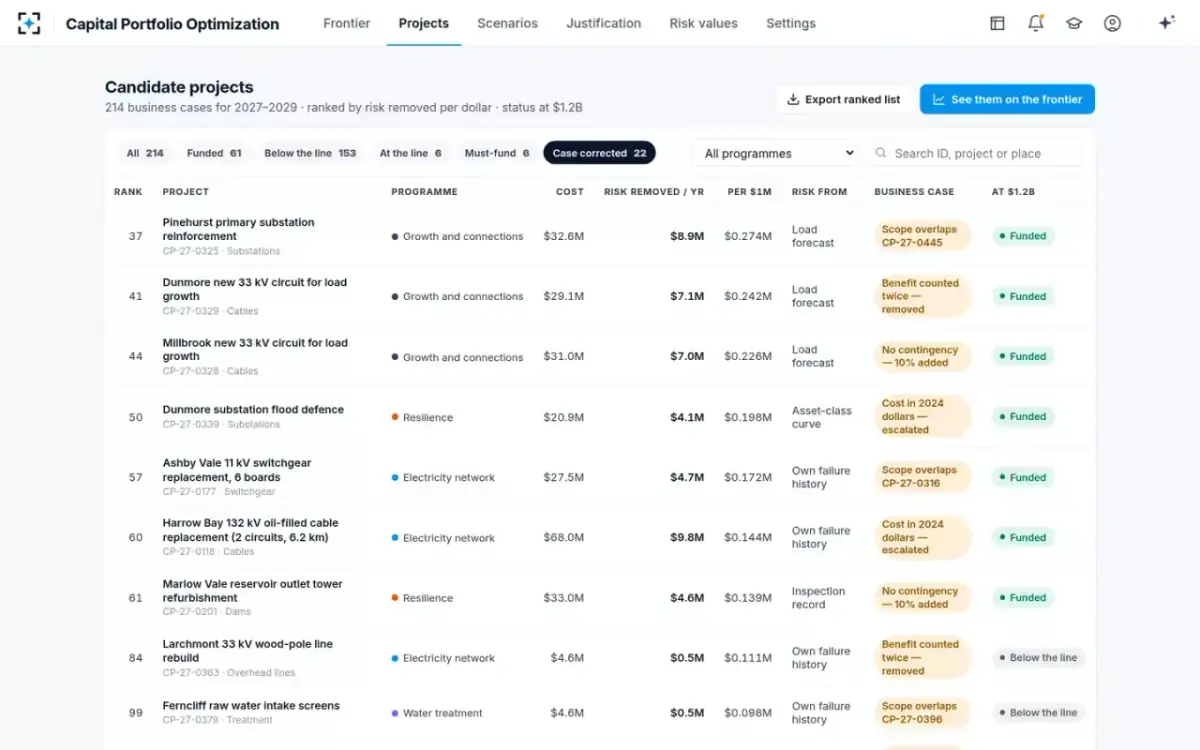

- 03Before ranking
22 business cases corrected, each original kept
Business case readerThe Case corrected filter lists the 22 cases the reader fixed. Some were priced in older dollars and were brought up to date. Others counted a benefit twice, and the extra count was removed. Where contingency was missing, 10% was added. Cases whose scope overlaps another candidate are flagged too. Each correction sits beside the engineer's original figure. The reader flags problems and never rejects a case.
“Shows the original beside every correction”

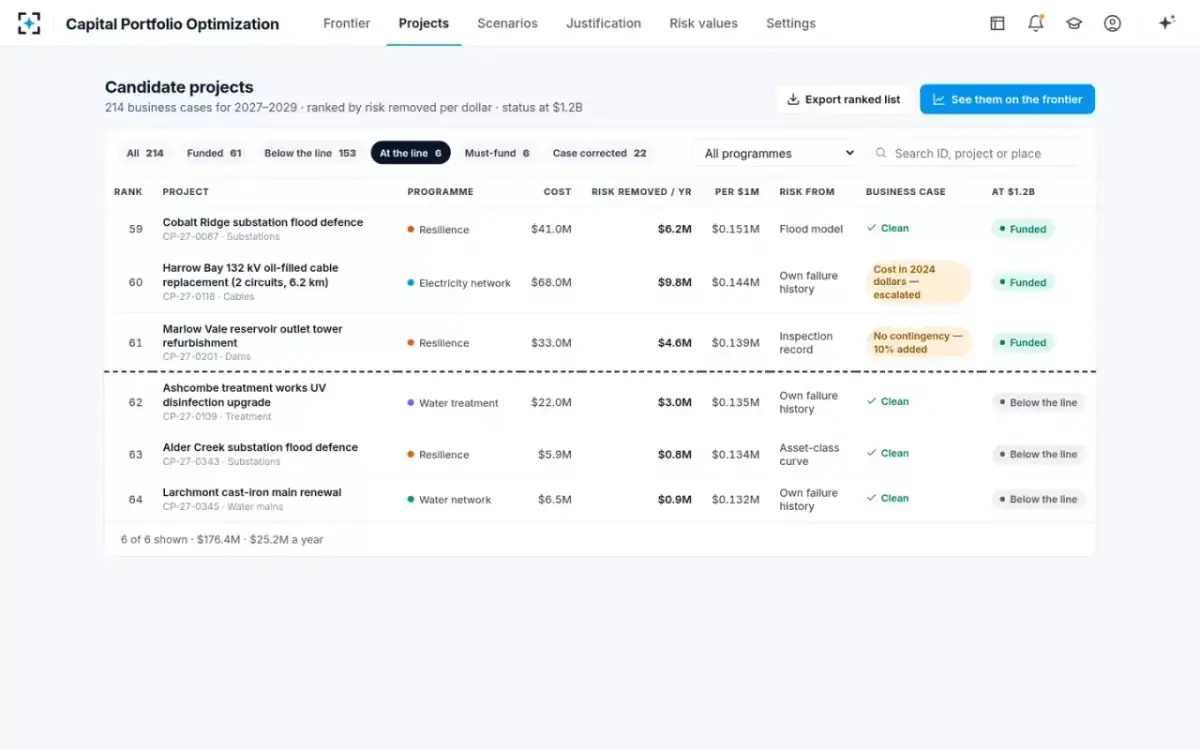

- 04At the line

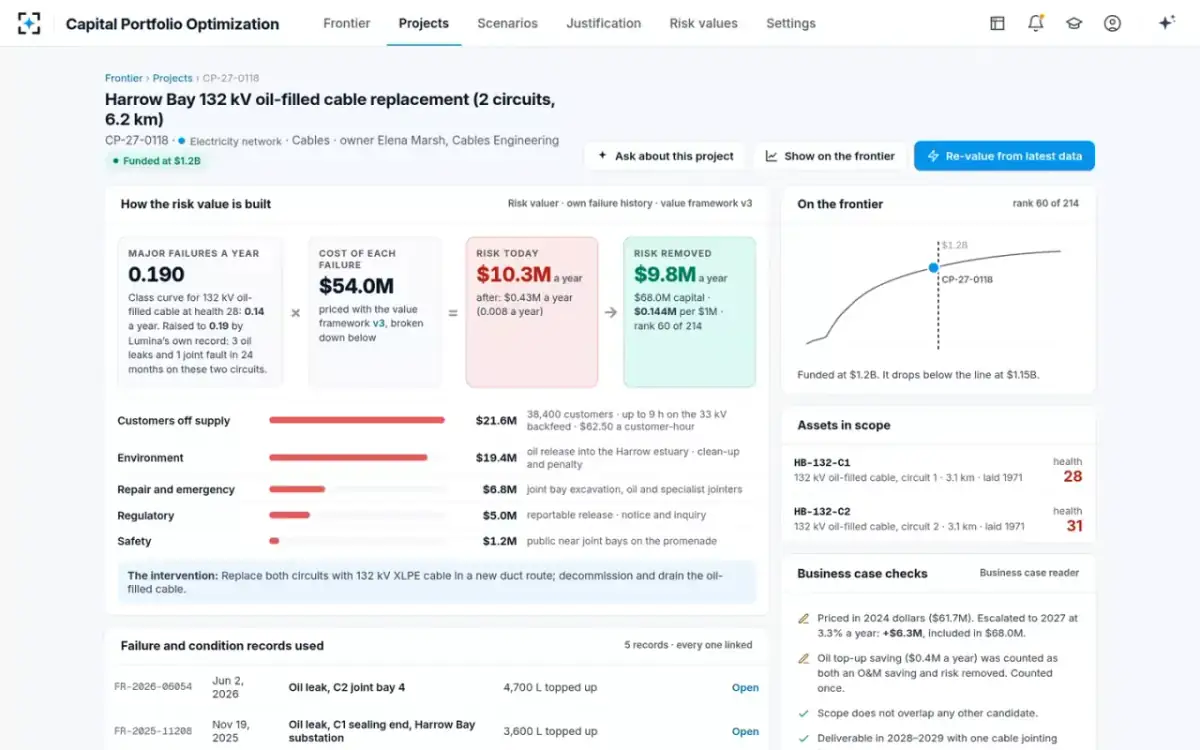

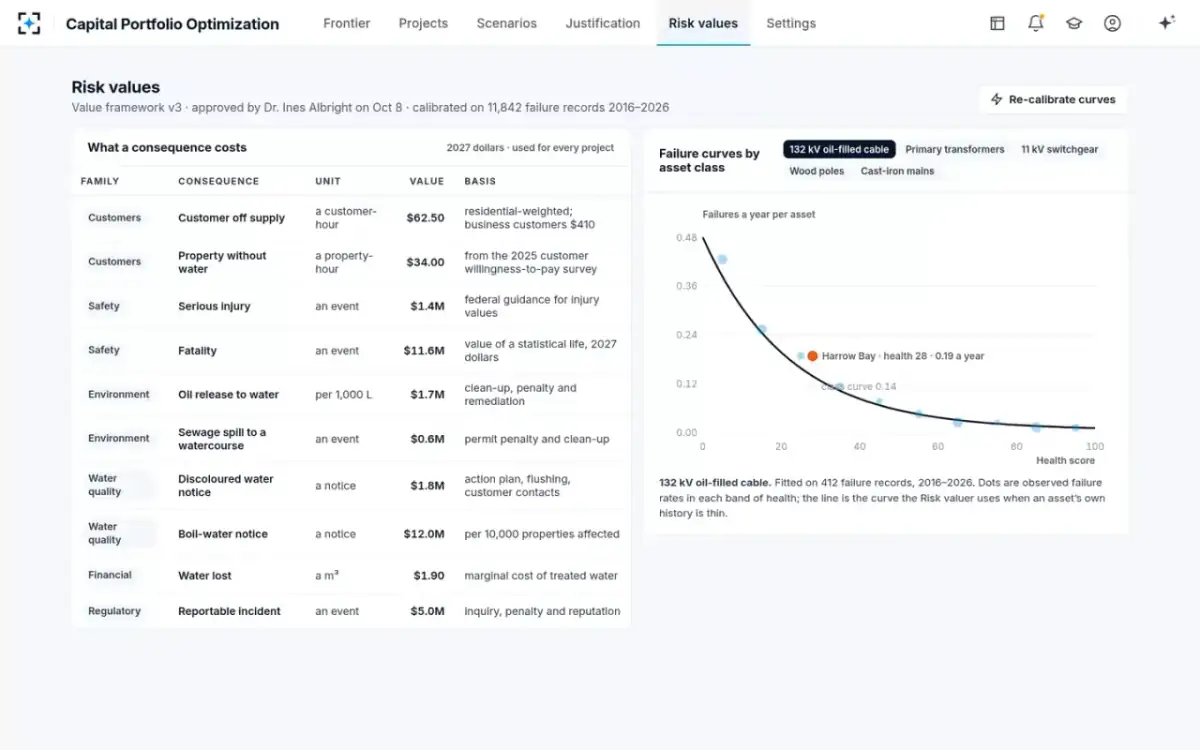

An oil-filled cable, valued from its own records
Risk valuerRank 60 is a 132 kV oil-filled cable replacement costing $68.0M. Its two circuits were laid in 1971, and their health scores are 28 and 31. The curve for this class of cable gives 0.14 major failures a year. This cable has had 3 oil leaks and 1 joint fault in 24 months, which raises it to 0.19. A major failure would cost $54.0M. That covers 38,400 customers off supply at $62.50 a customer-hour, oil in an estuary, repair, a reportable release and the public near the joint bays. So the risk today is $10.3M a year, and $0.4M after replacement. The project removes $9.8M.
The Risk valuer never invents a failure rate. It uses the class curve when an asset's history is thin, and says so.
- 05The evidence

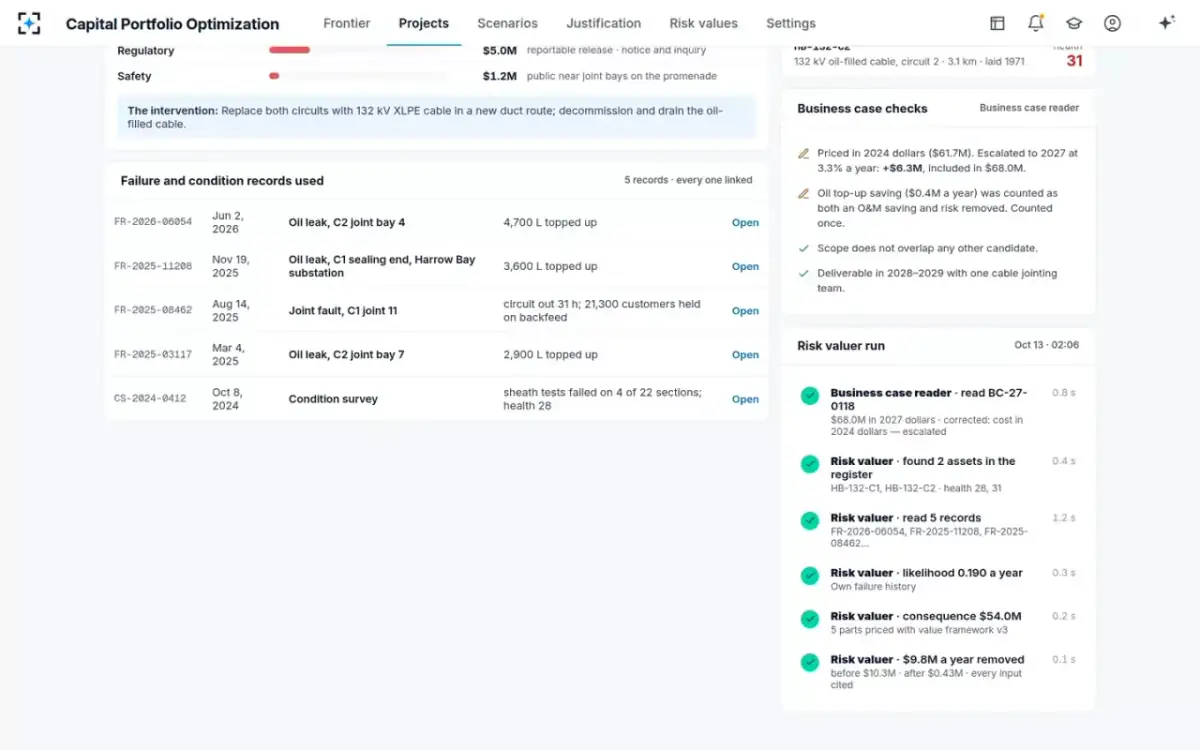

Five records behind the number, and two fixes to the case
Risk valuer and Business case readerEach record is linked. There were three oil leaks in two years, of 2,900 L, 3,600 L and 4,700 L. A joint fault took circuit 1 out for 31 hours, with 21,300 customers kept on supply from another circuit. A condition survey found failed sheath tests on 4 of 22 sections. The business case was priced in older dollars, so $6.3M of escalation is now included. An oil top-up saving was counted twice and is now counted once.
Valuer run: “$9.8M a year removed · before $10.3M · after $0.4M · every input cited”
- 06The CFO's question

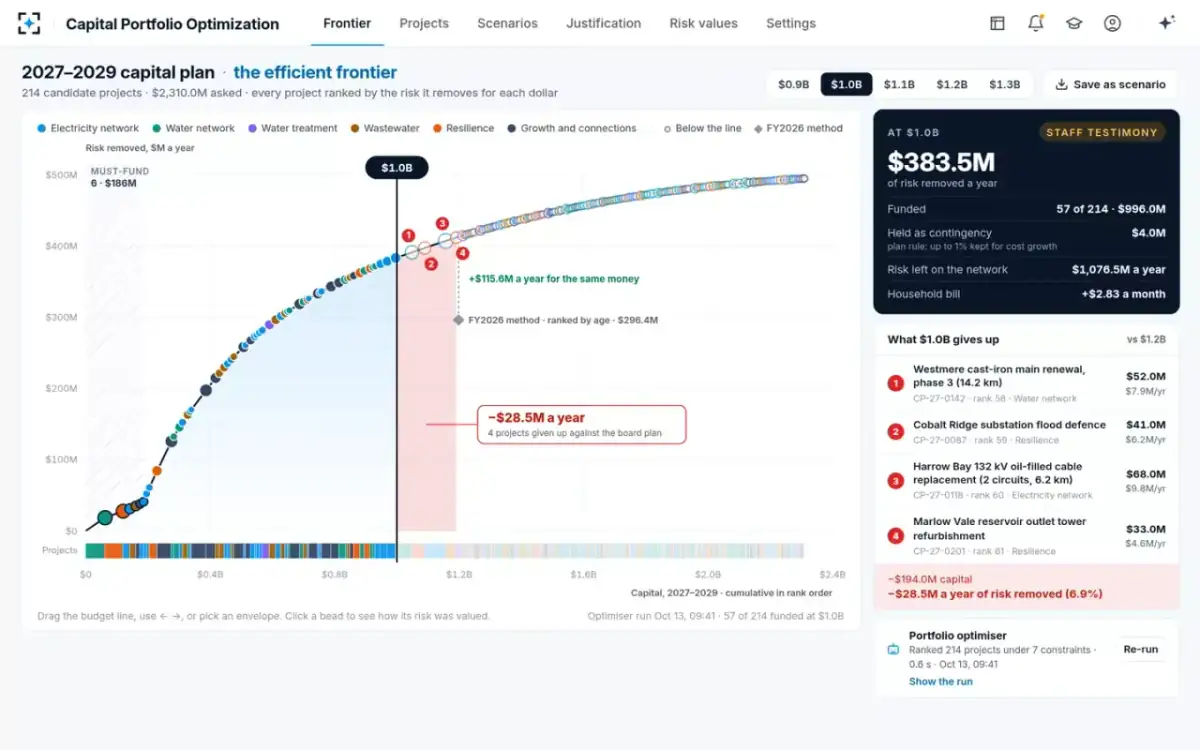

Move the line to $1.0B and see what is given up
Head of capital planningThe regulator's staff proposed $1.0B in their opening testimony. The CFO asks what that would mean. The head of capital planning moves the budget line, and four projects drop. Two are phase 3 of a cast-iron main renewal ($52.0M, $7.9M a year) and a substation flood defense ($41.0M, $6.2M). The other two are the oil-filled cable ($68.0M, $9.8M) and a reservoir outlet tower ($33.0M, $4.6M). In all, 57 projects stay funded for $996.0M and remove $383.5M a year. The bill rise falls to $2.83 a month.
“−$194.0M capital · −$28.5M a year of risk removed (6.9%)”
- 07Below the line

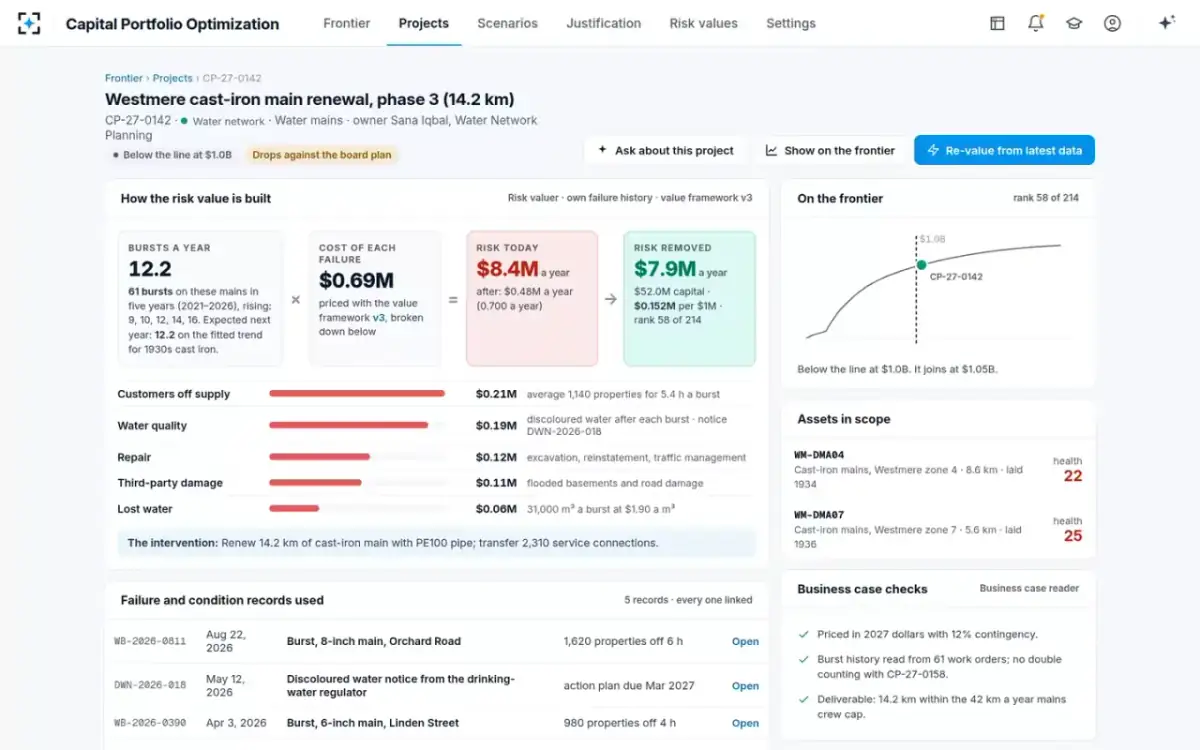

A cast-iron main with 61 bursts in five years
Water network planningThe cast-iron mains were laid in 1934 and 1936. They have burst 61 times in five years, and the count rises each year: 9, 10, 12, 14, 16. The fitted trend expects 12.2 bursts next year, at $0.69M each. Renewing 14.2 km with plastic (PE) pipe removes $7.9M of its $8.4M a year of risk. Its records include a discolored-water notice with an action plan due. At $1.0B the main drops below the line. It comes back in at $1.05B.
Asked to keep the main in at $1.0B, the assistant proposes deferring depot fleet charging and an 11 kV switchgear project. The plan then costs $999.5M and removes $383.0M a year, $0.5M less.
- 08Side by side

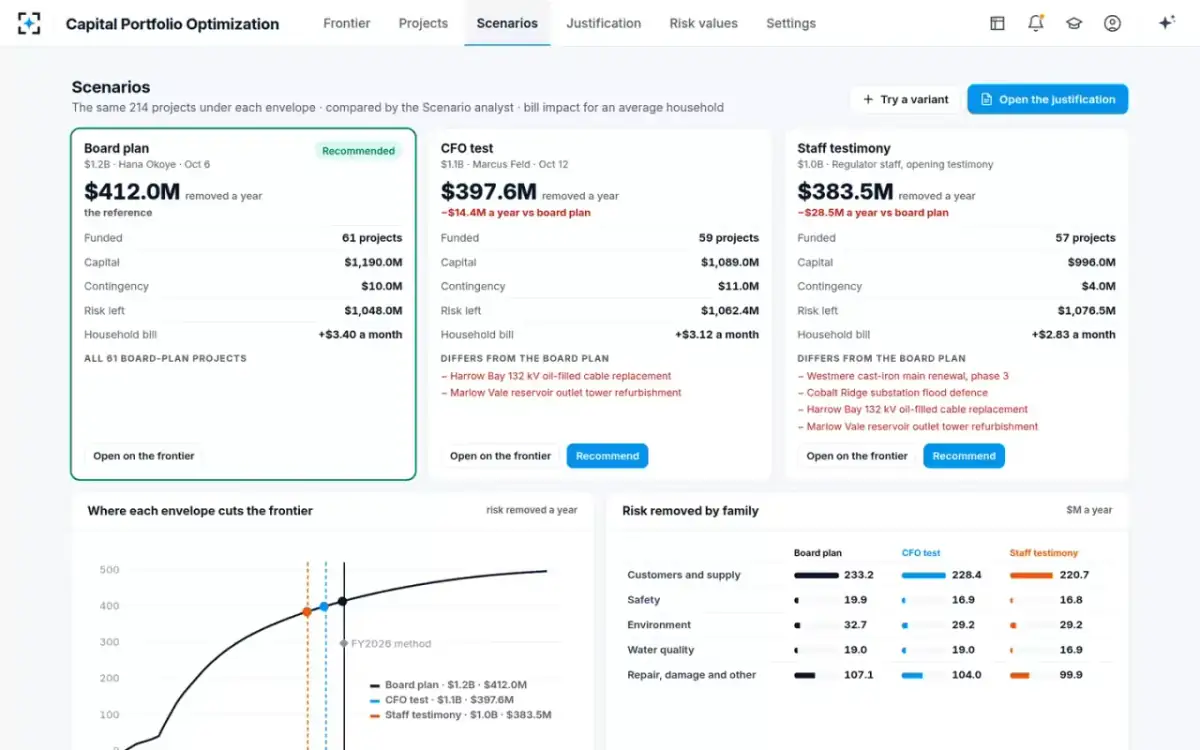

Three budgets, with the risk each one leaves
Scenario analystThe board plan at $1.2B removes $412.0M a year. At $1.1B, the CFO's test removes $397.6M and drops the cable and the outlet tower. Staff testimony at $1.0B removes $383.5M and drops all four. Risk removed is broken out by family. For customers and supply it is $233.2M, $228.4M and $220.7M a year. For water quality it is $19.0M, $19.0M and $16.9M. The bill impact sits under each.
Scenario analyst: “Compares; does not choose.”
- 096 seconds later

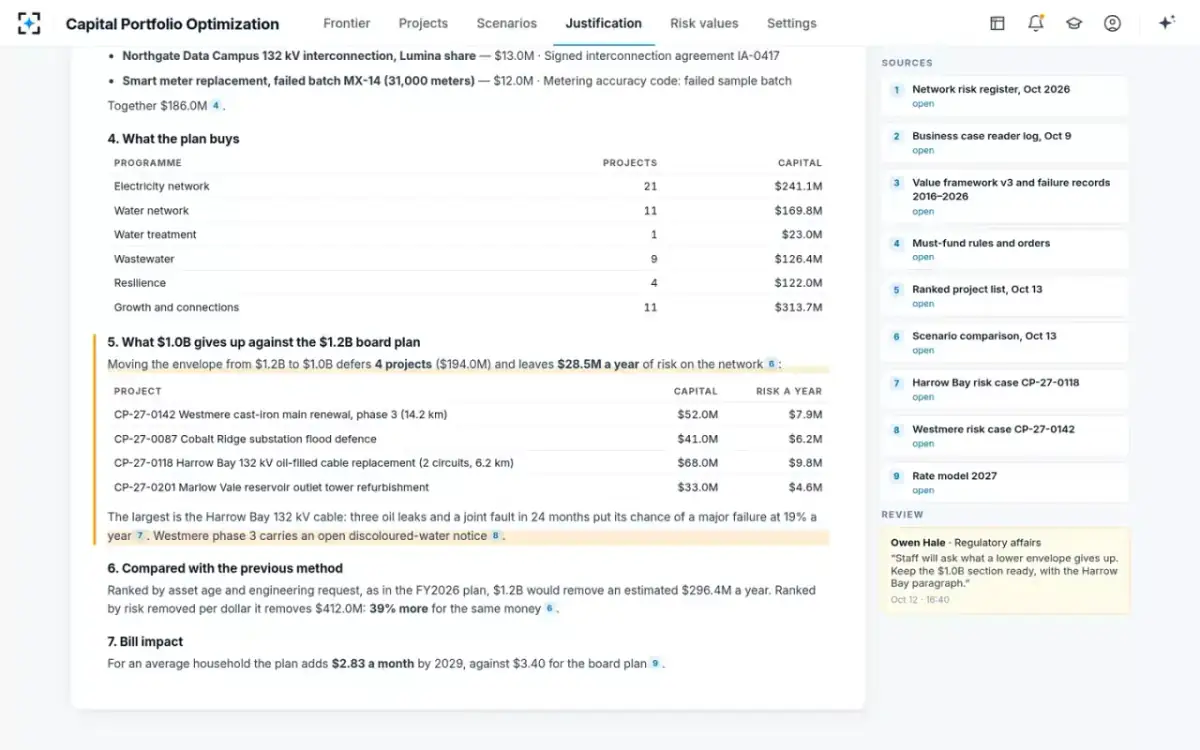

The justification, redrafted for $1.0B
Justification writerThe writer redrafts seven sections with nine sources. The new section names the four projects that drop. It gives the $194.0M of capital and the $28.5M a year of risk they carry. It explains why the oil-filled cable matters most. Three oil leaks and a joint fault in 24 months put its chance of a major failure at 19% a year. The bill section compares $2.83 a month with $3.40 for the board plan.
The regulatory affairs manager's review note: “Staff will ask what a lower envelope gives up. Keep the $1.0B section ready, with the cable paragraph.”
- 10Signed at 10:12

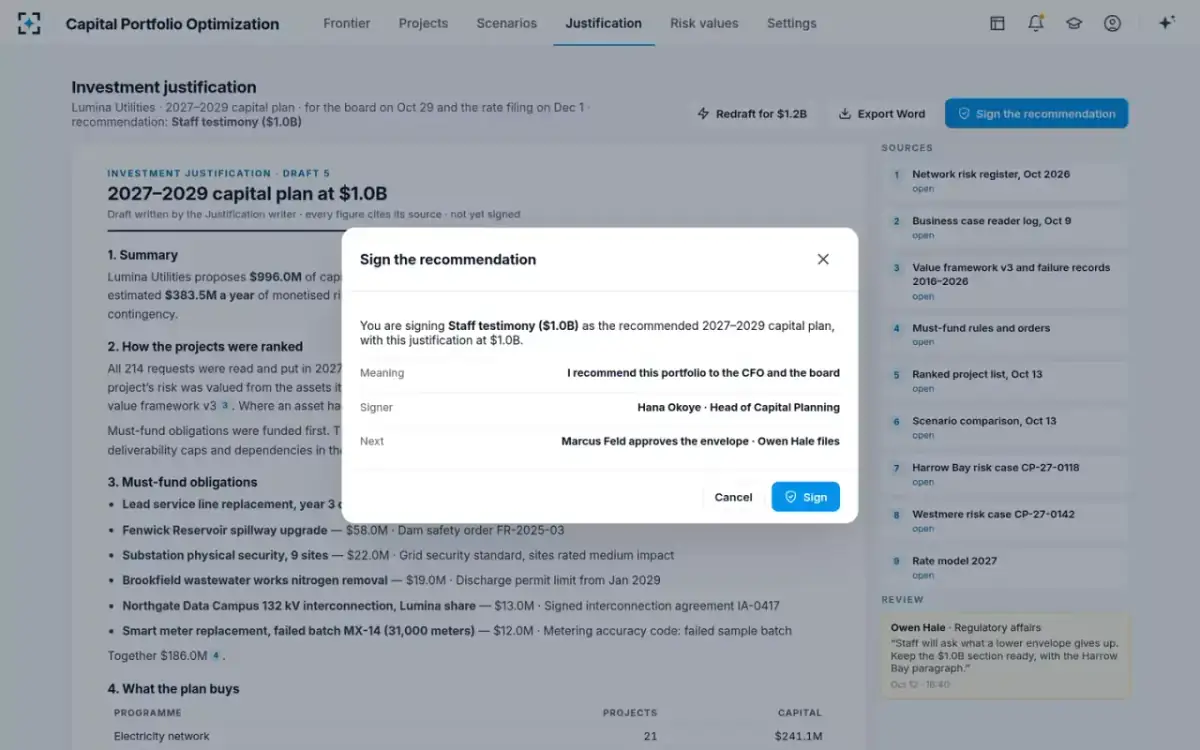

The recommendation signed, with what the signature means
Head of capital planningThe head of capital planning makes the $1.0B scenario the recommendation. They sign it together with the justification drafted for the same budget. The signature records its meaning, “I recommend this portfolio to the CFO and the board”, and what comes next. The CFO approves the budget, and regulatory affairs files with the regulator. The signing goes on the audit trail and the CFO is notified.
If the draft and the recommendation are for different budgets, the solution asks for a redraft first and will not sign.
