- Before
- Acts for the Engineer on two projects, with 11 open change orders, each on a 42-day response clock. The contract documents sit in five places. A rate can be argued all week, but the first question is whether anything is owed at all.
- Now
- Opens each claim with the four entitlement tests answered and each clause quoted with its page. A drafted response is ready to edit, sign and send.
A cable tray claim, checked for whether it is owed before it is priced
The sample utility is building a 132/11 kV substation. The contract is a $48.6M design-build EPC contract, so the contractor both designs and builds. Eleven days ago, the contractor sent a change order for $640,012. It asks to be paid for more cable trays in the 11 kV switchroom and cable basement. Here is what happens next, screen by screen, in the working solution.
A worked example on sample data. Names, IDs and figures on the screens and in this section come from the demo.
- 01Morning
The claim opens with a verdict before a price
Contract administratorThe contract administrator acts for the Engineer on two projects. They have 11 change orders open, each with 42 days to answer. The cable tray claim is on day 11 of 42. On the left is the claim as the contractor wrote it. The middle shows the entitlement tests, which check whether anything is owed. The right shows the cost check against contract rates. The overnight check ran from 06:38 to 06:47 and has already answered all four tests.
Not entitled: “In the original scope. The contractor's own design change. No instruction. Notice 18 days late.” · Reject · $0 · recommendation · you decide
- 0206:38

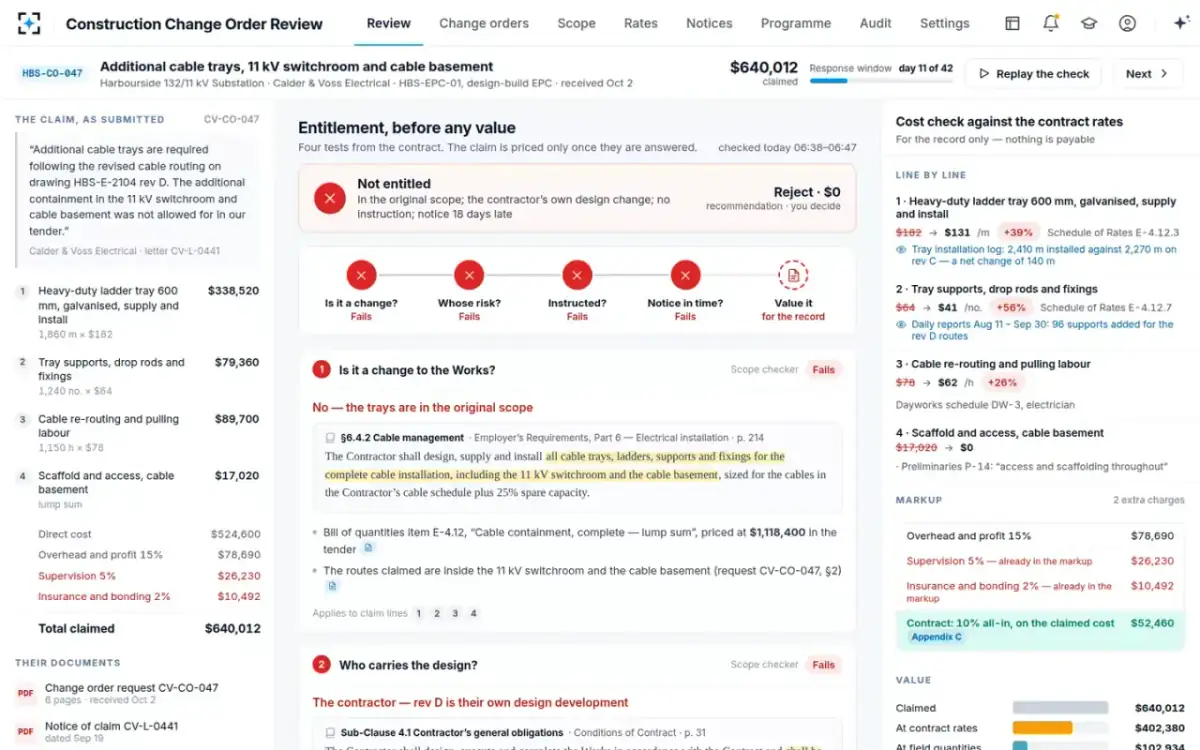

The claim as sent, with nothing priced yet
Claim readerThe claim reader lists what the contractor asked for. That is 1,860 m of 600 mm heavy-duty ladder tray at $182 and 1,240 supports at $64. It adds 1,150 hours of re-routing and pulling labor at $78 and a $17,020 scaffold lump sum. The direct cost comes to $524,600. On top come 15% overhead and profit, 5% supervision and 2% insurance and bonding. The contractor's letter says the trays follow “the revised cable routing on drawing … rev D”. The administrator can replay the check step by step. The cost column stays locked while the tests run.
“Valuation waits for entitlement” · “Waiting for entitlement: the cost is checked only after the four tests are answered.”

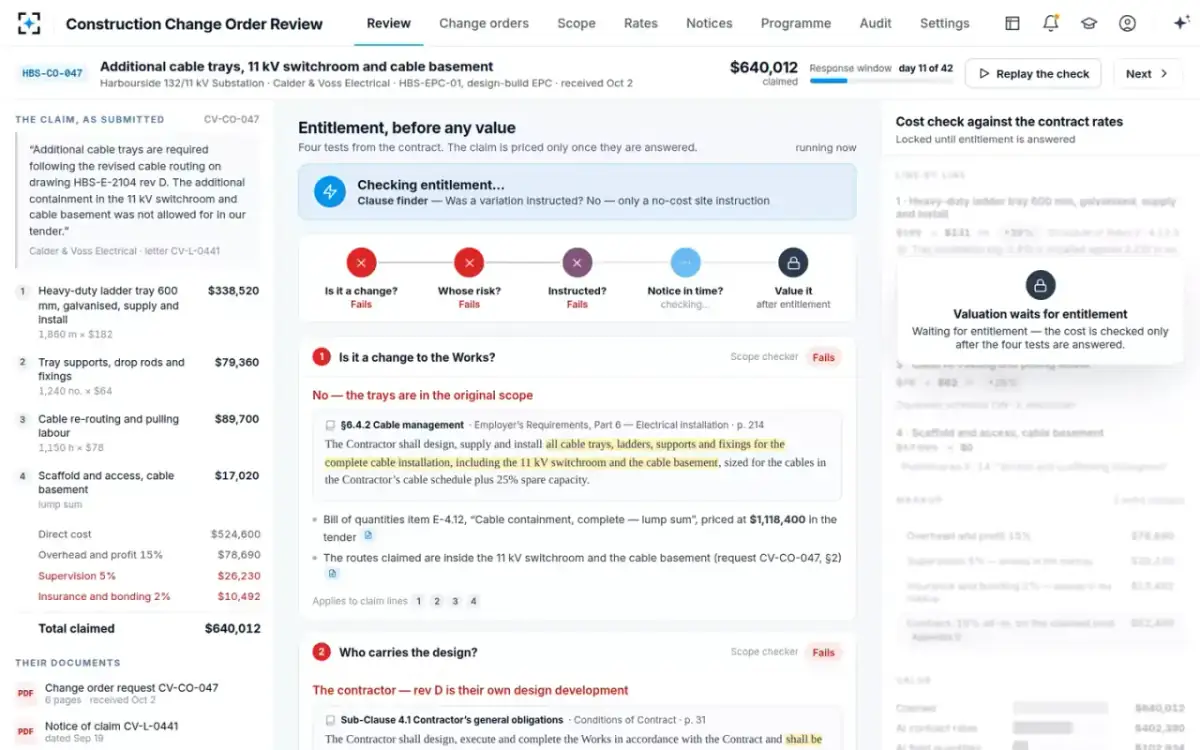

- 03Test 1
The trays were always part of the contract

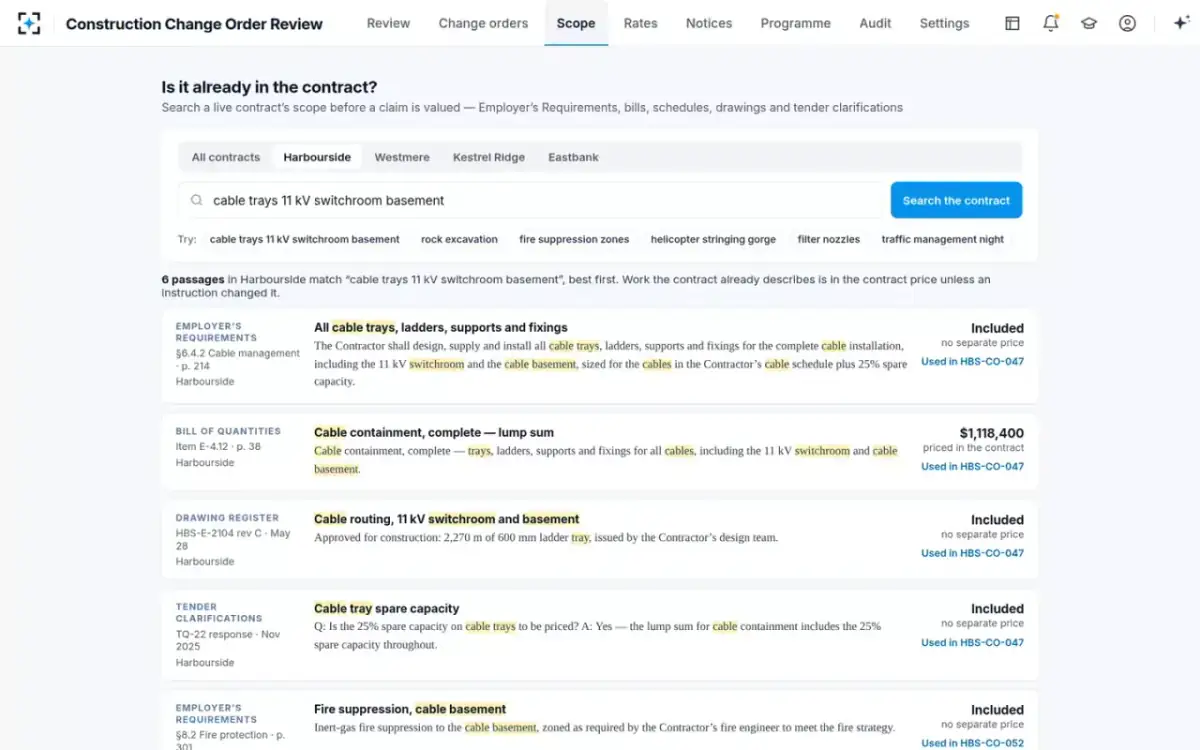

Scope checkerSection 6.4.2 of the Employer's Requirements sits on page 214 of Part 6. It already requires “all cable trays, ladders, supports and fixings for the complete cable installation, including the 11 kV switchroom and the cable basement”. It also asks for 25% spare capacity. In the tender, the bill item for cable containment was priced at $1,118,400, “complete, lump sum”. A tender clarification confirmed the spare capacity is in that lump sum. Anyone can run the same search on the Scope screen.
“Work the contract already describes is in the contract price unless an instruction changed it.”

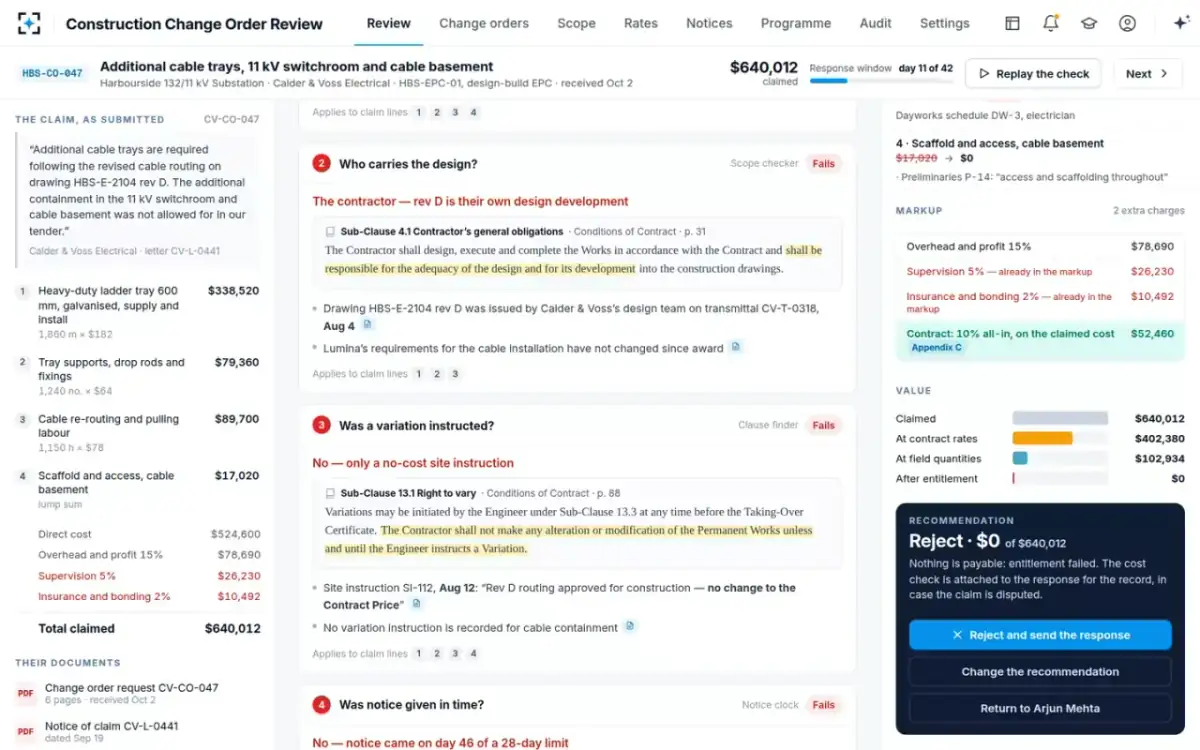

- 04Tests 2 and 3
The contractor's own design, and no instruction to change the work
Scope checker and Clause finderRev D was issued by the contractor's own design team, on its own transmittal. The utility's requirements have not changed since the contract was awarded. Under Sub-Clause 4.1, the contractor is “responsible for the adequacy of the design and for its development”. The only instruction came eight days later. It is a site instruction that reads “Rev D routing approved for construction, no change to the Contract Price”. Sub-Clause 13.1 is quoted beside it, word for word, with its page.
Scope checker: “Reports what the documents say. Never decides entitlement.”
- 05Test 4

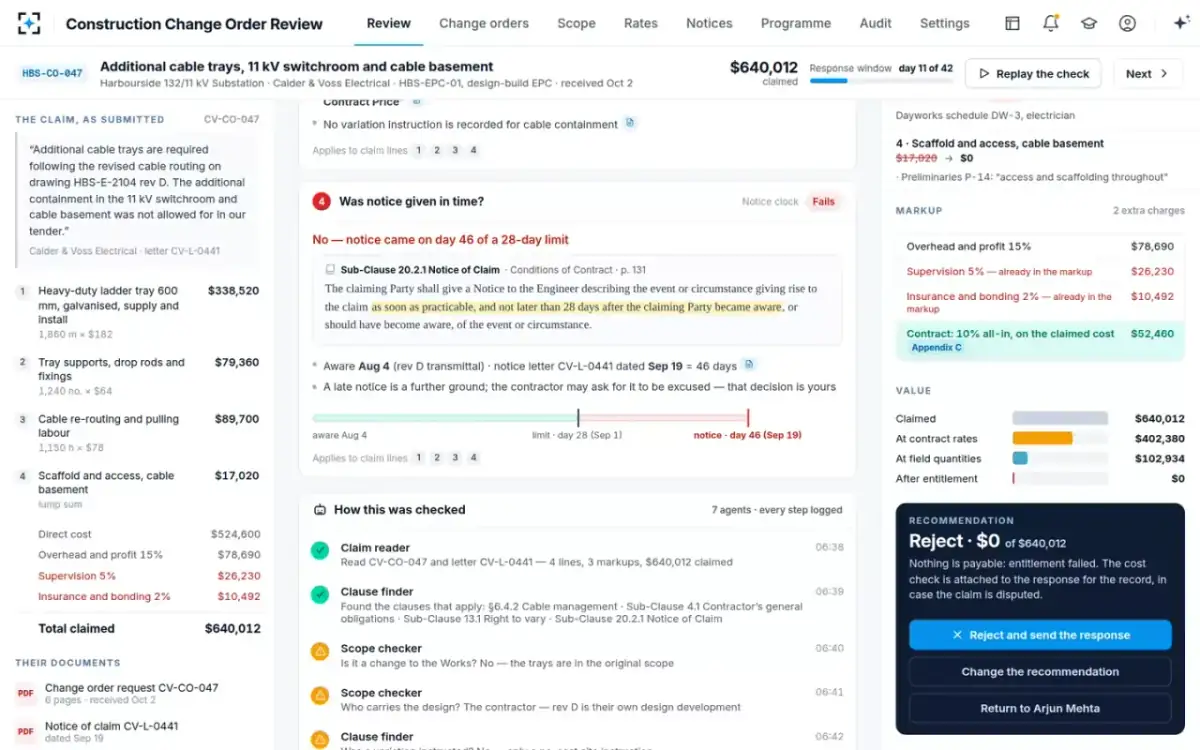

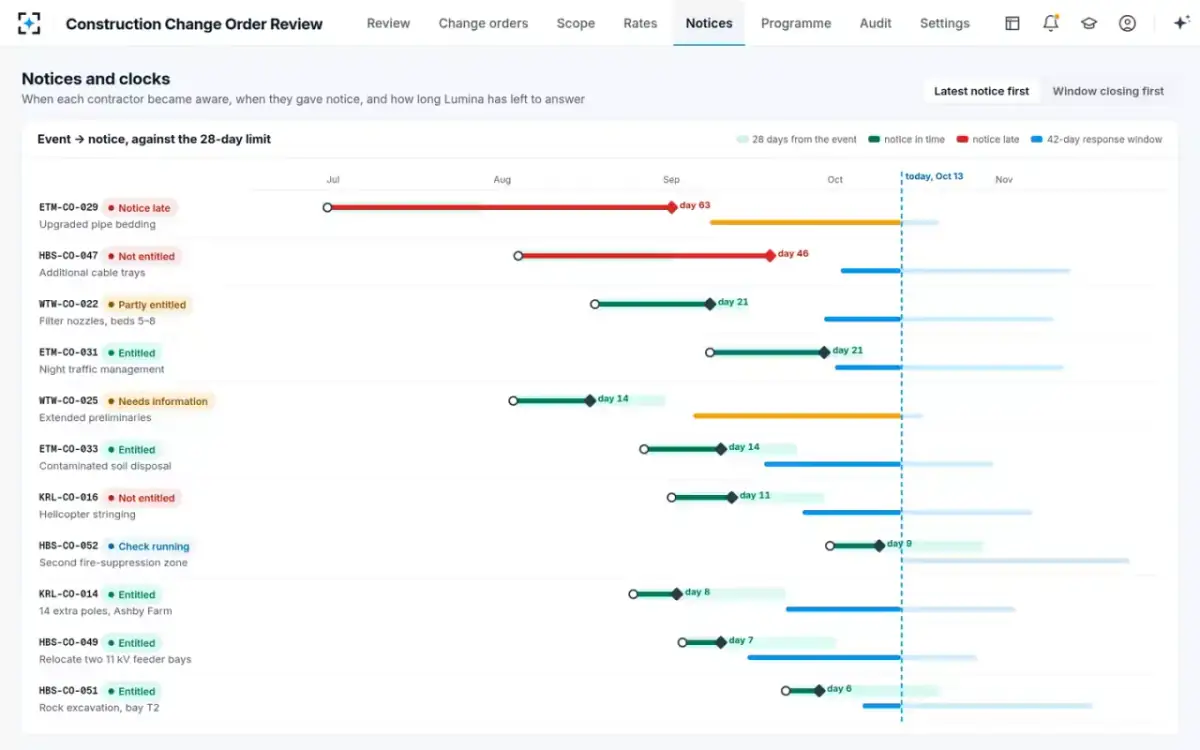

Notice on day 46 of a 28-day limit
Notice clockThe contractor became aware of the event on the day of the rev D transmittal. Its notice letter is dated 46 days later. Sub-Clause 20.2.1 allows 28 days, so the limit had already passed. The notice ruler shows both dates. Below it, the run log lists each agent step with its time.
“A late notice is a further ground. The contractor may ask for it to be excused. That decision is yours.”
- 06For the record

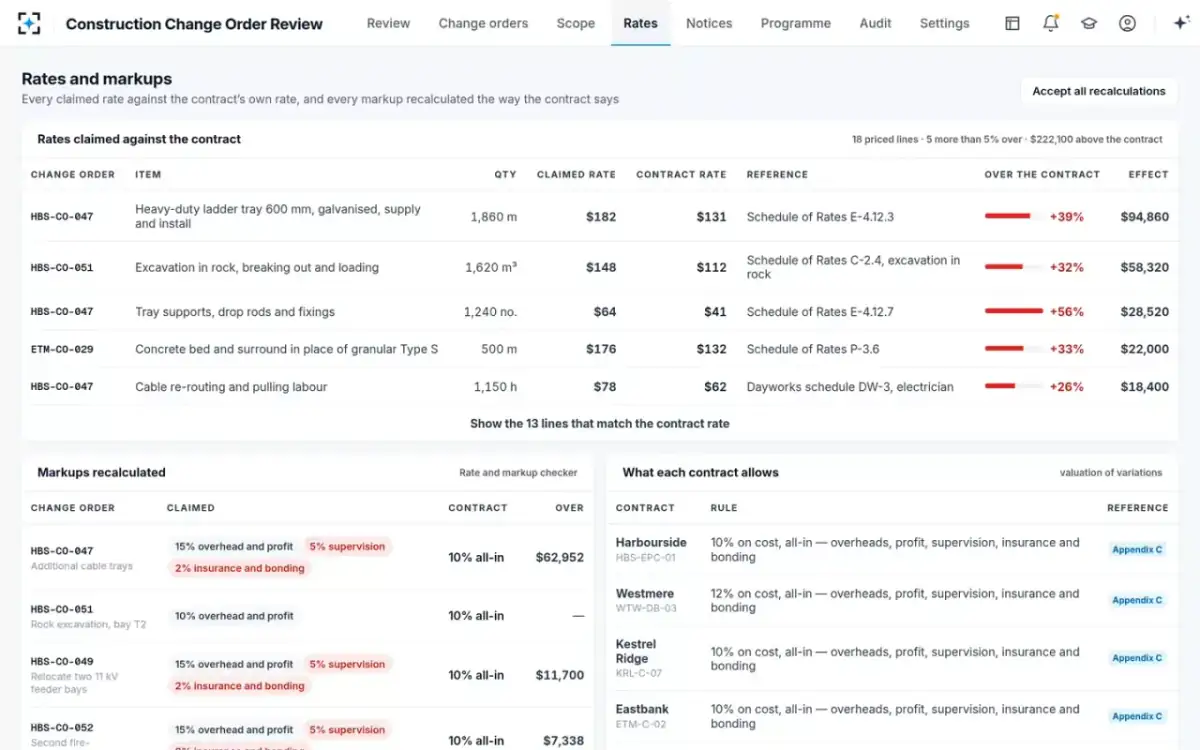

The cost check, for the record, finds rates and markup above the contract
Rate and markup checker · Field record matcherThe cost column now opens, marked for the record. The tray is claimed at $182 against $131 in the schedule of rates (+39%). Supports are claimed at $64 against $41. Labor is $78 against $62 on the dayworks schedule. The scaffold is already in a preliminaries item, the contract's line for general site costs. The claimed 22% markup becomes the contract's 10% all-in under Appendix C. At contract rates, the claimed quantities are worth $402,380. The tray installation log shows a net change of only 140 m, against 1,860 m claimed. At those field quantities the work is worth $102,934. The subcontractor quote attached to the claim prices the tray at $118/m.
Rate and markup checker: “Never values a claim before entitlement is answered.”

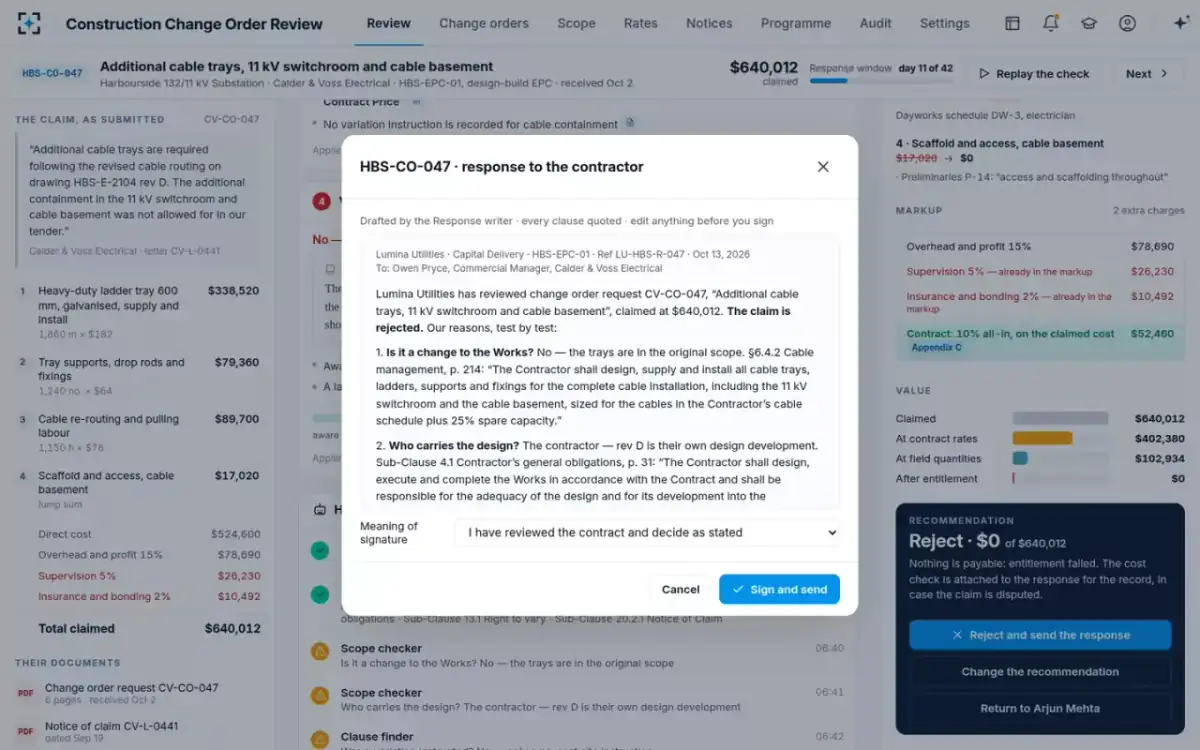

- 07Signed
The administrator rejects at $0 and signs the response
Contract administratorThe response writer has drafted the letter to the contractor's commercial manager. It goes test by test and quotes §6.4.2 and Sub-Clauses 4.1, 13.1 and 20.2.1. The value at contract rates is attached for the record only. The letter states that this does not admit anything is owed. The contract administrator can edit anything and chooses what the signature means. Then they sign and send.
“Drafted by the Response writer · every clause quoted · edit anything before you sign”
- 08Next

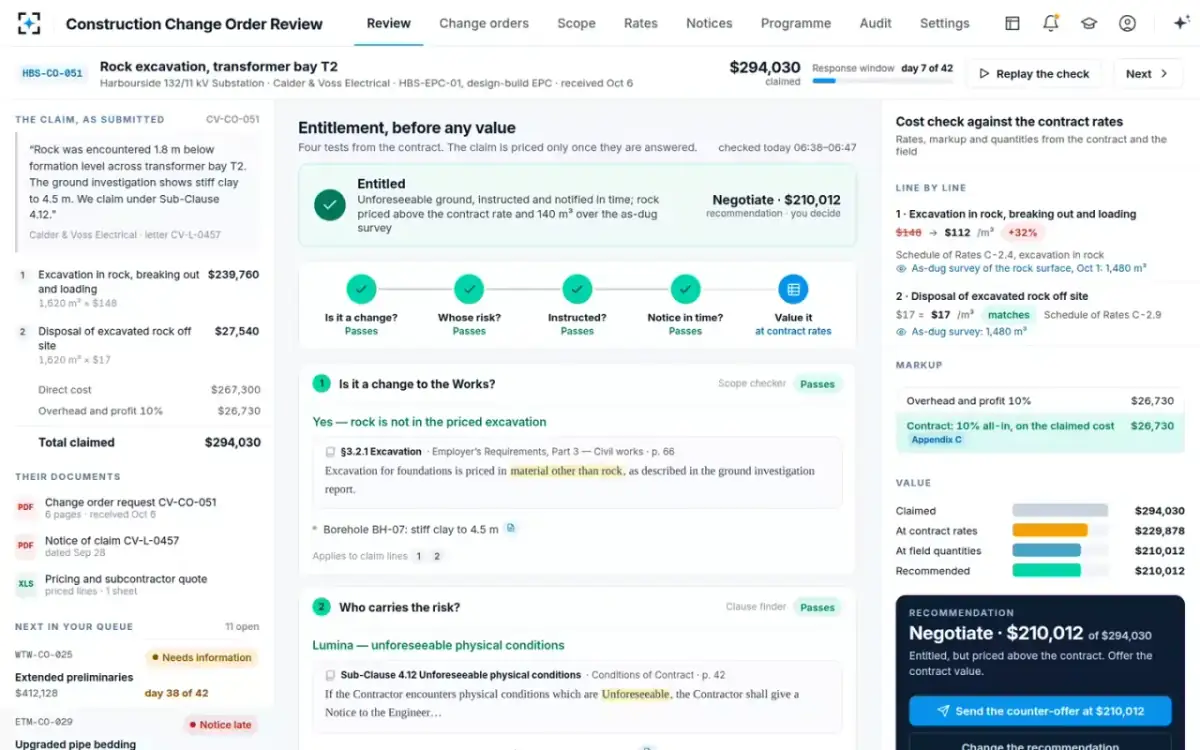

A claim that is owed, priced at the contract rate
Contract administratorA rock excavation claim in transformer bay T2 passes all four tests. A borehole had shown stiff clay to 4.5 m, so the rock counts as unforeseeable ground under Sub-Clause 4.12. Notice came on day 6. Now the valuation opens. Rock is priced at the contract's $112/m³ instead of $148, on 1,480 m³ from the as-dug survey. The recommendation is to negotiate at $210,012 of the $294,030 claimed.
“Entitled, but priced above the contract. Offer the contract value.”

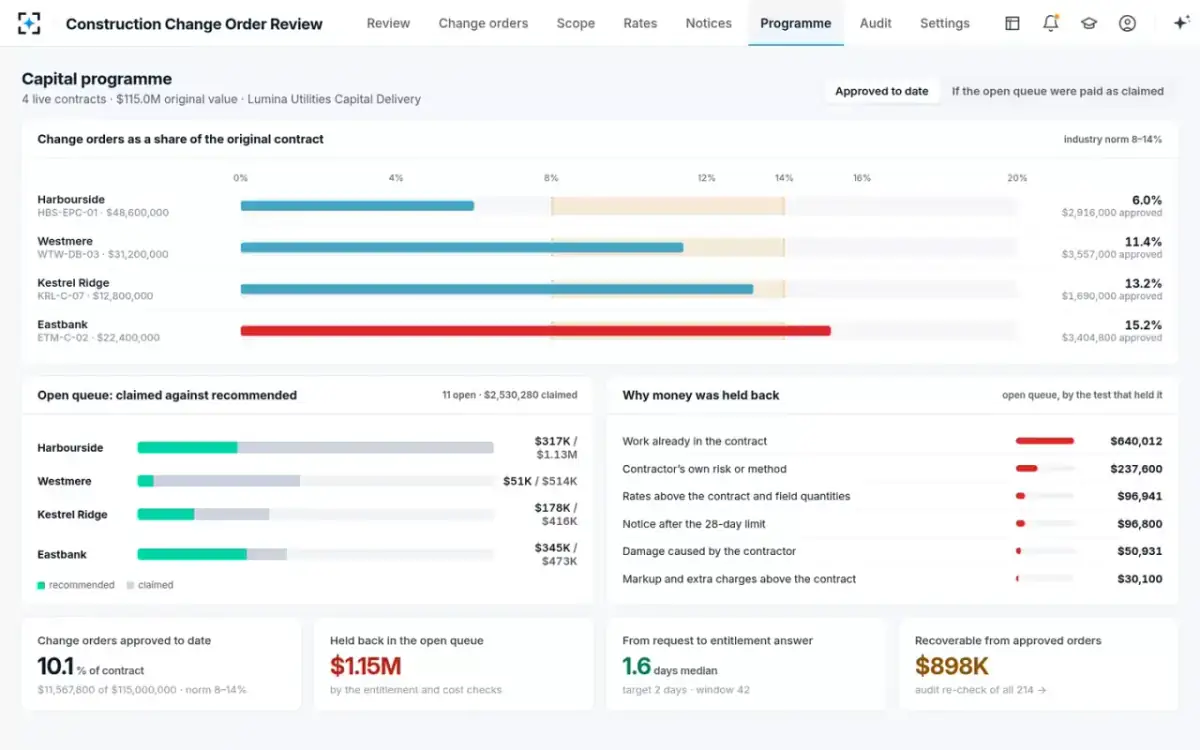

- 09The queue
Eleven change orders, each with its verdict and its clock
Project controls analystThe register shows the whole queue across four live contracts. In all, $2,530,280 is claimed. On the 9 claims already checked, $891,166 is recommended and $1,152,383 is held back. Another $486,731 waits for details or for the check. Filters pick out claims not owed, priced above the contract or notified after 28 days. One claim on another contract asks for extra site costs because the work ran longer. It is on day 38 of 42 and needs a request for details.
“11 open across 4 live contracts · $2,530,280 claimed · checked overnight, decided by you”

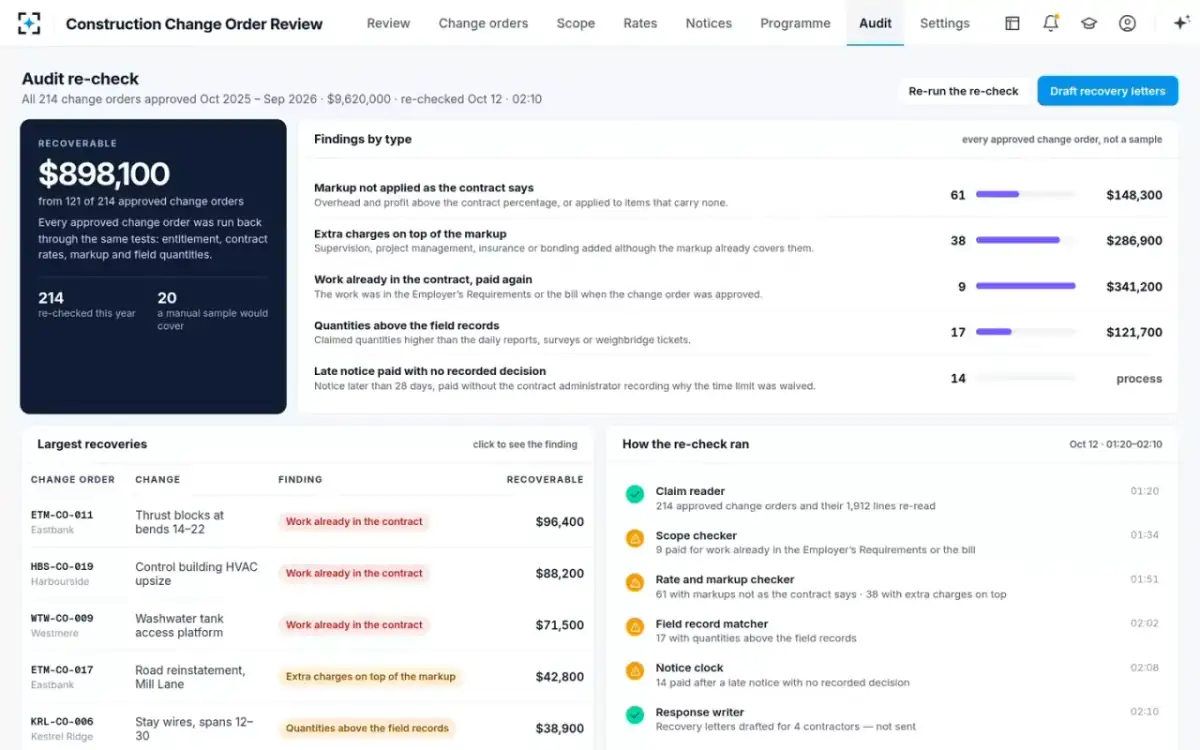

- 10Each month
All approved change orders checked again, instead of a sample
Internal audit managerThe audit re-check runs all 214 change orders approved in the last 12 months back through the same tests. It finds markups not applied as the contract says on 61. Extra charges sit on top of the markup on 38. Work already in the contract was paid again on 9, and quantities exceed the field records on 17. In all, $898,100 can be recovered from 121 of them. Separately, 14 late notices were paid with no recorded decision. Recovery letters are drafted for 4 contractors and wait unsent.
“214 re-checked this year · 20 a manual sample would cover”
