Tender Bid Evaluation

Tender bid evaluation that levels every bid to the same scope, so a hidden exclusion never wins the award

See one case, screen by screen ↓
Watch with transcript →

Built forCategory managersEngineering evaluatorsContracts counselCost engineersTender committees

The Problem Today

What a bid leaves out can sit deep in thousands of pages of text, so the bid that looks cheapest is often missing scope.

30 days
to evaluate a four-bid substation tender by hand our estimate
2-3 yrs
for a transformer to arrive, so a slow award delays the project published

Read by hand, beside day jobs

  • Tender
  • Technical
  • Prices
  • Drawings
  • Exclusions hidden in the text“By others” written deep in a volume and left off the deviation list
  • Scores drift apartOne evaluator's score sits far from the rest, with no reason given

The Solution

  1. Each page of each bid readExclusions found anywhere in the bid, including outside the deviation schedule
  2. Each requirement markedCompliant, deviation, exclusion or to clarify. Mandatory failures listed
  3. Hidden scope priced inEach gap priced from the other bids. The apparent winner drops to third
  4. The committee awardsThe category manager signs, counsel decides exceptions, the committee awards

Built-in controls

  • Agents never disqualify or reprice a bid
  • Each finding quotes its bid page
  • Clarifications can't reopen the price

What You Get

The committee can award to the bid that is cheapest for the full scope, and defend the choice if a bidder challenges it.

  • Hidden scope found before awardExclusions in the text priced into the bid that looked cheapest
  • Same scope, lower award priceThe recommendation goes to the bid cheapest once leveled
  • Scores kept consistentA score with no reason, or a wide spread, is flagged
In short

What is Tender Bid Evaluation?

It is software that takes a tender from the opened bids to an evaluation ready for committee. It produces a compliance matrix per bidder, a register of deviations and exceptions, a bid leveling sheet and a draft evaluation report. Tender Bid Evaluation adds six agents. They read each page of each bid against the tender's requirements and price each exclusion into a leveled price. The category manager signs and the tender committee awards.

How to choose AI solutions for utilities →

Updated

The problem

The cheapest bid often leaves out part of the work, and nobody finds it in time

A utility buys its big projects by open tender. Examples are a high-voltage substation, a smart-meter roll-out or a pumping-station refurbishment. Four to eight bidders each send a technical proposal and a commercial proposal. A bid for a substation EPC contract, where one firm designs, buys and builds the whole thing, can run to 2,000 to 3,000 pages. It holds technical volumes, drawings, type-test certificates, delivery schedules and price schedules. The evaluation falls to a small team of engineers, a category manager and contracts counsel. They have a few weeks, beside their day jobs, to tell the tender committee which bids comply and which is really cheapest.

The trouble is that the quoted prices do not cover the same work. One bidder leaves out two mandatory spares. Another offers 24 months of defects liability where the tender asks for 36. A third adds a copper price clause on page 38. Bidders are meant to list what they leave out in a deviation schedule, but the costly gaps are rarely there. They sit in the technical text as “by others”, or behind a price line marked “included in item 6”. A gap missed before the award comes back later as a variation, a change priced with no competition. A missed mandatory failure, or a low price nobody looked into, also gives a bidder grounds to challenge the award.

typical2-3yearsto deliver a power transformer today, so a slow or challenged award costs time that money cannot buy back
typical2-3%of contract value saved in the University of California's published best-value procurement pilots
Where an evaluation's working days goestimated
By hand30 days
With the solution8 days
  • Reading the tender, addenda and pre-closing answers into requirements3 → 0.5 d
  • Reading each page of each bid12 → 1 d
  • Building the compliance matrix and checking mandatory items4 → 1 d
  • Leveling prices: exclusions, spares, losses, price clauses5 → 1.5 d
  • Clarifications and checking the evaluators' scores3 → 2 d
  • Writing the evaluation report and signing off3 → 2 d

Estimated split for a four-bid substation EPC tender of about 10,500 pages and three evaluators. Shown in working days, by hand and with the solution.

How it works

Tender bid evaluation from opened envelopes to a committee-ready report

What comes in
Tender and bids inEvery page · RFP, bids, clarifications, weights
Agents at work
Tender readereach requirement
Then
Bid readerevery page
Compliance checker
Then
Price levellersame scope
Scoring consistency checker
Then
Report and clarification writercited drafts
A person decides
Tender committeeawards
What comes out
Compliance matrix
Leveled prices
Evaluation report
One case, step by step

Four substation bids, leveled to one scope before the tender committee

The utility needs a new GIS substation to connect 14,200 homes in a growth area. GIS means gas-insulated switchgear, a compact type of switchgear. The tender covers 8 GIS bays, two 63 MVA transformers, switchgear, protection and SCADA, cables and civil works. It has closed, and the engineer's estimate is $64.2M. The commercial envelopes open today, and the Tender Committee meets in two weeks. Here is what happens next, screen by screen, in the working solution.

A worked example on sample data. Names, IDs and figures on the screens and in this section come from the demo.

  1. 01Envelopes opened

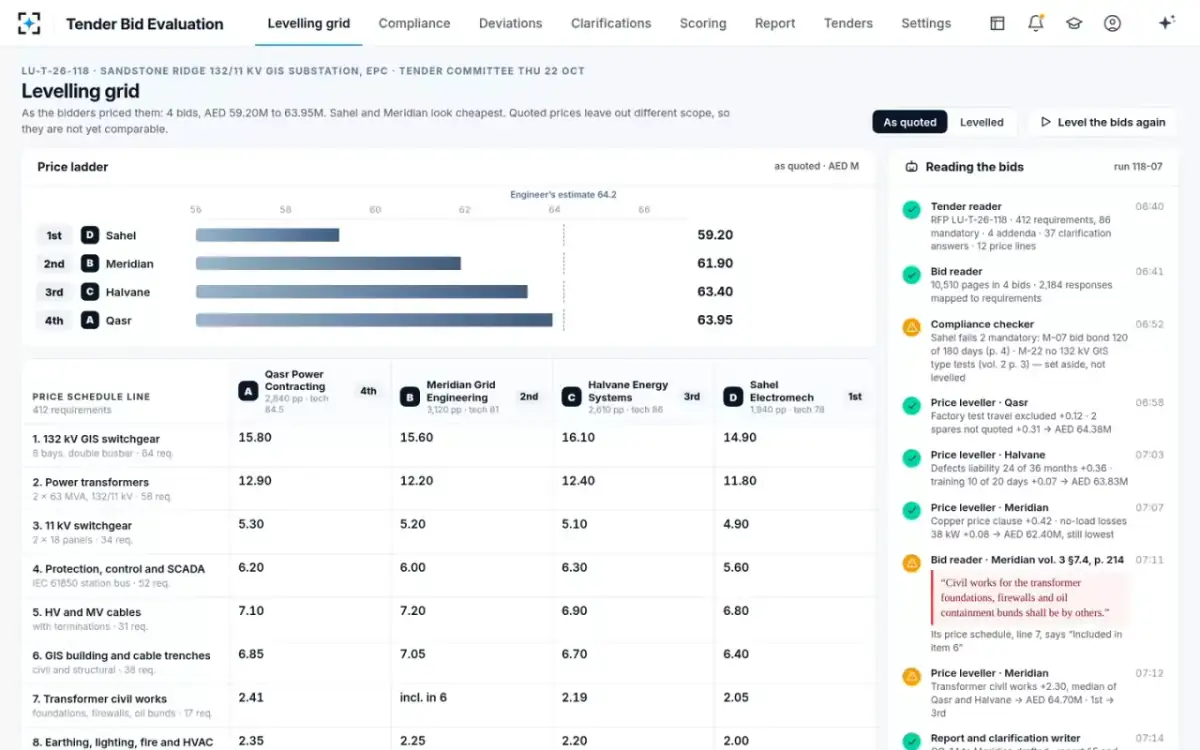

    As quoted, Bidder B looks like the winner

    Category manager

    There are four bids, 10,510 pages in all. As the bidders priced them, Bidder A is cheapest at $59.20M. Next come Bidder B at 61.90M, Bidder C at 63.40M and Bidder D at 63.95M. The category manager runs four live tenders, and this one goes to committee in two weeks.

    “Bidders A and B look cheapest. Their quoted prices leave out different scope, so they cannot be compared yet.”

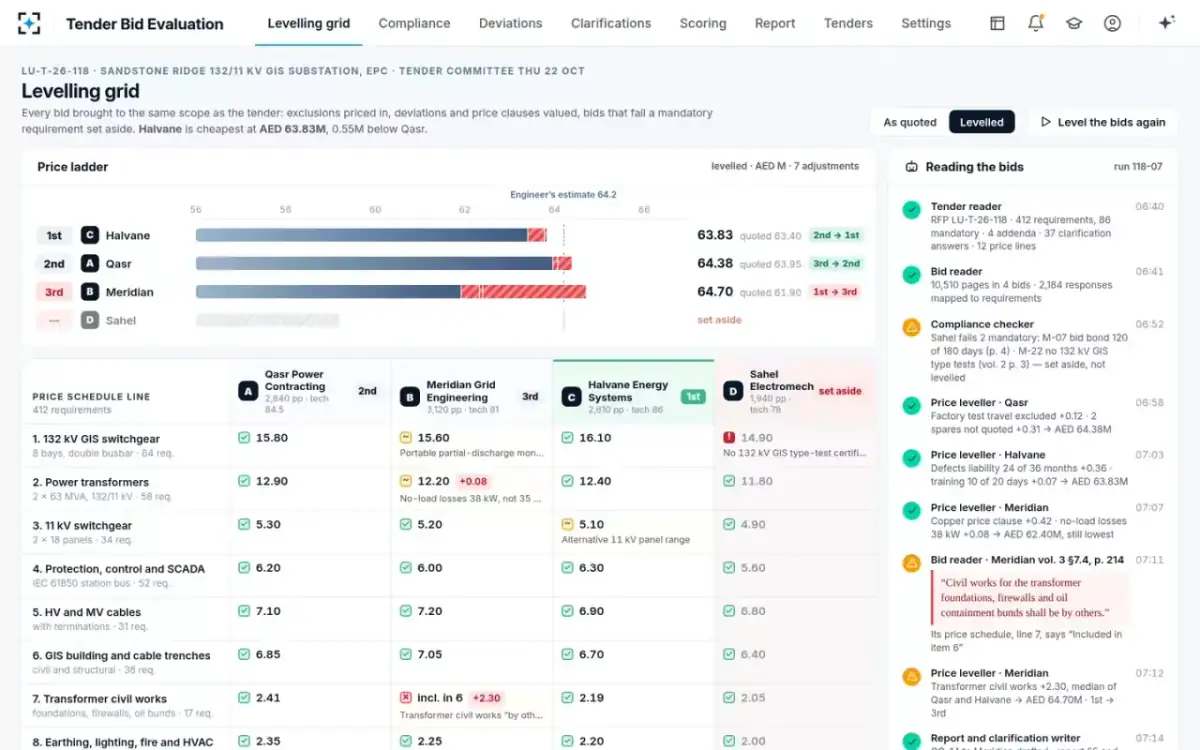

  2. 0206:40

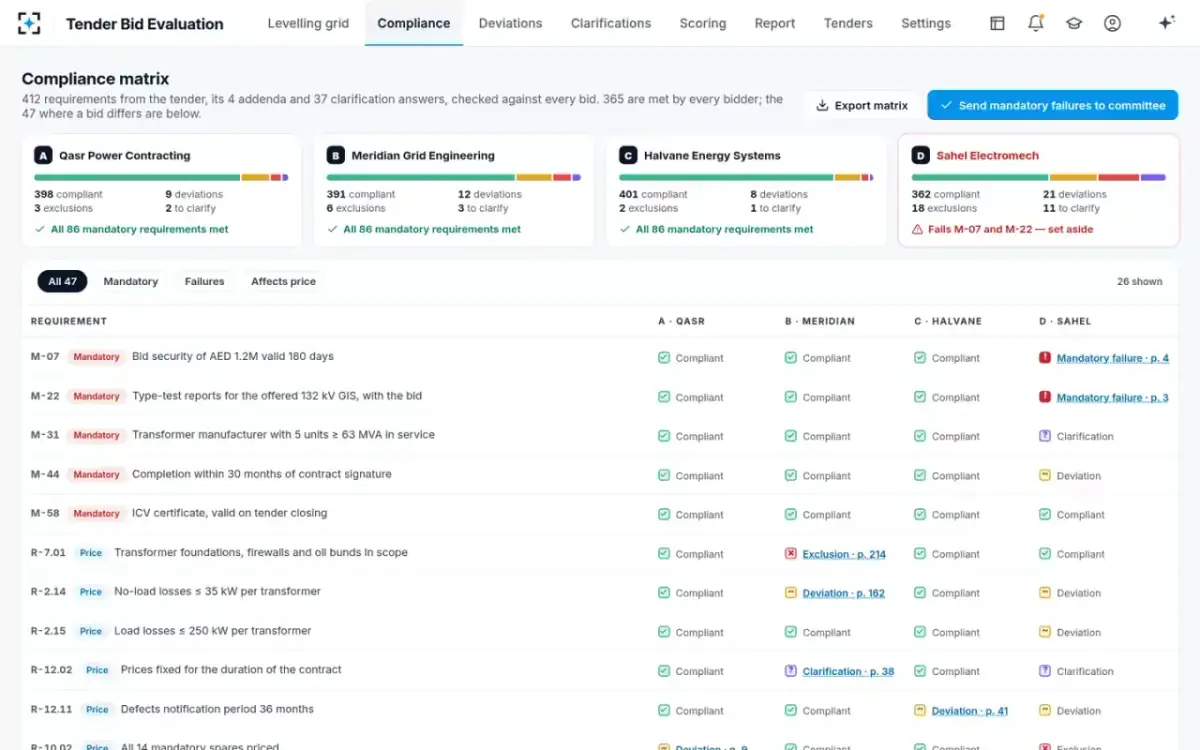

    412 requirements, checked against each bid

    Tender reader and Compliance checker

    The tender reader reads the RFP, its 4 addenda and 37 answers given before closing. It turns them into 412 requirements and 12 price lines. Each requirement cites its clause, and 86 of them are mandatory. The compliance checker then marks each requirement for each bid. All four bidders meet 365 of them. The matrix shows the 47 where a bid differs.

    Bidders B, C and D meet all 86 mandatory requirements · Bidder A fails two and is set aside

  3. 0306:52

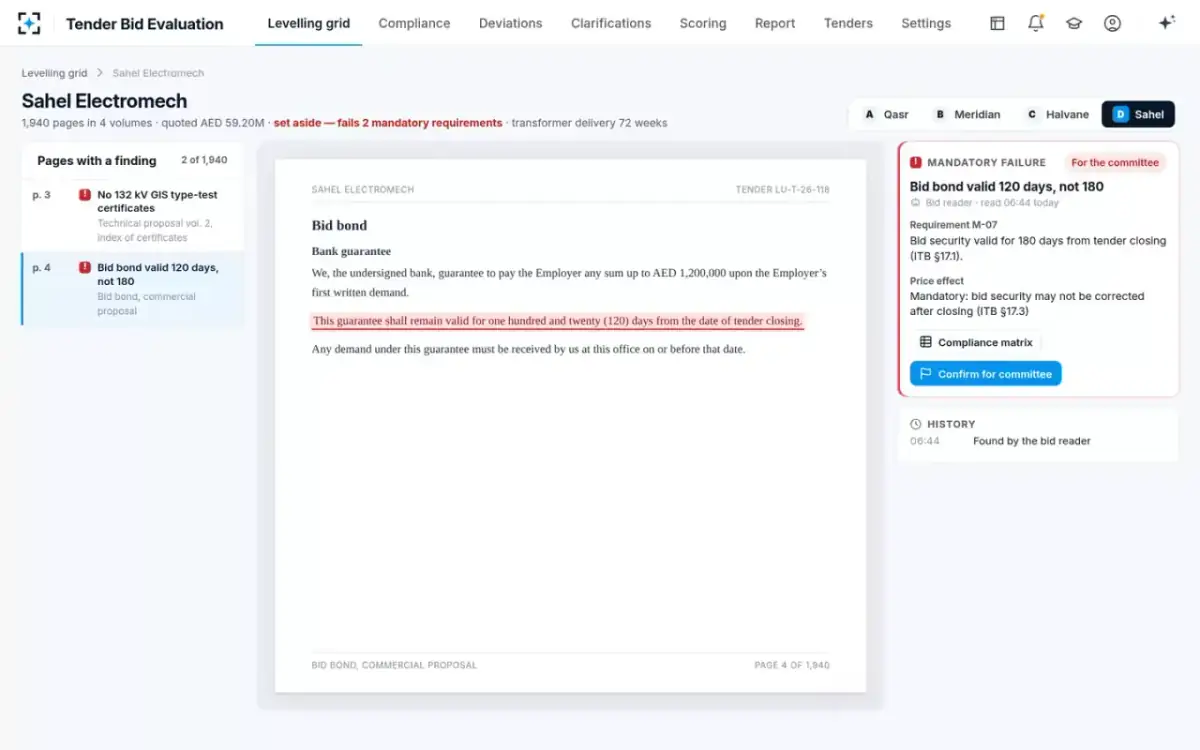

    Bidder A fails two mandatory requirements

    Bid reader and Compliance checker

    Page 4 of Bidder A's commercial proposal sets the term of its bank guarantee. It “shall remain valid for one hundred and twenty (120) days from the date of tender closing”. The tender asks for 180. Its technical volume 2 also has no type-test reports for the offered GIS. Bidder A is not leveled. The committee is asked to confirm that the bid is set aside.

    Price effect: “Mandatory: bid security may not be corrected after closing (ITB §17.3)”

  4. 0406:58

    Spares, warranty and price clauses, priced into each bid

    Price leveller

    Bidder D leaves out travel for four of the utility's engineers to the factory acceptance tests (+0.12M). It also leaves 2 of 14 mandatory spares unpriced (+0.31M), which brings it to $64.38M. Bidder C offers 24 months of defects liability against 36 (+0.36M) and 10 training days against 20 (+0.07M). That brings it to 63.83M. Bidder B has a copper price clause on the transformers (+0.42M). Its no-load losses are 38 kW against 35 kW (+0.08M). That leaves it at 62.40M, still the lowest.

    Commercial exceptions (delay damages, advance payment, performance security, the copper clause) go to contracts counsel.

  5. 0507:11

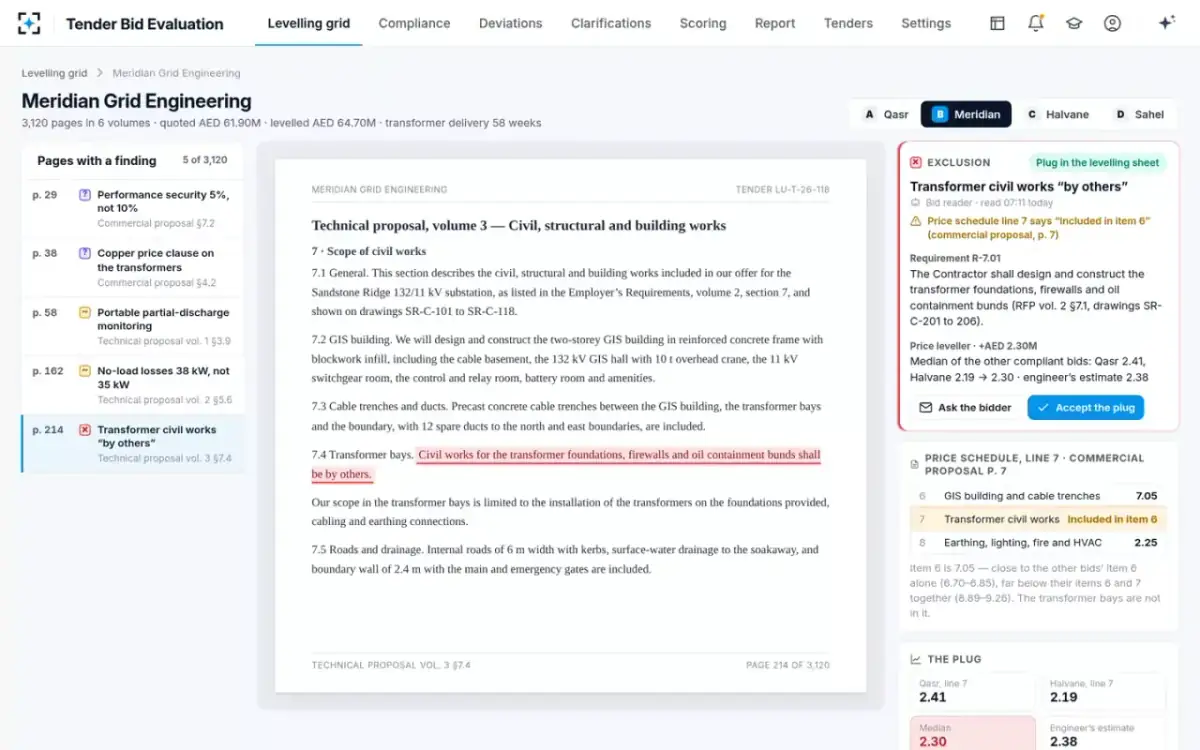

    Page 214: “shall be by others”

    Bid reader

    Deep in Bidder B's technical proposal, in volume 3 §7.4, the bid reader finds a sentence the deviation schedule never declared. Bidder B's own price schedule, line 7, says the same works are “Included in item 6”. The grid still shows Bidder B first, at $62.40M. Meanwhile the price leveller works out what the missing scope is worth.

    “Civil works for the transformer foundations, firewalls and oil containment bunds shall be by others.”

  6. 0607:12

    The missing scope priced, with its basis

    Price leveller

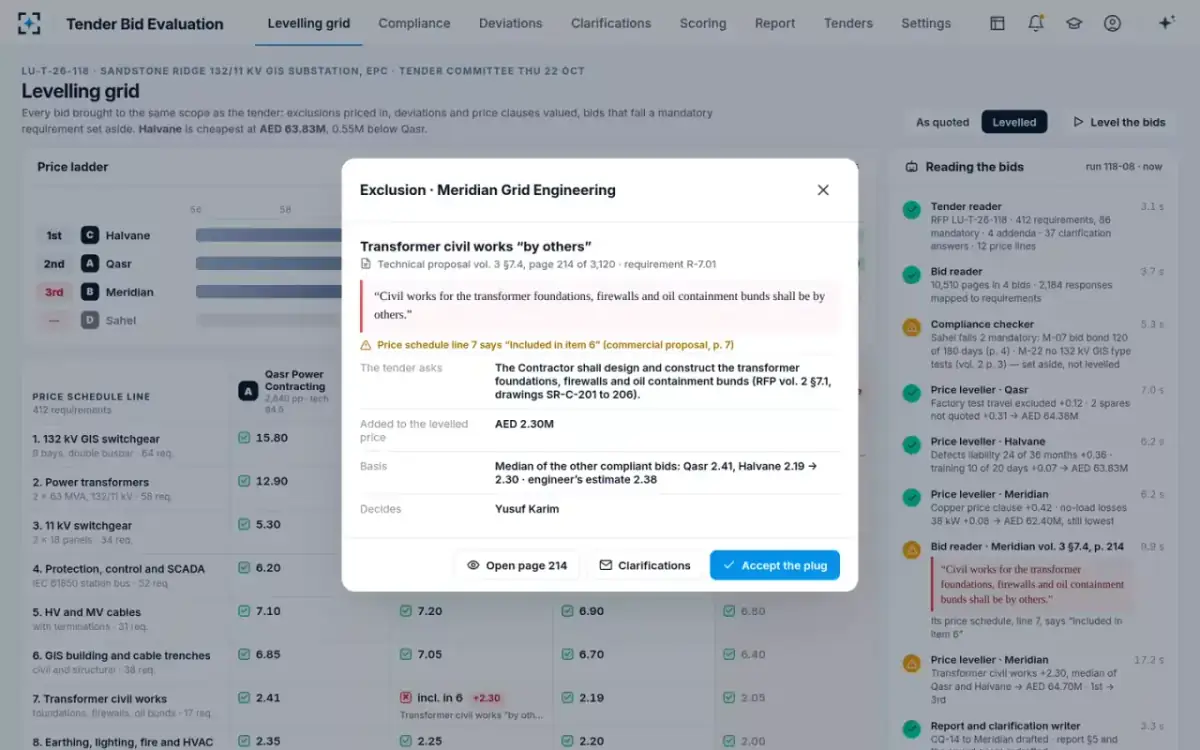

    The leveller adds $2.30M. That is the median of line 7 in the other compliant bids (Bidder D 2.41M, Bidder C 2.19M). For the same line, the engineer's estimate is 2.38M. The bid reader opens on page 214 with the sentence highlighted, beside the price line that contradicts it. Bidder B's item 6 is 7.05M. That is close to item 6 alone in the other bids (6.70 to 6.85M). It is far below their items 6 and 7 together (8.89 to 9.26M).

    “The transformer bays are not in it.”

  7. 0707:14

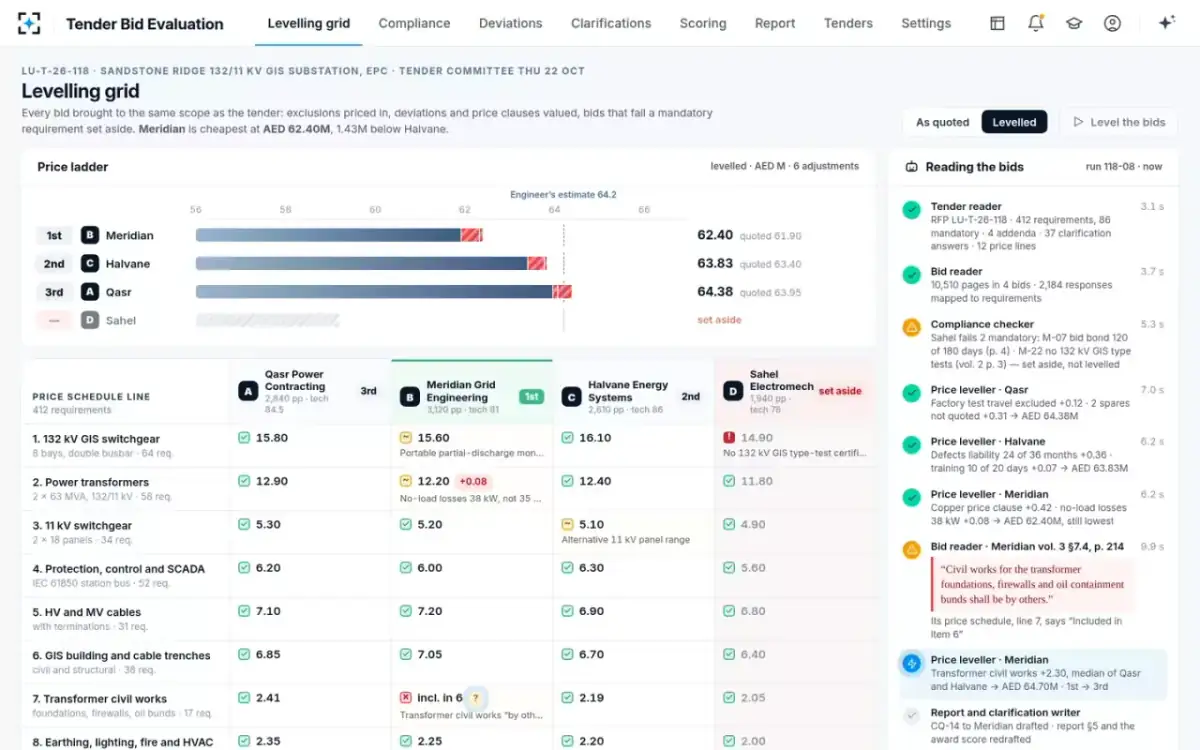

    Leveled: Bidder B drops from first to third

    Category manager

    With $2.80M of adjustments, Bidder B is leveled at 64.70M. The price ladder re-sorts on the real scope. Bidder C is now first at 63.83M, 0.55M below Bidder D at 64.38M. Bidder B is third. Each red chip in the grid is one of the leveller's 7 adjustments. The category manager can click any cell to see its source.

    “Bidder C is cheapest at $63.83M, 0.55M below Bidder D.”

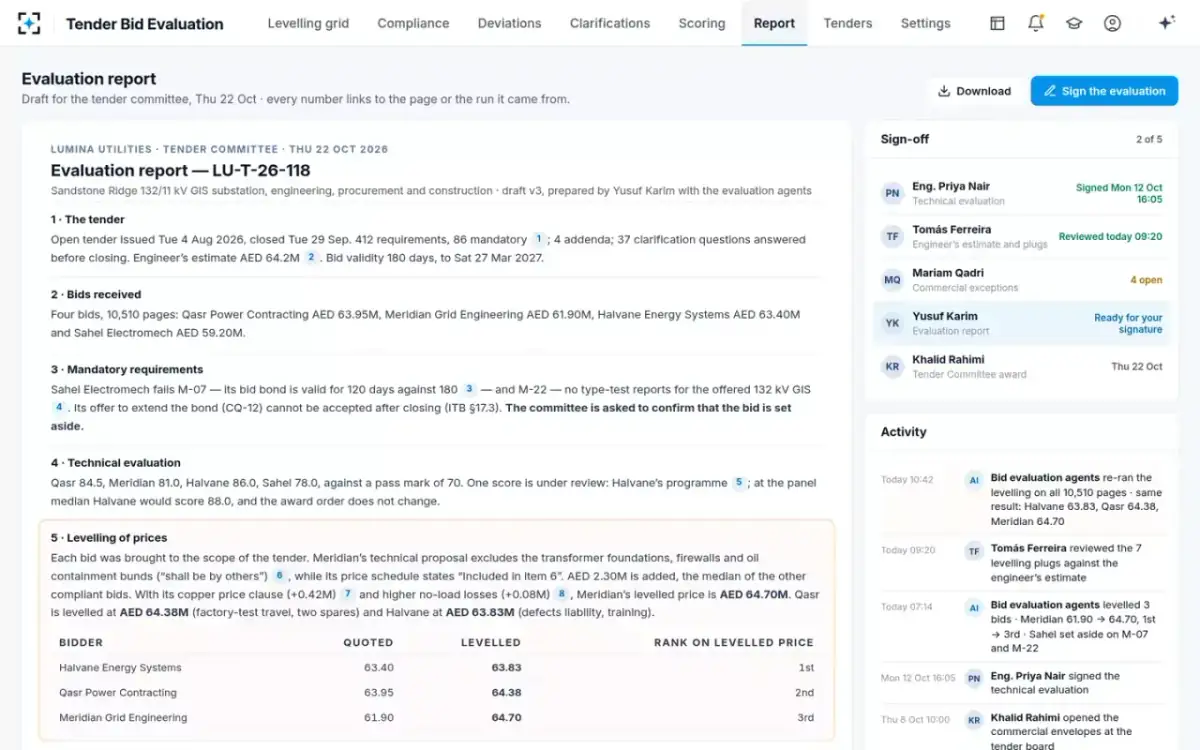

  8. 08Drafted for review

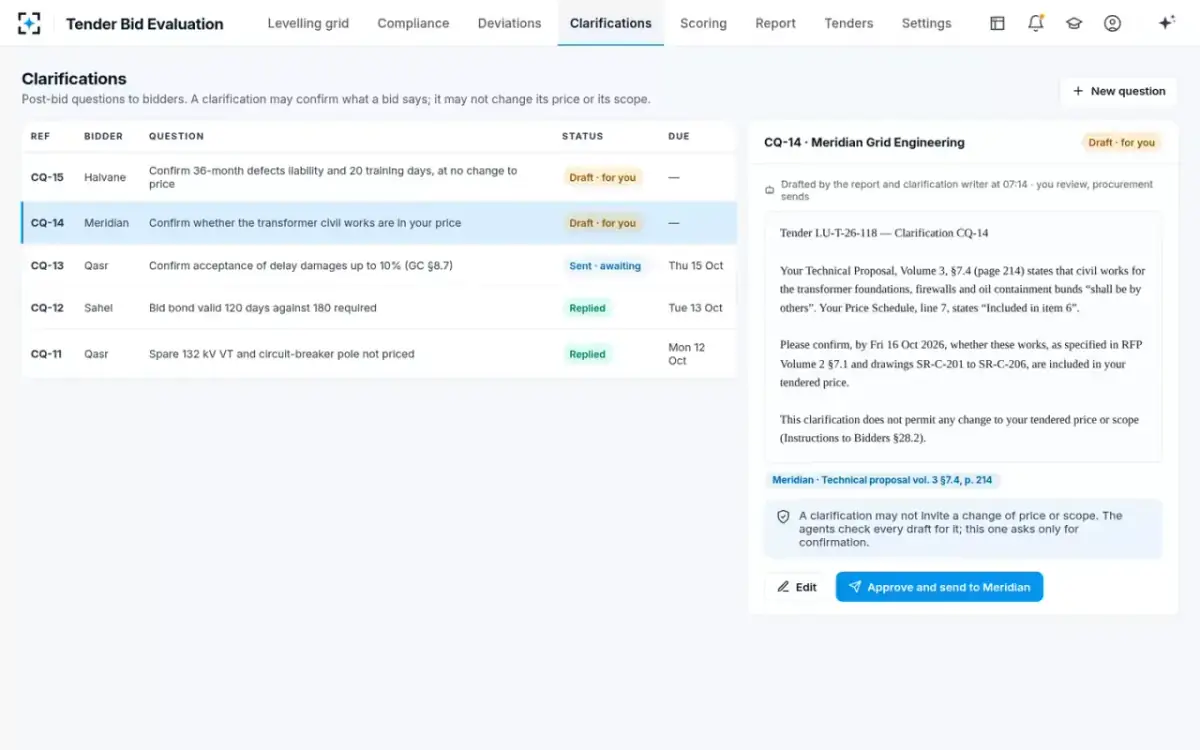

    A clarification that cannot reopen the price

    Report and clarification writer

    The clarification to Bidder B quotes page 214 and price line 7 side by side. It asks Bidder B to confirm whether the works in RFP volume 2 §7.1 are in its price. The answer is due by the clarification deadline. A second clarification asks Bidder C to confirm 36-month defects liability and 20 training days, with no change to price. The category manager reviews, and procurement sends.

    “This clarification does not permit any change to your tendered price or scope (Instructions to Bidders §28.2).”

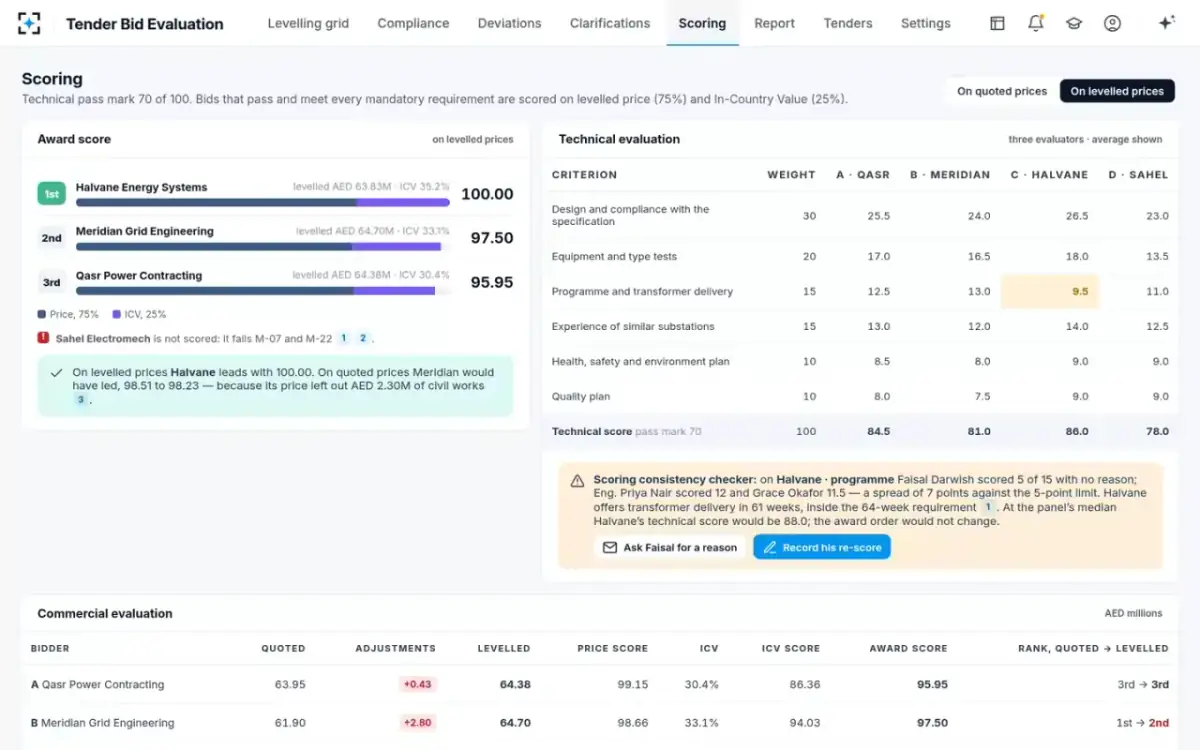

  9. 09The score

    Scores on leveled prices, and one score with no reason

    Scoring consistency checker

    A bid is scored only if it passes the technical mark of 70 and each mandatory requirement. The score weighs leveled price at 75% and the tender's other award criteria at 25%. Bidder C scores 100.00, Bidder B 97.50 and Bidder D 95.95. On quoted prices, Bidder B would have led by 98.51 to 98.23. One evaluator scored Bidder C's delivery schedule 5 of 15 and gave no reason. The other evaluators gave 12 and 11.5. That is a 7-point spread, and the limit is 5 points.

    “At the panel's median, Bidder C's technical score would be 88.0. The award order would not change.”

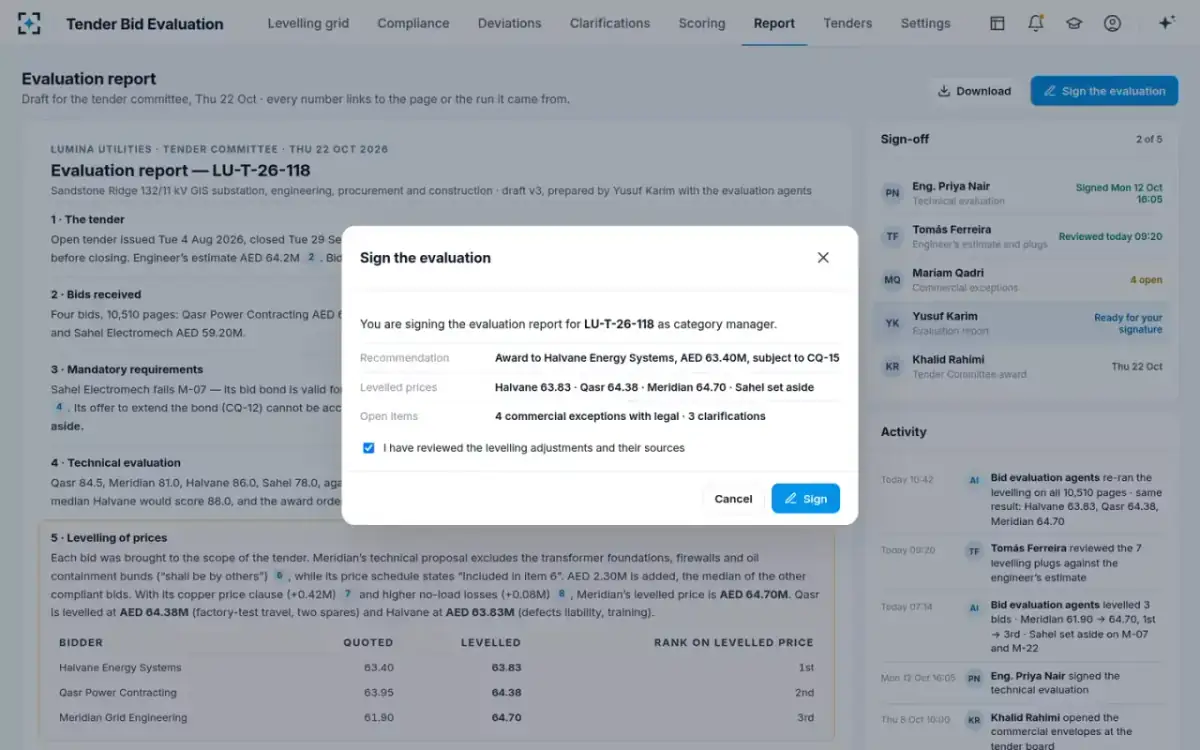

  10. 10Signed

    The evaluation, cited and signed for committee

    Category manager

    The draft report has nine sections. Each number links to the page or the run it came from. It recommends an award to Bidder C at its tendered $63.40M, subject to its clarification. That avoids a scope gap of about $2.30M that would come back as a variation. It is also $0.87M lower than Bidder B for the same scope. The lead engineer has already signed the technical evaluation. Now the category manager signs, confirming they reviewed the leveling adjustments and their sources.

    The agents draft, and the Tender Committee awards.

Who it’s for

Category manager, engineers, counsel and committee on one evaluation

Five people each own a part of the substation tender, from the technical score to the award. Here is their work before and after the agents.

Category manager
Prepares and signs the evaluation
Before
Runs four live tenders and prepares each evaluation for the committee. Knows the cheapest bid is often cheap for a reason nobody finds in time.
Now
Opens the leveling grid with each exclusion priced in, each adjustment showing its basis, and the clarifications already drafted for review.
Lead substation engineer
Signs the technical evaluation
Before
Scores technical proposals against the specification between design reviews. Knows the deviations that matter are rarely in the deviation schedule.
Now
Sees each technical deviation with the sentence and page it came from. Decides which ones go to engineering, such as Bidder B's portable partial-discharge monitoring.
Contracts counsel
Decides commercial exceptions
Before
Reviews each commercial exception and clarification letter. A price clause on page 38 is a negotiation nobody agreed to.
Now
Gets each liability cap, price adjustment, security and payment exception in one register, with its clause and page, waiting for a decision.
Cost engineer
Owns the engineer's estimate
Before
Owns the estimate that missing scope is priced from. Wants to know where any number added to a bid came from.
Now
Reviews the 7 amounts added to the bids against the estimate. Each one shows the other bids' prices it came from.
Tender committee chair
Chairs the committee, awards above $10M
Before
Approves awards above $10M. Must be able to show why, line by line, if a bidder challenges.
Now
Receives an evaluation report where each number links to the bid page or the run behind it. Each person who owns a part has signed it.
The agents

The agents that read, mark and level each bid in an evaluation

Each page is read against each requirement, and each exclusion is priced, before the report is drafted. The committee awards.

Tender reader

Reads each tender volume, each addendum and each answer given before closing. Turns them into requirements, mandatory items, price lines, criteria and weights. Each requirement is one testable statement with its clause.

  • Never rewrites a requirement, only quotes it
  • Each requirement cites its clause
  • A later addendum replaces the earlier text
Bid reader

Reads each bid in full, including technical volumes, drawings, certificates, the delivery schedule and the commercial proposal. Maps each response to the requirement it answers. Finds exclusions (“by others”, “not included”, “excluded”), deviations and qualifications in any volume, including outside the deviation schedule.

  • Never decides a mandatory requirement on its own
  • Each finding quotes its sentence and page
  • Where two volumes disagree, quotes both
Compliance checker

Marks each requirement for each bid as compliant, deviation, exclusion or clarification. Lists each mandatory failure with its evidence for the committee.

  • Never disqualifies a bidder. It recommends, and the committee decides
  • A mandatory failure needs two pieces of evidence or a clarification
Price leveller

Brings each compliant bid to the same scope. For each exclusion it adds the median price of the other compliant bids, or the engineer's estimate when fewer than two price it. It prices guaranteed losses above the specification over the asset's life. Commodity clauses are priced at forward market prices, and short warranties at the extended-warranty rate.

  • Never changes a quoted price
  • Each adjustment shows its basis
  • Never levels a bid that fails a mandatory requirement
Scoring consistency checker

Compares the three evaluators' technical scores for each criterion and bid. Flags a spread over the limit and any score without a written reason. Shows the score at the panel median and whether the award order changes.

  • Never scores a bid and never changes a score
  • Names the evaluator only to the category manager
Report and clarification writer

Drafts clarification questions that quote the bid and the tender side by side and ask only for confirmation. Drafts the evaluation report section by section from the run, with each number linked to its source.

  • Never sends anything to a bidder or the committee
  • Never invites a change of price or scope
  • Drafts only. The category manager signs and procurement sends
Tender committee

Awards, after the category manager signs and legal decides exceptions.

Ask in plain words

Bids, requirements and price lines, answered with the page they came from

Ask about any bid, requirement or price line. Each answer cites the page it came from.

Why did Bidder B drop to third?

Bidder B quoted the lowest compliant price, $61.90M. Its technical proposal (vol. 3 §7.4, p. 214) says the transformer foundations, firewalls and oil bunds “shall be by others”. Yet its price schedule line 7 says “Included in item 6”. The leveller added $2.30M, the median of Bidder D's 2.41M and Bidder C's 2.19M. That is close to the engineer's estimate of 2.38M. The copper clause and higher losses add more. Bidder B is leveled at 64.70M, behind Bidder C at 63.83M and Bidder D at 64.38M.

Which bids fail a mandatory requirement?

Only Bidder A, on two counts. Its bid bond is valid for 120 days where the tender asks for 180. There are also no type-test reports for the offered GIS, which “will be submitted after award”. In reply to its clarification, Bidder A offered to extend the bond. But the Instructions to Bidders (ITB §17.3) do not allow bid security to be corrected after closing. The committee confirms the bid is set aside.

Draft the clarification to Bidder B on the civil works

Drafted. The letter quotes p. 214 and price line 7 side by side. It asks Bidder B to confirm by the clarification deadline whether the works in RFP vol. 2 §7.1 are in its price. A closing line states that no change of price or scope is permitted (ITB §28.2). You approve it, and procurement sends it.

Are the technical scores consistent?

One is not. One evaluator scored Bidder C's delivery schedule 5 of 15 with no reason. The lead engineer gave 12 and the third evaluator 11.5, a 7-point spread. Bidder C offers transformer delivery in 61 weeks, inside the 64-week requirement. At the panel median, Bidder C's technical score is 88.0 instead of 86.0. The award order does not change.

The screens

The leveling grid, the hidden exclusion, the scores and the signed report

From the working solution, on its sample data. Pick one to see it large.

The leveling gridThe bids side by side, price line by price line. Each requirement is marked compliant, deviation, exclusion or to clarify. The price ladder re-sorts on leveled prices.
As quotedThe same four bids as the bidders priced them. Two look cheapest before any scope is compared.
The hidden exclusionThe agents' run beside the grid. The bid reader quotes Bidder B's “by others” sentence from page 214, next to its price line.
A finding and its sourceAny cell opens its finding. It shows the bid sentence and page, what the tender asks, the amount added, its basis and who decides.
The bid readerThe bid page with the sentence highlighted, the pages with findings, the price line that contradicts it and the basis for the added amount.
A mandatory failureBidder A's bid bond, valid 120 days against 180, quoted from page 4 and sent to the committee to confirm.
The compliance matrix412 requirements against each bid, with counts per bidder, the mandatory items and the 47 requirements where a bid differs.

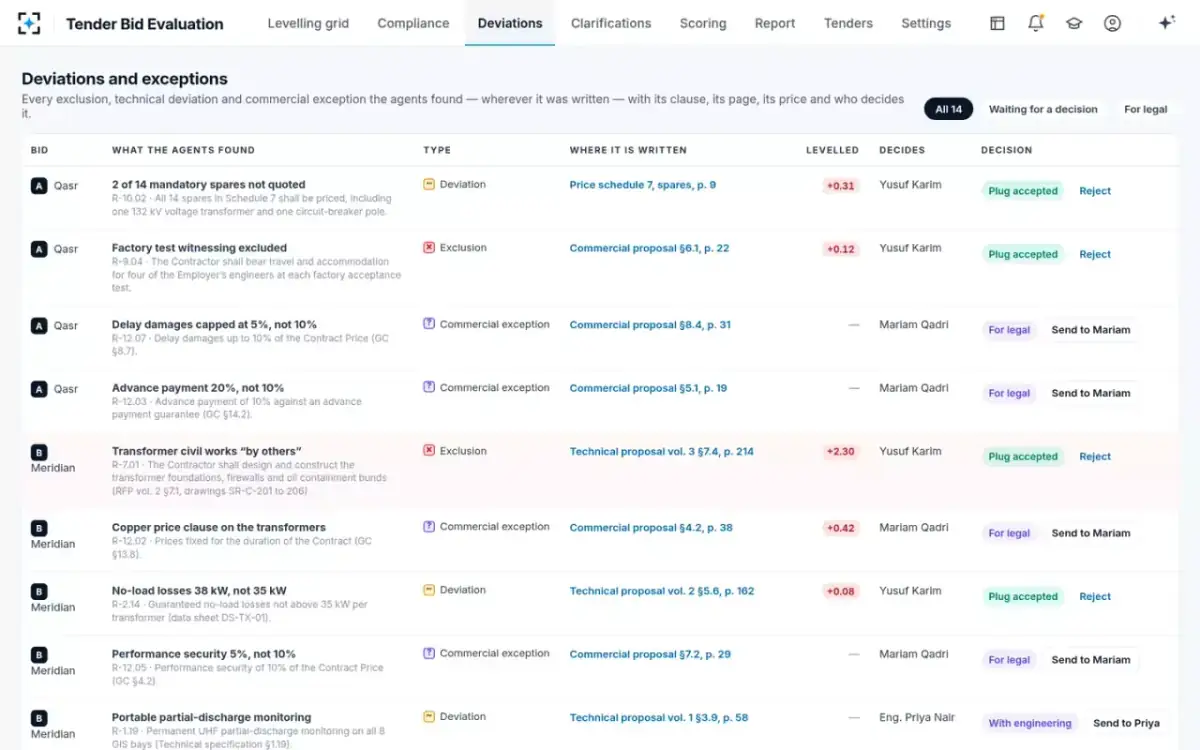

Deviations and exceptionsEach exclusion, technical deviation and commercial exception with its clause, page, price and who decides it.
ClarificationsPost-bid questions with their status and due dates. One is drafted for review and confirms scope without inviting a price change.
ScoringThe award score on leveled prices and other criteria, technical scores by criterion, and the flag on one evaluator's score.
The evaluation reportThe draft report for the Tender Committee, each number linked to its page, with the sign-off chain and the activity trail.
Sign the evaluationThe recommendation, the leveled prices and the open items on one screen before the category manager signs.
Evaluation rulesThe pass mark, award weights, abnormally low threshold, how exclusions and losses are priced, and the approvers.
Governance

Quoted findings, sealed prices and named sign-offs on each tender

Each finding quotes its pageRequirements cite their tender clause. Findings quote the bid sentence and its page. Each number in the evaluation report links to the page or the run it came from.
Agents never disqualify or repriceThe agents recommend. They do not set a bidder aside, change a quoted price or level a bid that fails a mandatory requirement. The committee confirms each set-aside.
Each added amount shows its basisEach leveling adjustment shows where its number came from. That is either the other compliant bids' prices for the same line, or the engineer's estimate. The cost engineer reviews each one against that estimate.
Sealed commercial envelopesTechnical evaluators see prices only after the technical stage is signed. Bids stay sealed until their envelope is opened at the tender board.
Clarifications that cannot move the priceEach draft clarification is checked so it asks only for confirmation. It must not invite a change of price or scope. Nothing reaches a bidder until the category manager approves and procurement sends it.
Named sign-offs, on the audit trailThe lead engineer signs the technical evaluation. Contracts counsel decides commercial exceptions. The category manager signs the evaluation, and the Tender Committee awards. Signatures and decisions are recorded on the audit trail, and changes to settings are versioned.
Configuration

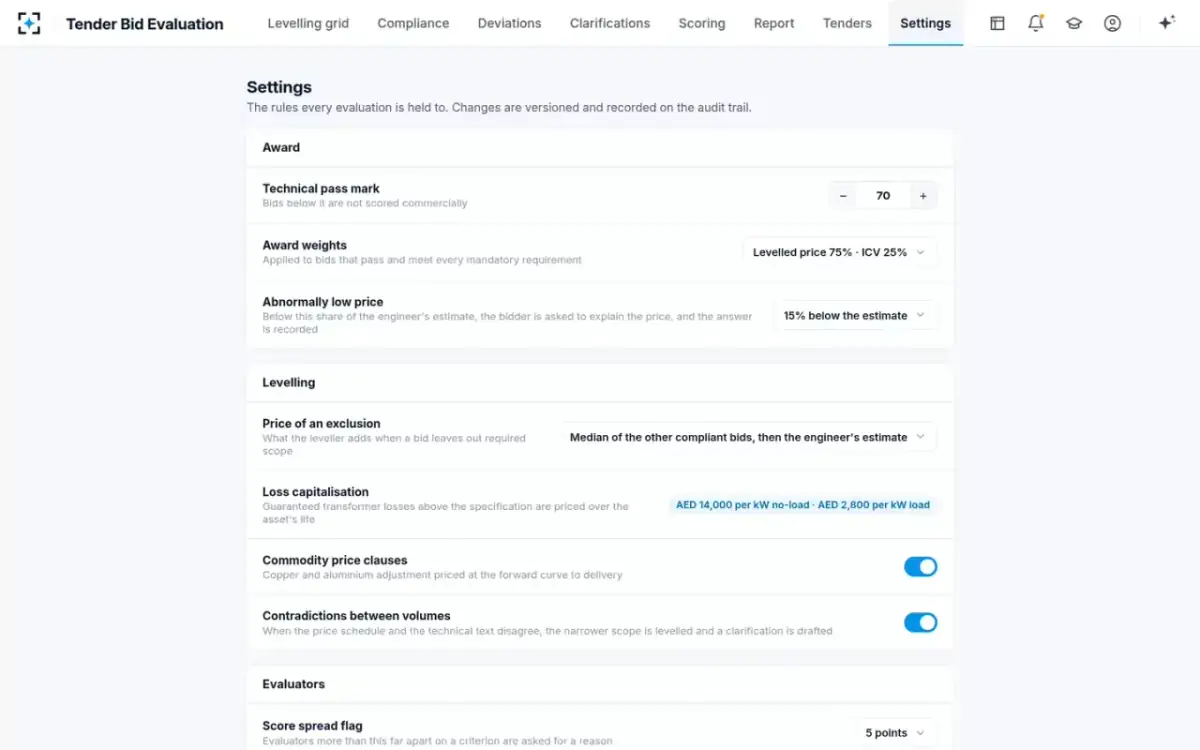

Pass mark, award weights, exclusion pricing and approvers for each tender

The pass mark, the award weights, how an exclusion is priced and who signs are settings. Procurement chooses them. Changes are versioned and recorded on the audit trail.

SettingDefaultChoose from
Technical pass mark70Set with − and +. Bids below it are not scored on price
Award weightsLeveled price 75% · other criteria 25%Leveled price 75% · other criteria 25% · Leveled price 60% · other criteria 40% · Leveled price 100%
Abnormally low price15% below the estimate10% · 15% · 20% below the engineer's estimate. The bidder is asked to explain the price, and the answer is recorded
Price of an exclusionMedian of the other compliant bids, then the engineer's estimateMedian of the other compliant bids, then the engineer's estimate · Highest of the other compliant bids · Engineer's estimate only
Loss capitalization$14,000 per kW no-load · $2,800 per kW loadGuaranteed transformer losses above the specification are priced over the asset's life
Contradictions between volumesOnOn · Off. When the price schedule and the technical text disagree, the narrower scope is leveled and a clarification is drafted
Score spread flag5 points3 points · 5 points · 8 points. Evaluators further apart than this on a criterion are asked for a reason
AwardsTender Committee · committee chairTender Committee · Director of Procurement alone, for packages above $10M
Connections

RFP volumes, technical and commercial proposals and the engineer's estimate

RFP and tender specificationvolumes, drawings, data sheets, addenda and the pre-closing answers
Technical proposalstechnical volumes, type-test certificates, delivery schedules and deviation schedules
Commercial proposals and price schedulesprices line by line, bid bonds, securities, liability and payment terms
Clarification logspost-bid questions, bidders' replies and their due dates
Evaluation criteria and weightstechnical criteria, pass mark, price weight and the other award criteria
Engineer's estimatethe cost engineer's price for each line, sealed until the commercial envelopes open
What it changes

Hidden scope found and a faster, traceable tender award

Each figure carries its label: a target the solution is built to, an estimate, a typical published result, or a proven one.

demo
$2.8M
of hidden scope and price clauses found in the cheapest bid before award, in the sample tender
As quoted$61.90M · 1st
Leveled$64.70M · 3rd
target
100%
of scores and findings traced to the bid page, ready for a challenge or an audit
14 of 14 findings
each quoted with its page
target
8days
from opening the bids to the committee report, so long-lead transformers are ordered sooner
By hand≈ 6 weeks
With agents8 working days

“Demo” means seen in the working solution, on its sample tender. “Target” is the design goal, measured in the live solution. “Estimated” is our own estimate, used for the working-day split. That split assumes about 10,500 pages and three evaluators, about 6 weeks by hand, or 30 working days. “Typical” means published figures. Transformer lead times of 2 to 3 years come from MarketScale 2025. Savings of about 2 to 3% of contract value come from University of California best-value pilots, reported in California Senate bill analyses. Regulatory context: EU Directive 2014/25/EU Art. 84 and CJEU case C-669/20 Veridos, on abnormally low tenders. Names on the screens are sample data.

Questions

Tender bid evaluation questions from procurement and engineering

What is tender bid evaluation software?

It is software that takes a tender from the opened bids to an evaluation ready for committee. It produces a compliance matrix per bidder, a register of deviations and exceptions, a bid leveling sheet and a draft evaluation report. Tender Bid Evaluation adds six agents. They read each page of each bid against the tender's requirements and price each exclusion into a leveled price. The category manager signs and the tender committee awards.

How does bid leveling work?

Each compliant bid is brought to the scope of the tender. An exclusion is priced at the median of the other compliant bids for the same line. When fewer than two bids price it, the engineer's estimate is used. Guaranteed losses above the specification are priced over the asset's life. Commodity price clauses and warranty shortfalls are valued too. The quoted price does not change. The adjustments sit beside it, each with its basis.

How does it find exclusions that are not in the deviation schedule?

The bid reader reads each volume, including the parts outside the deviation schedule. It looks for phrases such as “by others”, “not included” and “excluded”. Where two volumes disagree, it quotes both. In the sample tender, it found the apparent winner's transformer civil works marked “by others” on page 214. Its price schedule said “Included in item 6”.

Does it disqualify bidders or change their prices?

No. The compliance checker recommends a set-aside with its evidence, and the committee decides. The price leveller does not change a quoted price or level a bid that fails a mandatory requirement. Clarifications may only ask a bidder to confirm what its bid says. They can never ask for a change of price or scope.

How does it handle an abnormally low tender?

A setting defines the threshold, 15% below the engineer's estimate in the sample. Below it, the bidder is asked to explain its price, and the answer is recorded on the evaluation file. EU utilities procurement law requires a utility to ask for that explanation (Directive 2014/25/EU, Art. 84).

Can it apply our own pass mark and award weights?

Yes. Bids that pass the technical mark and each mandatory requirement are scored on leveled price and your other award criteria. You set the weights: 75% and 25% in the sample, or 60/40, or price alone. The pass mark, the score spread that flags evaluators and the approvers are settings too.

Who signs the evaluation, and who awards?

People do. The agents read, mark, price and draft. They do not send anything to a bidder or the committee. The lead engineer signs the technical evaluation, and contracts counsel decides commercial exceptions. The category manager signs the evaluation and the Tender Committee awards. Each step is on the audit trail.

What do we provide to try it on a past tender?

Your procurement rules, evaluation criteria, report template and a sample of past tenders. The Agentic Solution Engine builds and deploys it from those requirements and documents. It goes live once each quality gate has passed. We will walk you through it on one of your own awarded tenders first.

Run tender bid evaluation
on one of your awarded tenders.

We'll run Tender Bid Evaluation on one of your own recently awarded tenders.
