- Before
- Checks more than 60 contractor invoices a month across four frameworks, rate by rate. The quantities are taken on trust. The rate can be checked, but the 480 meters cannot.
- Now
- Opens each invoice already tied to its rates and field evidence. Decides line by line and sends the notice with the proof attached.
A civil works invoice, from the supplier portal to an agreed credit note
A civil works contractor is building a low-voltage reinforcement scheme for the utility, under a civil works framework contract. At 06:42 one morning, its September invoice arrives through the supplier portal. It has 16 lines and comes to $204,436.00 before tax. Here is what happens next, screen by screen, in the working solution.
A worked example on sample data. Names, IDs and figures on the screens and in this section come from the demo.
- 0106:51

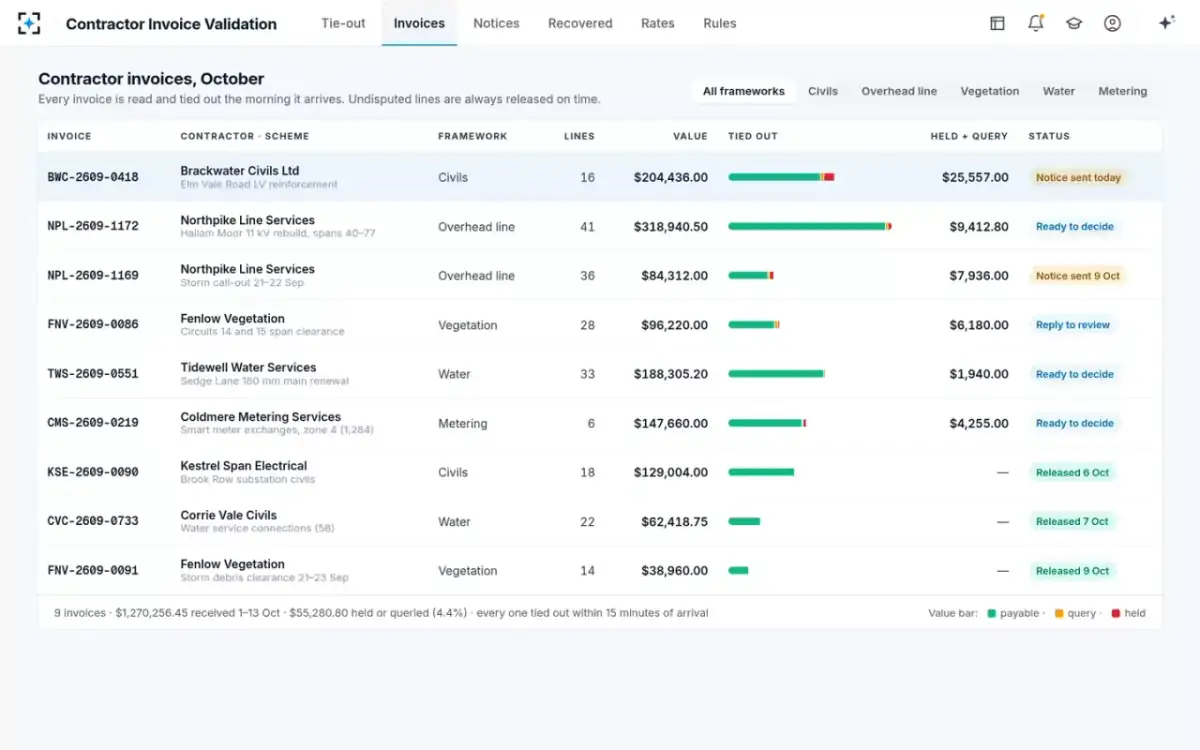

The invoice opens already tied out

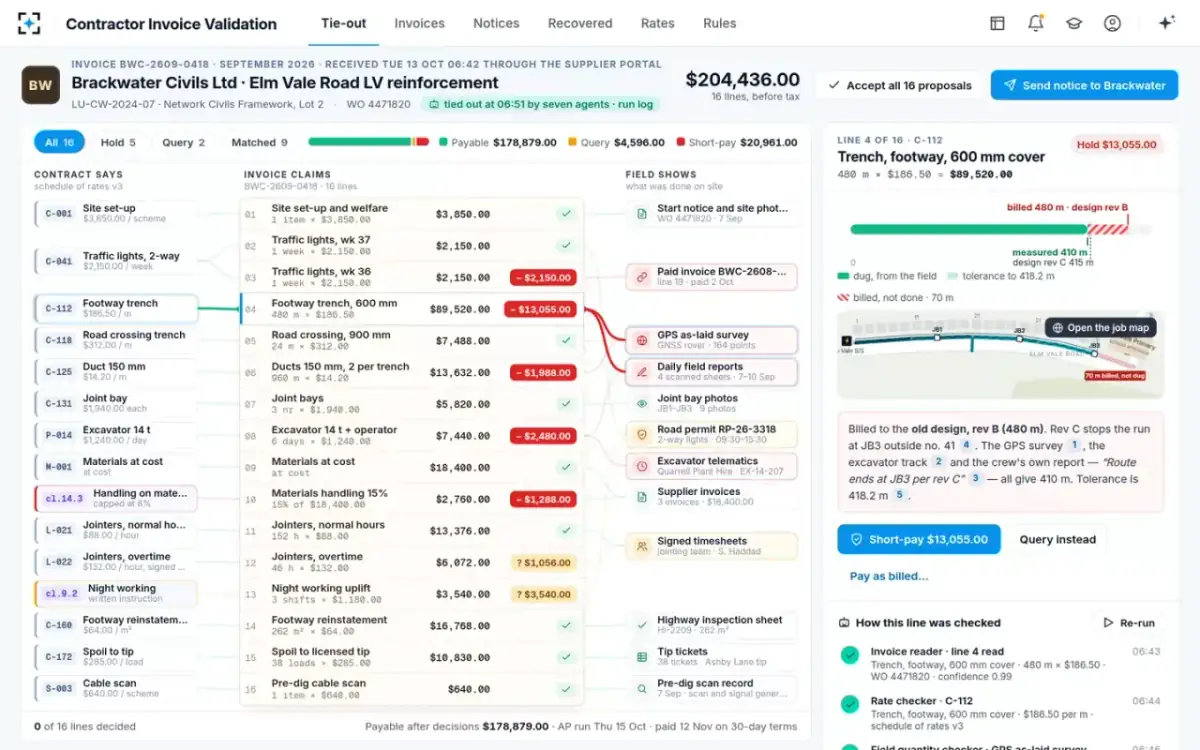

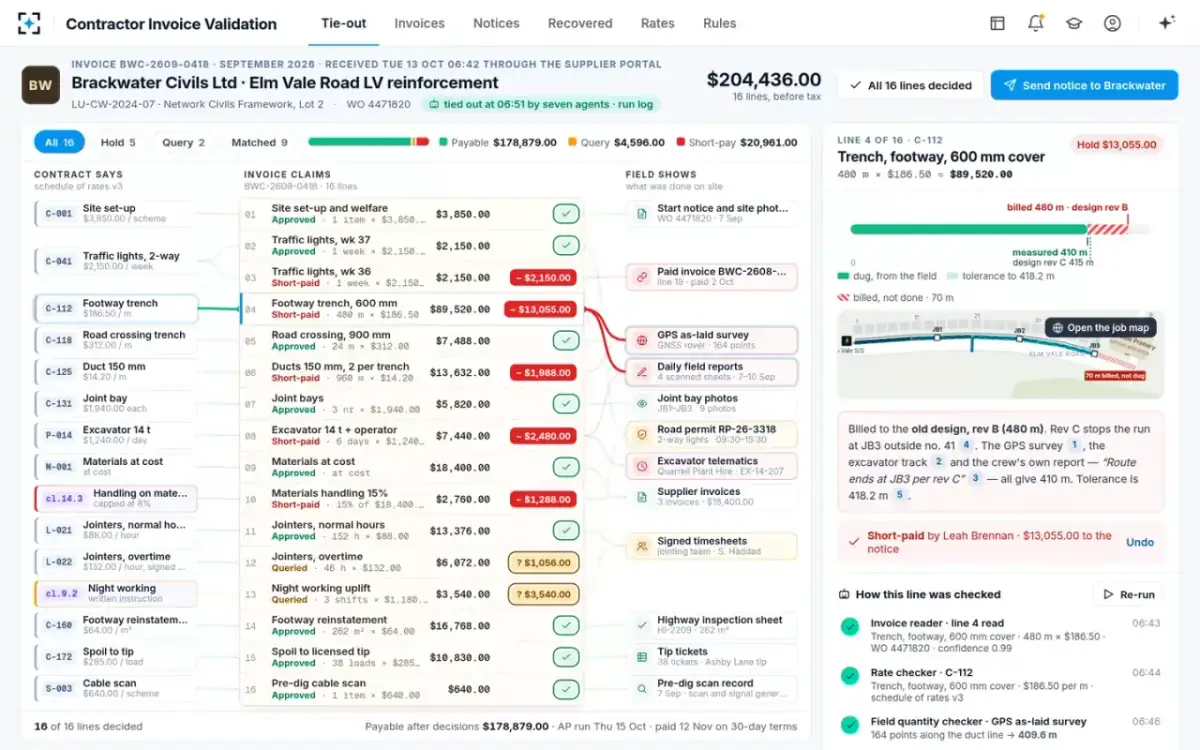

Contract administratorThe administrator checks more than 60 contractor invoices a month across four framework contracts. This one opens in three columns. They show what the contract says, what the invoice claims and what the field shows. Each line is linked to its rate on the left and its evidence on the right. Nine lines are matched, two are queried and five are held. The amount payable today is $178,879.00.
A person can check the rate by hand. Nobody can check the 480 meters that way.
- 0206:42-06:51
Each line checked in nine minutes

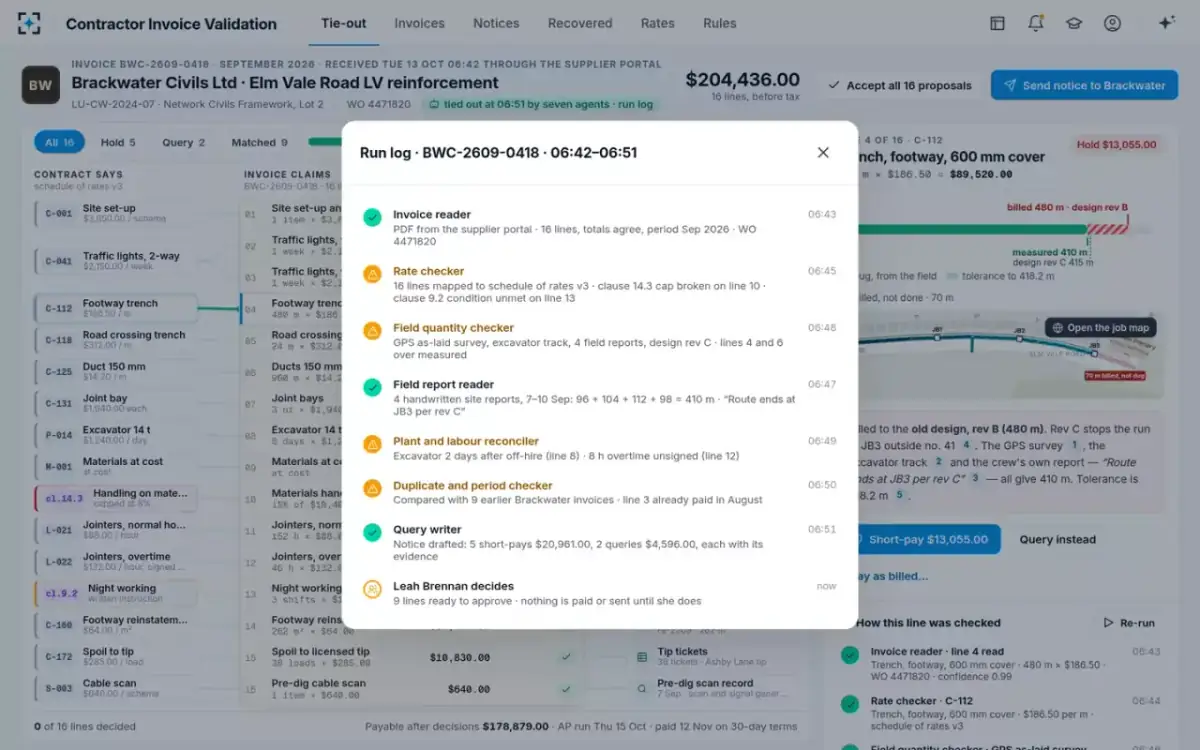

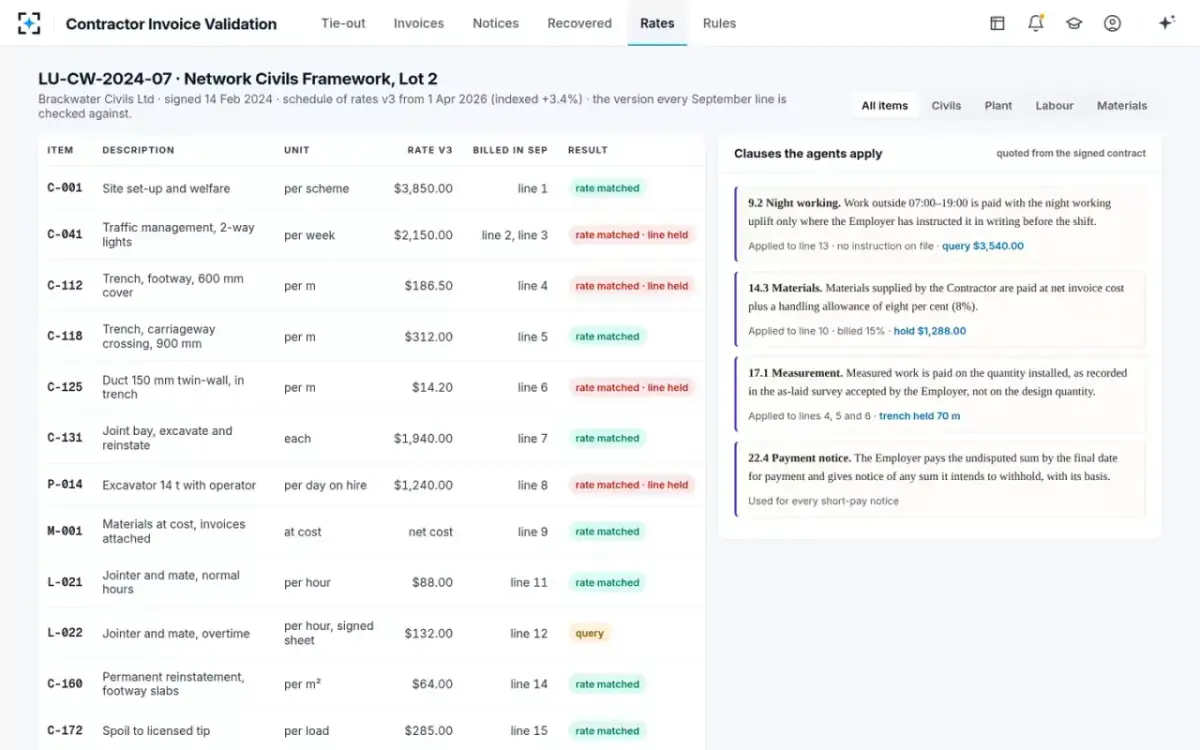

Seven agentsThe invoice reader takes the PDF from the supplier portal. It finds 16 lines for September, and the totals agree. The rate checker matches each line to schedule of rates v3. Line 10 breaks the cap in clause 14.3, and line 13 does not meet the condition in clause 9.2. The field report reader adds up four handwritten site reports of 96, 104, 112 and 98 m, for 410 m in all. The duplicate and period checker compares nine earlier invoices from the same contractor. It finds line 3 was already paid in August.
The contract administrator decides · 9 lines ready to approve · nothing is paid or sent until then
- 03Line 4
480 meters billed, 410 meters dug

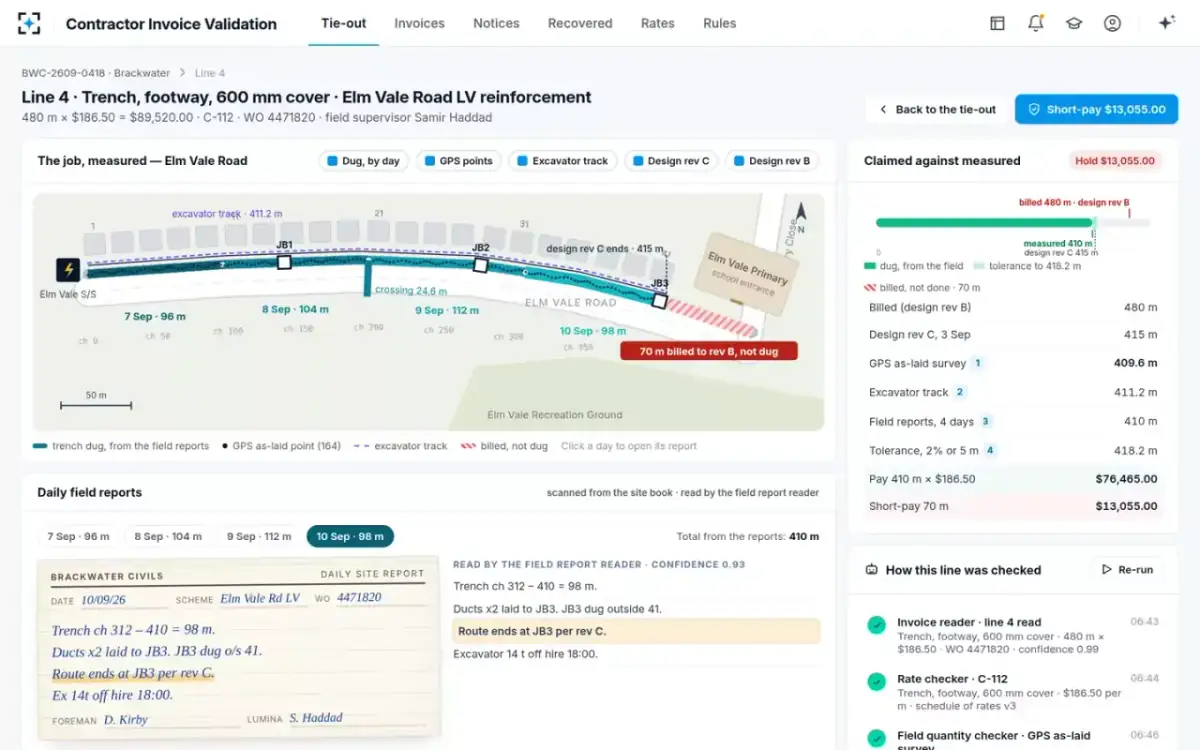

Field quantity checkerThe contractor billed 480 m of footway trench at $186.50 a meter. That is the length in design rev B. But rev C, issued earlier in the month, ends the run at joint bay JB3. The GPS as-laid survey measures 409.6 m from 164 points. The excavator track gives 411.2 m, and the crew's four daily reports give 410 m. With a tolerance of 2% or 5 m, the most that can be paid is 418.2 m. The proposal is to pay for 410 m, $76,465.00, and short-pay 70 m, $13,055.00, which means holding back that part of the payment.
From the crew's own daily report: “Route ends at JB3 per rev C.”
- 04Line 8
Six excavator days billed, four on hire

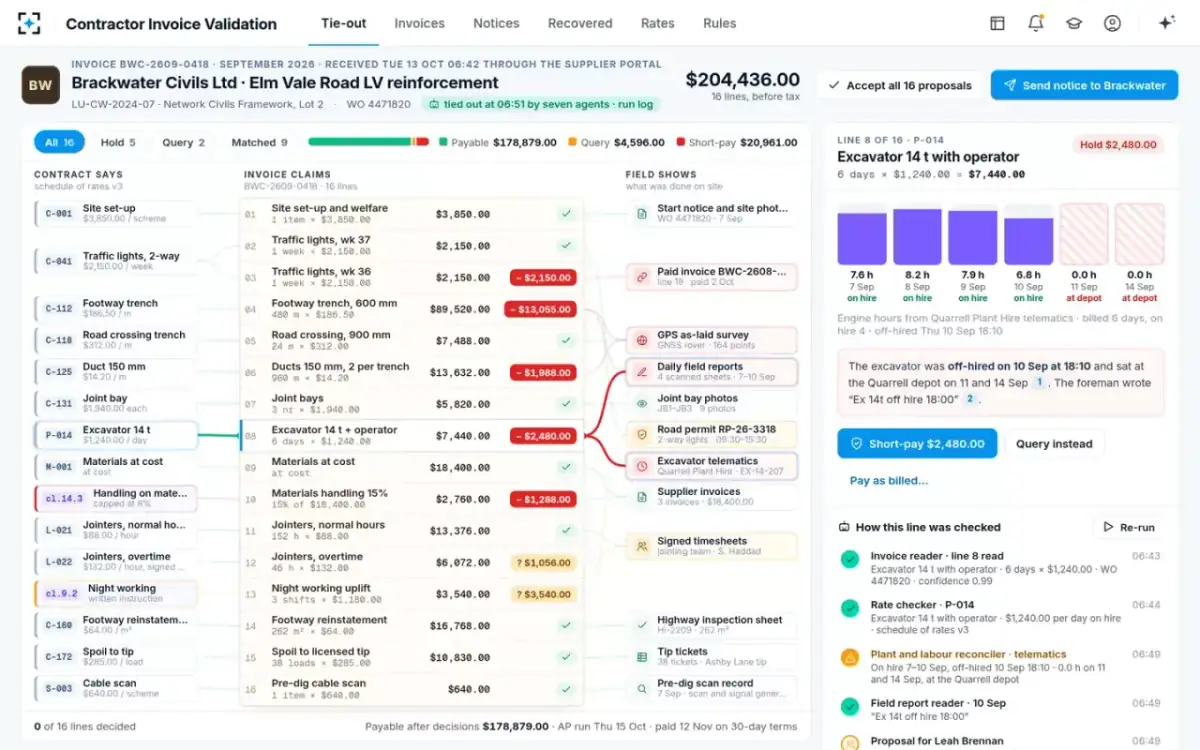

Plant and labour reconcilerThe 14 t excavator with operator is billed for 6 days at $1,240.00 a day. The hire company's telematics, the machine's own engine data, show four working days: 7.6, 8.2, 7.9 and 6.8 engine hours. On the next two working days it sat at the depot with 0.0 hours. It went off hire at 18:10 on the fourth day, and the foreman wrote “Ex 14t off hire 18:00”. So two days, $2,480.00, are held.
The ducts follow the trench, and 2 × 410 m is 820 m. So 140 m of duct on line 6 is held too, $1,988.00.
- 05Lines 12 and 13
Two lines get a question instead of a hold

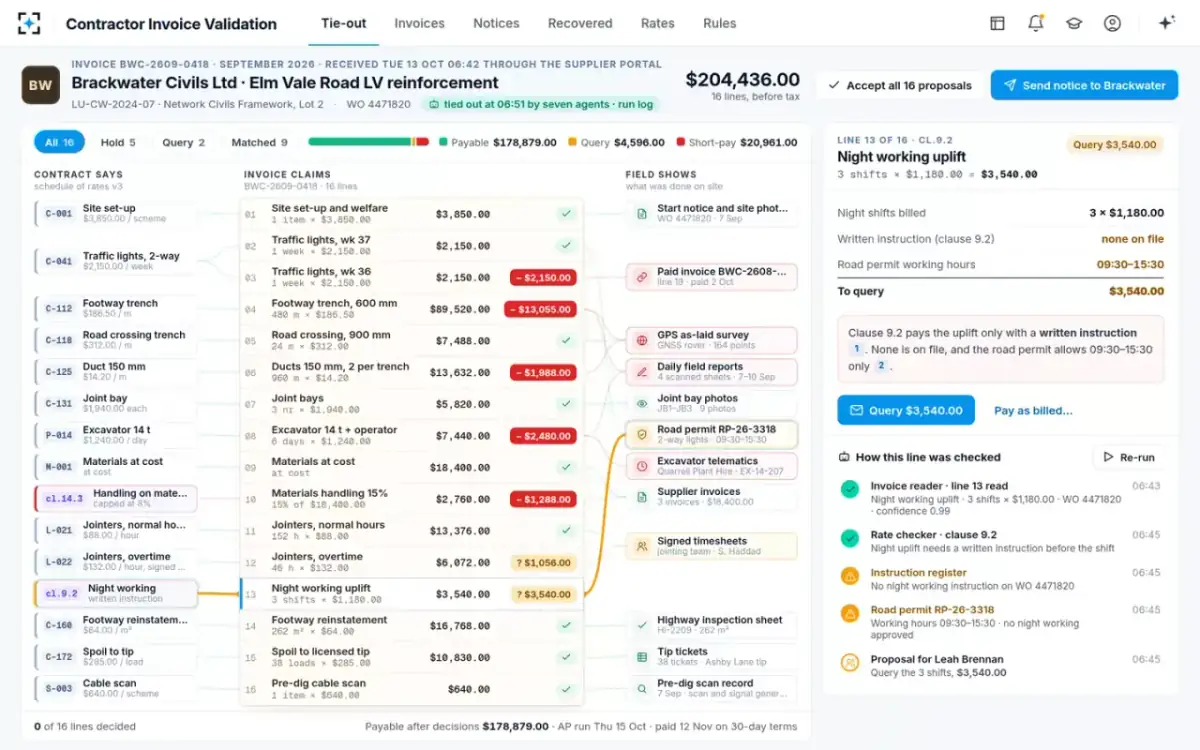

Rate checkerClause 9.2 pays the night uplift, the extra rate for night work, only if the Employer gave a written instruction before the shift. No instruction is on file. The road permit also allows work only from 09:30 to 15:30. So three night shifts, $3,540.00, are queried. On line 12, three weekly sheets are signed for 38 of the 46 overtime hours. The 8 hours on a Saturday have no signature, so $1,056.00 is queried.
For line 12, the contractor can send the signed sheet, or the field supervisor can confirm the hours.
- 06Decided
Sixteen lines decided, each by name
Contract administratorThe administrator accepts the proposals. Nine lines are approved, 5 are short-paid ($20,961.00) and 2 are queried ($4,596.00). Each line now shows its decision. Line 4 shows who short-paid it and the $13,055.00 sent to the notice, with Undo beside it. The administrator could have queried line 4 instead. Any line can also be paid as billed, with a reason that goes to the audit trail.
16 of 16 lines decided · payable after decisions $178,879.00 · released to the next AP run · paid on 30-day terms.
- 0707:20
The notice goes with its proof

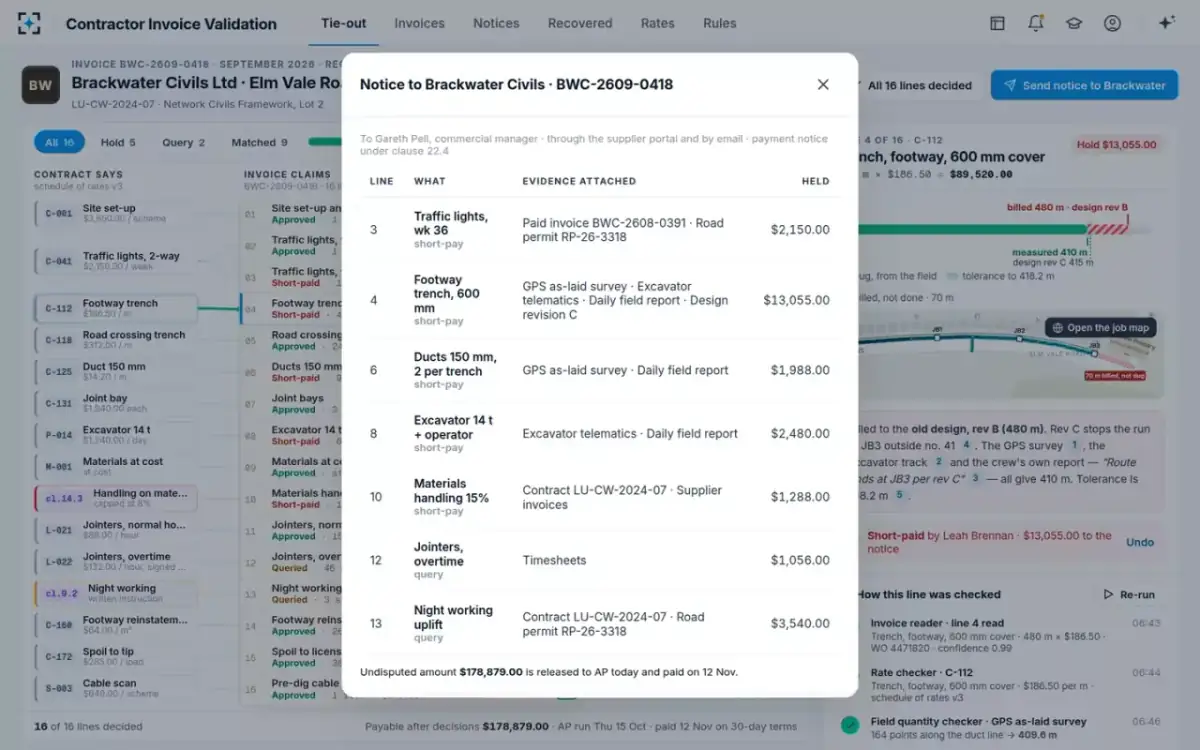

Query writerThe query writer has drafted the payment notice under clause 22.4, addressed to the contractor's commercial manager. Each of the seven disputed lines lists the evidence attached. That includes the paid August invoice, the road permit, the GPS survey and the excavator telematics. The daily field report, design revision C, the contract, the supplier invoices and the timesheets are attached too. The administrator reads the notice and sends it at 07:20.
The undisputed $178,879.00 is released to accounts payable today and paid on 30-day terms.
- 0811:05
The contractor agrees, from the supplier portal

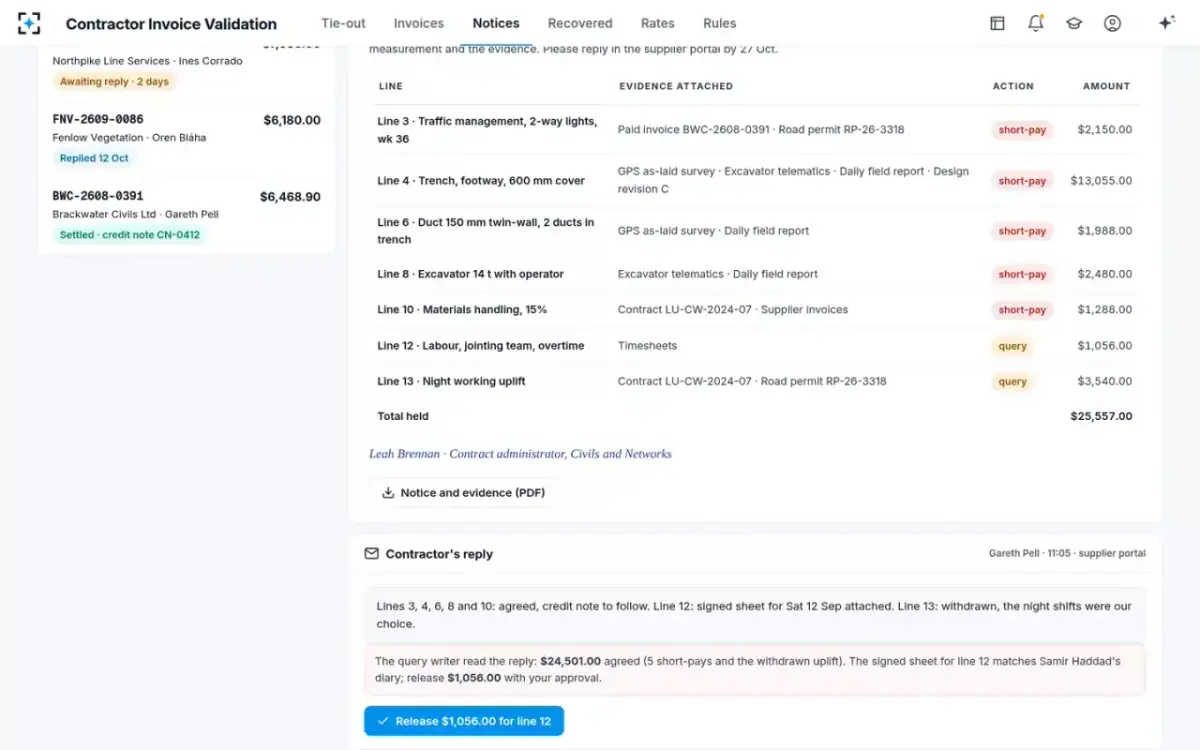

Contractor's commercial managerThe contractor replies in the supplier portal. “Lines 3, 4, 6, 8 and 10: agreed, credit note to follow. Line 12: signed sheet for the Saturday attached. Line 13: withdrawn, the night shifts were our choice.” The query writer reads the reply. It finds $24,501.00 agreed, and the signed sheet for line 12 matches the field supervisor's diary. The $1,056.00 for line 12 is released once the administrator approves.
Before this notice, the contractor had asked that any short-pay show the measurement behind it.
- 09The ledger
Each dollar stopped, with its evidence

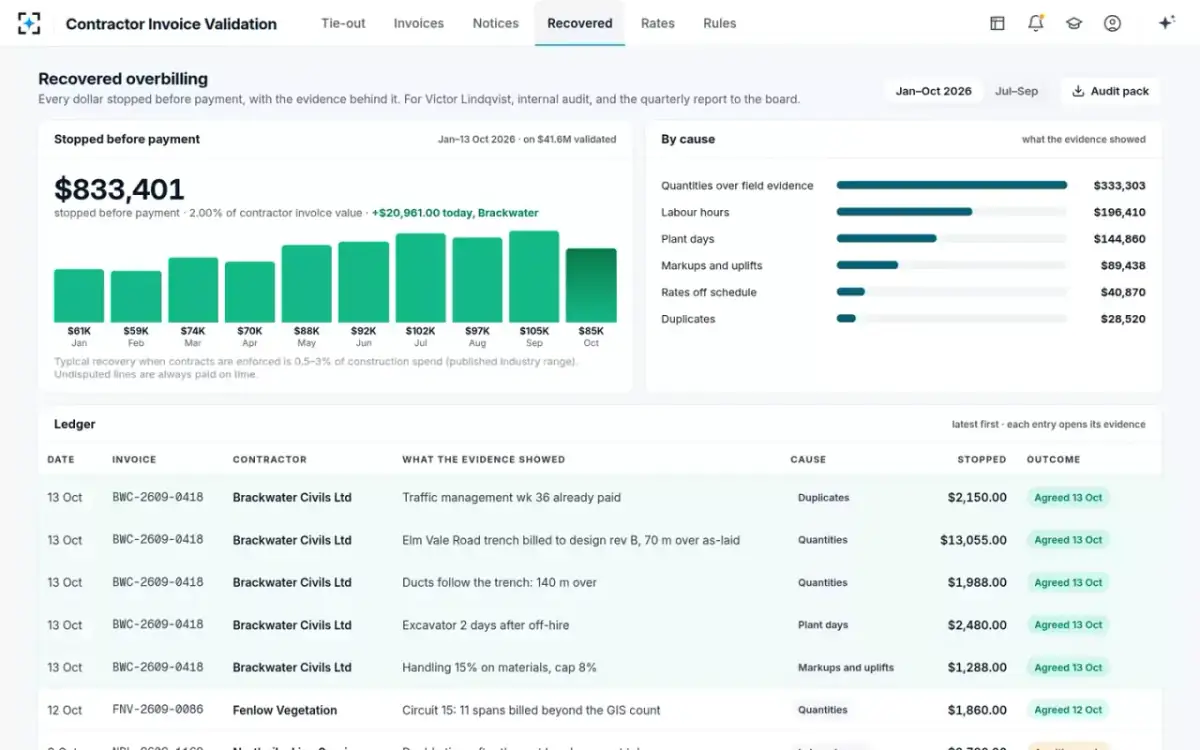

Internal audit managerThe recovered-overbilling ledger shows $833,401 stopped before payment this year. That is 2.00% of contractor invoice value, and this invoice adds $20,961.00 today. The biggest cause is quantities billed above the field evidence, at $333,303. Labor hours and plant days come next. Each entry opens its evidence, for internal audit's quarterly sample and for the report to the board.
Internal audit asks for the evidence behind each dollar stopped, and each one paid.
- 10The pattern
The third time billed to the design length

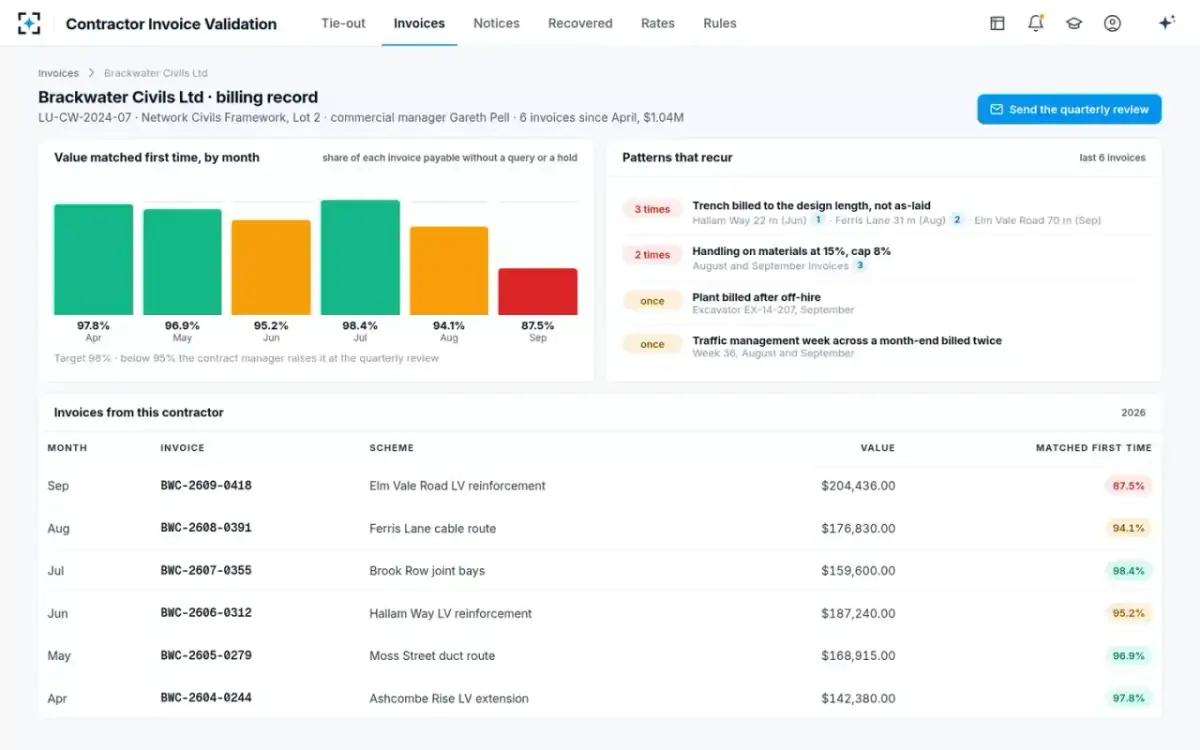

Contract administratorThe contractor's billing record shows how much of each invoice was payable with no query or hold. It was 98.4% in July, 94.1% in August and 87.5% in September, against a target of 98%. Trench has now been billed to the design length instead of the as-laid length three times. That was 22 m on one street in June, 31 m on another in August and 70 m on this job in September. When the share falls below 95%, the contract manager raises it at the quarterly review.
Another repeat: handling on materials billed at 15% against a contract cap of 8%, on both the August and September invoices.
