- Before
- Owns 46 contracts with ICV pledges and 212 supplier certificates, and reports local spend to the board each quarter. “Every supplier pledges 45%. Nobody shows me the invoices.”
- Now
- Opens a ledger of every pledge beside what the invoices show, traces each gap to its lines and signs the finding with the evidence attached.
How ICV compliance works: one pledge and one tender, screen by screen
Lumina Utilities, an electricity and water utility, has 46 contracts with ICV pledges worth AED 2.41B. Gulfstar Cable Industries supplies its 132 kV and 11 kV power cable under framework LU-C-2291, AED 184.6M, and the renewal decision is due Nov 30, 2026 — 48 days from today. Tender LU-T-2026-118 for ring main units goes to committee on Thursday. Here is what happens, screen by screen, in the working solution.
- 01Morning

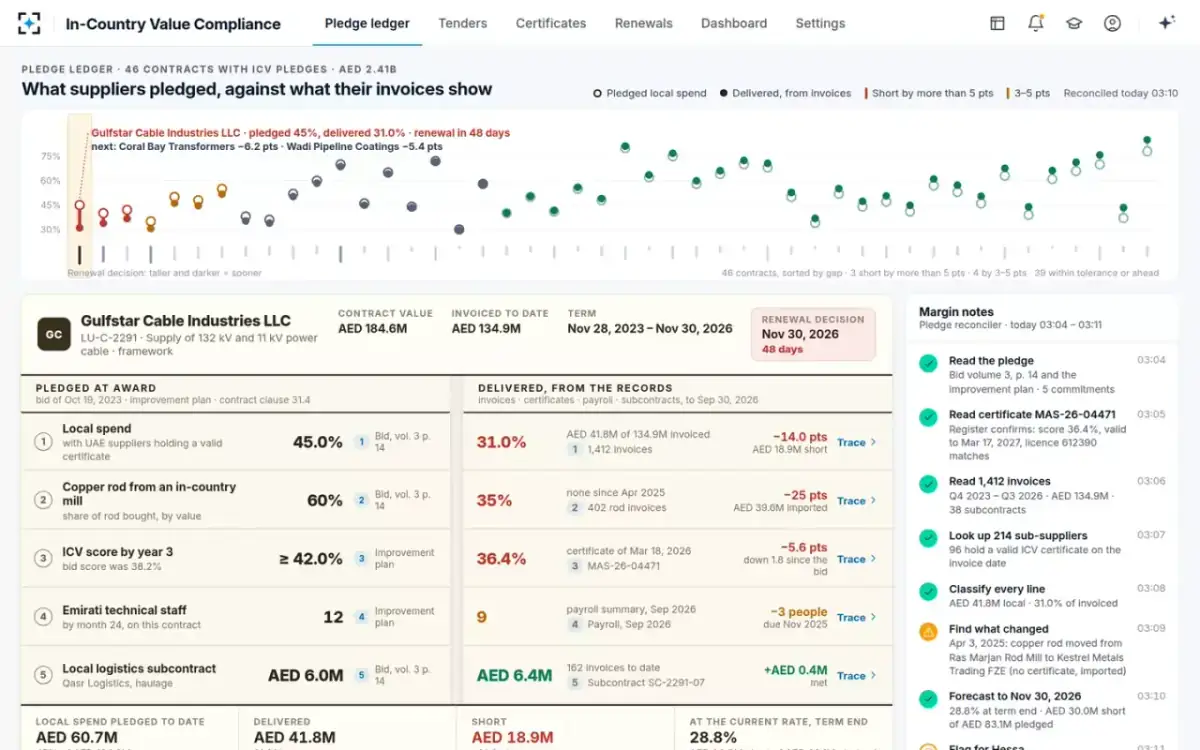

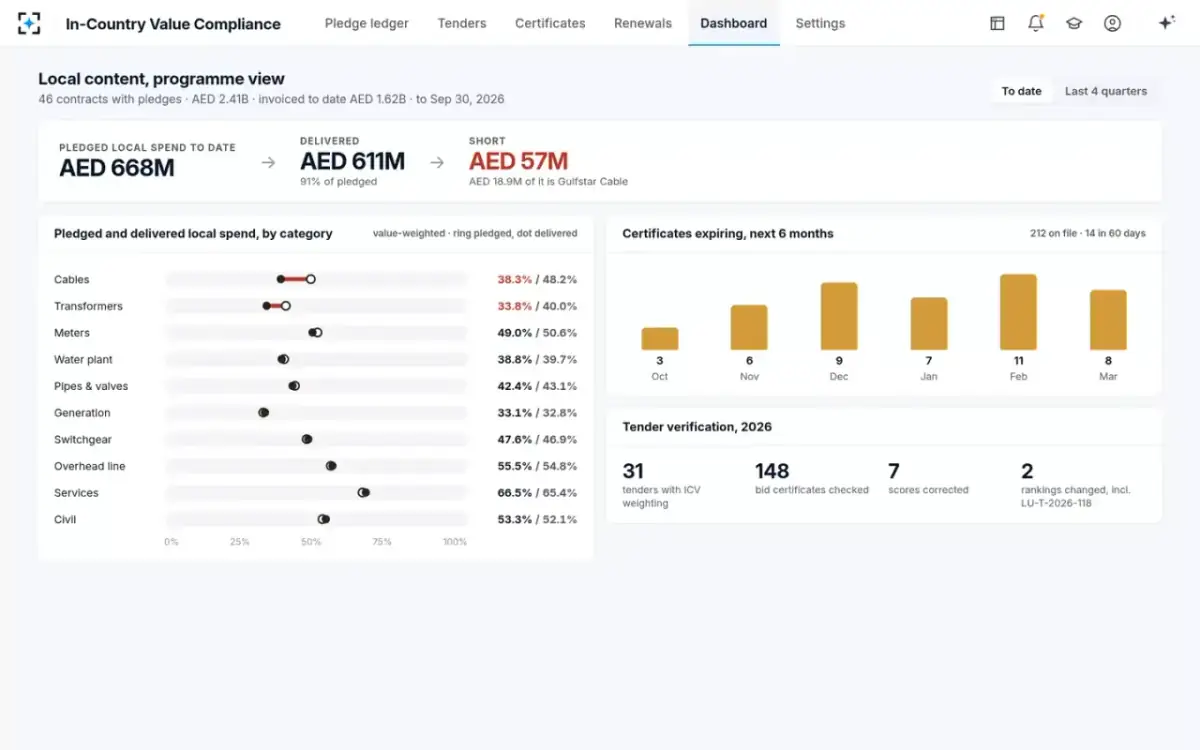

The pledge ledger opens on the longest gap
Hessa Al Mansoori · Local content managerEvery contract with a pledge is a ring at what was pledged and a dot at what the invoices show, sorted by gap and darker as the renewal nears. The overnight reconciliation ran at 03:10: 3 contracts short by more than 5 points, 4 by 3–5 points, 39 within tolerance or ahead. Gulfstar Cable sits at the far left, and its ledger is open below.
“Gulfstar Cable Industries LLC · pledged 45%, delivered 31.0% · renewal in 48 days”
- 02The ledger
What was pledged at award, against what the records show

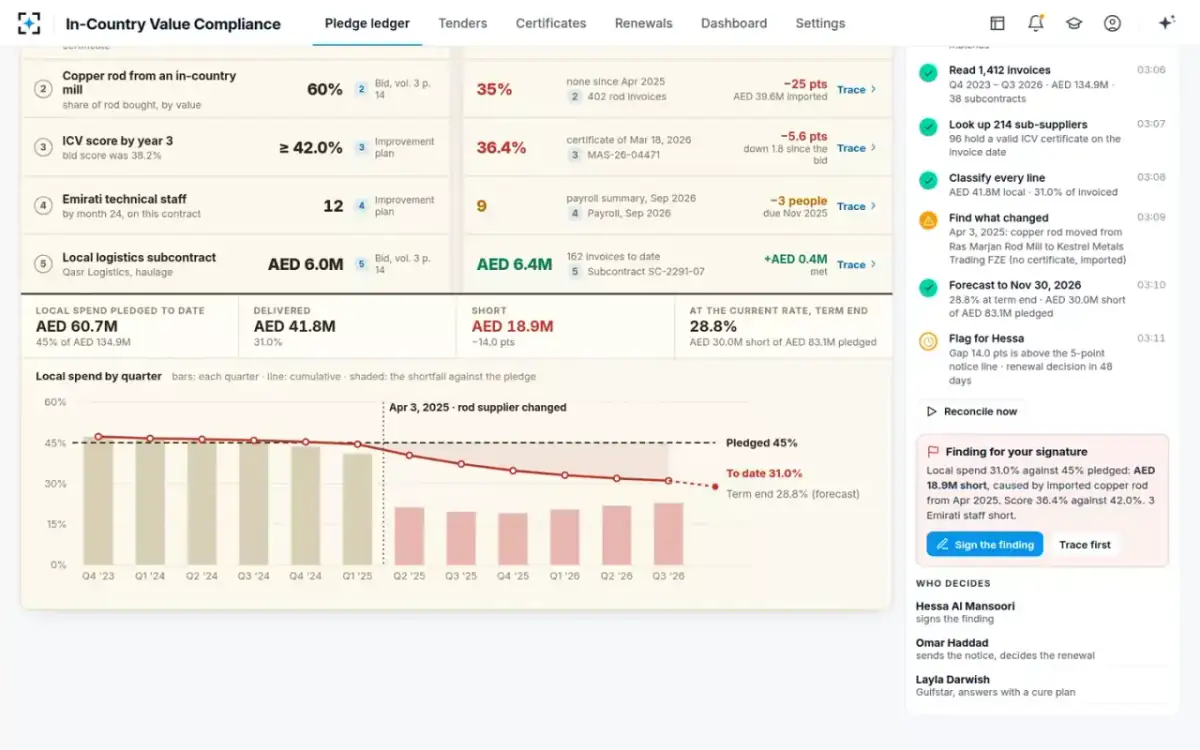

Pledge reconcilerFive pledges from the bid of Oct 19, 2023 and the improvement plan, each beside what the invoices, certificate, payroll and subcontract show to Sep 30, 2026. Local spend 31.0% against 45%: AED 18.9M short. Copper rod from an in-country mill 35% against 60%. ICV score 36.4% against 42.0% by year 3. Emirati technical staff 9 against 12. Only the Qasr Logistics subcontract is met, at AED 6.4M against AED 6.0M.
Quarter line: “Apr 3, 2025 · rod supplier changed” — at the current rate the term ends at 28.8%, AED 30.0M short of AED 83.1M pledged.

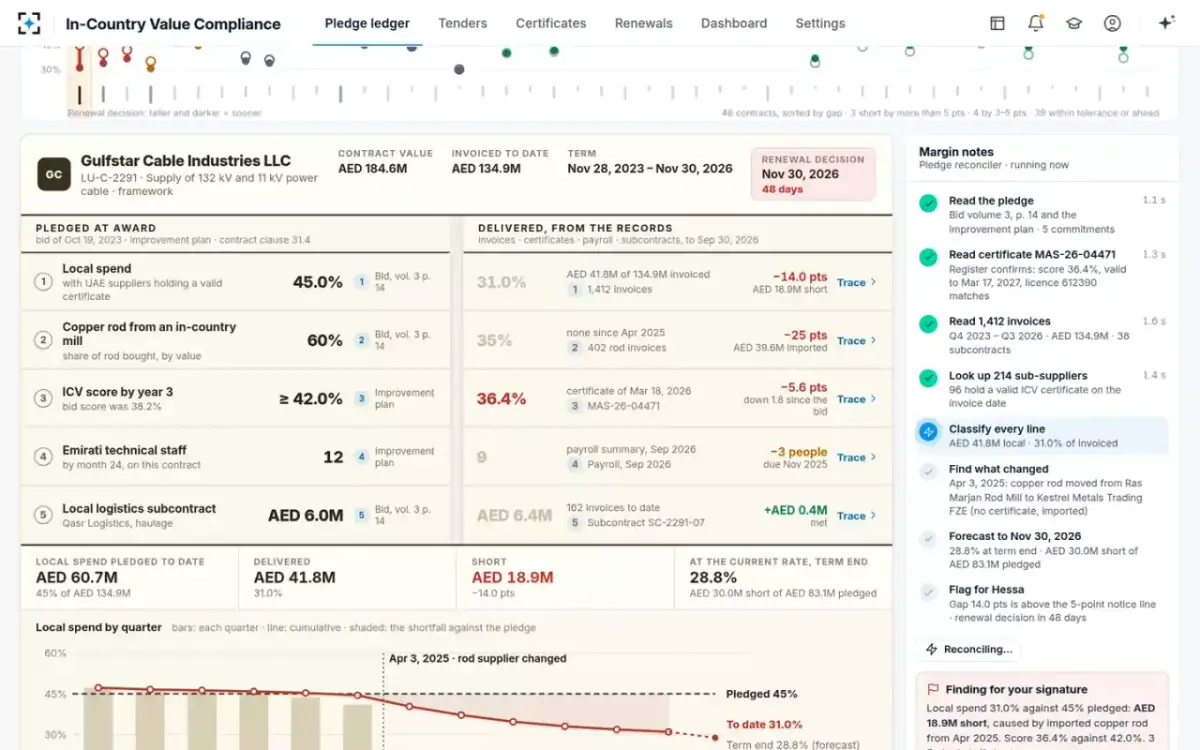

- 03Reconcile now
Every invoice re-read, every sub-supplier looked up
Pledge reconciler and Spend classifierHessa re-runs the reconciliation and the numbers on the page are recomputed as it goes. The agents read the pledge in bid volume 3, page 14, confirm certificate MAS-26-04471 on the register, read 1,412 invoices worth AED 134.9M across 38 subcontracts, and look up 214 sub-suppliers — 96 hold a valid ICV certificate on the invoice date. Then they find what changed and forecast to Nov 30, 2026.
“Flag for Hessa · Gap 14.0 pts is above the 5-point notice line · renewal decision in 48 days”

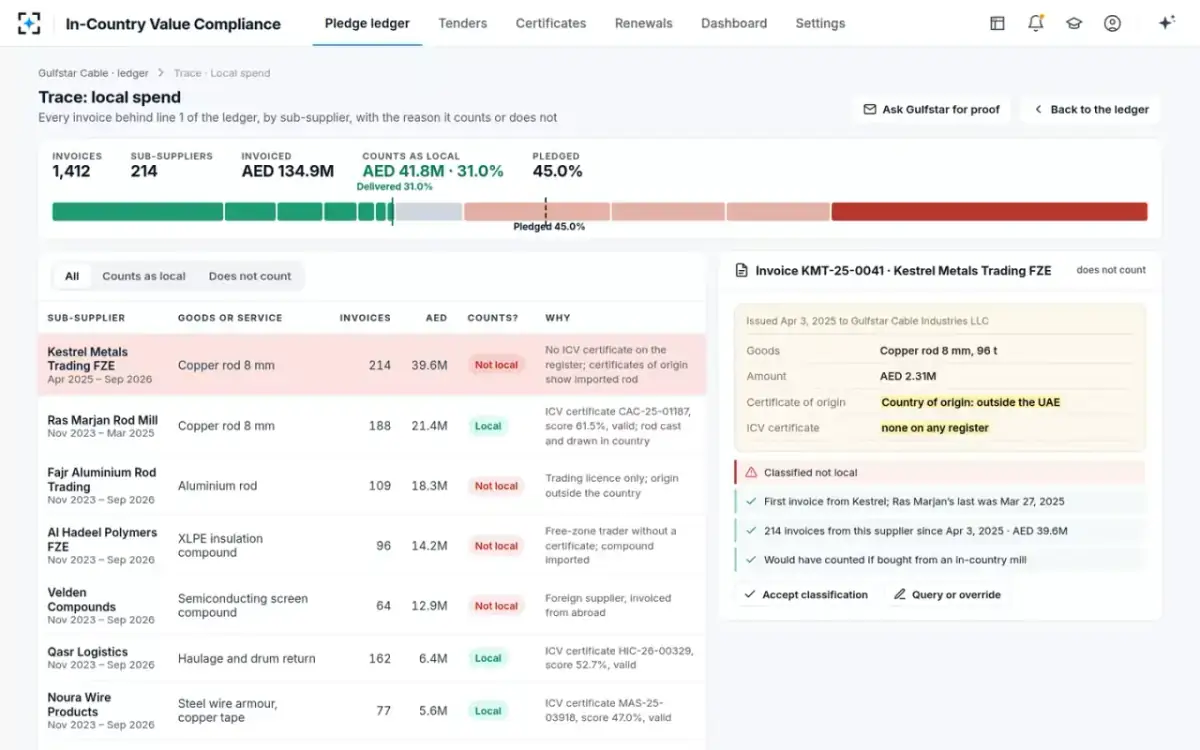

- 04Trace

The gap traced to 214 rod invoices
Spend classifierEvery invoice behind the local spend line, by sub-supplier, with the reason it counts or does not. Ras Marjan Rod Mill, 188 invoices and AED 21.4M to Mar 2025, counts as local on certificate CAC-25-01187 at 61.5%. From Apr 2025, Kestrel Metals Trading FZE: 214 invoices, AED 39.6M, not local — no ICV certificate on the register and certificates of origin showing imported rod. Invoice KMT-25-0041, 96 t of 8 mm copper rod for AED 2.31M, shows the country of origin outside the UAE.
“Would have counted if bought from an in-country mill” · Hessa can accept the classification or query it, with a reason.
- 05Signed
Hessa signs the finding
Hessa Al Mansoori · Local content managerThe finding is one paragraph: local spend 31.0% against 45% pledged, AED 18.9M short, caused by imported copper rod from Apr 2025; score 36.4% against 42.0%; 3 Emirati staff short. Hessa signs it, and the notice writer drafts the shortfall notice for the contract manager.
“Finding signed · shortfall notice drafted for Omar Haddad”

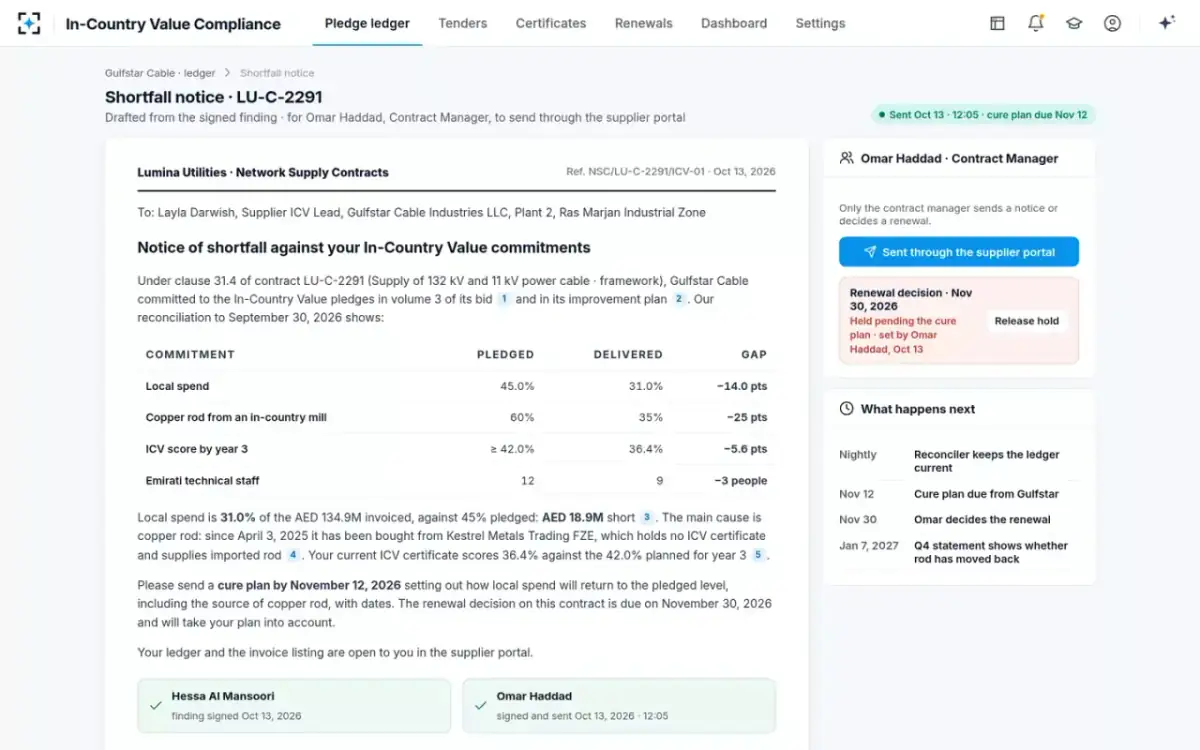

- 06Same morning
The notice goes out, and the renewal is held
Omar Haddad · Contract managerThe notice to Layla Darwish, Gulfstar's Supplier ICV Lead, cites clause 31.4, bid volume 3 and the improvement plan, sets out each gap, names the cause, and asks for a cure plan by Nov 12, 2026. Omar signs and sends it through the supplier portal at 12:05 and holds the renewal decision pending the cure plan.
“Only the contract manager sends a notice or decides a renewal.”

- 07Before the committee
Five bids, ranked on the scores they claimed
Priya Nair · Category managerTender LU-T-2026-118, 33/11 kV ring main units, 420 units over three years, closed Oct 8; the committee meets Thu Oct 15 at 10:00. Commercial score = 60 × lowest price ÷ price + 40 × ICV ÷ highest ICV. On claimed scores Coastline Switchgear LLC leads at 95.7 with a 52.4% certificate, and Harbourline Power Equipment is fifth.
“Verify the certificates to see whether the order holds.”

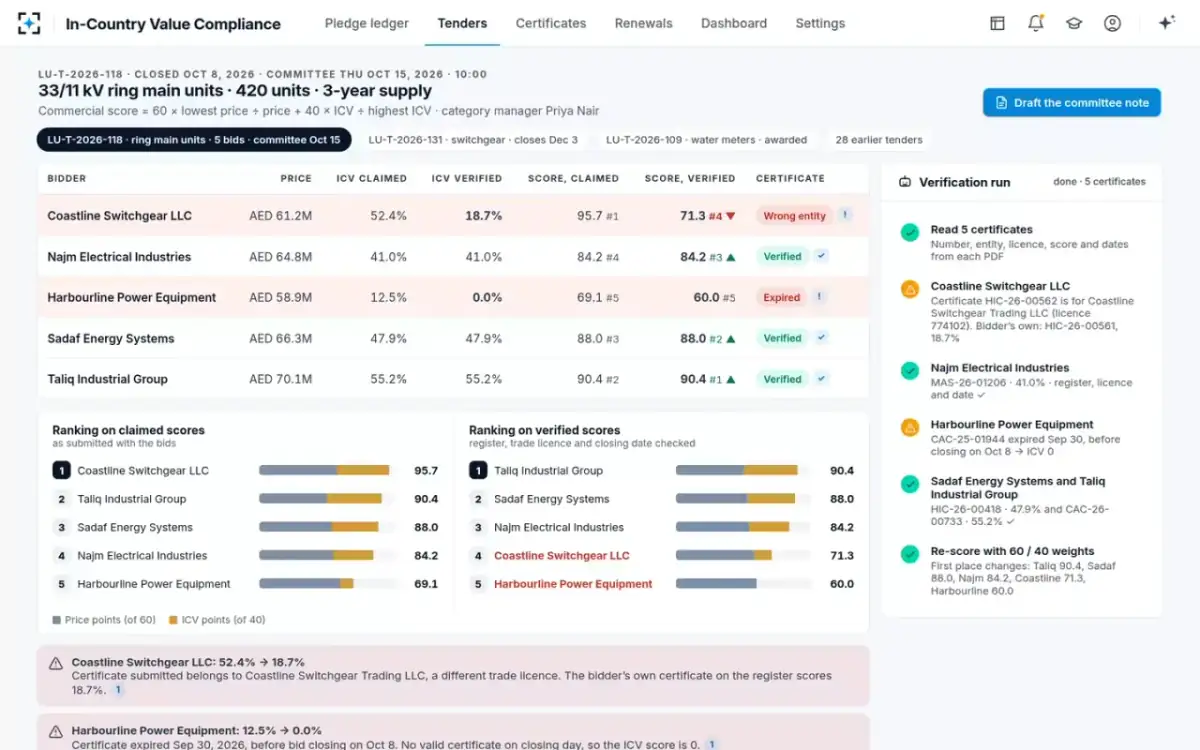

- 08Verified
Two certificates fail, and first place changes
Certificate reader, Certificate validator and Bid score checkerThe certificate submitted by Coastline Switchgear LLC, HIC-26-00562, belongs to Coastline Switchgear Trading LLC on trade licence 774102; the bidder is licence 774088, and its own certificate on the register scores 18.7%. Harbourline's certificate expired Sep 30, before closing, so its ICV score is 0. Re-scored at 60 / 40: Taliq Industrial Group 90.4, Sadaf Energy Systems 88.0, Najm Electrical Industries 84.2, Coastline 71.3, Harbourline 60.0.
“Coastline Switchgear LLC: 52.4% → 18.7%”

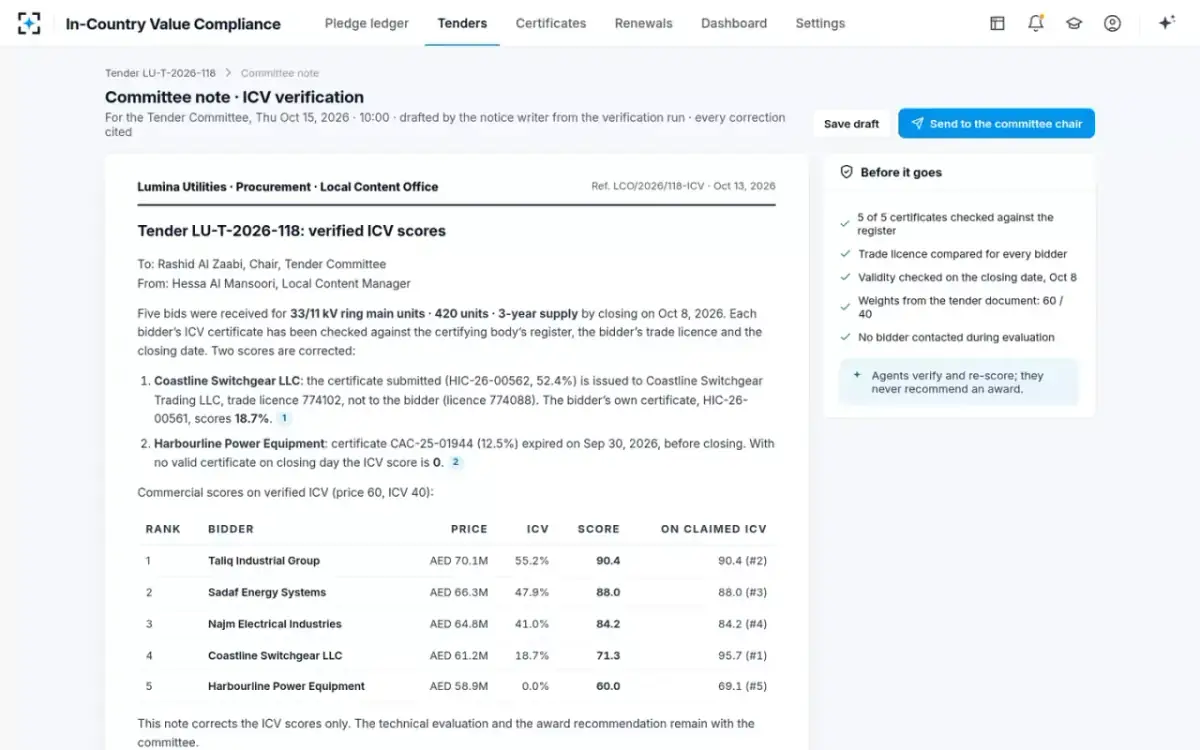

- 09The committee note
A note that corrects the scores, and nothing else
Notice writer · for Rashid Al Zaabi, Tender committee chairThe note to the chair lists the two corrections with their certificates, the verified ranking beside the claimed one, and what was checked: 5 of 5 certificates on the register, the trade licence for every bidder, validity on the closing date, the weights from the tender document. Hessa sends it to Rashid Al Zaabi, who signs at the committee.
“This note corrects the ICV scores only. The technical evaluation and the award recommendation remain with the committee.”
- 10The weeks ahead

The next renewals, and the certificates about to lapse
Hessa Al Mansoori · Local content managerEleven contracts with pledges renew in the next 26 weeks, five with a gap above 3 points — Marsa Valve & Pump at 71 days and −4.4 points, Coral Bay Transformers at 112 days and −6.2. Of 212 certificates on file, 14 expire within 60 days, and reminders go at 60 and 30 days before expiry.
“11 renewals in 26 weeks · 5 with a gap above 3 points”
