- Before
- Checks and approves 6 to 10 switching orders a day as the second person, before they are issued. Reads each one twice, knowing the risk is the step read only once.
- Now
- Opens each order on the live single-line diagram, the control room's map of the network. Each step is simulated and each finding is tied to its rule. Decides the reconciliation flags after the job.
How one cable joint's switching order was blocked, redrafted and signed
A distribution control room has a cable joint to replace on an 11 kV ring. The ring has six ring main units, the switching points along it. The work is one Thursday from 09:00 to 15:30. Here is what happens to its switching order, screen by screen, in the working solution.
A worked example on sample data. Names, IDs and figures on the screens and in this section come from the demo.
- 01A week before
The work request asks for a dead, grounded cable and nobody off supply
Cable engineerAn online partial-discharge monitor, which picks up small sparks inside the insulation, reads 2,400 pC at the joint. The alarm level is 500 pC, and the reading has been rising for weeks. The cable engineer raises the work request. It asks for the cable to be isolated at the feeder breaker and at the first ring main unit, with a ground at each end. All six ring main units are to stay on supply from the neighboring feeder, which is 1,654 customers and 3.1 MW. Four priority customers are on the ring, including a clinic's dialysis unit.
Work request: the cable dead and grounded at both ends from 09:00 to 15:30, and nobody on the ring off supply.
- 02Checked 08:47
Rev A is copied from last year's order and checked by four agents
Switching order writerThe writer drafts rev A, a 16-step order copied from last year's joint on the next cable section. As soon as it is submitted, the agents check it. The prior-order finder finds 3 earlier orders on the feeder breaker and the first ring main unit. It shows rev A is 81% identical to last year's order. The network simulator runs all 16 steps on a model of the two feeders, starting from the SCADA states.
Prior-order finder: “rev A is 81% identical to last year's order. Step 7 is copied unchanged from its step 9.”

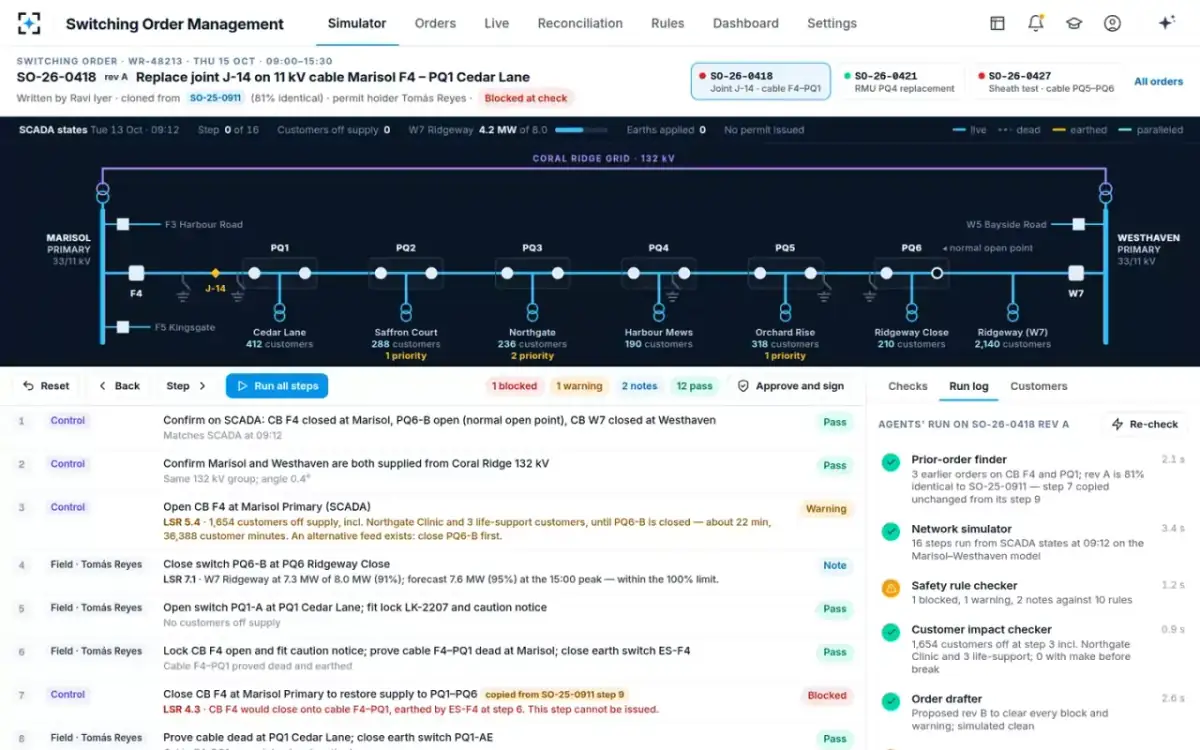

- 03Step 3

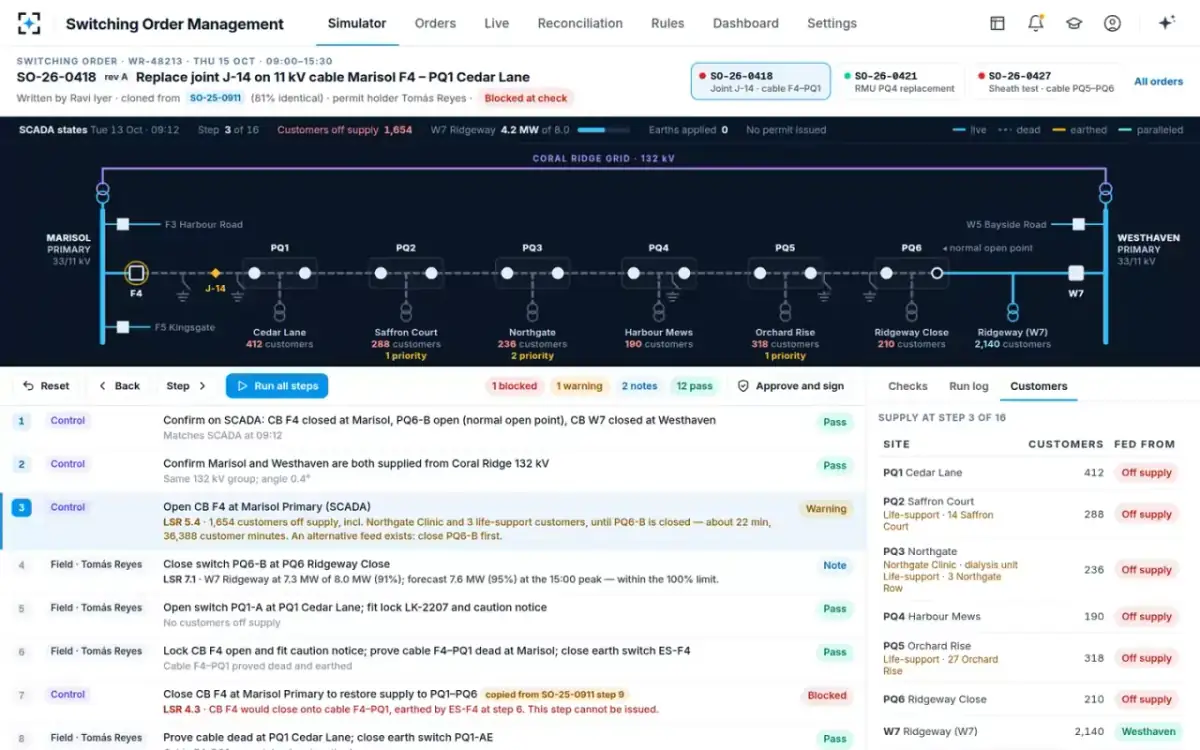

Opening the feeder first drops the whole ring
Customer impact checkerRev A opens the feeder breaker before closing the open point, the normally open switch at the far end of the ring. On the diagram, each ring main unit goes off supply, cutting off 1,654 customers, including the clinic and 3 life-support registrations. They stay off for the roughly 22 minutes it takes to reach the far end. That is 36,388 customer minutes on a job that needed none. Last year's order did exactly this.

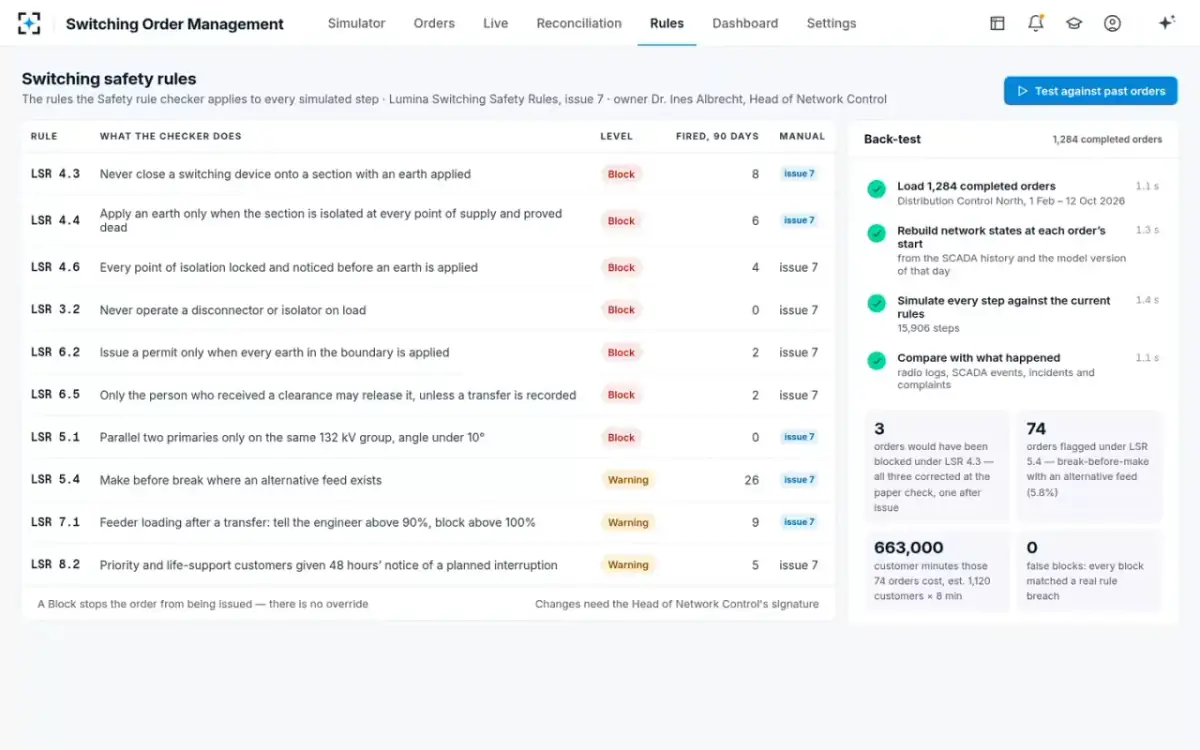

Rule 5.4 · “An alternative feed exists: close the open point first.” · Warning

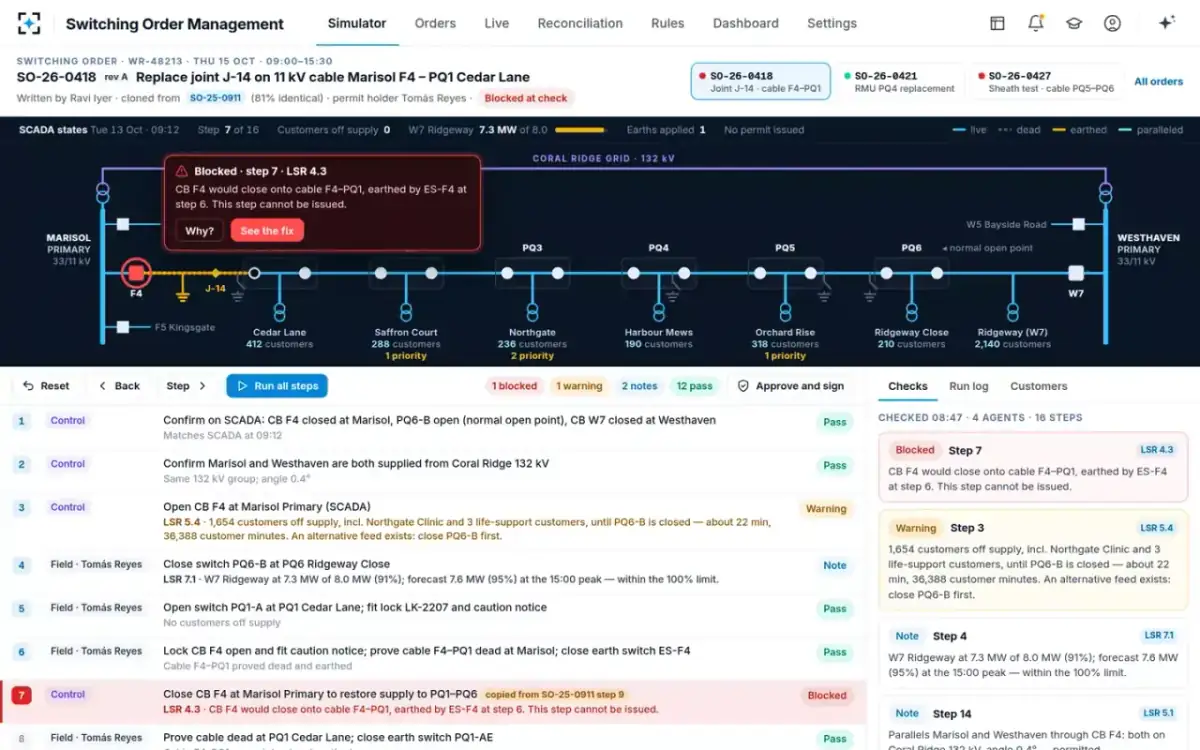

- 04Step 7
A copied step would close onto a grounded cable, so it is blocked
Safety rule checkerAt step 6 the crew closes the ground switch at the breaker end, so the cable is grounded. Step 7 was copied from step 9 of last year's order. It closes the feeder breaker to restore supply. In the old order, the worked section was farther around the ring and this cable was not grounded. Here the breaker would close onto the crew's grounds. The run stops and the breaker is ringed in red on the diagram. The step is marked Blocked, and it cannot be issued.
“Rule 4.3 · The feeder breaker would close onto the cable grounded at step 6. This step cannot be issued.”
- 05The fix

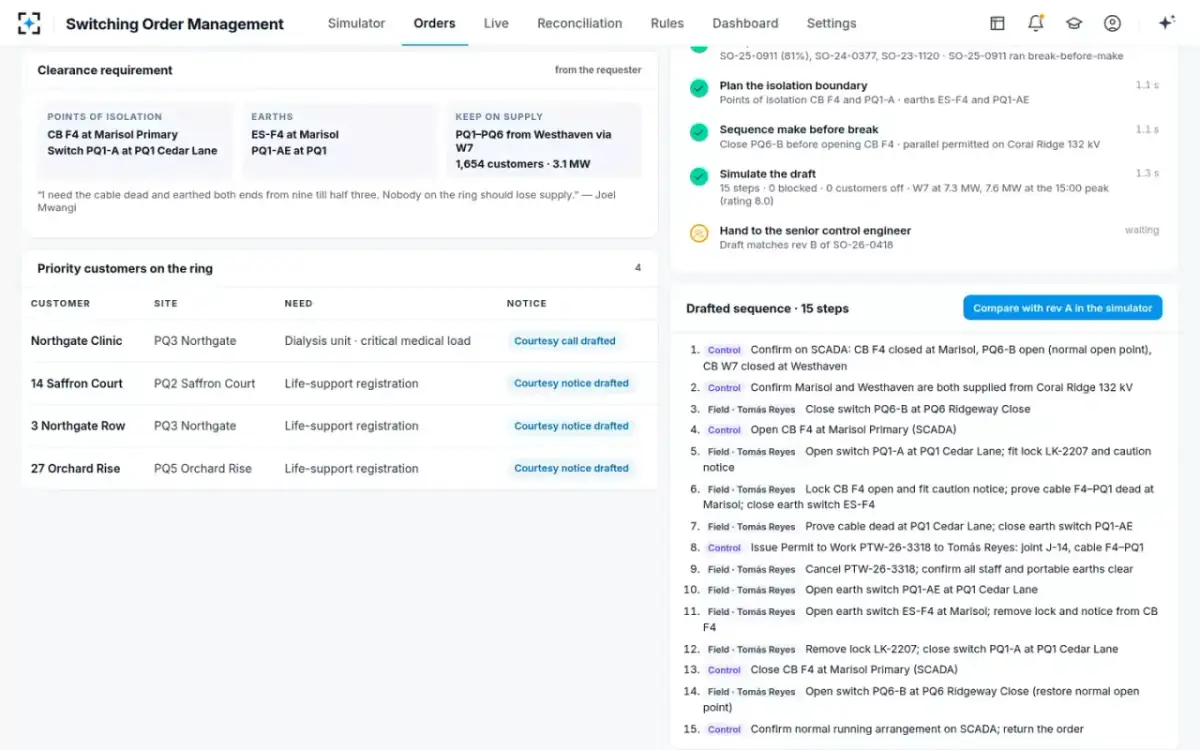

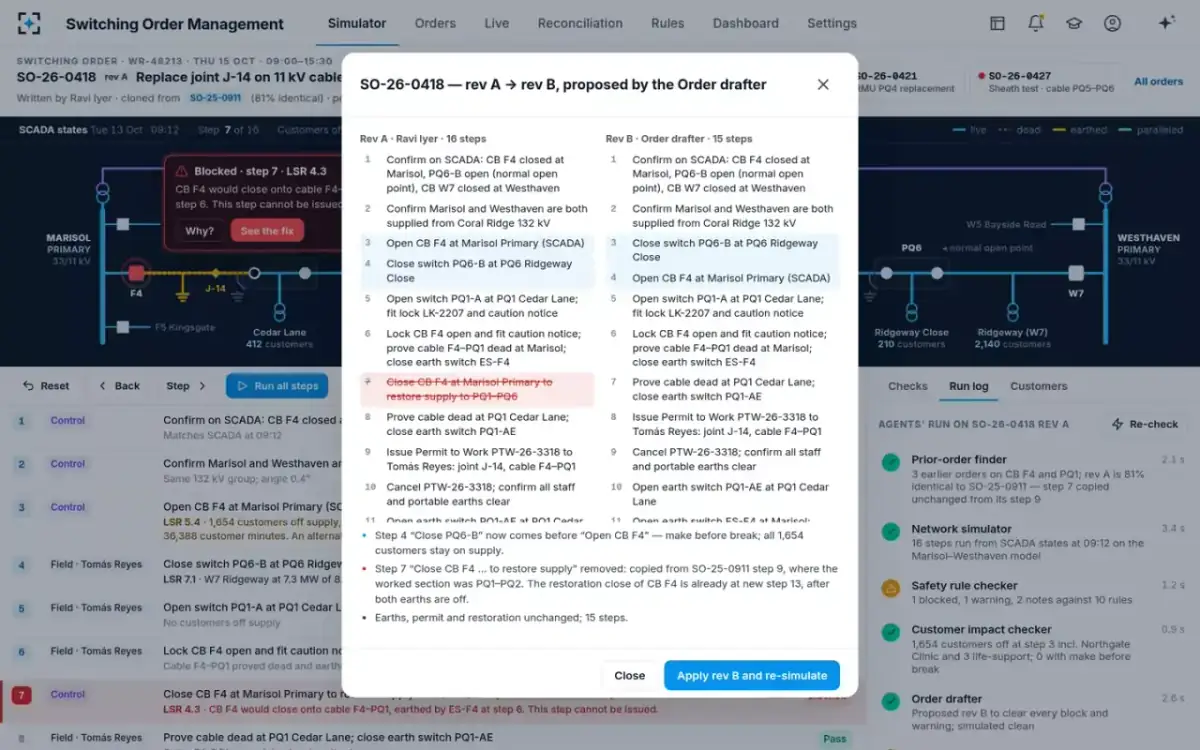

Rev B keeps customers on and removes the copied step
Order drafterThe order drafter proposes rev B as a side-by-side change to the order. It does not rewrite the whole order. Closing the open point now comes before opening the feeder breaker, so all 1,654 customers stay on supply. The copied step 7 is removed. The breaker's restoration close already sits at new step 13, after both grounds are off. Grounds, permit and restoration are unchanged, and the order now has 15 steps.
The drafter changes as little as possible and explains each change. It does not issue or approve an order.
- 06Re-simulated

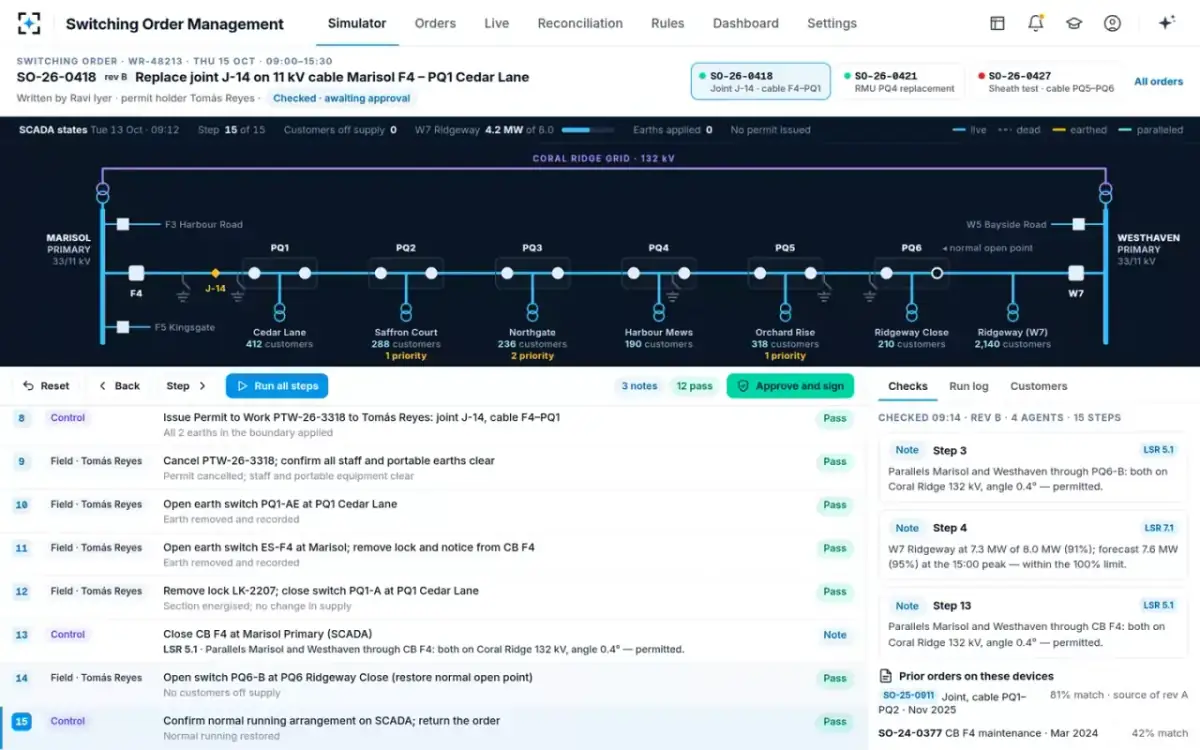

Fifteen steps, nothing blocked, nobody off supply
Network simulatorRev B is applied and the simulator runs each step again. It finds 0 blocked steps, 0 customers off supply and 3 notes. The two feeders run in parallel through the open point for a moment, which is permitted. Both are on the same 132 kV group, at an angle of 0.4°. The neighboring feeder carries 7.3 MW of its 8.0 MW rating, or 91%. At the 15:00 peak it is forecast at 7.6 MW, or 95%, which is within the limit.
Rule 7.1 · “Neighboring feeder at 7.3 MW of 8.0 MW (91%). Forecast 7.6 MW (95%) at the 15:00 peak, within the 100% limit.” · Note

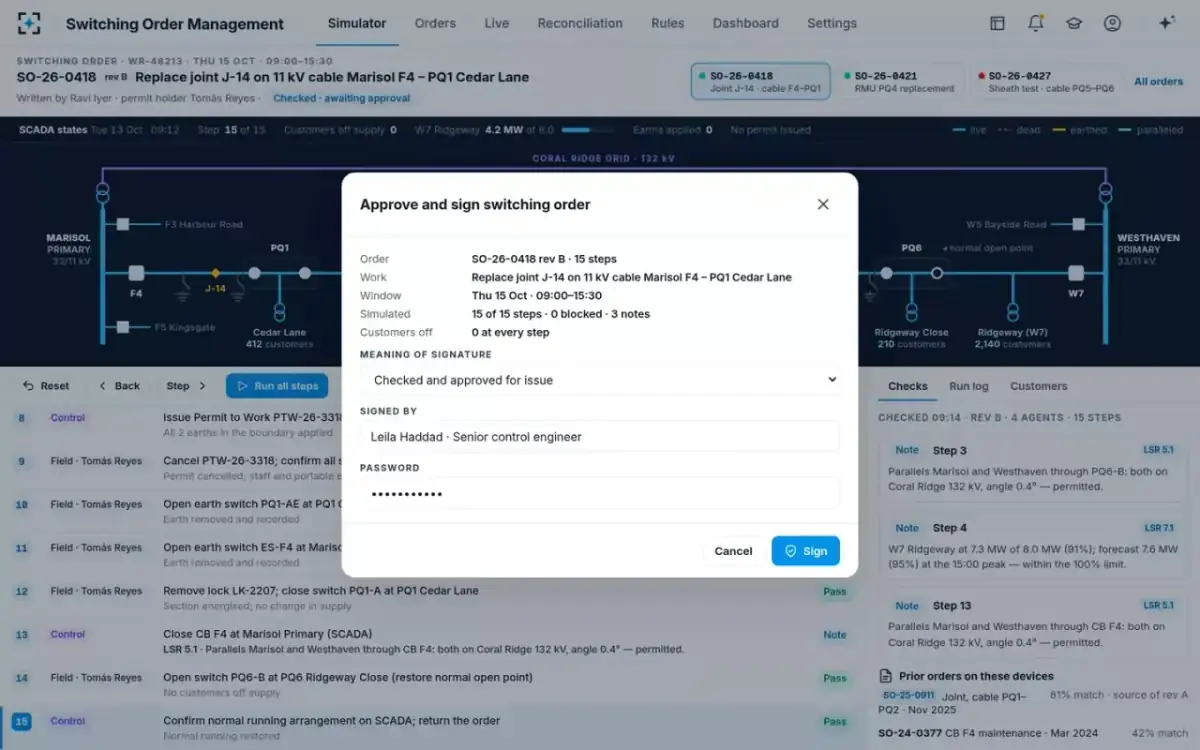

- 07Signed 09:16
The senior engineer signs, with the meaning of the signature
Senior control engineerApprove and sign stays locked while any step is blocked or has a warning. Rev B is clean. The senior control engineer sees the order, the work and the time window. All 15 steps are simulated, with none blocked and no customers off at any step. The engineer signs with a password and the meaning “Checked and approved for issue”. On Thursday at 09:00 the control room operator issues it. The permit goes to the senior authorized person in the field.
Approve and sign opens only when no step is blocked or has a warning.
- 08On the day

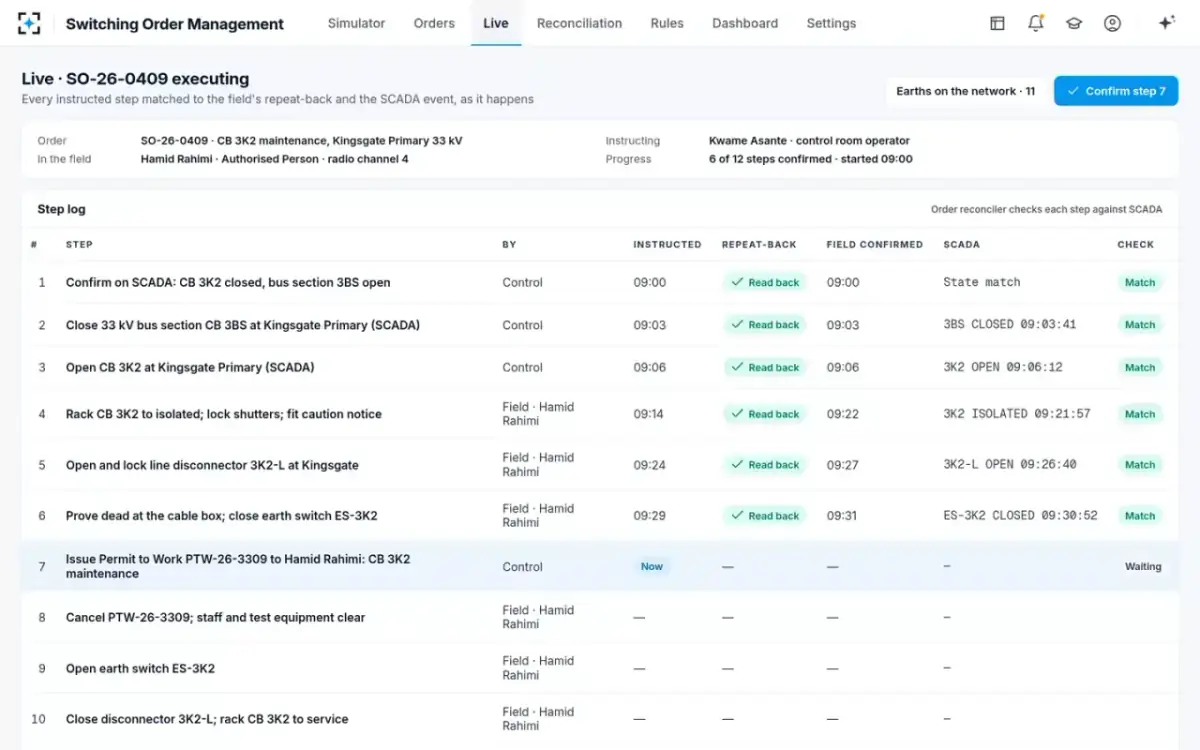

Each step is read back, confirmed and matched to SCADA as it happens
Control room operatorDuring breaker maintenance on another order at 33 kV, the operator instructs the field switcher over the radio, one step at a time. Each step records when it was instructed, the repeat-back, the field confirmation and the SCADA event. For example, the breaker was isolated at 09:21:57 and the ground switch closed at 09:30:52. The order reconciler marks each one Match. Step 7, the permit, waits for the operator to confirm it.
Repeat-back, confirm, next. One step at a time.
- 09After the job

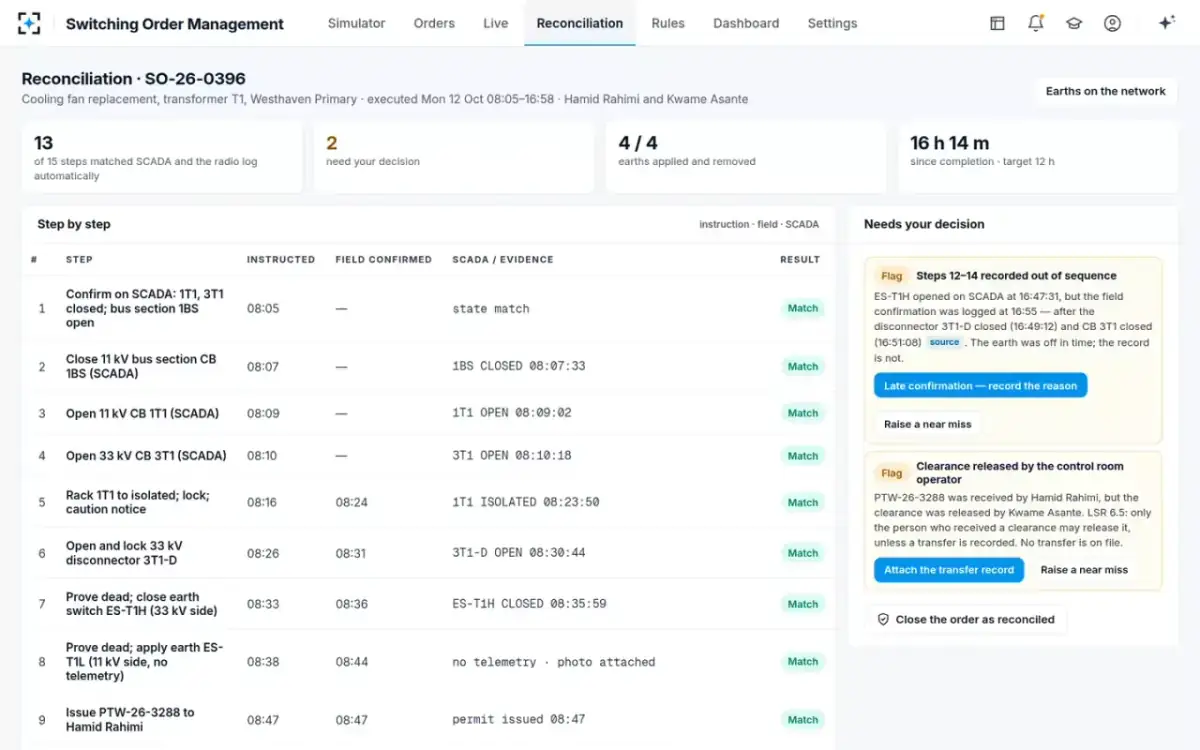

Two flags the paper record would have hidden
Order reconcilerNext comes a different job, a cooling fan replacement on a substation transformer that finished on Monday at 16:58. Of its 15 steps, 13 matched SCADA and the radio log automatically. All 4 grounds were applied and removed. Two flags go to the senior control engineer. First, the field confirmation that the transformer's ground switch was open came in after the disconnector and the transformer breaker had closed. Second, the control room operator released the clearance for the permit. Only the field switcher who received it should have released it.
“The ground was off in time. The record is not.” · Rule 6.5: only the person who received a clearance may release it, unless a transfer is recorded.
- 10The next morning

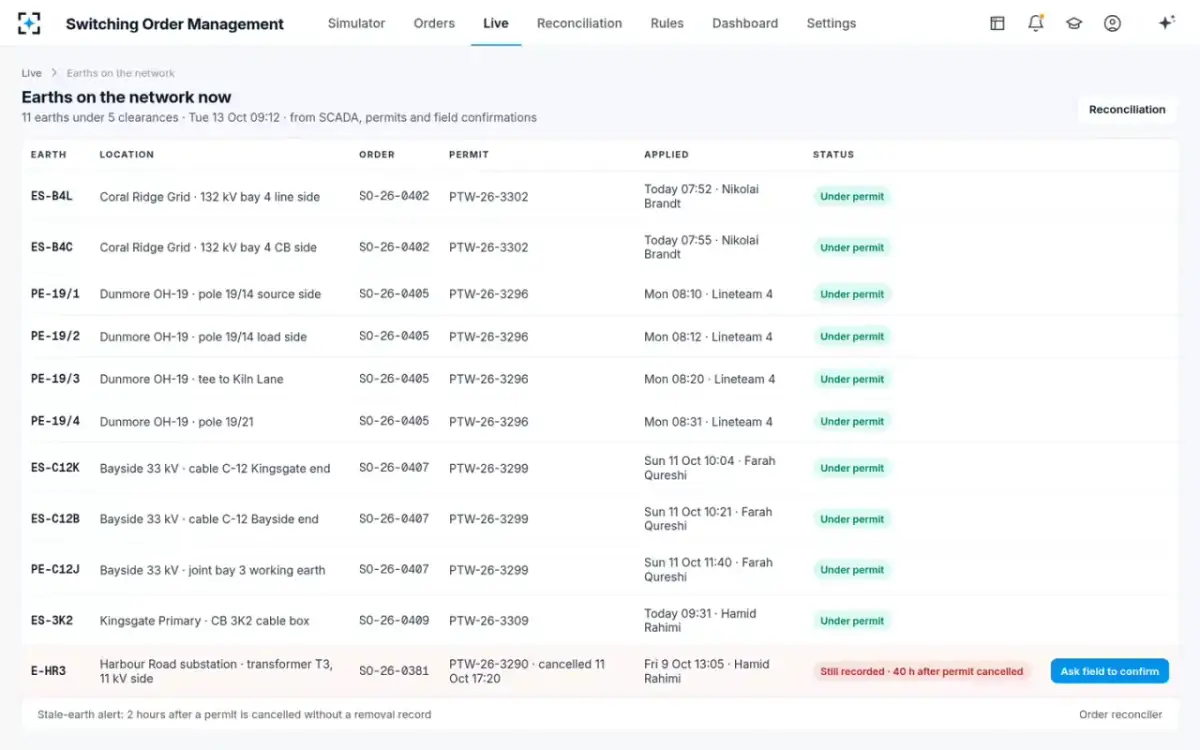

The grounds on the network, and the one that should not be there
Order reconcilerThe grounds board lists 11 grounds under 5 clearances, drawn from SCADA, permits and field confirmations. Ten are under a live permit. One, on a transformer at another substation, is still recorded as applied 40 hours after its permit was canceled. Until it is confirmed removed, rule 4.3 blocks any close onto that transformer's 11 kV side. The senior control engineer asks the field to confirm, with a photo.
“Still recorded · 40 h after permit canceled”
