- Before
- Places 40 to 60 outage requests a week and builds next week's plan by Wednesday so letters can go out. Learns that a backup feeder is out when the control room calls that morning.
- Now
- Sees each day on a feeder's row light up green, amber or red before dropping an outage. Gets the reason and the first clear day the moment it lands.
A ring main unit swap, a Thursday clash and letters ready to post
A utility is planning next week's outages across three primary substations and a water supply zone. It is Tuesday, 10:20. Next week's letters must post by Wednesday at 16:00. Here is what happens to one request, screen by screen, in the working solution.
A worked example on sample data. Names, IDs and figures on the screens and in this section come from the demo.
- 01Tuesday 10:20

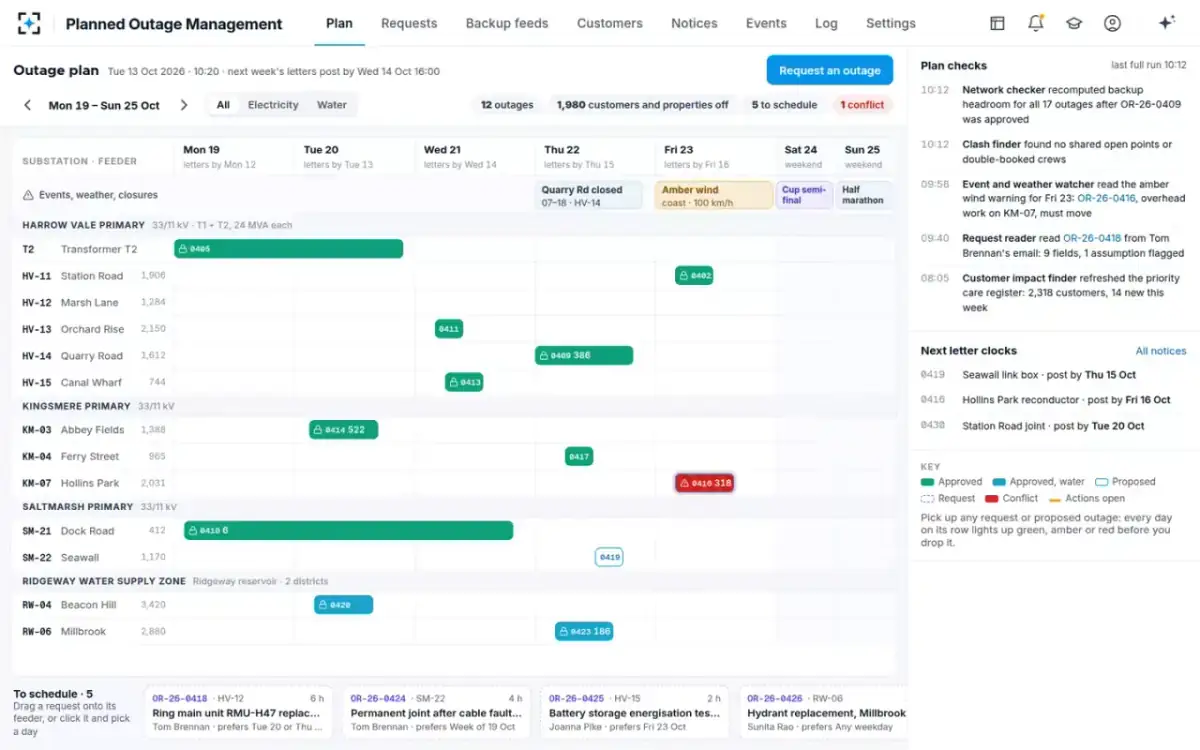

The week on one chart, by substation and feeder

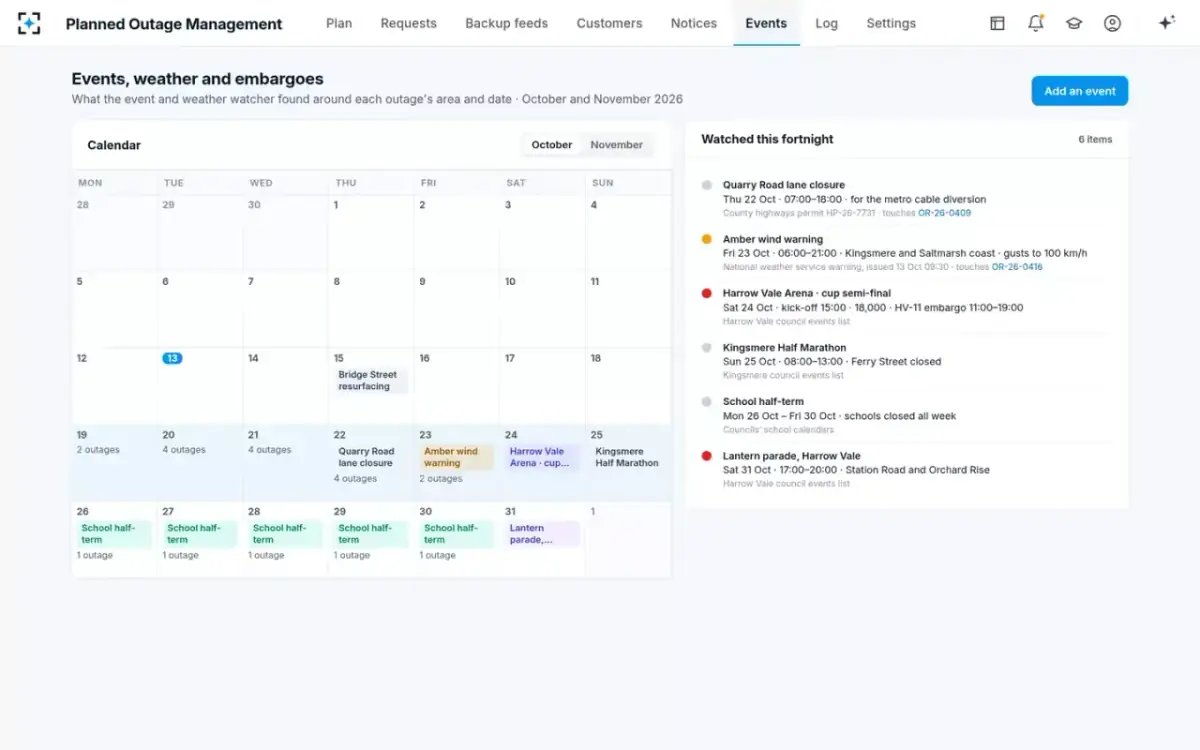

Outage coordinatorThe coordinator's plan shows 12 outages and 1,980 customers and properties off. There are 5 requests to schedule and 1 conflict. A lane across the top shows a road closure on Thursday, an amber wind warning on Friday, a cup semi-final and a half marathon. The one red bar is an overhead line job, where old wires are being replaced. The event and weather watcher has already flagged it.
“Event and weather watcher read the amber wind warning for Friday: the overhead reconductoring job must move”

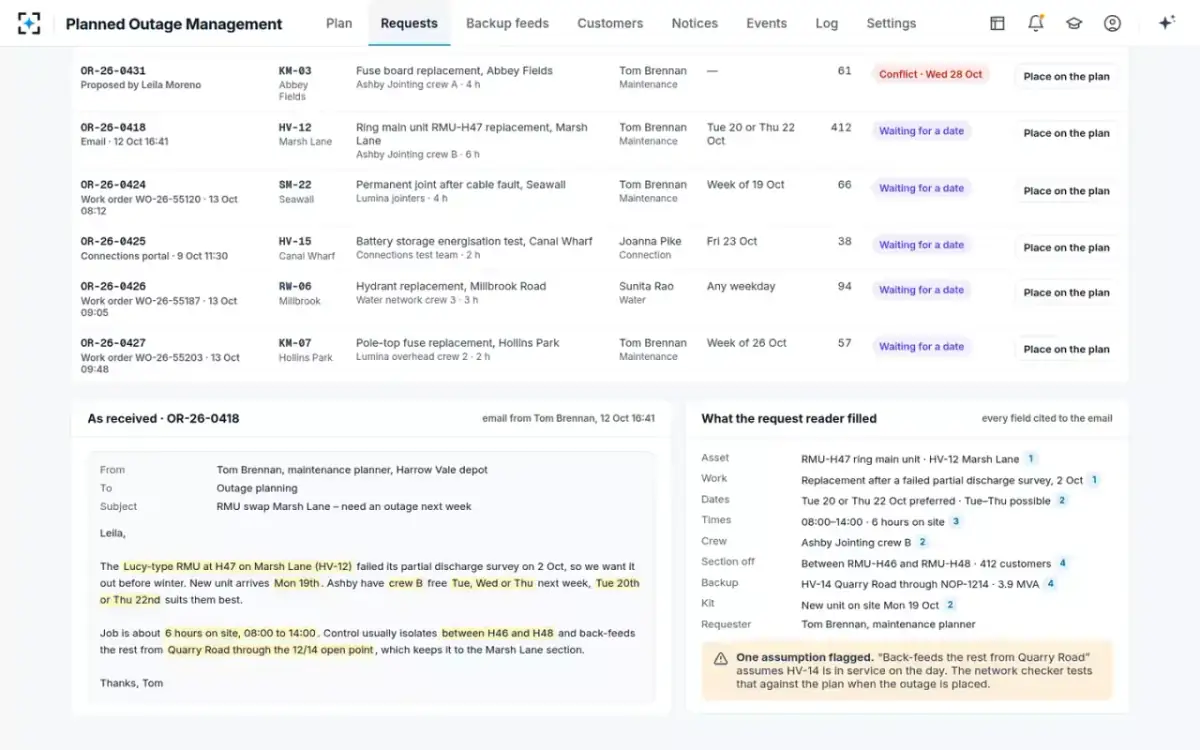

- 02Read at 09:40
A planner's email, read into nine fields
Request readerThe maintenance planner emailed the afternoon before. The planner wants to replace a ring main unit, a switching unit on the cable network. It failed its partial discharge survey, a test for insulation wear, earlier in the month. The request reader fills in the asset, work, dates, times, crew, section off, backup, kit and requester. Each field links to the sentence it came from. The work runs 08:00 to 14:00 with a contractor's jointing crew. It takes 412 customers off between the neighboring ring main units. The rest are back-fed from a second feeder through a normally-open point at 3.9 MVA.
One assumption flagged: back-feeding the rest from the second feeder assumes that feeder is in service on the day.
- 03Picked up

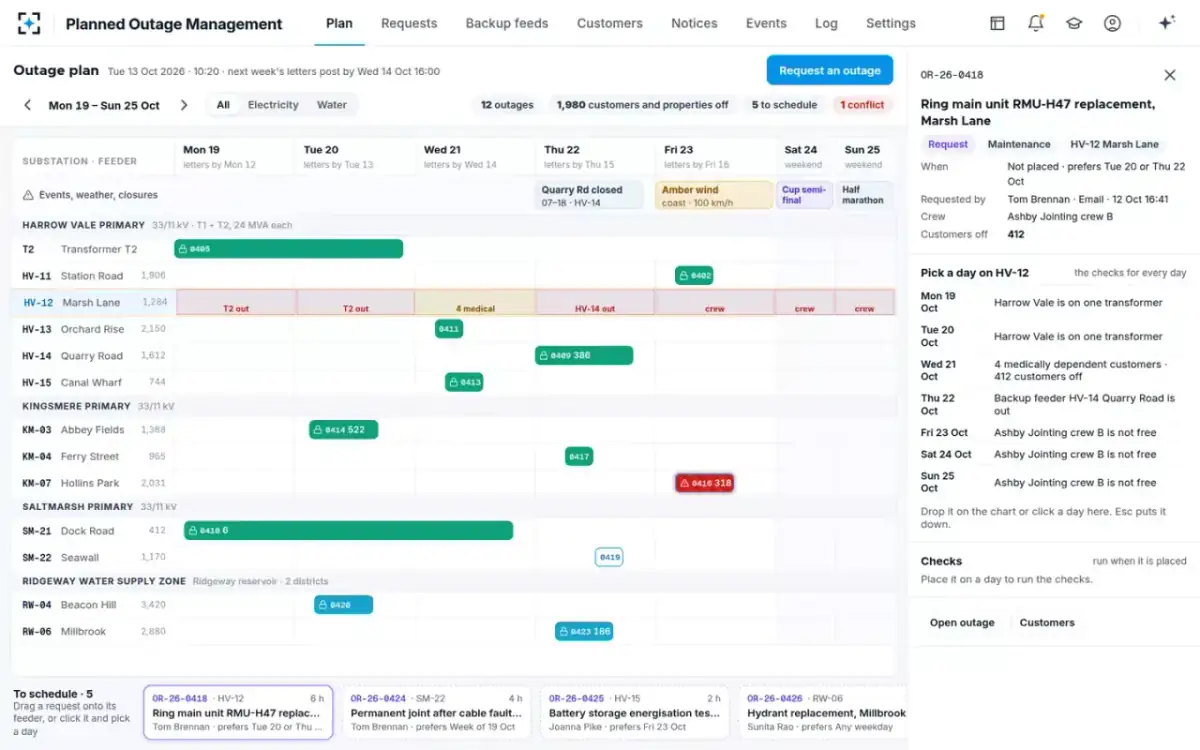

Each day on the feeder's row lights up before the job is placed
Outage coordinatorThe coordinator picks the request from the tray, and each day on the feeder's row lights up. On Monday and Tuesday the primary substation runs on one transformer while T2 is overhauled. Wednesday is amber, with 4 medically dependent customers and 412 customers off. On Thursday the backup feeder is out. From Friday to Sunday the jointing crew is not free.
“Thursday: the backup feeder is out”

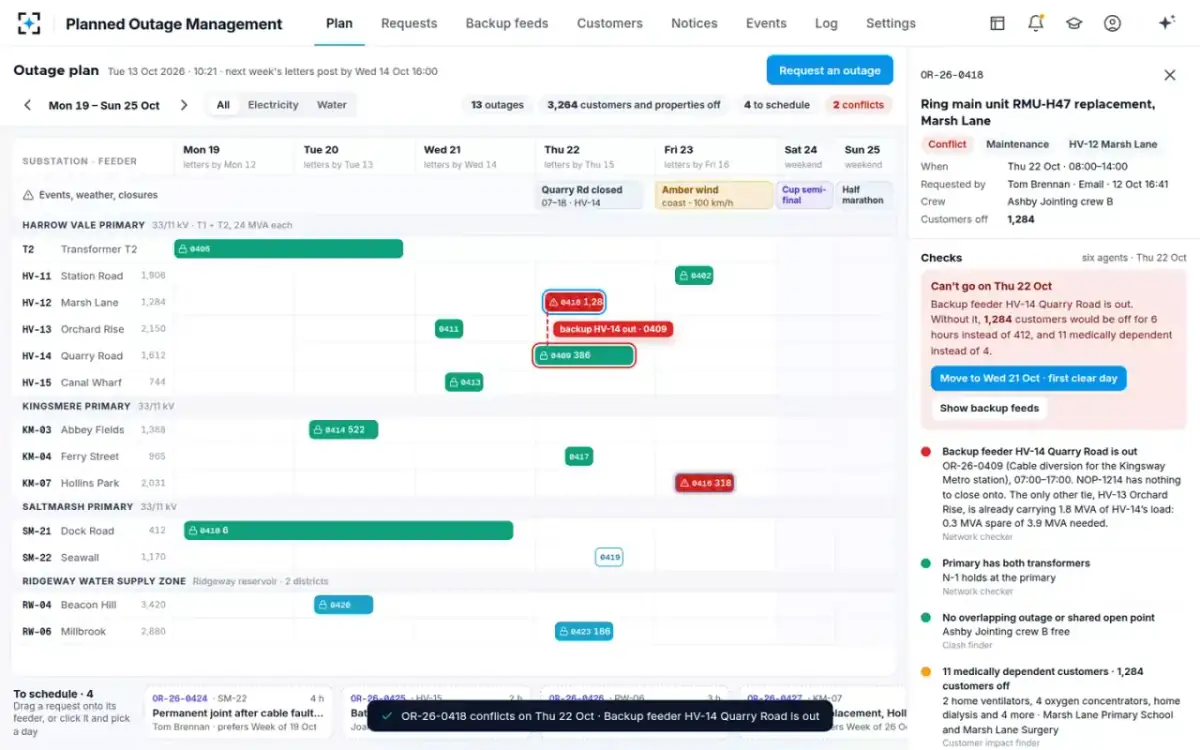

- 04Dropped on Thursday
A red bar, linked to the outage that causes it
Network checkerThursday is one of the crew's two preferred days, so the coordinator drops the job there. The six checks run again in the side panel and the bar turns red. A red link points to another outage. A project engineer's cable diversion for a new rail station takes the backup feeder out from 07:00 to 17:00. The open point has nothing to close onto. The only other linked feeder already carries 1.8 MVA of the backup's load. That leaves 0.3 MVA spare against the 3.9 MVA needed.
“Can't go on Thursday. The backup feeder is out. Without it, 1,284 customers would be off for 6 hours instead of 412, and 11 medically dependent instead of 4.”

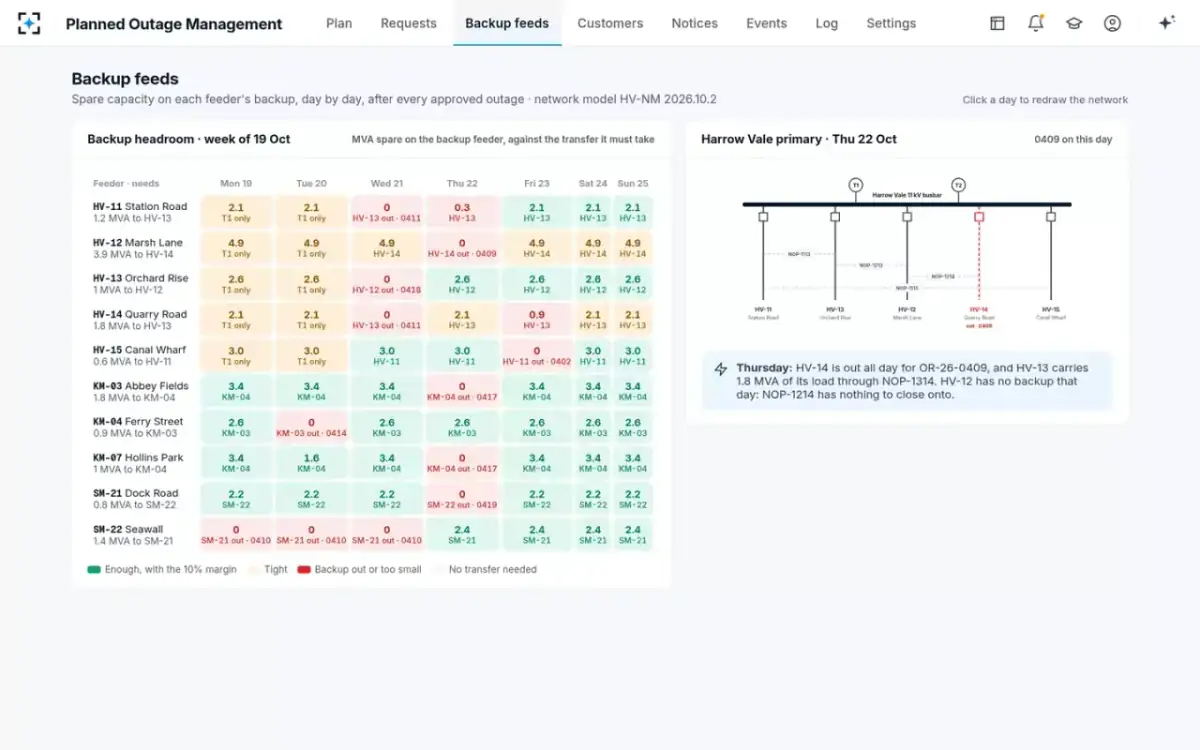

- 05The reason
Spare backup capacity, feeder by feeder, day by day
Network checkerThe backup feeds view shows the spare capacity on each feeder's backup for the week. It counts the approved outages and uses the current version of the network model. The job's feeder needs 3.9 MVA from its backup. Most days there is 4.9 MVA spare. On Thursday there is 0. The substation's one-line diagram for Thursday shows the backup feeder out, with nothing behind the open point.
“Thursday: the backup feeder is out all day for the cable diversion … the job's feeder has no backup that day.”

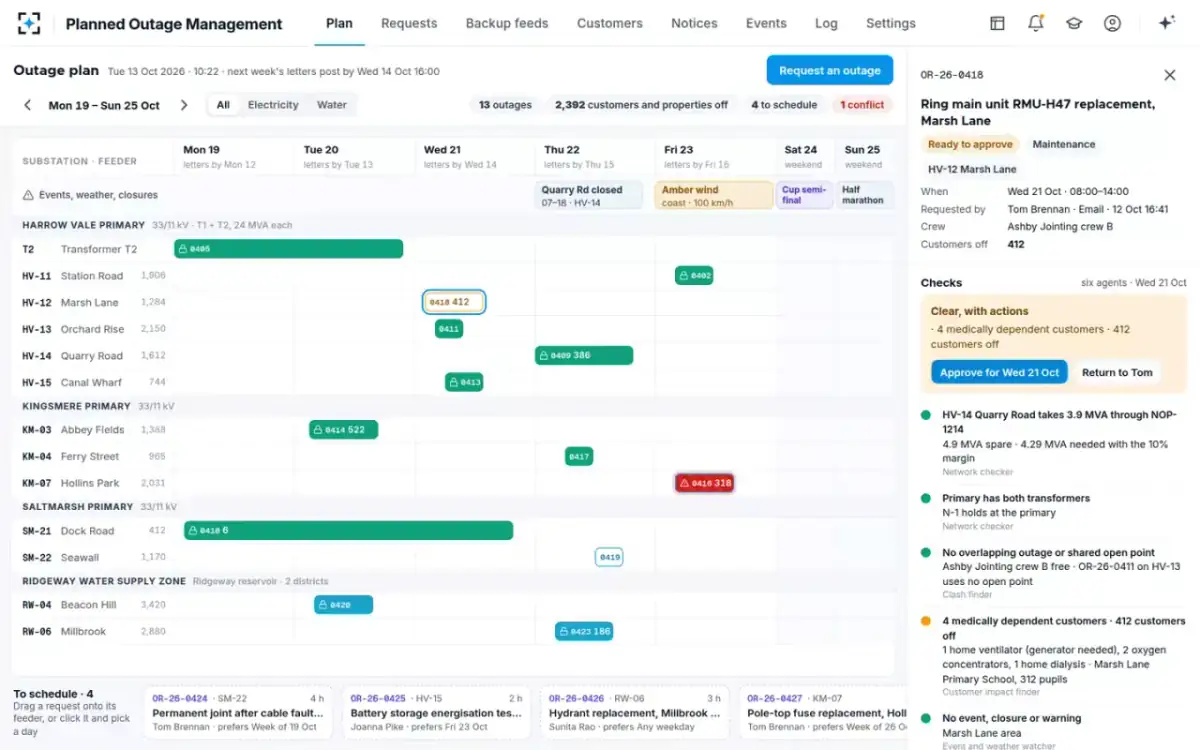

- 06Moved to Wednesday
The first clear day, with actions
All six agentsOne click moves the job to Wednesday, the first clear day. The backup feeder takes 3.9 MVA through the open point. It has 4.9 MVA spare, against 4.29 MVA needed with the 10 % margin. Both transformers are in service. No other outage uses the open point, the crew is free, and no event, closure or warning is nearby. One amber remains: 4 medically dependent customers and a primary school of 312 pupils. The four rely on a home ventilator, two oxygen concentrators and home dialysis.
“Clear, with actions · 4 medically dependent customers · 412 customers off”

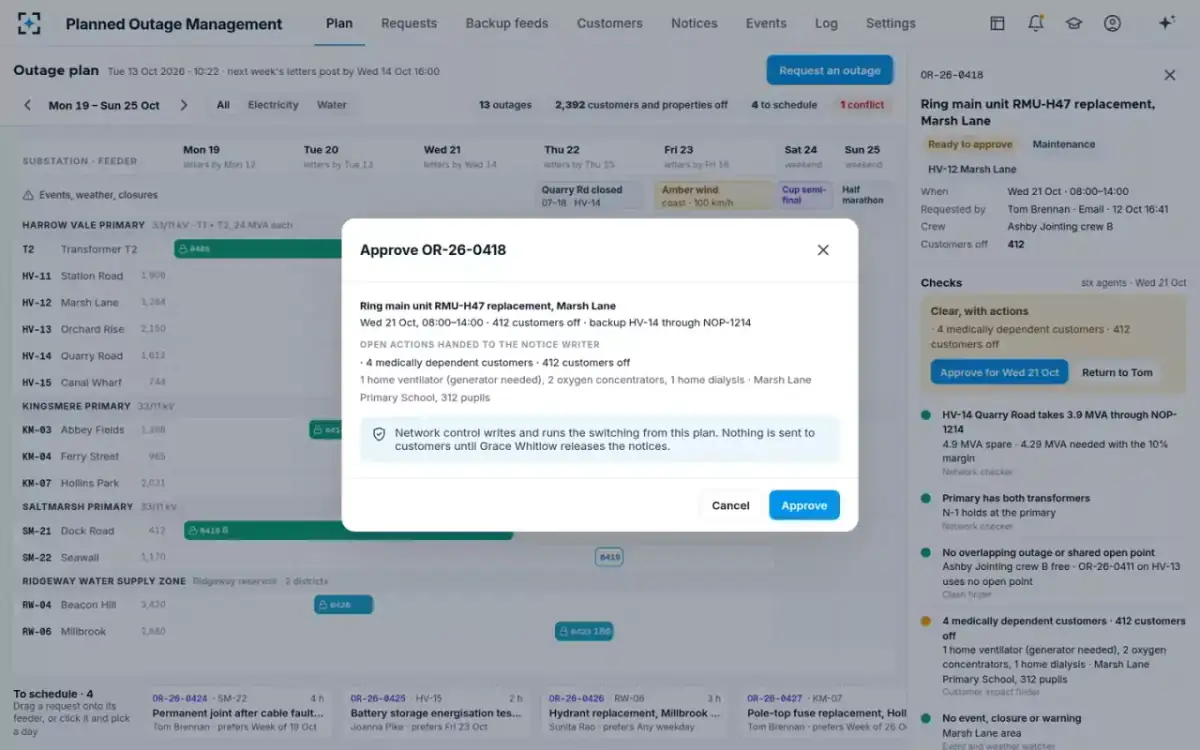

- 07Approve
What the coordinator approves, and what stays with others
Outage coordinatorThe approval shows the outage, its date and hours, 412 customers off and the backup through the open point. It lists the open tasks handed to the notice writer. It also says what the approval does not do. Network control still writes and runs the switching. Nothing reaches a customer until the communications lead releases it.
“Network control writes and runs the switching from this plan. Nothing is sent to customers until the communications lead releases the notices.”

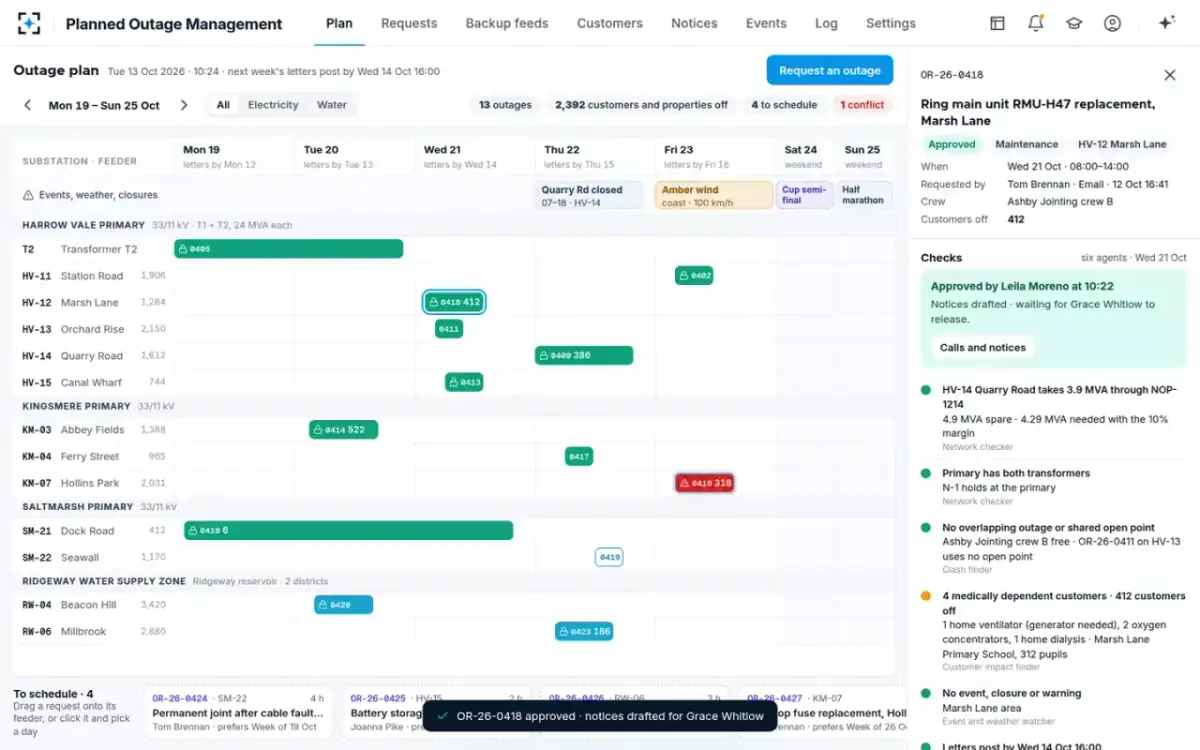

- 08Approved
Letters, texts, calls and a generator, drafted
Notice writerThe bar turns green on Wednesday. The notice writer drafts 412 letters, 386 texts and 241 emails to post by this Wednesday at 16:00. It books 4 priority care calls and a mobile generator for the home ventilator. It also writes a letter to the school. All of it waits for release.
“Notices drafted · waiting for the communications lead to release.”
- 09Before release
Who is off, who needs a call, and what they will read

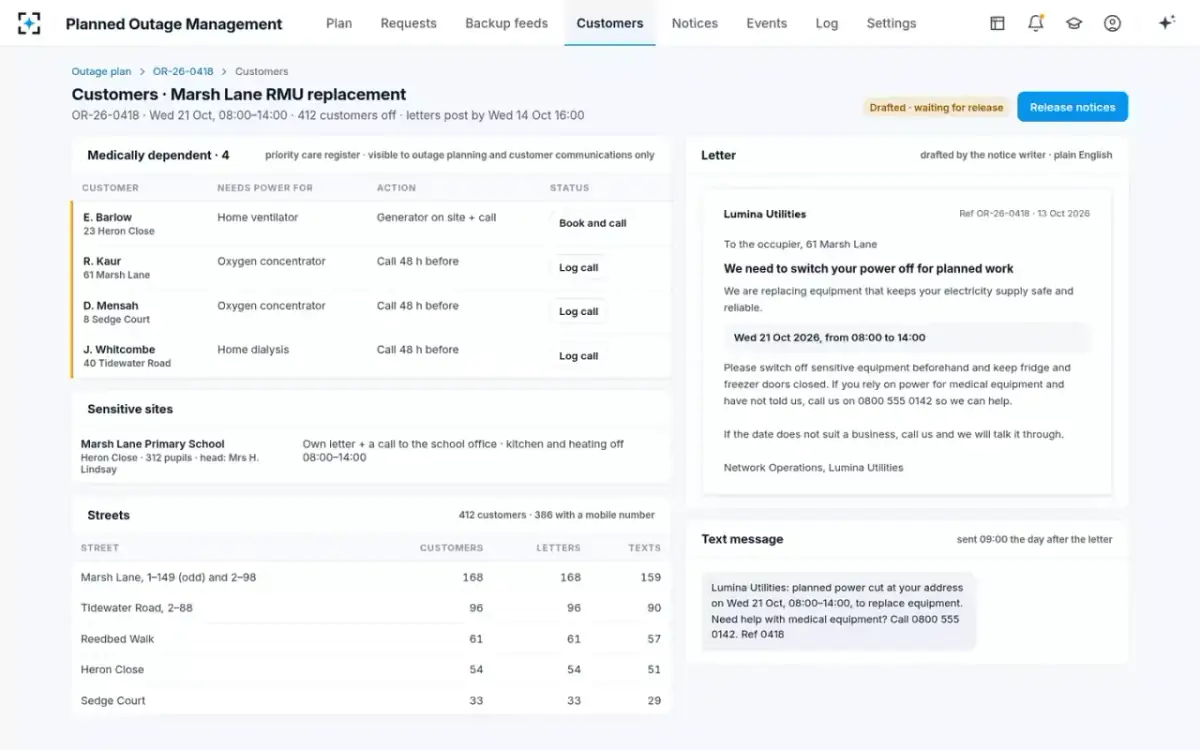

Customer communications leadThe communications lead sees the four medically dependent customers. Each shows what they need power for and what will be done. The ventilator customer gets a generator on site and a call. A call 48 hours before goes to the other three. The school gets its own letter and a call, because its kitchen and heating are off from 08:00 to 14:00. Beside them are five streets and 412 customers, 386 of them with a mobile number, with the plain-English letter and text.
Letter: “If you rely on power for medical equipment and have not told us, call us so we can help.”

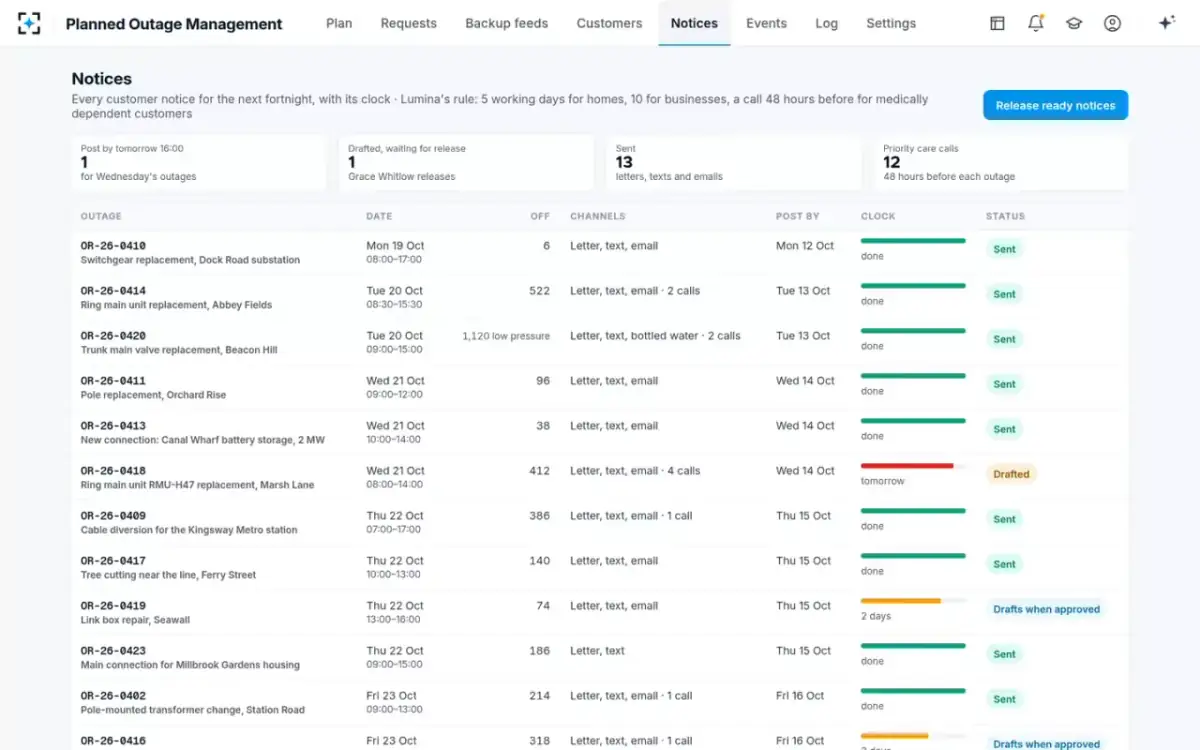

- 10The clock
Each notice on its clock

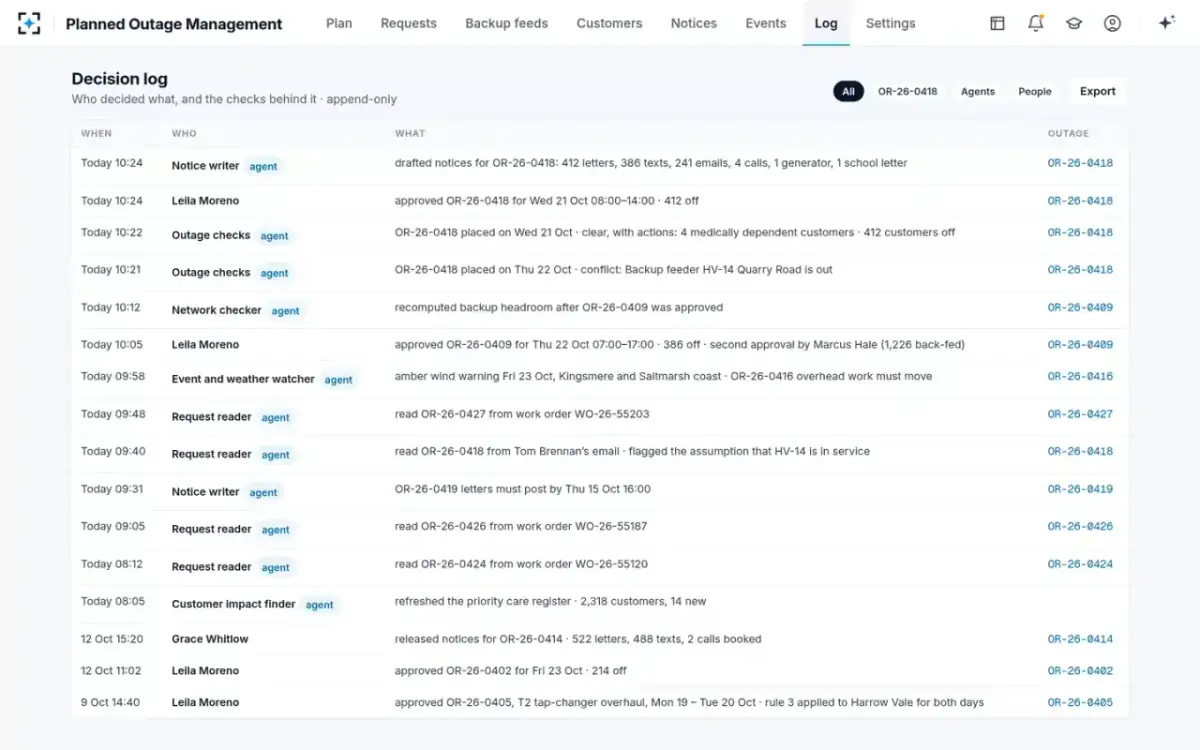

Customer communications leadOn the notices list, the outage shows Drafted, with its deadline at “tomorrow”. Its letters post by Wednesday. The fortnight's other outages sit beside it, sent or being drafted as each was approved, with their channels and calls. The communications lead releases them. Each step, by agent and by person, is already in the decision log, which cannot be edited.
“Letters post by 16:00 on the post-by day · texts and emails go at 09:00 the next morning · regulatory floor: 2 days”
