WorkflowGrid Operations & Outage Management

Outage Post-Event Review

Outage post-event review that finds the delays behind your outage minutes, and checks the fix held

Post-event reports in hours, actions tracked to closure.

See one case, screen by screen ↓
demo83,356customer minutespriced to one held dispatch — 13.4 % of the demo event's outage minutes, found and cited on the timeline
target10–15%fewer outage minutes on events like it, by fixing the delays each review finds
demo37minto the first life-support call-back in the demo event, flagged against the 30-minute standard
target100%of regulator reports and 120-day protection reviews inside their clock
The problem

Why a post-event review takes days, and the same delay comes back

When a feeder locks out, a substation trips or a near miss happens, someone has to explain it: what happened, in what order, why restoration took as long as it did, and what will stop it happening again. The evidence sits in seven places, each with its own clock: the SCADA sequence of events at millisecond GPS time, the relay records, the outage system's calls, prediction and dispatches, smart-meter last gasps, crew van GPS, the control-room log typed during the event, and the care-team call log. Before anyone can think about causes, an operations engineer spends days lining up timestamps in a spreadsheet.

The delays that cost the most customer minutes hide in the gaps between those systems. No single system shows the 23 minutes between the first customer call and the crew dispatch: the call is in the outage system, the hold is in the control-room log, the van is in the GPS feed. And when the report is done, its actions go into another spreadsheet, closed when the work is done rather than when it is shown to work — so the same delay returns on the next event.

typical11hourswithout power per US customer in 2024, about double a decade earlier
typical41%of WECC protection misoperations in 2024 came from incorrect settings
typical$44B a yearwhat sustained power interruptions cost US customers
Where a review's hours goestimated
By hand36 days
With the solution4.5 days
  • Pulling SCADA, relay, outage-system, meter, GPS and log records8 → 0.3 d
  • Lining up clocks and building the sequence of events8 → 0.3 d
  • Finding the delays and pricing them in customer minutes6 → 1 d
  • Checking protection operations against the feeder as built3 → 1 d
  • Searching past reviews for the same delay3 → 0.4 d
  • Writing the after-action report8 → 1.5 d

Estimated split of an operations engineer's working hours on one significant event, by hand and with the solution. In the working solution the timeline was built in 36 minutes and the cited draft was ready 4 h 10 min after assembly started.

How it works

How an outage becomes a review

Six agents merge every source onto one timeline, find the delays and draft the cited report; the review lead confirms the causes and signs.

What comes in
Evidence in7 sources · SCADA, relays, calls, meters, crew GPS, logs
Agents at work
Event assembler11,479 records, clocks aligned
Then
Delay finder3 delays, 5 decisions
Protection reviewer
Then
Lessons matchersame delay 3 times before
Then
Report writercited draft
Action tracker
A person decides
Review leadconfirms causes and signs
What comes out
Event timeline
Signed report
Actions to closure
One case, step by step

One feeder lockout, from the trip to a signed report

On Friday 9 October 2026 at 18:41:52, a cable joint fails on feeder F12 out of Corran Vale primary, a 33/11 kV substation of the fictional Lumina Utilities. 6,412 customers lose power, among them 3 life-support customers, Holmewood care home and Lumina's own Tamsin Hill water booster station. Here is the review, screen by screen, in the working solution.

  1. 01Oct 10, 07:58

    The review opens itself

    Mara Lindqvist · review lead

    The event passed a trigger — more than 1,000 customers off — so PER-2026-0219 opened in the register on its own, for 6,412 customers and 273 minutes. Mara, a senior operations engineer, sees it beside the other open reviews and their clocks: PER-2026-0207 with its report due Oct 21 and two sections unsigned, Storm Ilse at sign-off with Ruth Abernathy, and her own report due Nov 8.

    “41 reviews in 2026 · opened automatically when an event passes a trigger · 4 open”

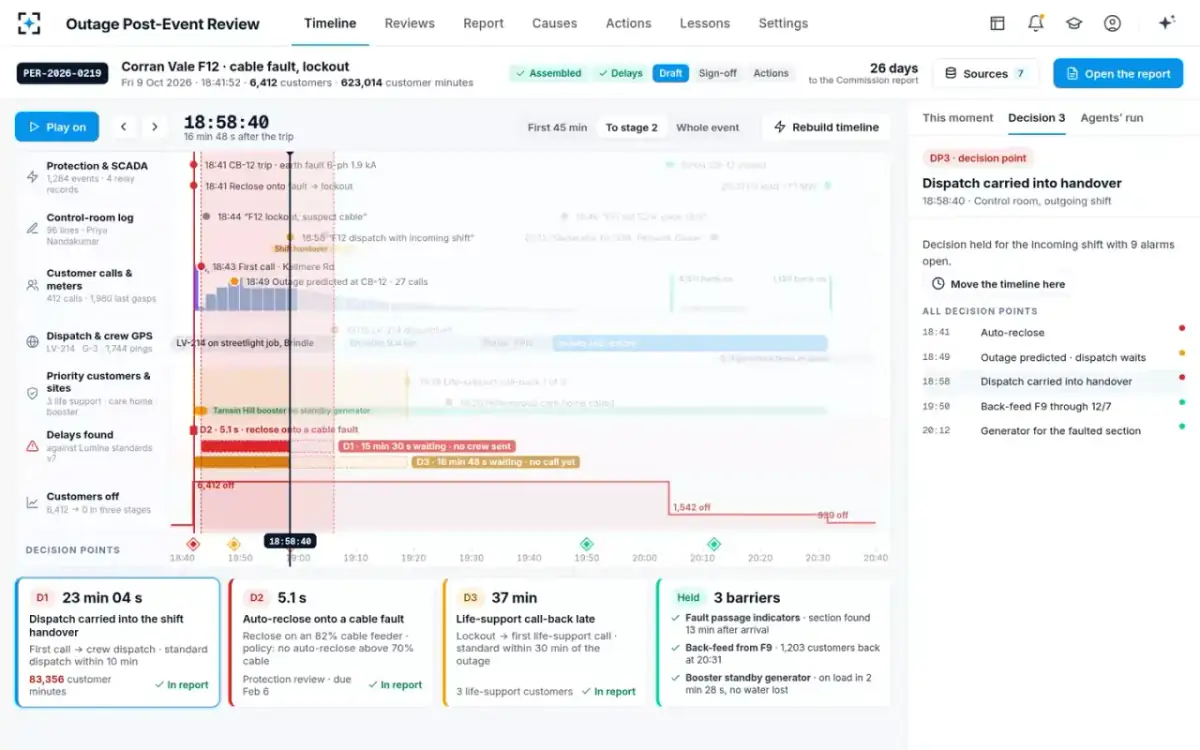

  2. 0208:05 → 08:41

    Seven sources, one clock

    Event assembler

    The event assembler reads 11,479 records for the event window: 1,284 SCADA events, 4 relay records, 416 outage-system records, 7,921 smart-meter events, 1,744 crew GPS pings, 96 control-room log lines and 14 care-team calls, plus 9 crew job notes. It aligns every clock to SCADA GPS time: the outage system was 2 s out, the care-team log 1 min 12 s, and the control-room log, typed to the minute, is anchored to SCADA on 11 lines.

    “The event assembler reads this source and never writes to it. The correction is shown on every item it moved.”

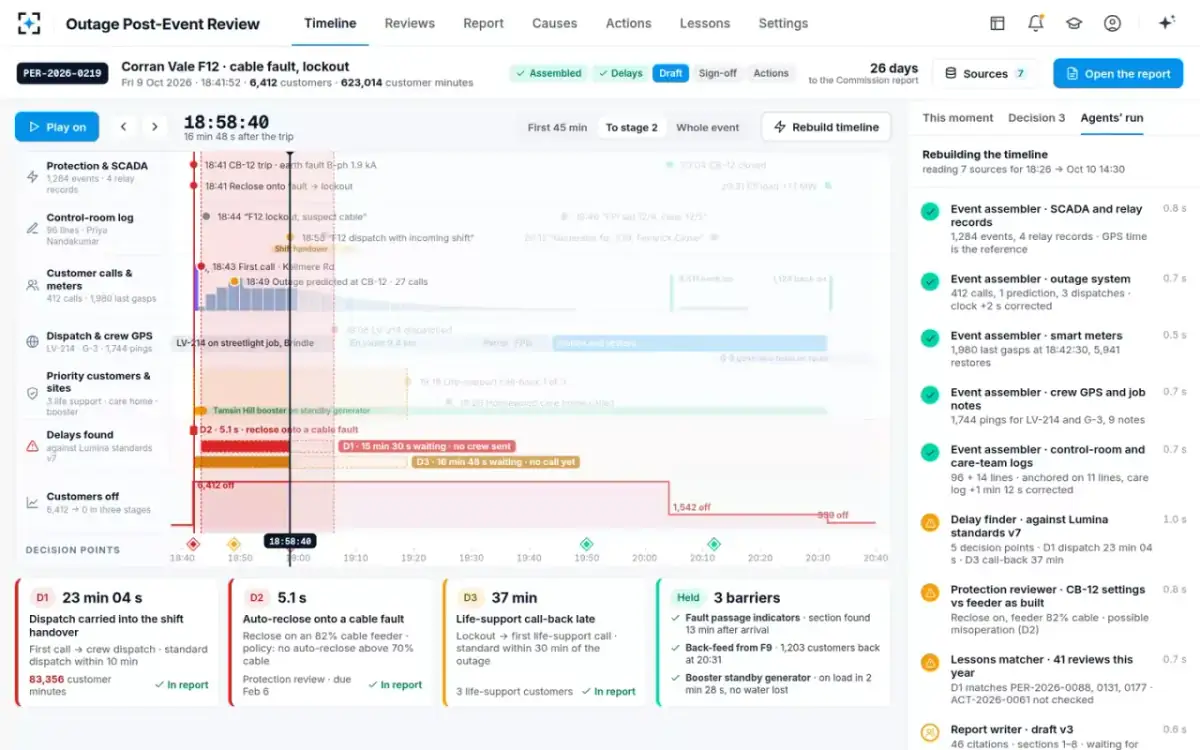

  3. 03The agents' run

    Three delays, five decision points, a lesson that did not hold

    Delay finder, Protection reviewer, Lessons matcher

    Against Lumina operating standards v7, the delay finder marks 5 decision points and measures D1, dispatch at 23 min 04 s, and D3, the life-support call-back at 37 min. The protection reviewer reads CB-12's settings against the feeder as built — reclose on, feeder 82 % cable — and flags a possible misoperation (D2). The lessons matcher finds D1 in three earlier reviews.

    Lessons matcher: “D1 matches PER-2026-0088, 0131, 0177 · ACT-2026-0061 not checked”

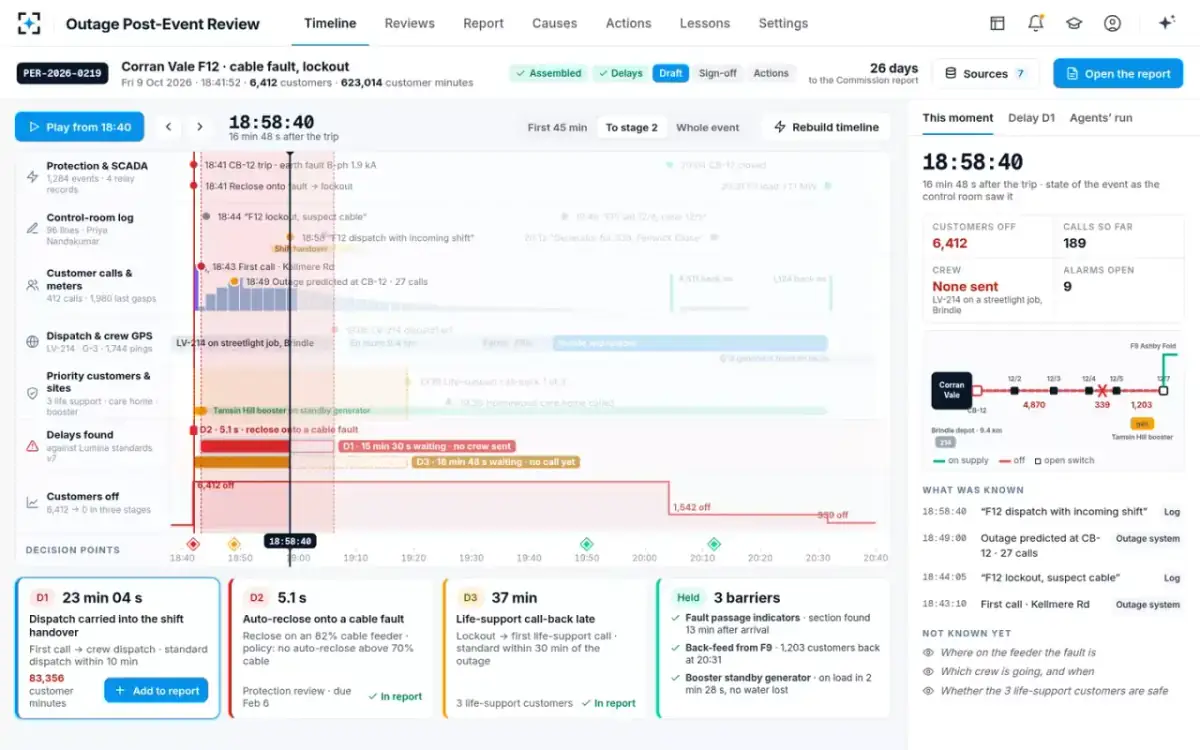

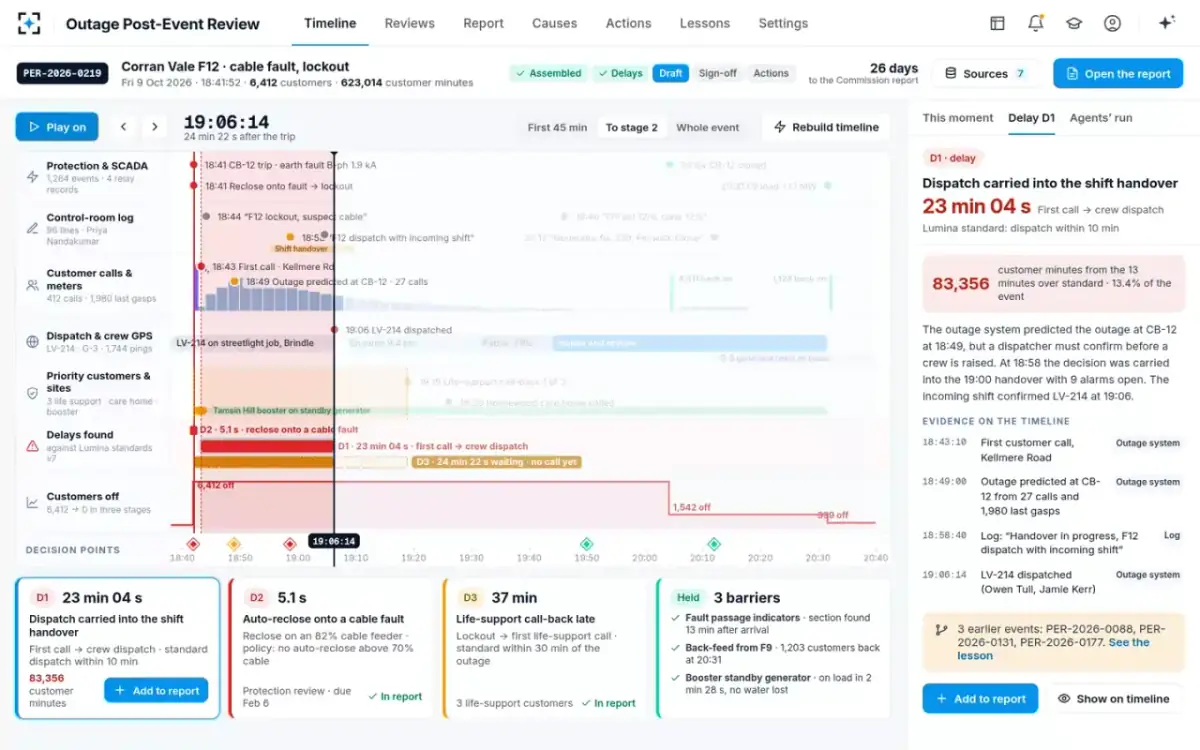

  4. 04Play from 18:40

    She plays the evening back

    Mara Lindqvist · review lead

    Five lanes on one time axis: protection and SCADA, the control-room log, customer calls and meters, dispatch and crew GPS, priority customers and sites. At 18:58:40, 16 min 48 s after the trip, the rail shows the event as the control room saw it: 6,412 customers off, 189 calls, 9 alarms open, and no crew sent — van LV-214 is still on a streetlight job in Brindle, 9.4 km away. The D1 bar fills as the playhead crosses it.

    Not known yet at 18:58:40: “Where on the feeder the fault is · Which crew is going, and when · Whether the 3 life-support customers are safe”

  5. 0519:06:14

    Twenty-three minutes, lost in a shift handover

    Delay finder

    The outage system predicted the outage at CB-12 at 18:49 from 27 calls and 1,980 last gasps, but a dispatcher must confirm before a crew is raised. At 18:58 the log reads “Handover in progress, F12 dispatch with incoming shift”, and the incoming shift sent LV-214 at 19:06:14. Against the 10-minute standard, the 13 extra minutes cost 83,356 customer minutes, 13.4 % of the event.

    Decision point 3: “Decision held for the incoming shift with 9 alarms open.” The delay finder names the decision, never the person.

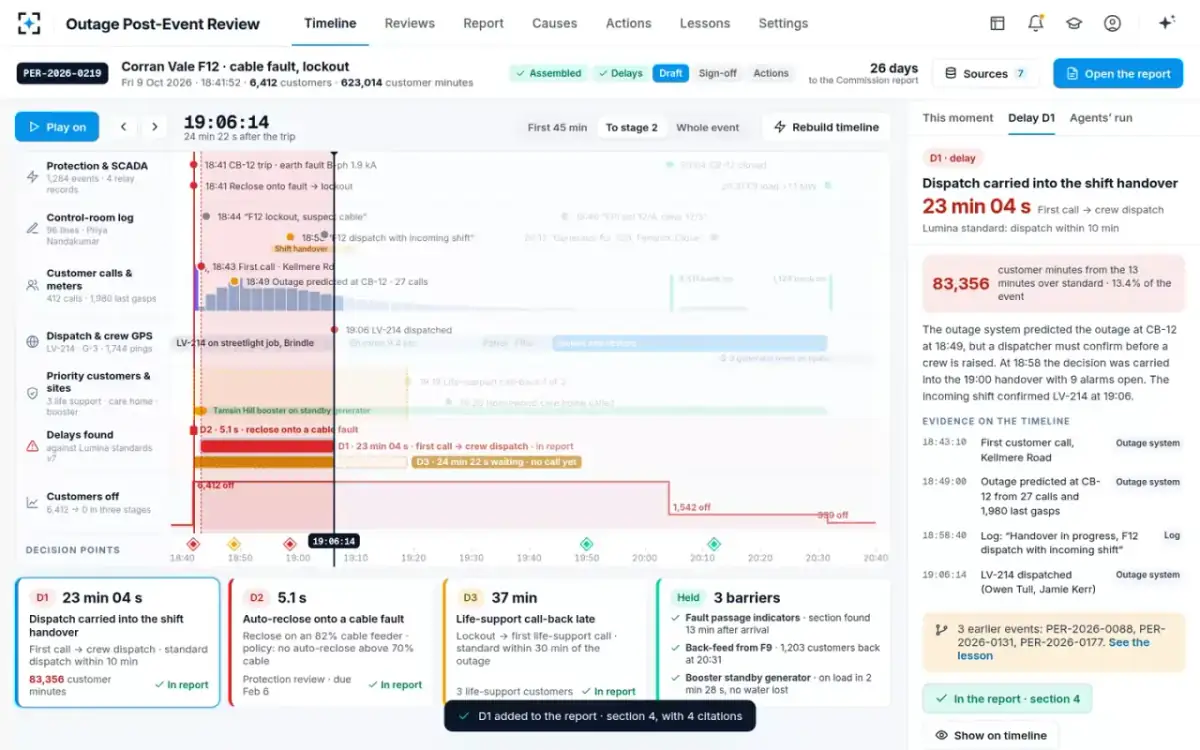

  6. 06One click

    D1 goes into the report, with its evidence

    Mara Lindqvist · review lead

    Each delay on the timeline carries its evidence from every lane: the first call at Kellmere Road, the prediction, the log line, the dispatch. Mara adds D1 to the report. It lands in section 4, Delays and decision points, numbered with its timestamps, and the draft goes from 46 to 50 citations.

    “D1 added to the report · section 4, with 4 citations”

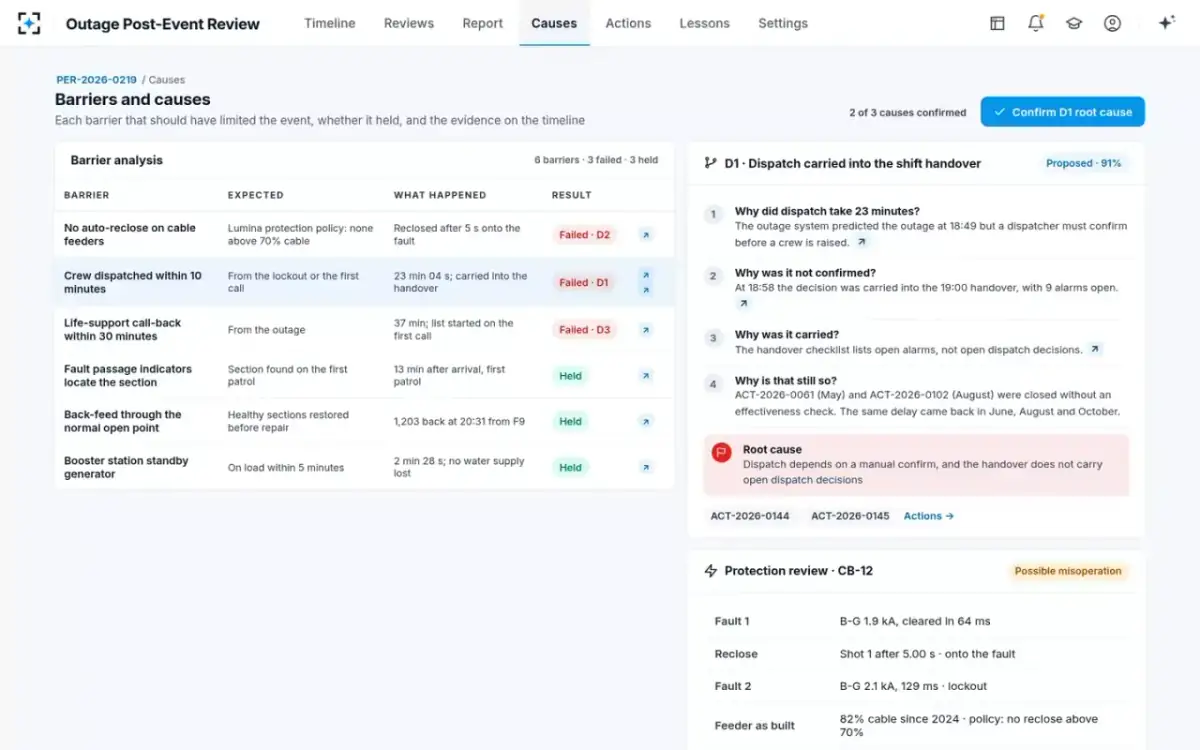

  7. 07The causes

    Six barriers: three failed, three held

    Protection reviewer · Dev Ramaswamy

    The barrier analysis lists what should have limited the event. Failed: no auto-reclose on cable feeders (D2), crew dispatched within 10 minutes (D1), life-support call-back within 30 minutes (D3). Held: fault passage indicators found the section 13 minutes after arrival, back-feed from F9 restored 1,203 customers at 20:31, and the booster's standby generator took load in 2 min 28 s, with no water supply lost. The protection review of CB-12 goes to Dev Ramaswamy, due Feb 6, 2027, with 14 similar feeders listed.

    D1 root cause, proposed at 91 %: “Dispatch depends on a manual confirm, and the handover does not carry open dispatch decisions”

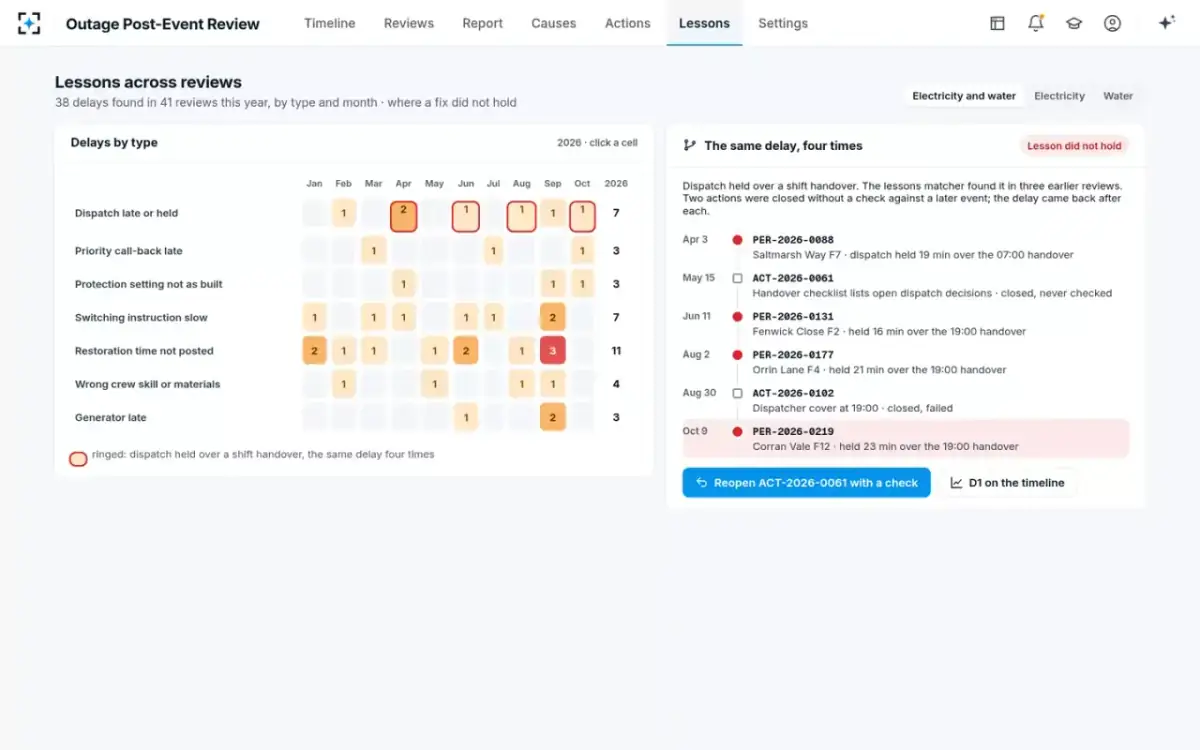

  8. 08Before signing

    The same delay, four times

    Lessons matcher

    Dispatch held over a shift handover also happened at Saltmarsh Way F7 in April (19 min over the 07:00 handover), Fenwick Close F2 in June (16 min) and Orrin Lane F4 in August (21 min). ACT-2026-0061, a handover checklist change, was closed in May and never checked; ACT-2026-0102, dispatcher cover at 19:00, was closed in August and failed. Mara reopens ACT-2026-0061 with an effectiveness check on the next 5 handovers with an open fault.

    “Two actions were closed without a check against a later event; the delay came back after each.”

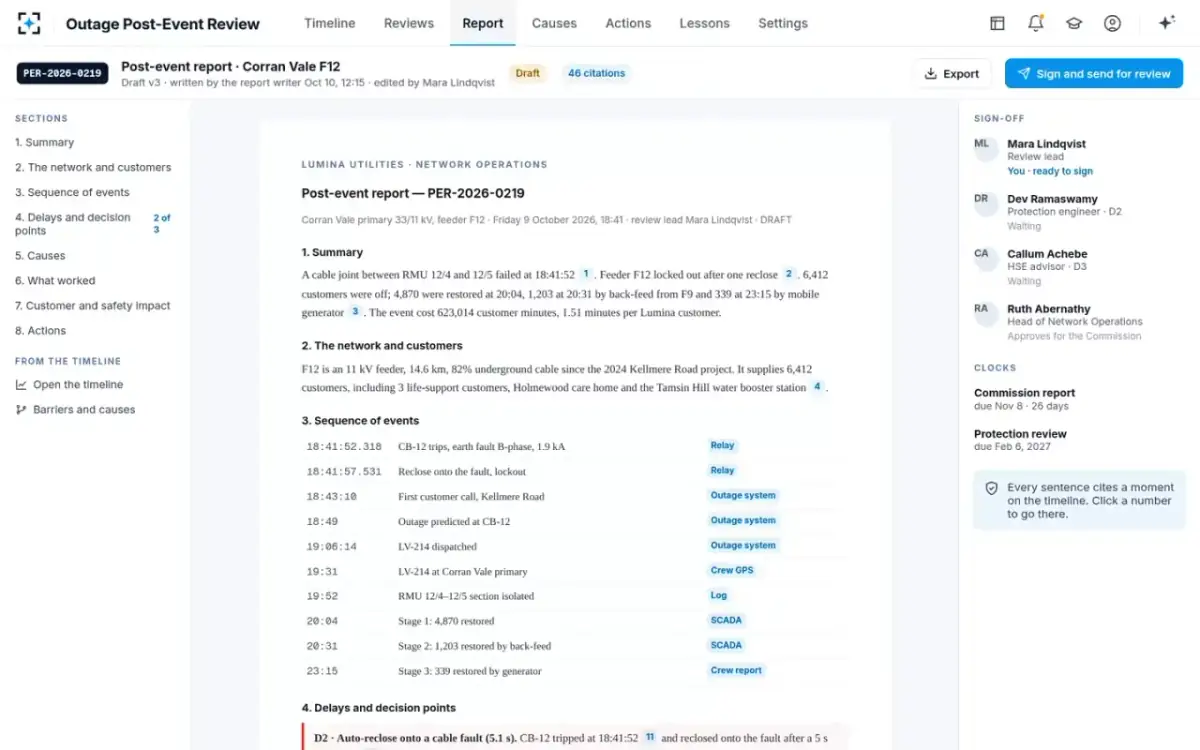

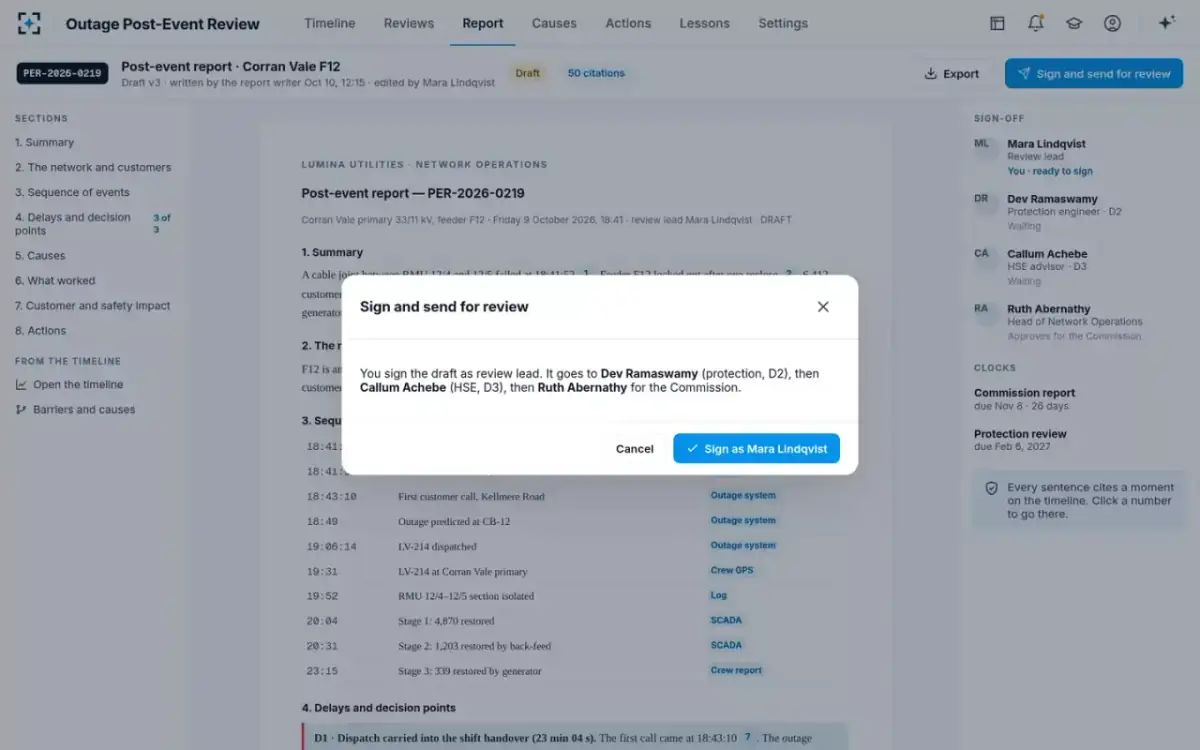

  9. 09Signed · 26 days left

    The cited report, signed and on its way

    Mara Lindqvist · review lead

    The report writer drafted the post-event report in Lumina's template — summary, network and customers, sequence of events, delays and decision points, causes, what worked, customer and safety impact, actions — with a citation on every sentence that jumps back to its moment on the timeline. Mara signs as review lead. It goes to Dev Ramaswamy for the protection section, then Callum Achebe for safety and life support, then Ruth Abernathy for the Commission.

    The report writer's limit: no sentence without a citation, and the report stays draft until the review lead signs.

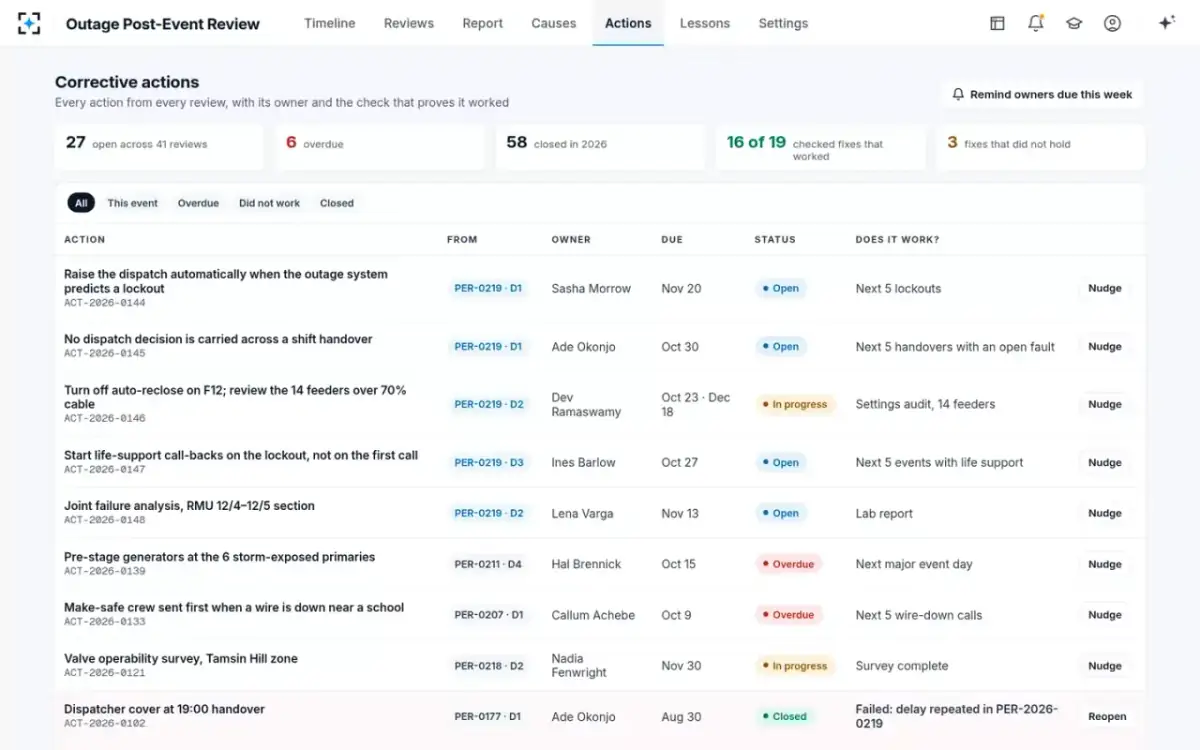

  10. 10Until it works

    Five actions, each with the check that proves it

    Action tracker

    ACT-2026-0144: raise the dispatch automatically when the outage system predicts a lockout — Sasha Morrow, Nov 20. ACT-2026-0145: no dispatch decision carried across a handover — Ade Okonjo, Oct 30. ACT-2026-0146: auto-reclose off on F12 and the 14 feeders over 70 % cable reviewed — Dev Ramaswamy. ACT-2026-0147: life-support call-backs start on the lockout — Ines Barlow. ACT-2026-0148: joint failure analysis — Lena Varga. Each carries the check that proves it: the next 5 lockouts, the next 5 handovers with an open fault, a settings audit of the 14 feeders, the next 5 events with life-support customers, the lab report.

    “Every action from every review, with its owner and the check that proves it worked”

Who it’s for

Built for everyone who answers for an outage.

The same lockout, seen by the five people who own its review — what the work looked like, and what it looks like now.

ML
Mara LindqvistSenior operations engineer, Lumina Utilities · leads post-event reviews
Review lead
Before
Leads 3–4 reviews a month on top of planning work. “I spend three days lining up timestamps before I can even start thinking.”
Now
Opens the event already on one timeline, plays it back, confirms the causes and signs a draft in which every sentence points to its moment.
DR
Dev RamaswamyProtection engineer · decides misoperations, owns settings
Protection engineer
Before
Reads relay event records after every trip. “The relay did what it was set to do. The setting was wrong for the feeder it now protects.”
Now
Gets the protection review drafted — both fault records, the reclose shot, the feeder as built — and the 14 similar feeders listed, on a 120-day clock.
PN
Priya NandakumarControl engineer, Corran Vale desk · on shift during the event
Control engineer
Before
Runs the 11 kV network for the east area on 12-hour shifts. “At 18:58 I was handing over with nine alarms open.”
Now
Sees the review describe the decision and the system — a dispatch that waits for a manual confirm, a handover checklist without open dispatch decisions — not the person.
CA
Callum AchebeHSE advisor · signs safety and priority-customer findings
HSE advisor
Before
Reviews safety and vulnerable-customer findings in every review. “If a life-support customer waits past 30 minutes, I need to know why, every time.”
Now
Every life-support call-back is measured against its standard on every event, and the review comes to him to sign when a safety or priority-customer delay is found.
RA
Ruth AbernathyHead of Network Operations · approves reports for the Commission
Head of Network Operations
Before
Signs every major-interruption report to the regulator. “I want the actions closed, not just written down.”
Now
Sees every open, overdue and failed action across the year's reviews, and which fixes held when the next event came.
Built on the engine

6 agents. Each with one job, and hard limits.

Six agents merge every source onto one timeline, find the delays and draft the cited report; the review lead confirms the causes and signs.

Event assembler

Pulls every source for the event window — trip minus 15 minutes to normal running — and puts it on one timeline: SCADA sequence of events, relay records, outage-system calls, predictions and dispatches, smart-meter events, crew GPS and notes, the control-room log and the care-team log, every clock aligned to SCADA GPS time.

  • Read-only on every source system
  • Every correction shown, never silent
  • A timestamp it cannot place is flagged, not guessed
Delay finder

Walks the merged timeline, marks every decision point, automatic or human, and measures each interval that has a Lumina standard — dispatch, call-back, switching, restoration time posted. For each breach it says what was waiting and for what, and prices the excess in customer minutes.

  • No blame: names systems and decisions, not people
  • Every delay cites at least two sources
Protection reviewer

Reads the relay event records for every operation in the event, compares the active settings with the feeder as built — cable share, length, load — flags any operation that may be a misoperation and drafts the protection review for the engineer.

  • Never changes a setting
  • The protection engineer decides on every misoperation
Lessons matcher

Searches all past reviews for the same delay or cause, lists the matches with their actions and whether those actions were checked, and flags any lesson that did not hold.

  • Shows the reason for every match
  • Never merges reviews
Report writer

Drafts the post-event report in Lumina's template — summary, the network and customers, sequence of events, delays and decision points, causes, what worked, customer and safety impact, actions — every sentence cited to a moment on the timeline. Exports to Word and PDF.

  • No sentence without a citation
  • Stays draft until the review lead signs
Action tracker

Turns each confirmed cause into an action with an owner, a due date and an effectiveness check, reminds owners 5 days before the due date, and after closure watches the next events of the same kind to report whether the delay came back.

  • Never closes an action without evidence
  • Reopens only with the review lead's agreement
Review lead

Confirms causes and signs. The agents propose; a named person decides.

Ask in plain words

Ask about any moment of the event

Ask about a moment, a delay or an action, or say what to change. Every answer points back to the timeline.

Why did the crew take 23 minutes to be sent?

The dispatch waited for a person, then for the handover. The first call came at 18:43:10. The outage system predicted the lockout at 18:49, but dispatch needs a dispatcher to confirm. At 18:58 the log says “F12 dispatch with incoming shift”, and LV-214 was sent at 19:06:14. Against the 10-minute standard that is 13 extra minutes for 6,412 customers: 83,356 customer minutes, 13.4 % of the event.

Which other feeders still auto-reclose on mostly cable?

14 feeders over 70 % cable still have auto-reclose on. The four with the most cable: Saltmarsh Way F7 (91 %), Kellmere F3 (88 %), Corran Vale F12 (82 %) and Orrin Lane F6 (79 %). F12 changed in the 2024 Kellmere Road cable project; the setting was never reviewed. ACT-2026-0146 asks Dev Ramaswamy to review all 14 by Dec 18.

Was any life-support customer left too long?

Yes, all three. The lockout was at 18:41:52; the care team's list only reached them at 18:51 because it starts on the first customer call; the first life-support call was at 19:19, 37 minutes against Lumina's 30. All three had backup and were fine. ACT-2026-0147 moves the start to the lockout.

Draft the summary for Ruth

On 9 Oct at 18:41 a cable joint failed on Corran Vale F12; 6,412 customers lost power for up to 273 minutes, 623,014 customer minutes in all. Two things made it worse: the breaker reclosed onto the fault, and the dispatch waited 23 minutes. Five actions are with their owners. It is in the report, marked draft.

Every screen

The working solution, as it ships.

13 screens from the working solution, on its sample data. Pick one to see it large.

The event timelineEvery source on one time axis, the state of the event as the control room saw it at the playhead, and the delays the agents found.
A delay, explainedD1 locked at 23 min 04 s, priced at 83,356 customer minutes, with its evidence from each lane and three earlier events like it.
Add to the reportOne click writes the delay into section 4 of the draft, with its timestamps and citations.
Decision pointsEvery automatic and human decision on the axis, from the auto-reclose at 18:41 to the generator for the faulted section at 20:12.
The agents' runThe timeline rebuilt source by source, the clocks corrected, then the delays, the protection check, the lessons and the draft.
Seven sources, one clock11,479 records, each source's count, time range and clock correction, with sample raw records.

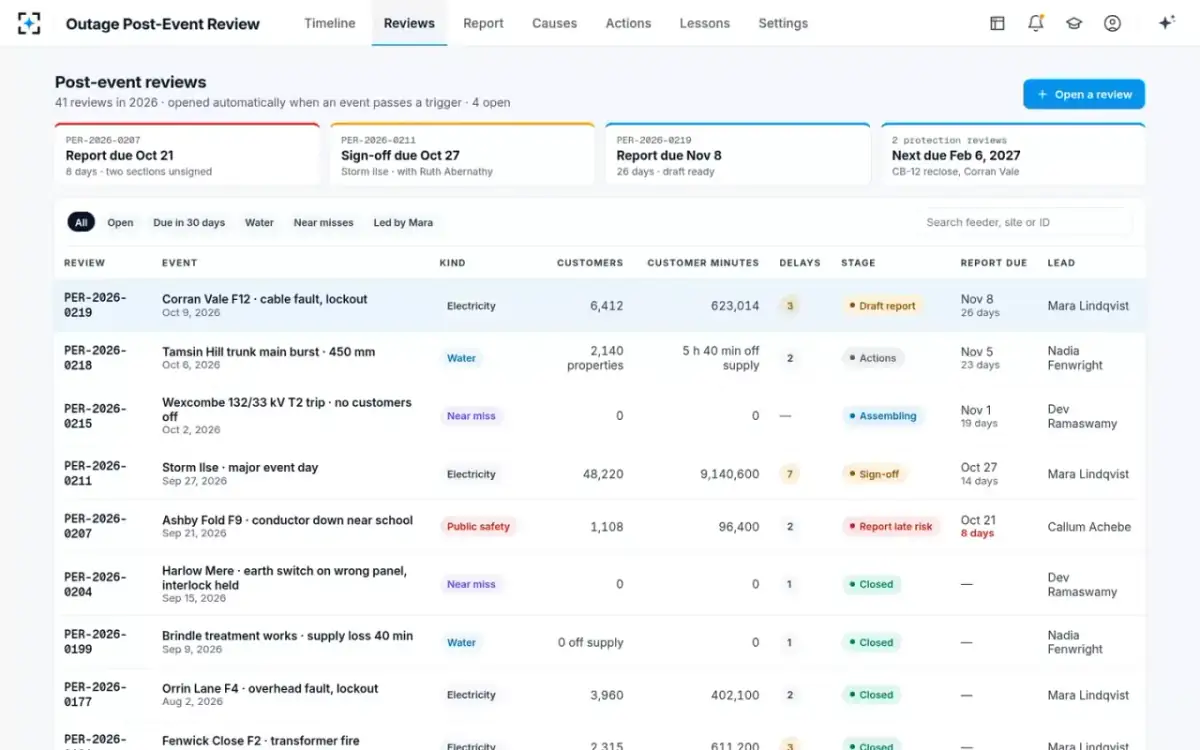

Post-event reviewsEvery review this year with its kind, customers, customer minutes, delays, stage, report clock and lead.
The cited reportThe draft in Lumina's template, every sentence numbered to a moment on the timeline, with the sign-off order and the clocks.
Sign and send for reviewThe review lead signs; the draft goes to protection, then HSE, then the Head of Network Operations for the Commission.
Barriers and causesSix barriers, three failed and three held, the why chain for D1 and the protection review of CB-12.
Corrective actionsEvery action from every review with its owner, due date, status and the check that proves it worked.
Lessons across reviews38 delays in 41 reviews by type and month, and the dispatch held over a handover found four times.
Your rulesWhen a review opens, the standards the delays are measured against, the clocks and who signs.
Governance

Built for a review a regulator will read: cited, signed, without blame.

Every line points to its momentEvery item on the timeline links to its source record, and every sentence in the report cites a moment on the timeline. Click a citation number and the timeline jumps there.
Read-only on operational systemsThe agents read SCADA, relay, outage, meter and field systems and never write to them. The protection reviewer never changes a setting.
Clock corrections in the openEvery source is aligned to SCADA GPS time, and each correction — outage system +2 s, care-team log +1 min 12 s — is shown on every item it moved. A timestamp that cannot be placed is flagged, not guessed.
Decisions and systems, not peopleDelays describe what was waiting and why — “dispatch was carried into the handover” — never who: a just-culture rule built into the delay finder.
Named people sign, in orderThe review lead confirms causes and signs; the protection engineer decides any misoperation; the HSE advisor signs safety and priority-customer findings; the Head of Network Operations approves the report for the Commission.
Closed when it works, not when it is doneAn action closes only with evidence, and its effectiveness is checked on the next events of the same kind. Each agent step and each person's decision is on the activity trail with its time.
Configuration

Your standards and clocks, not ours

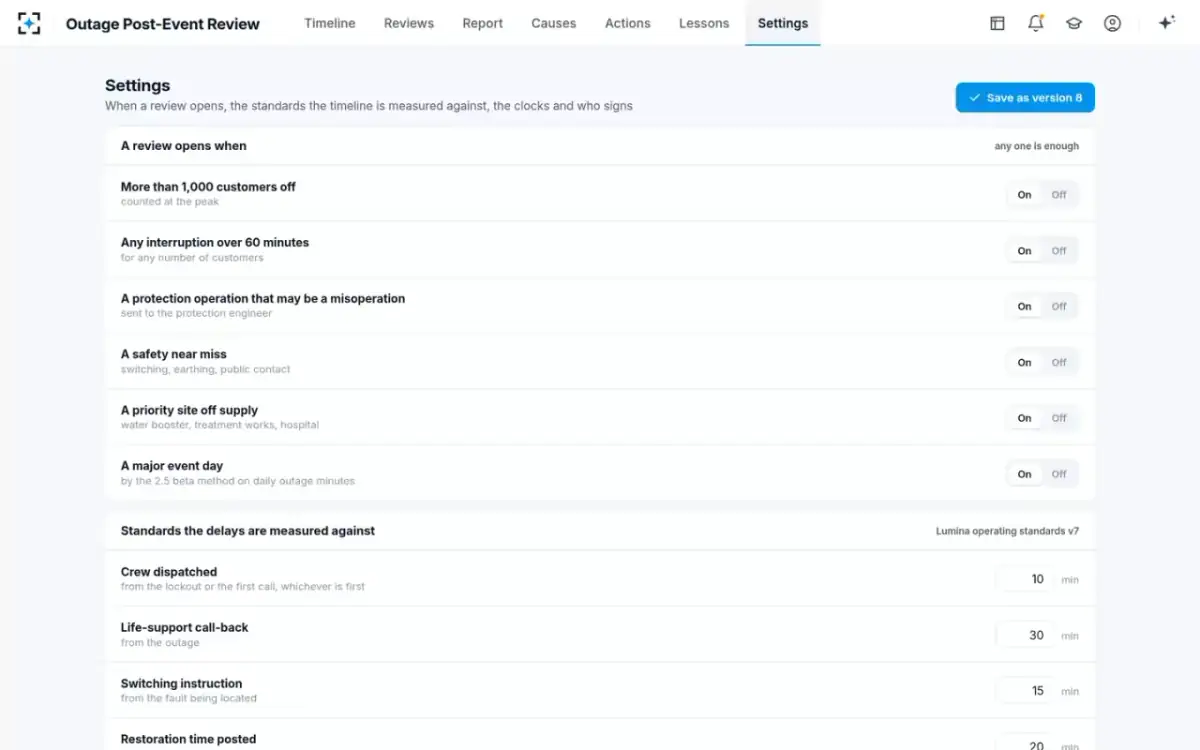

When a review opens, the standards the timeline is measured against, the clocks and who signs are settings, saved as a new version that applies to reviews opened from then on.

SettingDefaultChoose from
A review opens whenAny one of six triggers · all six onEach On · Off: more than 1,000 customers off (counted at the peak), any interruption over 60 minutes, a protection operation that may be a misoperation, a safety near miss, a priority site off supply, a major event day by the 2.5 beta method
Crew dispatched10 minMinutes from the lockout or the first call, whichever is first
Life-support call-back30 minMinutes from the outage
Switching instruction · restoration time posted15 min · 20 minFrom the fault being located · from the outage
Report to the Commission30 daysDays, set by the Lumina licence condition
Protection review120 daysDays until the misoperation is decided
Default action due · effectiveness check30 days · 5 eventsDays from the cause being confirmed · later events of the same kind
Who signs, in this orderReview lead → protection engineer → HSE advisor → Head of Network OperationsReview leads Mara Lindqvist, Hal Brennick, Nadia Fenwright (water); protection and HSE sign when their kind of delay is found
Connections

Works with the systems an outage already leaves records in

SCADA and protection relaysthe sequence of events at GPS time, relay fault records and the active settings
Outage managementcustomer calls, the outage prediction and every dispatch
Smart-meter head-endlast-gasp and restore messages from the meters on the feeder
Field servicecrew van GPS pings and job notes
Control-room and care-team logsthe shift log typed during the event and the priority-services call log
Standards and past reviewsoperating standards, protection policy, the report template, the regulator's reporting guide and every earlier review
What it changes

The difference, in numbers.

Every figure is labelled: a target the solution is built to, an estimate, a typical published result, or a proven one.

target
10–15%
fewer outage minutes on events like it, by fixing the delays each review finds
One held dispatch13.4% of the event
Fixed0
target
Every
life-support call-back checked against its 30-minute standard, in every review
30-minute standard
checked on every event
target
100%
of regulator reports and 120-day protection reviews inside their clock
Draft ready with 26 days left
30-day report clock

“demo” = seen in the working solution, on its sample event (there, 13.4 % = 13 excess minutes × 6,412 customers, of 623,014 customer minutes) · “target” = the design goal, measured in the live solution · “estimated” = our estimate (the hours split) · “typical” = published figures: EIA, Electric Power Annual 2024 (about 11 hours without power per US customer); WECC 2024 Misoperations Report (41 % from incorrect settings); LBNL, LaCommare et al., Energy, 2018 (about $44B a year). Regulatory context: NERC PRC-004-5(i) (120 days to identify a misoperation, 60 days for the corrective action plan). Lumina Utilities, its network and the people named on this page are fictional — characters and sample data in the working solution.

Questions

What network operators ask us.

What is an outage post-event review?

It is the review a network operator owes after a significant interruption, a protection operation or a near miss: what happened in what order, why restoration took as long as it did, the causes, and the actions that will stop it happening again. Outage Post-Event Review builds the sequence of events from every source, finds and prices the delays, drafts the cited report and tracks the actions.

How does outage root cause analysis work in the solution?

The event assembler puts SCADA, relay, outage-system, smart-meter, crew GPS and log records onto one timeline at SCADA GPS time. The delay finder measures each interval against your standards and marks the decision points; the protection reviewer checks relay operations against the feeder as built. A barrier analysis shows which barriers failed and which held, with a why chain for each delay that the review lead confirms.

How does it reduce outage minutes?

By finding the delays that add customer minutes and making sure the fix works. In the sample event one held dispatch cost 83,356 customer minutes, 13.4 % of the event; the lessons matcher found the same delay three times before, after two actions closed without a check. The design target is 10–15 % fewer outage minutes on events like it.

Does it check protection misoperations?

Yes. The protection reviewer reads every relay operation in the event against the active settings and the feeder as built, flags a possible misoperation and drafts the protection review. In the sample case CB-12 reclosed onto a cable fault on a feeder that had become 82 % cable, against a policy of no auto-reclose above 70 %. The protection engineer decides, and the agent never changes a setting.

How does it keep regulator reports and protection reviews on time?

Every review carries its clocks — in the sample, 30 days to the Commission under Lumina's licence condition and 120 days for a protection review — and the register shows each one's days left. The sample draft was ready with 26 days to go. The clocks are settings, so they can follow your own regulator's rules.

Does it blame the control engineer?

No. The delay finder describes the decision and the system, never the person: “dispatch was carried into the handover”, with the cause found in a manual confirm step and a handover checklist that does not list open dispatch decisions.

Do people stay in control of the review?

Yes. The agents are read-only on SCADA, relay, outage, meter and field systems; they propose causes and draft, and the report stays draft until the review lead signs. The protection engineer, the HSE advisor and the Head of Network Operations sign their parts in order, and an action closes only with evidence.

How long does it take to go live?

The Agentic Solution Engine builds and deploys it from your requirements and documents — your operating standards, protection policy, report template and the records of a few past events — and it goes live once every quality gate has passed. We will walk you through it on one of your own recent outages first.

See it on
your last outage.

We'll run Outage Post-Event Review on the records of one of your own recent events.
