- Before
- Approves each planned-outage notice, watches live faults and answers to the customer director for the complaints. Can see what was sent, with no view of who has been told.
- Now
- Opens each outage as a map of who has been told, on which channel and in which language. Approves the drafts in each language with one Send.
A moved isolation point, 120 premises not told and six hours to the minimum
A planned outage replaces a ring main unit, a sealed switching unit, on an 11 kV feeder. Supply is off from 15:00 to 19:00 on a set Tuesday. Friday's first notice went to 1,726 premises. On Monday morning the switching plan changed. Here is what happens next, screen by screen, in the working solution.
A worked example on sample data. Names, IDs and figures on the screens and in this section come from the demo.

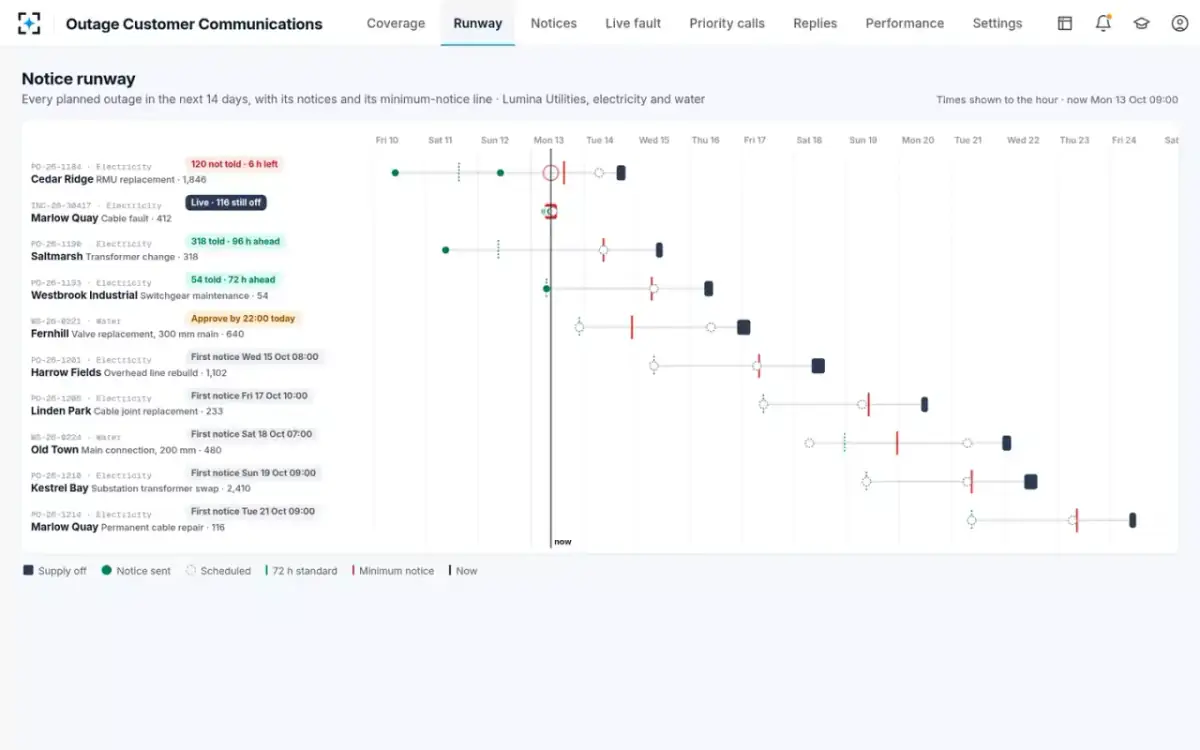

- 01Monday, 09:00

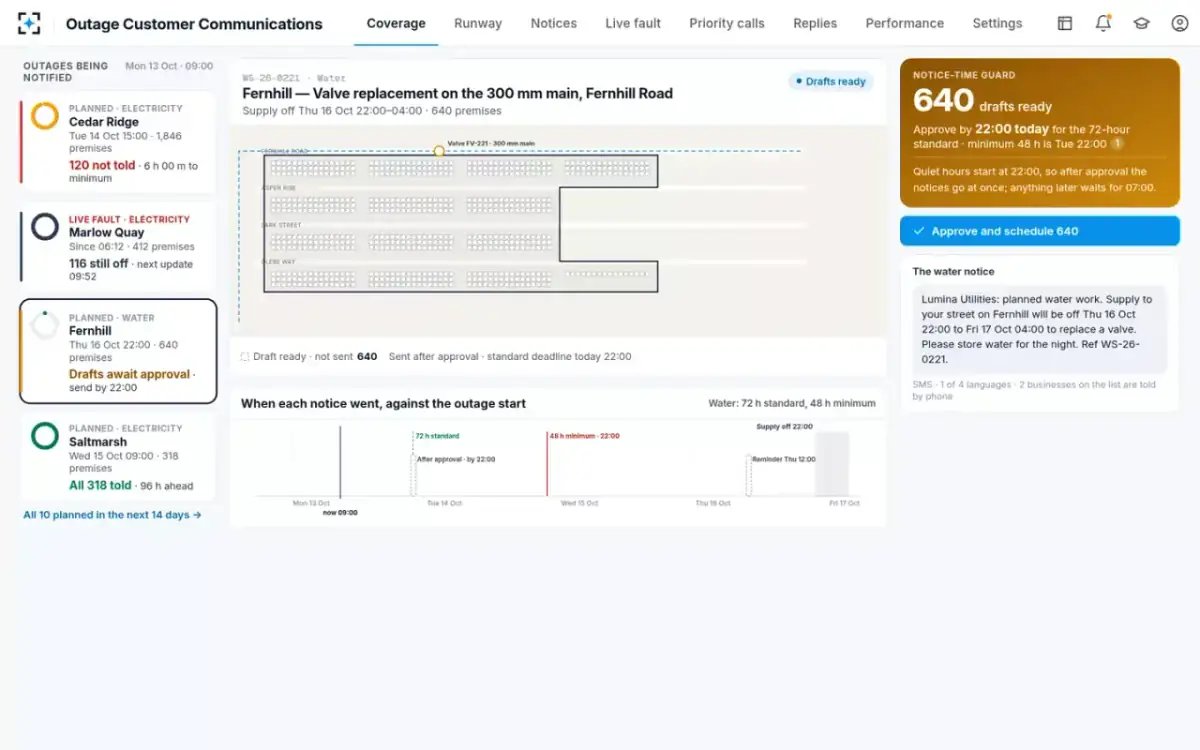

The outage opens as a map of who has been told

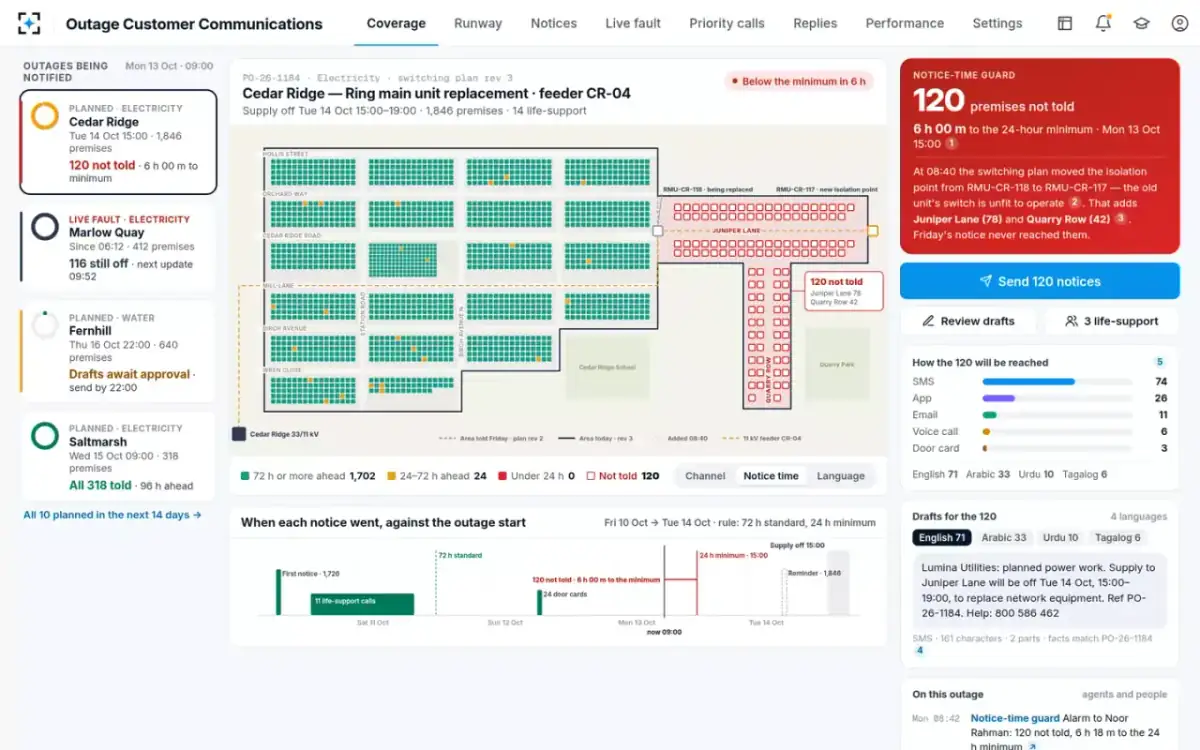

Outage communications leadThe communications lead approves each planned-outage notice at the utility. The home screen lists the four outages being notified now. It draws this one as an area of premises, each square colored by the channel that reached it. Inside the new area, 120 squares sit hollow with a red edge. The notice-time guard's alarm reads 120 premises not told, 6 h 00 m to the 24-hour minimum.
Before this screen, the lead could see what was sent. There was no way to see who had been told.
- 02Earlier, 08:40
The isolation point moves, and the area grows
Outage managerThe field survey found the ring main unit's switch unfit to operate. So the outage manager revised the switching plan to rev 3 and moved isolation one unit up. At 08:41 the affected-premises tracer traced the network again. It found 120 premises added on two streets, 78 and 42, and none removed. Colored by notice time, the map shows 1,702 told 72 h or more ahead and 24 told 24 to 72 h ahead. The other 120 were not told at all.
Notice-time guard, 08:42: alarm to the communications lead, 120 not told, 6 h 18 m to the 24 h minimum
- 0308:42

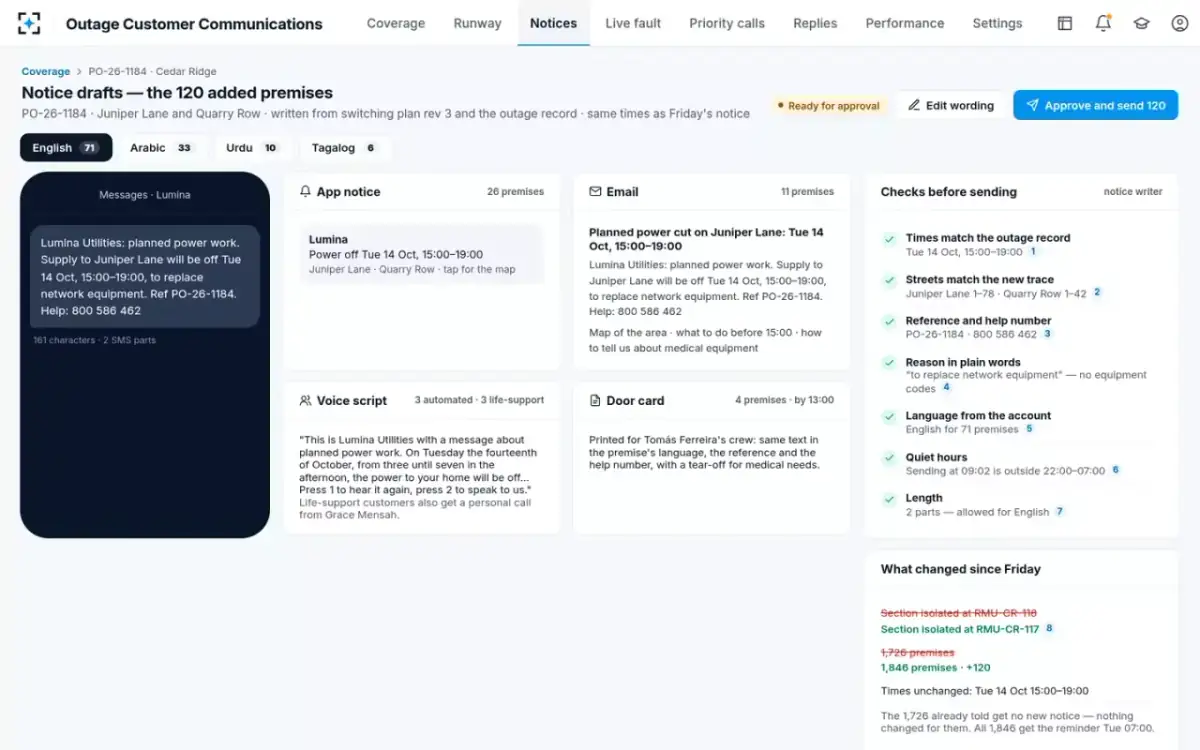

Drafts for the 120, with each fact checked
Notice writerThe contact and channel picker chose SMS for 74, app for 26, email for 11, voice for 6 and door cards for 3. It flagged 3 life-support customers. The notice writer drafted the SMS, app, email, voice script and door card from the outage record. Then it ran its checks. Times must match the record, and streets must match the new trace. The reference and help number must be right. The reason must be in plain words with no equipment codes. Quiet hours and length are checked too.
“The 1,726 already told get no new notice, as nothing changed for them. All 1,846 get the reminder on Tuesday at 07:00.”
- 04Before sending

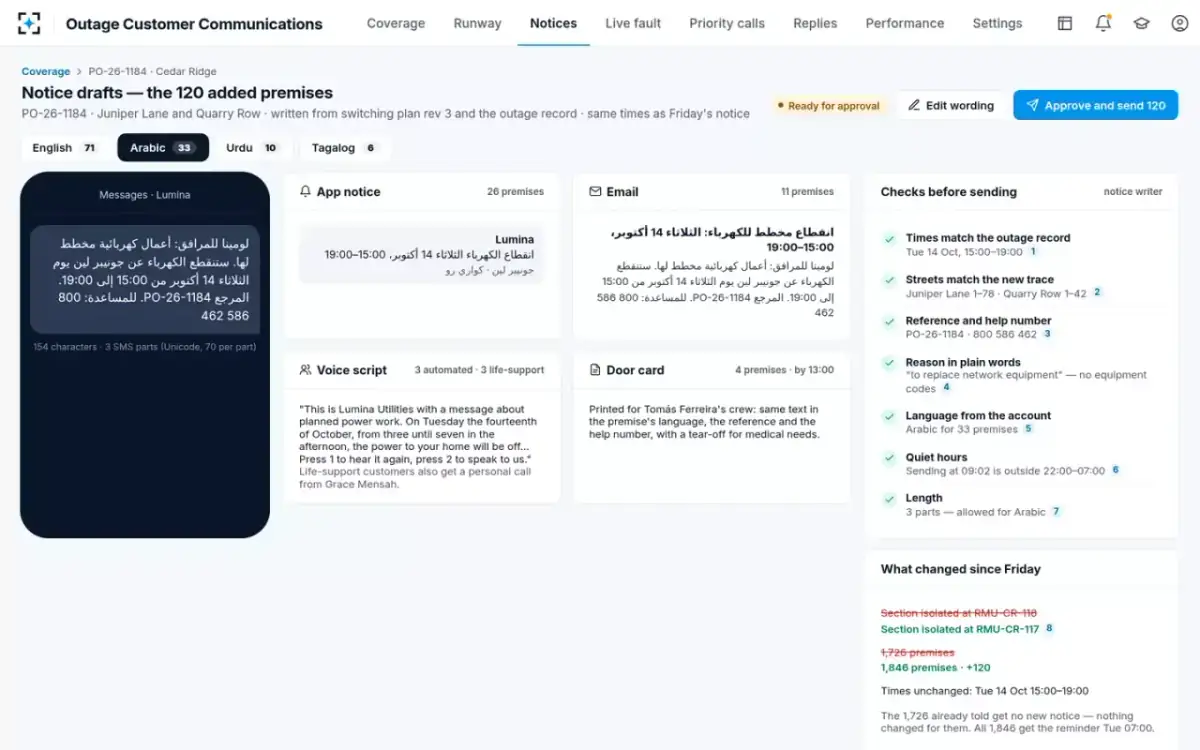

A second-language draft, for 33 premises
Outage communications leadLanguages come from the account, four in all across the 120 premises. The lead opens the draft for the 33 premises that read a second language. It is 154 characters, which is 3 SMS parts in Unicode. It has the same times, streets, reference and help number as the English. The checks run again for each language, with 3 parts allowed for this one.
The notice writer states no time, street or reason that is not in the outage record.
- 05One Send

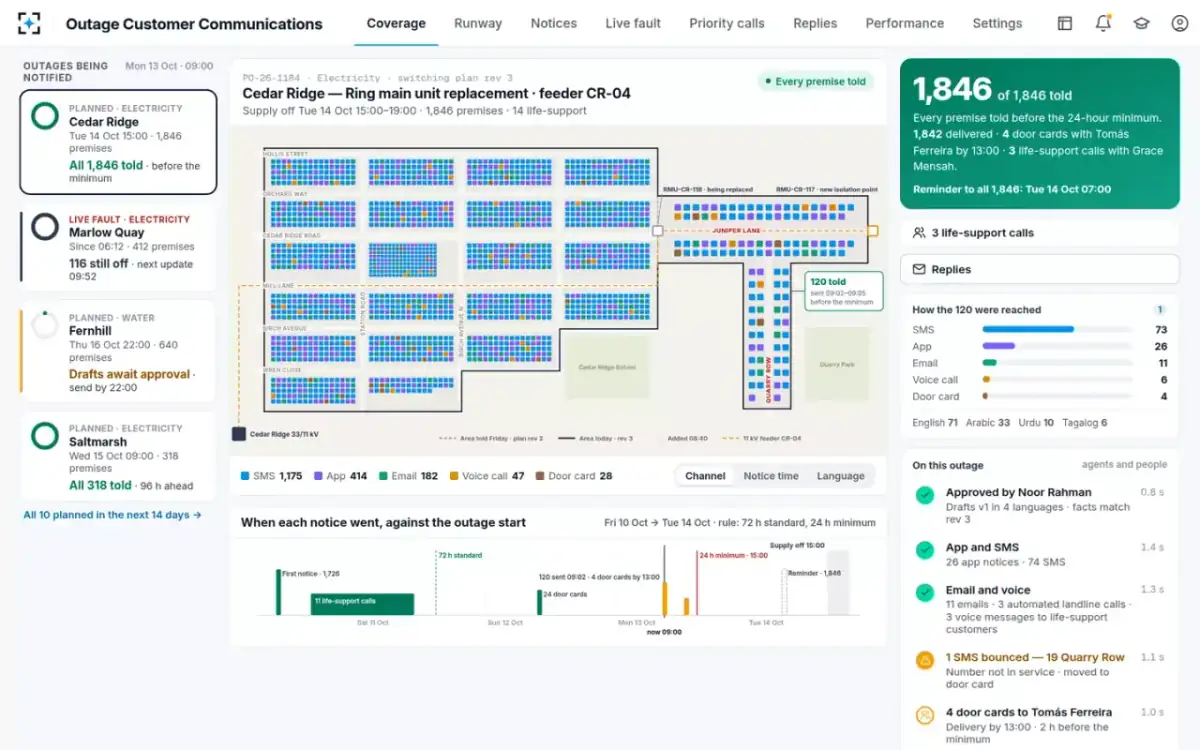

One Send fills the map in
Outage communications leadThe lead presses Send 120 notices. The run goes step by step. First come 26 app notices and 74 SMS. Then come 11 emails, 3 automated landline calls and 3 voice messages to life-support customers. One SMS bounces because the number is not in service, and the channel picker moves it to a door card. The guard closes its alarm, with 1,846 of 1,846 told before the 24-hour minimum.
“Each premise told before the 24-hour minimum. 1,842 delivered · 4 door cards with the field supervisor by 13:00 · 3 life-support calls with the priority care advisor.”
- 06By 11:00

Three life-support calls, made by a person
Priority care advisorThe advisor called the first 11 life-support customers on Friday and Saturday. One customer's home ventilator now has a portable generator booked for 13:00 on the day. Another customer moved a Tuesday dialysis session to the morning. The three added that morning are due by 11:00 today. They are an oxygen concentrator user who reads a second language, a home dialysis patient and a powered wheelchair user.

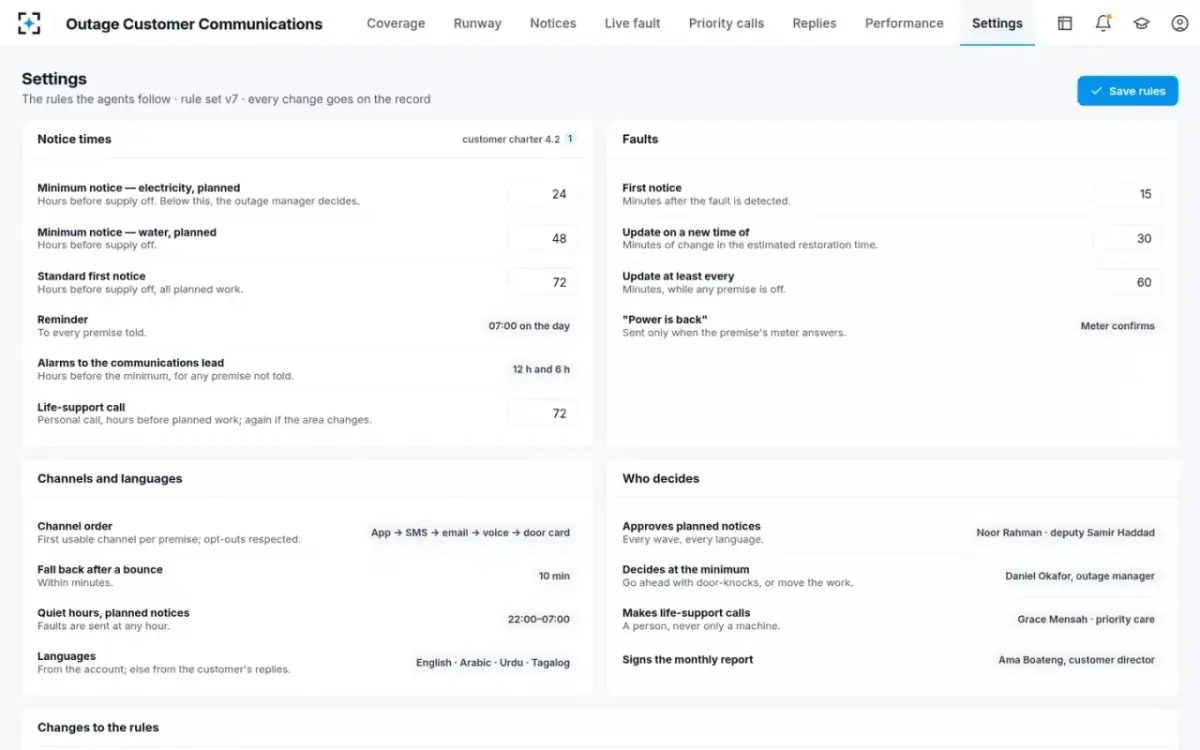

The rule asks for a personal call by 72 hours before planned work, and again if the area changes.
- 07Same morning

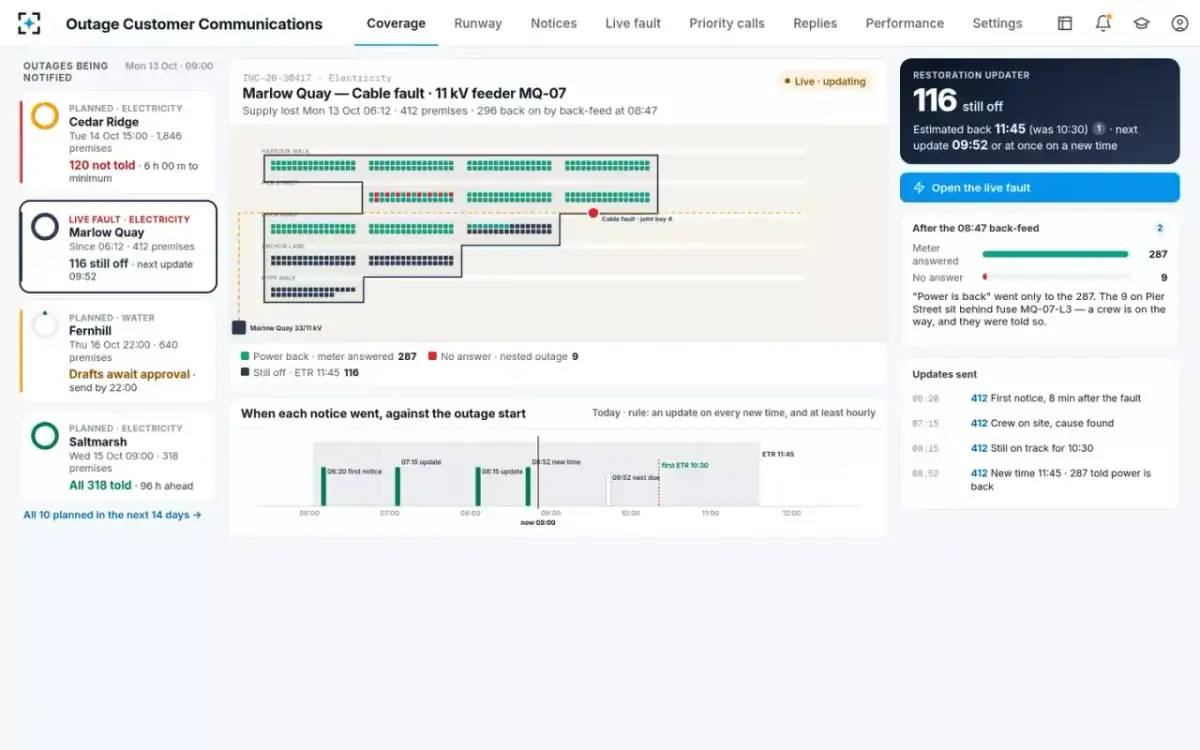

A live fault, back on only where the meter answers
Restoration updaterElsewhere on the network, a cable fault on one feeder took 412 premises off at 06:12. The first notice went at 06:20, 8 minutes later. At 08:47, 296 were back-fed, which means supplied from another direction. Of those, 287 meters answered, but 9 on one street did not, all behind one lateral fuse. "Power is back" went to the 287 only, and a crew was sent to the 9.
The restoration updater says “restored” only once the premise's meter confirms supply.
- 0808:52

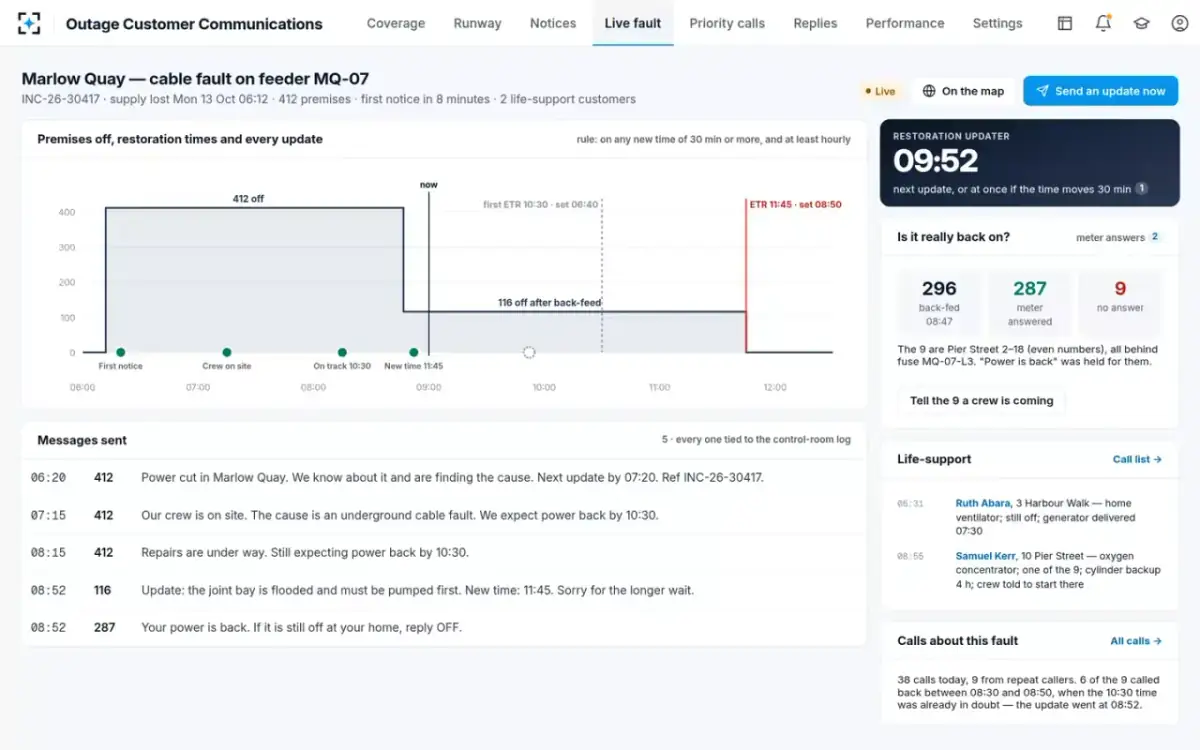

A new restoration time, and an update within minutes
Restoration updaterAt 08:50 the control room moved the ETR, the estimated restoration time, from 10:30 to 11:45. The joint bay is flooded and must be pumped first. The update went to the 116 still off at 08:52. The next is due at 09:52, or at once if the time moves 30 minutes. In all, 38 calls came in about this fault, 9 of them from repeat callers. Of those repeat calls, 6 came between 08:30 and 08:50, when the 10:30 time was already in doubt.
“Update: the joint bay is flooded and must be pumped first. New time: 11:45. Sorry for the longer wait.”
- 09Replies

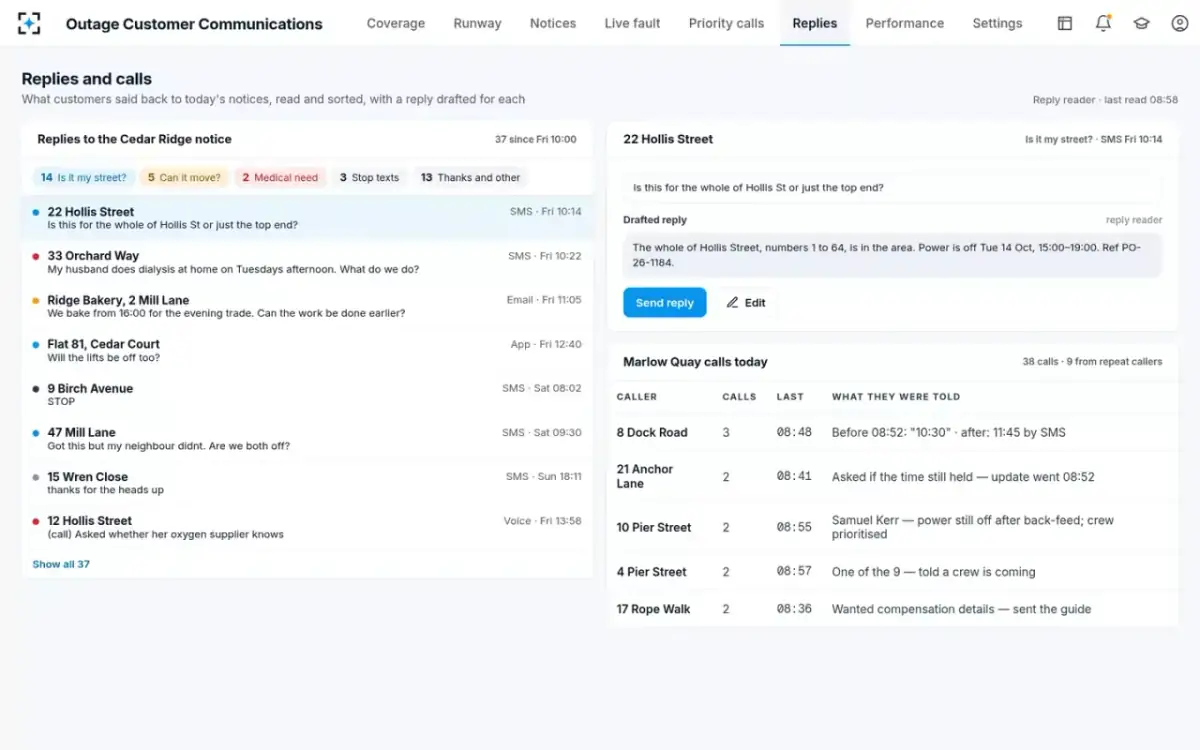

Each reply read, sorted and answered
Reply readerSince Friday, 37 replies came back to the planned-outage notice. There were 14 asking "is it my street?", 5 asking "can it move?", 2 medical needs and 3 stop texts. The reply reader drafted an answer for each from the outage record, such as yes, the whole street is in the area. It sent one dialysis reply straight to priority care. A local bakery's request to move the work was copied to the outage manager.
The reply reader promises only a time the control room has set.
- 10Month end

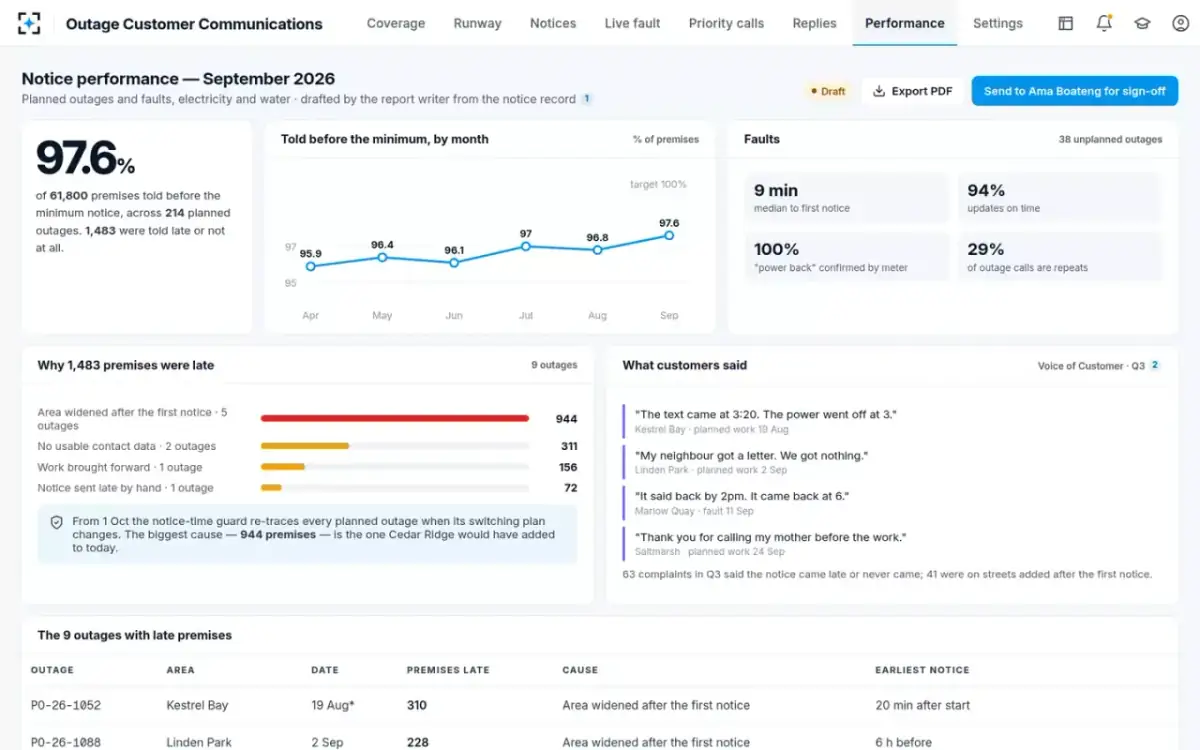

The notice performance report, signed
Customer directorThe report writer drafts the month's notice performance from the notice record. Across 214 planned outages, 97.6 % of 61,800 premises were told before the minimum. The report says why 1,483 were late. The area widened after the first notice (944), or there was no usable contact data (311). In other cases work was brought forward (156), or a notice was sent late by hand (72). The communications lead sends it to the customer director for sign-off.
“63 complaints in the quarter said the notice came late or not at all; 41 were on streets added after the first notice.”
