- Before
- Takes the desk at 07:00 on a note typed at 06:31, at the end of a twelve-hour night. Works out a rare event from scratch. Wants to know what is not normal before touching anything.
- Now
- Reads a one-page brief with each line cited. Asks in plain words whether something has happened before, and accepts the shift item by item.
A Buchholz trip, two missed items and a countersigned control room shift log
One night on a 33 kV and 11 kV desk, the night operator has handled one transformer trip and one cable fault. The senior system operator takes the desk at 07:00, and the shift supervisor countersigns. Here is what happens, screen by screen, in the working solution.
A worked example on sample data. Names, IDs and figures on the screens and in this section come from the demo.
- 0106:46 · 14 min to go

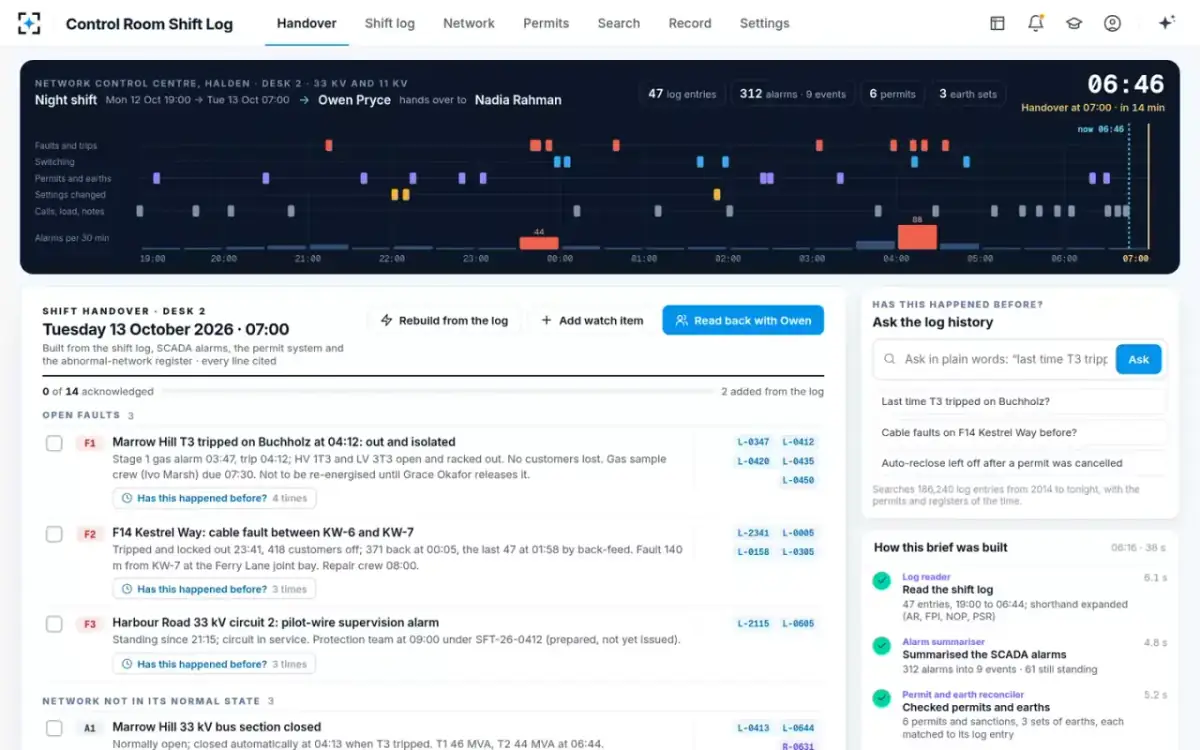

The night on one strip, the handover on one page
Senior system operatorAcross the top, the night shift from 19:00 to 07:00 is one band. Each trip, switching operation, permit, earth and changed setting is a tick on it. Alarms per half hour run below, with 44 in the half hour before midnight and 88 between 04:00 and 04:30. Under that sits the brief. It has 14 items in five sections, from open faults to what to watch this shift. Each item has its log lines in the margin and a box to acknowledge it.
“Built from the shift log, SCADA alarms, the permit system and the abnormal-network register · every line cited”
- 02Built at 06:16 in 38 s
Two items the note left out

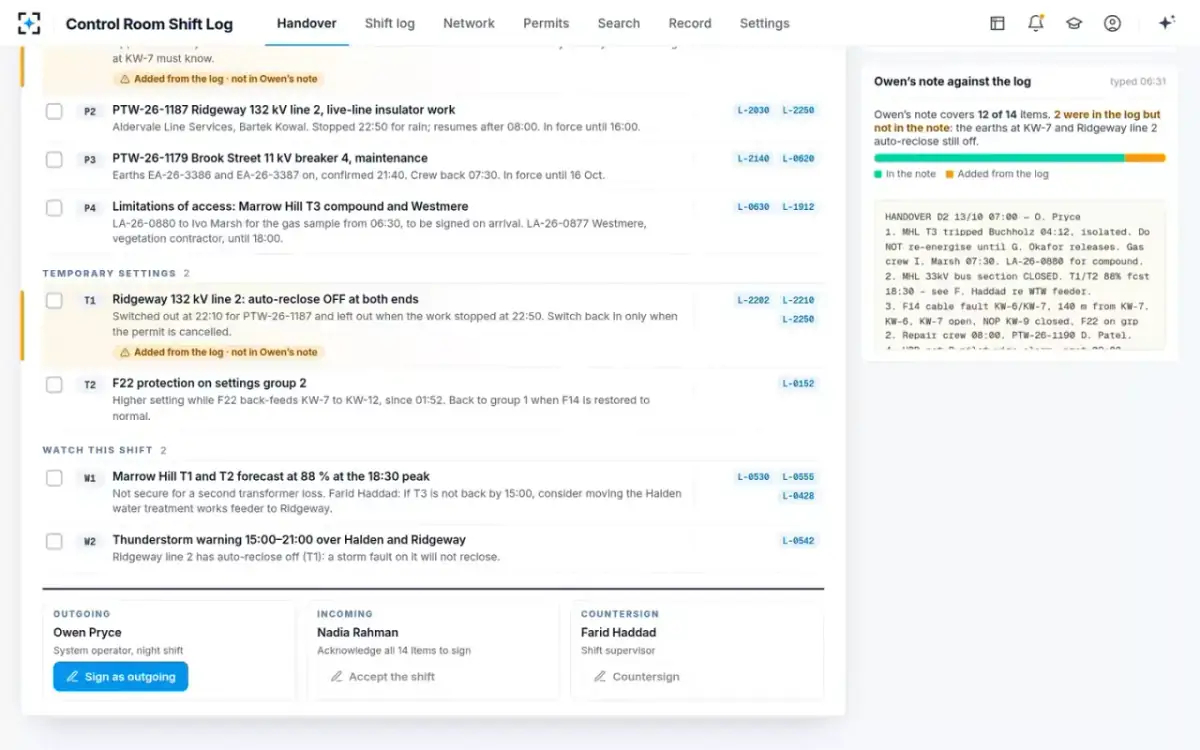

Log reader, Alarm summariser, Handover writerThe log reader read 47 entries and expanded the shorthand (AR, FPI, NOP, PSR). From 312 alarms, the alarm summariser made 9 events, with 61 still standing. The handover writer wrote 14 items with 31 citations. It then compared them with the note the outgoing operator typed at 06:31, which covers 12 of the 14. The other two were in the log but not in the note, so they carry an amber mark. Earths are still on at a cable switching point. Auto-reclose is still off at both ends of line 2, a 132 kV line.
“Switched out at 22:10 for a permit to work and left out when the work stopped at 22:50. Switch back in only when the permit is canceled.”
- 03The register

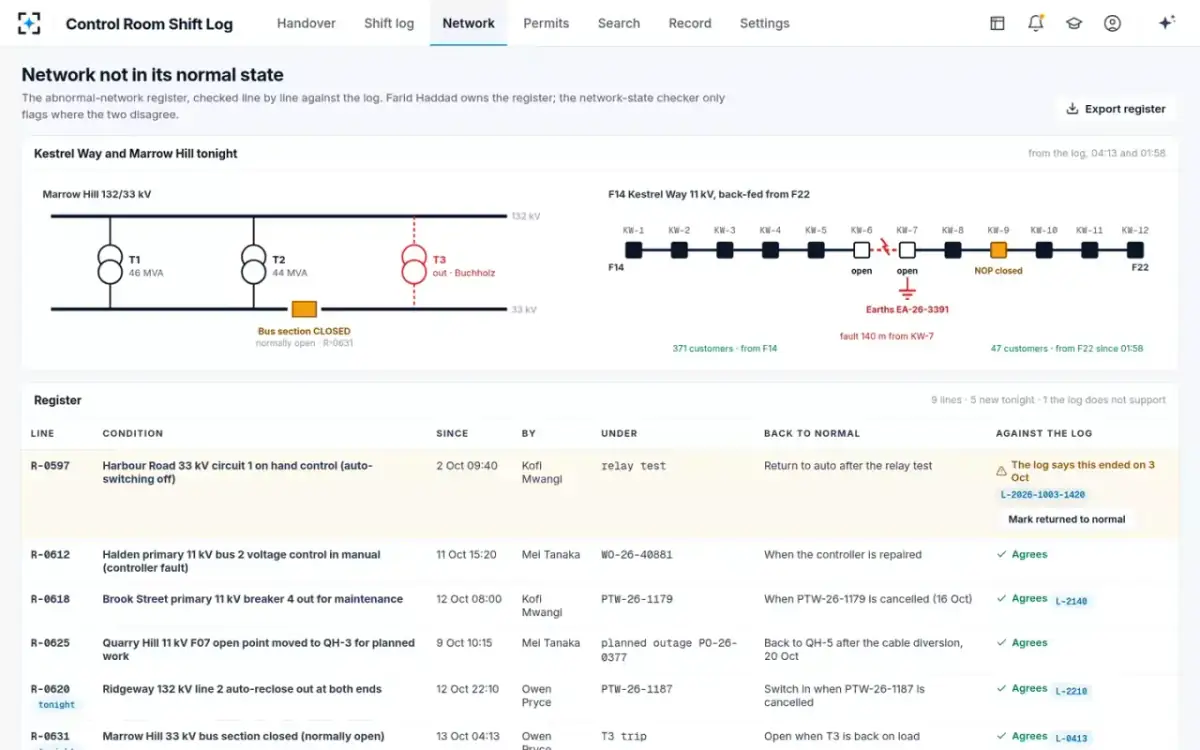

The abnormal-network register, checked against the log
Network-state checkerThe register has nine lines, and five were raised tonight. A 33 kV bus section is closed. A normal open point, the switch normally left open between two feeders, is closed. So another feeder now supplies part of the 11 kV network from the other side. Two switches are open, transformer T3 is out and isolated, and auto-reclose is out on line 2. Each line agrees with its log entry except one, a 33 kV circuit on hand control. The log says that condition ended earlier in the month, but the register was never updated.
The shift supervisor owns the register. The network-state checker only flags where the two disagree.

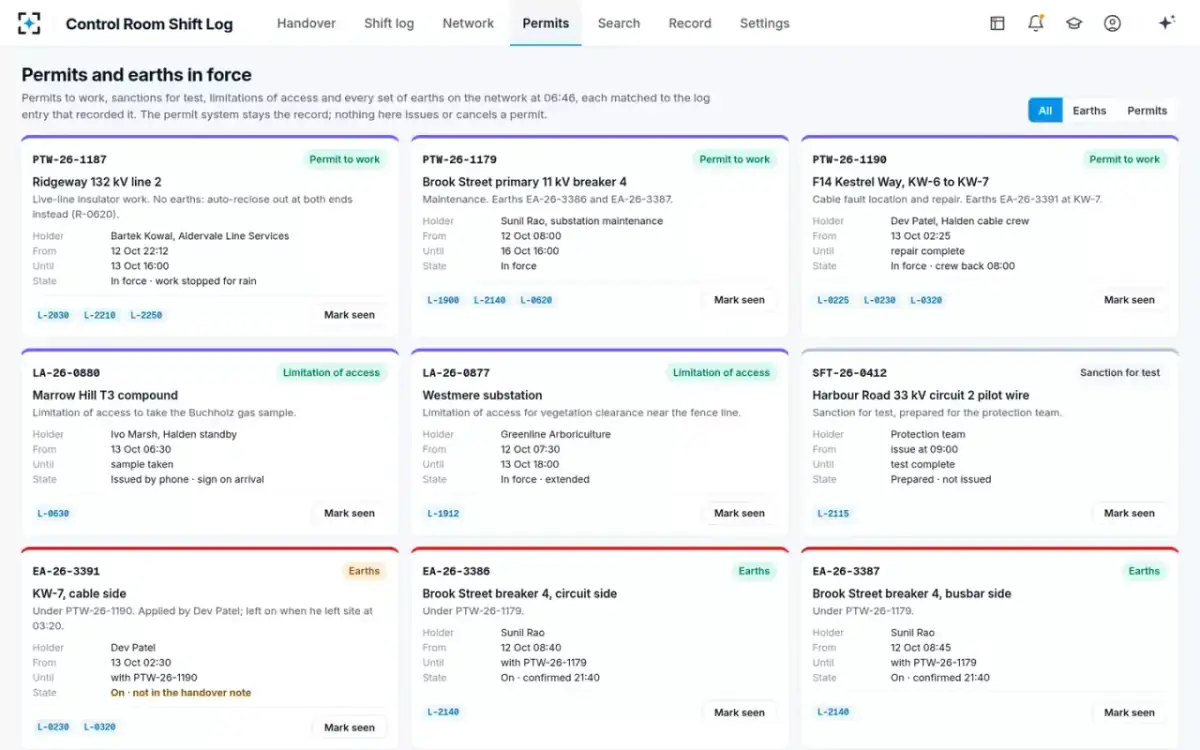

- 04Permits and earths
Each permit and each set of earths, matched to the log
Permit and earth reconcilerThere are six permits and sanctions and three sets of earths. Each shows its holder, dates, state and the log entries that recorded it. The earths at the cable switching point show “On · not in the handover note”. Permits canceled in the last 7 days stay listed below, because a past case may need them. One covered the replacement of T3's cooler pump P1 and was canceled on Saturday at 16:40.
“The permit system stays the record. Nothing here issues or cancels a permit.”

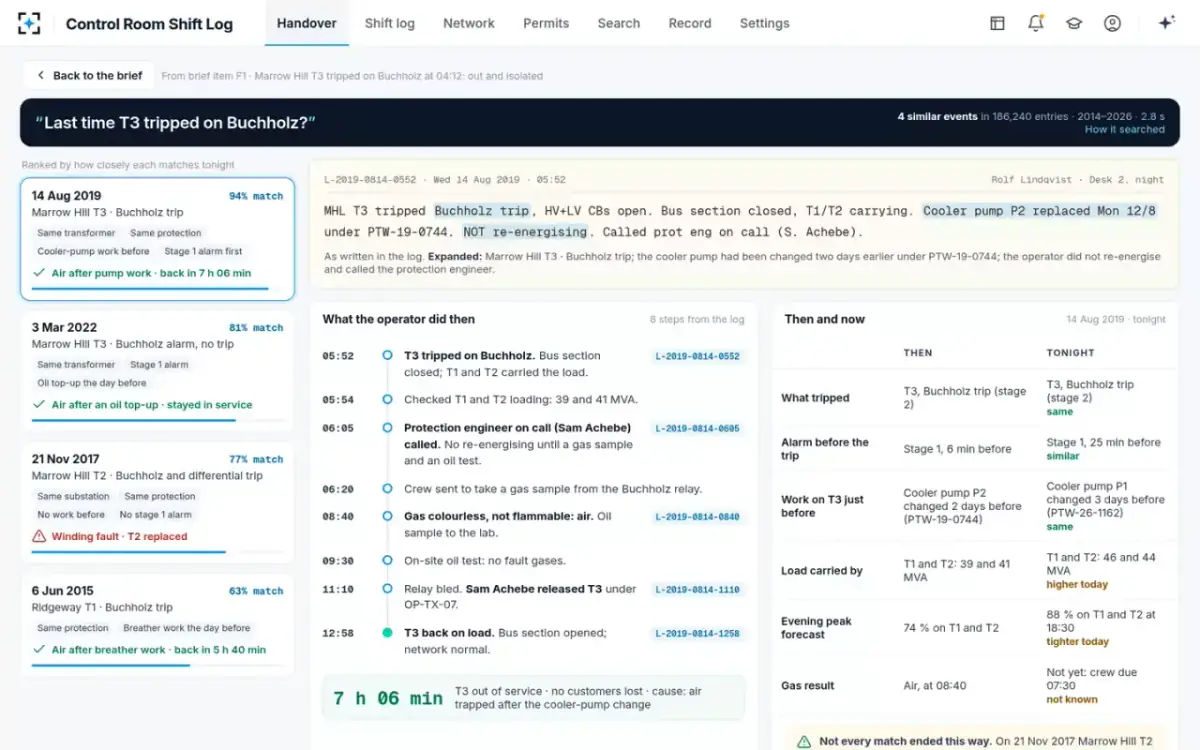

- 052.8 seconds

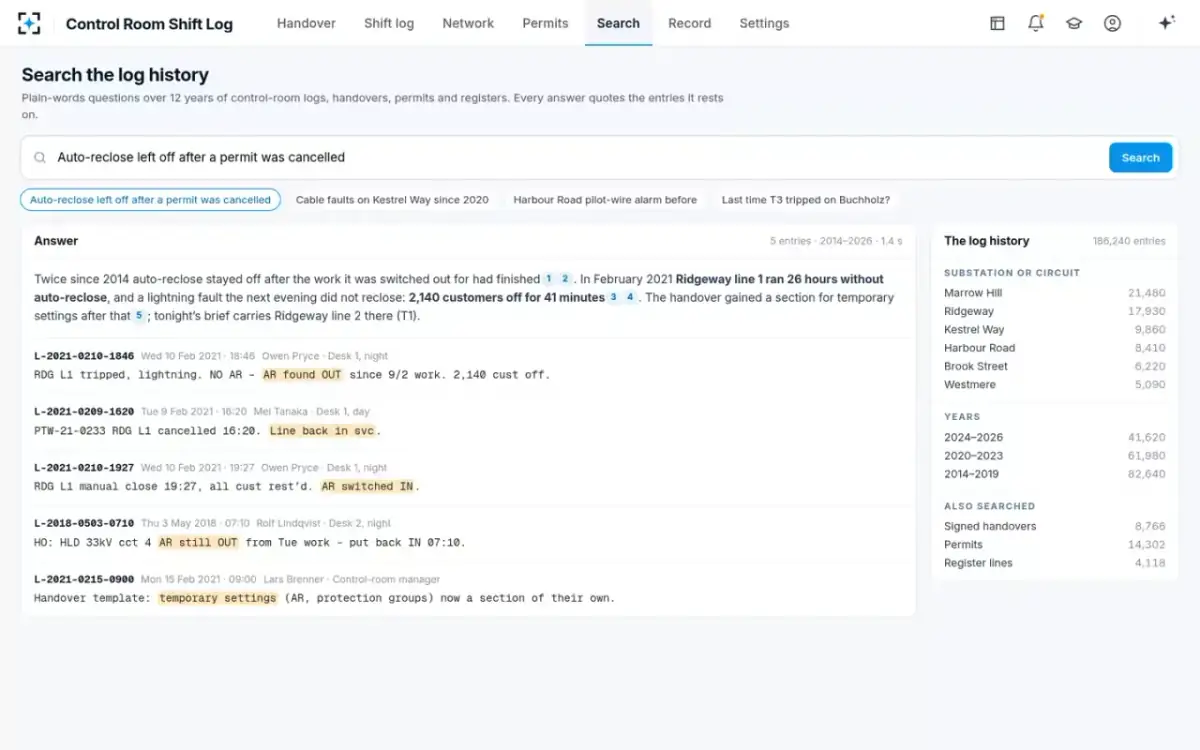

“Last time T3 tripped on Buchholz?”
Precedent finderT3 tripped on its Buchholz relay at 04:12, 25 minutes after a stage 1 gas alarm. The incoming operator asks the log history about it. The precedent finder searches 186,240 entries from twelve years of logs and finds 4 similar events. It opens the best match, at 94 %, an earlier trip of the same transformer. It shows the entry the operator on duty wrote at 05:52, as written. Then it shows what that operator did, minute by minute. The protection engineer was called at 06:05. At 08:40 the gas proved colorless and not flammable, the relay was bled at 11:10 and T3 was back on load at 12:58. T3 was out 7 h 06 min, with air trapped after the cooler-pump change.
Then and now: “Cooler pump P2 changed 2 days before” on the earlier trip · “Cooler pump P1 changed 3 days before” tonight.

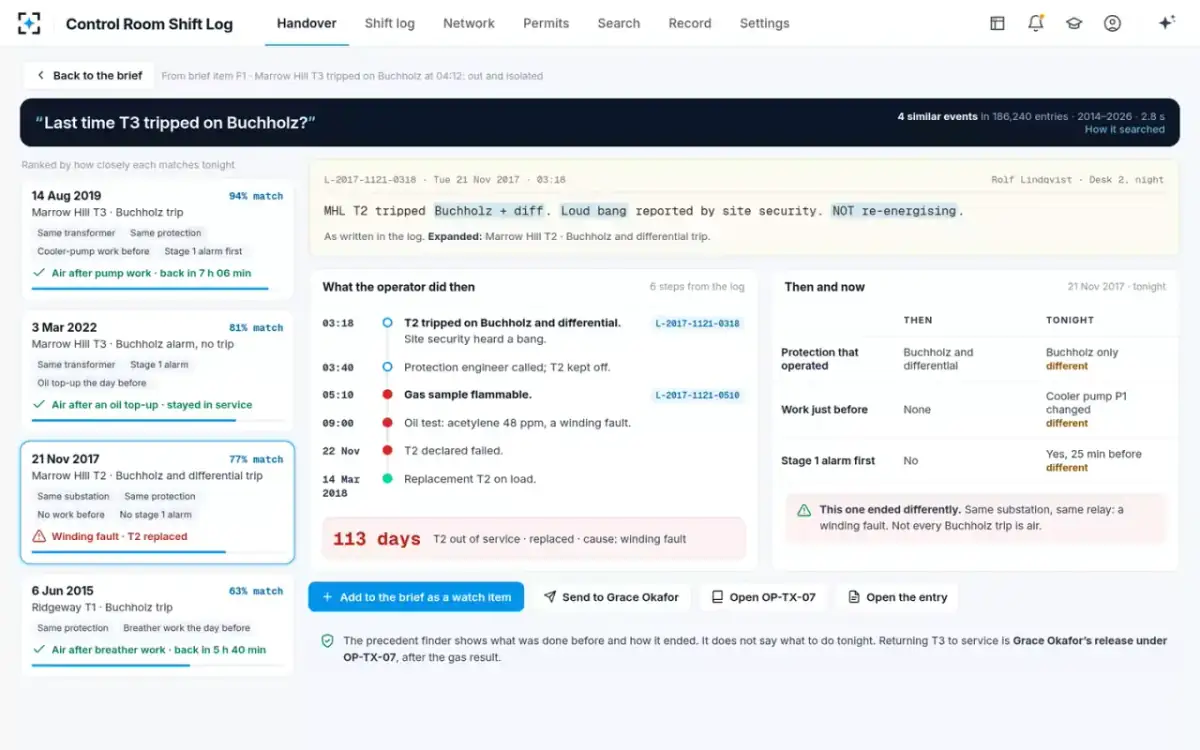

- 06The case that ended differently
Not every Buchholz trip is air
Precedent finderThe precedent finder always shows the closest match that ended differently. In an older case, transformer T2 at the same substation tripped on Buchholz and differential protection. No work came before it and there was no stage 1 alarm. The gas was flammable and the oil showed acetylene at 48 ppm, which meant a winding fault. T2 was out for 113 days and was replaced. So the precedent changes the watch list, and it does not change the decision.
It does not say what to do tonight. Returning T3 to service is for the protection engineer to release, under the approved transformer procedure, after the gas result.

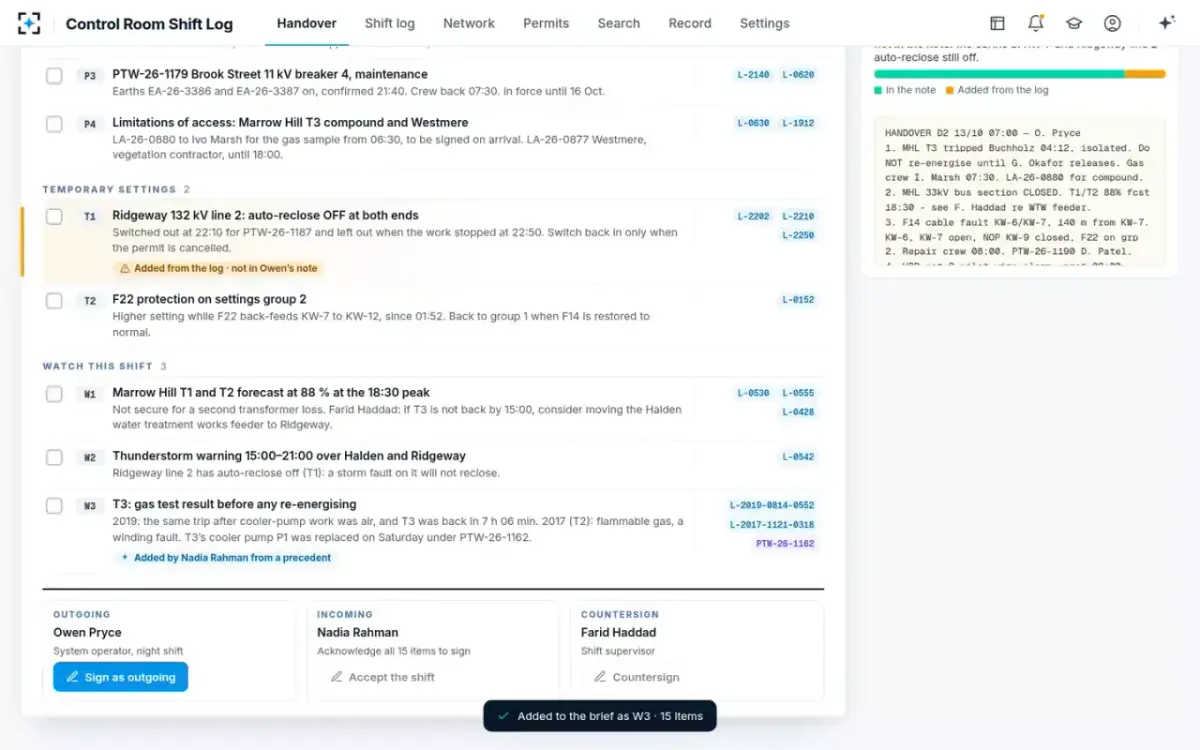

- 07One click
A watch item from the precedent
Senior system operatorThe incoming operator adds a watch item to the brief, W3. It reads “T3: gas test result before any re-energizing”. The item is cited to both old entries and to the permit for Saturday's cooler-pump work. It is marked as added by the incoming operator. The brief now has 15 items.
“Added to the brief as W3 · 15 items”

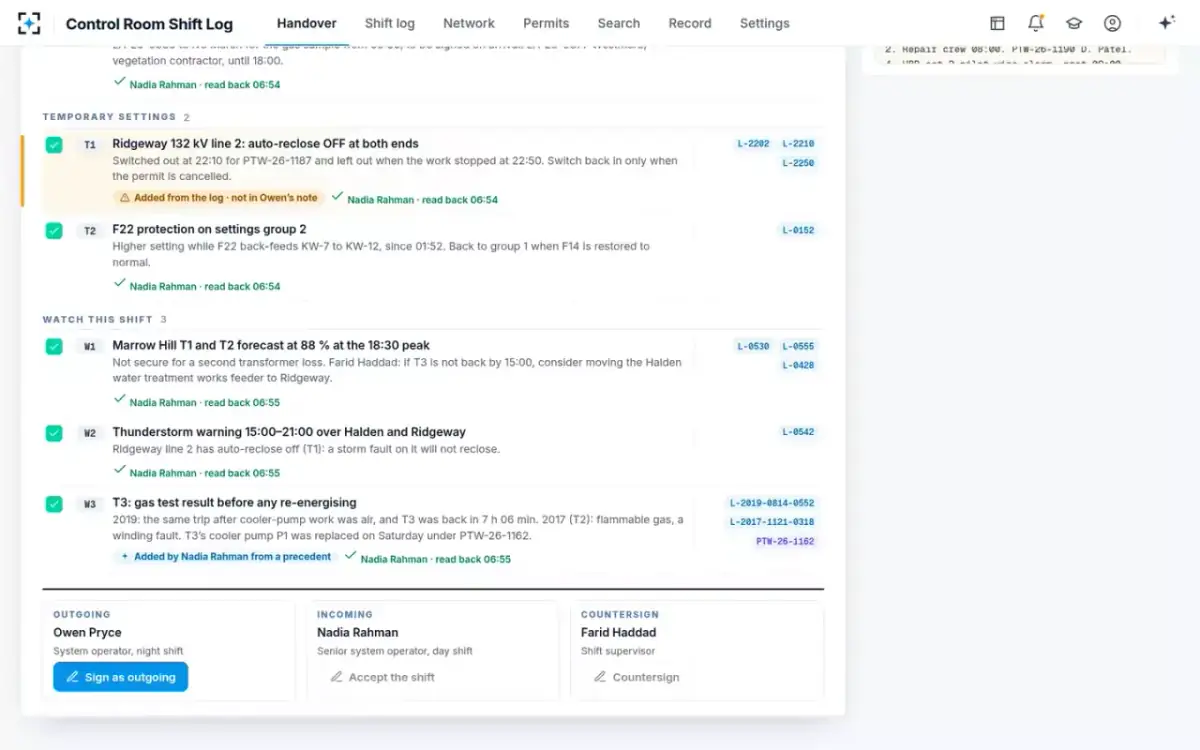

- 0806:52 to 06:55
Read back, item by item
Outgoing and incoming operatorsThe outgoing operator reads each item, and the incoming operator confirms it. Each acknowledgement is stamped with the incoming operator's name and the time. That runs from 06:52 to 06:55 across all 15 items, including the two amber ones and the new W3. The shift cannot be accepted while any item is still open.
“The incoming operator cannot sign until every item is acknowledged”

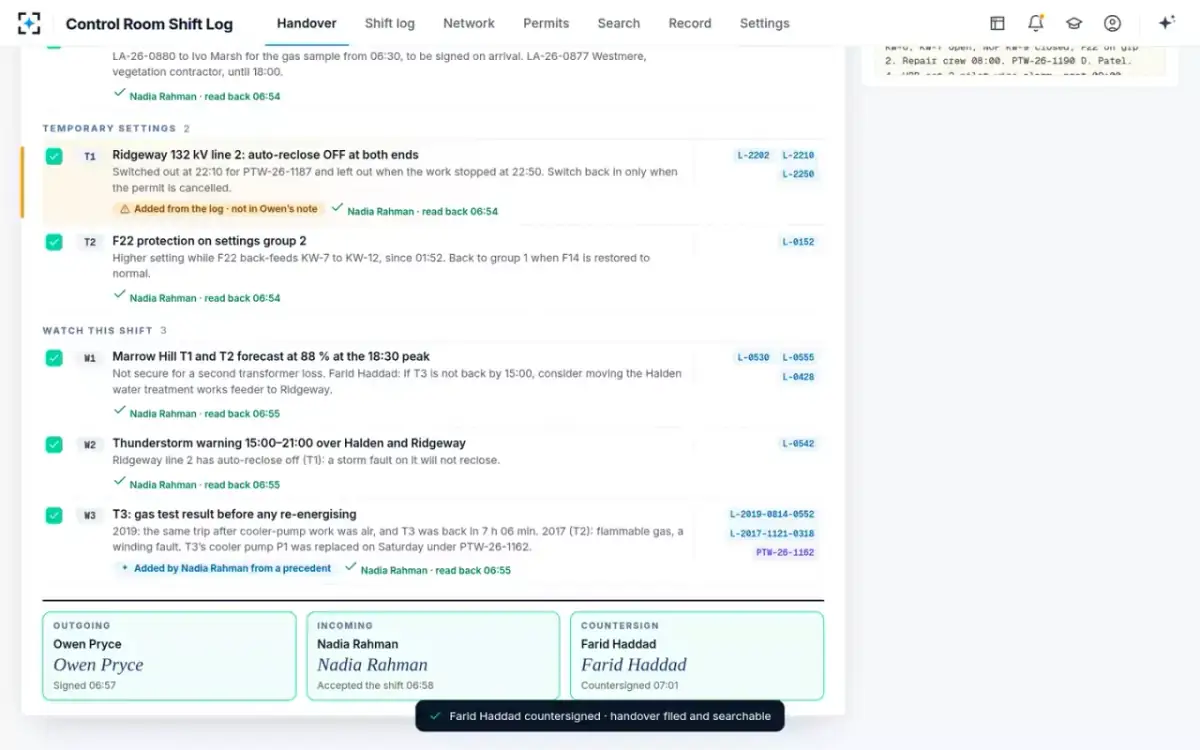

- 0907:01 · Countersigned
Signed, accepted and countersigned
Shift supervisorThe outgoing operator signs at 06:57. At 06:58 the incoming operator accepts the shift with 15 items acknowledged. The shift supervisor countersigns at 07:01. The handover is then filed read-only, and the shift's entries join the searchable log history.
“Countersigned by the shift supervisor · handover filed and searchable”

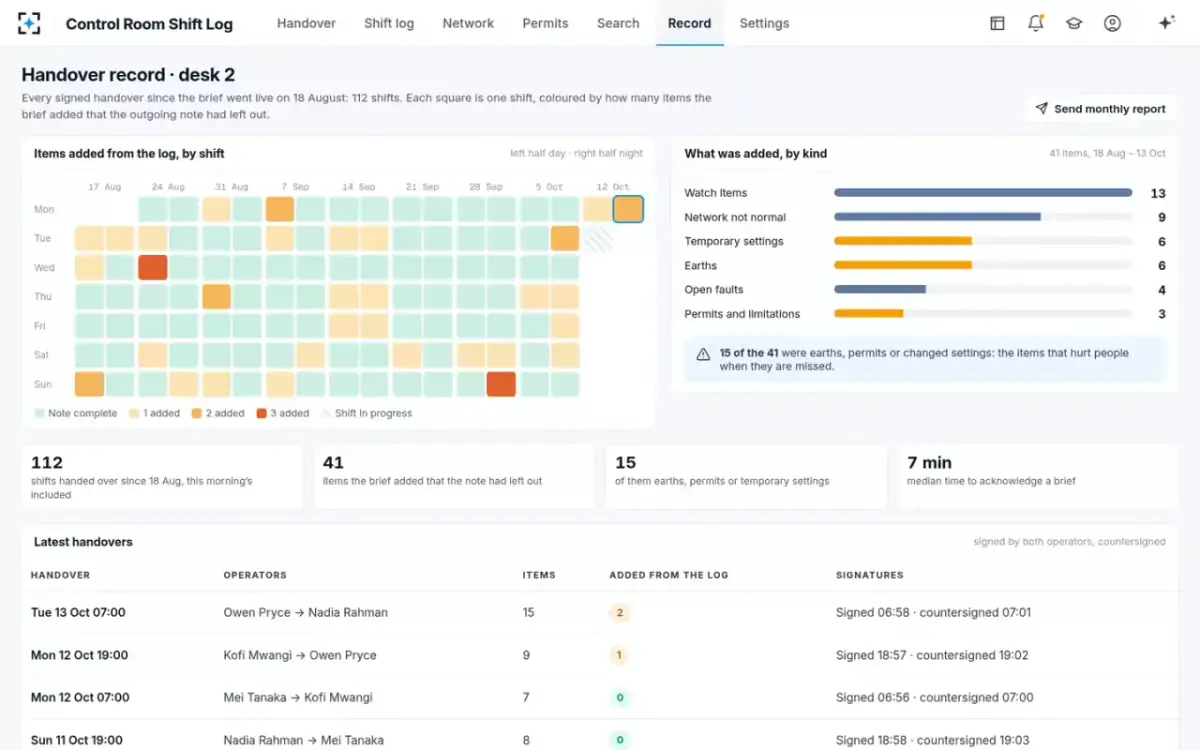

- 10Each month
Handover quality, shift by shift
Control room managerThe handover record shows each signed handover since the brief went live. There are 112 shifts on a calendar. Each is colored by how many items the brief added that the outgoing note had left out. In all, 41 items were added, and 15 of them were earths, permits or temporary settings. The median time to acknowledge a brief is 7 minutes.
“15 of the 41 were earths, permits or changed settings: the items that hurt people when they are missed.”
