- Before
- Builds the five-year plan from HR reports of age and service, and a rule of thumb for retirement. Can count who retires, but cannot see what work is coming.
- Now
- Opens a skills cliff refreshed overnight. Clicks any cell to see who retires, who leaves and which projects need people. Sends a plan that is sized and costed.
How the protection engineer gap is found, explained and closed
A large utility runs electricity and water networks across four regions. Its electricity capital plan peaks in 2029. That is the same year many of its protection and control engineers can retire. Here is how the working solution finds that gap, explains it and closes it, screen by screen.
A worked example on sample data. Names, IDs and figures on the screens and in this section come from the demo.
- 01First thing in the morning

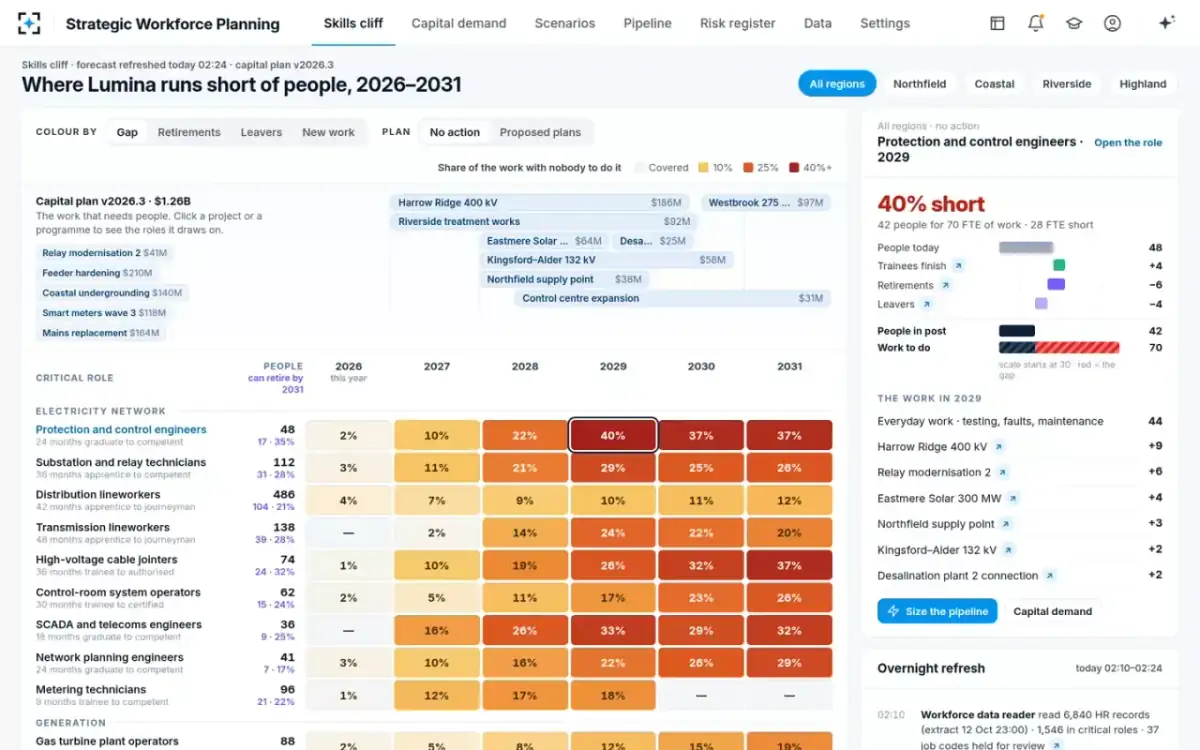

The home screen shows the skills cliff
Head of strategic workforce planningThe head of workforce planning builds the five-year plan that answers the board. The home screen is a heatmap of 14 critical roles across the electricity network, generation and water. It runs year by year from 2026 to 2031. Each cell shows the share of the work that nobody will be there to do. The current capital plan sits above it. With no action, the utility is 288 FTE (full-time staff) short across the 14 roles in 2029. Four roles are 25% or more short.
HR data alone can count retirements. The grid adds the work that is coming, from the capital plan.

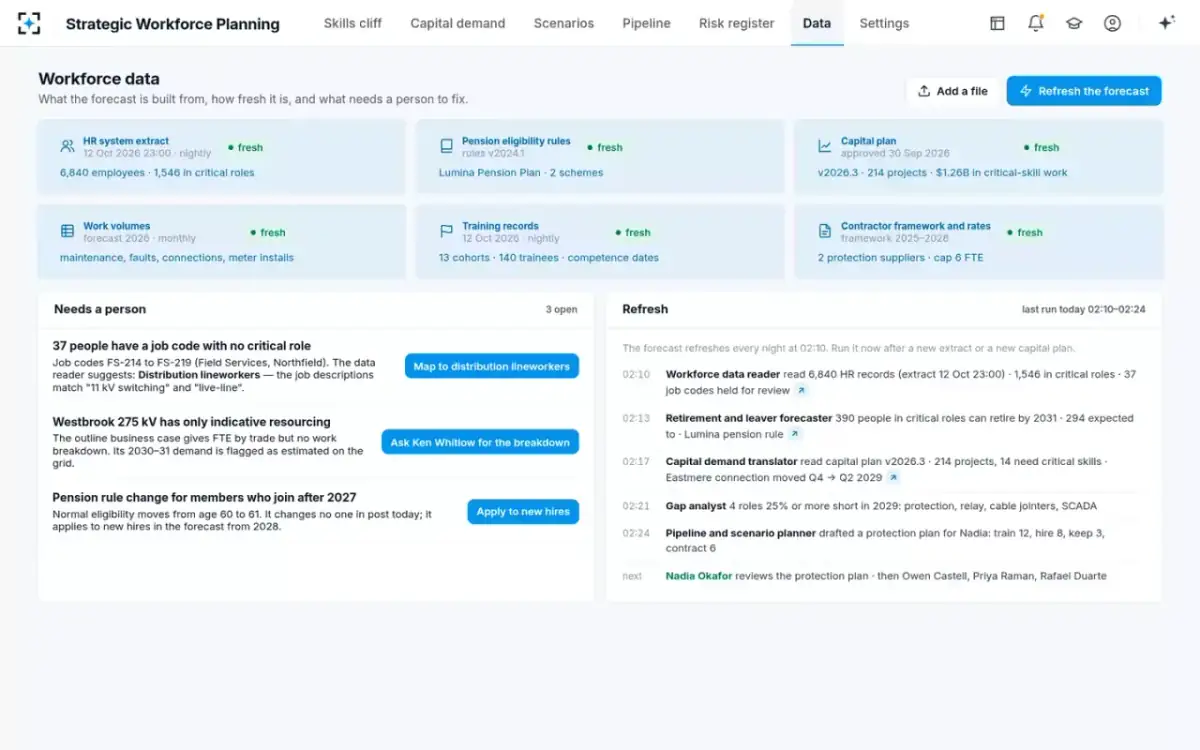

- 02Overnight
Five agents rebuild the forecast before the office opens
The overnight refreshThe workforce data reader took the 23:00 HR extract and mapped each job code to a critical role. It held 37 job codes for review. The forecaster found 390 people who can retire by 2031 and expects 294 of them to go. The capital demand translator read 214 projects, 14 of which need critical skills. It also spotted that a solar connection moved from Q4 to Q2 2029. The planner drafted a protection plan for the head of planning to review.
Needs a person: 37 people have a job code that matches no critical role. The data reader suggests a role and asks. It does not guess.

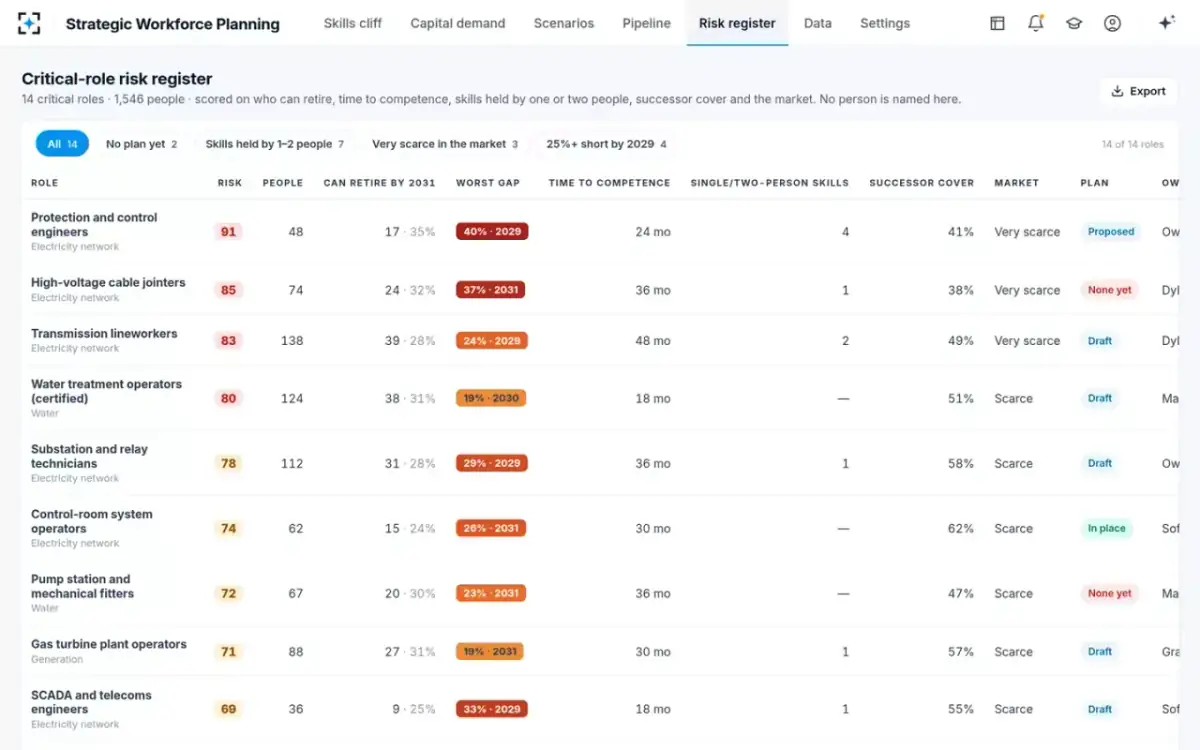

- 03Why the cliff exists

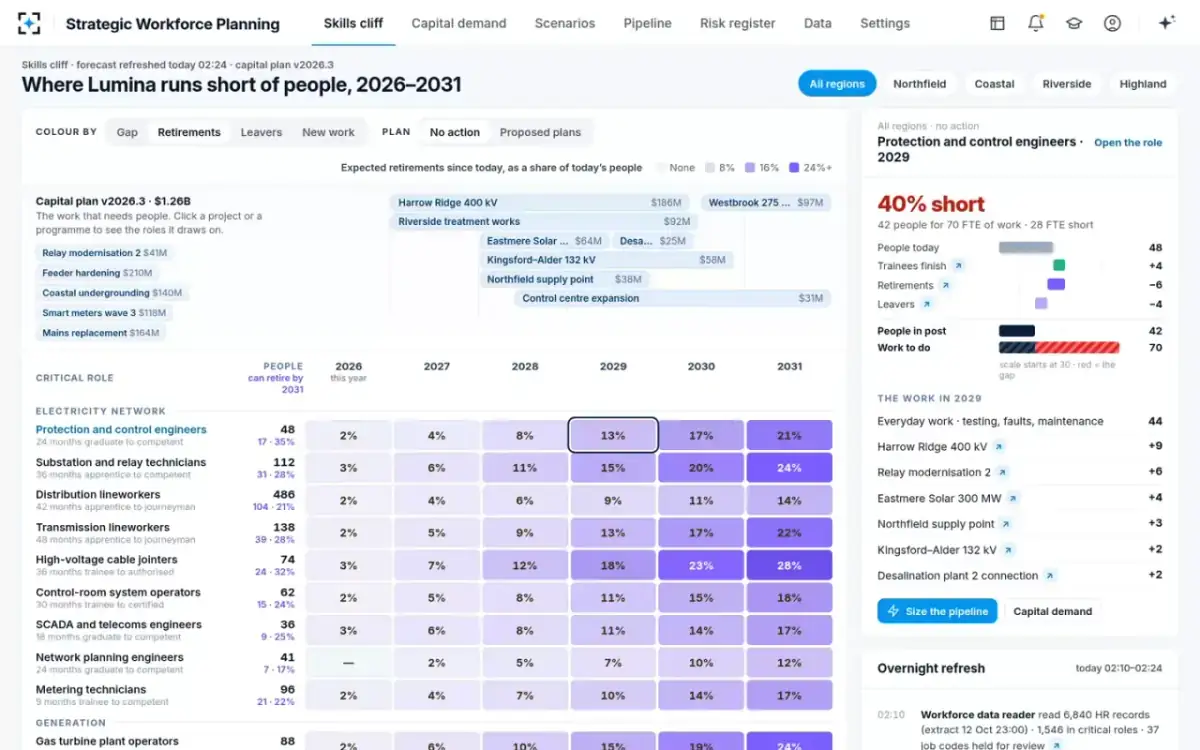

The same grid, colored by retirements
Retirement and leaver forecasterA switch recolors the grid by gap, retirements, leavers or new work, so the reason behind each cliff is plain to see. Colored by retirements, protection and control engineers reach 13% of today's people in 2029 and 21% in 2031. High-voltage cable jointers reach 28% in 2031. The forecaster uses the utility's own pension rule, which is age 60, or 55 with 30 years' service. It also uses the utility's own history, and does not assume everyone goes at 65.
Limit: it does not assume everyone retires as soon as they can, and it does not forecast for a group smaller than 5.
- 04One click on a cell

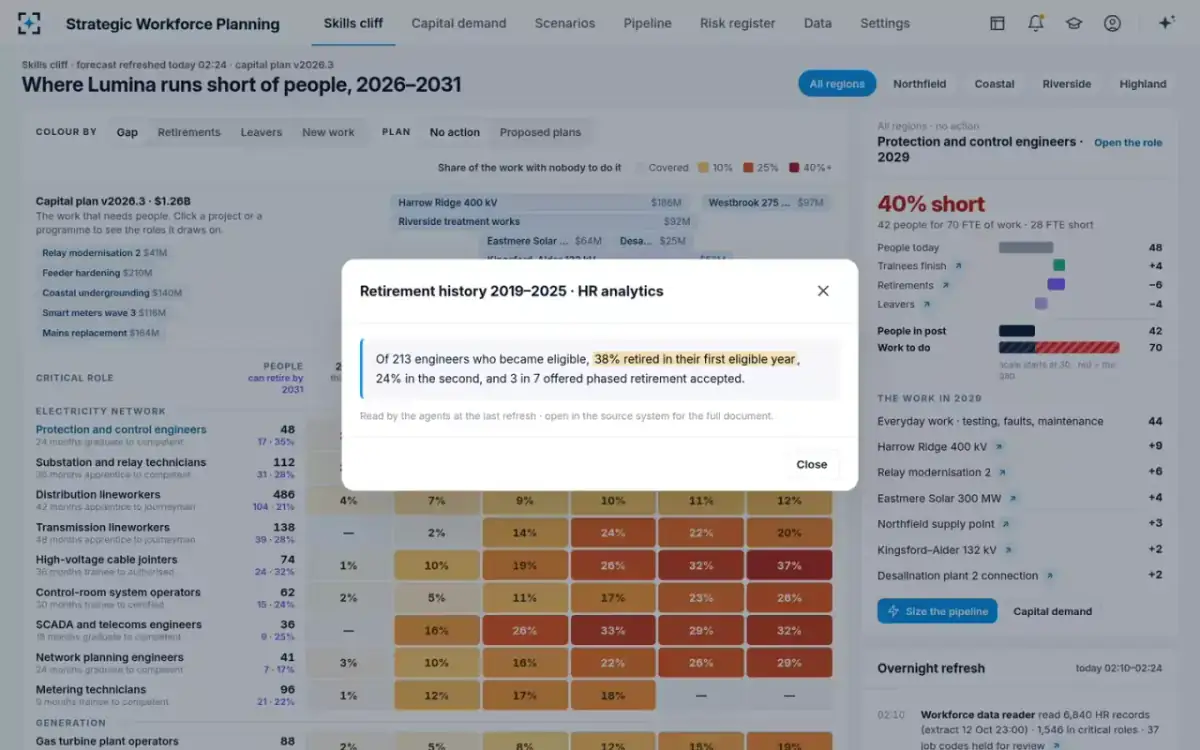

40% short in 2029, and where the number comes from
Gap analystThe head of planning clicks the cell for protection and control engineers in 2029. The side panel explains it. Of 48 people today, six retire and four leave, while four trainees finish, so 42 will be in post. The work needs 70 FTE, so the role is 28 FTE short. That work is 44 FTE of everyday testing, faults and maintenance, plus 26 from six projects. Each line opens its source, and the retirement line opens the history behind it.
Retirement history, 2019 to 2025: of 213 engineers who became eligible, 38% retired in their first eligible year and 24% in the second. Of those offered phased retirement, 3 in 7 accepted.
- 05One click on a project

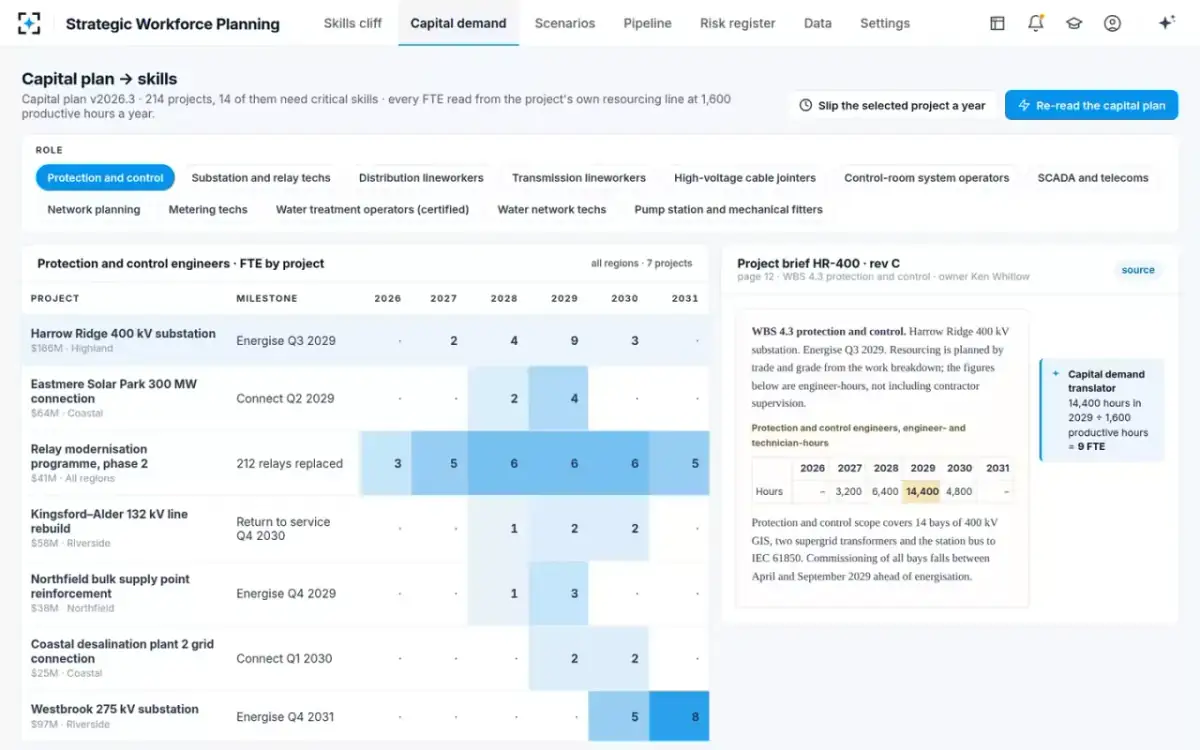

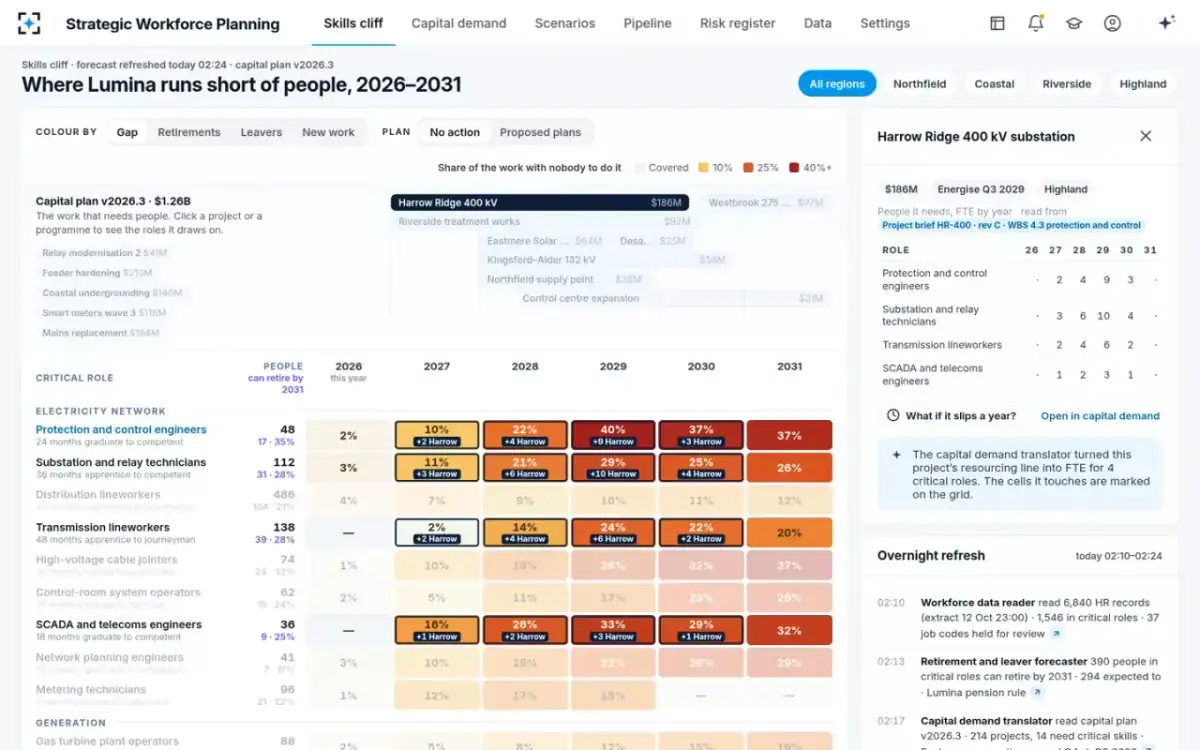

A substation project lights up the roles it needs
Capital demand translatorOn the capital plan ribbon, the head of planning clicks a 400 kV substation project. It costs $186M and is due to energize, or switch on, in Q3 2029 in one of the regions. The cells it draws on light up with the FTE it needs each year. In 2029 that is 9 protection and control engineers, 10 substation and relay technicians, 6 transmission lineworkers and 3 SCADA and telecoms engineers. A what-if can slip the project a year to show the cliff move. The capital plan itself does not change.
The capital demand translator turned this project's staffing line into FTE for 4 critical roles.
- 06The source
Each FTE comes from the project's own staffing line
Director of network deliveryCapital demand shows each project's FTE by year for the chosen role, beside the document it came from. For the substation, that is the project brief, page 12, work breakdown item WBS 4.3, protection and control. The director of network delivery owns it. The work is 14 bays of 400 kV GIS, two supergrid transformers and the station bus to IEC 61850. All of it is commissioned between April and September 2029. That is 14,400 hours in 2029. At 1,600 productive hours a year, it comes to 9 FTE.
The Q3 2029 switch-on date is fixed. Without the engineers, the substation cannot energize.

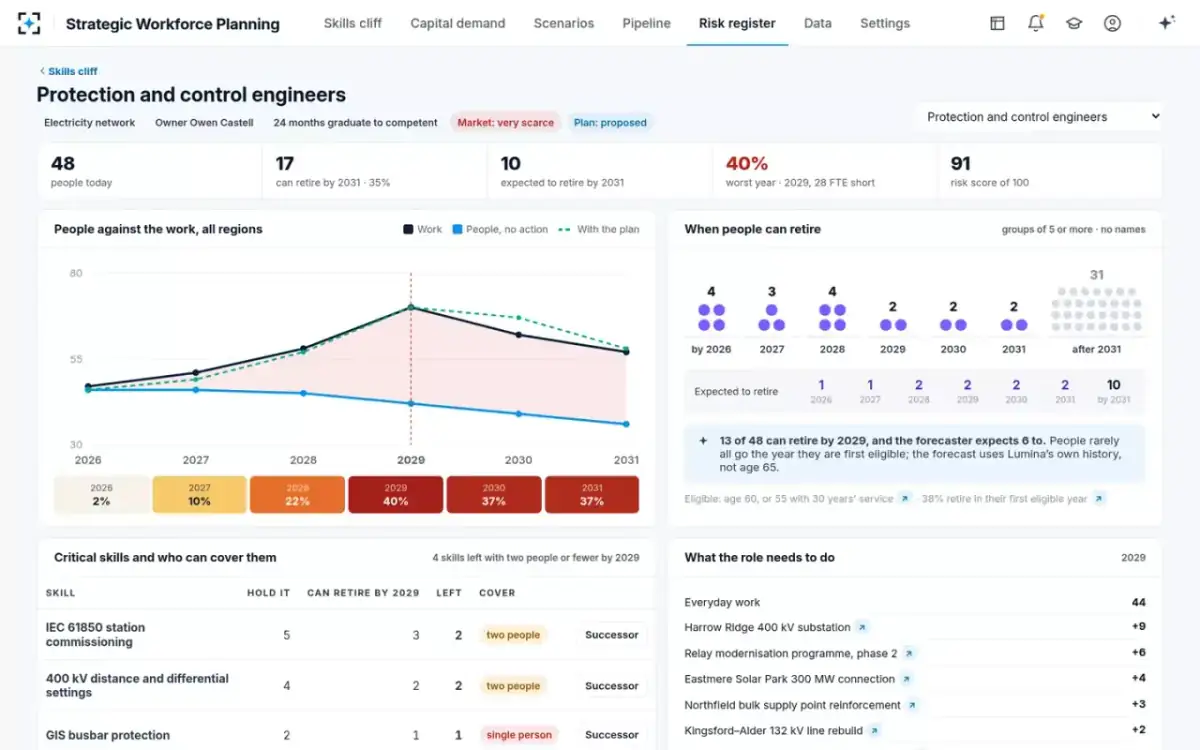

- 07The role in depth
Which skills leave with the people
Protection and control managerThe protection and control manager runs the team of 48 protection engineers. The role page shows people against the work to 2031. It shows when people can retire, in groups of five or more and with no names. It also lists the skills that matter. IEC 61850 station commissioning is held by 5 people, and 3 of them can retire by 2029. GIS busbar protection is held by 2, and 1 will be left. By 2029, four skills are down to two people or fewer. The manager can ask for a successor plan for each.
13 of 48 can retire by 2029, and the forecaster expects 6 to.

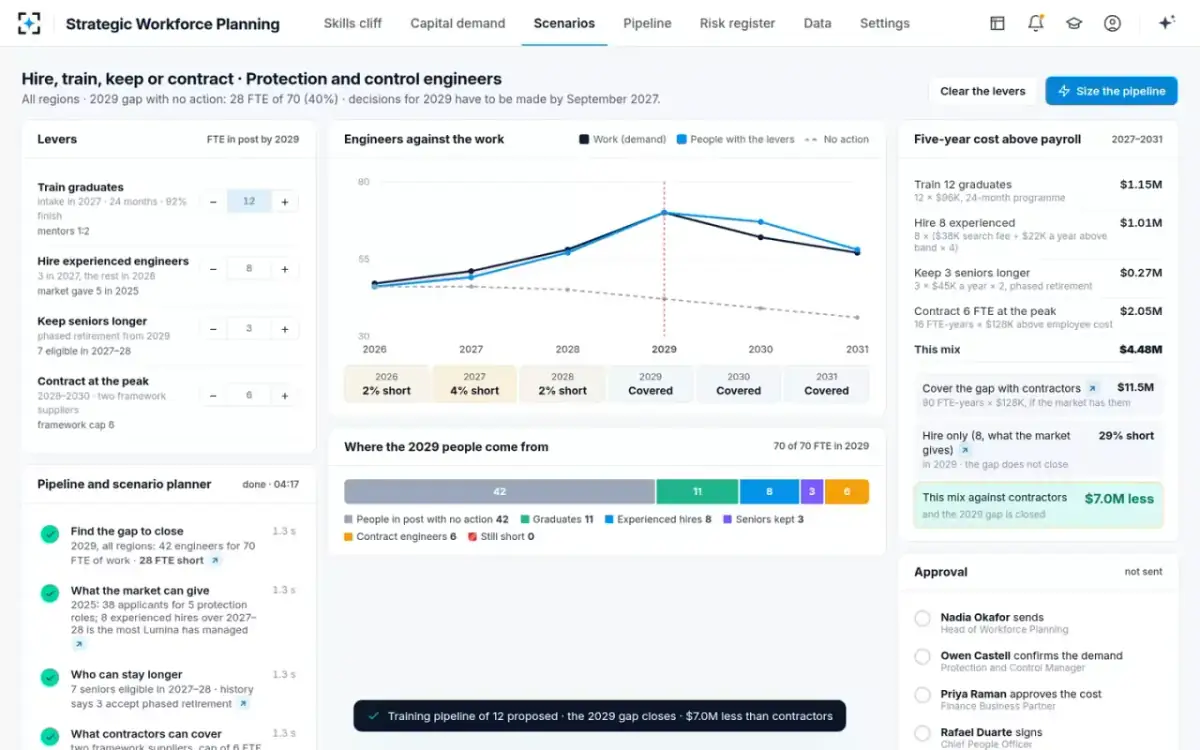

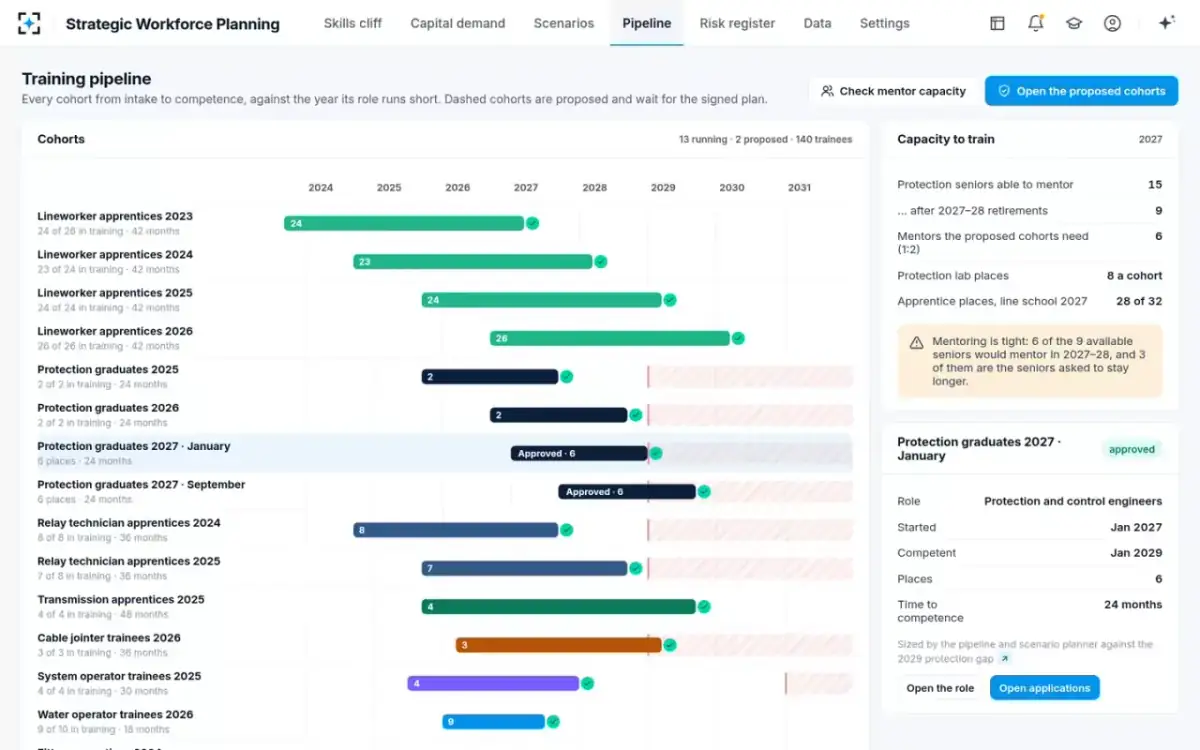

- 08Size the pipeline
Hire 8, keep 3, contract 6, and train 12
Pipeline and scenario plannerThe planner works from the 2029 gap of 28 FTE. The job market gives about 8 experienced hires over the two years from 2027, judging by 38 applicants for 5 roles last year. History says 3 of the 7 seniors eligible in those years will accept phased retirement. The two contractor firms on the utility's framework can cover 6 FTE at the peak. That leaves 11 people who must be competent by 2029. Training takes 24 months and 92% finish, so the intake is 12. That is two groups of six, starting in January and September 2027.
Check the limit: 12 graduates need 6 mentors, at one mentor for every two graduates. After retirements, 9 seniors can mentor in 2027.

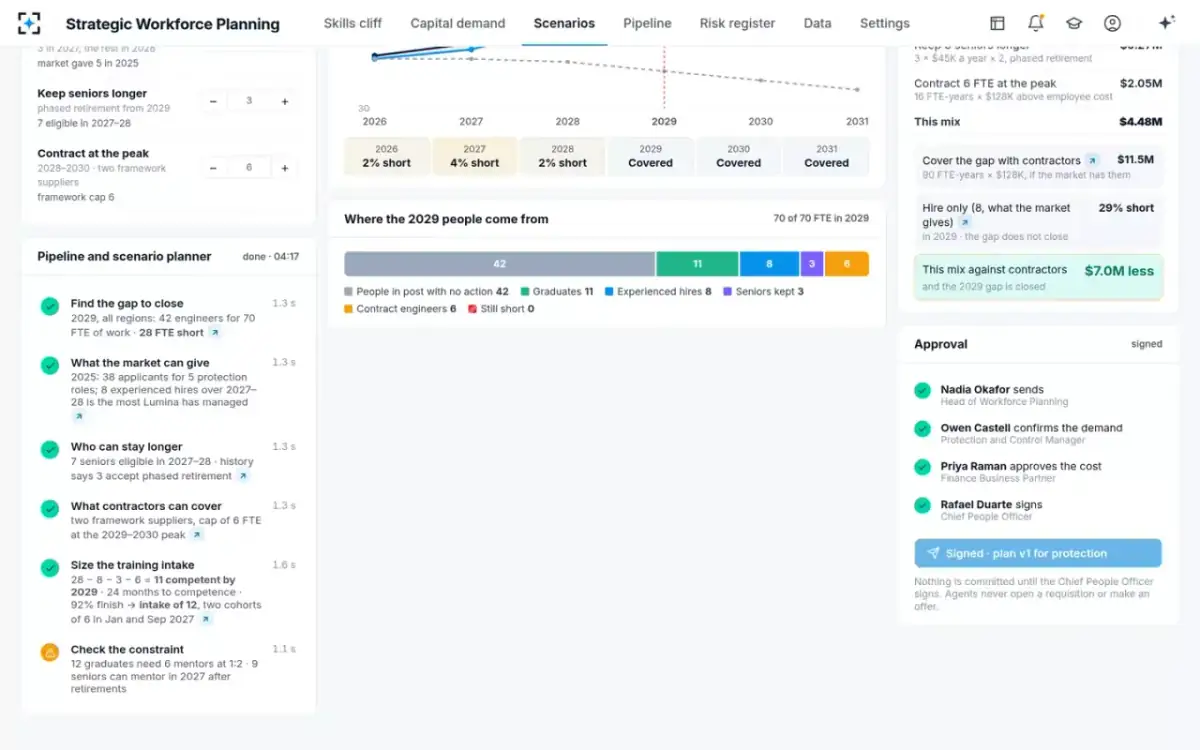

- 09Signed
Demand confirmed, cost approved, plan signed
Finance business partner · Chief people officerThe mix costs $4.48M above payroll over 2027 to 2031. That is $1.15M to train, $1.01M to hire, $0.27M to keep and $2.05M for contractors. Covering the gap with contractors alone would cost $11.5M, if the market has them. Hiring alone still leaves 2029 29% short. The head of planning sends the plan for approval. The protection manager confirms the 70 FTE of demand, the finance partner approves $4.48M, and the chief people officer signs.
Nothing is committed until the chief people officer signs. Agents do not open a job requisition or make an offer.
- 10The cohorts open
Two graduate cohorts open, sized to the real work
Head of strategic workforce planningOn the training pipeline, the two protection graduate cohorts move from proposed to approved. They will be competent in January and September 2029. The capacity to train them is shown alongside. Today 15 protection seniors are able to mentor. After retirements over the two years from 2027, 9 remain, and 6 are needed. Back on the skills cliff, protection in 2029 now reads Covered.
Mentoring is tight. Six of the nine available seniors would mentor over the two years from 2027. Three of them are the same seniors asked to stay longer.
