- Before
- Rebuilds the training by hand from a PDF and a spreadsheet, weeks after each revision. Needs to know by Monday which questions a Friday revision made wrong.
- Now
- Opens the breakdown on Tuesday morning. The changed clauses are already traced to 3 tasks, and 7 questions are already redrafted. Signs each task analysis.
Job task analysis for one switching procedure revision, screen by screen
A utility trains its HV authorized persons, the staff allowed to switch high-voltage equipment, at its own training center. The job “HV authorized person: distribution switching” has 31 tasks, taught by 9 lessons and tested by 310 questions. One Friday afternoon, its 11 kV ring main unit (RMU) procedure changed. Here is what happens next, in the working solution.
A worked example on sample data. Names, IDs and figures on the screens and in this section come from the demo.
- 01Friday · 14:20

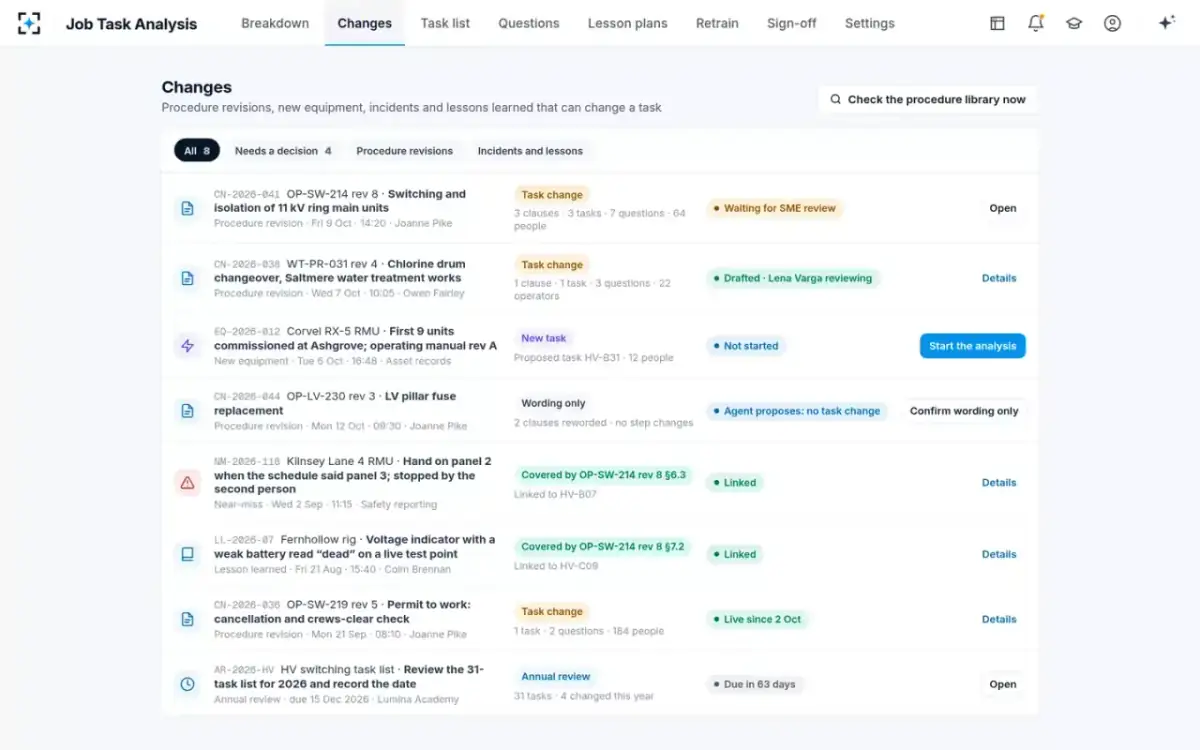

A new revision of the RMU switching procedure is issued
Procedure owner, network operations standardsThe procedure owner issues the new revision of “Switching and isolation of 11 kV ring main units” under a change notice. It follows a near-miss at one RMU and a lesson learned on the training rig. The change inbox picks it up as a task change. Beside it sit three other changes. One is a chlorine drum changeover revision at a water treatment works. Another is a new RMU type commissioned at one depot, and the last is a wording-only change to the LV pillar fuse procedure.
The near-miss: a hand on panel 2 when the schedule said panel 3, stopped by the second person
- 0214:22
Three clauses changed, eleven unchanged

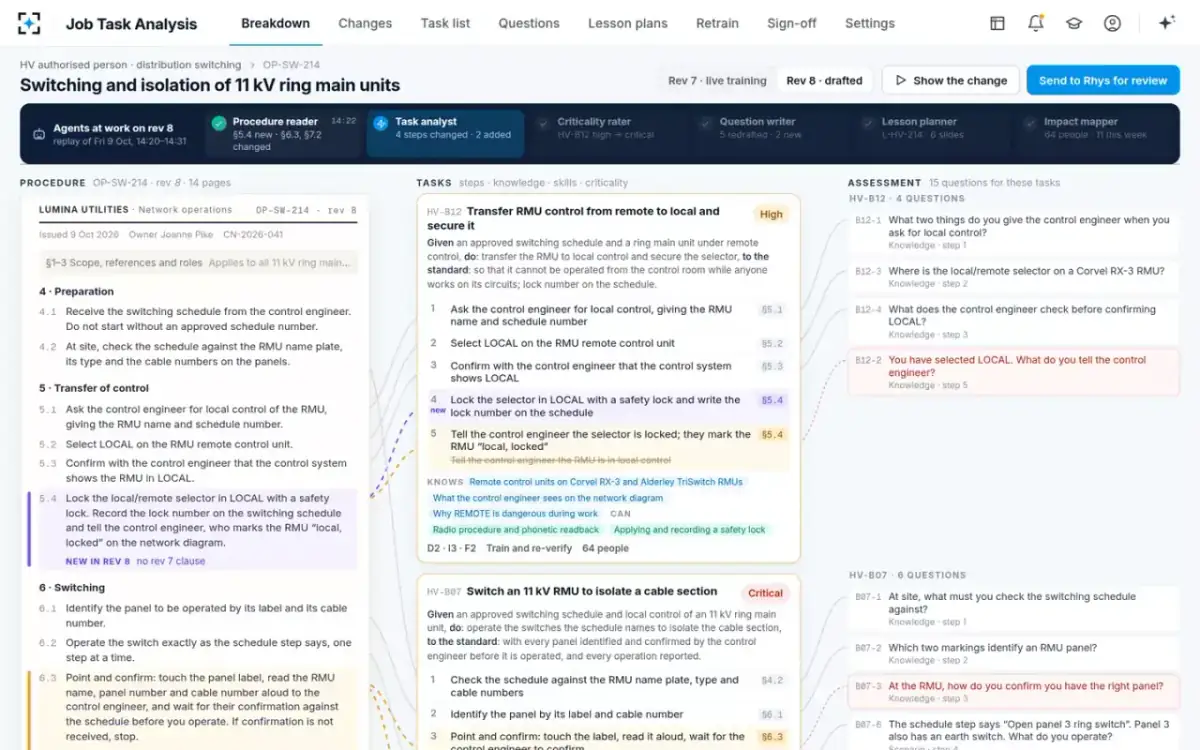

Procedure readerThe procedure reader compares the new revision with the old one, clause by clause. Section 5.4 is new. It says to lock the local/remote selector in LOCAL with a safety lock and record the lock number on the switching schedule. Section 6.3 replaces “check the panel label” with point and confirm. Section 7.2 adds a second check of the voltage indicator after testing for dead. By 14:25 the task analyst has updated three tasks. It has changed 4 steps and added 2, each cited to its clause.
Procedure reader · §5.4 new · §6.3, §7.2 changed
- 03Tuesday · 08:40

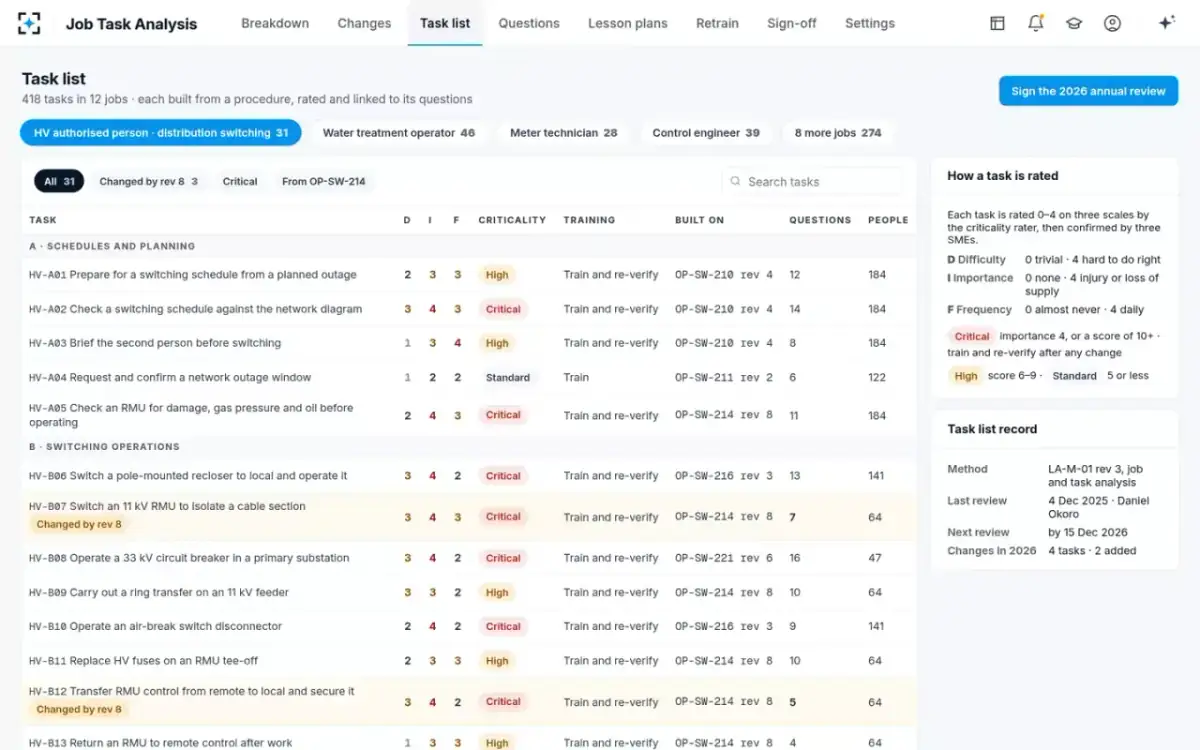

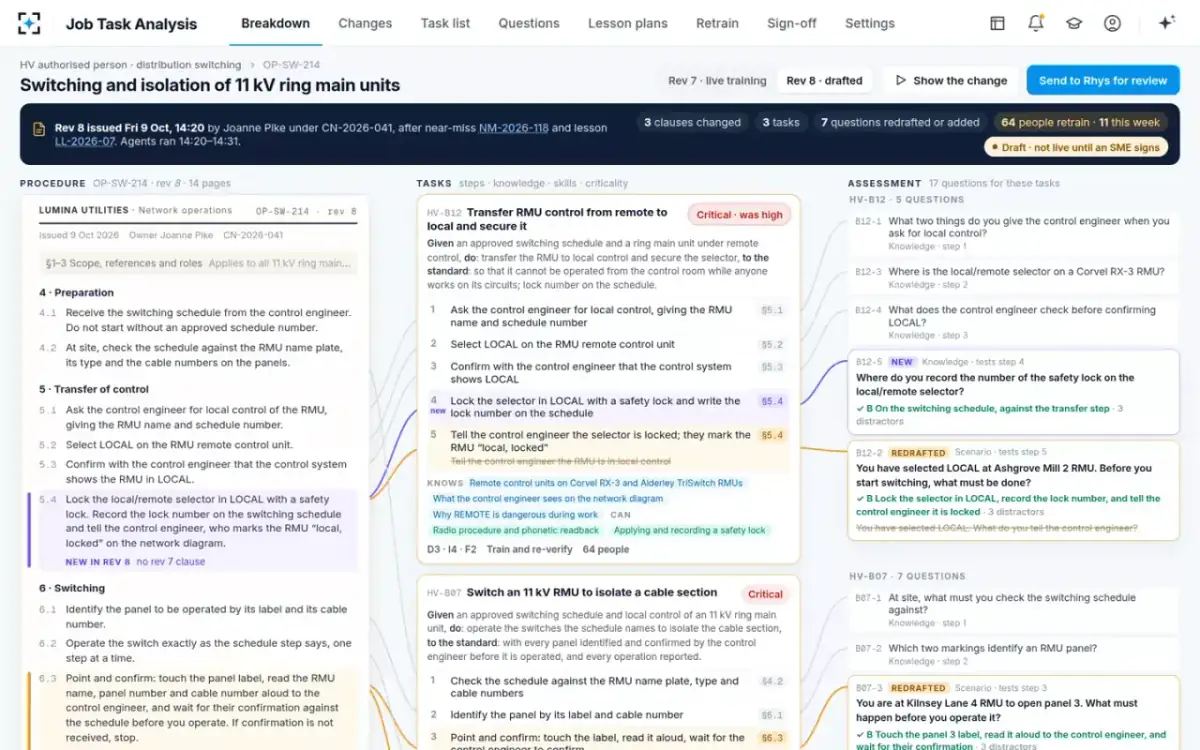

The procedure, its tasks and its questions, joined line to line
Instructional designerThe instructional designer owns the task analyses and assessments for HV switching and earthing. The designer opens the breakdown. On the left is the procedure, with change bars. In the middle are the tasks, each step tagged to its clause. On the right are the questions, each with the step it tests. The banner sums it up: 3 clauses changed, 3 tasks, 7 questions redrafted or added, 64 people to retrain, 11 of them this week.
Draft · not live until an SME (subject-matter expert) signs

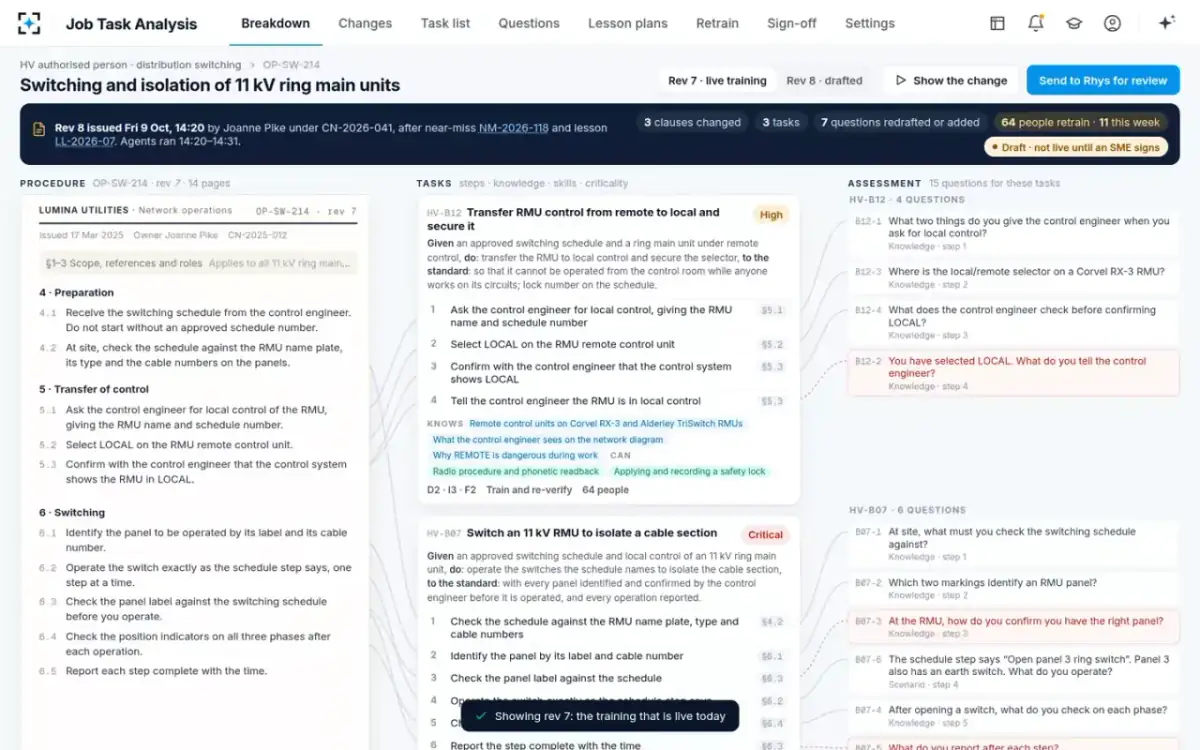

- 04Old revision · live today
What the live training still teaches
Instructional designerOne click shows the old revision, the training people are assessed on today. The selector task stops at telling the control engineer the RMU is in local control. There is no selector lock and no lock number. Two questions are marked as testing steps that have changed. The selector task's question is “You have selected LOCAL. What do you tell the control engineer?” The panel task's question is “At the RMU, how do you confirm you have the right panel?”
Showing the old revision: the training that is live today
- 0514:26 on Friday
The selector task rises from high to critical, with the evidence

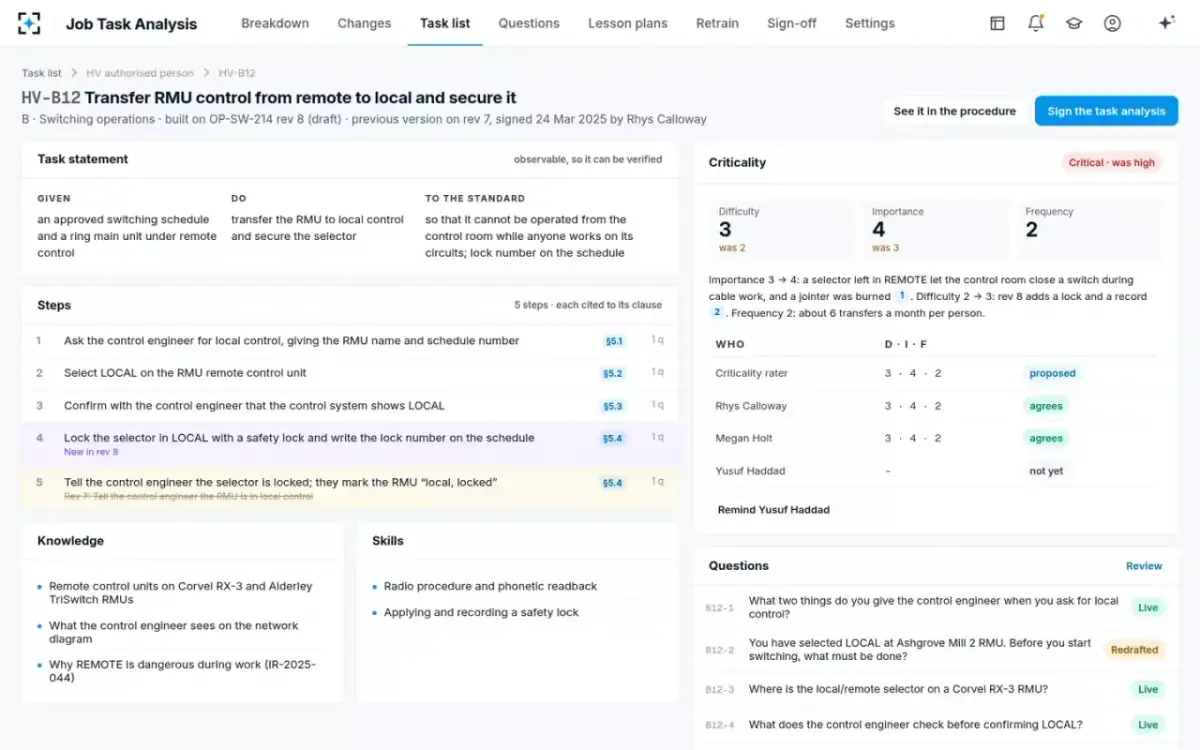

Criticality raterThe task statement follows the form “given, do, to the standard”. It reads: transfer the RMU to local control, and secure the selector so the control room cannot operate it during work on its circuits. Importance goes from 3 to 4 because of an earlier incident. A selector left in REMOTE let the control room close a switch during cable work, and a jointer was burned. Difficulty goes from 2 to 3 for the lock and its record. Two SMEs agree, and the third has not yet confirmed.

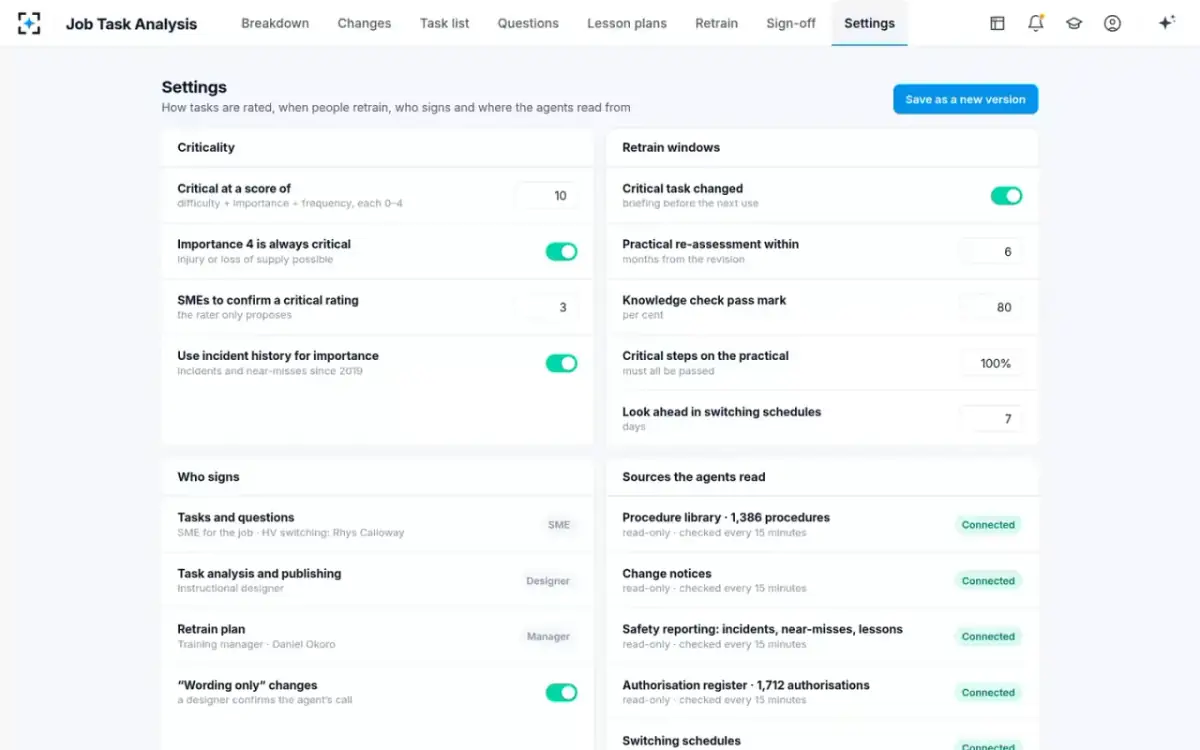

The criticality rater only proposes. Three SMEs must confirm a critical rating.
- 06The questions

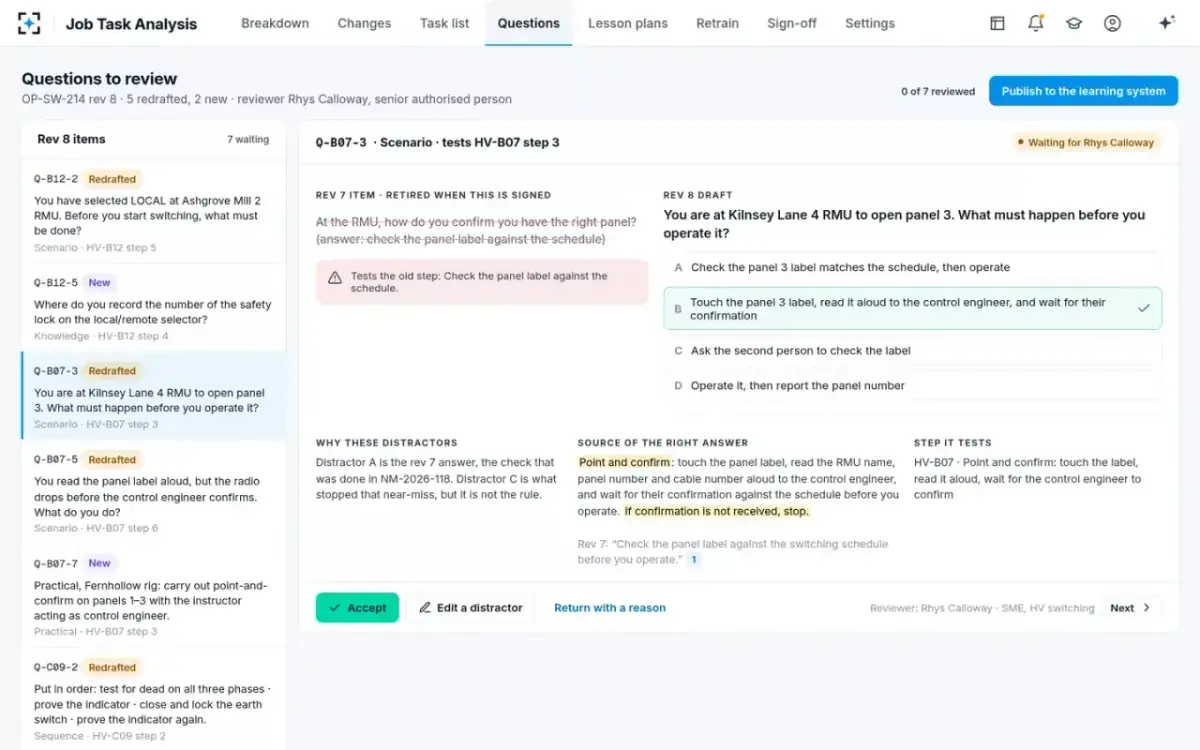

Wrong answers drawn from the near-miss
Question writerThe panel question now asks, “You are at the RMU to open panel 3. What must happen before you operate it?” The right answer is point and confirm, cited to §6.3. The wrong options are called distractors. Option A is the old revision's answer, the check that was done in the near-miss. Option C, asking the second person, is what stopped the near-miss, but it is not the rule. The old item is retired when the new one is signed, and it is kept.
The SME's test: if someone who would still open the wrong panel can pass the question, it is the wrong question.
- 07The lesson

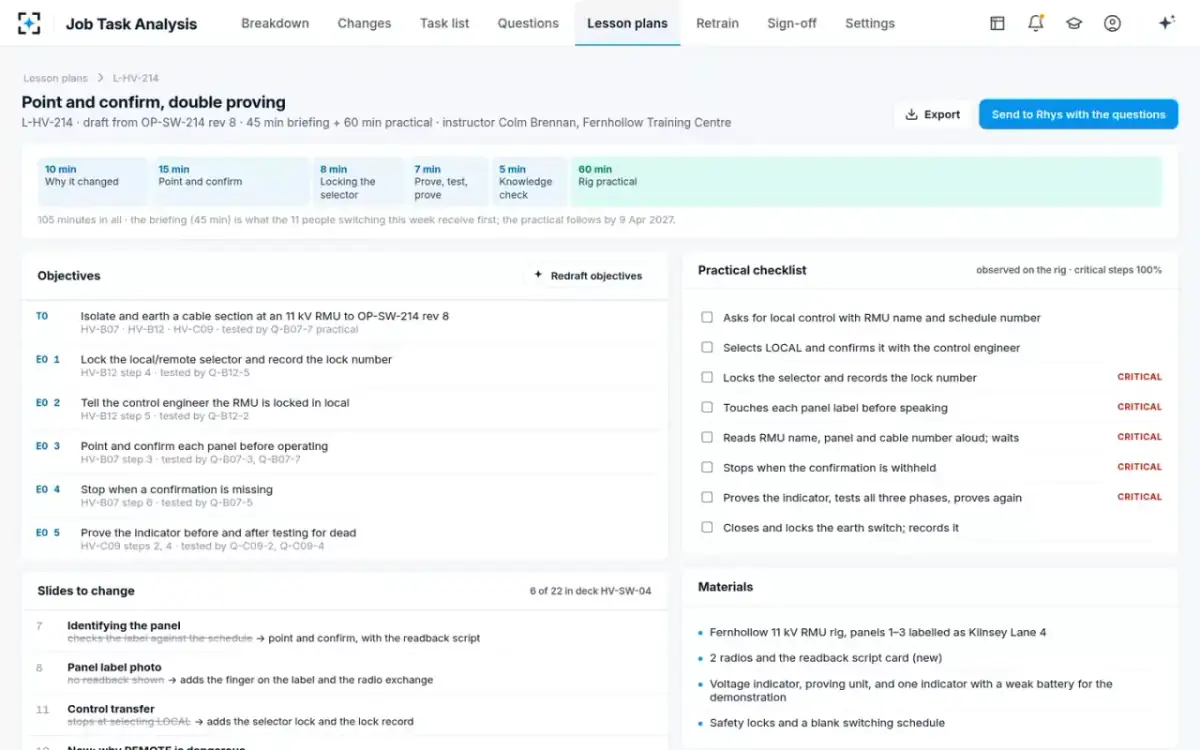

A 45-minute briefing and a 60-minute rig practical
Lesson plannerThe lesson “Point and confirm, double proving” is drafted from the changed steps. It covers why the procedure changed, point and confirm, locking the selector, prove-test-prove and a knowledge check. Then comes the practical on the 11 kV RMU training rig, with an instructor. Each objective maps to a step and the question that tests it. Six of 22 slides in the switching deck must change. The practical checklist marks five critical steps.
Practical checklist: observed on the rig · critical steps 100%
- 0814:31 on Friday

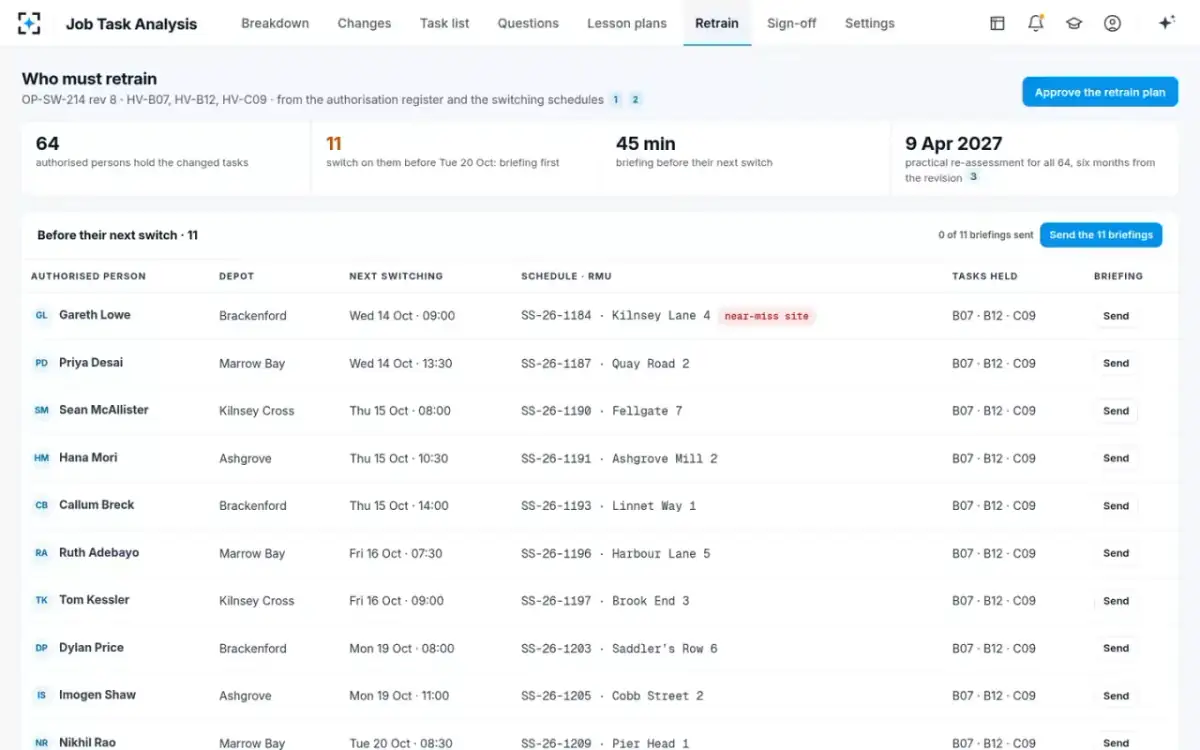

64 people hold the changed tasks, and 11 switch in the next 7 days
Impact mapperThe impact mapper reads the authorization register and the switching schedules. It finds 64 authorized persons in four depots: 19, 16, 17 and 12. Eleven are named on switching schedules for these tasks in the coming week. So they get the 45-minute briefing first. The first of them switches on the Wednesday at 09:00, at the RMU where the near-miss happened.
The impact mapper does not suspend an authorization. The training manager decides.
- 09Six months
All 64 planned for re-assessment on the rig inside six months

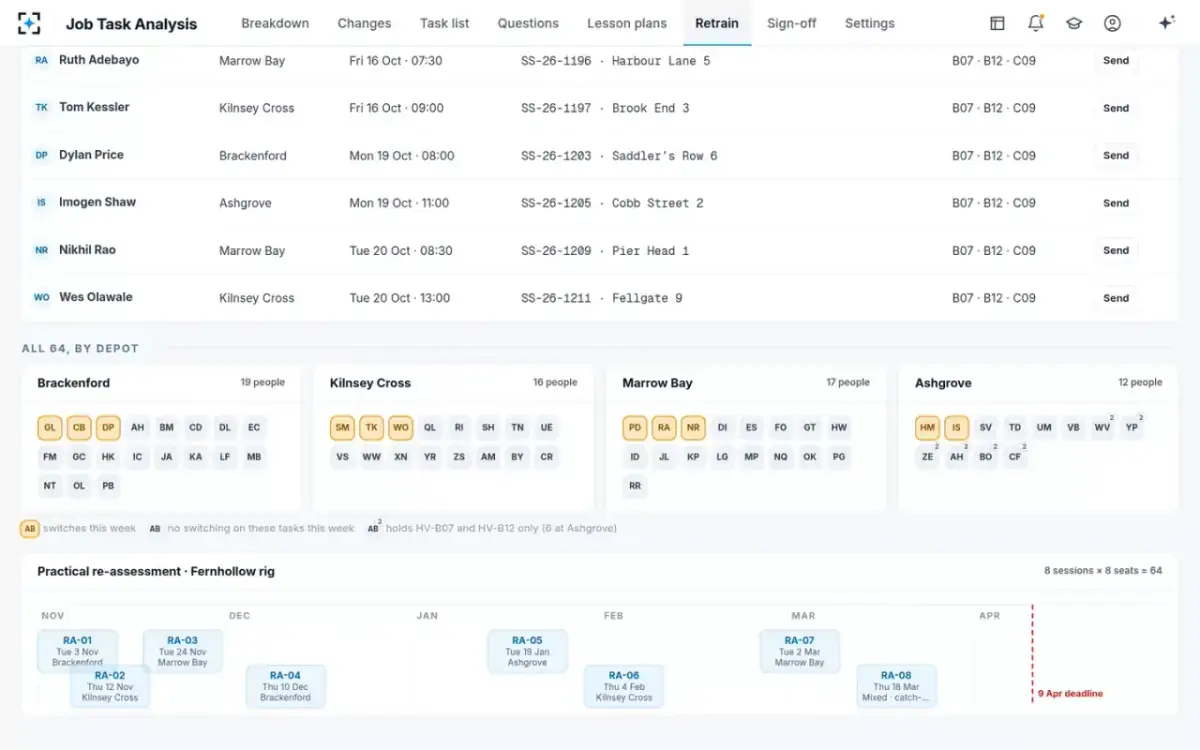

Impact mapperThe practical re-assessment is due six months from the revision. The plan proposes 8 sessions of 8 seats on the training rig, each with an instructor and an SME as assessor. The first session is in early November at one depot. The last is a mixed catch-up session in March.
8 sessions × 8 seats = 64

- 10Signed
The training manager approves who retrains, and by when

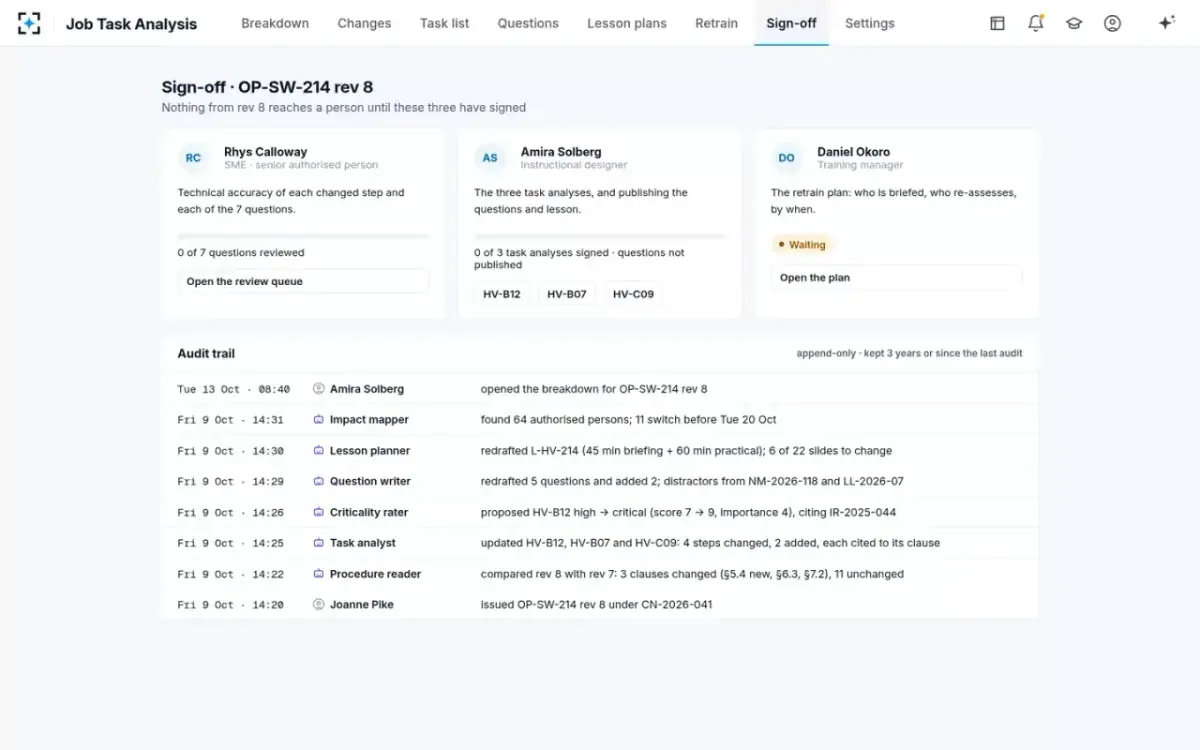

Training manager, network operationsThe training manager signs the retrain plan with a password. The plan sets 11 briefings before the next switch. It also sets a practical re-assessment for all 64 authorized persons, in 8 sessions inside the six-month window. Nothing from the new revision reaches a person until three people have signed. The SME signs each changed step and question. The instructional designer signs the three task analyses, and the training manager signs the plan.
The training manager's test: who must be re-briefed before they next switch.
