- Before
- Runs training for 38 system operators in five crews. Knows they are trained, but proving it task by task takes the team three weeks before each audit.
- Now
- Opens the grid with each cell scored overnight. Sees the gaps before the auditor does, and books each one with its date.
An audit request on the load-shed task, answered with a released binder
A utility runs a control center with 38 system operators, in five crews of seven plus three relief operators. Its task list has 64 tasks in six areas. The regional auditor is on site in three weeks. Here is what happens next in the working solution, screen by screen.
A worked example on sample data. Names, IDs and figures on the screens and in this section come from the demo.
- 0106:00

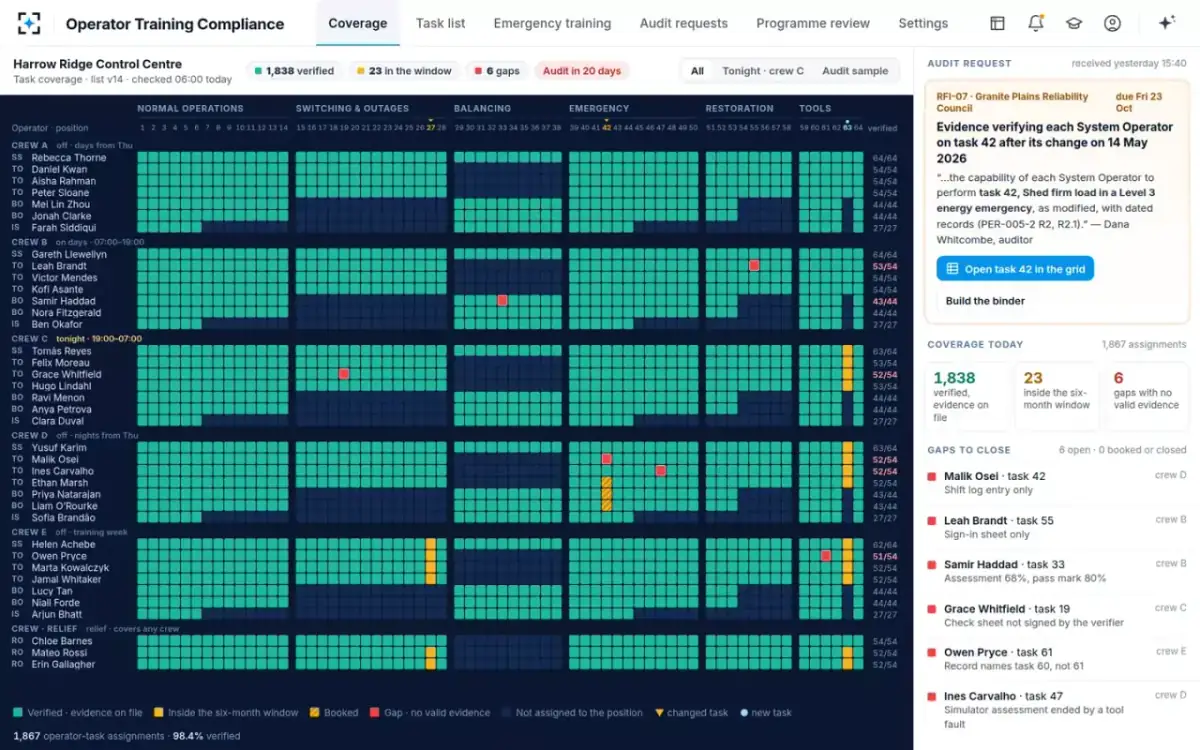

The home screen is the proof itself
Control-room training managerOperators run down the side by crew, and the 64 tasks run across the top by area. Each cell shows verified, inside the six-month window, or a gap. Overnight the agents read 412 new records from the learning system, simulator and document library. They filed 409 to an operator and task, and set 3 course sign-ups aside. The grid shows 1,838 verified, 23 inside the window and 6 gaps. That is 98.4% of 1,867 assignments.
06:03 · New gap: one operator on a switching task, whose check sheet has no verifier signature
- 02One click

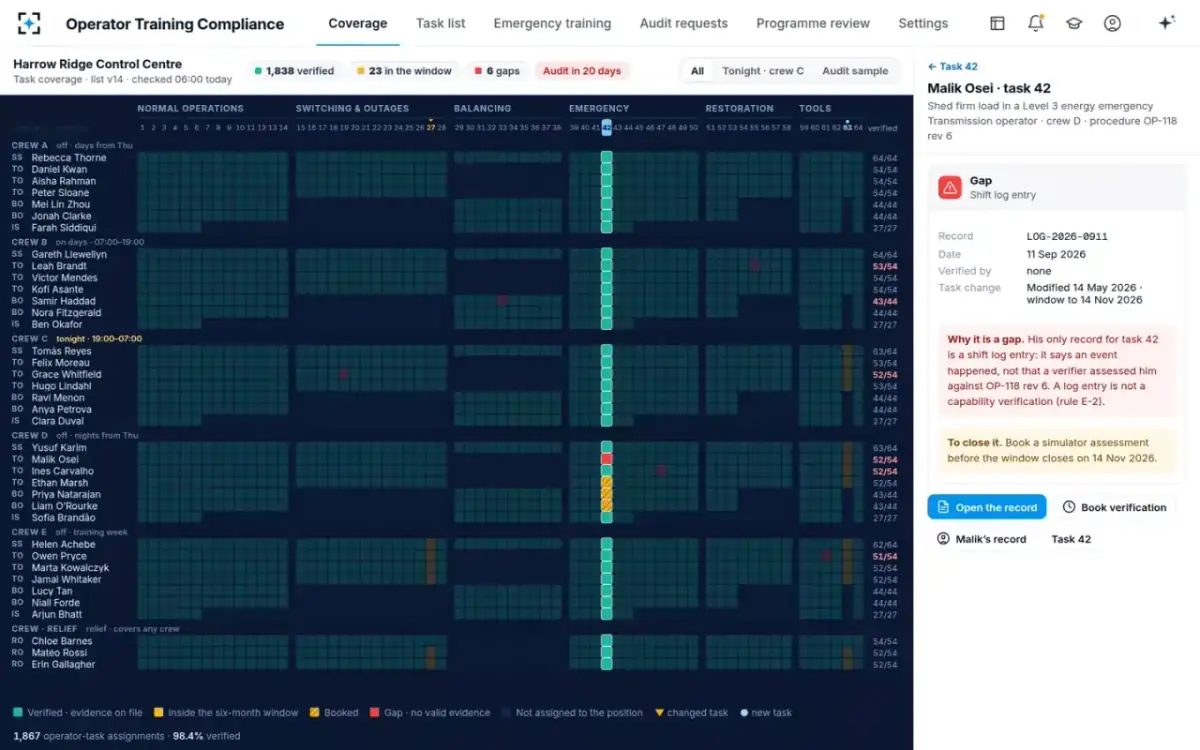

The audit request names the load-shed task, and its column lights up
Control-room training managerThe afternoon before, the auditor asked for evidence on one task, “Shed firm load in a Level 3 energy emergency”. Shedding load means cutting power to some customers to protect the grid. The request asks how each system operator was verified on the task after its change in May (PER-005-2 R3, R3.1). The training manager opens that task in the grid. Its records show 34 verified, 3 booked and 1 gap. The window to re-verify closes in about a month.
The request asks for the capability of each system operator to perform the task as modified, with dated records.
- 03The gap
A transferred operator holds a shift log entry and no verification
Records readerThe operator transferred from the backup control center. Their only record for the task is a shift log entry from September, verified by nobody. Three others in crew D are already booked on the crew's next simulator session. This operator is not.
Why it is a gap: the only record for the task is a shift log entry. A log entry says an event happened. It does not show that a verifier assessed the operator against the load-shed procedure (rule E-2).

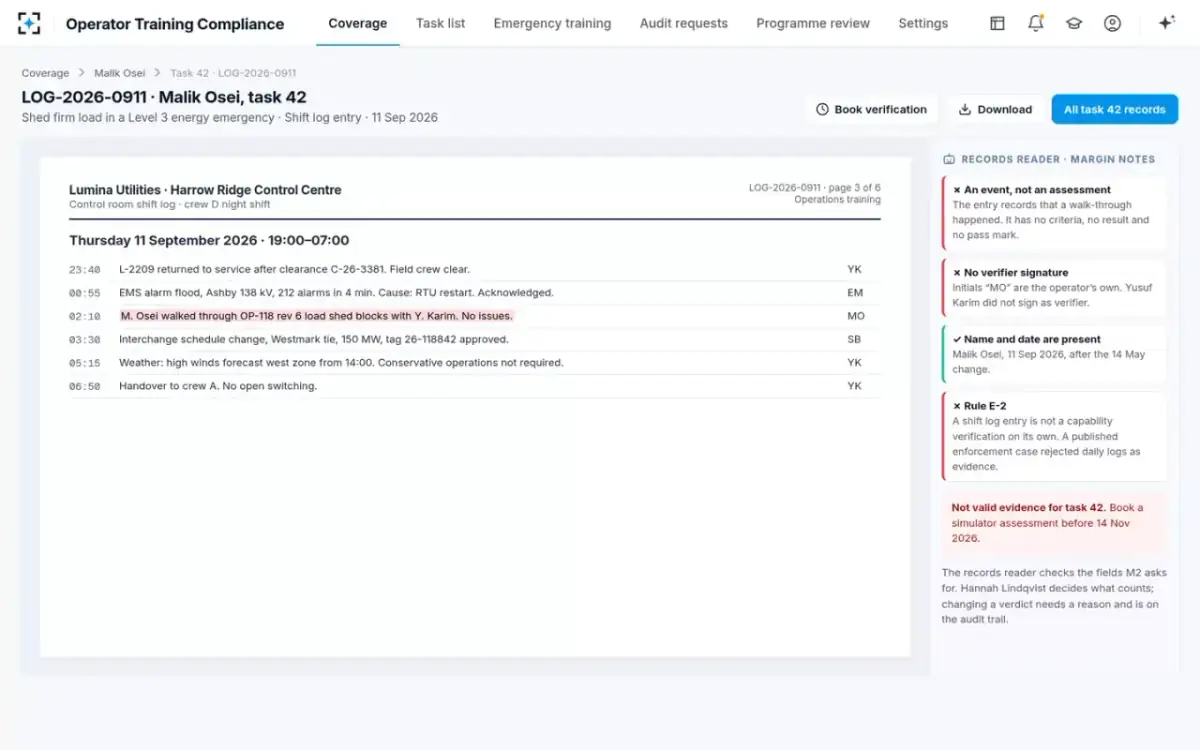

- 04The record
The log page, with the reader's margin notes
Records readerThe record opens at the line. It says the operator walked through the load-shed blocks of the revised procedure with a colleague, with no issues. The margin notes say why it fails. It records an event, and no one assessed the operator. The initials are the operator's own, so the colleague did not sign as verifier. The name and date are present, and fall after the May change.
The records reader checks the fields that M3, the audit measure for records, asks for. The training manager decides what counts. Changing a verdict needs a reason and goes on the audit trail.
- 05Booked

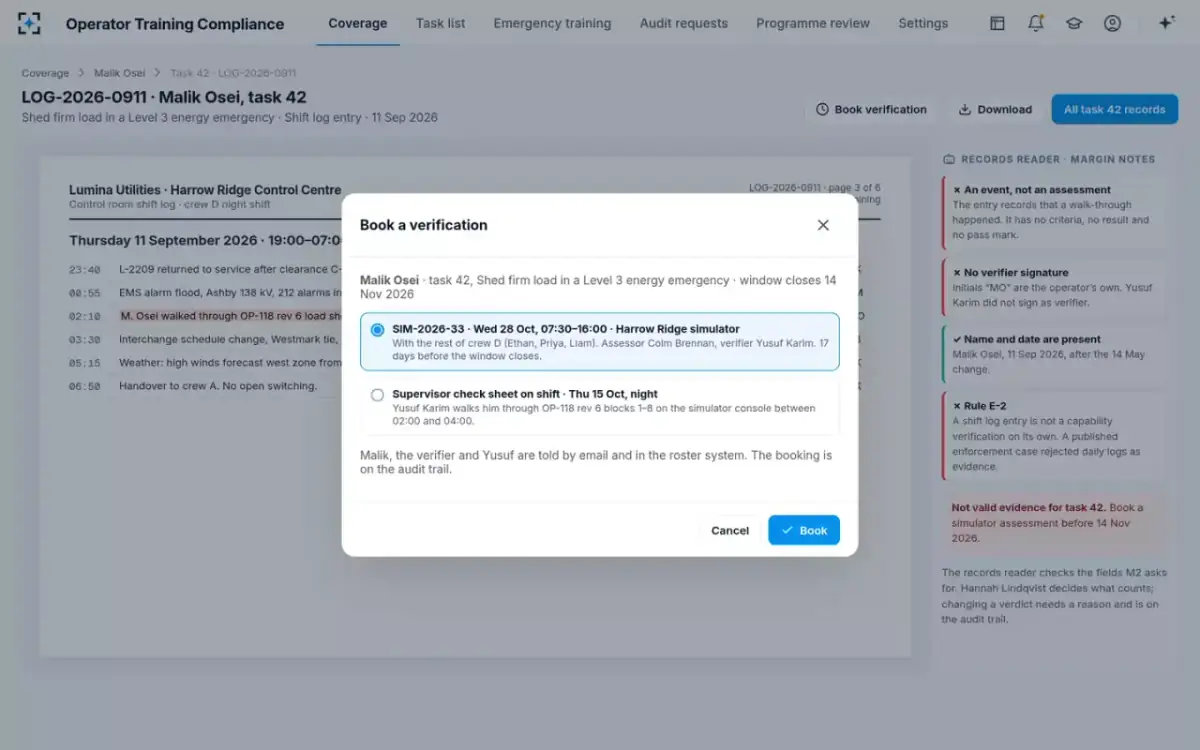

A simulator assessment, 17 days before the window closes
Control-room training managerThe training manager books the operator on the crew D simulator session. It is a full day, from 07:30 to 16:00, with an assessor and a verifier. The other choice on screen is a supervisor check sheet on shift later that week. The operator and the verifier are told by email and in the roster system.
The booking is on the audit trail.

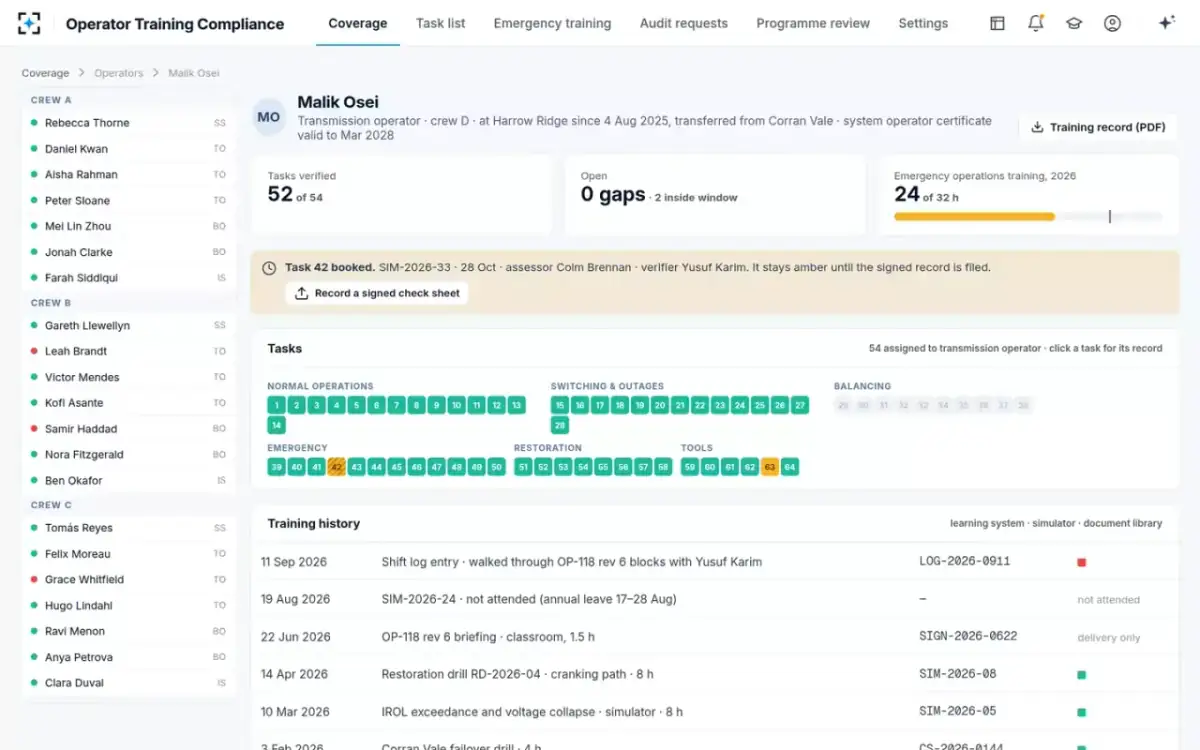

- 06The operator's record
Booked is still amber until the signed record is filed

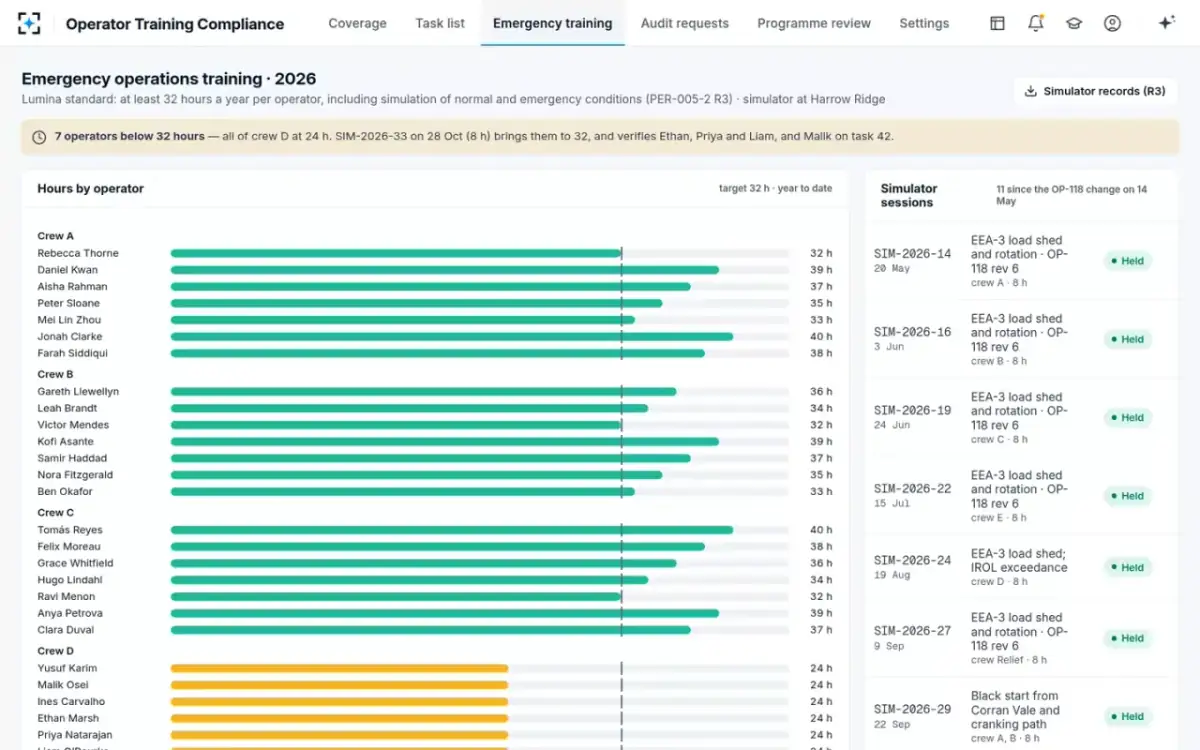

Transmission operator, crew DThe operator's page shows 52 of 54 tasks verified, 0 gaps and 2 inside the window. It also shows 24 of 32 hours of emergency operations training this year. The training history explains the gap. The operator was on annual leave for the August simulator session. The classroom briefing on the revised procedure counts for delivery only.
Task booked. It stays amber until the signed record is filed.
- 07The binder

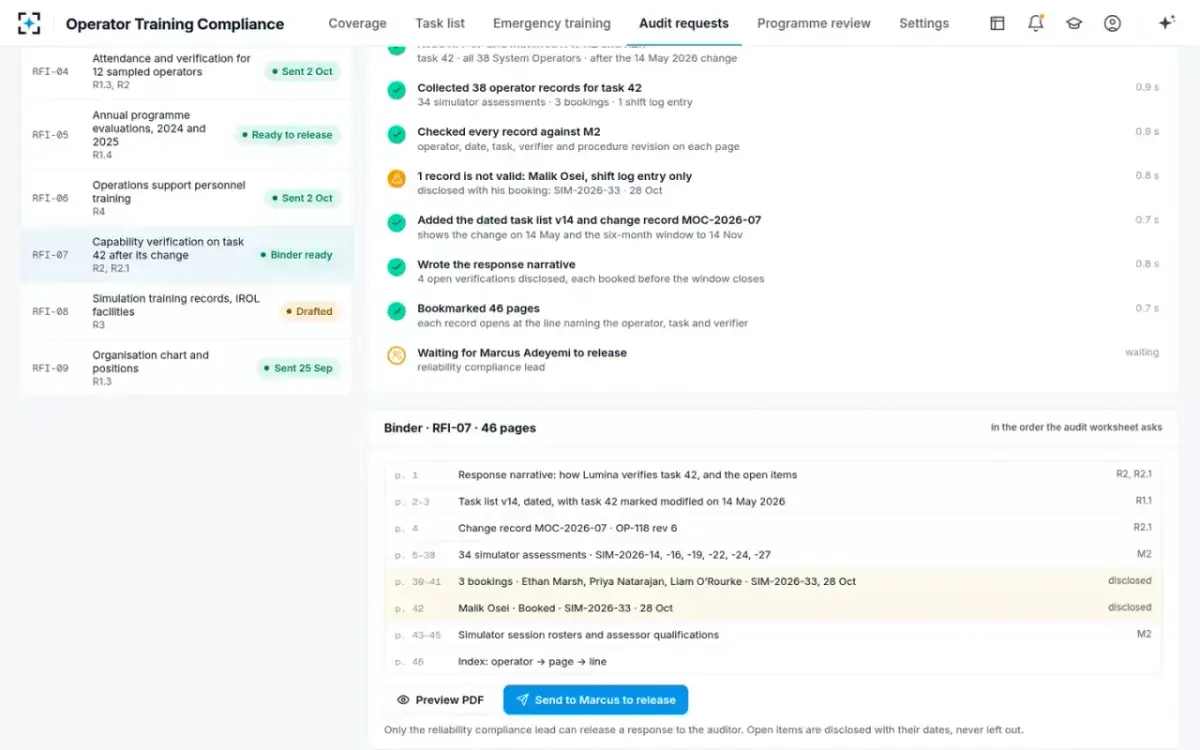

46 pages, in the order the audit worksheet asks
Evidence binder builderThe binder builder matches the request to R3 and R3.1 and collects 38 operator records for the task. It checks each against M3 and adds the dated task list with its change record. It writes the response narrative and bookmarks each page at the line naming the operator, task and verifier. The four open verifications are in the binder on pages 39 to 42, each with its booking.
Open items are disclosed with their dates, and kept in the binder.
- 08Release

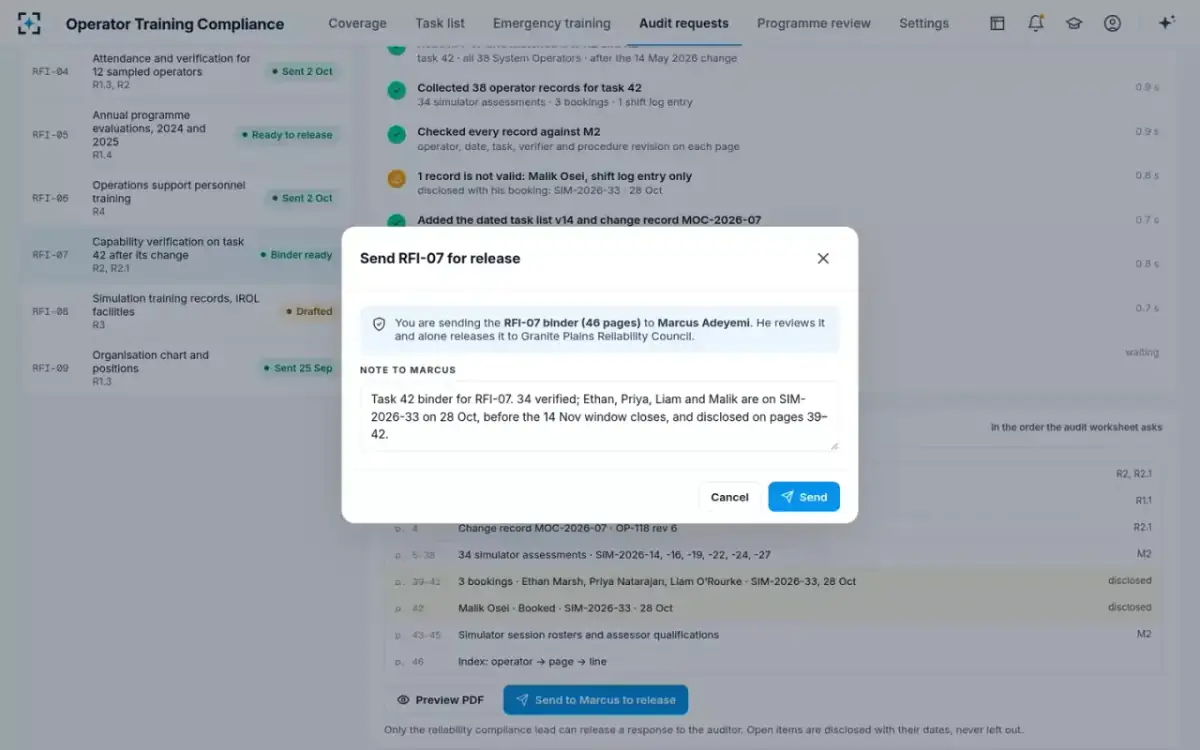

Only the compliance lead releases to the auditor
Reliability compliance leadThe training manager sends the binder to the compliance lead with a note. It says 34 are verified, and four operators are on the crew D simulator session before the window closes. The compliance lead reviews it, and only the compliance lead can release it to the auditor. The response is due the following week.
Nothing leaves the utility until the compliance lead releases it.

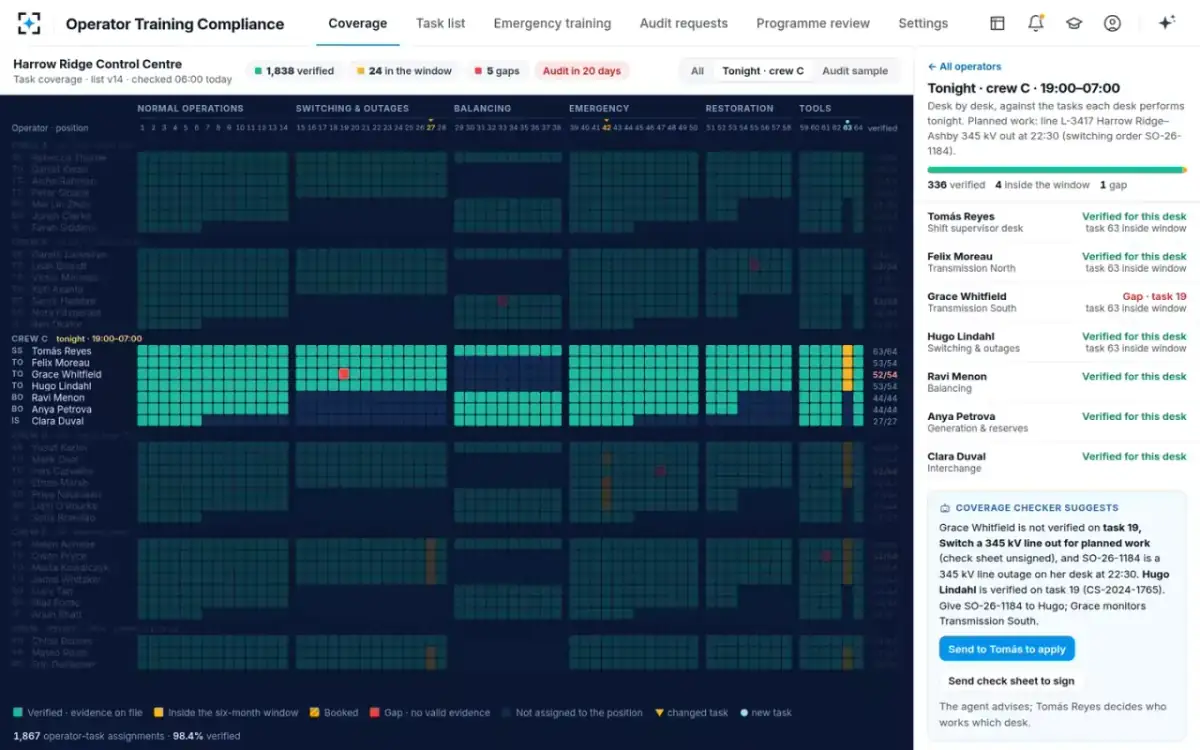

- 09Tonight, 19:00
Tonight's crew, checked against its desks
Shift supervisor, crew CA 345 kV line comes out of service at 22:30 under a switching order. It is on the desk of an operator whose check sheet for that switching task is unsigned. The coverage checker suggests a swap. A colleague verified on the task takes the switching order, and the first operator monitors the southern transmission desk. The shift supervisor decides.
The agent advises, and the shift supervisor decides who works which desk.

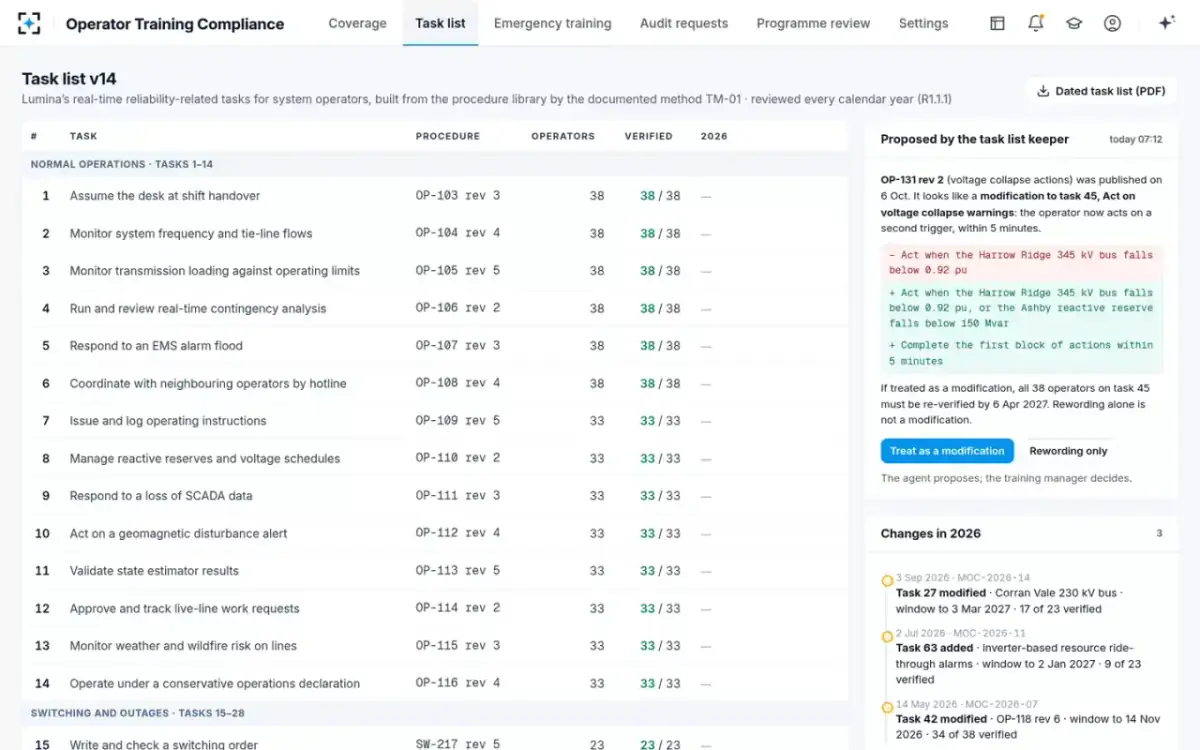

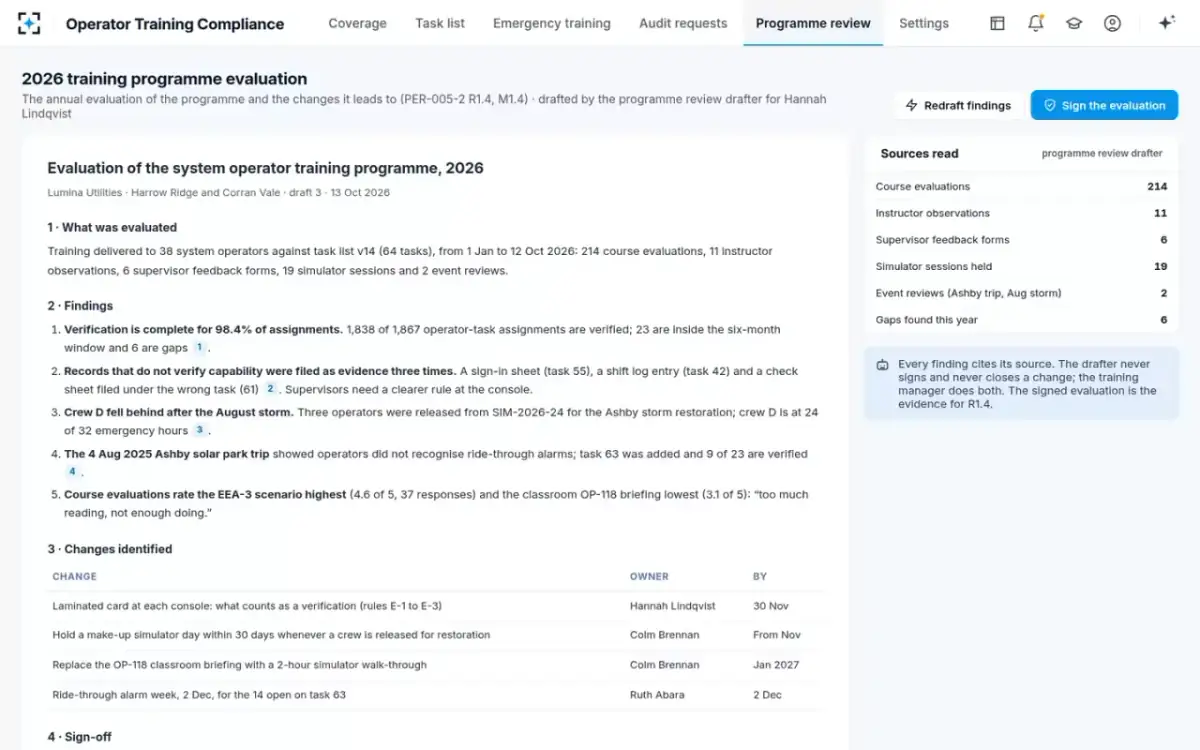

- 10Waiting for the training manager
A procedure revision that may change a task
Task list keeperA revised procedure on voltage collapse actions was published the week before. The task list keeper shows what changed. Operators now act on a second trigger, within 5 minutes. The training manager decides whether this modifies the voltage collapse task. If it does, all 38 operators must be re-verified within six months. New wording alone does not count as a modification.
The agent proposes, and the training manager decides.
