- Before
- Owns the work list and schedule for the outage. Finds out what a finding costs only when the schedule is already late.
- Now
- Adds a finding and sees the critical path, return date and cost redraw at once. Gets a way to do the job alongside other work when it would push the date out.
One late boiler finding on a 28-day power plant outage, worked alongside other jobs
The unit is a 320 MW plant that makes power and also supplies steam to a nearby plant. Its major overhaul starts on a Monday at 06:00, when the unit is cut off from the grid. It is due back four weeks later, at 28.0 days. Today is 20 days before the start, and the work list freezes in 3 days. Here is what happens next, screen by screen, in the working solution.
A worked example on sample data. Names, IDs and figures on the screens and in this section come from the demo.
- 01T-20 · morning

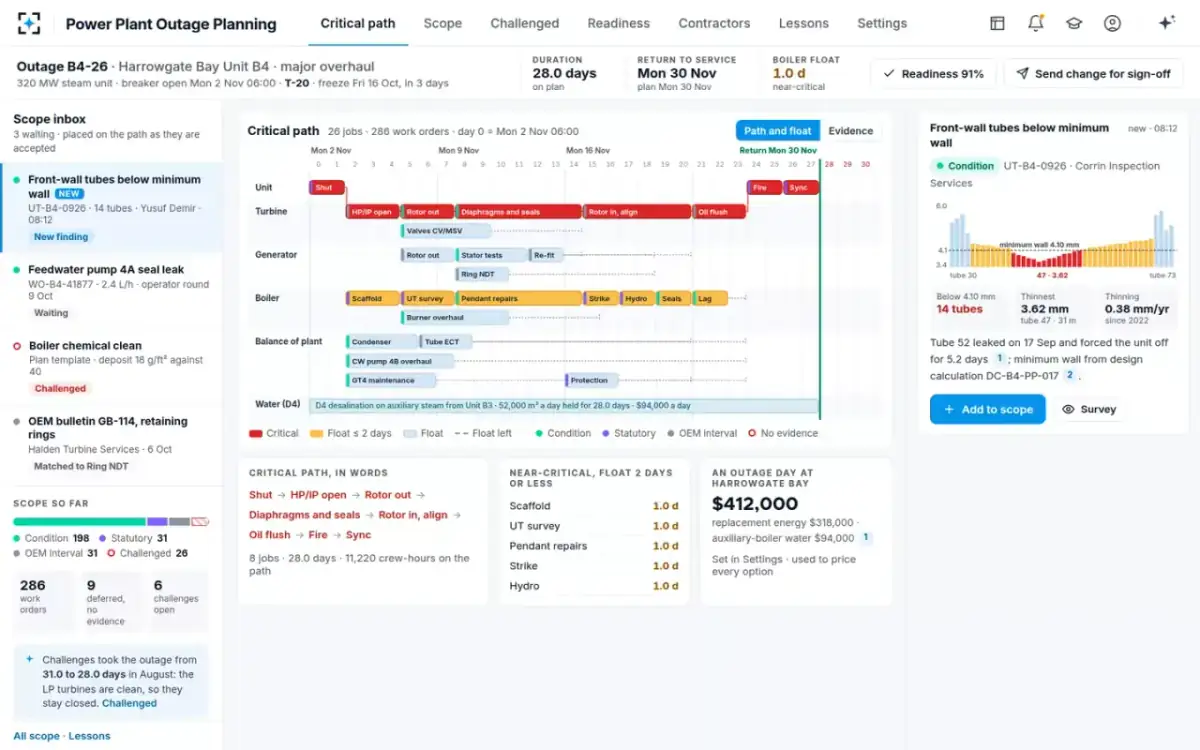

The schedule is the home screen

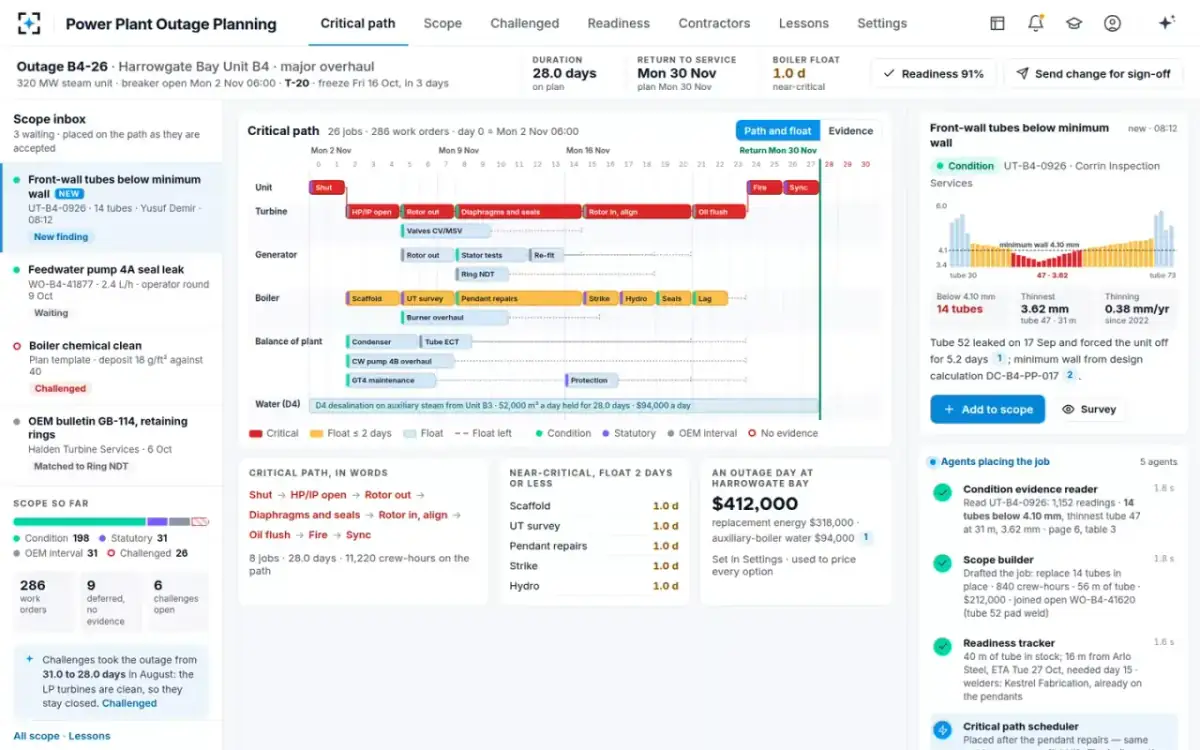

Outage plannerThe planner owns the work list and the schedule for the outage. The home screen shows the schedule as a network over time: 26 jobs and 286 work orders across days 0 to 30. There are lanes for the unit, turbine, generator, boiler, the rest of the plant and the steam supply. The critical path, the chain of jobs that sets the end date, is in red. The header reads 28.0 days, with only 1.0 day of spare time on the boiler, so it is close to the critical path. Three items wait in the inbox: the new boiler survey, a feedwater pump seal leak and a challenged chemical clean.
“An outage day at this station: $412,000 · replacement energy $318,000 · auxiliary-boiler steam $94,000”
- 02One click
Each bar shows the evidence that put it there

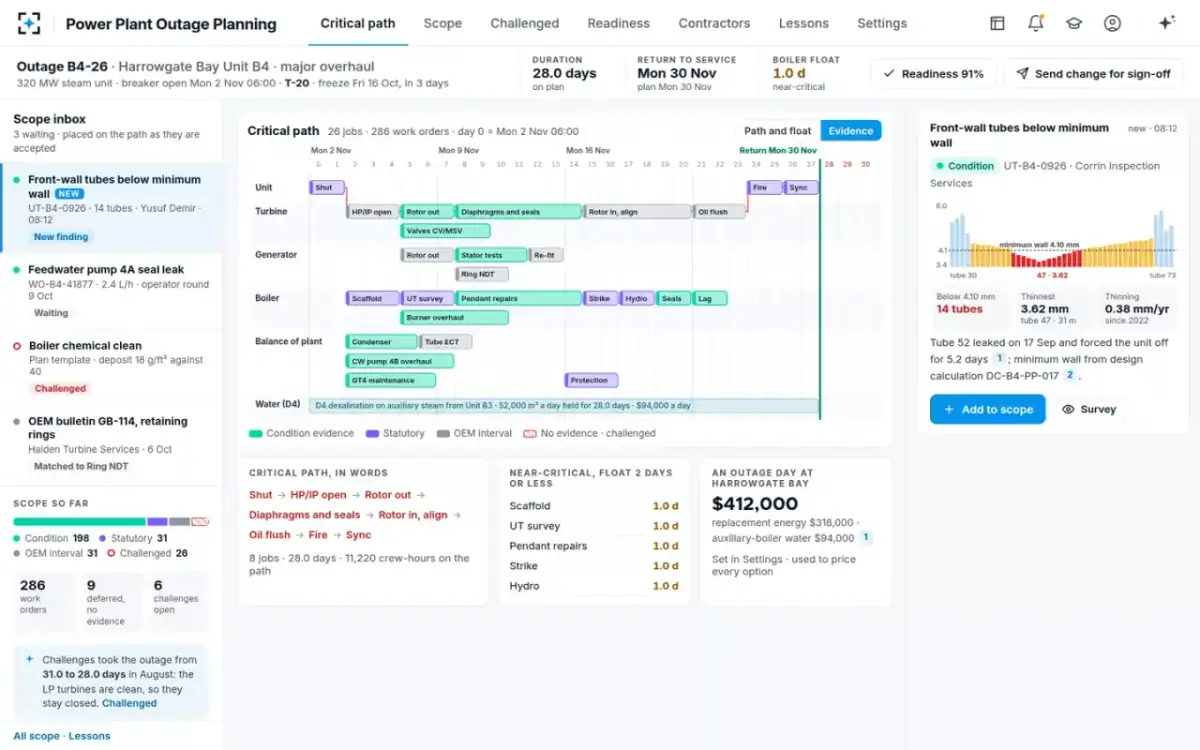

Condition evidence readerSwitched to Evidence, the same schedule is colored by why each job is in the outage. A job can rest on a condition reading, a legal requirement or the maker's service interval. Or it has no evidence and is challenged. Of 286 work orders, 198 rest on a reading, 31 on the law and 31 on the maker's interval. The other 26 were challenged.
“Challenges took the outage from 31.0 to 28.0 days: the LP turbines are clean, so they stay closed.”
- 03Before the freeze
No reading, no outage time

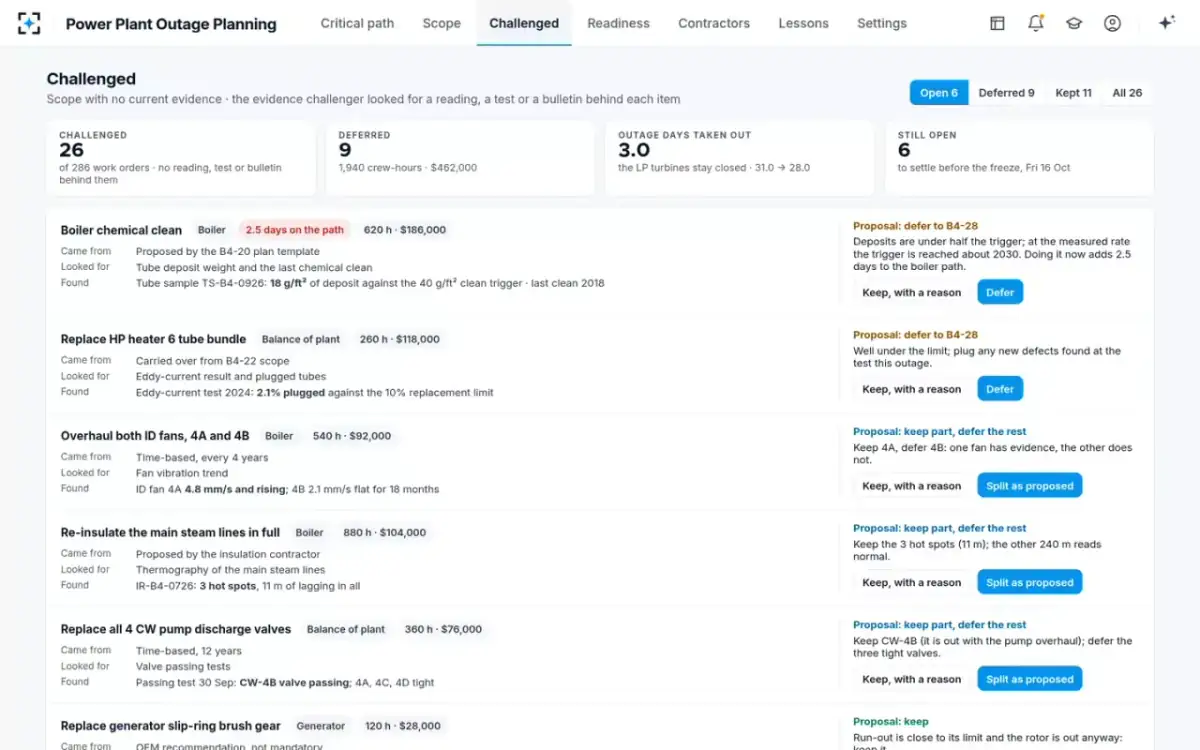

Evidence challengerEach challenged item says where it came from, what the challenger looked for and what it found. The boiler chemical clean was copied from an old outage plan. The tube sample shows 18 g/ft² of deposit, against a 40 g/ft² trigger. So the proposal is to put it off to the next outage and keep 2.5 days off the boiler work. For the two fans, it proposes a split. Keep 4A, whose vibration is rising at 4.8 mm/s. Put off 4B, flat at 2.1 mm/s for 18 months.

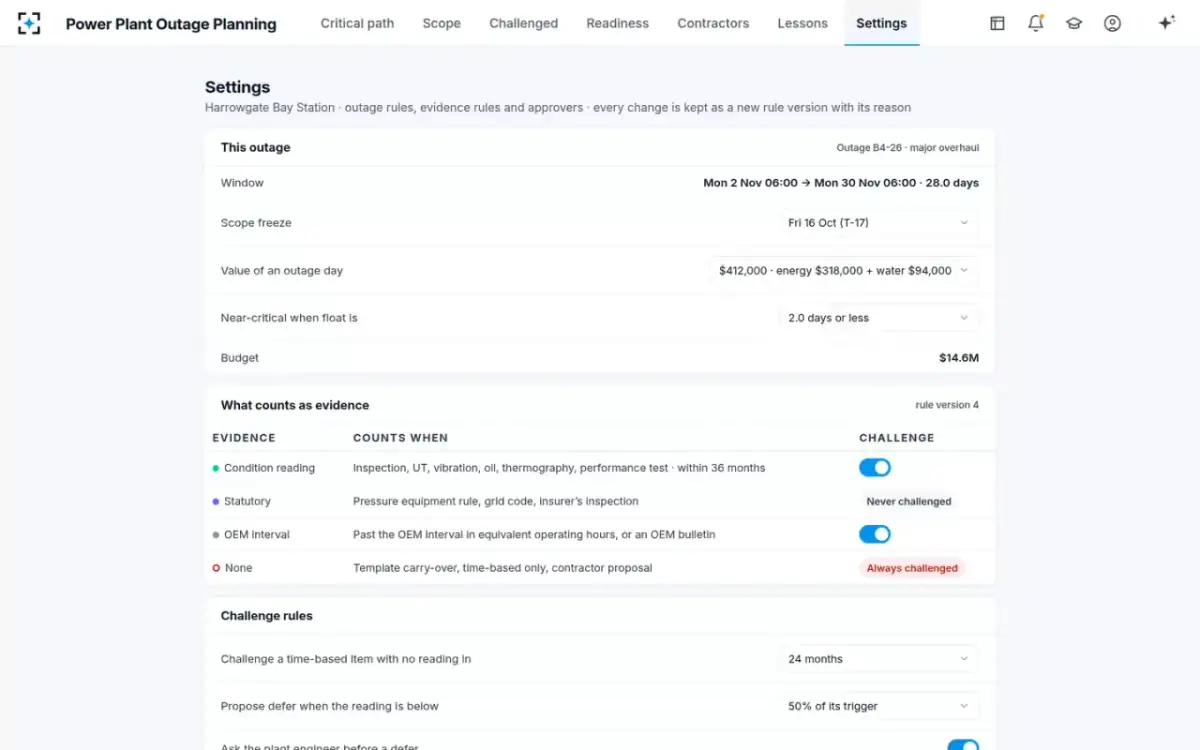

Jobs the law requires are not challenged · the challenger proposes, the planner decides, the outage manager signs changes after the freeze.
- 04Add to scope

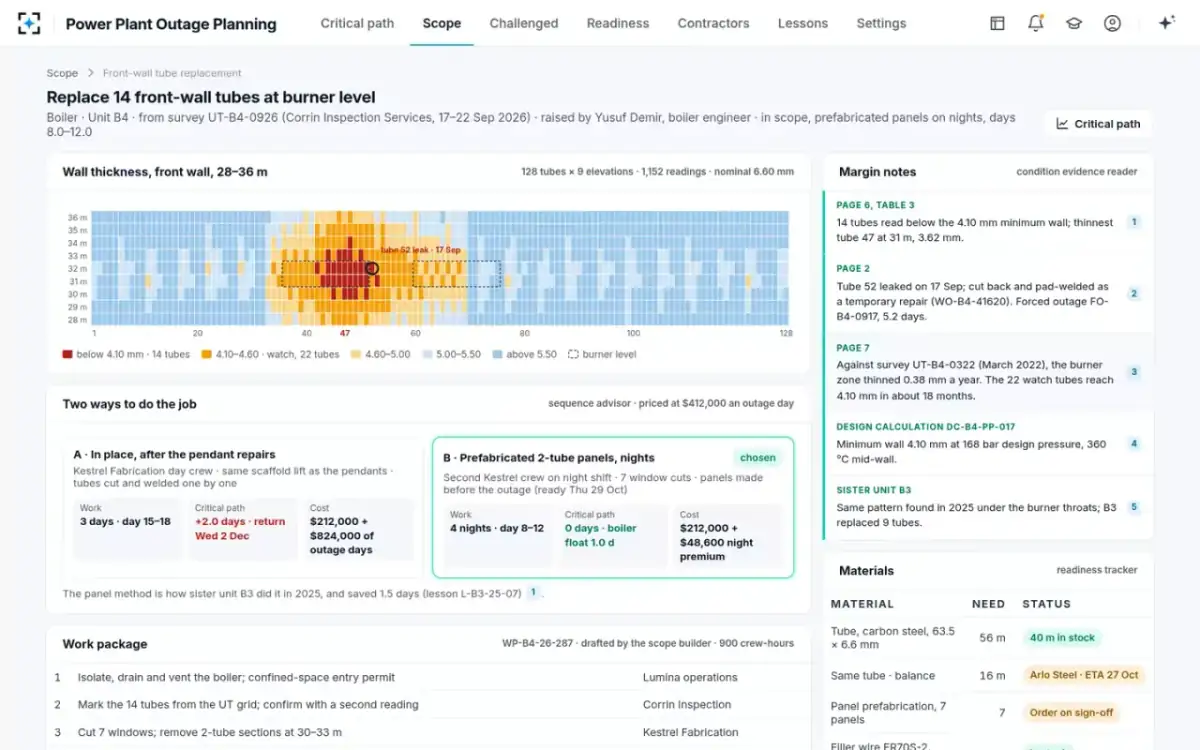

Fourteen front-wall tubes worn below the safe thickness
Condition evidence reader and Scope builderAt 08:12 the boiler engineer raised the inspection contractor's new survey. It found 14 front-wall tubes at burner level below the 4.10 mm minimum safe thickness. The thinnest, tube 47 at 31 m, reads 3.62 mm and has thinned 0.38 mm a year since the previous survey. Tube 52 leaked weeks earlier and forced the unit off for 5.2 days. The planner adds the finding. The reader checks all 1,152 readings and cites page 6, table 3. The scope builder drafts the job: 840 crew-hours, 56 m of tube and $212,000. It also joins the job to the open pad-weld work order.
Readiness tracker: “40 m of tube in stock; 16 m from the supplier, arriving the week before breaker open, needed day 15.”
- 05Seconds later

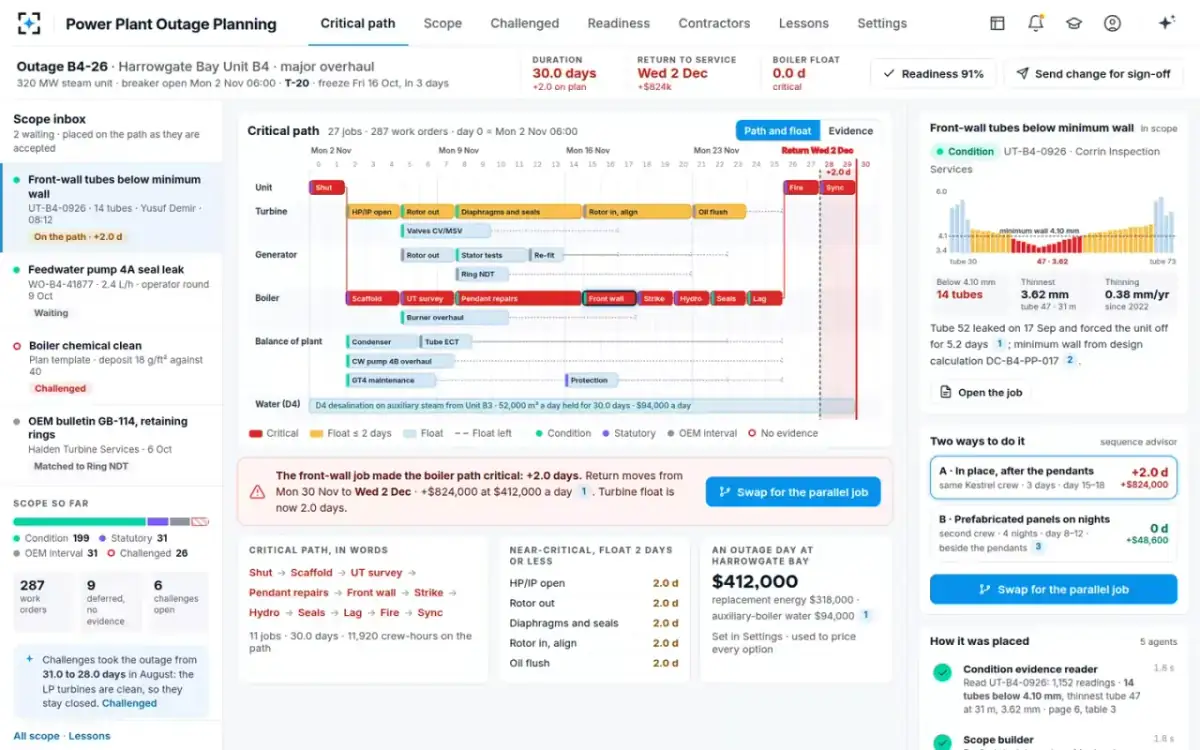

The boiler sets the end date: +2.0 days
Critical path schedulerThe job is placed after the superheater pendant repairs, because it needs the same welders and scaffold. That puts the boiler on the critical path. The schedule redraws at 30.0 days, so the unit returns two days later. The boiler has no spare time left. At the value of an outage day, those two days cost $824,000. The turbine work now has 2.0 days to spare.
“The front-wall job made the boiler path critical: +2.0 days. Return moves two days later · +$824,000 at $412,000 a day.”
- 06The swap
Tube panels fitted on night shifts, beside the superheater repairs

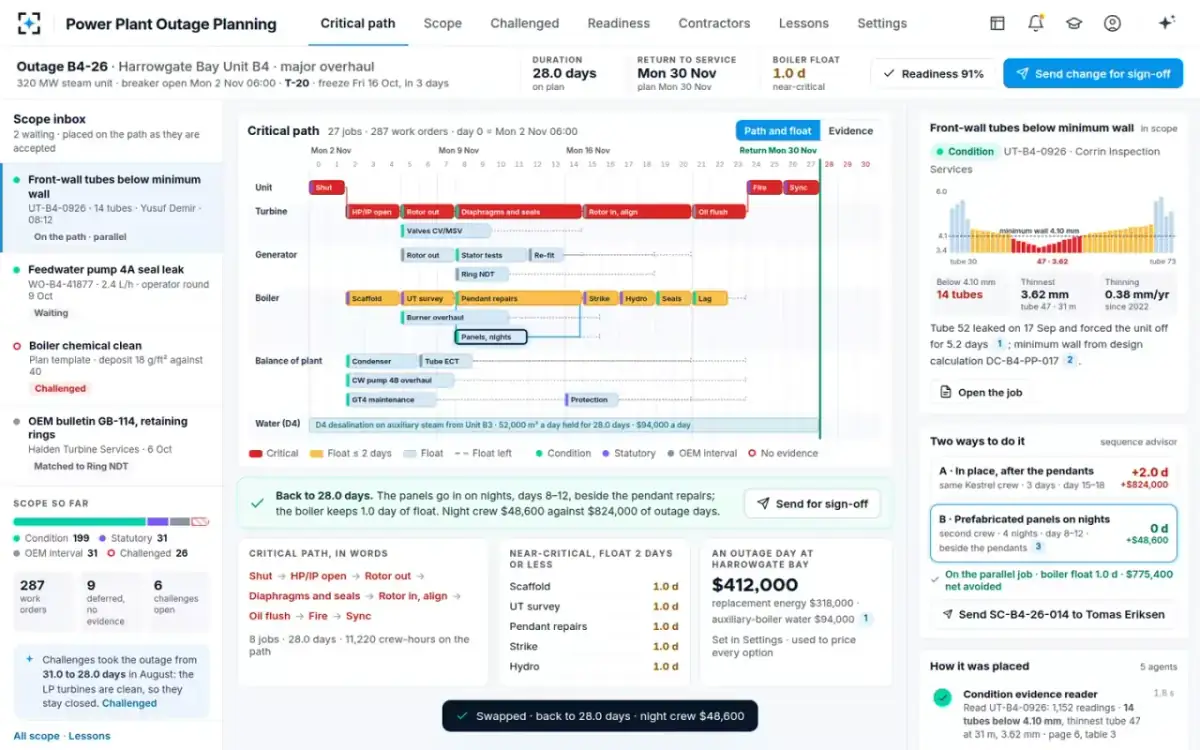

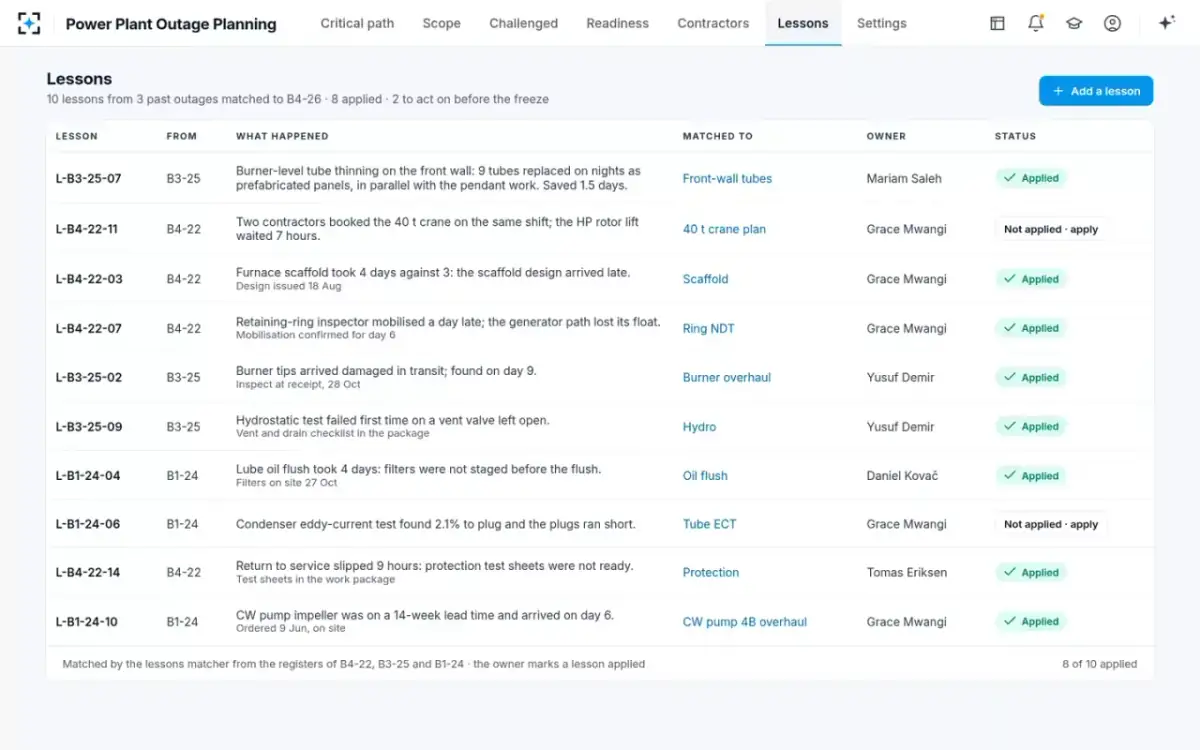

Sequence advisorThe advisor offers a way to do the job alongside other work. It cites a sister unit that replaced 9 front-wall tubes on nights last year and saved 1.5 days. A fabricator builds 2-tube panels before the outage. A second crew fits them through 7 cuts in the wall, on nights, days 8 to 12. The planner takes it. The outage is back to 28.0 days, with 1.0 day of spare time on the boiler. The net saving is $775,400.
“Back to 28.0 days. The panels go in on nights, days 8 to 12, beside the pendant repairs; the boiler keeps 1.0 day of float. Night crew $48,600 against $824,000 of outage days.”

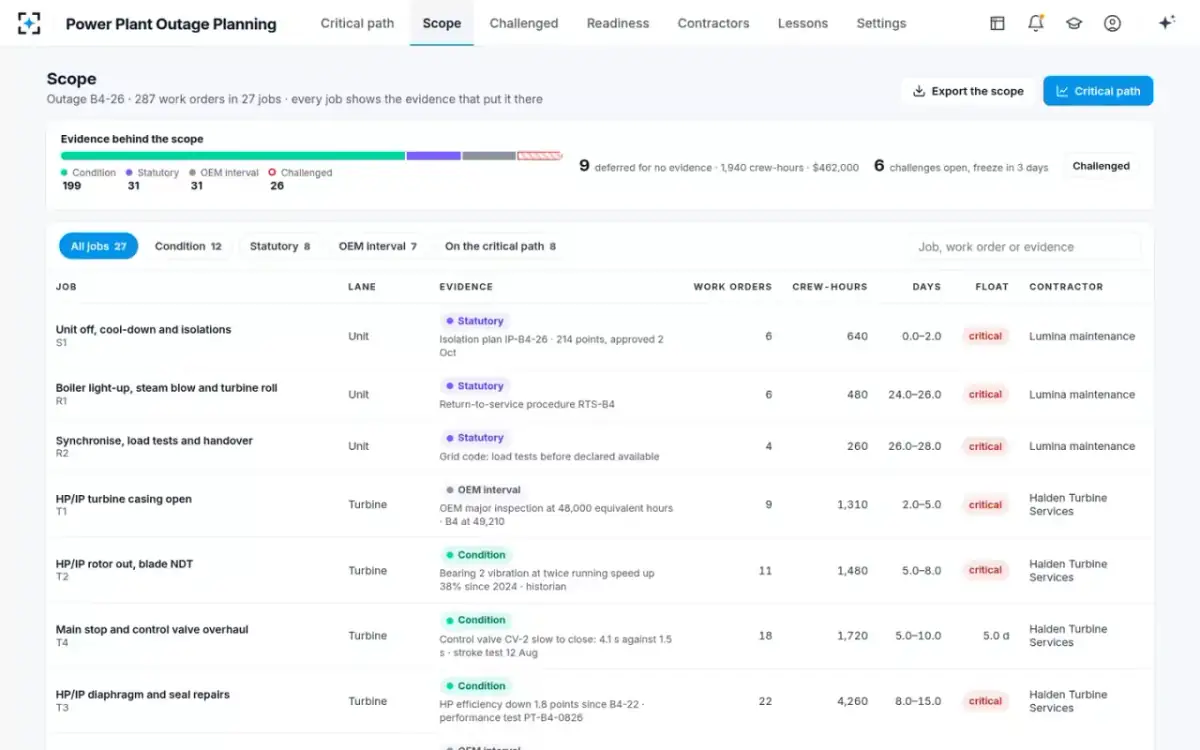

- 07The job
The tube thickness map behind the job
Boiler engineerThe job page shows the front wall as a map of 128 tubes at 9 heights, colored by thickness. Fourteen are below 4.10 mm and 22 are on a watch list, between 4.10 and 4.60 mm. Notes in the margin cite the survey page and table, the forced outage and the design calculation. The work package runs from isolation and confined-space entry to X-ray checks of all 28 welds. It includes a new survey of the 22 watch tubes and each material's quantity and status.
Margin note: “Against the previous survey, the burner zone thinned 0.38 mm a year. The 22 watch tubes reach 4.10 mm in about 18 months.”
- 08Signed
The evidence, both options and the money on one page

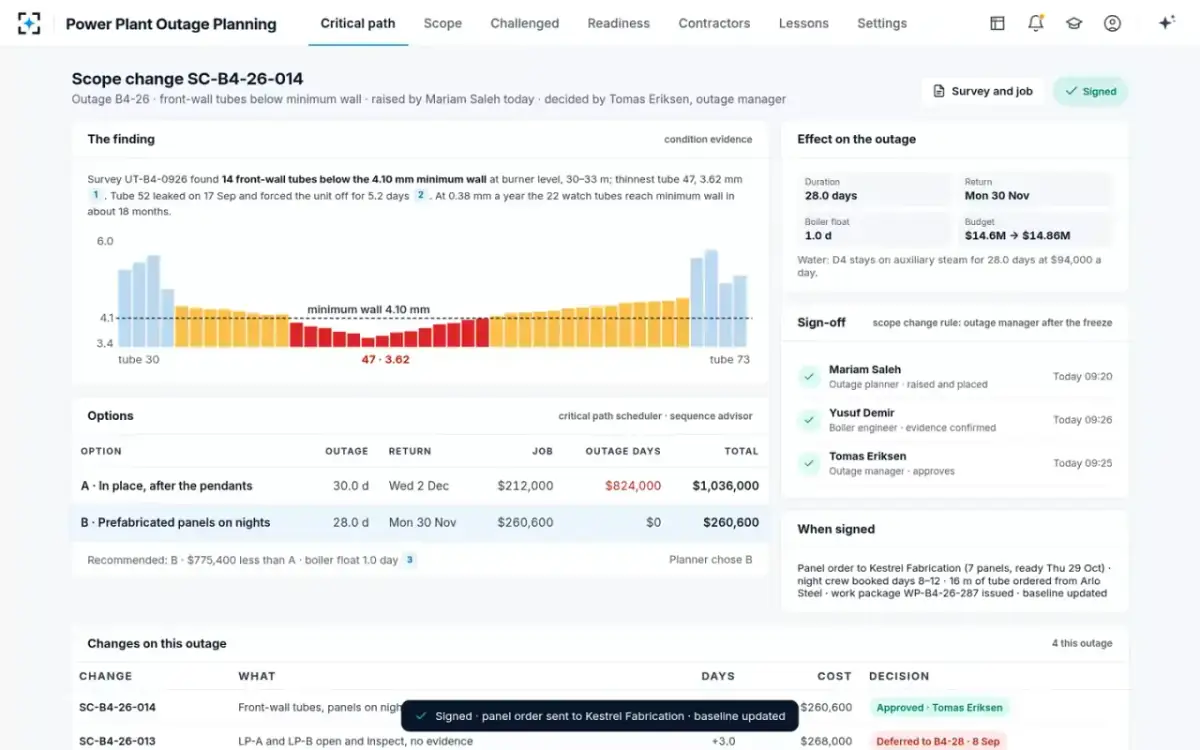

Outage managerThe change goes to the outage manager with the finding, both options and their effect. Option A, tubes replaced in place after the superheater repairs: 30.0 days and $1,036,000 with the outage days. Option B, panels on nights: 28.0 days and $260,600. The planner raised and placed it, and the boiler engineer confirmed the evidence. The outage manager signs. The panel order goes to the fabricator and the approved schedule is updated.
When signed: panel order to the fabricator (7 panels, ready before breaker open). Then: night crew booked days 8 to 12 · work package issued · baseline updated.
- 09Day 5 clash

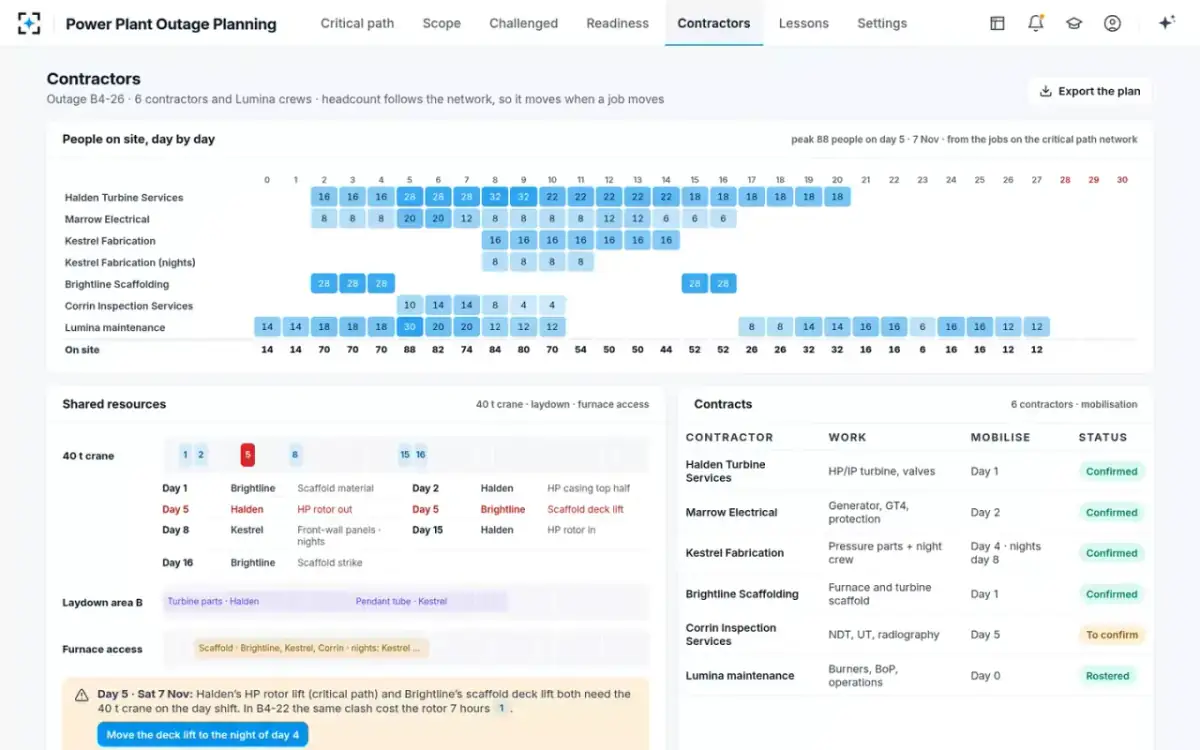

One 40 t crane, two lifts on the same shift
Contracts and procurementThe number of people on site follows the schedule. It peaks at 88 on day 5. On that day two lifts need the 40 t crane on the same day shift. One is the turbine contractor's rotor lift, which is on the critical path. The other is the scaffolders' deck lift. In an earlier outage the same clash cost the rotor 7 hours. The fix is one button: move the deck lift to the night of day 4.
Readiness tracker: it finds the clash and does not book a contractor. Procurement moves the lift.

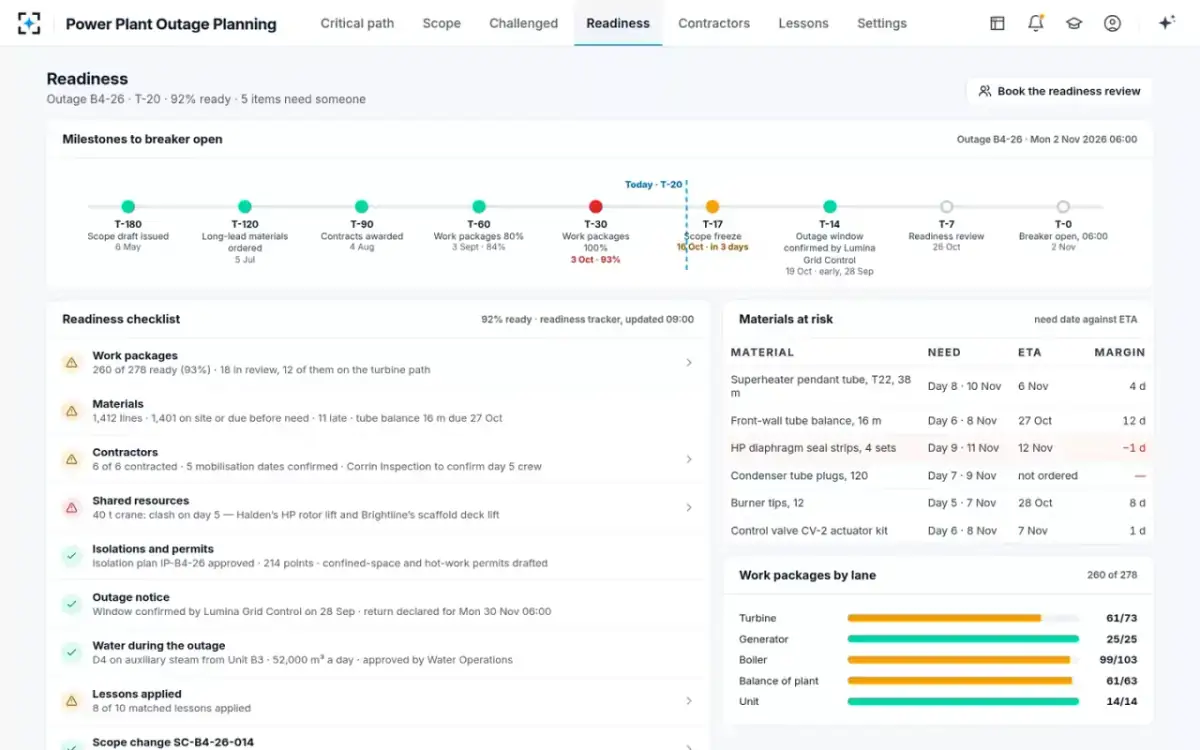

- 10T-20 · ready?
What still needs someone before the outage starts
Readiness trackerA timeline runs from 180 days out to the day the unit comes off the grid. The work-package milestone, due 30 days out, was missed at 93 %. The checklist covers work packages, materials, contractors, the crane, isolations and permits, the outage notice and the steam plan. Materials at risk are listed by the date they are needed, against when they arrive. The turbine seal strips arrive a day after they are needed, and the condenser tube plugs are not yet ordered.
“Host plant on auxiliary steam from a sister unit · approved by the host plant's operations”
