SystemPower Generation & Water Production

Desalination Plant Performance Monitoring

Desalination plant performance monitoring that predicts membrane fouling and staggers every clean against the city's demand

See one case, screen by screen ↓
Watch with transcript →

Built forProcess engineersWater production managersShift supervisorsMaintenance plannersPlant chemists

The Problem Today

Membrane trains are cleaned by the calendar, so some are cleaned too early and others too late.

45–60%
of a reverse-osmosis plant's operating cost is energy published
15–40%
of a membrane plant's productivity can be lost to fouling published

Pasted into a spreadsheet by hand

  • Pressure
  • Flow
  • Lab tests
  • Past cleans
  • Two cleans, one hot dayTwo trains out at once can drop output below demand
  • Membranes replaced by ageBought new while they still clean well

The Solution

  1. Each train normalizedReadings corrected overnight to each train's clean baseline
  2. The cleaning day forecastEach train's fouling rate projected to the day it hits its trigger
  3. Fouling named, clean chosenFouling types ranked from the readings, lab results and past cleans
  4. The manager signs the planCleans staggered against demand, one train out at a time on a peak day

Built-in controls

  • Each forecast cites its readings
  • Each booking signed by the process engineer
  • Hands off the control system

What You Get

Fewer wasted cleans and less energy lost to fouling, with each day of the cleaning plan above demand.

$0.9M
a year in energy and cleaning, for one 200,000 m³/day plant our estimate
  • Drift seen the next morningInstead of days later, from a weekly spreadsheet
  • The clean matched to the foulingAn acid-only clean on a biofilm recovers less flow
  • Engineer hours backour estimate22 → 4 hours a week, looking after eight trains
In short

What is Desalination Plant Performance Monitoring?

Desalination plant performance monitoring is software that tracks how each reverse-osmosis train in a desalination plant is performing (normalized flow, pressure drop, salt passage and energy per cubic meter) and tells you when each needs cleaning. Desalination Plant Performance Monitoring adds six agents that normalize the data, forecast fouling, name its type, stagger the cleans against demand and plan membrane replacement. The process engineer books each clean and the water production manager signs the plan.

How to choose AI solutions for utilities →

Updated

The problem

A desalination plant cleaning calendar that is wrong in both directions

A seawater reverse-osmosis (RO) plant's historian logs feed, concentrate and permeate pressure, flow, conductivity and temperature for each train, each minute. To see real fouling, a process engineer pastes those readings into a normalization spreadsheet (the ASTM D4516 method, with its temperature correction factor and net driving pressure) once a day or once a week. Most plants still clean on a fixed calendar and look at the cleaning trigger only when something is already wrong.

So the calendar is wrong both ways. At the sample plant, Train 7 was cleaned at +2.4 % pressure drop, before it needed it; Train 3 will cross its trigger 14 days before its calendar date. Cleans also collide: on the calendar, Train 3 and Train 5 both land on the hottest day of a heatwave, and two trains out leaves 162,500 m³ against a demand of 172,400 m³. Membranes are replaced by age, without regard to how well they recover after each clean.

typical45–60%of an RO plant's operating cost is energy
typical15–40%of a plant's productivity can be lost to membrane fouling
typical12–15a yearunplanned shutdowns a year, at the upper end, reported at some seawater RO plants
A process engineer's week on membrane performance, in hoursestimated
By hand22 hours
With the solution4 hours
  • Pasting historian readings into the normalization spreadsheet6 → 0.5 h
  • Checking each train against its cleaning triggers3 → 0.5 h
  • Working out the fouling type from lab results and past cleans4 → 1 h
  • Fitting cleans around demand and the other trains' bookings3 → 0.5 h
  • Energy per cubic meter and the monthly performance report4 → 1 h
  • The membrane replacement case for the capital plan2 → 0.5 h

Estimated split for one engineer looking after eight RO trains, in hours a week, by hand and with the solution.

How it works

Overnight readings to a signed plan, in desalination plant monitoring

What comes in
Plant data in4 sources · historian, feed-water lab, clean records, energy meters
Agents at work
Data normaliserevery 15 min
Then
Fouling forecaster
Fouling diagnostician
Energy tracker
Then
Clean scheduleragainst demand
Then
Membrane plannerreplace on evidence
A person decides
Process engineerbooks the clean; the manager signs the plan
What comes out
Forecast per train
Staggered cleaning plan
Membrane plan
One case, step by step

Desalination plant performance monitoring of one fouling train, run to plan

A seawater RO plant runs 8 trains of 25,000 m³/day each. It is a Tuesday. An algal bloom reached the intake earlier in the month, and demand rises to 172,400 m³ on a Thursday nine days away, in a heatwave. Here is what happens next, screen by screen, in the working solution.

A worked example on sample data. Names, IDs and figures on the screens and in this section come from the demo.

  1. 0105:30

    The overnight run normalizes each train

    Data normaliser

    Before the day shift, the data normaliser corrects 11,520 readings across the 8 trains to each train's post-clean baseline. Two conductivity readings on Train 6 look wrong; they are marked suspect and left out of the calculation, and the readings themselves are kept. Yesterday's view still has Train 3 on Watch at +9.6 % differential pressure.

    “8 trains · 11,520 readings normalized to their post-clean baselines; 2 suspect conductivity readings on Train 6 marked, not used”

  2. 0205:42

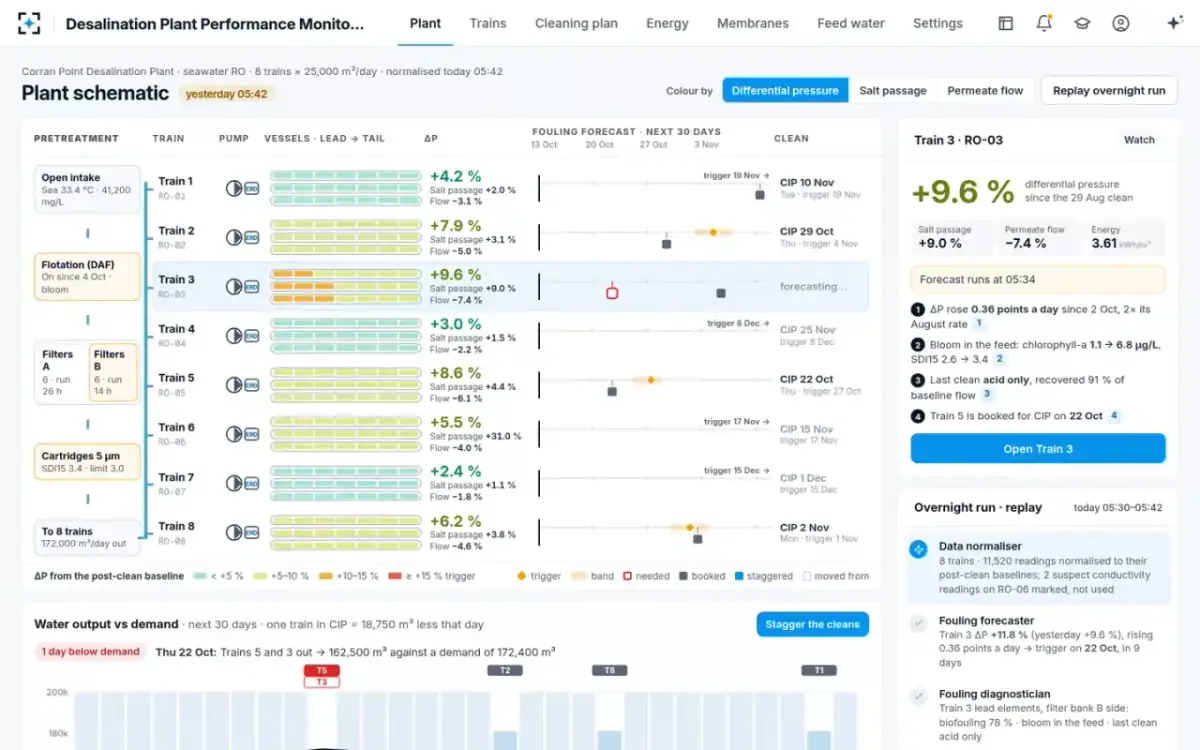

    Train 3 turns amber, and its clean falls on Train 5's day

    Process engineer

    The process engineer opens the plant schematic: intake, flotation, filter banks A and B, cartridges and the 8 trains, each vessel grid colored by drift. Train 3 is at +11.8 % pressure drop since its last clean, rising 0.36 points a day, twice its rate the month before. The fouling forecaster puts its trigger on the peak Thursday, in 9 days, with a band of two days either side, while its calendar clean is 14 days after that. The output band under the trains shows one day below demand.

    “Peak Thursday: Trains 5 and 3 out → 162,500 m³ against a demand of 172,400 m³”

  3. 03One click

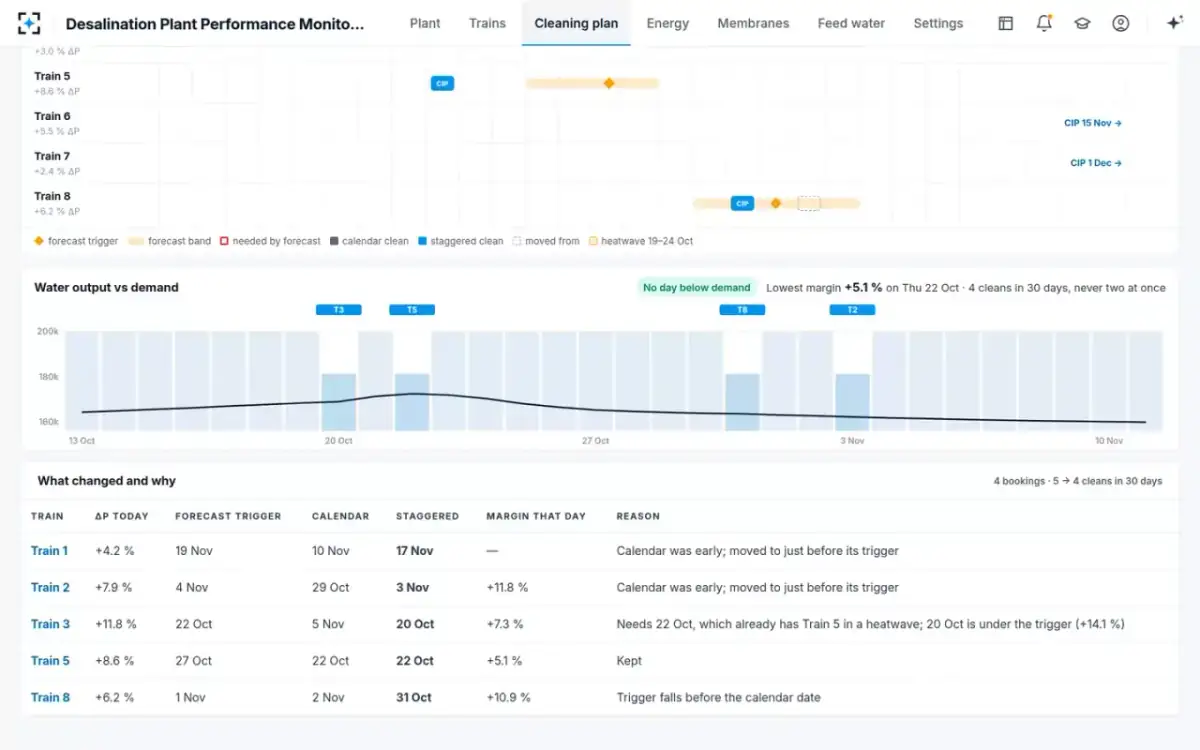

    Stagger the cleans

    Clean scheduler

    The clean scheduler reads the demand forecast and tries the options in order. Moving Train 5 earlier is rejected: it is at +8.6 %, and cleaning it 7 days before its forecast wastes a clean. Moving Train 3 two days earlier, to the Tuesday, works: forecast pressure drop on the day +14.1 %, still under the trigger, with 181,250 m³ available against 168,900 m³ (+7.3 %). Trains 8, 2 and 1 are matched to their own forecasts, and the CIP skid and crew are free.

    “No day below demand · lowest margin +5.1 % on the peak Thursday · 4 bookings changed → the water production manager approves”

  4. 04The diagnosis

    Biofouling in the lead elements, fed from filter bank B

    Fouling diagnostician

    In Train 3, the rise sits in rows E–H, fed first from filter bank B, and in the lead elements, where a biofilm starts. The diagnostician ranks biofouling at 78 %, particulate at 15 %, scaling at 4 % and organic at 3 %, each with the evidence for and against. Chlorophyll-a is 6.8 µg/L and TOC is up since the bloom arrived; against it, salt passage is rising slower than a pure biofilm usually gives.

    Against scaling: “Tail elements normal; antiscalant dosing in range; LSI −0.4 in the concentrate”

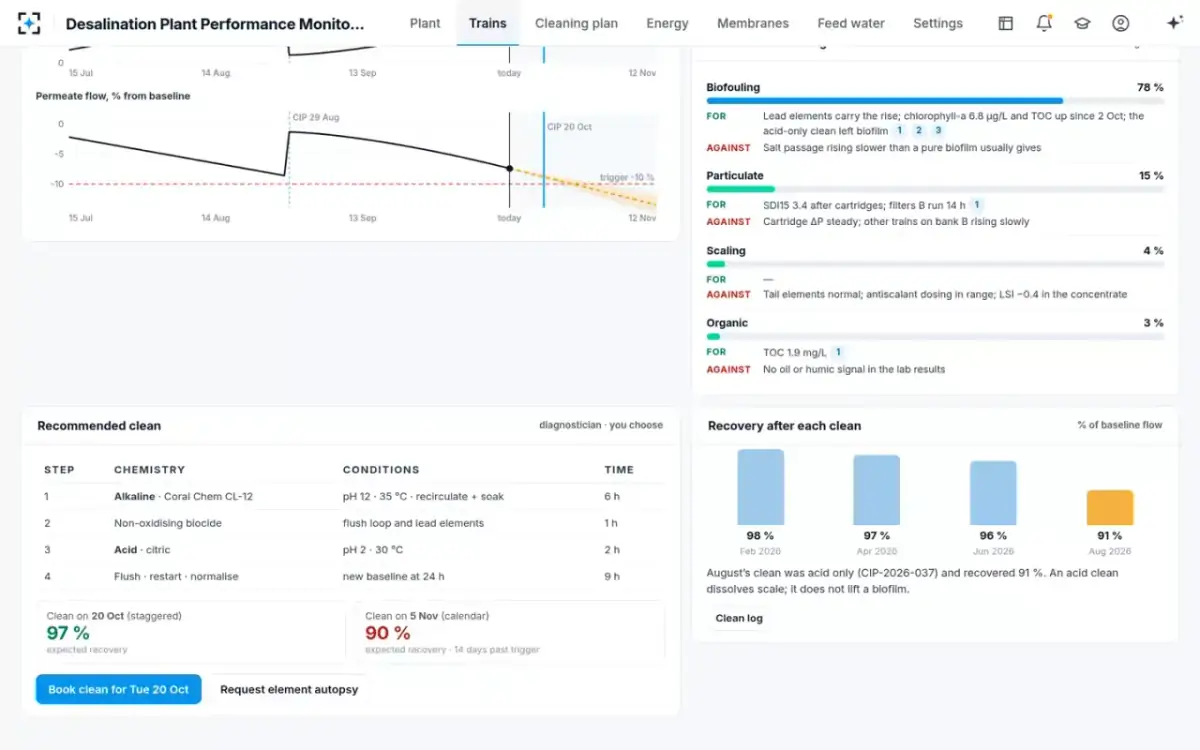

  5. 05The chemistry

    Alkaline first, because the last clean was acid only

    Fouling diagnostician

    The last clean was acid only and recovered 91 % of baseline flow; earlier cleans recovered 96–98 %. The recommended clean is an alkaline cleaner at pH 12 and 35 °C for 6 hours, a non-oxidizing biocide, then citric acid at pH 2, then flush and a new baseline at 24 hours. Cleaning two days early is expected to recover 97 %; waiting for the calendar date, 90 %.

    “An acid clean dissolves scale; it does not lift a biofilm.” The diagnostician recommends; the process engineer chooses.

  6. 06Booked

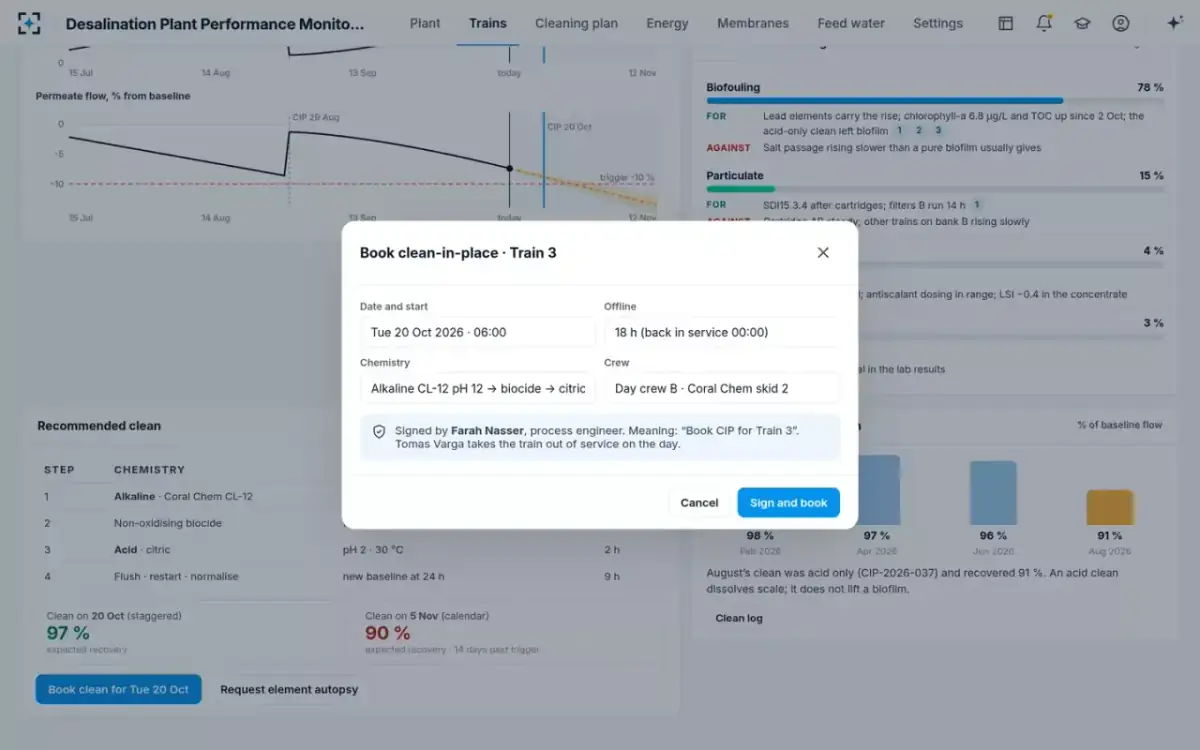

    The process engineer signs the booking for 06:00

    Process engineer

    The process engineer books the clean-in-place (CIP) for the Tuesday at 06:00: 18 hours offline, back in service at midnight, with day crew B and CIP skid 2. The signature records its meaning, and the shift supervisor takes the train out of service on the day. The maintenance planner is notified to have the crew and chemicals ready.

    “Signed by the process engineer. Meaning: “Book CIP for Train 3”.”

  7. 07The plan

    Each move in the plan, with its reason

    Clean scheduler

    The second version of the cleaning plan covers the next 30 days: 4 bookings changed, and 5 cleans down to 4. Train 1 moves a week later and Train 2 five days later, because the calendar was early. Train 8 comes forward two days, because its trigger falls before the calendar date. Train 5 stays on the peak Thursday.

    Train 3: “Needs the peak Thursday, which already has Train 5 in a heatwave; two days earlier is under the trigger (+14.1 %)”

  8. 08Signed · 09:40

    The manager signs a plan with one train in CIP at a time

    Water production manager

    The process engineer sends the plan to the water production manager with each change and its reason. The lowest margin in the 30 days is +5.1 % on the peak Thursday, 181,250 m³ against 172,400 m³, and there is no day below demand. The manager approves at 09:40, signing approve cleaning plan for the next 30 days, and the crew request goes to the maintenance planner.

    A plan with any day under +5 % margin needs the water production manager.

  9. 09Same data

    Membranes replaced on evidence instead of age

    Membrane planner

    Replacing by age would buy new membranes for Trains 1, 2 and 6 next year, $2.23M. Train 6 has to go early next year (salt passage +31 % and recovery down to 89 %) at $742,560 for 952 elements. Trains 1 and 2 still recover 97–98 % after each clean with salt passage at +2–3 %, so the planner moves them a year later: $1.49M deferred.

    “This supports the case to defer; it is not an order.”

Who it’s for

Five desalination plant roles around one fouling train

The same fouling train, seen by the five roles who run the plant: what their month looked like, and what it looks like now.

Process engineer
Books each clean
Before
Owns membrane performance for 8 trains: normalizes the data in a spreadsheet, plans the cleans and writes the monthly performance report.
Now
Opens each morning on trains already normalized and forecast, with the fouling type and the chemistry, and cleans Train 3 because it needs it, whatever the calendar says.
Water production manager
Approves the cleaning plan and membrane spend
Before
Answers for water delivered, energy per cubic meter and the membrane budget, and wants the margin for each day of the plan before signing it.
Now
Signs a plan that shows the output against demand for each day, the lowest margin and the reason for each move.
Shift supervisor
Takes trains out of service
Before
Runs the plant to the demand set-point, takes trains out for CIP and watches the tank levels, and does not want two trains in CIP in a heatwave.
Now
Sees one train in CIP at a time in the plan, and the output band that shows what each clean takes out of the day.
Maintenance planner
Books CIP crews, chemicals and membranes
Before
Books CIP crews, chemicals and the membrane replacement program, and needs the clean dates a week ahead to have the skid ready.
Now
Gets the crew and chemicals request as soon as a clean is booked and the plan is signed: the date, the hours offline and the skid.
Plant chemist
Runs the feed-water lab and CIP chemistry
Before
Runs the feed-water lab (SDI, chlorophyll, TOC) and the CIP chemistry, and knows the lead elements are the first to feel a bloom.
Now
Sees the lab results tied to the trains the bloom reaches first, and raises the bloom response from the same screen.
The agents

Normalizing, forecasting and scheduling agents for plant performance

Overnight, six agents normalize each train’s readings, forecast and name its fouling and stagger the cleans; the process engineer books each clean and the manager signs.

Data normaliser

Every 15 minutes, normalizes each train's permeate flow, differential pressure and salt passage to its post-clean baseline with the ASTM D4516 method (temperature correction factor and net driving pressure), and flags suspect sensors.

  • Read-only access to the historian: never edits historian data
  • Suspect readings are marked, never deleted
  • Each value keeps its source tag
Fouling forecaster

Fits each train's fouling rate since its last clean from 90 days of normalized data, weighting the last 10 days, and forecasts the day it crosses each cleaning trigger, with a confidence band.

  • Forecasts only: never books or moves a clean
  • Shows the band as well as the date
Fouling diagnostician

Compares lead and tail elements, salt passage and pressure-drop patterns, feed-water lab results and the last cleans; ranks biofouling, particulate, scaling, organic fouling and aging; and recommends the clean chemistry.

  • Never changes dosing or chemistry: the process engineer chooses
  • Shows evidence against as well as for
  • Stays within the membrane maker's pH and temperature limits
Clean scheduler

Places each clean before its forecast trigger and staggers the cleans against the demand forecast, the trains-in-CIP limit and crew availability, moving the train closest to its trigger by the fewest days and explaining each move.

  • Proposes; the process engineer books and the water production manager approves
  • Never takes a train out of service
Energy tracker

Computes kWh/m³ for each train and the plant every day from the energy meters and permeate flow, and prices the energy above each train's clean baseline at the tariff.

  • Reads meters only
Membrane planner

Builds the five-year membrane replacement plan from recovery after each clean, salt passage and age, compares it with replace-by-age and drafts the capital request.

  • Drafts only: never orders membranes
  • Says “supports the case to defer”, never “approved”
Process engineer

Books each clean; the manager approves the plan.

Ask in plain words

Plain questions on a train's fouling, a clean's chemistry or energy cost

Ask about any train, clean, energy or membrane, or say what to change. Each answer points to its readings. These answers use the sample data.

Why is Train 3 fouling faster than the others?

Biofouling, started by the bloom and helped by the last clean. Its pressure drop has risen 0.36 points a day since the bloom arrived. Chlorophyll-a at the intake went from 1.1 to 6.8 µg/L and filters B are backwashing every 14 h; Train 3's rise sits in rows E–H, fed first from filters B. Its last clean was acid only and recovered 91 %, and acid does not lift a biofilm.

Can we clean Train 3 and Train 5 in the same week?

Yes, on different days. Both on the peak Thursday would leave 162,500 m³ against a demand of 172,400 m³. Train 3 two days earlier is still under its trigger (+14.1 % forecast) and leaves 181,250 m³ against 168,900 m³; Train 5 stays on the Thursday.

What is fouling costing us in energy this month?

About $27,100: 361 MWh above what the trains would use if they were all clean (12,040 kWh a day at $0.075). Train 3 is 39 % of it at 3.61 kWh/m³ against its 3.39 baseline. Cleaning it before its trigger, instead of on its calendar date, avoids about 72 MWh.

Which trains can wait for new membranes?

Trains 1 and 2 can wait a year. Replacing by age would buy them next year, but both still recover 97–98 % after each clean and their salt passage is only +2–3 %. Train 6 cannot: recovery has fallen 95 → 89 % over four cleans and salt passage is +31 %. That moves $1.49M out of next year's budget.

The screens

The plant schematic, a train's fouling, the cleaning plan and membranes

From the working solution, on its sample data. Pick one to see it large.

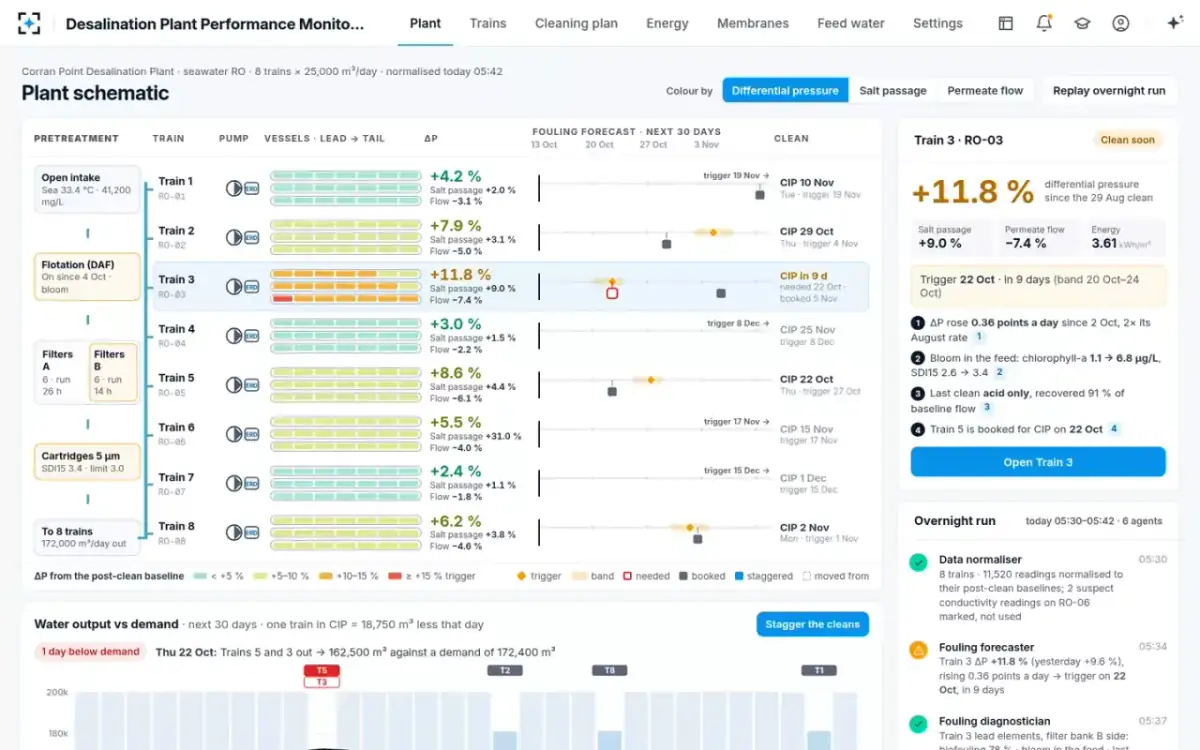

The plant schematicIntake, pretreatment and 8 RO trains, each vessel grid colored by pressure-drop drift, with its fouling forecast and the 30-day output against demand.
The overnight runThe six agents' 05:30 run replayed: readings normalized, suspect sensors marked, Train 3 still on Watch at yesterday's +9.6 %.

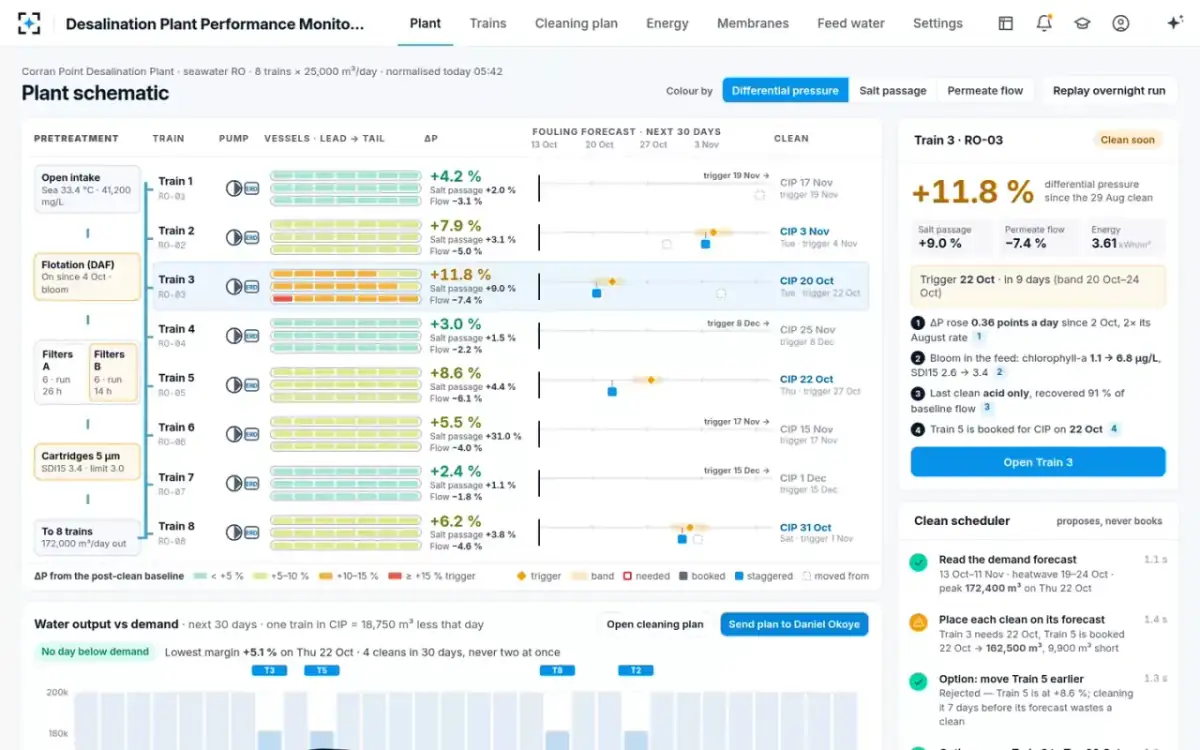

Stagger the cleansThe clean scheduler's options, step by step, and the output band with no day below demand.

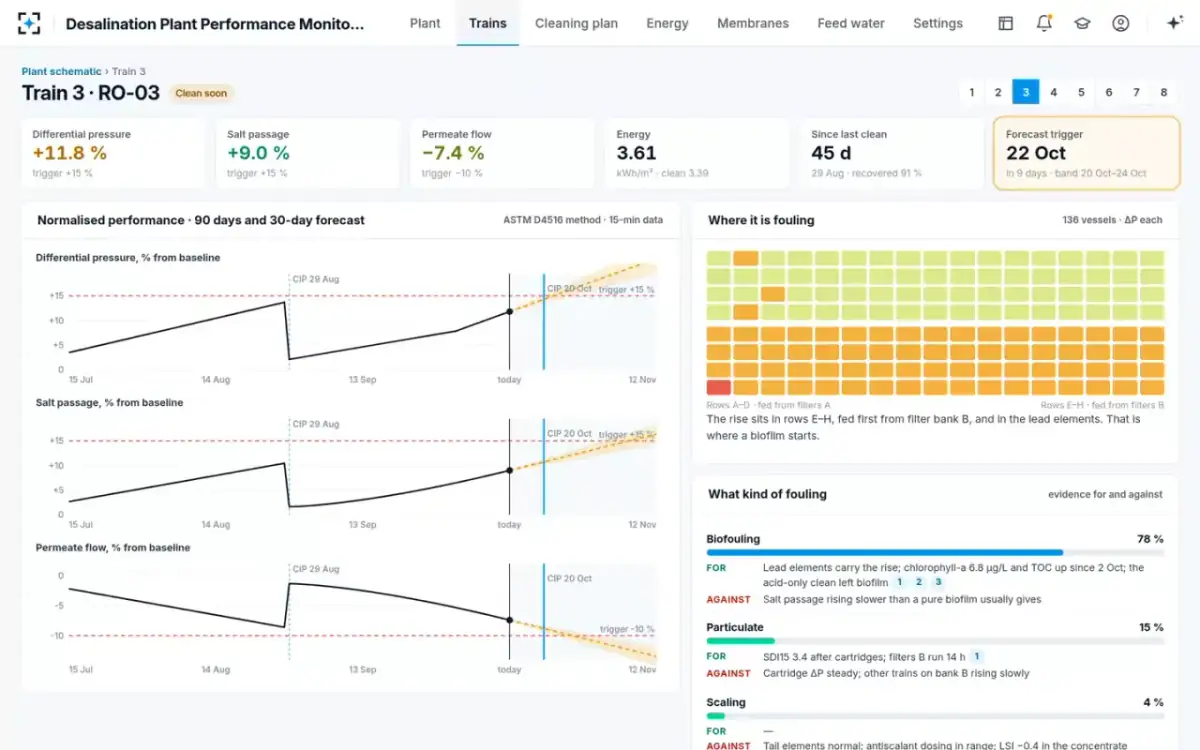

One trainNormalized pressure drop, salt passage and flow over 90 days with the forecast, the vessel heat map, and each fouling type for and against.
The recommended cleanThe CIP sequence and conditions, expected recovery now against the calendar date, and recovery after each past clean.
Book the cleanDate, hours offline, chemistry and crew, signed by the process engineer with the meaning recorded.
The cleaning planOutput against demand for 30 days and each booking moved, with the margin that day and the reason.

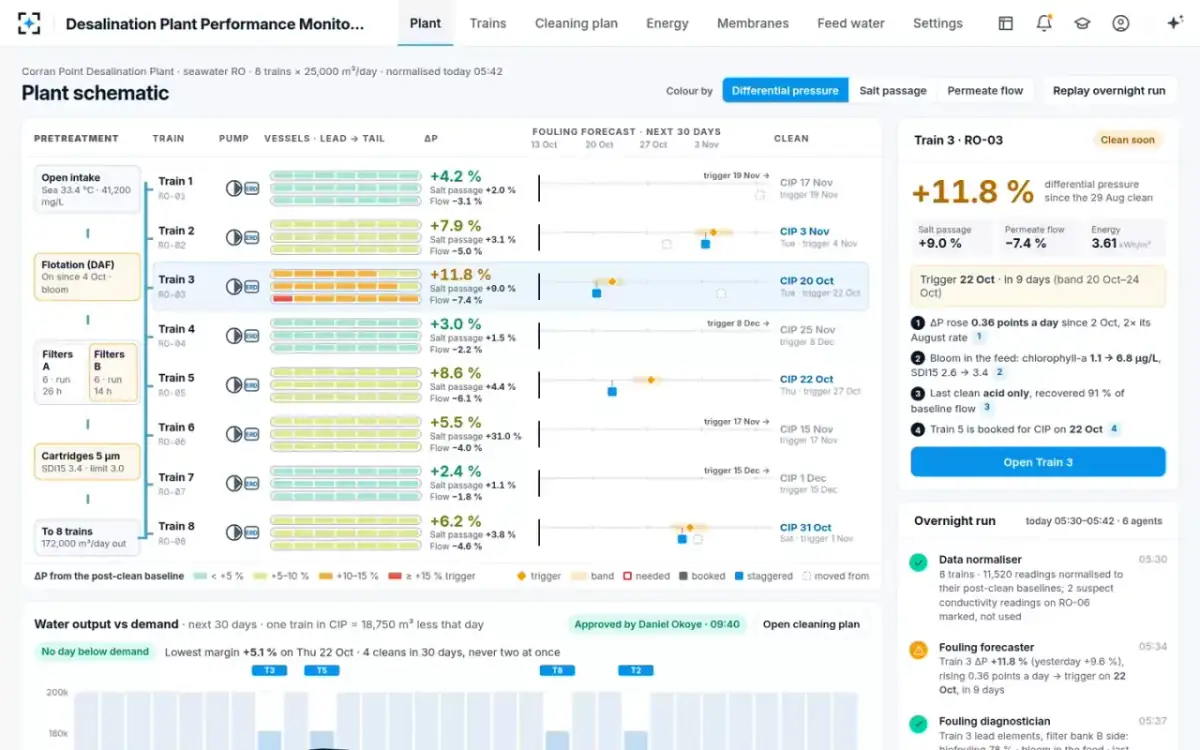

The plan, signedApproved by the water production manager at 09:40, lowest margin +5.1 %, one train in CIP at a time.

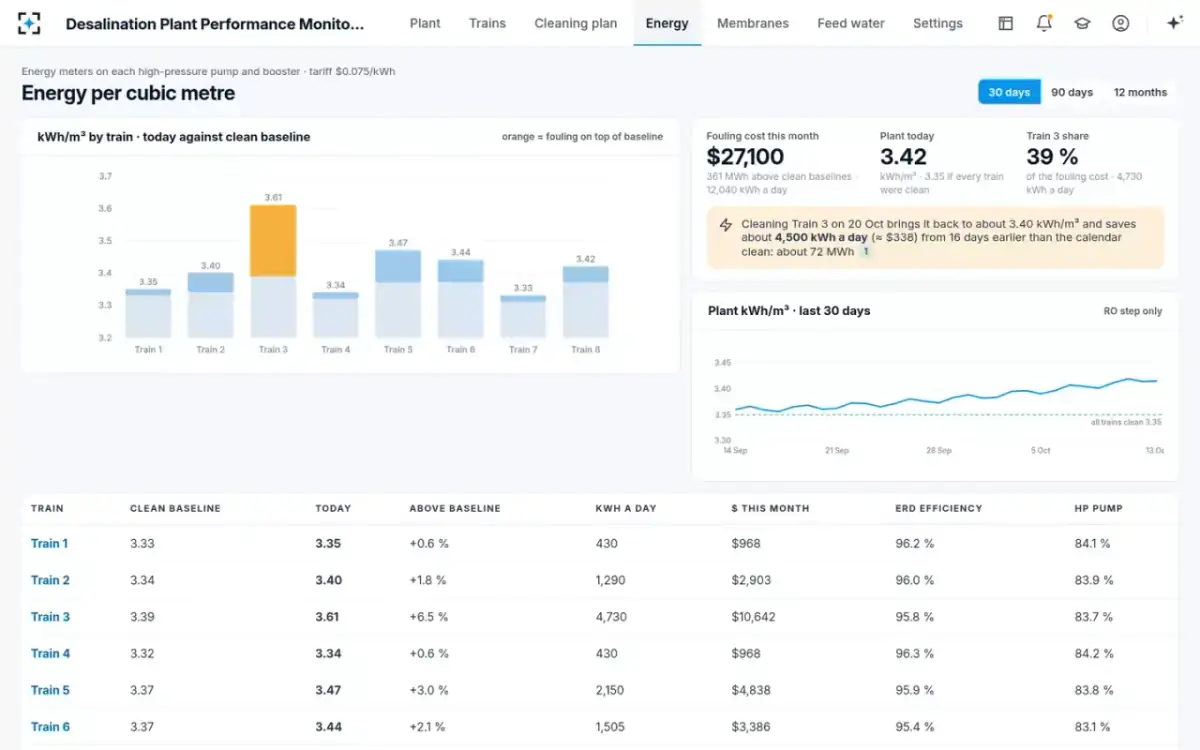

Energy per cubic meterkWh/m³ by train against its clean baseline, the fouling cost this month, and ERD and pump efficiency.

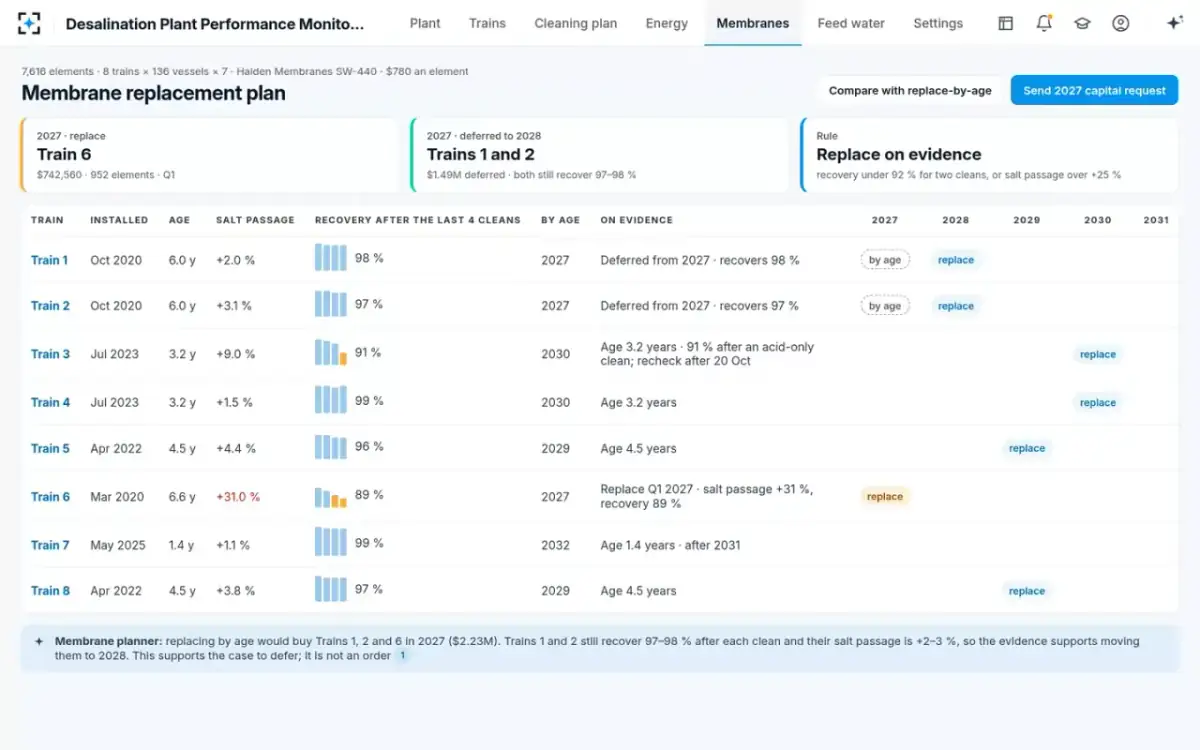

Membrane replacement planAge, salt passage and recovery after each clean for each train, replace-on-evidence against replace-by-age.

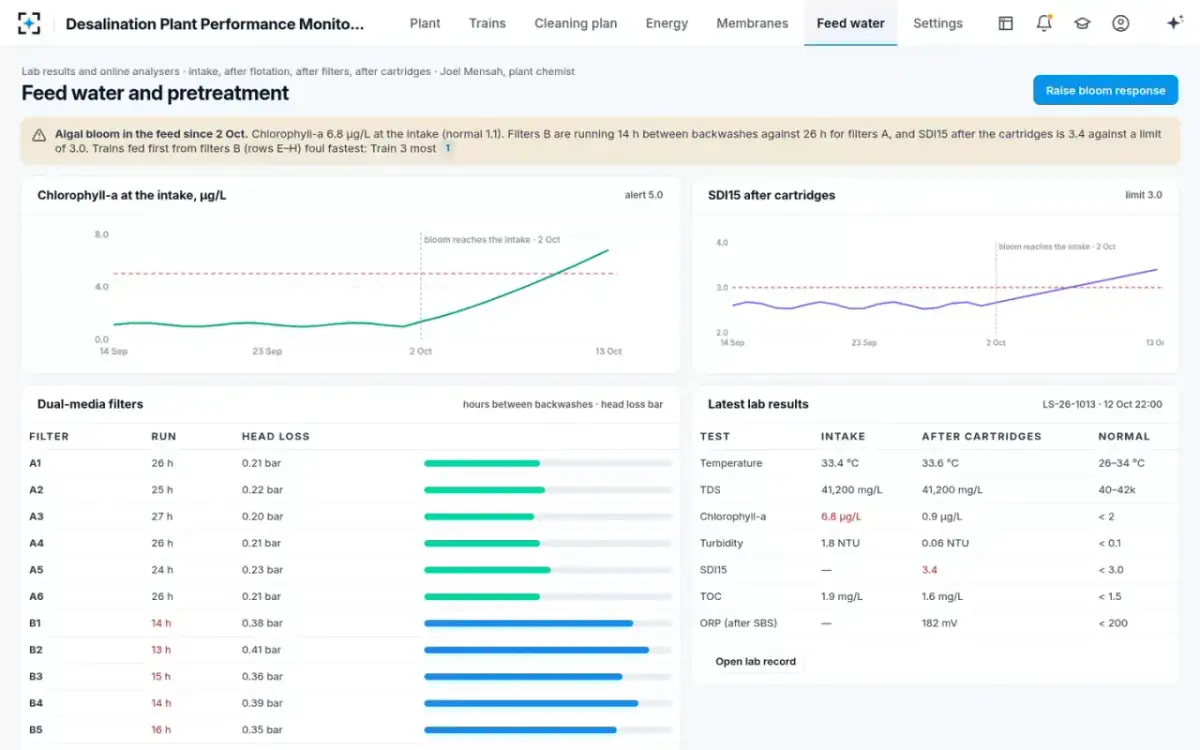

Feed water and pretreatmentThe bloom alert, chlorophyll-a and SDI15 trends, filter run times and the latest lab results.

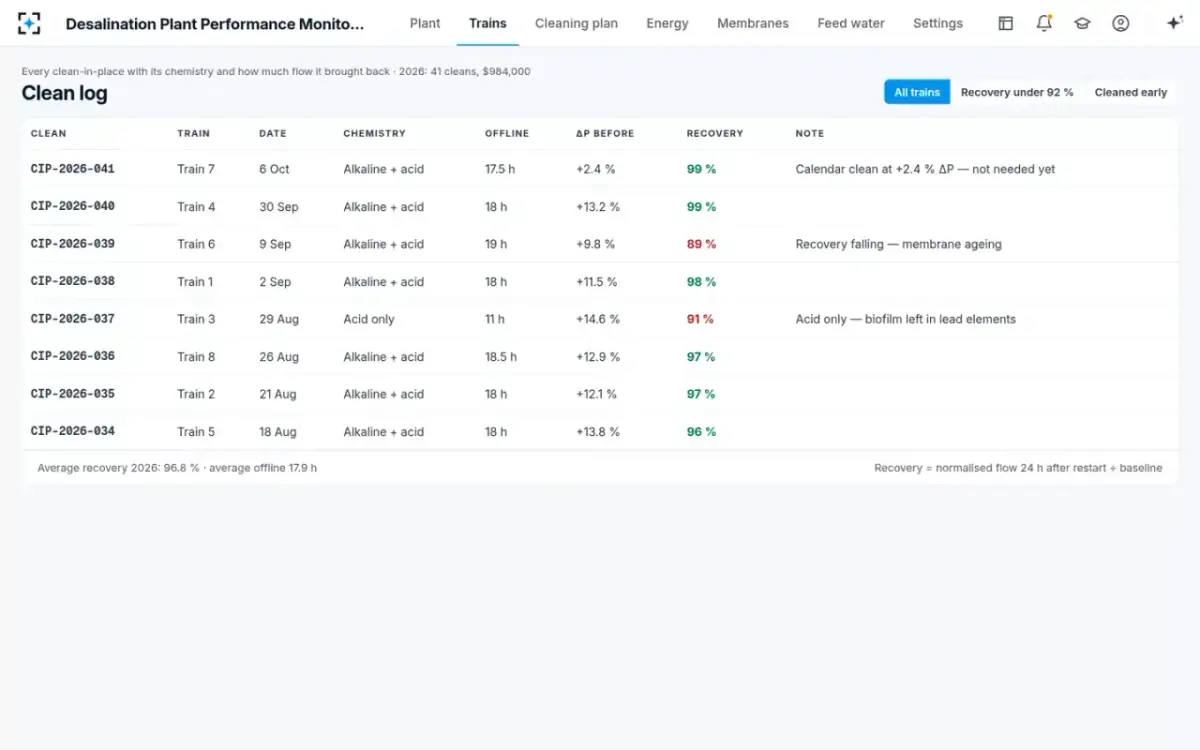

The clean logEach clean-in-place with its chemistry, hours offline, pressure drop before and recovery after.
Plant rulesCleaning triggers, the margin over demand, trains in CIP at once, costs, who decides and the agents' schedules.
Governance

Read-only plant data, signed bookings and water output protected by rule

Each forecast cites its readingsEach forecast, diagnosis and plan change points to the readings behind it: historian tags, lab sample IDs and clean records.
The process engineer books, with a signatureA clean is booked only by the process engineer, with an electronic signature that records its meaning (Book CIP for Train 3). The shift supervisor on duty takes the train out of service.
The manager signs any plan that changes bookingsA cleaning plan that changes bookings needs the water production manager's signature, recorded with its meaning (approve cleaning plan, with its dates). The membrane capital request is the manager's decision too.
Hands off the control systemThe agents read historian, lab and meter data. They do not write to the control system, change set-points or dosing, or order membranes. Plant data stays with the utility.
Water output protected by ruleNo more than one train in CIP above 150,000 m³/day demand, and available output above demand plus the minimum margin for each day of the plan. The scheduler cannot break these rules.
Each step on the activity trailEach agent run, booking, plan change and signature is recorded with who and when, from the normaliser's 05:30 run to the manager's approval at 09:40. Settings changes are recorded and apply from the next run.
Configuration

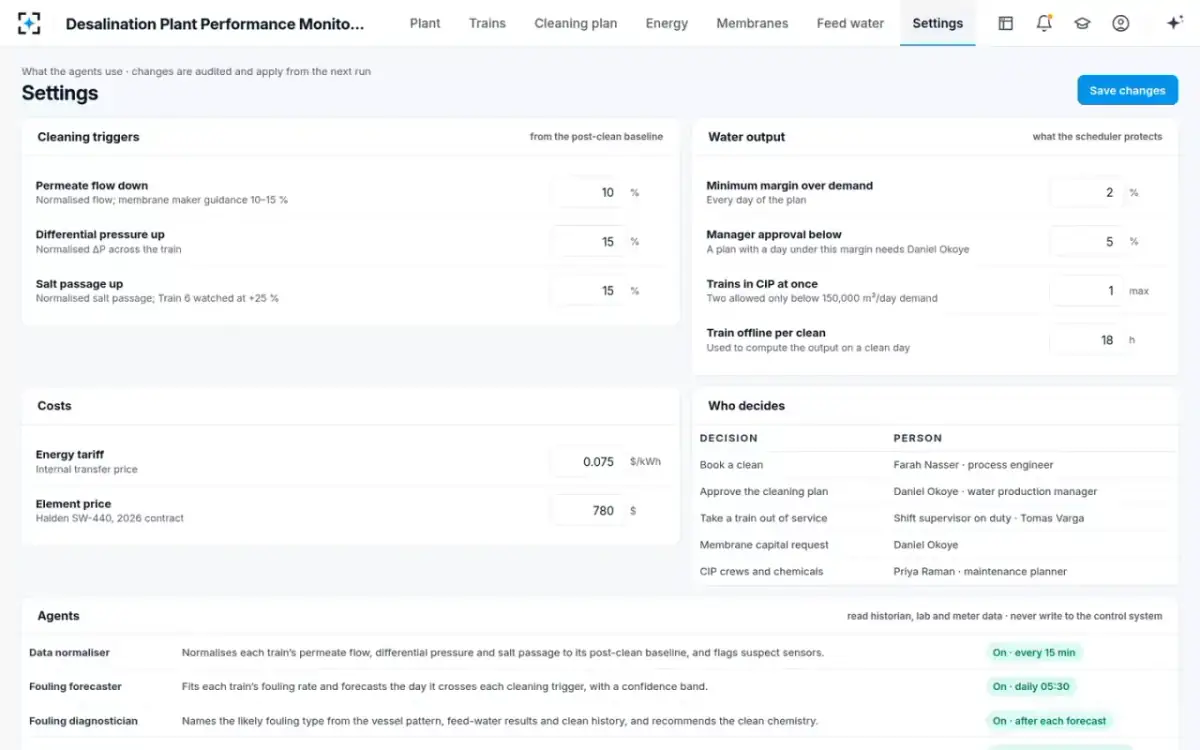

Cleaning triggers, output margins and membrane costs the plant sets

The cleaning triggers, the output the scheduler protects, the costs and who decides are settings, chosen by the plant.

SettingDefaultChoose from
Permeate flow down10 %Normalized flow; membrane maker guidance 10–15 %
Differential pressure up15 %Normalized ΔP across the train
Salt passage up15 %Normalized salt passage; Train 6 watched at +25 %
Minimum margin over demand2 %Every day of the plan — what the scheduler protects
Manager approval below5 %A plan with a day under this margin needs the water production manager
Trains in CIP at once1Two allowed only below 150,000 m³/day demand
Train offline per clean18 hUsed to compute the output on a clean day
Energy tariff and element price$0.075/kWh · $780Internal transfer price · membrane element contract price
Connections

Historian, lab, CIP records, energy meters and the demand forecast

Plant historianfeed, concentrate and permeate pressure, flow, conductivity and temperature for each train
Feed-water lab and online analysersSDI15, chlorophyll-a, TOC, turbidity, ORP and filter run times, intake to cartridges
Clean-in-place recordseach clean's chemistry, hours offline and recovery after restart
Energy metershigh-pressure pumps and boosters, with ERD efficiency
Demand forecastdaily water demand for the next 30 days, heatwaves included
Maintenance systemcalendar CIP bookings in, and CIP work orders out from the cleaning plan
What it changes

Days below demand, energy cost and membrane spend at a desalination plant

Each figure carries its label: a target the solution is built to, an estimate, a typical published result, or a proven one.

target
0days
with water output below demand during a clean, the design goal of the staggered plan
0 of 30 days
below demand in the staggered plan
estimated
$0.9M
a year in energy and cleaning for one 200,000 m³/day plant
Calendar cleans52 a year
On forecast≈ 35 a year
demo
$1.49M
of membrane replacement deferred on the sample's trains that still clean well
2 of 3 trains
due by age, replacement deferred

“demo” = seen in the working solution, on its sample plant data · “estimated” = our arithmetic, inputs shown: $0.9M = 62.8M m³ a year × 3.42 kWh/m³ × $0.075 × 3 % less energy ($0.48M) + one third fewer of 52 cleans a year × $24,000 ($0.41M), sample inputs for a 200,000 m³/day plant; the hours-a-week split is also our estimate · “typical” = published figures: Water Online (2026): energy is 45–60 % of RO operating cost, fouling cuts productivity 15–40 %; Mahmoud et al., Frontiers in Membrane Science and Technology (2026): up to 12–15 unplanned shutdowns a year at some seawater RO plants, and a literature-based model, not field-validated, of 3 % less energy and 50 % fewer cleans (we use a third). Normalization method: ASTM D4516. Names on the screens are sample data.

Questions

Desalination plant performance monitoring questions from process engineers

What is desalination plant performance monitoring?

Desalination plant performance monitoring is software that tracks how each reverse-osmosis train in a desalination plant is performing (normalized flow, pressure drop, salt passage and energy per cubic meter) and tells you when each needs cleaning. Desalination Plant Performance Monitoring adds six agents that normalize the data, forecast fouling, name its type, stagger the cleans against demand and plan membrane replacement. The process engineer books each clean and the water production manager signs the plan.

How does RO membrane fouling prediction work?

The data normaliser corrects each train's readings to its post-clean baseline every 15 minutes, using the ASTM D4516 method. The fouling forecaster fits each train's fouling rate since its last clean and forecasts the day it crosses each cleaning trigger, with a confidence band. In the sample plant it put Train 3's trigger 9 days out, with a band of two days either side, 14 days before its calendar clean.

How does it decide which CIP chemistry to use?

The fouling diagnostician reads where the pressure rise sits in the train, the feed-water lab results and the clean history, and ranks biofouling, particulate, scaling, organic fouling and aging with the evidence for and against each. It recommends a sequence within the membrane maker's limits; the process engineer chooses.

Does it keep water output above demand during cleans?

That is what the clean scheduler is for. It places each clean before its trigger, keeps the number of trains in CIP within what the plant allows, and keeps output above demand plus the minimum margin for each day. In the sample plan it moved Train 3 off Train 5's day, and the lowest margin in 30 days was +5.1 %.

Does it reduce energy per cubic meter (kWh/m³)?

It shows what fouling costs in energy, train by train, so each clean is timed by its forecast rather than the calendar. The energy tracker computes kWh/m³ for each train against its clean baseline each day; at the sample plant, fouling cost $27,100 of energy this month, and cleaning Train 3 before its trigger instead of on its calendar date avoids about 72 MWh. Our estimate for a 200,000 m³/day plant is $0.9M a year in energy and cleaning.

Can we replace membranes on evidence instead of age?

Yes. The membrane planner builds a five-year plan from recovery after each clean, salt passage and age, and compares it with replace-by-age. In the sample plant it keeps Train 6 for early next year and supports the case to defer Trains 1 and 2 by a year. It drafts the capital request and does not order membranes.

Does it write to the control system or change dosing?

No. The agents read historian, lab and meter data and do not write to the control system, set-points or dosing. Only the process engineer books a clean, with a signature; the water production manager signs any plan that changes bookings; the shift supervisor takes the train out of service.

What plant data does it need to start?

The Agentic Solution Engine builds and deploys it from your requirements and documents: your historian tags, cleaning triggers, CIP records and membrane data. It goes live once each quality gate has passed. We will walk you through it on your own plant data first.

Try it on your own
RO trains and clean records.

We'll run Desalination Plant Performance Monitoring on a sample of your own historian data and clean records.
