SystemPower Generation & Water Production

Power Purchase Agreement Compliance

Power purchase agreement compliance that works out each producer's availability from plant data, using the contract's own wording

See one case, screen by screen ↓
Watch with transcript →

Built forContract managersSettlements analystsLegal teamsDispatch shift leads

The Problem Today

Each power producer reports its own availability, and the buyer checks it in spreadsheets months later.

3 weeks
to check one producer's invoice line by line, in spreadsheets our estimate

Read and retyped by hand

  • Contract
  • Amendments
  • Plant logs
  • Invoices
  • One word sets the moneyA grid event or a plant fault, decided by one clause
  • Amendments missedSettlements check clauses that an amendment changed

The Solution

  1. Each clause in one listDuties read from the contract, with each amendment applied
  2. Availability worked out againHourly reports checked against plant logs, dispatch and meters
  3. Each invoice line checkedCapacity billed before it passed its test is taken off
  4. Confirmed, reviewed, signedThe contract manager confirms, Legal reviews, the director signs

Built-in controls

  • Read-only on contracts and plant data
  • Only the contract manager changes a coding
  • Finance releases each payment

What You Get

Less is paid for capacity a plant could not deliver, and claims are ready well before the notice deadline.

  • Coding disputes foundEvents the contract reads differently from the producer
  • Dispute file readyTimeline and exhibits built before the producer replies
  • Fuel use on watchA warning before the plant's fuel use passes its limit
In short

What is Power Purchase Agreement Compliance?

It checks what a power producer is owed against what its PPA actually says. Power Purchase Agreement Compliance turns each PPA into a clause list. Each duty shows its limit, the value worked out from plant data and the penalty or bonus so far. It also checks each invoice line. The contract manager confirms, Legal reviews and the Director signs.

How to choose AI solutions for utilities →

Updated

The problem

Utilities pay power producers for availability they rarely check

A utility that buys from independent power producers, or IPPs, signs a power purchase agreement, or PPA, with each one. A PPA runs 20 to 25 years and has long schedules of definitions. The utility pays a capacity charge for keeping the plant available, plus an energy charge for what it makes. The producer reports its own availability, codes its own outages and sends a monthly invoice. The buyer checks it in spreadsheets months later, against plant logs it rarely gets in full. Some outages count against the producer: a forced outage, a planned outage that ran past its window, or capacity called on but not delivered. Which ones count turns on a few defined words, such as Grid System Event or Planned Outage Window. Those words are often changed by an amendment the settlements team never saw.

In India, the regulator and the appeals tribunal have held that capacity charges follow the availability the plant declared. That holds whether or not the buyer calls on the plant to run. So the buyer's only protection is to check each declaration against what the plant could really do. The deadlines are short too. Under the sample PPA, the buyer has 30 days after the contract year to claim a shortfall, or the claim is lost. A shortfall found late is a claim lost, and a capacity charge paid for capacity the plant could not deliver is not recovered.

typicalRs 139 to 150bna year in capacity payments to power producers in Pakistan, with “hardly any monitoring” of availability, a PIDE paper finds
Working days for one PPA's year-end settlement and monthly invoiceestimated
By hand35 days
With the solution4.7 days
  • Finding the clauses, schedules and amendments in force2 → 0.2 d
  • Getting plant logs, dispatch records and meter data5 → 0.5 d
  • Matching the hourly reports with the records6 → 0.5 d
  • Working out availability and the penalty again3 → 0.5 d
  • Checking the producer's invoice line by line15 → 2 d
  • Drafting the notice and gathering the exhibits4 → 1 d

Our estimate for one PPA's year-end settlement and that month's invoice, in working days, by hand and with the solution.

How it works

Declared availability to a signed notice, under the power purchase agreement

What comes in
Contract and plant data in5 sources · PPA, availability reports, plant logs, dispatch, invoices
Agents at work

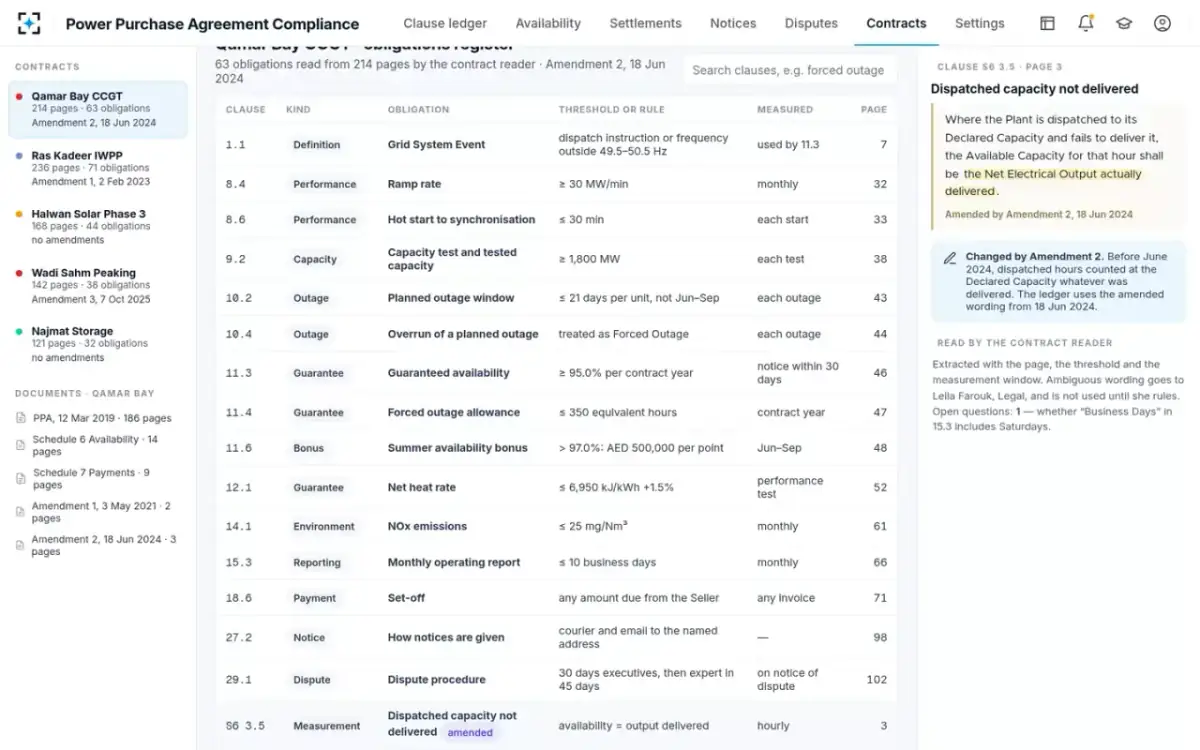

Contract readerclauses in force
Then
Plant data reconciler8,760 hours
Availability calculatorcontract wording
Then
Settlement checker
Notice drafter
Then
Dispute pack builderexhibits
A person decides
IPP contract managerconfirms, Legal reviews, Director signs
What comes out
Clause list
Settlement with deductions
Signed notice + evidence pack
One case, step by step

Power purchase agreement software on one contract year's settlement

A utility buys power from an 1,800 MW combined-cycle gas plant under a PPA changed by Amendment 2. Contract Year 4 has just ended. The plant has declared 95.3 % availability, against a 95.0 % guarantee. Here is what happens, screen by screen, in the working solution.

A worked example on sample data. Names, IDs and figures on the screens and in this section come from the demo.

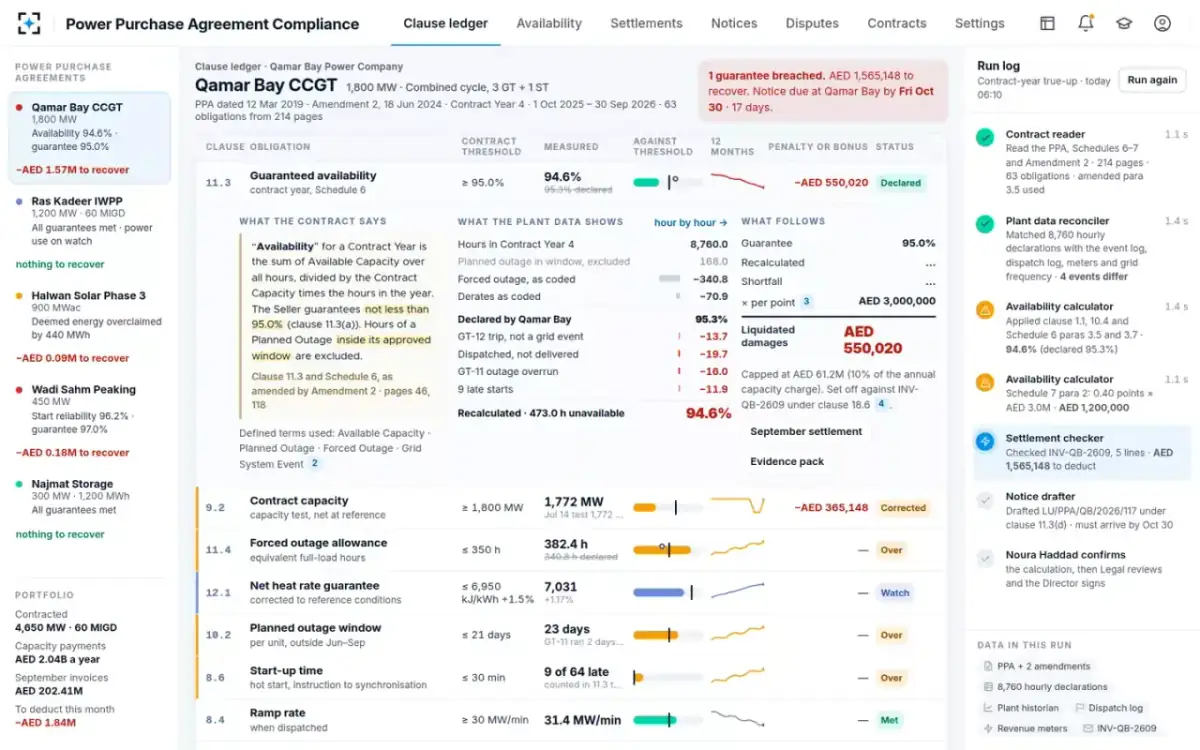

  1. 01Tuesday morning

    The clause list opens on the breach

    Contract manager

    The contract manager owns the utility's five PPAs. This plant's list holds 63 duties read from 214 pages. Each shows its contract limit, the measured value, a 12-month trend and the penalty or bonus so far. Clause 11.3 is open. It shows what the contract says, what the plant data shows and what follows.

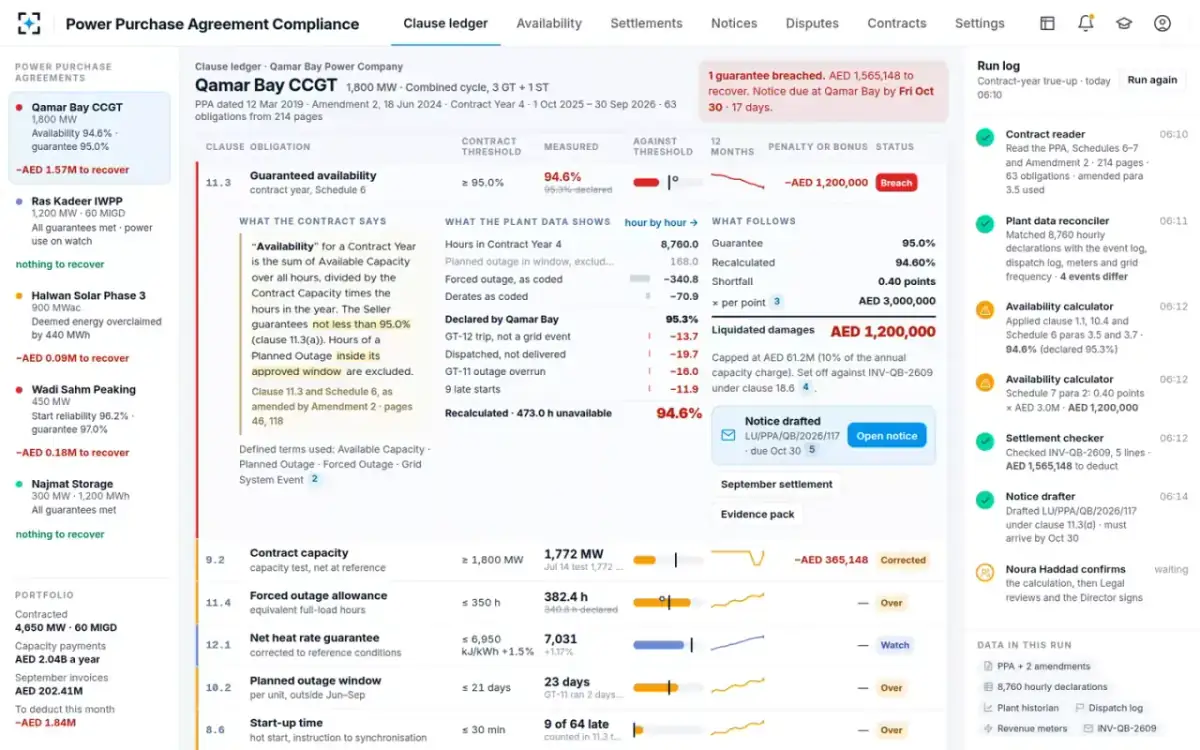

    “1 guarantee breached. $1,565,148 to recover. Notice due at the plant by the end of the month · 17 days.”

  2. 0206:10, replayed

    Worked out again from plant data, step by step

    Six agents

    The contract reader read the PPA, Schedules 6 and 7 and Amendment 2. It used Schedule 6 para 3.5 as amended. The plant data reconciler matched 8,760 hourly reports with the event log, dispatch log, meters and grid frequency. Four events differ. The availability calculator applied clauses 1.1 and 10.4 and Schedule 6 paras 3.5 and 3.7. Pressing Run again replays it. The figure falls from 95.3 % to 94.6 % and the penalty counts up.

    “Schedule 7 para 2: 0.40 points × $3.0M · $1,200,000”

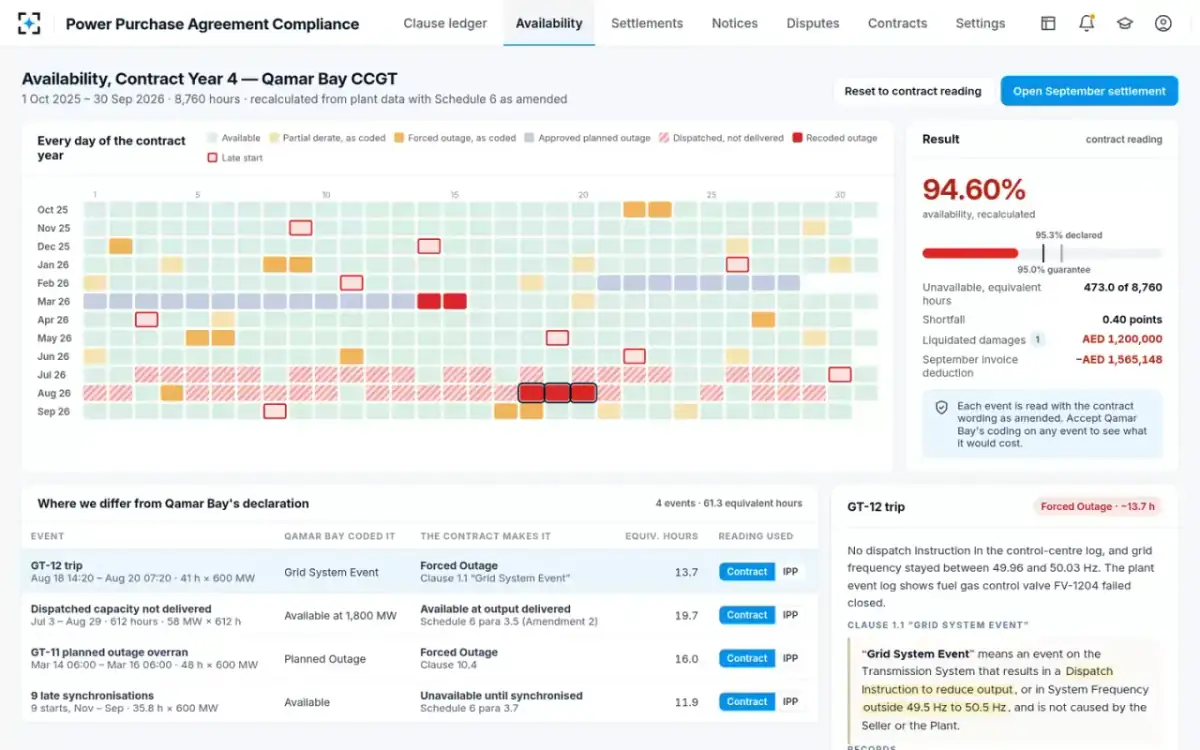

  3. 03Hour by hour

    Each day of the contract year, and four events read differently

    Plant data reconciler and availability calculator

    The availability page shows all 365 days of Contract Year 4 as a calendar. It marks available days, reduced output and faults as the plant coded them. It also shows the approved planned outage, hours dispatched but not delivered, recoded outages and late starts. Below are the four events the contract reads differently. They are a gas turbine trip, 612 hours dispatched but not delivered, an outage that ran past its window and 9 late starts. Together they add 61.3 equivalent hours.

    Result, by the contract: 94.60 % · 473.0 of 8,760 hours unavailable · shortfall 0.40 points

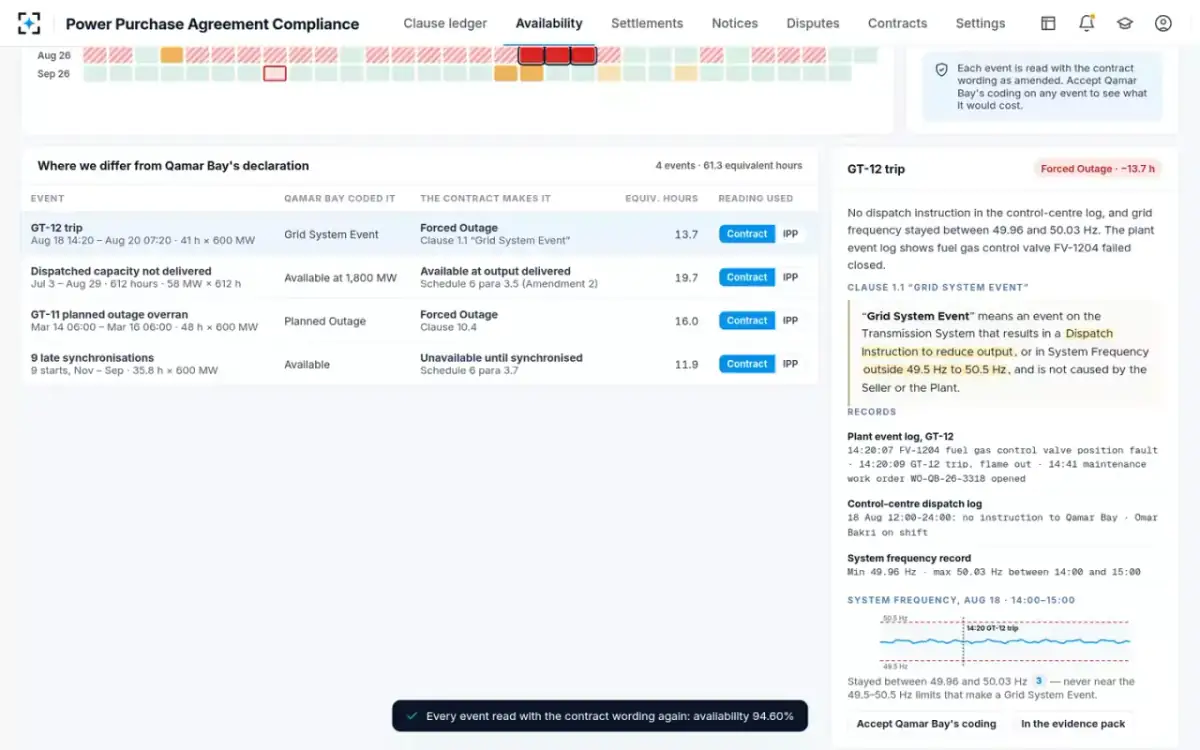

  4. 04One afternoon, 14:20

    Coded as a grid event, with no dispatch instruction behind it

    Dispatch shift lead

    The plant coded the gas turbine trip as a Grid System Event. Clause 1.1 needs one of two things for that. The grid operator must have told the plant to cut output, or the grid frequency must have left the 49.5 to 50.5 Hz range. The control center's dispatch log, kept by the dispatch shift lead, has no instruction to the plant from 12:00 to 24:00. Frequency stayed between 49.96 and 50.03 Hz. The plant's own log shows a fuel gas control valve failed closed at 14:20:07. Under the contract, it is a forced outage, a plant fault.

    Plant event log: “14:20:07 fuel gas control valve position fault · 14:20:09 gas turbine trip, flame out”

  5. 05What if

    The contract as a working calculator

    Contract manager

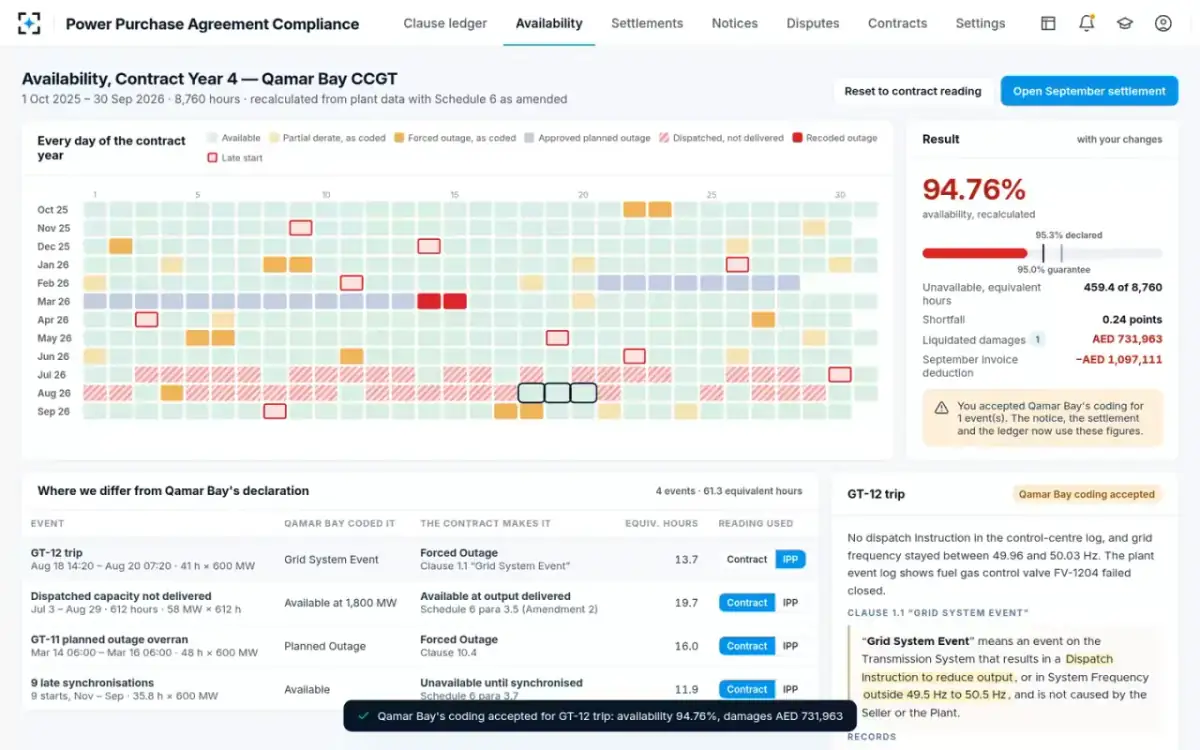

    For each disputed event, the contract manager can switch between the contract's reading and the producer's. Accepting the plant's coding of the trip alone gives 94.76 % and $731,963 of penalty. The month's deduction falls to $1,097,111. Only the contract manager may override a coding, and the reading goes back to the contract afterward.

    “Each event is read with the contract wording as amended. Accept the plant's coding on any event to see what it would cost.”

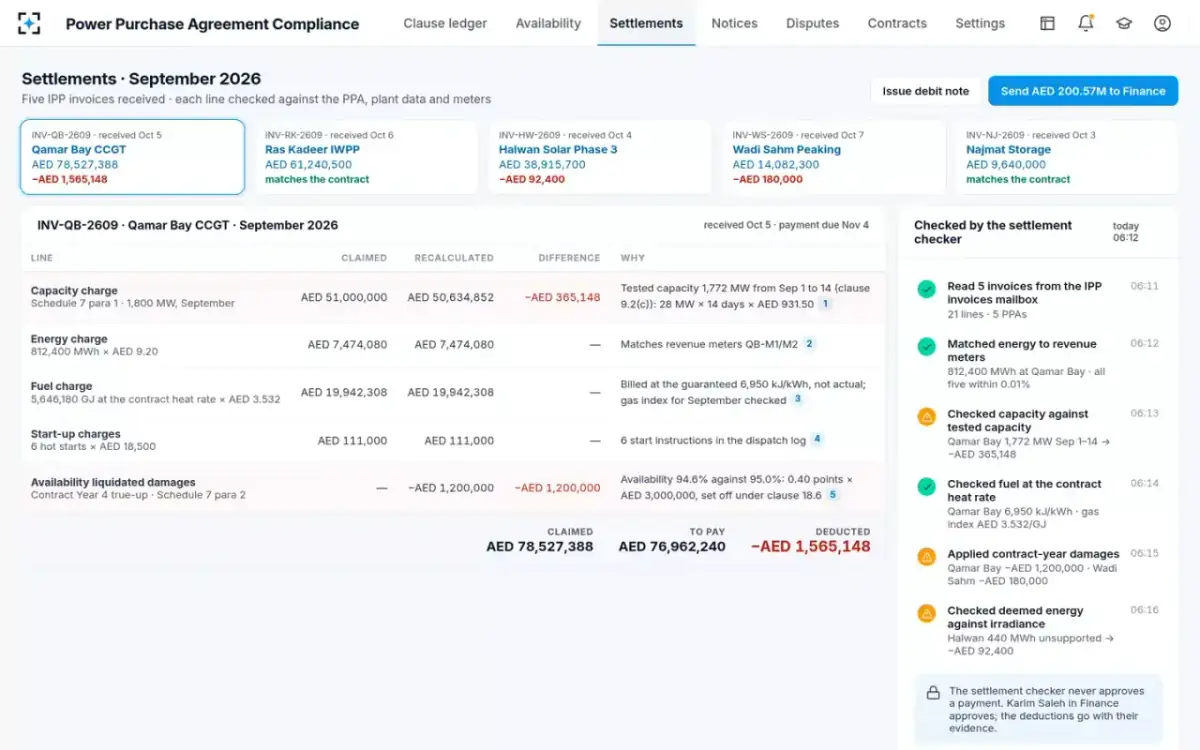

  6. 06Invoice day

    The month's invoice, line by line

    Settlements analyst, Finance

    The invoice claims $78,527,388. The settlement checker works out each line again. A capacity test showed only 1,772 MW, and the retest passed 14 days into the month. So the capacity charge falls by $365,148 (28 MW × 14 days × $931.50). Energy matches the meters, fuel is billed at the agreed 6,950 kJ/kWh and 6 start-ups match the dispatch log. After the $1,200,000 set off under clause 18.6, the amount to pay is $76,962,240.

    “The settlement checker never approves a payment. The settlements analyst in Finance approves, and the deductions go with their evidence.”

  7. 0706:14

    The notice drafted under clause 11.3(d)

    Notice drafter

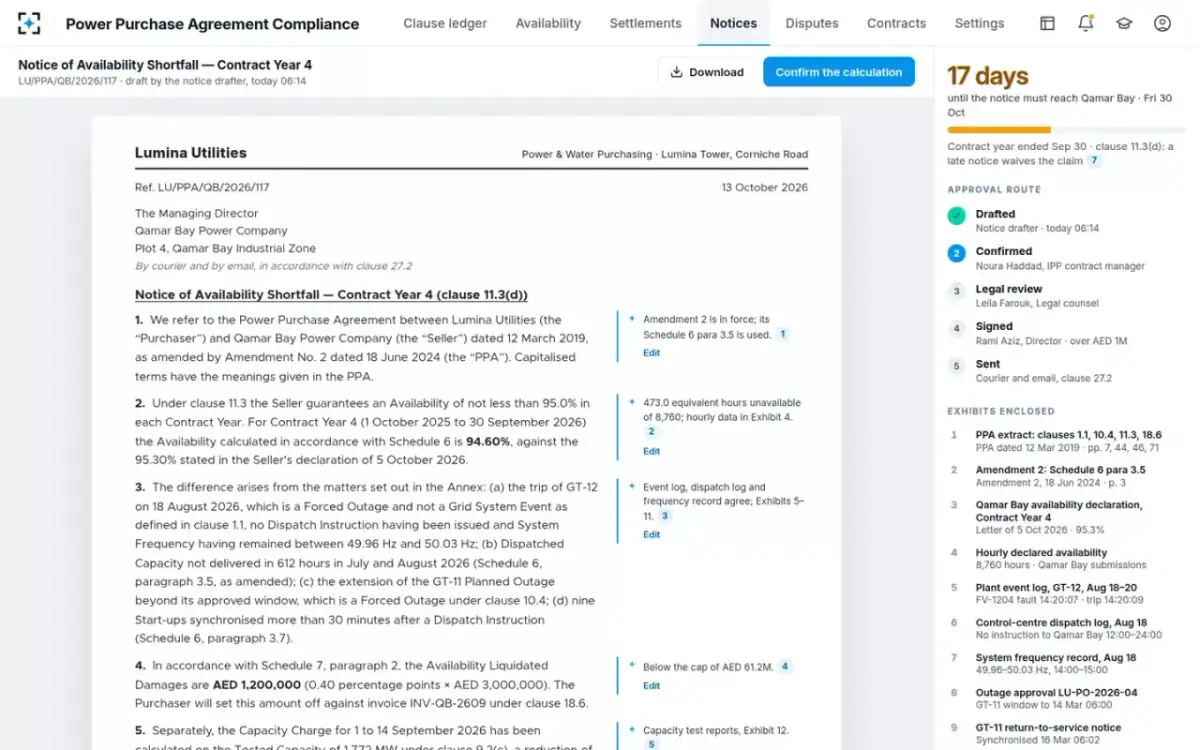

    The notice is drafted on the utility's letterhead, to the plant's Managing Director. It goes by courier and email, as clause 27.2 requires. Each paragraph has a note in the margin with its source: the amended Schedule 6, the hourly data, the event and dispatch logs. It encloses 14 exhibits. The clock shows 17 days until the notice must reach the plant.

    “Contract year ended · clause 11.3(d): a late notice waives the claim”

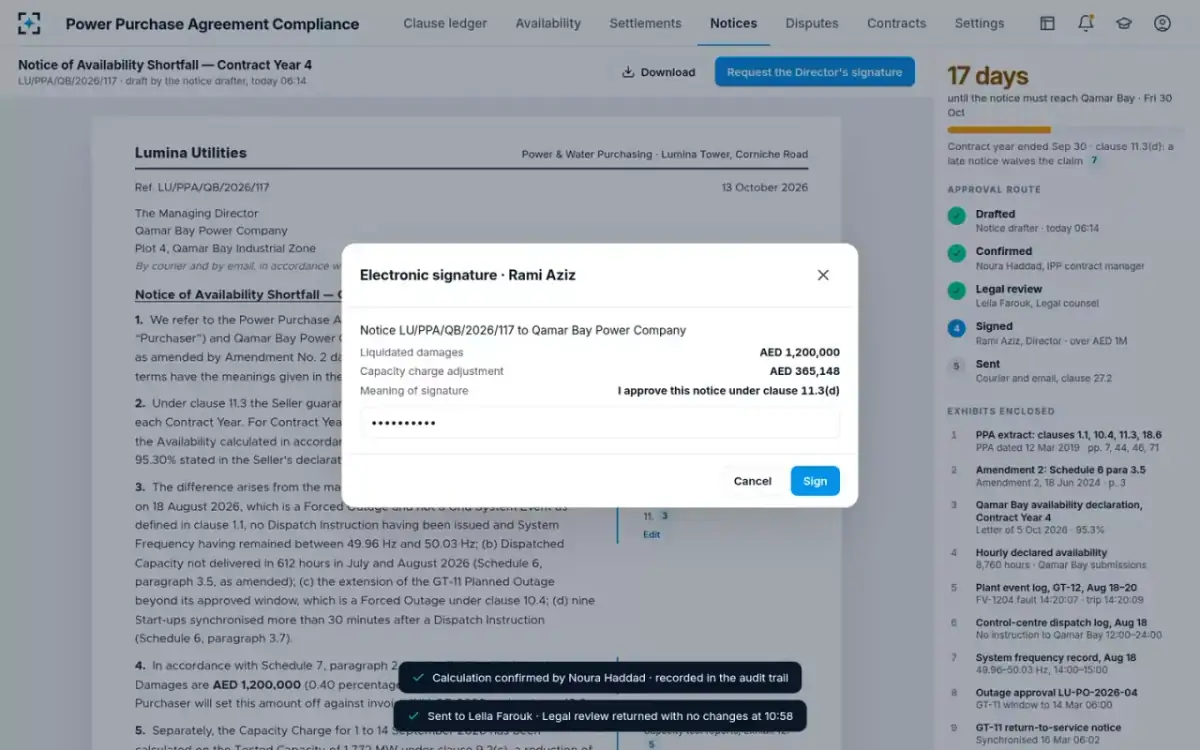

  8. 08Before noon

    Confirmed, reviewed, signed

    Director, power purchasing

    The contract manager confirms the calculation, and the audit trail records it. Legal review comes back with no changes at 10:58. The notice is over $1M, so the director signs it at 11:20. The signature needs a password and records what the signature means. Only then can the notice be sent.

    Meaning of signature: “I approve this notice under clause 11.3(d)”

  9. 09Ready if disputed

    The evidence file, before the plant replies

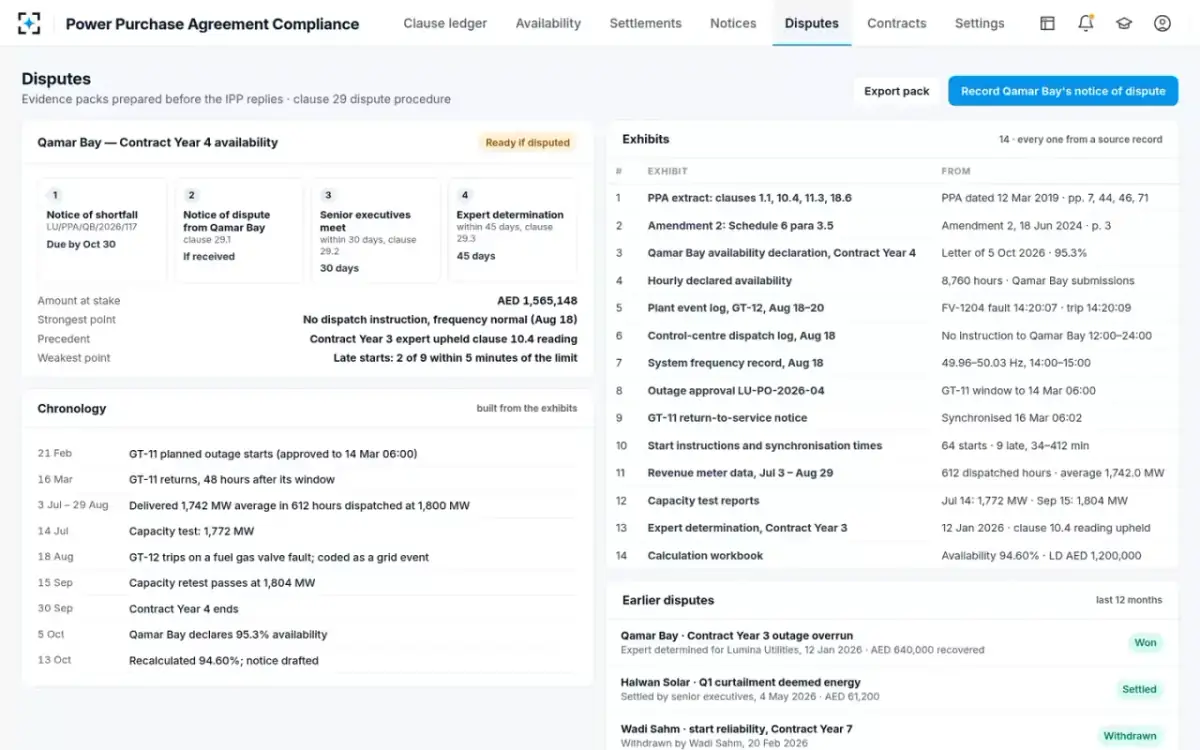

    Dispute pack builder

    If the plant disputes the figures, clause 29 gives 30 days for senior executives to meet. After that, an independent expert decides within 45 days. The file is already built. It holds a timeline, 14 exhibits each taken from a source record, the $1,565,148 at stake, and the strongest and weakest points. In Contract Year 3, the expert upheld the same reading of clause 10.4, and $640,000 was recovered.

    Weakest point: “Late starts: 2 of 9 within 5 minutes of the limit”

  10. 10Next

    Fuel use is inside its limit, and on watch

    Availability calculator

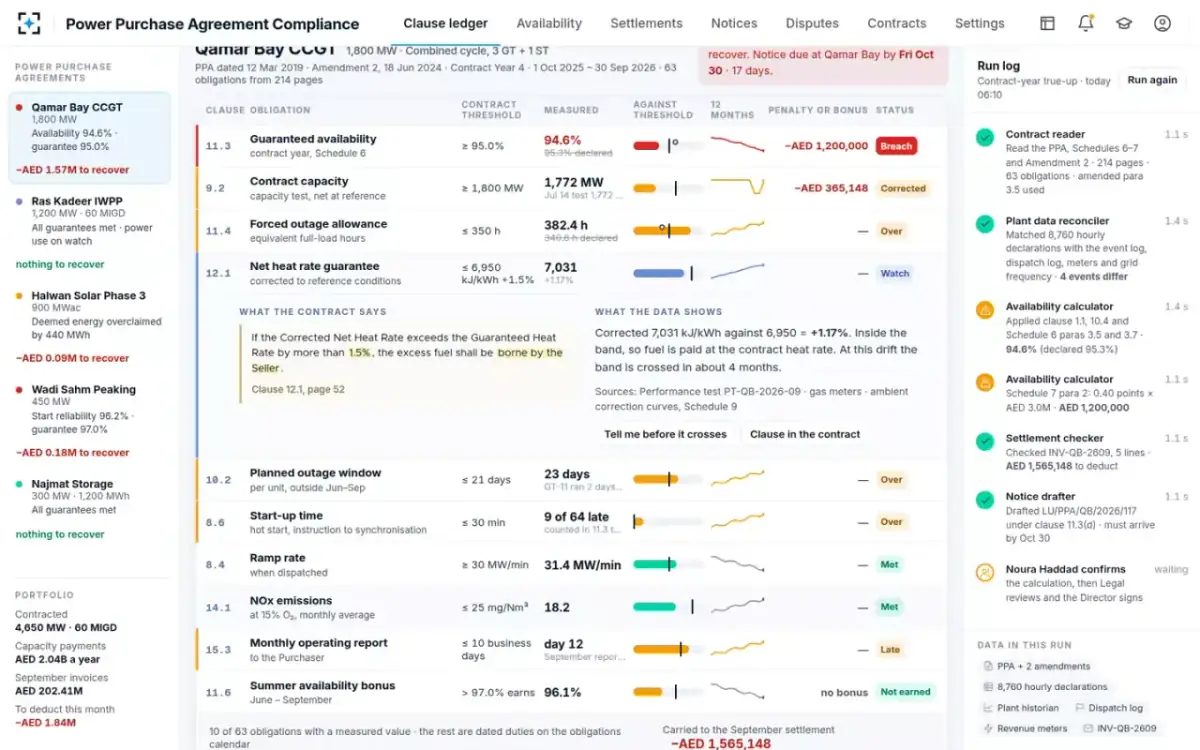

    Heat rate is how much fuel the plant burns for each unit of power. Clause 12.1 guarantees 6,950 kJ/kWh, with a 1.5 % band. The corrected measurement is 7,031 kJ/kWh, 1.17 % higher. So fuel is still paid at the contract rate, with no penalty. The list marks it Watch and offers to warn the contract manager before it crosses the band.

    “At this drift the band is crossed in about 4 months.”

Who it’s for

Five roles that settle one power purchase agreement

The same contract year, seen by the five roles who carry it. What their month looked like, and what it looks like now.

IPP contract manager
Owns five PPAs and confirms each calculation
Before
Signs off each month's settlement and each year-end review from spreadsheets. Needs to know what the contract says availability was, hour by hour, whatever the producer reported.
Now
Opens a list of each duty worked out again from plant data, with the clause and records behind each figure. Confirms the calculation.
Settlements analyst
Approves payments to producers in Finance
Before
Checks five producer invoices a month in spreadsheets. An invoice can add up and still charge for the wrong thing.
Now
Gets each invoice line worked out again from the PPA, the meters and tested capacity. Each difference has its reason and citation. Then approves payment.
Legal counsel
Reviews notices and disputes
Before
Keeps the interpretation of each clause and reviews each notice. Knows that a claim sent after the 30-day window is lost, however right it is.
Now
Reviews a notice drafted under the right clause, with its exhibits. Rules on each unclear clause before the contract reader may use it.
Dispatch shift lead
Issues dispatch instructions from the control center
Before
Logs dispatch instructions and grid events. Holds that an outage with no instruction in the log was no grid event.
Now
Sees the dispatch log and the frequency record beside the producer's outage coding, hour by hour.
Director, power purchasing
Signs notices over $1M
Before
Signs each notice over $1M once shown the clause and the data.
Now
Signs once the contract manager has confirmed and Legal has reviewed. What the signature means is recorded with it.
The agents

Contract, data, availability and notice agents for power purchase agreements

Agents read the PPA, work out each clause from plant data, check invoices and draft notices. The contract manager confirms.

Contract reader

Reads each PPA, schedule and amendment into a list of duties. Each has its limit, formula, measurement period, notice clause and page. Applies each amendment to the clauses it changes.

  • Each obligation carries its page
  • Unclear wording goes to Legal. The agent never interprets it
  • Uses the wording in force for each date
Plant data reconciler

Matches the hourly reports with plant event logs, dispatch instructions, meters and grid frequency. Lists the hours where they disagree, grouped into events.

  • Read-only access to source data
  • Never changes a declaration
Availability calculator

Applies the contract's definitions, clause 1.1 and Schedule 6 as amended. Works out availability, fault hours, reduced output and the penalty or bonus, showing each step of the arithmetic.

  • Shows each step and the clause behind it
  • Coding overrides only by the contract manager
Settlement checker

Checks each invoice line against the recalculated figures, the tariff, price indexing, meters and tested capacity. Prepares the debit note.

  • Never approves or releases a payment
  • Each difference cites its clause and data
Notice drafter

Drafts notices in the buyer's template, under the clause that gives the remedy. Each has the amounts, the deadline and the exhibits, and is ready before the notice window closes.

  • Never sends a notice
  • Legal reviews. The Director signs over $1M
Dispute pack builder

Builds the timeline, exhibits, earlier expert decisions and clause trail for a claim that may be disputed. Lists its strongest and weakest points.

  • Never contacts the producer
  • Exhibits are unchanged copies of source records
IPP contract manager

Confirms, Legal reviews, Director signs, Finance pays.

Ask in plain words

Plain-language answers on a PPA clause, an invoice or a penalty

Ask about any PPA, clause, invoice or penalty, or say what to change. Each answer points to its clause and its records. These answers use the sample data.

Why is our availability lower than the plant declared?

Four events are coded differently from the contract. The biggest is the gas turbine trip. The plant coded it a Grid System Event. But there was no dispatch instruction, and frequency stayed between 49.96 and 50.03 Hz. So clause 1.1 makes it a Forced Outage, a plant fault. Add the outage overrun, 612 hours not delivered and 9 late starts. That is 61.3 equivalent hours, giving 94.6 % against the 95.3 % declared.

What do we deduct from this month's invoice?

$1,565,148 in all. $1,200,000 is the availability penalty (0.40 points × $3.0M), set off under clause 18.6. The other $365,148 is capacity charge for the first 14 days of the month, when tested capacity was 1,772 MW. Energy and fuel match the meters and the contract heat rate.

Will the plant win if it disputes the outage overrun?

Unlikely. Clause 10.4 treats any time past the approved window as a Forced Outage. The expert upheld the same reading for Contract Year 3. The weakest point in the file is the late starts. Two of the 9 were within 5 minutes of the 30-minute limit.

Warn me before any heat rate drifts into a penalty

Done. New rule: warn when a heat rate drifts more than 1.0 % above its guarantee, before it reaches the contract band. This plant is 1.17 % above today, against a 1.5 % band. At this rate it crosses in about 4 months. You can change the rule in Settings.

The screens

The clause ledger, the true-up, the settlement check and the signed notice

From the working solution, on its sample data. Pick one to see it large.

The clause listEach duty in the PPA with its limit, the recalculated value beside the declared one, the trend and the penalty so far. The breach is open on the wording, the plant data and the penalty.
Recalculating from plant dataThe run log replays the year-end check step by step, and the penalty counts up as availability is worked out again.
Availability, hour by hourEach day of the contract year as a calendar, the result by the contract, and the four events read differently from the producer.
The gas turbine tripThe contract's definition of a Grid System Event, beside the plant event log and the dispatch log. The grid frequency for the hour of the trip sits below.
What if we accept the producer's codingSwitch any event to the producer's reading and see availability, the penalty and the invoice deduction change at once.
The settlement checkFive producer invoices for the month. Each line is claimed, recalculated and explained, with the amount to pay and to deduct.
The drafted noticeThe notice of shortfall on letterhead, with a source note beside each paragraph, the approval route, the deadline and the exhibits.
The director's signatureConfirmed by the contract manager, reviewed by Legal, signed by the director with the meaning of the signature.
The dispute evidence fileThe clause 29 steps, the amount at stake, the strongest and weakest points, the timeline, 14 exhibits and earlier disputes.
The list of dutiesEach clause read from the PPA with its type, limit, measurement and page, and what Amendment 2 changed.
Fuel use on watchThe heat-rate guarantee with its wording and the corrected measurement, inside the band and on watch.

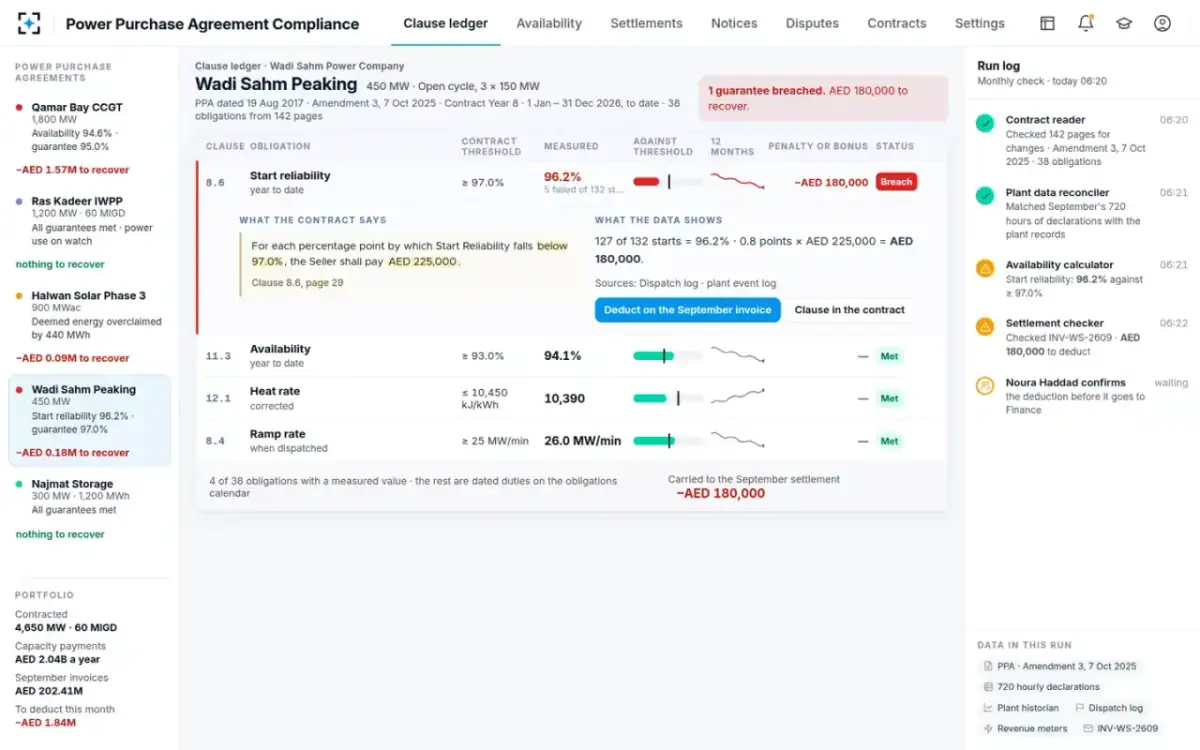

Another PPA: a peaking plantThe peaking plant starts reliably 96.2 % of the time, against 97.0 % agreed. The penalty is ready to deduct from its monthly invoice.
PPA settingsLimits, approvers, notice deadlines for each PPA, read-only data sources and the rules applied on each run.
Governance

Each figure cited, with codings, notices and payments decided by people

Each figure cites its clause and its recordEach value carries the clause, page and amendment it comes from, and the data behind it. That can be a line in the plant event log, a dispatch record, a meter or a capacity test.
Read-only on contracts and plant dataThe agents only read PPAs, reports, plant data, dispatch logs, meters and invoices. They recalculate and draft, but never change a declaration or a source record.
Only the contract manager changes a codingThe what-if view shows the cost of accepting the producer's coding of any event. Only the contract manager may override how an event is read.
Confirmed, reviewed, signed before it is sentA notice goes from the contract manager's confirmation to Legal review. Over $1M, the Director then signs electronically, and what the signature means is recorded. No agent sends a notice or contacts the producer.
Finance releases each paymentThe settlement checker prepares the deductions and the debit note. The settlements analyst in Finance approves payment, and each deduction goes with its evidence.
Each step on the audit trailEach recalculation, coding override, confirmation, review, signature and send is recorded with who did it and when. Each calculation shows the contract wording it used, as signed and as amended.
Configuration

Limits, approvers and notice deadlines for each PPA

Limits, approvers, notice deadlines and data sources are settings. The purchasing team chooses them for its own contracts.

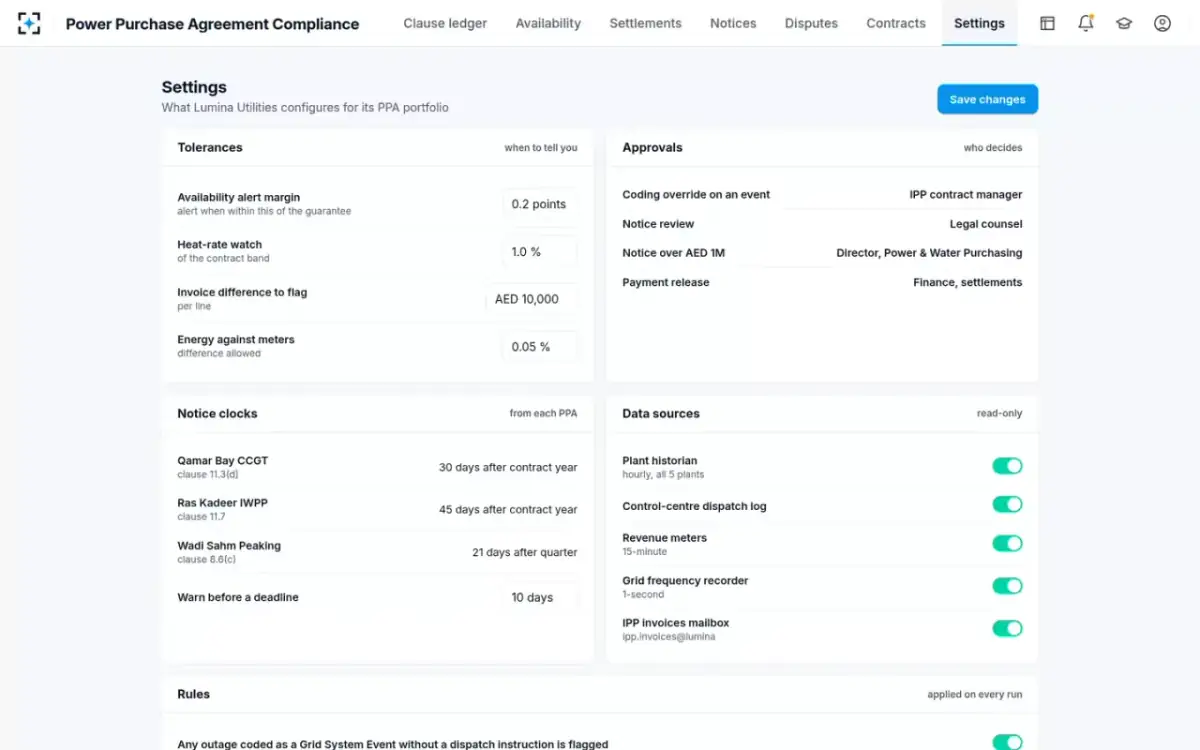

SettingDefaultChoose from
Availability alert margin0.2 pointsAny margin, in points. Alerts when availability is within this margin of the guarantee
Heat-rate watch1.0 %Any share of the contract band, before it is reached
Invoice difference to flag$10,000Any amount, per invoice line
Energy against meters0.05 %The difference allowed between invoiced energy and the revenue meters
ApprovalsCoding override: IPP contract managerNotice review: Legal counsel · Notice over $1M: Director, power purchasing · Payment release: Finance, settlements
Notice clocksFrom each PPAThe combined-cycle plant: 30 days after the contract year (clause 11.3(d)). A second plant: 45 days after the contract year (clause 11.7). A peaking plant: 21 days after the quarter (clause 8.6(c))
Warn before a deadline10 daysAny number of days before a notice must arrive
Rules applied on every runOnFlag any outage coded as a Grid System Event with no dispatch instruction. Read a planned outage past its approved window under clause 10.4. Check deemed energy against sunlight at the plant
Connections

PPAs, availability reports, plant logs, dispatch, meters and the producer's invoices

PPAs and amendmentsthe agreement, its schedules and each amendment, read clause by clause with the page
Availability declarationsthe producer's hourly reports and its year-end availability letter
Plant historian and event logshourly plant data for all five plants, the unit event logs, and capacity and performance tests
Control-centre dispatch logdispatch instructions, start instructions and synchronization times
Revenue meters and grid frequencynet output metered every 15 minutes and the grid frequency recorded every second
IPP invoicesmonthly invoices from the producers' invoice mailbox, checked line by line
What it changes

Power purchase agreement results: money recovered, claims on time, fewer days

Each figure carries its label: a target the solution is built to, an estimate, a typical published result, or a proven one.

demo
$1.57M
recovered on one plant's invoice in the sample: the availability penalty and 28 MW billed before it passed its test
Claimed $78.53M78.53
Paid $76.96M76.96
target
100%
of contract claims sent before the PPA's notice deadline
target
2days
to check a producer's invoice line by line, where spreadsheets take 3 weeks
3 weeks2 days

“Demo” means seen in the working solution, on its sample contracts and plant data. The $1,565,148 is $1,200,000 (0.40 points × $3.0M) plus $365,148 (28 MW × 14 days × $931.50). “Target” means the design goal, measured in the live solution. “Estimated” means our estimate of where the days go. “Typical” means published figures. Profit / Pakistan Today (Sep 2024) puts Pakistan's capacity payments at about Rs 139 to 150bn a year. A PIDE paper, “IPPs and capacity payments”, finds “hardly any monitoring” of availability against capacity payments. On the law, CERC order 115/MP/2019 (GKEL v. GRIDCO) and APTEL, MB Power v. UPPCL (reported Feb 2025), hold that capacity charges follow declared availability. Names on the screens are sample data.

Questions

Questions buyers ask about power purchase agreement software

What is power purchase agreement compliance software?

It checks what a power producer is owed against what its PPA actually says. Power Purchase Agreement Compliance turns each PPA into a clause list. Each duty shows its limit, the value worked out from plant data and the penalty or bonus so far. It also checks each invoice line. The contract manager confirms, Legal reviews and the Director signs.

How does PPA availability verification work?

The plant data reconciler lines up the producer's hourly reports with plant event logs, dispatch instructions, meters and grid frequency. It groups the hours where they disagree into events. The availability calculator then reads each event with the contract's own definitions, as amended. It shows each step of the arithmetic with its clause.

How are availability penalties calculated?

By the PPA's own formula. In the sample PPA, Schedule 7 para 2 charges $3,000,000 per percentage point below the 95.0 % guarantee. The total is capped at 10 % of the yearly capacity charge. The plant's recalculated 94.60 % gives 0.40 points × $3.0M = $1,200,000. That is set off against the month's invoice under clause 18.6.

Does it check producer invoices line by line?

Yes. The settlement checker works out each line again: capacity, energy, fuel, start-ups and penalties. It uses the contract tariff, the meters and tested capacity, and explains each difference with its clause and source. It prepares the debit note and does not approve a payment. Finance does.

How does it make sure claims meet the PPA's notice deadline?

Each PPA's notice deadline is a setting. For the combined-cycle plant it is 30 days after the contract year, and 45 for a second plant. A peaking plant has 21 days after the quarter. The solution warns 10 days before a deadline. The notice drafter drafts the notice under the right clause when a limit is crossed. In the sample case it was ready with 17 days to spare.

What happens when the producer codes an outage as a grid event?

The solution reads it against the contract's definition. In the sample case the plant coded a gas turbine trip as a Grid System Event. But the dispatch log had no instruction, and frequency stayed between 49.96 and 50.03 Hz. So clause 1.1 makes it a plant fault. A rule flags each such outage on every run.

Who decides the reading of an event, the notice and the payment?

People do. The agents read contracts and plant data without changing them. They recalculate and draft, and never decide. Only the contract manager overrides how an event is read. Legal reviews each notice, the Director signs notices over $1M and Finance releases payment. Each step is on the audit trail.

What contracts and data does it need to start?

The Agentic Solution Engine builds and deploys it from your requirements and documents. That means your PPAs and amendments, notice templates, and a past contract year's reports, plant data and invoices. It goes live once each quality gate has passed. We will walk you through it on one of your own PPAs first.

Check one of
your own contract years.

We'll run Power Purchase Agreement Compliance on one of your PPAs and a past contract year's plant data.
