WorkflowPower Generation & Water Production

Generation Availability Reporting

NERC GADS reporting with each outage coded to the failed part and checked before it is filed

See one case, screen by screen ↓
Watch with transcript →

Built forAvailability analystsPerformance engineersReporting leadsShift managers

The Problem Today

Analysts join historian signals, shift logs and work orders by hand, often weeks later, so outages get miscoded.

45 days
all the time allowed to code and file a quarter's outages published
9.2%
forced outage rate at conventional plants, 2025 (norm under 8%) published

What the analyst reads by hand

  • Breakers
  • Shift log
  • Repairs
  • Code rules
  • Fuel cuts charged to plantOutside causes counted against the unit's record
  • One failure, three codesThe board never sees it is one problem

The Solution

  1. Events built from signalsBreaker and output signals become events, start to end, with MW lost
  2. Log and work order joinedThe shift log's words and the repaired part, pinned to the event
  3. Analyst confirms each codeType and code proposed from the failed part, and the analyst confirms
  4. Checked, then signedEach record checked against the filing rules, then the reporting lead signs

Built-in controls

  • Each code traced to a log line and work order
  • Outside causes carry their evidence
  • Coding rule changes tested and approved

What You Get

Capacity value and availability payments rest on a forced outage rate the utility can defend.

  • Repeat causes foundThree leaks on one wall read as one problem to fix
  • Quarter closed soonerour estimate21 → 5.5 analyst days a quarter, for six units
  • Fewer records returned at filingEach event checked against the filing rules before it goes
In short

What is Generation Availability Reporting?

It is software that turns a generating fleet's outages, derates and reserve shutdowns into the event records NERC asks for. NERC is the body that sets reliability rules for the North American grid. Its Generating Availability Data System, GADS, needs each event's type, start and end, MW lost and cause code, each quarter. Generation Availability Reporting adds six agents. They build the events from historian signals, read the shift log and work order, propose the code with its reasons and check each record. The analyst confirms each code and the reporting lead signs.

How to choose AI solutions for utilities →

Updated

The problem

Outage reports are pieced together by hand from three systems, so codes go wrong

Power plants registered with NERC, the body that sets reliability rules for the North American grid, must report how available their units were. Each quarter, the fleet sends each outage, derate and reserve shutdown to GADS, NERC's Generating Availability Data System. A derate is a cut in how much power a unit can make. Each record needs its event type, its start and end, the MW lost and a cause code that names the failed equipment. The file is due 45 days after the quarter ends. The trouble is that the raw facts sit in three systems built for other jobs. The breaker and MW signals sit in the historian, the plant's store of sensor data. The reason sits in the control-room shift log. The failed part sits in a maintenance work order. Availability analysts join the three by hand, in spreadsheets, often days or weeks after the event.

The coding rules are strict and detailed. The event type depends on timing. U1 is immediate, U2 is delayed by up to six hours, U3 is postponed and SF is a failure at start-up. The cause code must name the part that failed, and the alarm that tripped the unit does not count. An extension to a maintenance outage is allowed only for work in the original scope. Solar events count only at 20 MW or more. So mistakes creep in. Steam codes land on gas-turbine trips, and forced outages hide as maintenance extensions. Cuts in fuel supply are charged to the plant. The same failure gets coded three ways, so the board never sees it as one problem. Each wrong code moves the forced outage rate, the share of time a unit was forced off. That rate feeds capacity accreditation, regulator benchmarks and payments tied to availability.

typical9.2%weighted equivalent forced outage rate of conventional generation in 2025, against historical norms rarely above 8 %
typical45daysafter each quarter ends to file GADS data, for conventional and solar units of 20 MW and up
typical20MWthe solar plant threshold from January 2025, down from 100 MW, so many more plants now report
Where an analyst's days go in one GADS quarterestimated
By hand21 days
With the solution5.5 days
  • Building events from breaker and MW signals4 → 0.5 d
  • Chasing shift logs for what happened and why5 → 1 d
  • Matching work orders to find the failed part3 → 0.5 d
  • Choosing the event type and the cause code4 → 2 d
  • Checking records and fixing what fails3 → 1 d
  • Availability tables and the board summary2 → 0.5 d

Estimated split for one quarter of a six-unit fleet with about 60 events, in working days, by hand and with the solution.

How it works

From breaker signal to signed file: availability reporting step by step

What comes in
Plant data inThe quarter’s events · historian signals, shift logs, work orders, code rules
Agents at work
Event builderstart · end · MW
Then
Log reader
Work order matcher
Then
Cause codertype + code + why
Then
Report checker12 rules
Report writer
A person decides
Availability analystconfirms every code, and the reporting lead signs
What comes out
Coded events with their reasons
Quarterly GADS file, checked
Board availability report
One case, step by step

A waterwall tube leak at 02:47, coded and checked before the quarter closes

A utility runs six units. Four are steam units, one is a combined-cycle block and one is a solar plant. One Sunday at 02:47, the generator breaker on steam unit 3 opens on a waterwall tube leak. A waterwall is the wall of water-filled tubes lining the boiler. Three weeks later, 34 days are left before the Q3 file is due. Here is how that outage and the rest of the quarter get coded, checked and signed, screen by screen, in the working solution.

A worked example on sample data. Names, IDs and figures on the screens and in this section come from the demo.

  1. 01Three weeks later, morning

    The year on one strip, the quarter in one line

    Availability analyst

    The analyst codes the fleet's events. Each unit's year is one strip of states: in service, planned, maintenance and forced outages, derates drawn by MW lost, and reserve shutdown. Each row ends with its equivalent availability and forced outage rate. The Q3 bar reads 62 events, 55 coded, 3 checks to fix and 34 days left. The biggest uncoded block, first on the To code list, is steam unit 3.

    “To code · Biggest lost energy first · every proposal waits for you”

  2. 0202:25 to 02:47, the night of the trip

    The event built from the signals, the log pinned to its minutes

    Event builder

    The event builder turned the breaker and output signals into one event. It runs from Sunday 02:47 to Wednesday 19:15, lasting 88.5 h, with 330 MW and 29,194 MWh lost. On the signal chart, feedwater flow climbs to 18 t/h above steam flow, so the leak shows 22 minutes before the breaker opens. Each shift log entry is pinned at its minute.

    Limit: no start or end time is invented. Signals that disagree go to the analyst.

  3. 03The agents read

    What the control room wrote, and what the boilermakers repaired

    Log reader and Work order matcher

    The log reader picked out seven entries from 01:58 on. At 02:31 a control-room operator wrote “Feedwater flow 18 t/h above steam flow”. Seven minutes later came “Acoustic leak alarm ch 7, furnace front wall el. 38 m”. The shift manager wrote at 02:47 “Waterwall tube leak suspected, front wall”. The work order matcher linked the repair work order. It covers a pinhole leak in tube 114 and a steam-cut tube 115, front wall, el. 38.2 m, with radiography 100 % accepted.

    Limit: the log reader quotes the log. It does not paraphrase a cause the log does not state.

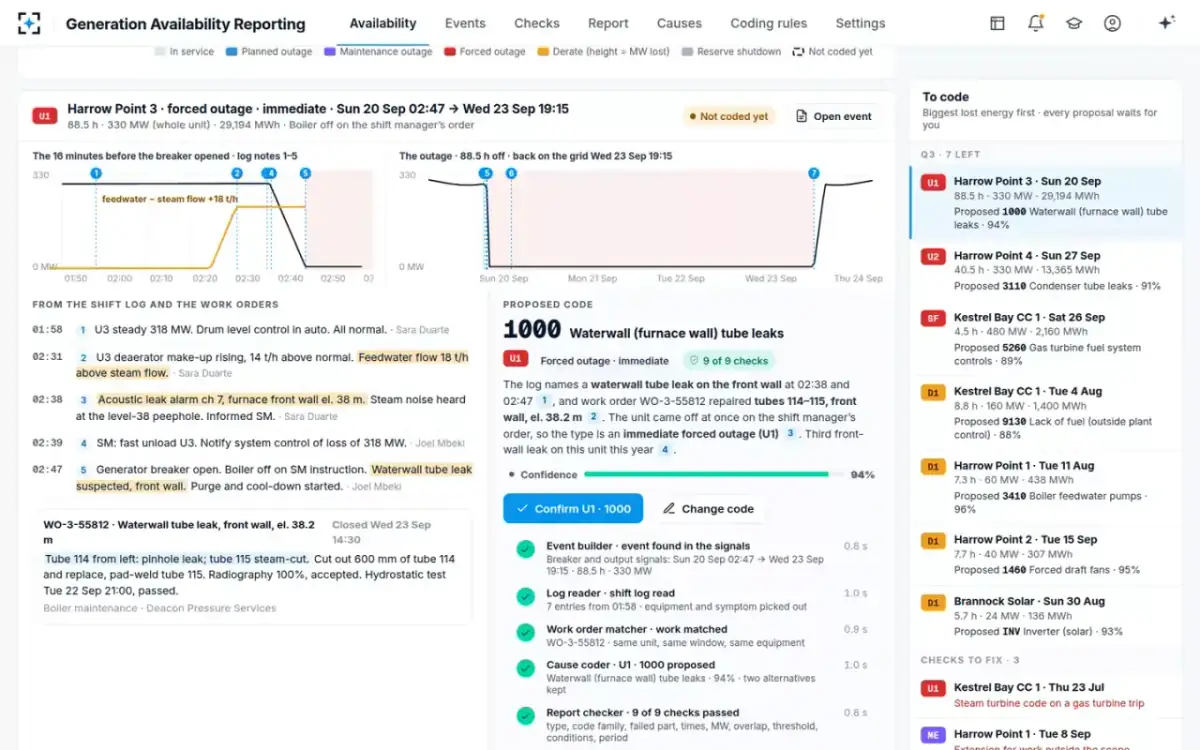

  4. 04Code proposed

    U1 · 1000 Waterwall (furnace wall) tube leaks, at 94 %

    Cause coder

    The cause coder proposes the type from the timing and the code from the failed part. The unit came off at once on the shift manager's order, so it is an immediate forced outage, U1. The code is 1000, citing the log and the work order. It notes this is the third front-wall leak on the unit this year. Two alternatives are kept. One is 1040 Waterwall, fireside slagging or fouling, at 4 %. The other is 1999 Boiler, miscellaneous, at 2 %. The record already passes 9 of 9 checks.

    “Pick one, or any code in the library. Your choice and the reason are kept with the record.”

  5. 05One click

    The analyst confirms, and the strip updates

    Availability analyst

    The analyst confirms U1 · 1000. The lens now shows the code on file, “Confirmed by you just now”. On the To code list, steam unit 3 is grayed out as coded. The Q3 count falls to 6 left. Undo sits beside the confirmation, and Next to code moves on to the next-biggest event.

    “Filed into the Q3 record with its rationale. 6 left to code.”

  6. 06Outside the plant

    A gas curtailment kept off the plant's record

    Work order matcher and Cause coder

    On a Tuesday in August, the combined-cycle block lost 160 MW for 8.8 h. The log reader found the operator's entry at 12:58. It records a notice from the gas transmission company cutting supply, with offtake pressure held at 24 bar from 13:15. There is no plant work order, so the matcher attached the supplier's notice instead. The proposal is D1 · 9130 Lack of fuel (outside plant control), at 88 %. It still waits for the analyst.

    “Output was held by supplier gas pressure. No plant equipment failed.”

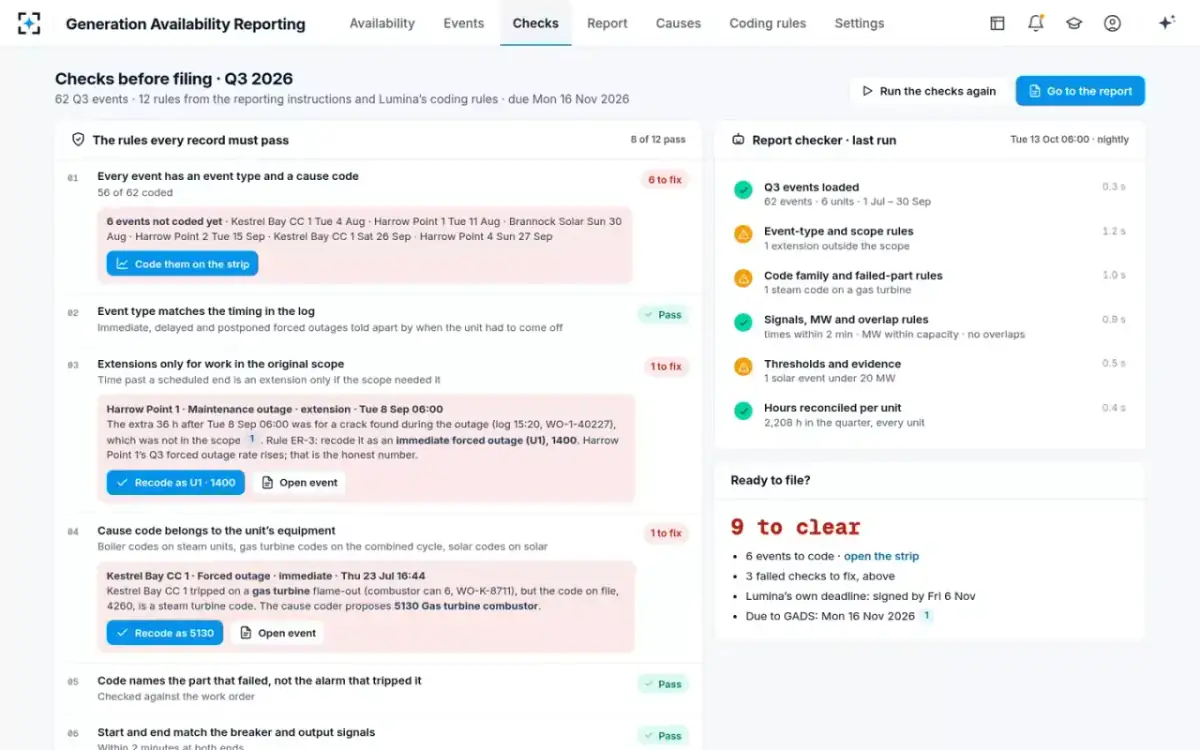

  7. 07Nightly, 06:00

    Twelve rules on each record before filing

    Report checker

    The report checker ran 12 rules on all 62 Q3 events. The rules come from the reporting instructions and the utility's own coding rules. Of the 12 rules, 8 pass. The checker caught three records. A 36 h maintenance extension on steam unit 1 was for a crack found during the outage, outside the original scope. A gas-turbine flame-out on the combined-cycle block carries 4260, a steam turbine code, so the cause coder proposes 5130 Gas turbine combustor. And an 18 MW tracker stow at the solar plant is under the 20 MW solar threshold. In a stow, the panels turn to a safe position.

    Limit: the report checker proposes a fix for each failure. It never changes a record on its own.

  8. 08The honest number

    The extension recoded as a forced outage

    Availability analyst

    Under the extension rule, the analyst recodes the steam unit 1 extension as U1 · 1400, with its repair work order behind it. Rule 03 now passes, making 9 of 12, and the quarter has 8 left to clear. In the Q3 report, steam unit 1's forced outage rate moves from 0.4 % to 2.1 %. The fleet's rate moves from 2.2 % to 2.4 %.

    “Steam unit 1’s Q3 forced outage rate rises. That is the honest number.”

  9. 09The report

    The Q3 tables and the board summary, drafted for sign-off

    Report writer

    The report writer computes service, planned, maintenance, forced and reserve hours by unit. It also computes equivalent availability, forced outage rate and forced MWh. Fleet equivalent availability is 97.2 %, weighted by capacity. The writer drafts the board summary for the reporting lead. Send for sign-off stays blocked until each record is coded and passes all 12 checks.

    “Each figure links to its events. Drafted by the report writer from the coded records. The reporting lead signs.”

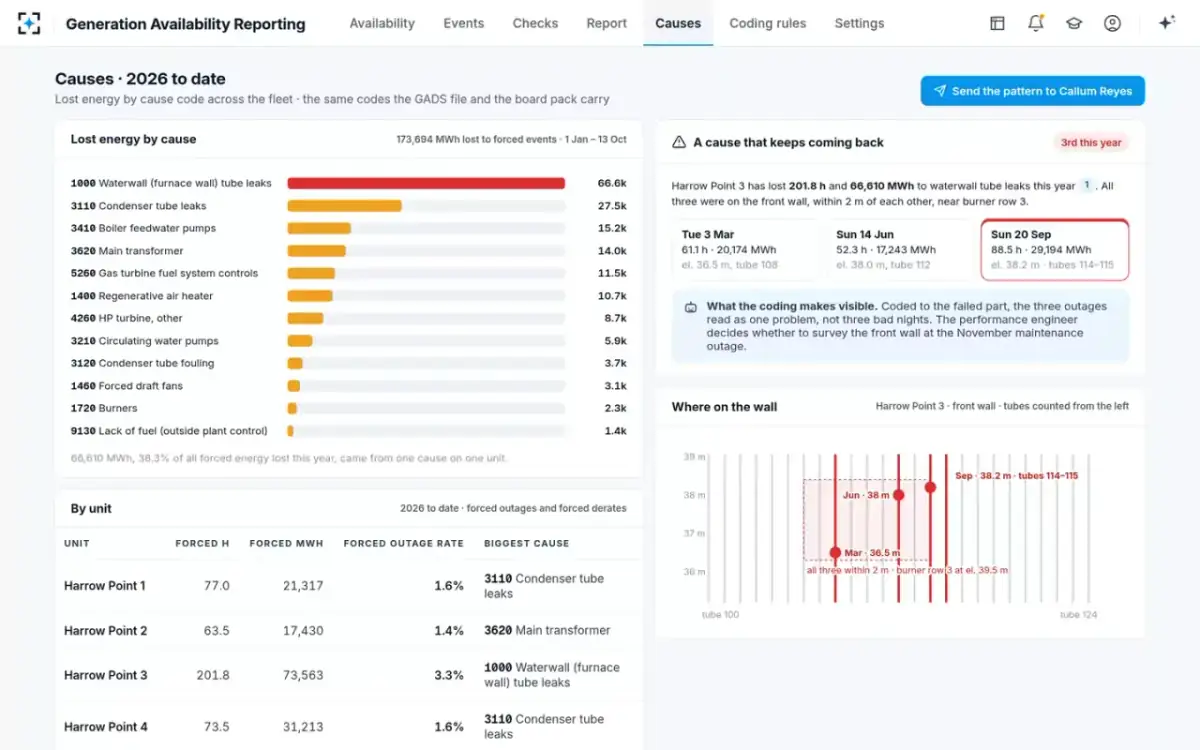

  10. 10The pattern

    Three leaks, one problem

    Performance engineer

    Coded to the failed part, steam unit 3's three waterwall leaks, months apart, add up to 201.8 h and 66,610 MWh. That is the largest cause in the fleet, 38 % of the year's forced energy lost. The tube map shows all three on the front wall, within 2 m of each other, near burner row 3. The analyst sends the pattern to the performance engineer. The engineer decides whether to survey the front wall at the next maintenance outage.

    “Coded to the failed part, the three outages read as one problem.”

Who it’s for

Who writes, codes, investigates and signs an outage record

The same outage, seen by the four people who write it, code it, investigate it and sign it. Here is what their quarter looked like, and what it looks like now.

Availability analyst
Codes and confirms events
Before
Codes 60 to 70 events a quarter across 6 units, and chases shift managers for what happened at 02:00. The breaker gives the time and the log gives the reason. The week goes into joining them.
Now
Works a queue of events, biggest lost energy first. Each comes with the log lines, the work order and a proposed code with its reasons. Confirms or changes each one.
Performance engineer
Investigates repeat causes
Before
Owns boiler reliability and wants the causes behind the totals, because three leaks on one wall are a pattern.
Now
Gets lost energy by cause code, the repeat-cause alert and a tube map of where on the wall each leak was.
Regulatory reporting lead
Signs the quarterly file and the board pack
Before
Signs the quarterly file and the board pack, and approves coding-rule changes. A code that cannot be traced to a log line and a work order does not leave the building.
Now
Receives a quarter that has passed all 12 checks, with a drafted board summary in which each figure links to its events.
Shift manager
Writes the shift log
Before
Writes the shift log and decides when a unit comes off, and expects a short line naming the leak and the wall to be enough.
Now
Each log line is quoted at its minute in the coded event and its rationale. The words written on shift are the evidence the code rests on.
The agents

Event, log and cause code agents behind generation availability

Six agents build events from the historian, join them to the log and the work order, then code and check them. The analyst confirms each code and the reporting lead signs.

Event builder

Turns breaker, output and status signals from the historian into events, minute by minute. Each event gets a start, an end, the MW lost and a first event type. An event opens when the unit leaves service, or loses more than 2 % of capacity for 15 minutes.

  • Never invents a start or end time no signal shows
  • Signals that disagree go to the analyst
Log reader

Reads the control-room shift log from 2 hours before each event to its end. Picks out the equipment named, the symptoms, the alarms and the orders given, with their times.

  • Quotes the log
  • Never paraphrases a cause the log does not state
Work order matcher

Links the maintenance work orders on the same unit in the event window, matched on the equipment the log names. Reports the failed part and the repair. For a cause outside the plant, it attaches the supplier or system operator notice instead.

  • Never links a work order from another unit
Cause coder

Proposes the event type by the timing rules and the cause code by the failed part, using the coding rules and the code library. Gives a rationale citing the log and the work order, a confidence and two alternatives. Below 80 % it shows the event without a proposal.

  • Never confirms or files a code
  • Names the failed part rather than the alarm that tripped the unit
Report checker

Runs 9 checks on each event and 12 rules on the quarter. They cover type, code family, failed part, times, MW, overlaps, thresholds, contributing conditions and hours. Names each failure and proposes a fix.

  • Never changes a record on its own
  • Names the event, the rule and a proposed fix. The analyst applies it
Report writer

Computes equivalent availability, forced outage rate and lost energy per unit and for the fleet. Drafts the board summary with the result, the biggest causes and what changed.

  • Numbers only from coded records
  • Nothing is sent until the reporting lead signs
Availability analyst

Confirms each code, and the reporting lead signs the file.

Ask in plain words

Plain-word answers on events, cause codes and the quarter's checks

Ask about an event, a code, a check or the quarter. Each answer cites the log, the work order or the rule. These answers use the sample data.

Why is steam unit 3’s September outage proposed as 1000?

The night-shift log names a waterwall tube leak on the front wall at 02:38 and 02:47. The repair work order covers tubes 114 and 115 at el. 38.2 m. The boiler came off at once on the shift manager’s order, which makes it an immediate forced outage, U1. It is the third front-wall leak on the unit this year.

What is left before Q3 can be filed?

Seven events to code and three failed checks. One is an outage extension on steam unit 1 for work outside the scope. Another is a steam code on a combined-cycle gas turbine trip. The third is an 18 MW solar event under the 20 MW threshold. The 45th day is a Sunday, so the file is due on the next business day.

Which cause cost the most energy this year?

Waterwall tube leaks on steam unit 3. There were three forced outages, 201.8 hours and 66,610 MWh, all on the front wall within 2 m of each other. That is the largest cause in the fleet.

Is the combined-cycle derate in August outside plant control?

Yes. The gas transmission company held the offtake at 24 bar from 13:15. The block was on its fuel pressure limit, with no plant fault and no work order. The proposal is D1 · 9130, lack of fuel outside plant control, with the notice attached as evidence. You confirm it.

The screens

The availability strip, the proposed code and the checks before filing

From the working solution, on its sample data. Pick one to see it large.

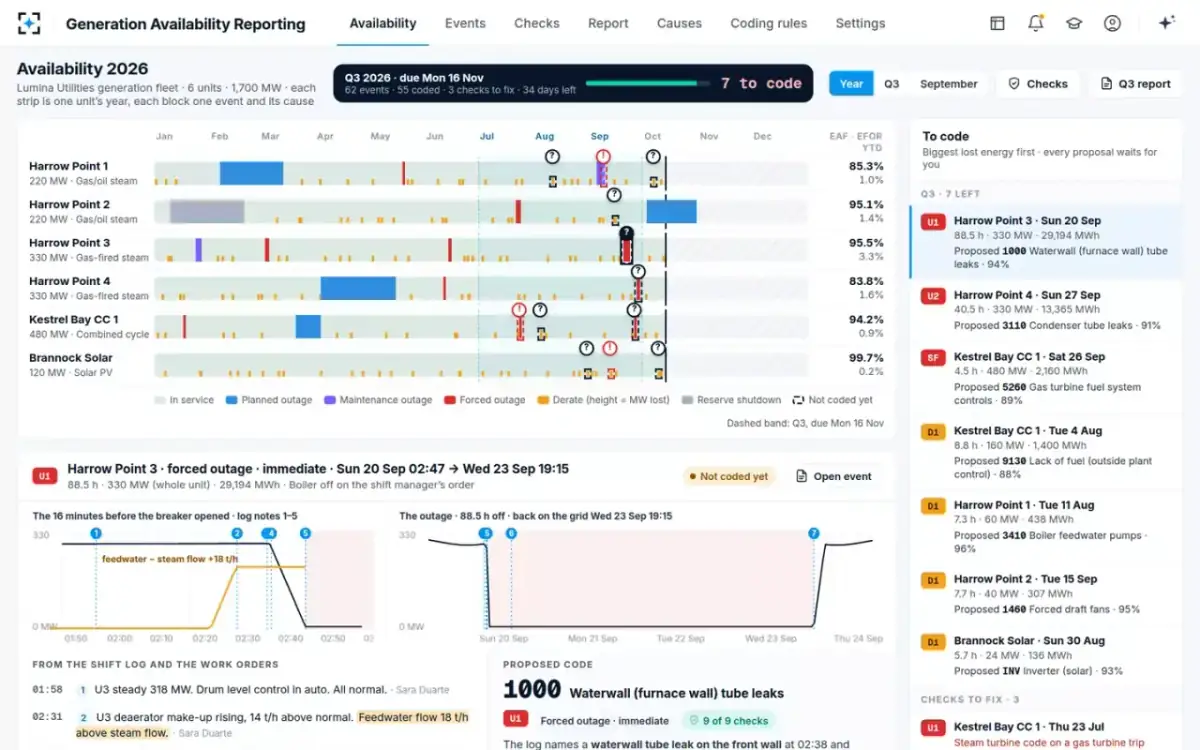

The availability stripEach unit's year as one strip of states, with the Q3 status and due date. Uncoded events and failed checks are pinned, and the To code list puts the biggest lost energy first.
The proposed codeThe shift log and the work order, with the words that decide the code highlighted. Beside them, the proposed type and cause code with its reasons and confidence, and the agents' run step by step.

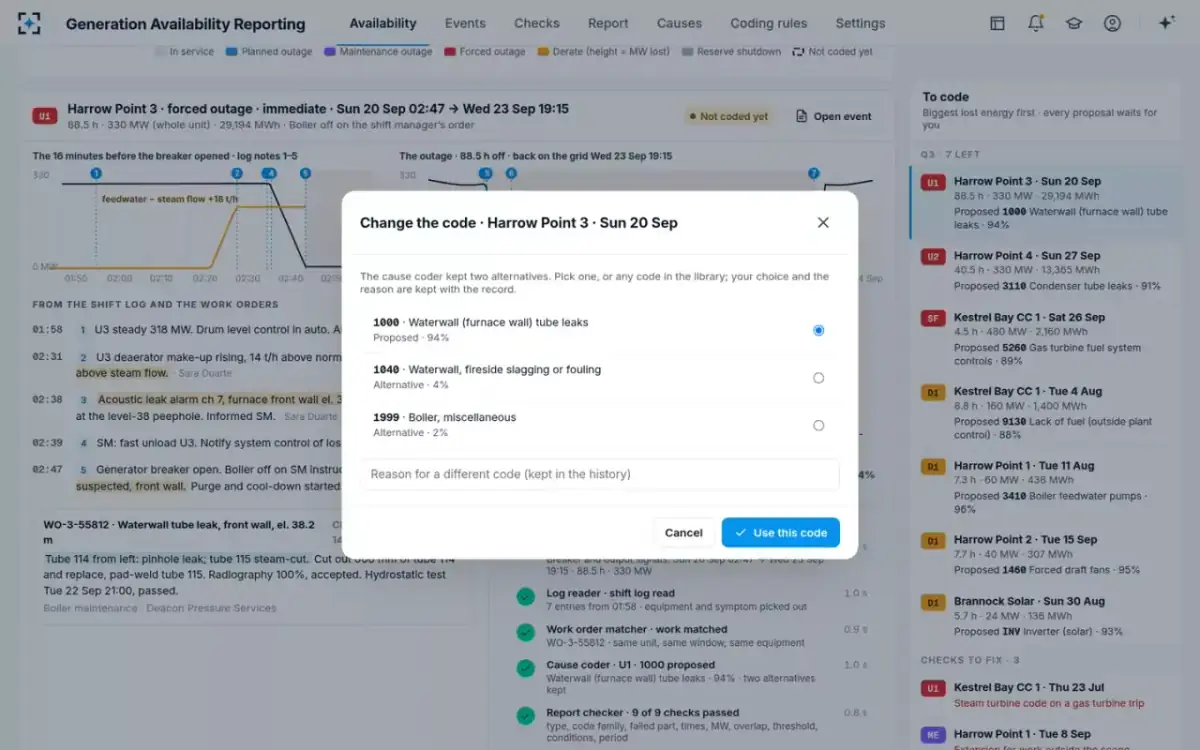

Change the codeThe proposal and the two alternatives the cause coder kept, any code in the library, and a reason that stays with the record.

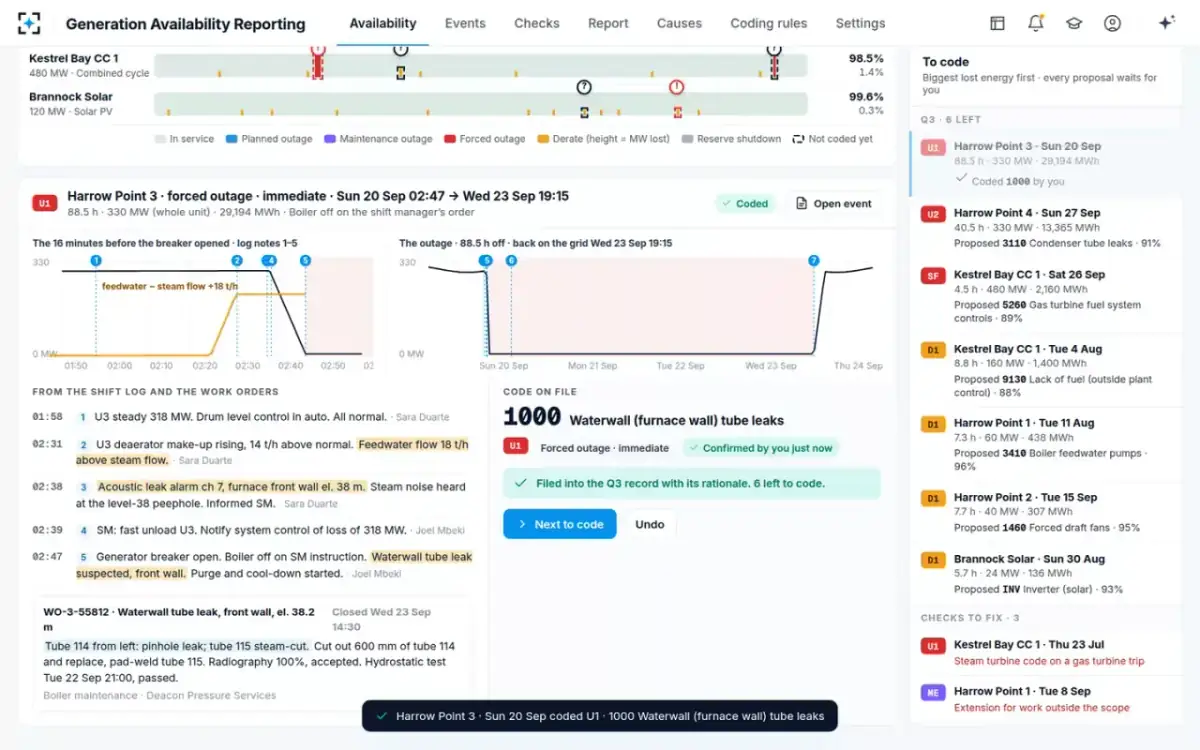

ConfirmedThe code on file, confirmed by the analyst, with undo and the next event to code.

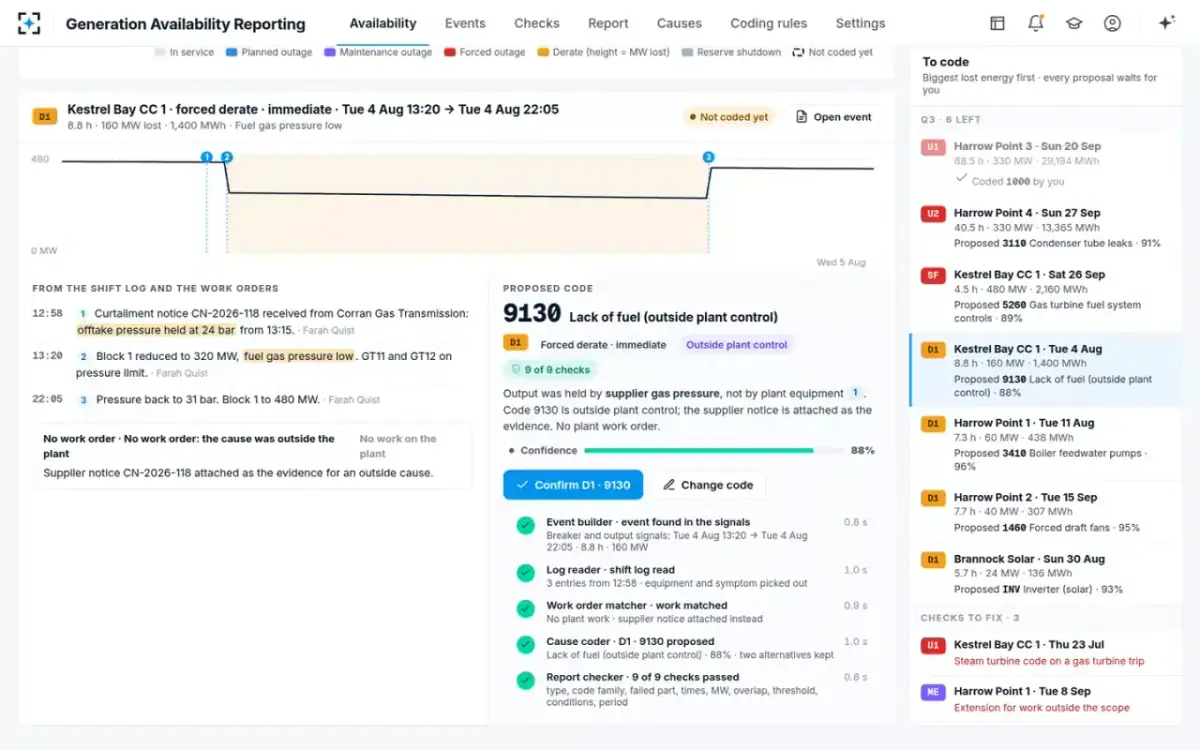

A cause outside the plantA forced derate on a gas curtailment, proposed as 9130 with the supplier's notice attached in place of a work order.

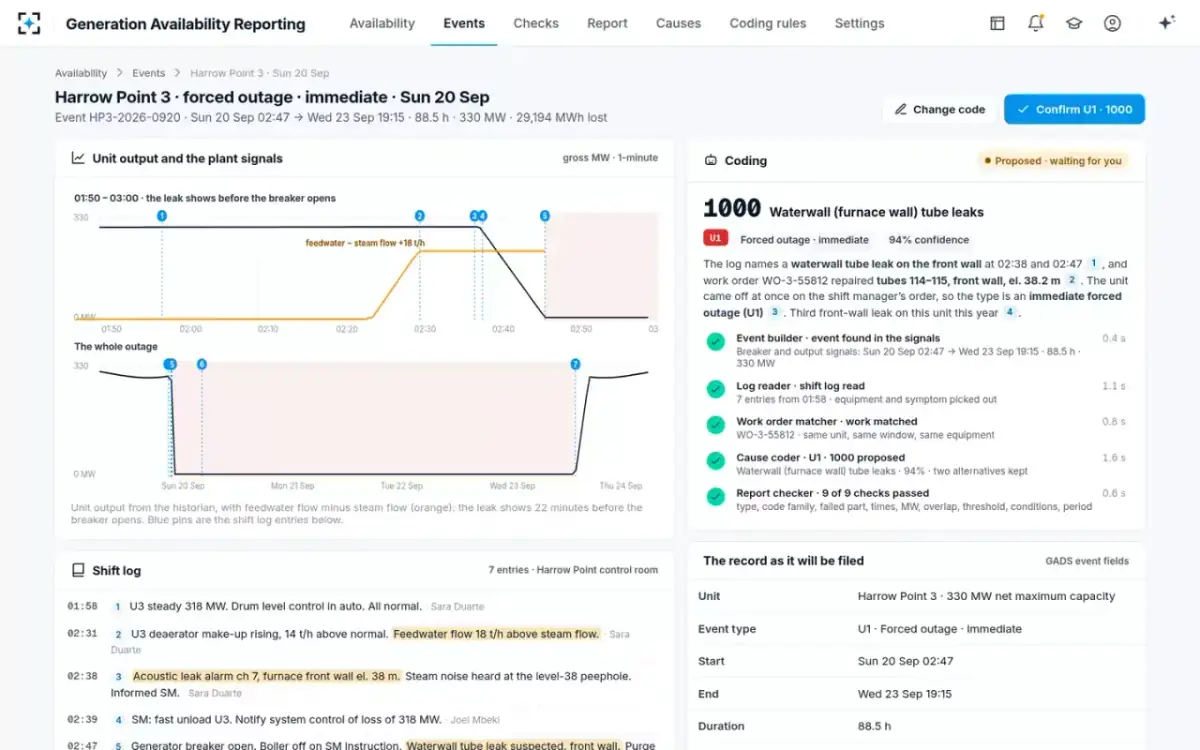

The event recordUnit output and the plant signals, with the log pinned at its minutes. Below are the shift log, the coding with its rationale and the record as it will be filed.

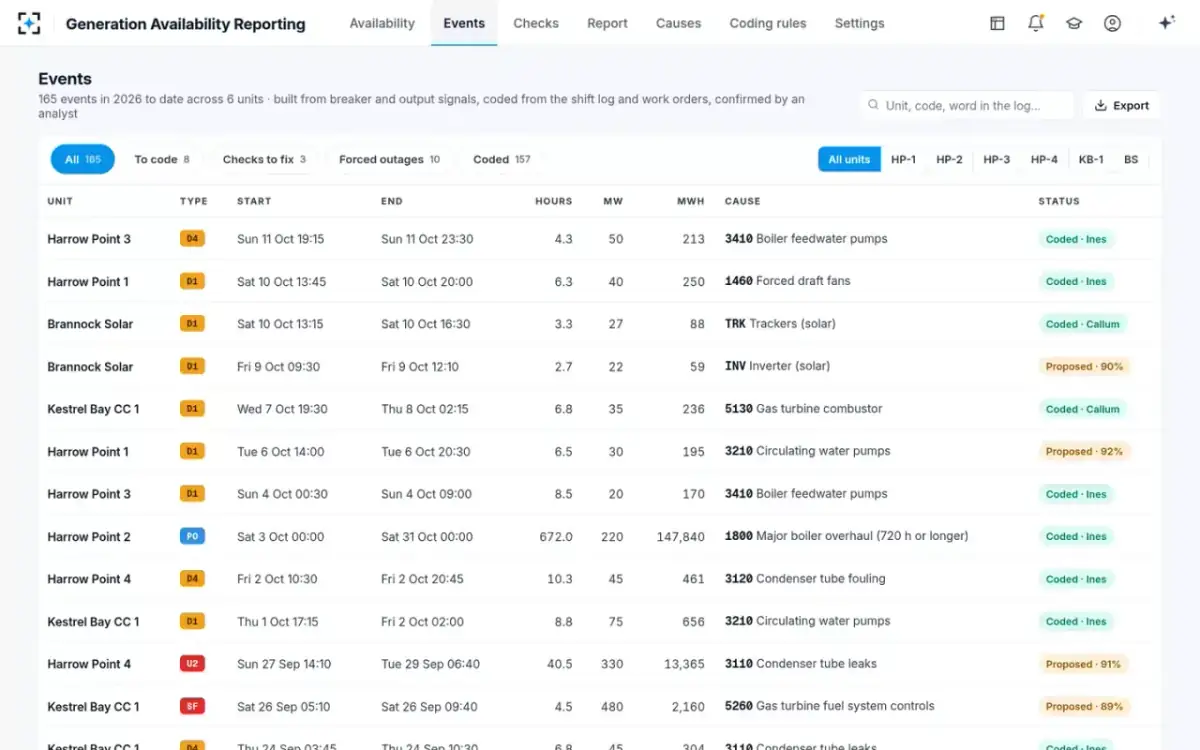

EventsAll 165 events of the year with type, times, hours, MW, MWh, cause and status. Filter by unit or status, search the log text, or export.
Checks before filingThe 12 rules each record must pass, and each failure with its reason and a one-click fix. Also the checker's nightly run and what is left before filing.

A check fixedThe maintenance extension recoded as a forced outage. Rule 03 passes and the count to clear falls.

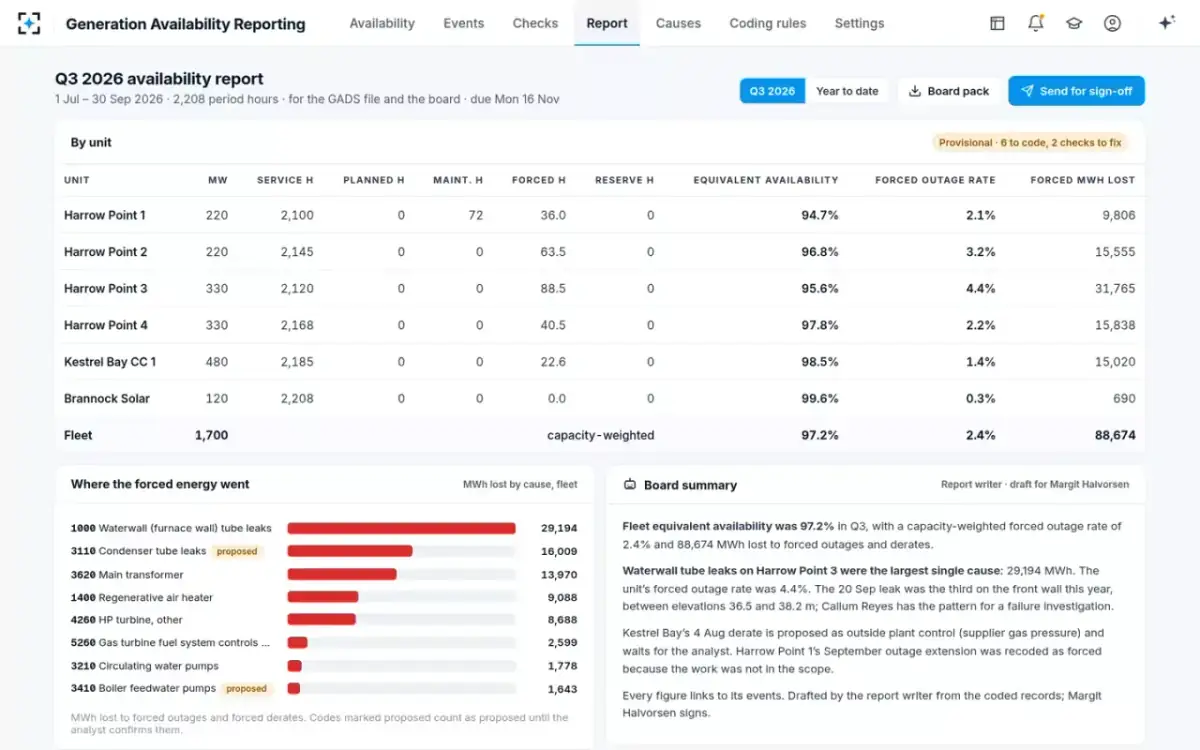

The quarterly availability reportHours, equivalent availability, forced outage rate and forced MWh by unit and fleet, where the forced energy went and the board summary draft.
CausesLost energy by cause code across the fleet, by unit, the cause that keeps coming back and where on the wall each leak was.

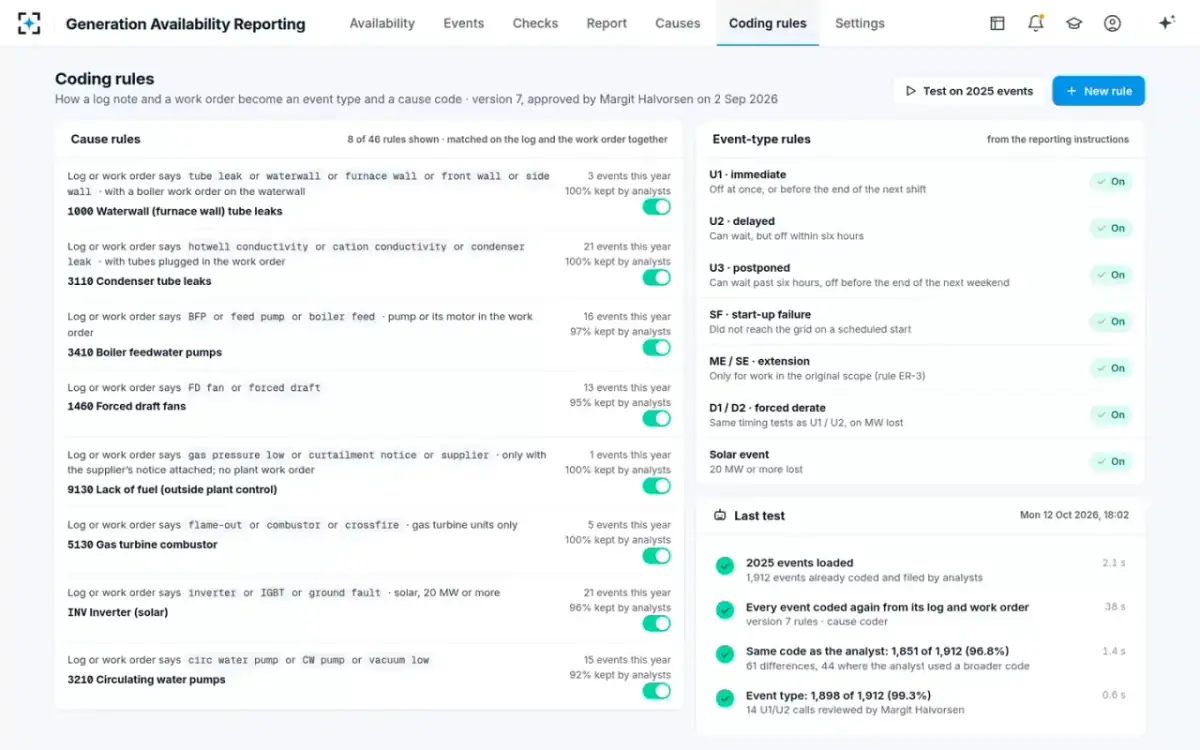

Coding rulesLog and work-order phrases mapped to cause codes, with how often analysts keep them. Also the event-type timing rules and the last test on last year's events.

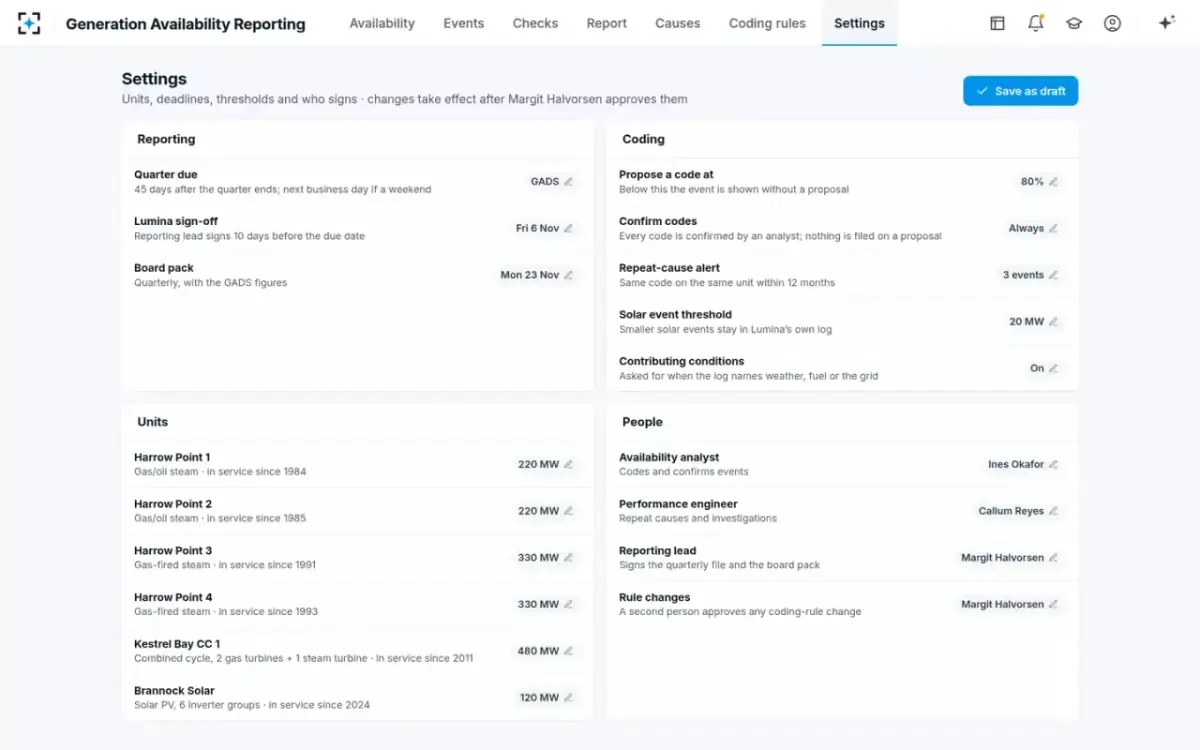

SettingsDeadlines, coding thresholds, units with their capacity, and who codes, investigates and signs.
Governance

Citations, confirmations and sign-off in generation availability reporting

Each code traced to a log line and a work orderEach proposal cites the shift log entries and the work order it rests on, and each figure in the quarterly report links to its events.
The analyst confirms each codeNothing is filed on a proposal. The analyst confirms or changes each code. A different choice and its reason are kept with the record, and undo keeps the history.
Outside causes carry their evidenceA fuel or grid event is coded outside plant control only when the supplier or system operator notice is attached. The gas curtailment notice on the combined-cycle derate is one example.
Twelve rules before the quarter leavesThe quarter can be sent for sign-off only when each record is coded and passes all 12 checks. They cover timing, scope, code family, failed part, signals, MW, thresholds, evidence, overlaps, conditions and hours.
The reporting lead signsThe GADS file and the board pack are built and sent only after the reporting lead signs. Settings changes take effect after the reporting lead approves them.
Rule changes are tested and approvedA coding-rule change needs a second person and a test on last year's events. Version 7 matched the analysts' code on 1,851 of 1,912 of them, 96.8 %. Each agent run and human decision is recorded with its time.
Configuration

Deadlines, thresholds and sign-off for generation availability reporting

Deadlines, thresholds, units and who signs are settings. Changes take effect after the reporting lead approves them.

SettingDefaultChoose from
Quarter dueGADS45 days after the quarter ends, or the next business day if that is a weekend
Internal sign-offBefore filingThe reporting lead signs 10 days before the due date
Board packMon 23 NovQuarterly, with the GADS figures
Propose a code at80 %Below this confidence the event is shown without a proposal
Confirm codesAlwaysEvery code is confirmed by an analyst. Nothing is filed on a proposal
Repeat-cause alert3 eventsSame code on the same unit within 12 months
Solar event threshold20 MWSmaller solar events stay in the utility’s own log
Contributing conditionsOnAsked for when the log names weather, fuel or the grid
Connections

Historian, shift logs, work orders and notices behind each GADS event

SCADA and historiangenerator breaker state, gross and net MW and unit status, at 1-minute resolution
Control-room shift logsone per shift, from each station: the symptom, the alarm and who decided
Maintenance work ordersequipment, failed part and repair, from the maintenance system
Cause code rulesthe reporting instructions, the cause code library and your own coding rules
Supplier and system operator noticesfuel curtailments and grid instructions, for causes outside plant control
GADS file and board packcoded event records with rationale, and the quarterly availability report with equivalent availability (EAF) and forced outage rate (EFOR)
What it changes

Capacity value, analyst days and returned records in availability reporting

Each figure carries its label: a target the solution is built to, an estimate, a typical published result, or a proven one.

target
0records
returned at filing, the design goal. Each event is coded and checked against 12 rules first
62 of 62 events in the sample quarter
coded and checked before filing
demo
$0.5Ma year
of capacity value per 0.3 point of forced outage rate wrongly charged. This is the sample fleet's figure
target
Every
repeat cause named. In the sample year, one cause on one unit was 40% of forced energy lost
66,610 of 165,774 MWh
waterwall leaks, one unit

“demo” = seen in the working solution, on its sample fleet data. “target” = the design goal, measured in the live solution. “estimated” = our estimate of the days split. The 21 and 5.5 analyst days are its two sums. “typical” = published figures. The conventional forced outage rate was 9.2 % in 2025 (NERC State of Reliability 2026, via Utility Dive). NERC Section 1600 makes GADS reporting mandatory for conventional and solar units of 20 MW and up, due 45 days after each quarter (NAES). The solar threshold of 20 MW applies from January 2025 (pv magazine USA, 2024). Cause code numbers are from the sample utility's library. Names on the screens are sample data.

Questions

Generation availability reporting questions from GADS analysts

What is NERC GADS reporting software?

It is software that turns a generating fleet's outages, derates and reserve shutdowns into the event records NERC asks for. NERC is the body that sets reliability rules for the North American grid. Its Generating Availability Data System, GADS, needs each event's type, start and end, MW lost and cause code, each quarter. Generation Availability Reporting adds six agents. They build the events from historian signals, read the shift log and work order, propose the code with its reasons and check each record. The analyst confirms each code and the reporting lead signs.

How does it allocate GADS cause codes?

The cause coder takes the event type from the timing in the log: immediate, delayed, postponed or start-up failure. It takes the cause code from the part that failed in the work order, rather than the alarm that tripped the unit. It writes a rationale citing both, gives a confidence and keeps two alternatives. Below 80 % confidence, it shows the event without a proposal.

How does it check records before the quarter is filed?

The report checker runs 9 checks on each event and 12 rules on the quarter, every night. It catches extensions for work outside the original scope and codes from the wrong equipment family. Times that do not match the breaker, overlapping derates and solar events under 20 MW are caught as well. So are outside causes without their notice and hours that do not reconcile. Each failure comes with a proposed fix that the analyst applies.

Does it handle GADS solar reporting?

Yes. From January 2025, solar plants of 20 MW and up must report, and only events losing 20 MW or more go in the file. The solar threshold is a setting. Smaller events stay in the utility's own log and still count in the board figures.

How does it calculate equivalent availability and forced outage rate?

The report writer works from the coded records only. It computes service, planned, maintenance, forced and reserve hours, equivalent availability, forced outage rate and forced MWh lost. It does this per unit and for the fleet, weighted by capacity. Each figure links to its events, and the rates update as codes are confirmed or fixed.

Can we use it if we are not NERC-registered?

Yes. Utilities outside NERC track the same measures for their regulator, their board and purchase agreements that pay on availability. These are equivalent availability factor, forced outage rate and EFORd under IEEE Std 762. The coding rules, deadlines and thresholds are settings.

Can an agent confirm a code or send the GADS file?

No. The agents propose and draft. They do not confirm a code, change a record or send anything. The analyst confirms each code, and the reporting lead signs before the file is built. Any coding-rule change needs a second person and a test on last year's events.

What do you need from us to code a first quarter?

The Agentic Solution Engine builds and deploys it from your requirements and documents. That means your coding rules, cause code library and unit list, plus a sample of historian data, shift logs and work orders. It goes live once each quality gate has passed. We will walk you through it on one of your own quarters first.

Code one of your own quarters
before the next GADS deadline.

We'll run Generation Availability Reporting on a quarter of your own historian data, shift logs and work orders.
