- Before
- Runs the control system on nights, 8 months in the job, and writes isolations for the field operators. Knows where the procedure is, but not where each valve is.
- Now
- Asks in plain words and gets the approved steps drawn in order on the current drawing. The reason for the order and each valve's history sit beside them.
Power plant procedure search on one feed pump isolation, from alarm to handover
It is night shift on Block 2, a 720 MW combined-cycle unit at a power station. High-pressure boiler feed pump 2B is vibrating, and the fitter is booked for 06:00. Here is what happens next, screen by screen, in the working solution.
A worked example on sample data. Names, IDs and figures on the screens and in this section come from the demo.
- 0102:14

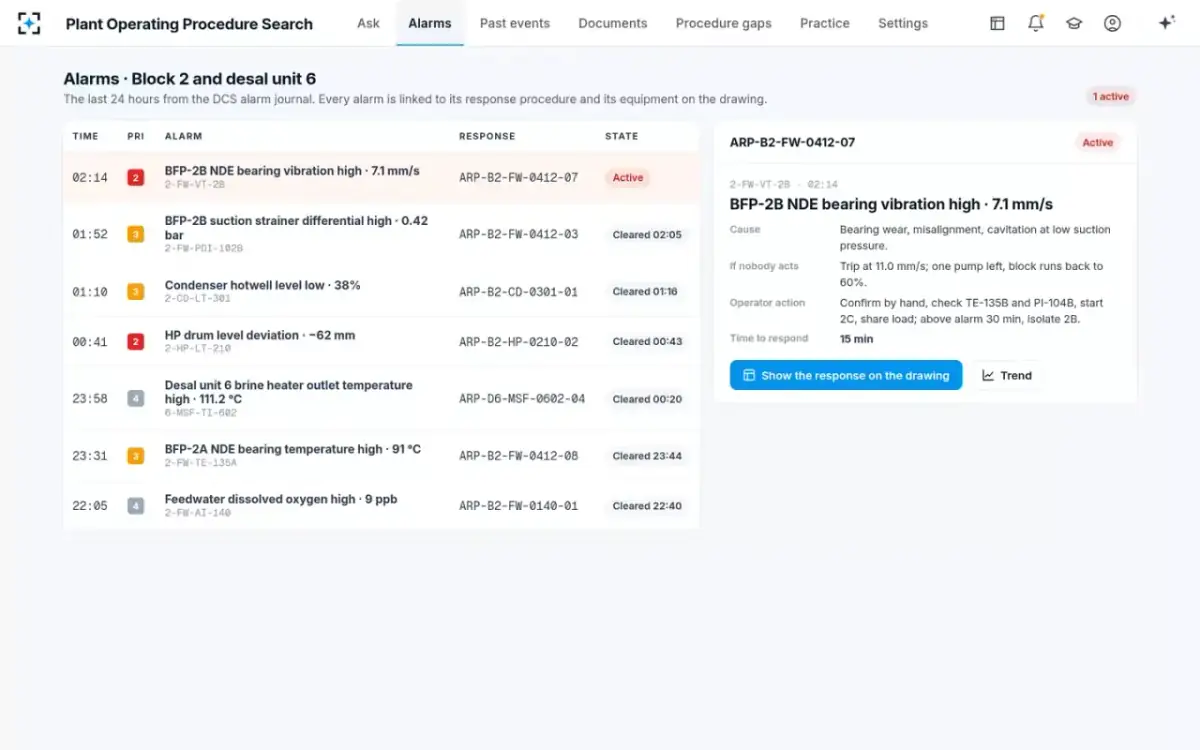

The alarm comes with its response
Control-room operatorFeed pump 2B shows high vibration at the bearing away from the motor, 7.1 mm/s. The plant control system keeps a journal of alarms. Each alarm of the last 24 hours is linked to its alarm response procedure. This one gives the cause, what happens if nobody acts, what the operator should do and the time to respond: 15 minutes.
“If nobody acts: trip at 11.0 mm/s; one pump left, block runs back to 60%.”
- 0202:31

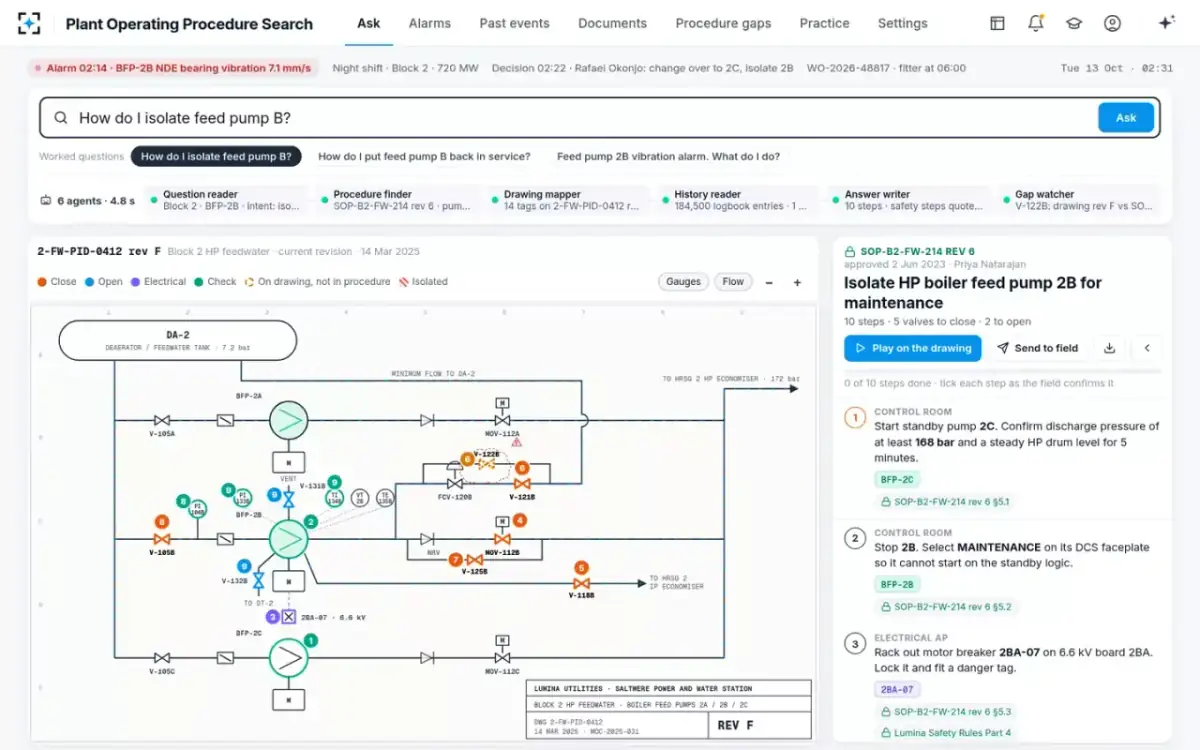

The operator asks how to isolate feed pump B

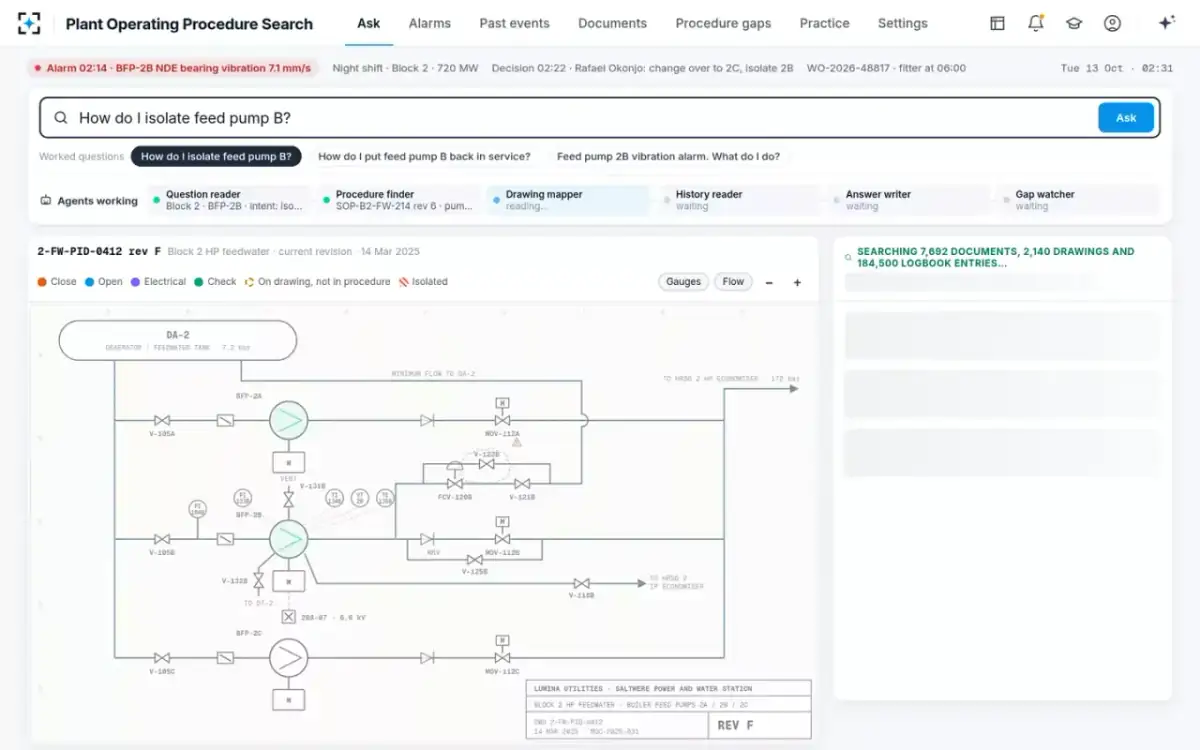

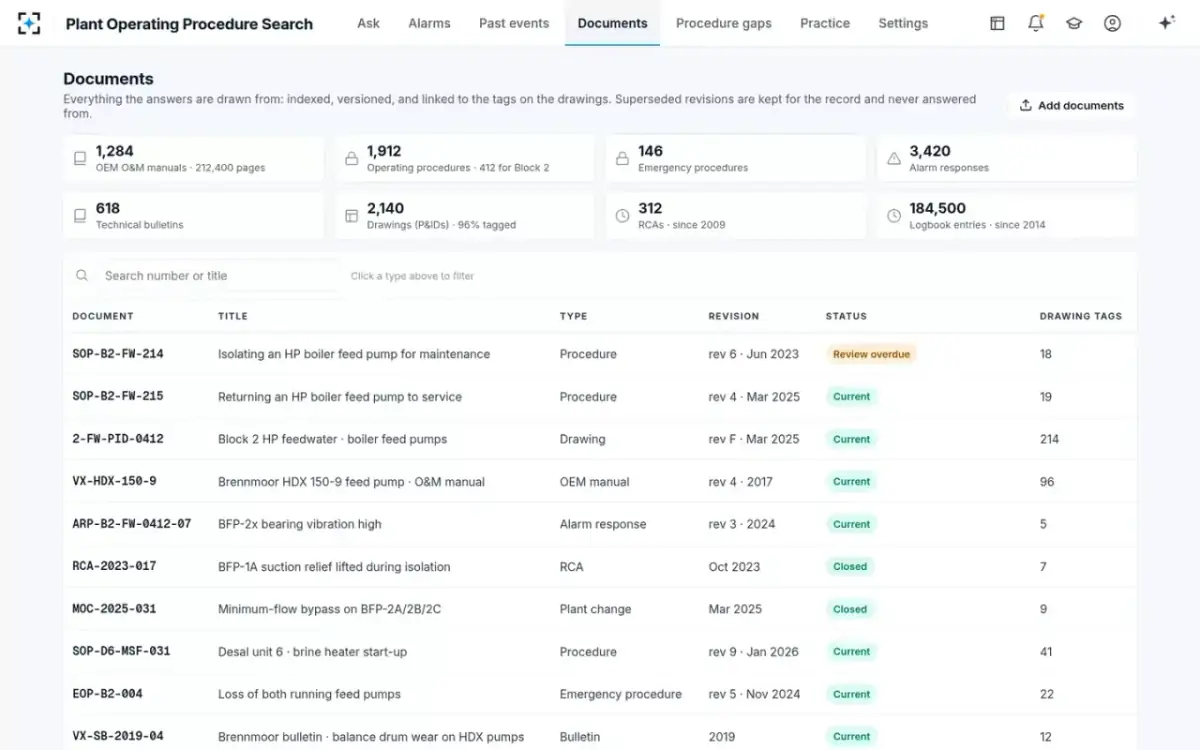

Control-room operator, 8 months in the jobAt 02:22 the shift supervisor decided to switch to standby pump 2C and isolate 2B for its work order. The operator types the question in plain words. The question reader finds Block 2, the pump and the goal, which is to isolate it for maintenance. Then the procedure finder returns the feed pump isolation procedure, revision 6, and §6.3 and §6.5 of the pump manual.
“Searching 7,692 documents, 2,140 drawings and 184,500 logbook entries…”
- 034.8 seconds later
Ten steps with sources, drawn on the plant diagram
Answer writer and Drawing mapperThe answer is the approved revision 6 of the procedure. It has 10 steps, with 5 valves to close and 2 to open, from 7 sources. Each tag is numbered in step order on the current P&ID, revision F. Orange means close, blue means open, and violet marks the pump's breaker on the 6.6 kV board. Each step names who does it and links to its section.
Drawing mapper: “14 tags on the P&ID rev F · 1 not in the procedure”
- 04Play on the drawing

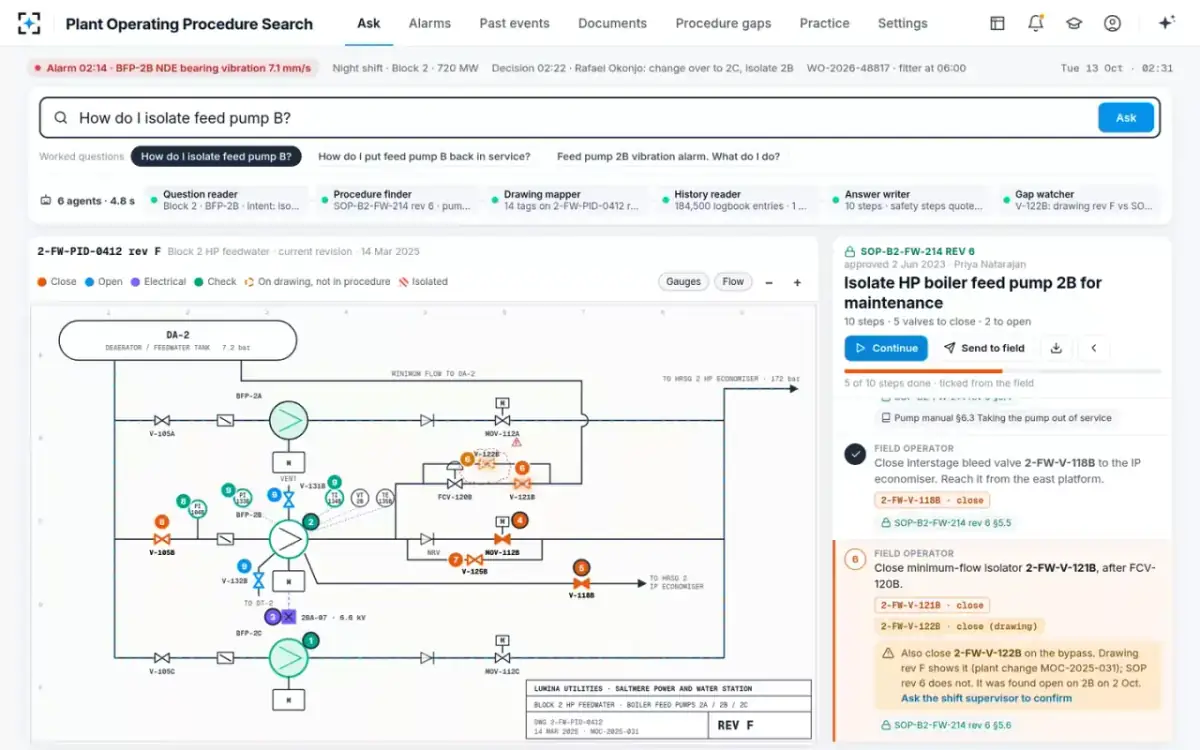

The drawing shows a valve the procedure misses
Control-room operatorPlay walks through the steps one at a time. Each valve pulses, its line stops flowing and the step lights up. At step 6 the minimum-flow isolator has a second valve beside it. A plant change added a bypass 19 months ago, and nobody updated the procedure. The extra valve is drawn in amber, and the step is marked for the shift supervisor.
“Also close the bypass isolator. Drawing rev F shows it (added by a plant change); the procedure rev 6 does not. It was found open on 2B earlier this month.”
- 05One click

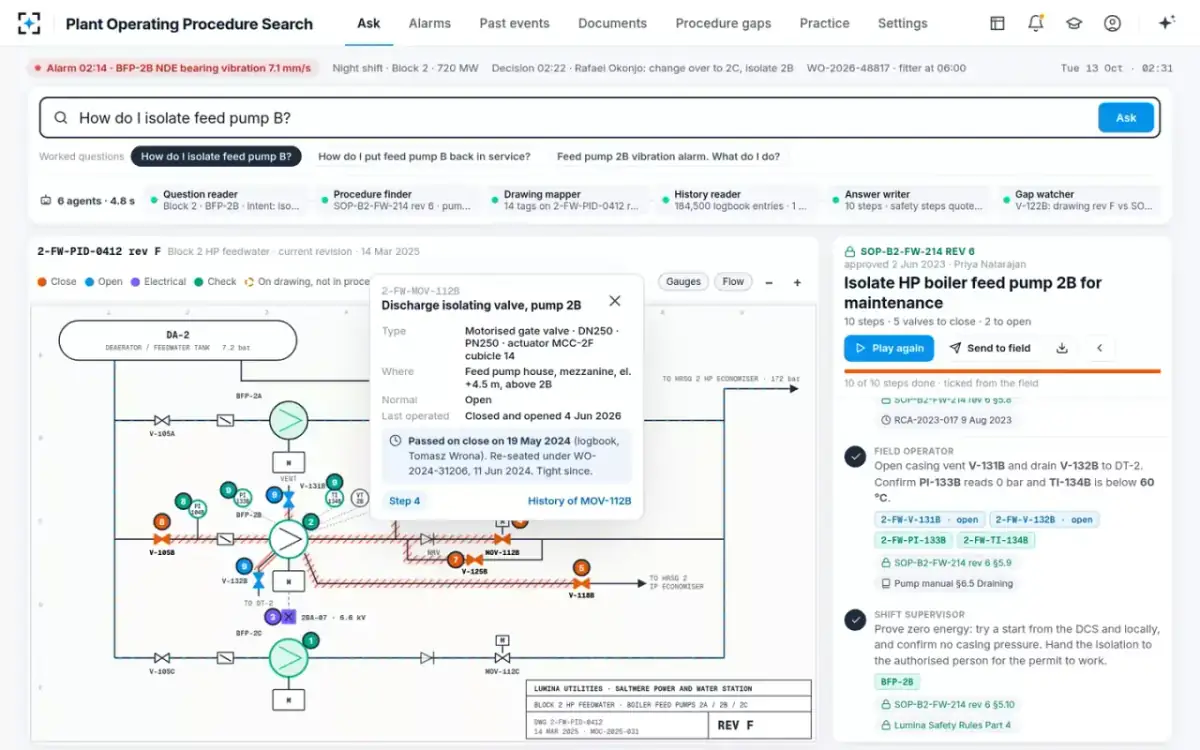

Each valve carries its history

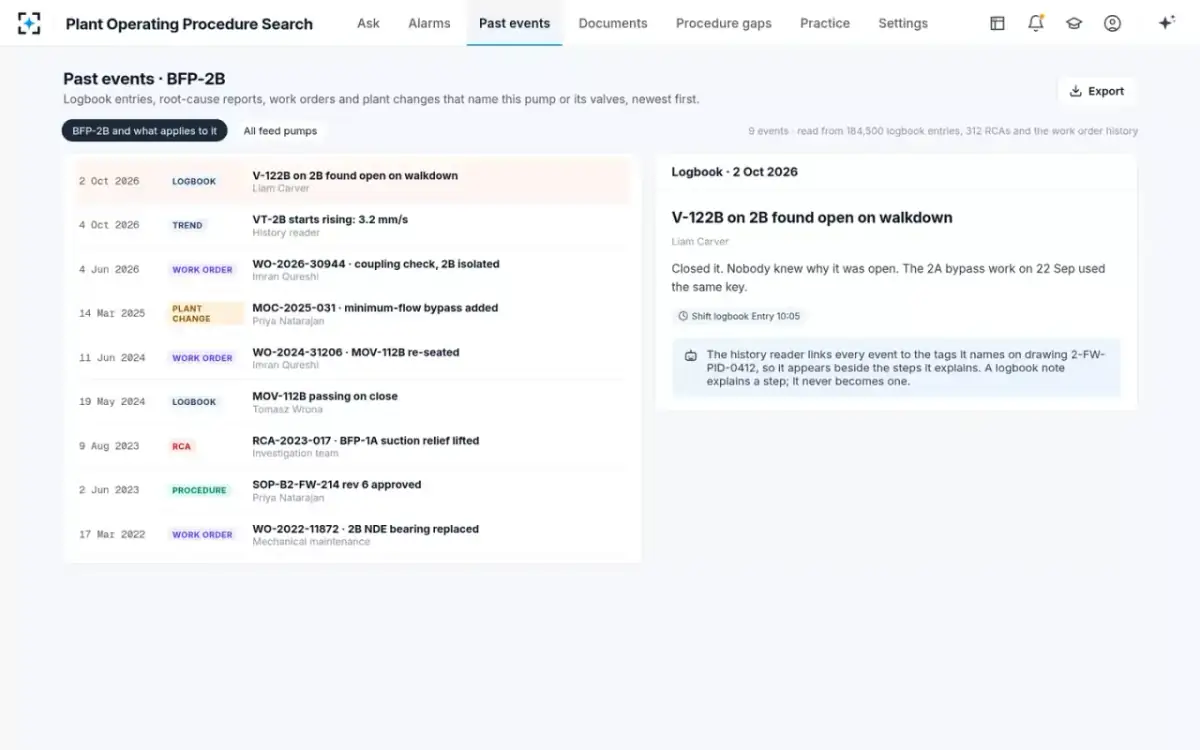

History readerClicking a valve opens its card. The discharge valve is a motorized gate valve, DN250 PN250. It sits on the feed pump house mezzanine at +4.5 m, above 2B, with its actuator's power supply at the motor control center. Its card says it once leaked when shut and was re-seated under a work order a few weeks later. It points back to step 4.
Step 4: “This valve has passed on close before; it was re-seated. Step 8 is your check.”

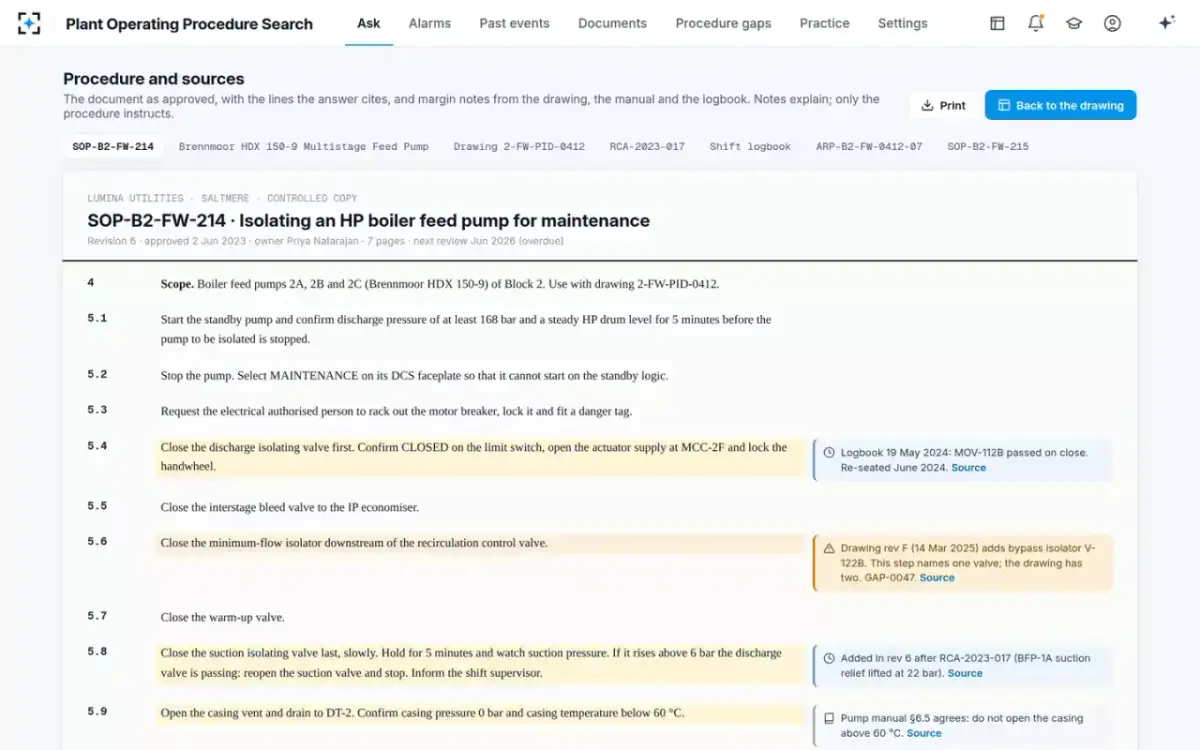

- 06Discharge first, suction last

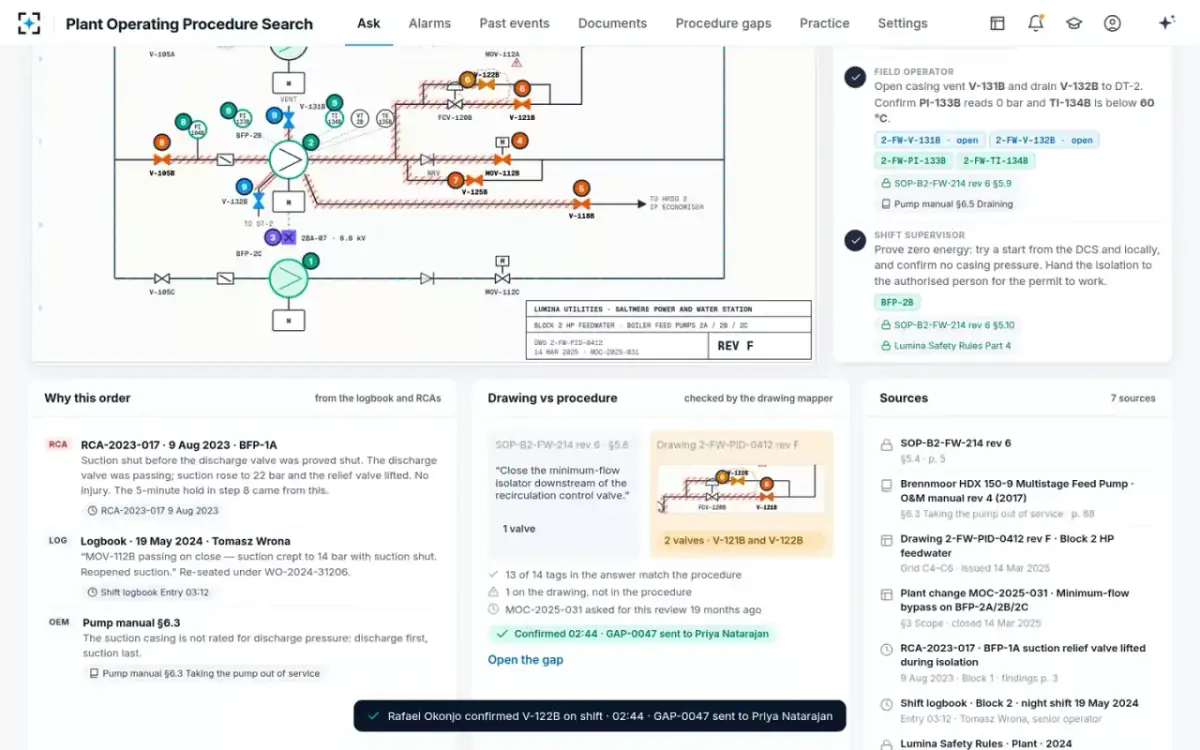

Why the order matters, from the plant's own events
History readerUnder the drawing, the reason for the order sits beside its source. A root-cause report records an earlier event on pump 1A. Its suction relief valve lifted at 22 bar because suction was shut while the discharge valve was leaking. The 5-minute hold in step 8 was added in revision 6. A senior operator's logbook note records the discharge valve on 2B leaking when shut, with suction creeping to 14 bar. The pump manual §6.3 says the suction side is not rated for discharge pressure.
“A logbook note explains a step; it never becomes one.”
- 0702:44
The supervisor confirms the marked step on shift

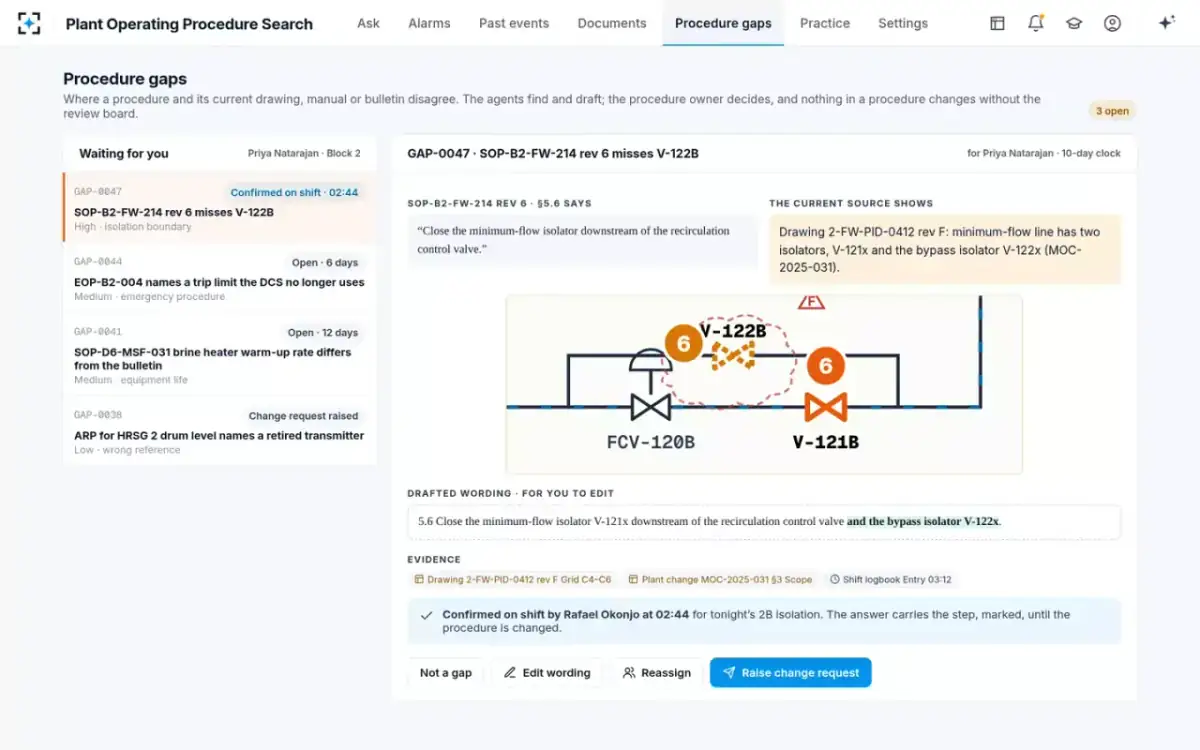

Shift supervisor, Block 2The check of drawing against procedure shows 13 of 14 tags matching. One is on the drawing but not in the procedure. It also shows that the plant change asked for this review 19 months ago. The operator sends it to the shift supervisor with one click. The supervisor confirms the bypass isolator, and a procedure gap goes to the procedure owner.
“Bypass isolator confirmed on shift · 02:44 · gap sent to the procedure owner”
- 08Sent to the field
The sheet goes to the tablet, and the section is isolated

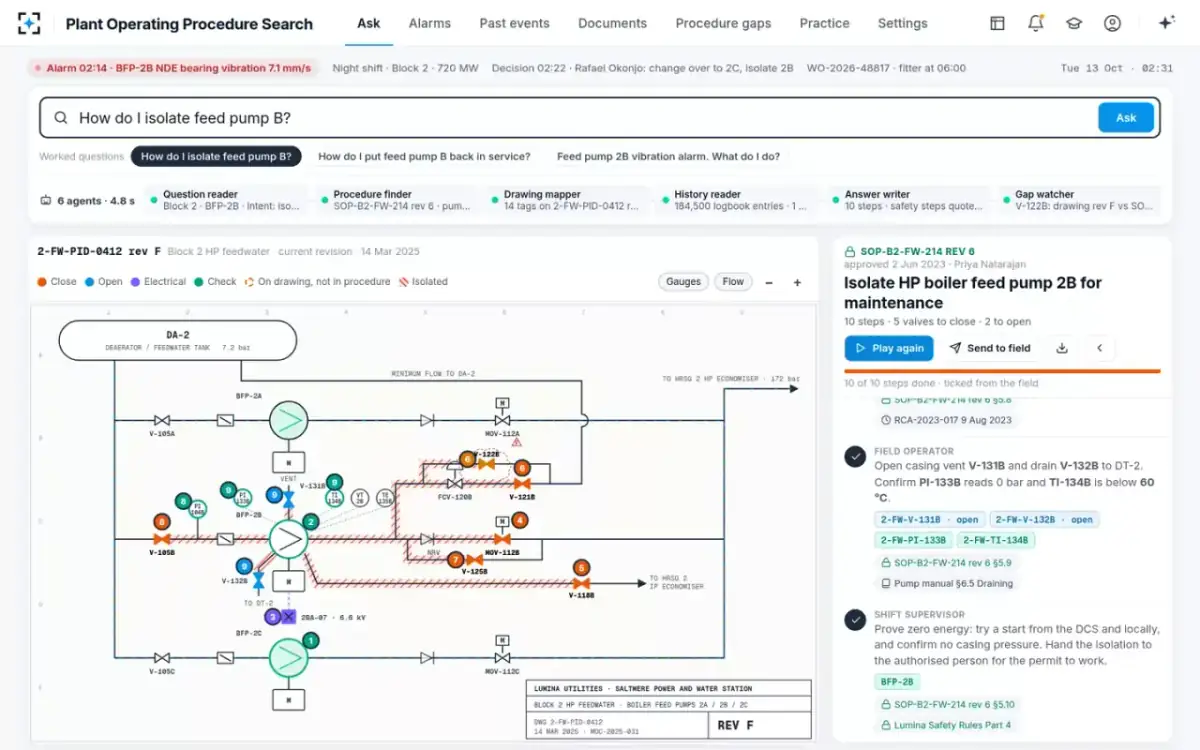

Field operatorSend to field puts all 10 steps, with the drawing, on the field operator's tablet. The field operator ticks each one as it is done. Then the isolated section of pipe is hatched on the drawing. The casing vent and drain are open, the pressure gauge reads 0 bar and the temperature is below 60 °C. The shift supervisor proves zero energy and hands the isolation over to the authorized person for the permit to work.
“2B isolated on the drawing · 5 valves closed in order · ready to prove zero energy”
- 09On a 10-day clock
The gap arrives with evidence and drafted wording
Operations engineer, procedure ownerThe gap lands in the procedure owner's queue, due in 10 days. It sets what §5.6 of the procedure says beside what the current drawing shows. It crops the drawing at grid C4 to C6 and drafts new wording to edit. The evidence is the drawing, §3 of the plant change and the shift logbook. Nothing in the procedure changes until the owner raises a change request and the review board approves.
Drafted: “5.6 Close the minimum-flow isolator downstream of the recirculation control valve and the bypass isolator.”
- 10Before the next isolation

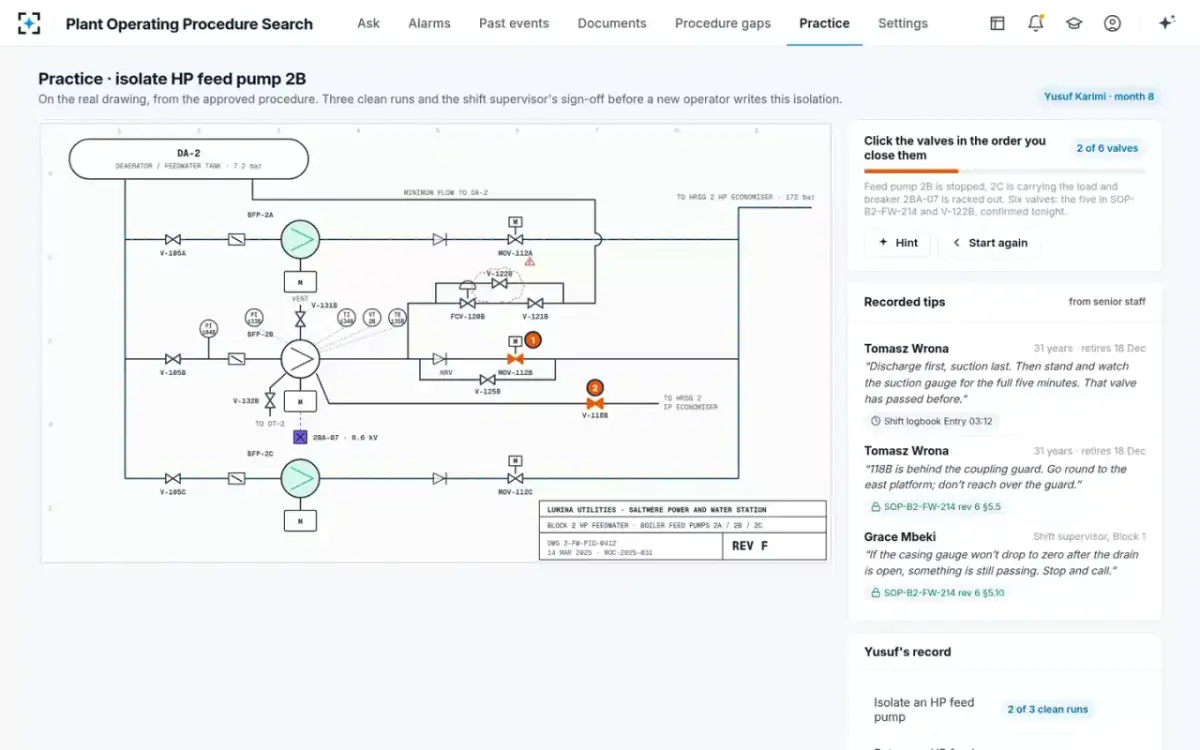

Practice on the real drawing, with the senior operator's tips
Trainee recordPractice asks the operator to click the valves in the order they are closed, on the real drawing. It uses the approved procedure plus the bypass isolator confirmed tonight. Beside it are tips recorded from senior staff, each with its source. The operator has 2 of 3 clean runs for a high-pressure feed pump isolation. They have practiced 14 of 22 Block 2 isolations.
Senior operator, 31 years: “Discharge first, suction last. Then stand and watch the suction gauge for the full five minutes. That valve has passed before.”
