- Before
- Owns yield and revenue for a large solar plant. Cleaning runs on a fixed calendar, and losses are explained weeks later. Needs to know where yesterday's megawatt-hours went, more than another alarm.
- Now
- Opens a waterfall each morning with each loss in MWh and dollars. Sets a cleaning plan when it pays back, and sends each case with the energy at stake.
Solar PV performance monitoring software on the morning after a dust storm
The sample plant is a large solar plant in 12 blocks. Its panels sit on single-axis trackers, frames that turn to follow the sun. Last Friday a dust storm crossed its western half. It is now Tuesday, 07:10. Here is what happens next, screen by screen, in the working solution.
A worked example on sample data. Names, IDs and figures on the screens and in this section come from the demo.

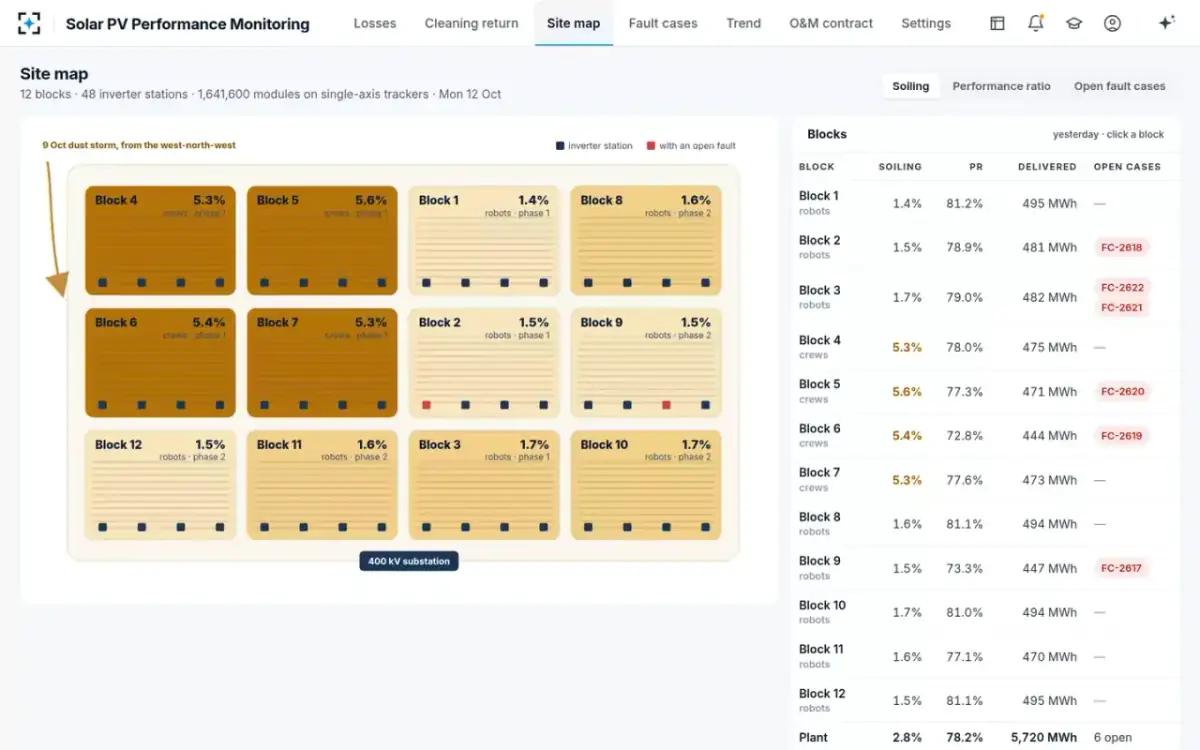

- 0107:10

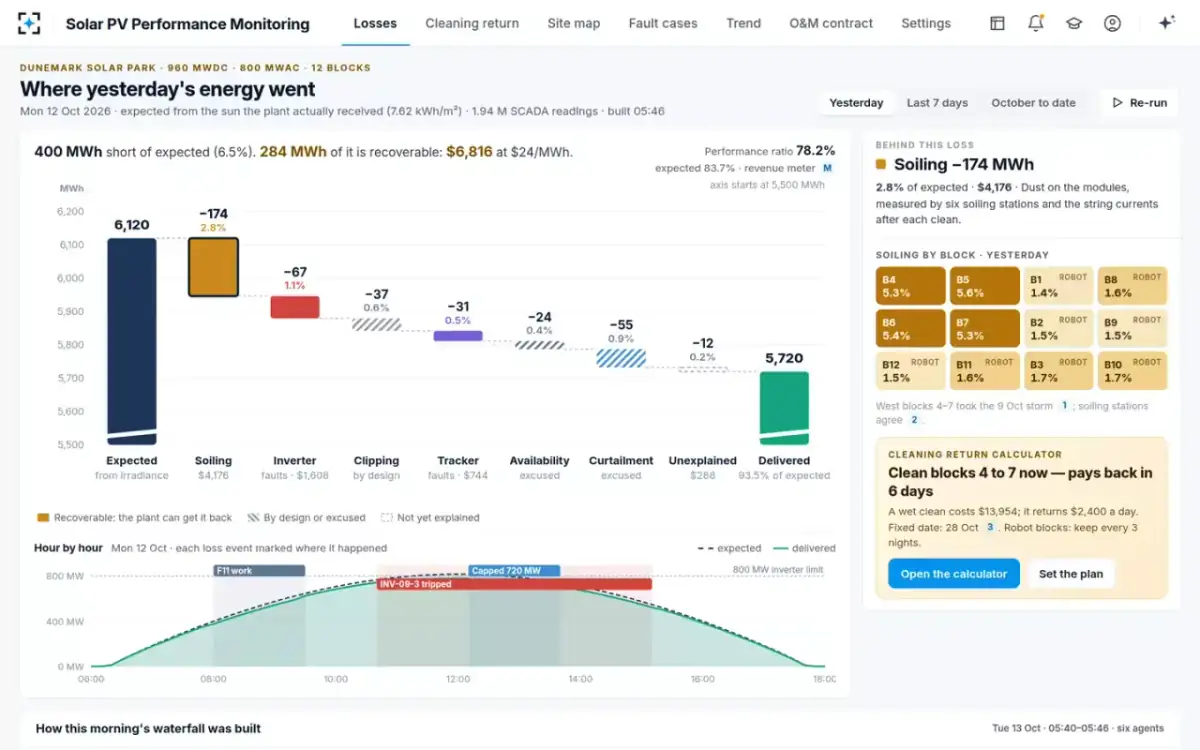

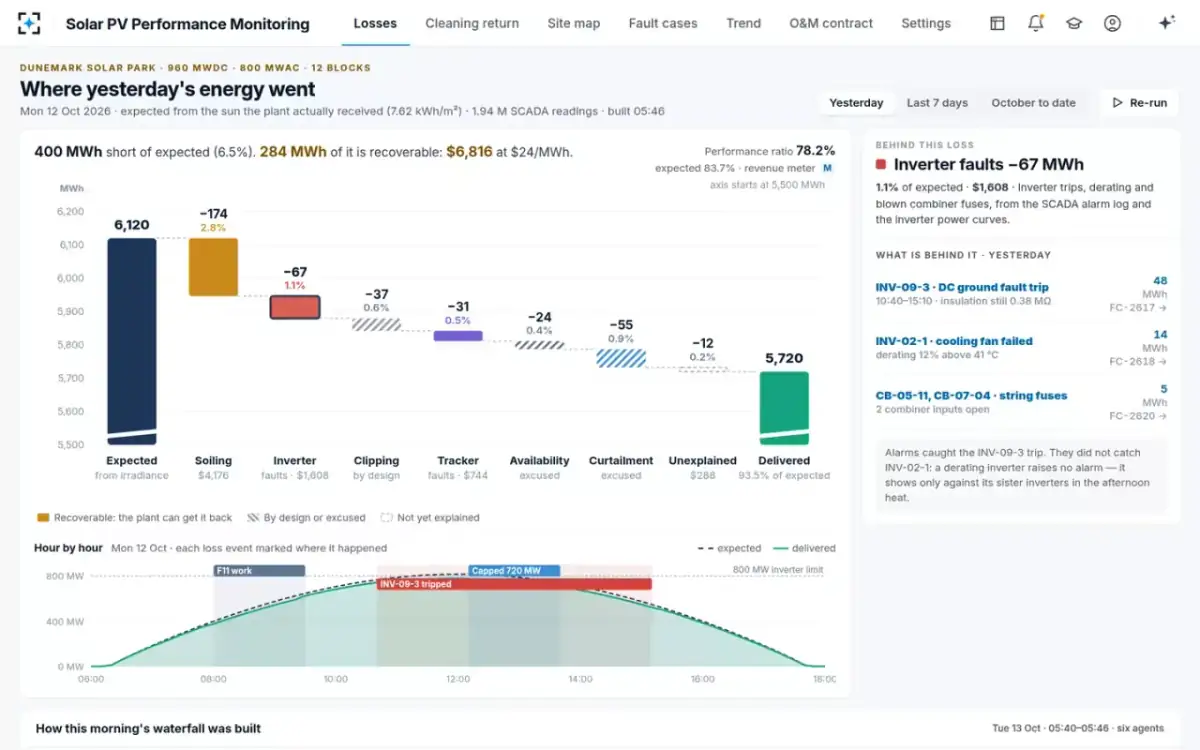

Yesterday's energy, from expected to delivered
Solar asset managerThe asset manager owns the plant's yield and revenue. The morning opens on one waterfall chart, with a step for each loss from expected to delivered. The plant received 7.62 kWh/m² of sun, so it should have made 6,120 MWh. The revenue meter shows 5,720 MWh. The plant was 400 MWh short (6.5 %), and 284 MWh of that can be recovered: $6,816 at $24/MWh. Soiling, the dirt on the panels, is the largest step down. It cost 174 MWh, 2.8 %, or $4,176. Blocks 4 to 7 are at 5.3 to 5.6 %, and the robot blocks at 1.4 to 1.7 %.
Built between 05:40 and 05:46 by six agents from 1.94 M SCADA readings. One sun sensor (a pyranometer) was left out because it read 3.1 % low against its neighbors.
- 02One click
Inverter faults: three causes, one the alarms missed
Loss attribution analystThree causes sit behind the 67 MWh inverter loss ($1,608). An inverter in block 9 tripped on a DC ground fault from 10:40 to 15:10 and lost 48 MWh. Its insulation is still at 0.38 MΩ. An inverter in block 2 cuts its output by 12 % above 41 °C because a cooling fan failed (14 MWh). Two combiner inputs, in blocks 5 and 7, have open string fuses (5 MWh). Each one links to its fault case.
“Alarms caught the block 9 trip. They did not catch the block 2 inverter: a derating inverter raises no alarm and shows only against its sister inverters in the afternoon heat.”

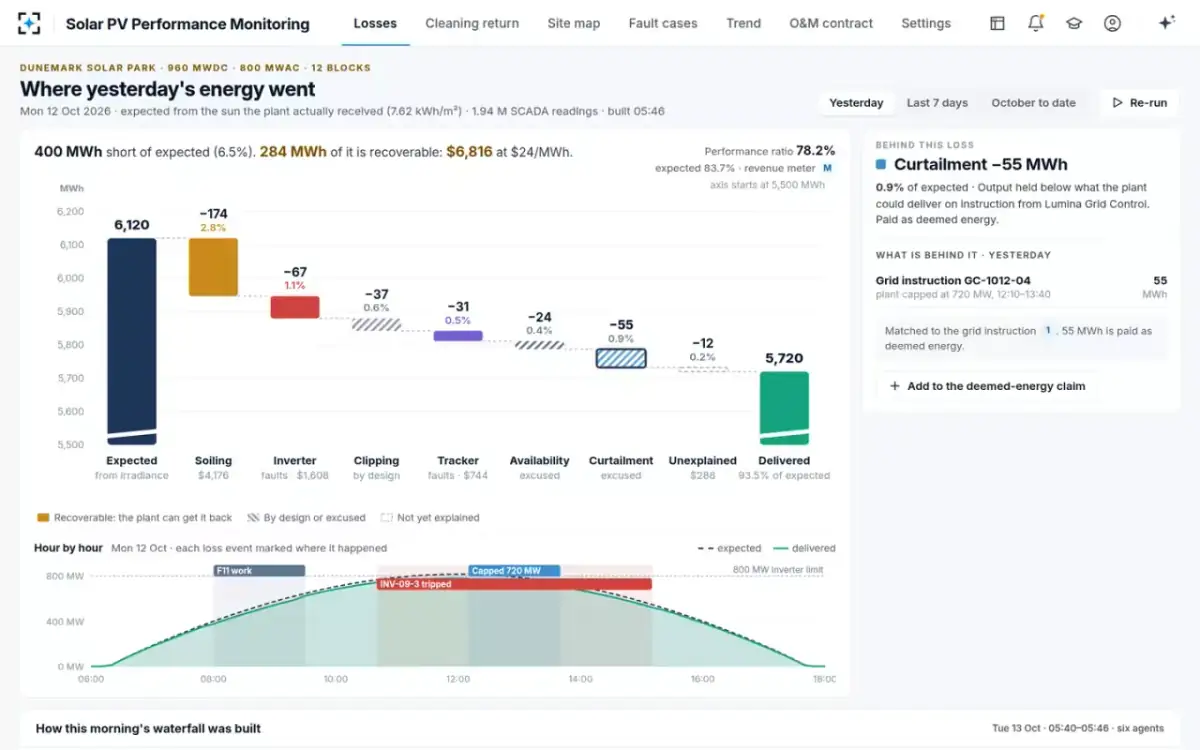

- 03Excused, by design
Curtailment matched to the grid instruction
Loss attribution analystThe 55 MWh curtailment step is hatched, which marks a loss that is by design or excused. Curtailment means the grid asked the plant to produce less. The analyst matched it to an instruction from the grid operator that capped the plant's output from 12:10 to 13:40. The setting Deemed energy, claimable is on. So the 55 MWh is paid as deemed energy, as if the plant had made it. The asset manager can add it to the deemed-energy claim from the side panel.
Unexplained: 12 MWh (0.2 %). That is under the 0.5 % limit, so it stays unexplained instead of being moved into a named loss.

- 04The calculator
Clean blocks 4 to 7 now: it pays back in 6 days
Cleaning return plannerBlocks 4 to 7 are cleaned by crews. They were last cleaned two weeks ago and are next due on a fixed date two weeks out. The dust is taking 100 MWh a day that a clean would return, worth $2,400 a day. A wet clean costs $13,954: crew labor $11,280, 219 m³ of water $679, and vehicles and supervision $1,995. It pays back in 5.8 days. By the fixed date it nets $20,846, when soiling would otherwise have reached 8.4 %.
“The calculator re-runs each morning after the soiling estimate. A plan is proposed only when it pays back inside 10 days.”

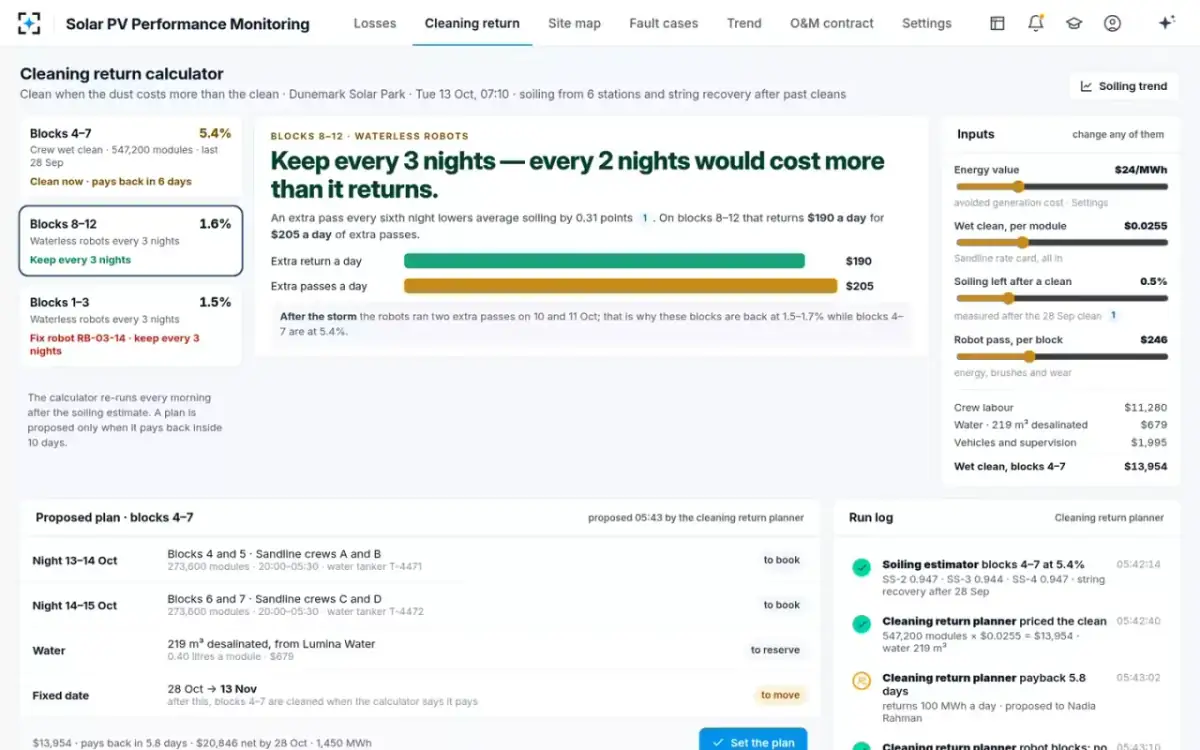

- 05And when not to
The robot blocks stay at one pass each 3 nights
Cleaning return plannerThe same calculator says when a clean does not pay. On blocks 8 to 12, an extra robot pass each sixth night would lower average soiling by 0.31 points. It would return $190 a day for $205 a day of extra passes. The robots already ran two extra passes on the two nights after the storm. Block 3 has higher soiling because one robot is stuck on its rail. That gets a fault case, and the schedule stays the same.
“Keep every 3 nights: every 2 nights would cost more than it returns.”

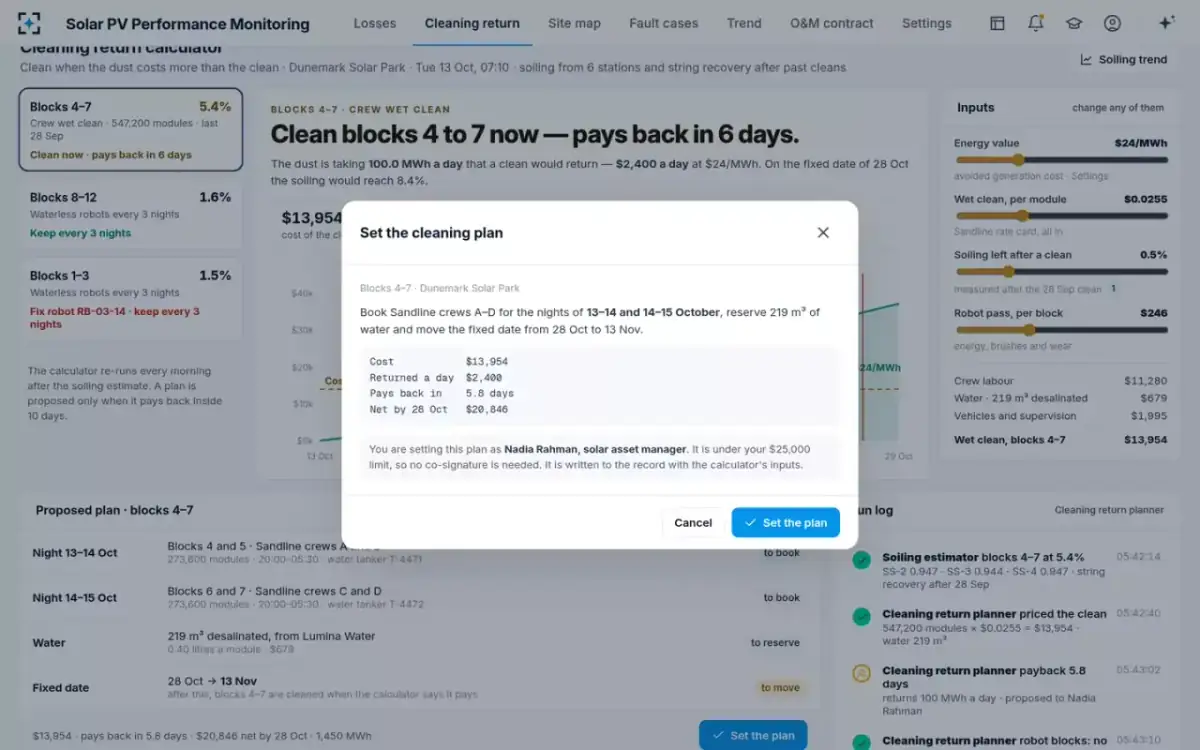

- 0607:24
The asset manager sets the plan, inside the limit
Solar asset managerThe plan books the contractor's crews A to D for tonight and tomorrow night. It reserves 219 m³ of water and moves the fixed date back about two weeks. The confirmation shows the cost, the daily return, the payback and the net by the old fixed date. The asset manager's limit is $25,000. Above it, the head of generation co-signs.
“It is under your $25,000 limit, so no co-signature is needed. It is written to the record with the calculator's inputs.”

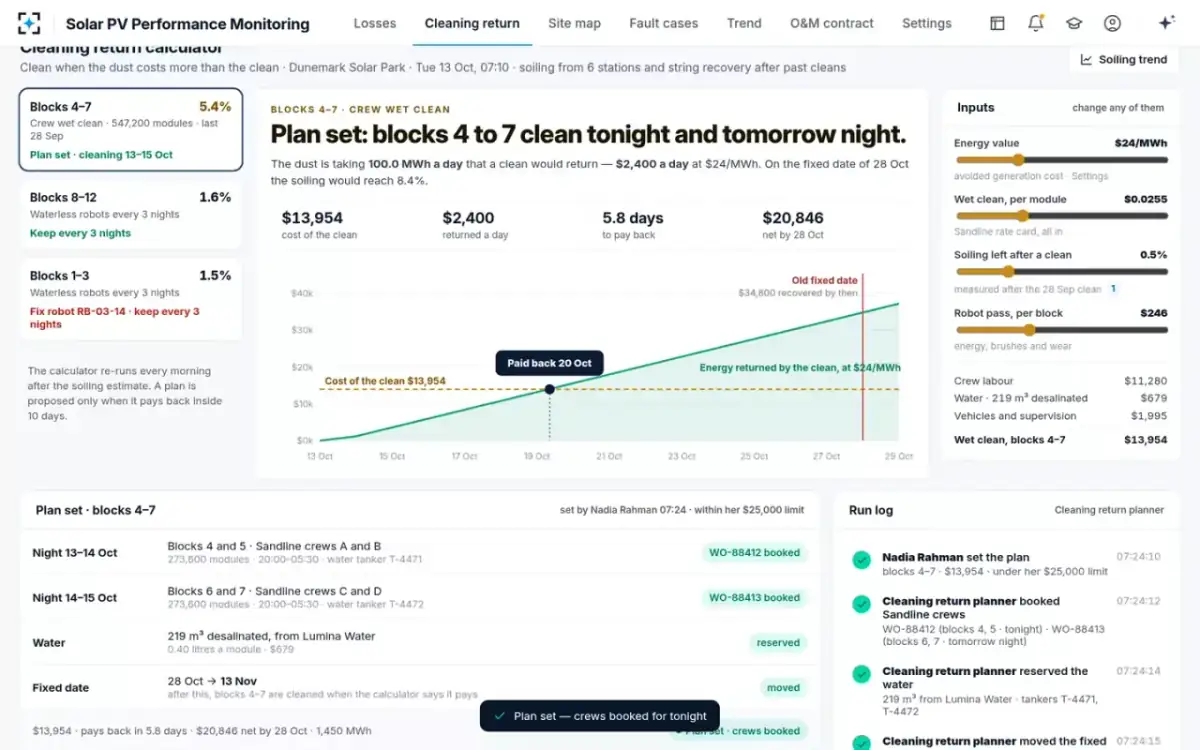

- 07Plan set
Crews booked for tonight, water reserved
Cleaning return plannerThe planner books nothing until the asset manager sets the plan. Then it books one work order for blocks 4 and 5 tonight and one for blocks 6 and 7 tomorrow night. It reserves 219 m³ of water on two tankers and moves the fixed date. At 07:26 the O&M contractor confirms crews A and B on site at 19:30.
The planner proposes only: it books no crew or robot run until the asset manager sets the plan.

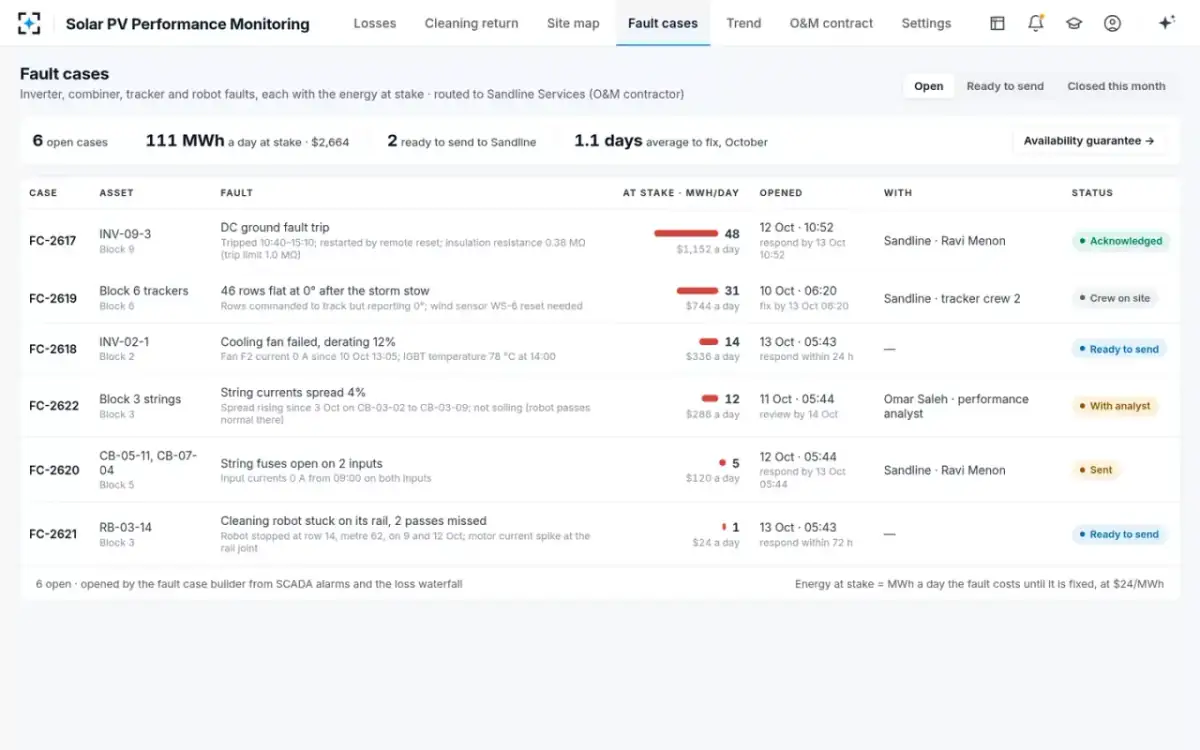

- 08Fault cases
Six open cases, each with the energy at stake
Fault case builderInverter, combiner, tracker and robot faults become cases for the O&M contractor. There are 6 open, with 111 MWh a day at stake ($2,664). Two are ready to send, and faults this month took 1.1 days on average to fix. In one case, 46 tracker rows in block 6 stayed flat at 0° after the storm, and a crew is on site. The block 2 inverter fan and the stuck robot wait for a person to send them.
“Energy at stake = MWh a day the fault costs until it is fixed, at $24/MWh.”

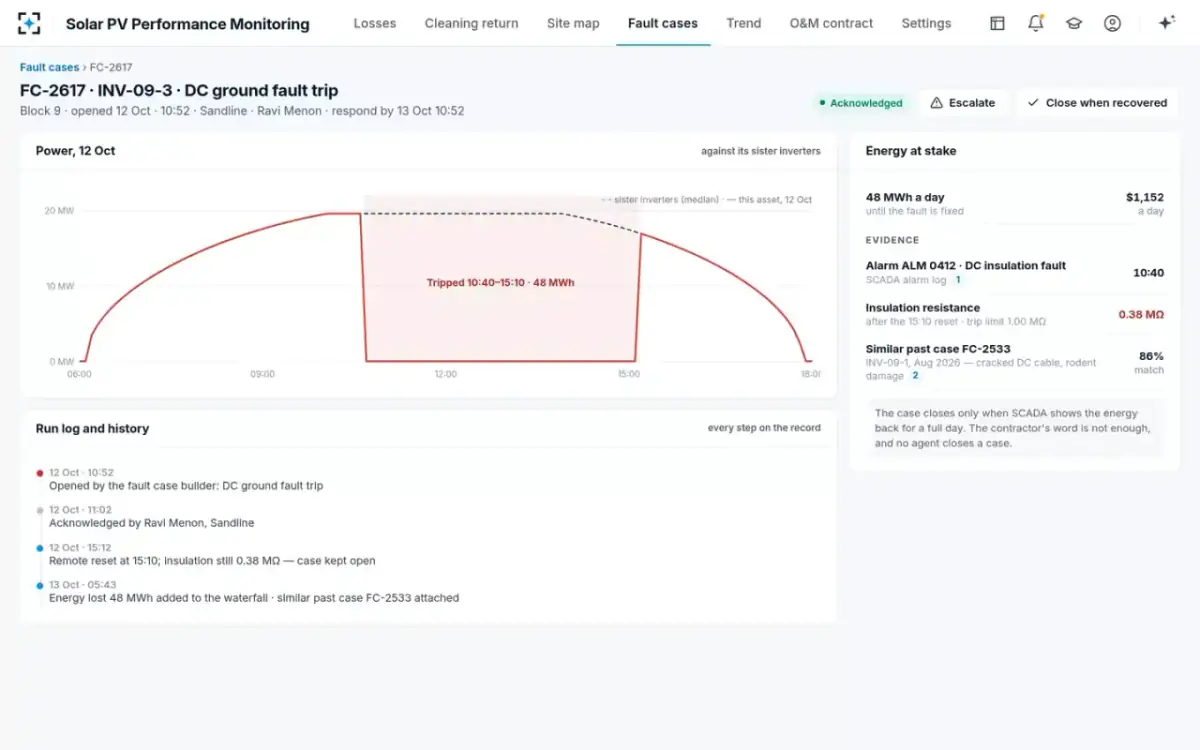

- 09The ground fault case
The ground fault, with its evidence and a past case
Site supervisor, O&M contractorThe case shows the block 9 inverter's power against its sister inverters yesterday, with the 48 MWh trip shaded. Then comes the evidence. The DC insulation fault alarm went off at 10:40. After the 15:10 reset, insulation resistance was 0.38 MΩ against a 1.00 MΩ trip limit. A similar past case on a sister inverter in August, an 86 % match, was a cracked DC cable. The contractor's site supervisor acknowledged the case at 11:02.
“The case closes only when SCADA shows the energy back for a full day. The contractor's word is not enough, and no agent closes a case.”

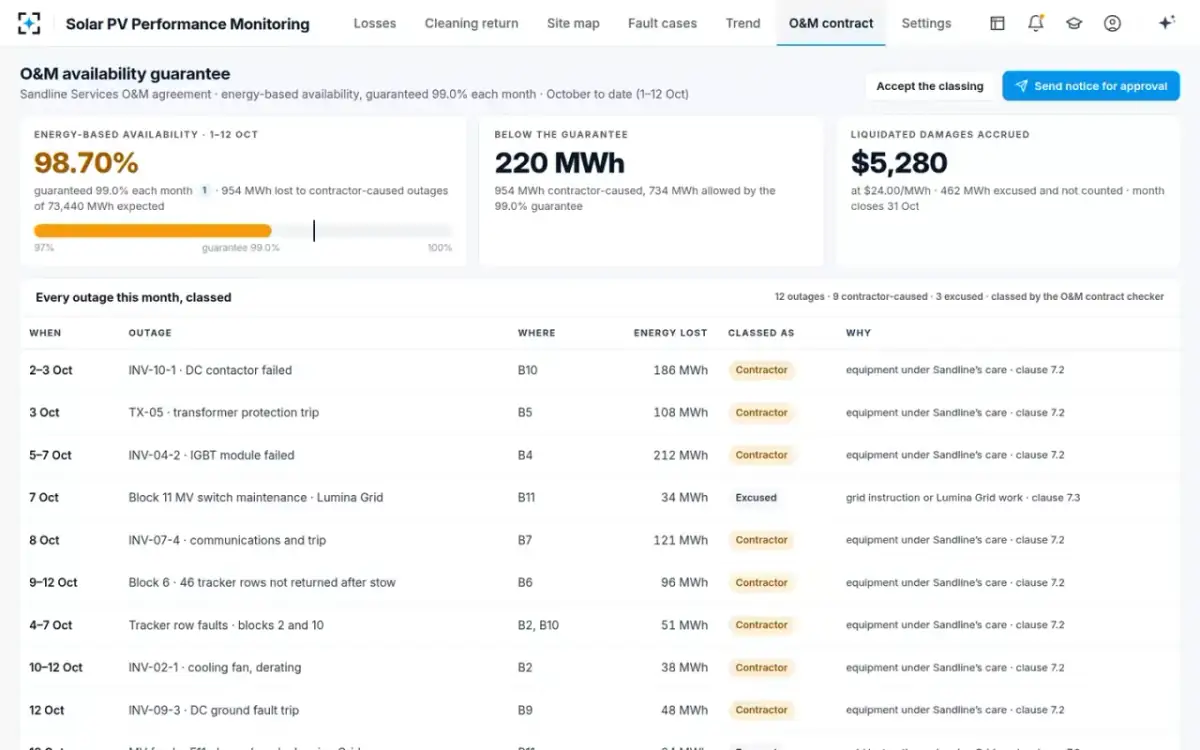

- 10Month to date
Availability against the O&M guarantee
Head of generationThe O&M contract checker has classed all 12 outages of the month so far. Nine were caused by the contractor, under clause 7.2. Three were excused under clause 7.3, for the grid operator's feeder and switch work and 7 grid instructions. Availability, measured by energy, is 98.70 % against the 99.0 % guarantee. Outages caused by the contractor lost 954 MWh, which leaves the plant 220 MWh below the guarantee. That has built up $5,280 in liquidated damages, the penalty the contract sets. The notice goes to the head of generation for approval.
The contract checker drafts only; the head of generation approves each notice.
