- Before
- Runs four to six bids at once, chasing experts, editing and reformatting. What helps most is knowing which section will miss Friday.
- Now
- Sees the forecast finish against the deadline, accepts the replan when a section slips, and approves each section with a reason code.
A health system's 184-question RFP, replanned two days before it is due
An 11-hospital health system has sent an RFP for EHR integration and interoperability services. EHR means electronic health record, the system that holds patient charts. The bid has 184 questions, covers five years and is worth $4.82M. It is due Friday at 17:00, and today is Wednesday, 09:40. Here is how the proposal manager works with the agents, screen by screen, in the working solution.
A worked example on sample data. Names, IDs and figures on the screens and in this section come from the demo.
- 01Wednesday, 09:40
The whole RFP on one board, and the section that will miss Friday

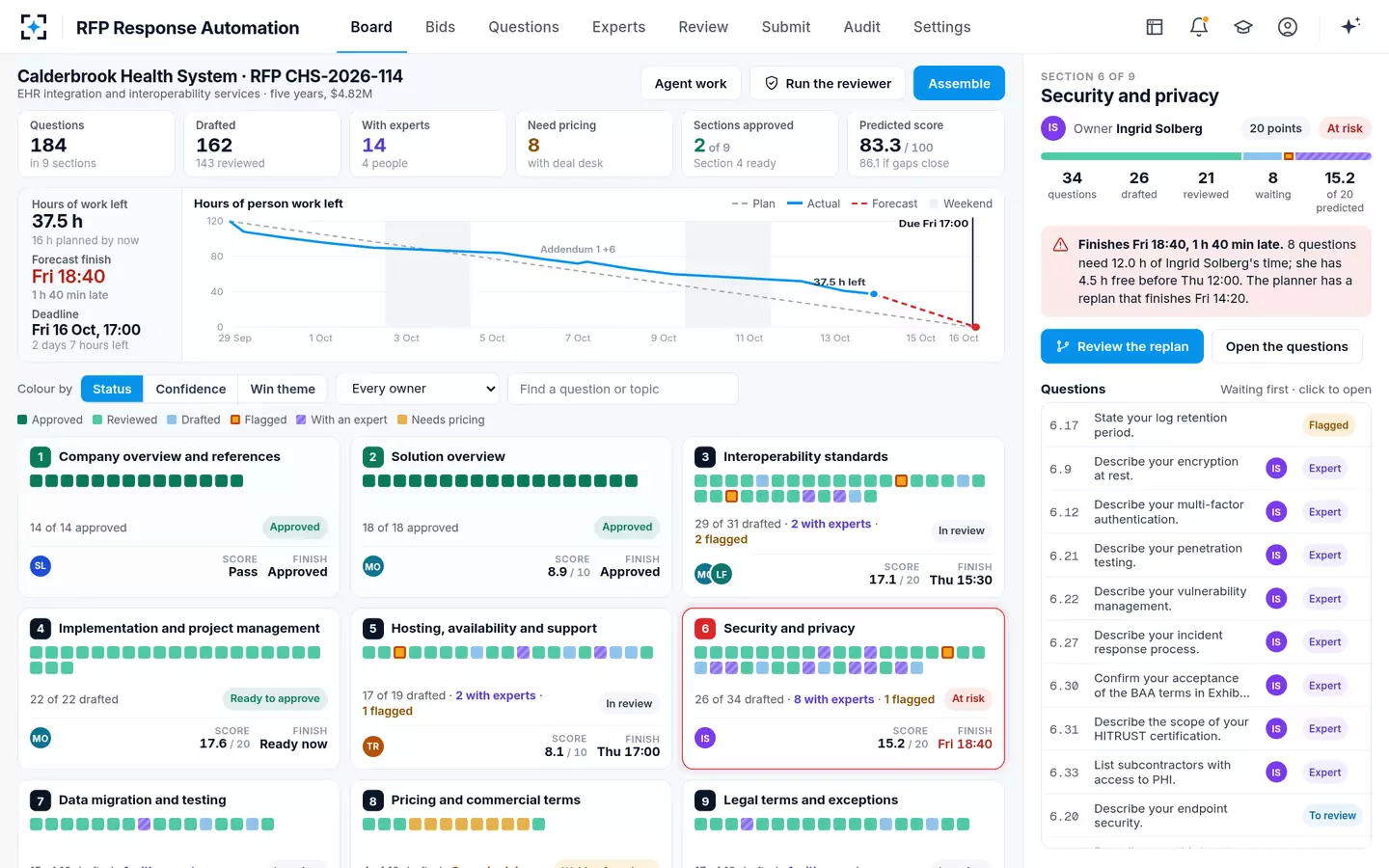

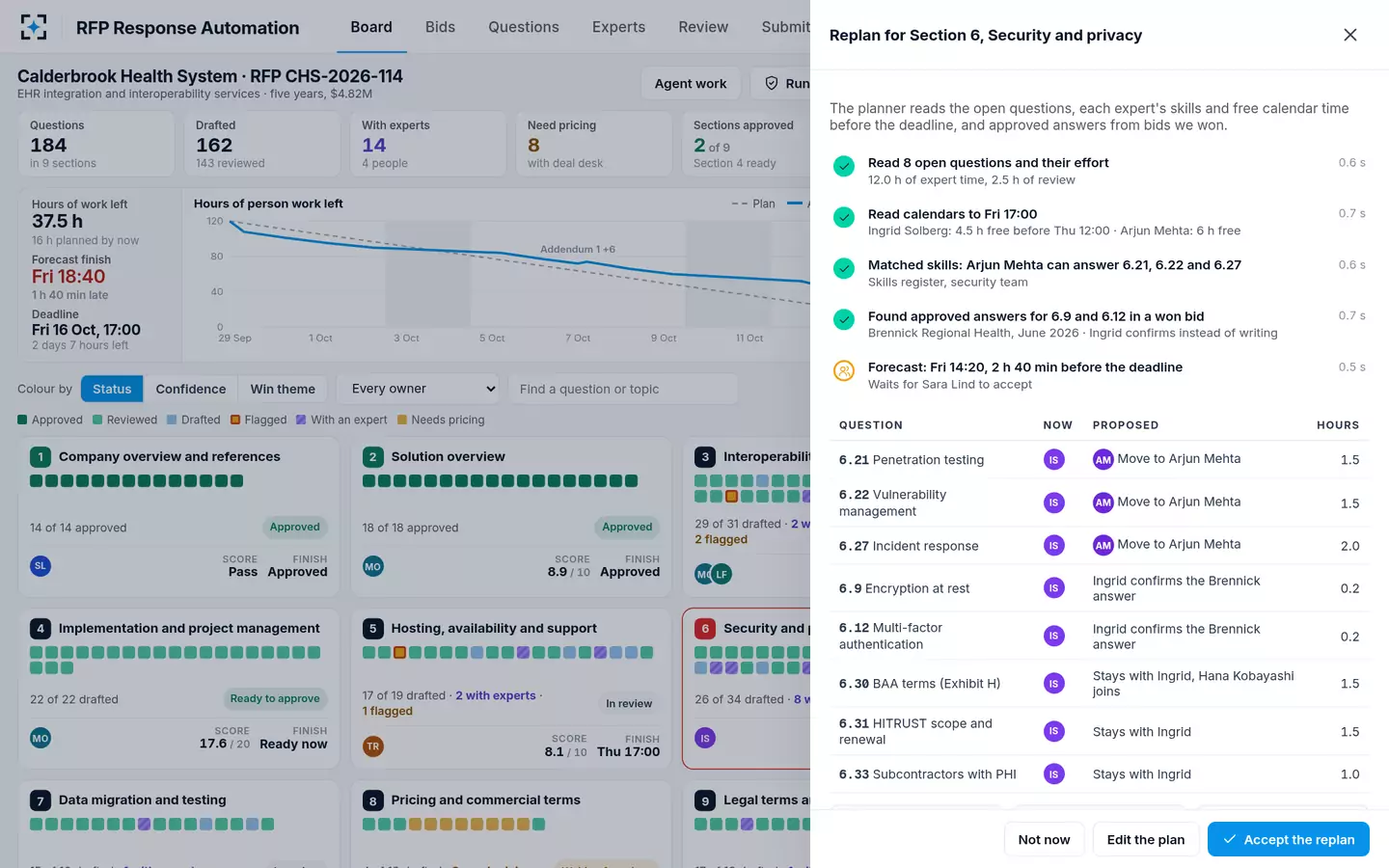

Proposal managerEach tile is a section and each small cell a question, filling as answers are drafted, reviewed and approved. So far, 162 of 184 are drafted, 14 are with experts and 8 need pricing. Two of 9 sections are approved, and the predicted score is 83.3 of 100. Above the tiles, the burndown chart shows 37.5 hours of person work left. The forecast finish is Fri 18:40, 1 h 40 min late. Section 6, Security and privacy, is marked at risk.
“Finishes Fri 18:40, 1 h 40 min late. 8 questions need 12.0 h of the security lead’s time. They have 4.5 h free before Thu 12:00.”
- 02One click
Review the replan: the planner shows its working

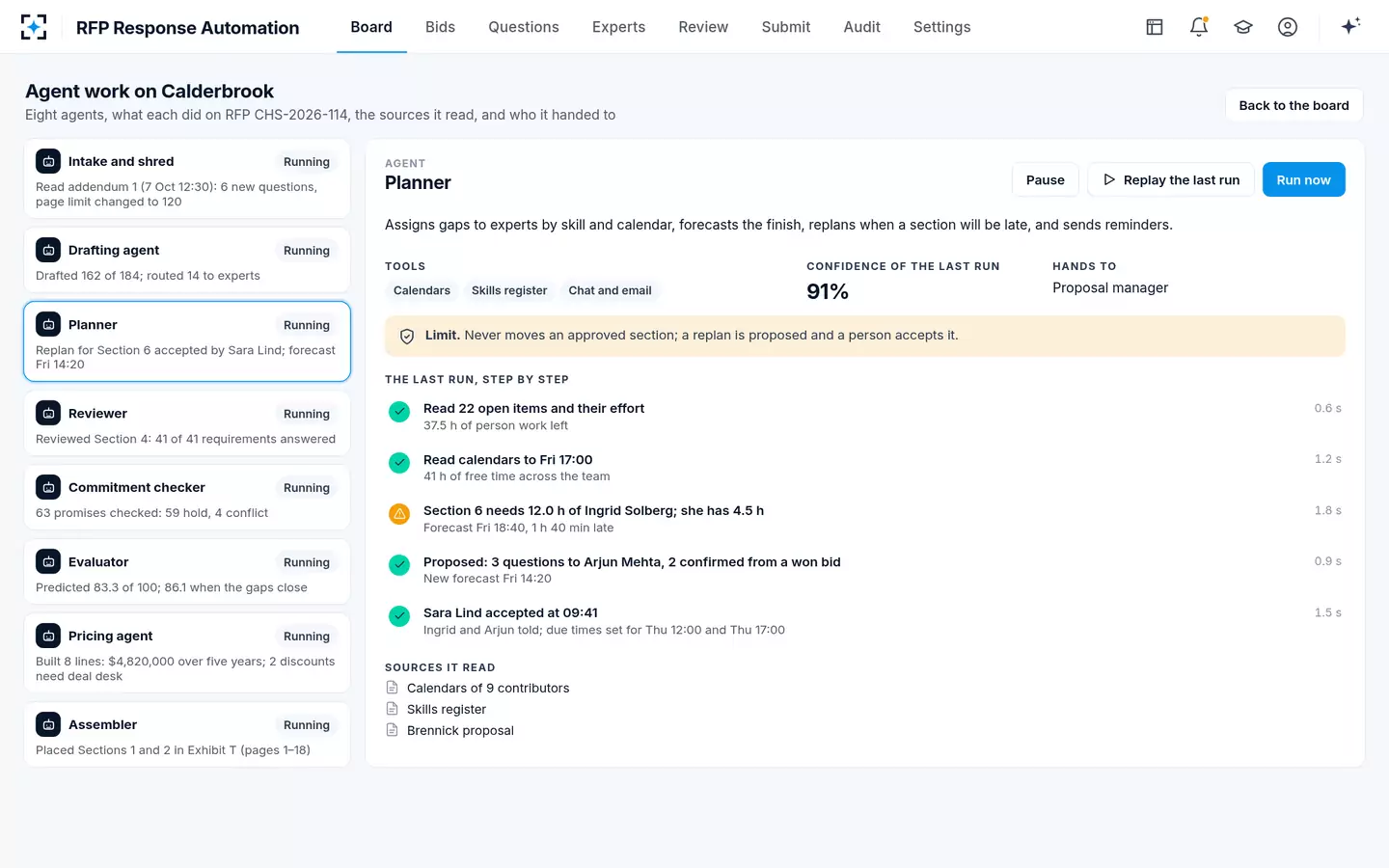

PlannerThe planner reads the 8 open questions and their effort, both experts’ calendars to Friday 17:00 and the skills register. It moves 6.21 penetration testing, 6.22 vulnerability management and 6.27 incident response to a security architect who has 6 hours free. For 6.9, encryption at rest, and 6.12, multi-factor authentication, it finds approved answers in a similar health-system bid won earlier. The security lead only has to confirm them. That takes the security lead from 12.0 to 4.4 hours.
“Nothing moves until you accept.”
- 03Accepted, 09:41
The forecast moves to Friday 14:20

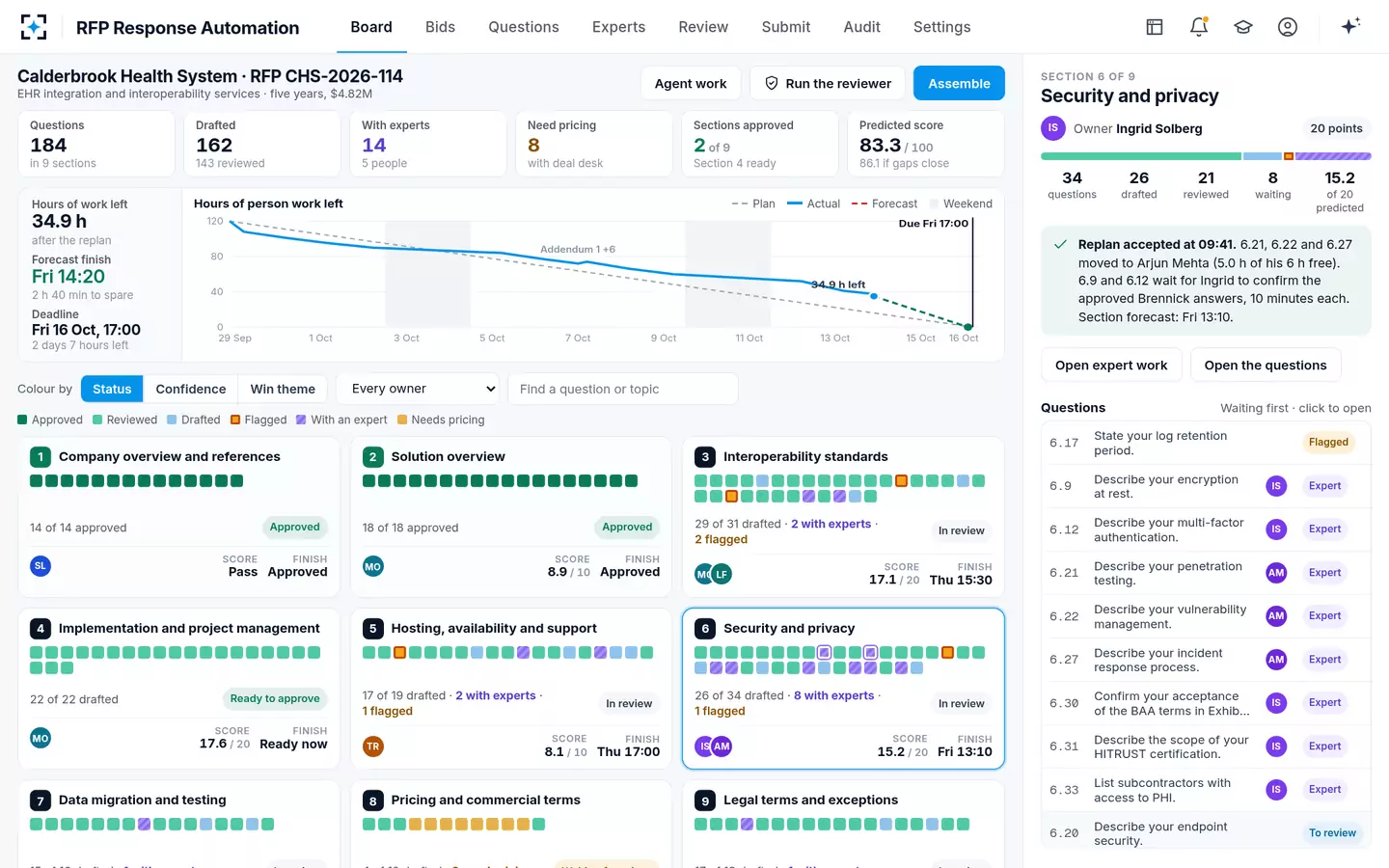

Proposal managerThe proposal manager accepts the replan. The burndown now forecasts Fri 14:20, with 2 h 40 min to spare and 34.9 hours of work left. Section 6 stops showing at risk. The planner tells both experts and sets their due times for Thursday 12:00 and 17:00. Both the acceptance and the message are on the audit trail.
- 04The security lead's inbox

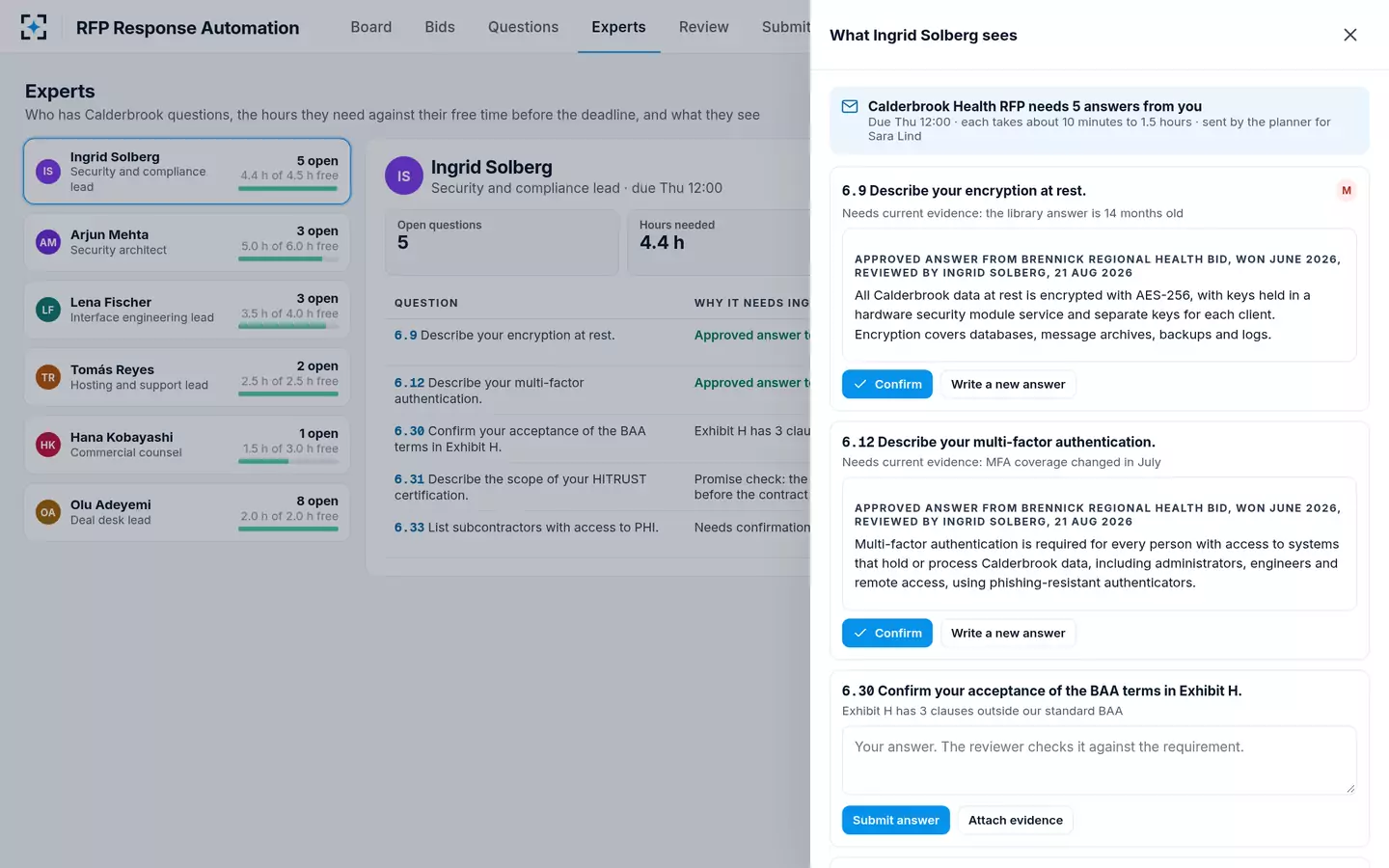

Only the five questions that need the security lead
Security and compliance leadThe security lead sees only what needs them: “The health system’s RFP needs 5 answers from you”, due Thursday 12:00. For 6.9 and 6.12, the approved answer from the won bid is already there. The same lead reviewed it a few months ago, and now confirms it or writes a new one. For 6.30, Exhibit H has 3 clauses outside the standard business associate agreement, the contract that covers patient data. The lead writes that answer, and the reviewer checks it against the requirement.
Each request says how long it should take: about 10 minutes to 1.5 hours.
- 05Each claim cited

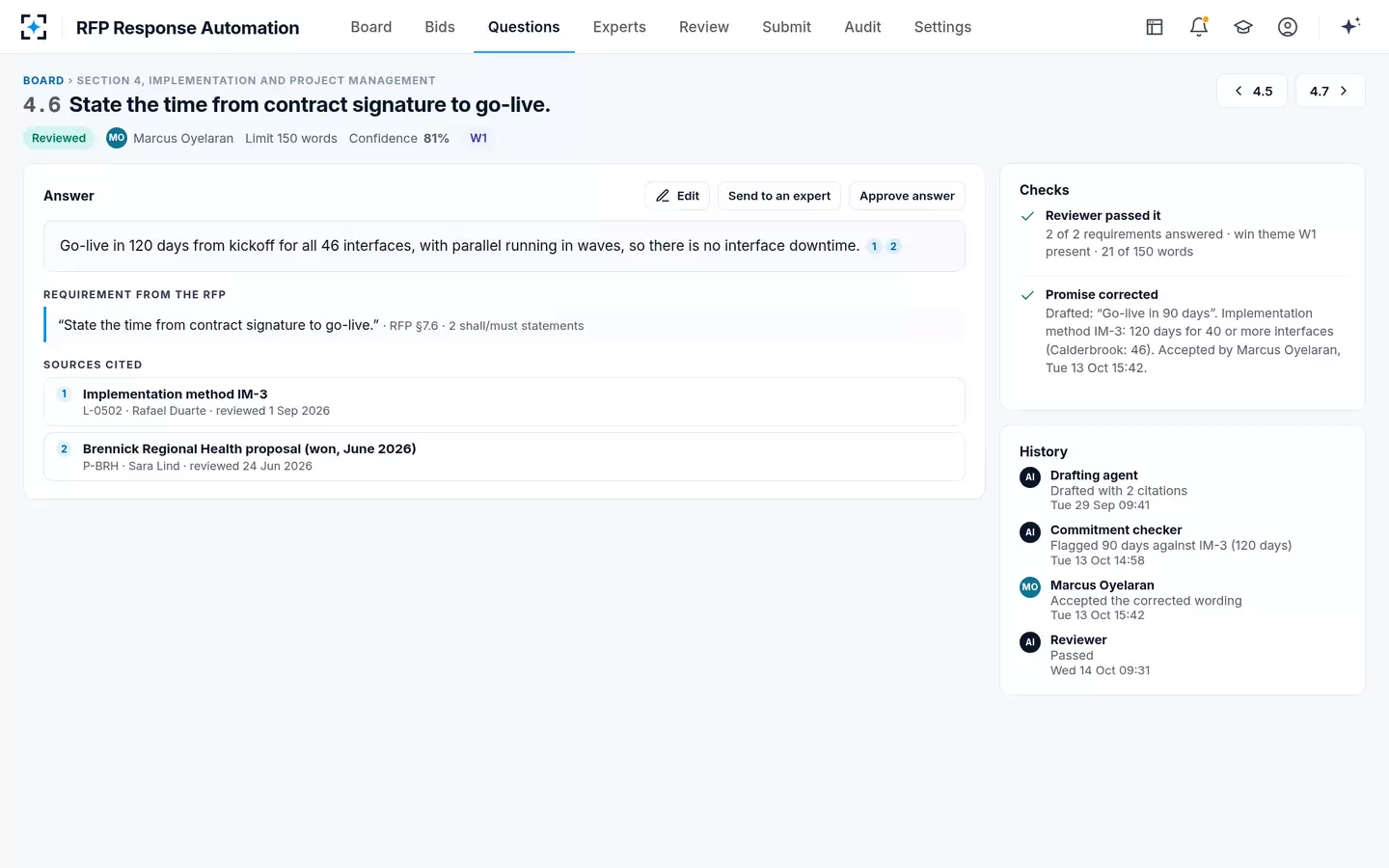

Question 4.6: 120 days, where the old bid said 90
Drafting agent and Commitment checker“State the time from contract signature to go-live.” The drafting agent wrote “Go-live in 90 days” from an older proposal. The commitment checker read the implementation method, which needs 120 days for 40 or more interfaces, and the buyer has 46. On Tuesday, the sales engineer accepted the corrected wording. The answer now cites the implementation method and the won proposal. The reviewer passed it: 2 of 2 requirements answered, win theme W1 present, 21 of 150 words.
The drafting agent states no capability without a source. Under 70% confidence, it routes the question to an expert.
- 06Promise check
63 promises read, 4 the company could not keep

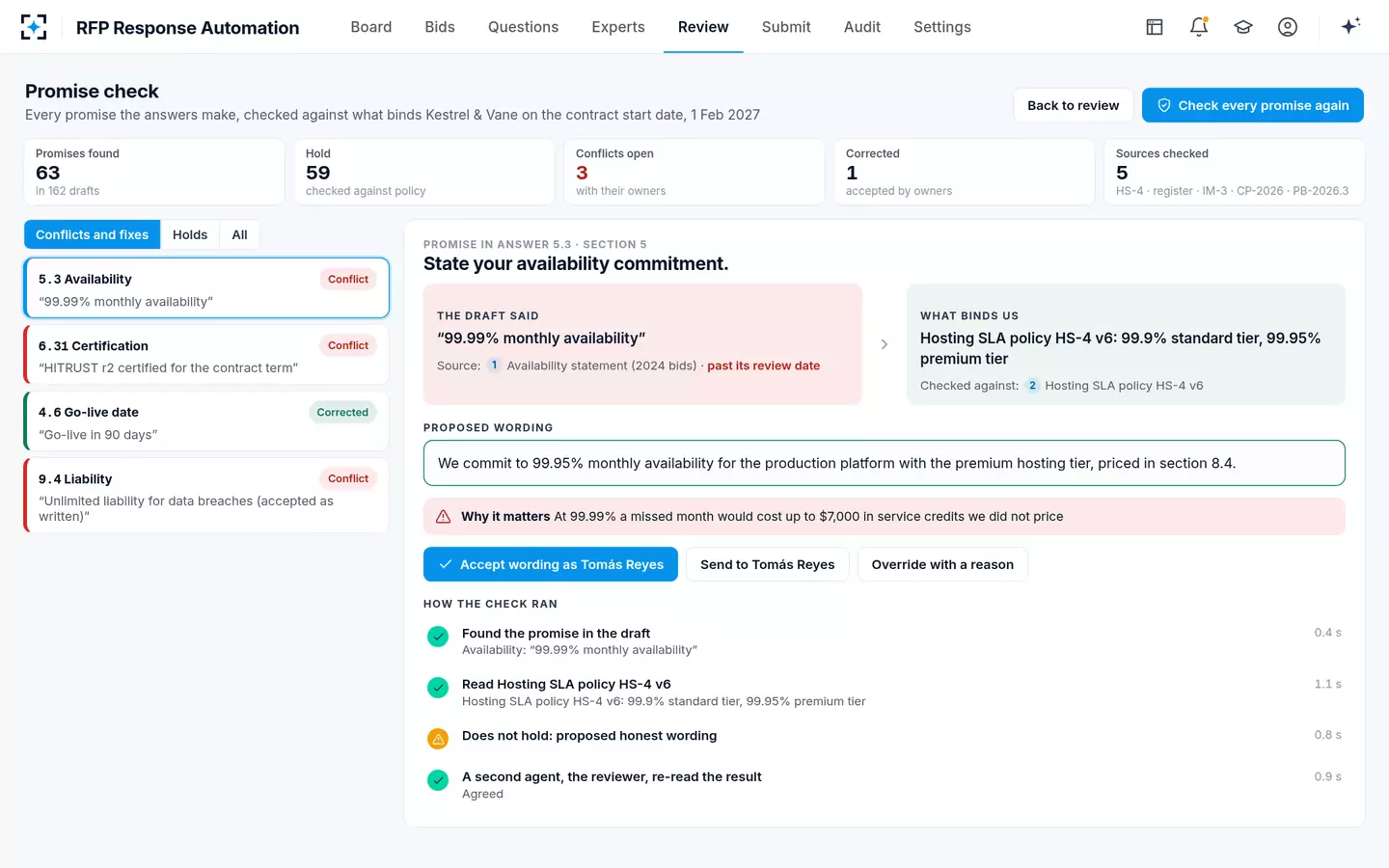

Commitment checkerThe commitment checker found 63 promises in 162 drafts, about availability, dates, certificates, liability and response times. It checked each one against what binds the company on the contract start date. Of these, 59 hold. Answer 5.3 promises “99.99% monthly availability”, from an old statement past its review date. The hosting SLA policy offers 99.9% standard and 99.95% premium. Instead, the checker proposes 99.95% with the premium tier, priced in 8.4. The hosting lead can accept it, send it on or override it with a reason.
“Why it matters: at 99.99% a missed month would cost up to $7,000 in service credits we did not price.”
- 07The buyer's red team
The buyer's own weights, applied before the buyer does

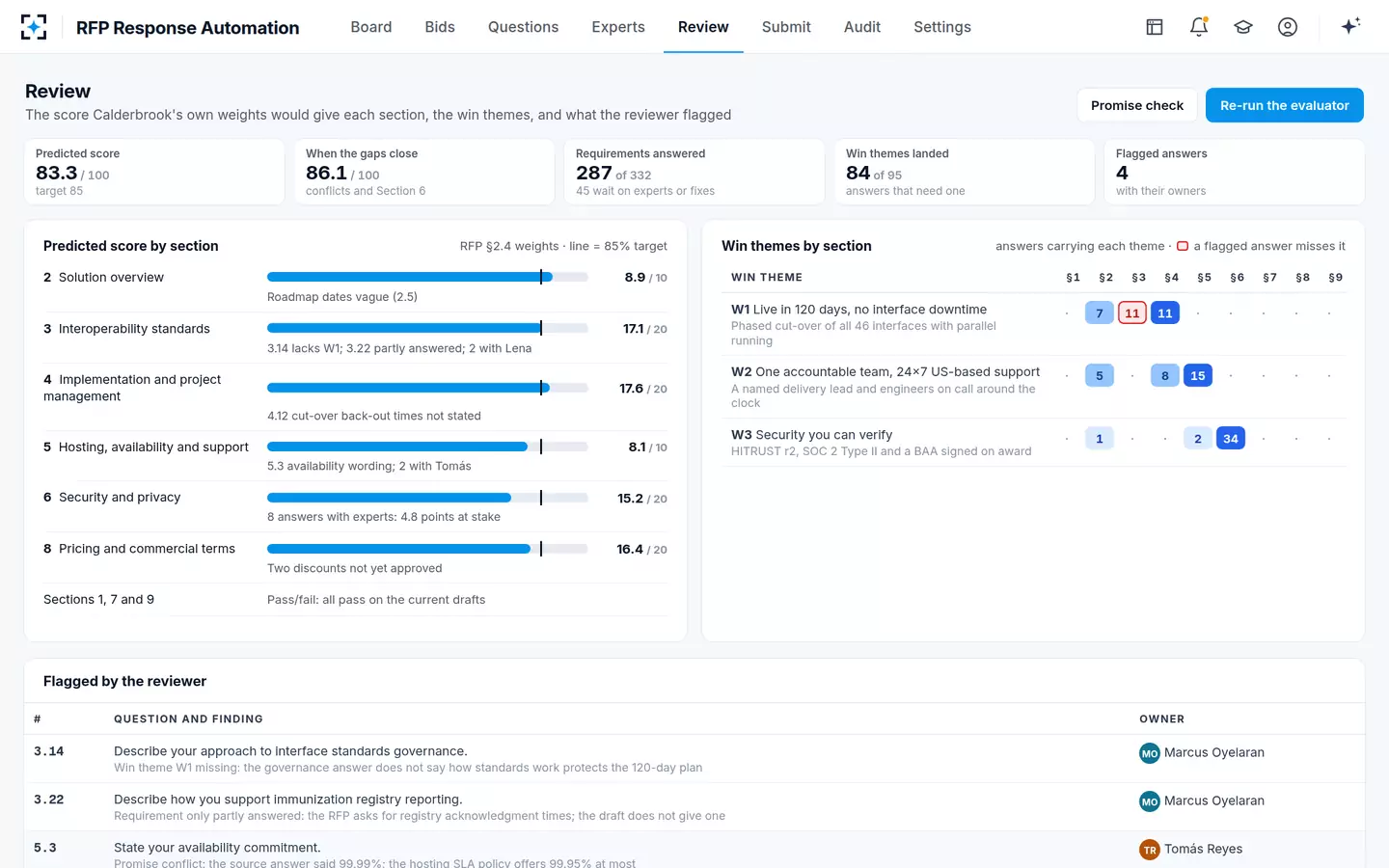

Evaluator and ReviewerThe evaluator scores each section with the RFP’s §2.4 weights. The bid scores 83.3 of 100 now and 86.1 when the gaps close, against a target of 85. Security sits at 15.2 of 20 because 8 answers are still with experts, with 4.8 points at stake. The reviewer works independently of the drafter. It finds 287 of 332 requirements answered, and win themes, the bid’s main selling points, in 84 of 95 answers that need one. It flagged 4 answers to their owners, such as 3.14, which does not say how standards work protects the 120-day plan.
The evaluator does not claim to know the buyer’s decision. The score is a prediction.
- 08Pricing

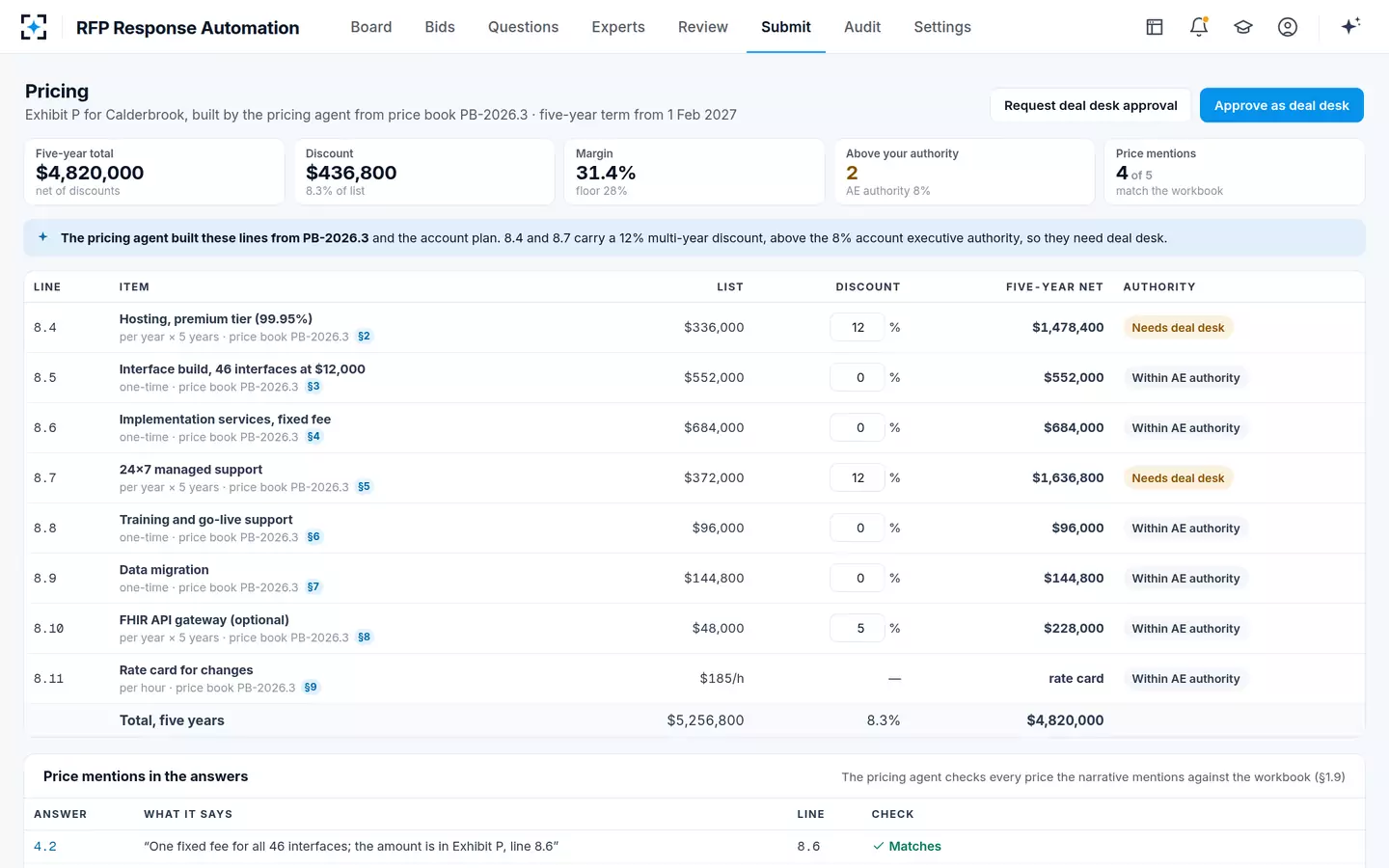

Exhibit P built from the price book, with authority checked
Pricing agentThe pricing agent filled 8 lines from the price book. They total $4,820,000 over five years, with $436,800 of discount and a 31.4% margin against a 28% floor. Lines 8.4 and 8.7 carry a 12% multi-year discount, above the account executive’s 8% authority, so they wait for the deal desk lead. The agent also checked the 5 prices the narrative mentions. Answer 7.4 says data migration is in the fixed fee, but the workbook prices it in 8.9.
The pricing agent never sends a price without deal desk approval.
- 09The decision
Section 4 approved with a reason code

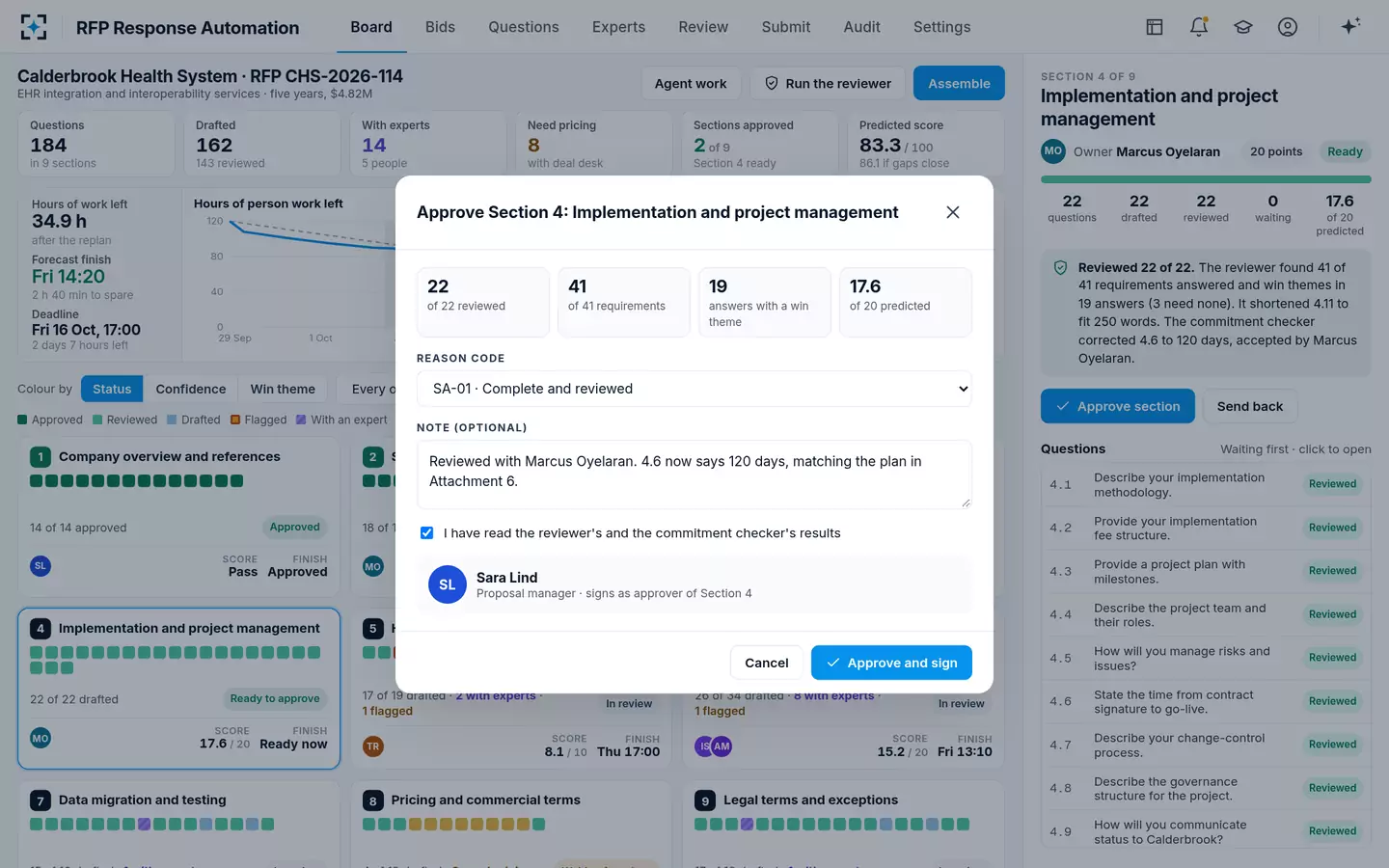

Proposal managerSection 4, Implementation and project management, shows 22 of 22 reviewed and 41 of 41 requirements answered. It has 19 answers carrying a win theme and a predicted 17.6 of 20. The proposal manager picks SA-01 Complete and reviewed and adds a note. They tick that the reviewer’s and the commitment checker’s results have been read, and sign as approver. Now 3 of 9 sections are approved.
“Reviewed with the sales engineer. 4.6 now says 120 days, matching the plan in Attachment 6.”
- 10Placed and proven
In the buyer's own template, checked against its rules

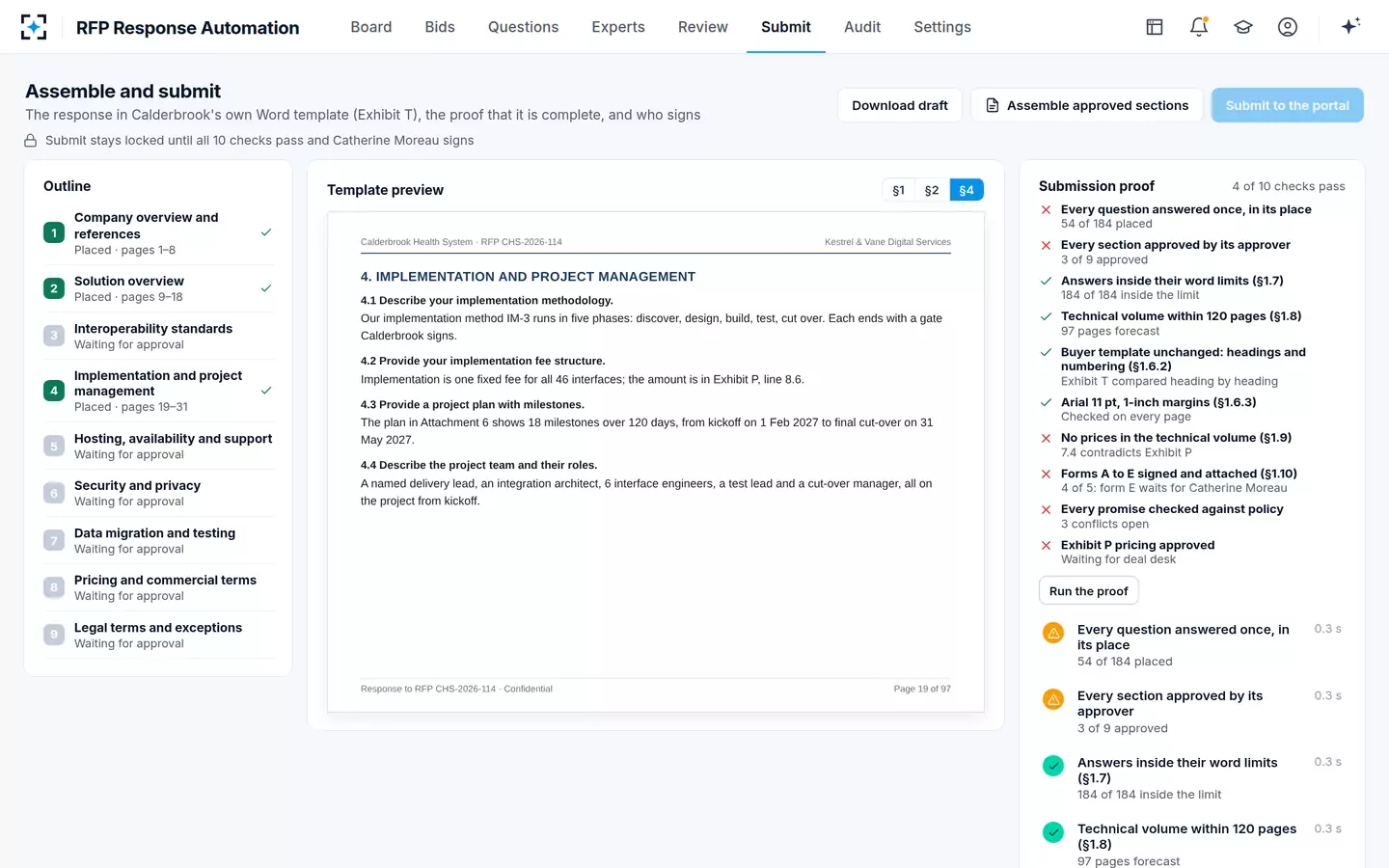

AssemblerThe assembler places Section 4 in the buyer’s own Word template, Exhibit T, on pages 19 to 31. Then it re-reads the file against every question and rule pulled from the RFP. The checks cover word limits, a 97-page forecast against the 120-page limit, unchanged headings and numbering, and Arial 11 pt. So far 4 of 10 checks pass, and the proof shows what is still open. Answer 7.4 contradicts Exhibit P, form E waits for the VP Sales Engineering, and 3 promise conflicts are open.
“Submit stays locked until all 10 checks pass and the VP Sales Engineering signs.”
