- Before
- Runs four pursuits and owns the bid strategy. Needs proof that nothing is missing, rather than another spreadsheet.
- Now
- Starts the day with the agents’ briefing and one decision, asks in plain words, and approves each matrix version with a reason code.
An amendment posted at 16:40, a new matrix version approved by breakfast
The company is bidding for a base operations support services contract worth about $186M. It has 412 requirements across 14 documents, and the proposal is due at a set date and hour. The third amendment was posted at 16:40 yesterday. Here is how the capture manager, who leads the bid, works with the agents the next morning, screen by screen, in the working solution.
A worked example on sample data. Names, IDs and figures on the screens and in this section come from the demo.
- 01The next morning

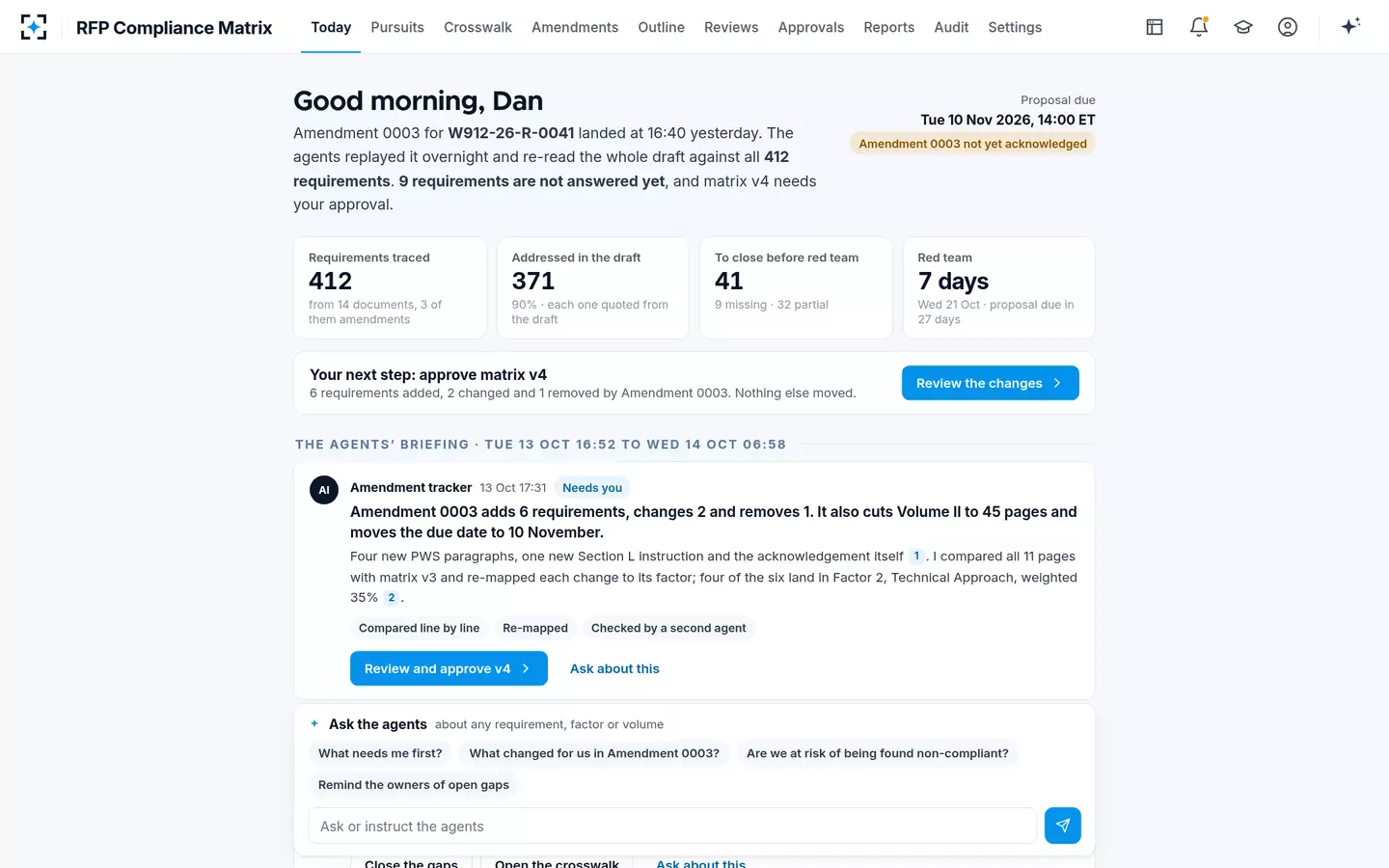

A briefing from the agents, and one decision waiting
Capture managerThe agents replayed the amendment overnight and re-read the whole draft against all 412 requirements. The capture manager’s screen shows 371 addressed, each one quoted from the draft. Another 41 are still open before red team (9 missing, 32 partial), and red team is in 7 days. The next step is one bar: approve matrix v4. Below it, five agents report what they did between 16:52 and 06:58, each with its sources.
Amendment tracker: “The amendment adds 6 requirements, changes 2 and removes 1. It also cuts Volume II to 45 pages and moves the due date.”
- 0207:42
A plain question: is the bid at risk?

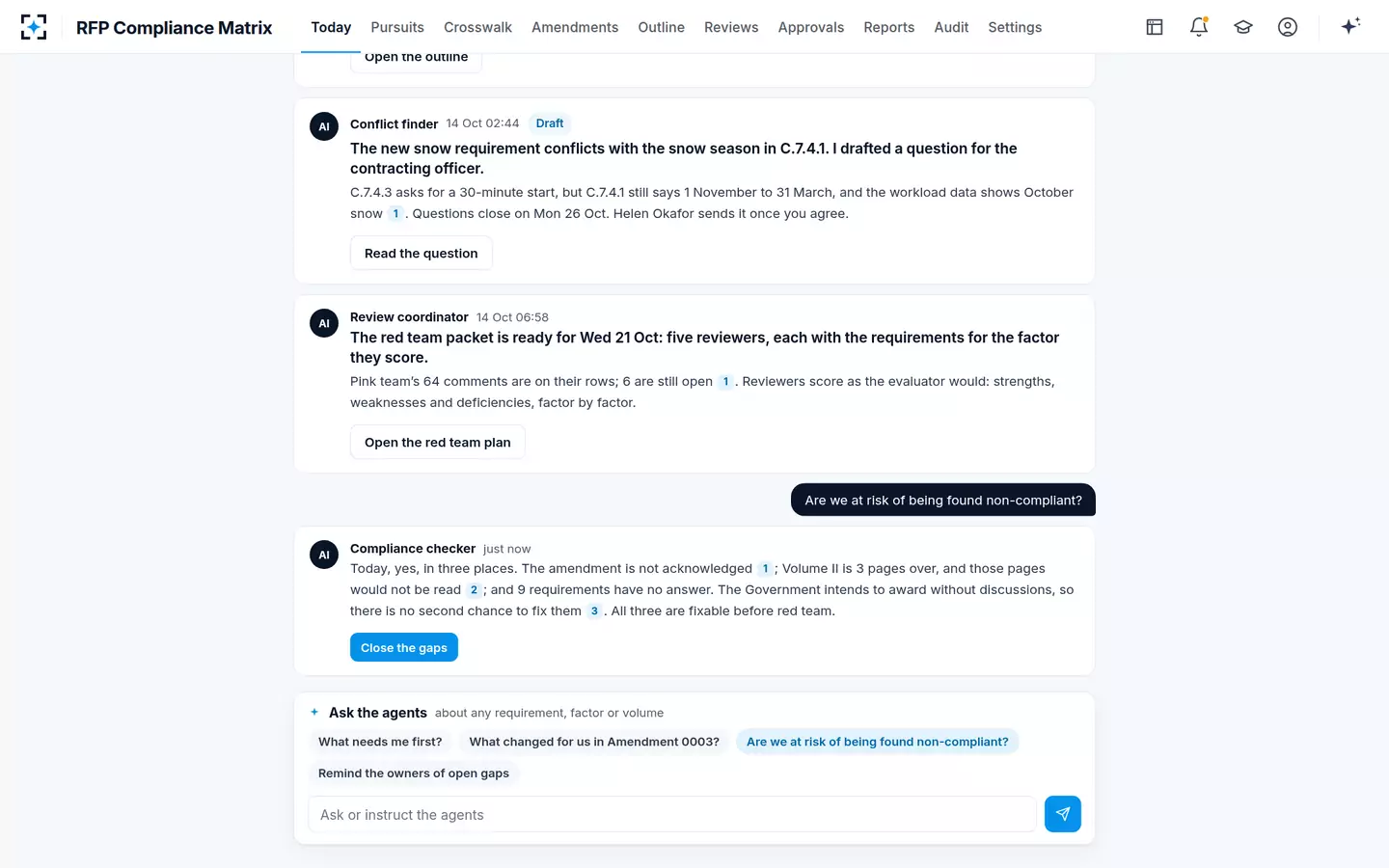

Compliance checkerThe capture manager types the question they would ask the proposal manager. “Are we at risk of being found non-compliant?” The compliance checker answers with its sources and names three risks. The amendment is not acknowledged. Volume II is 3 pages over, so those pages would not be read. Also, 9 requirements have no answer. The checker offers the next step as a button, Close the gaps.
“The Government intends to award without discussions, so there is no second chance to fix them. All three are fixable before red team.”
- 03In the crosswalk
A row marked done that the draft does not answer

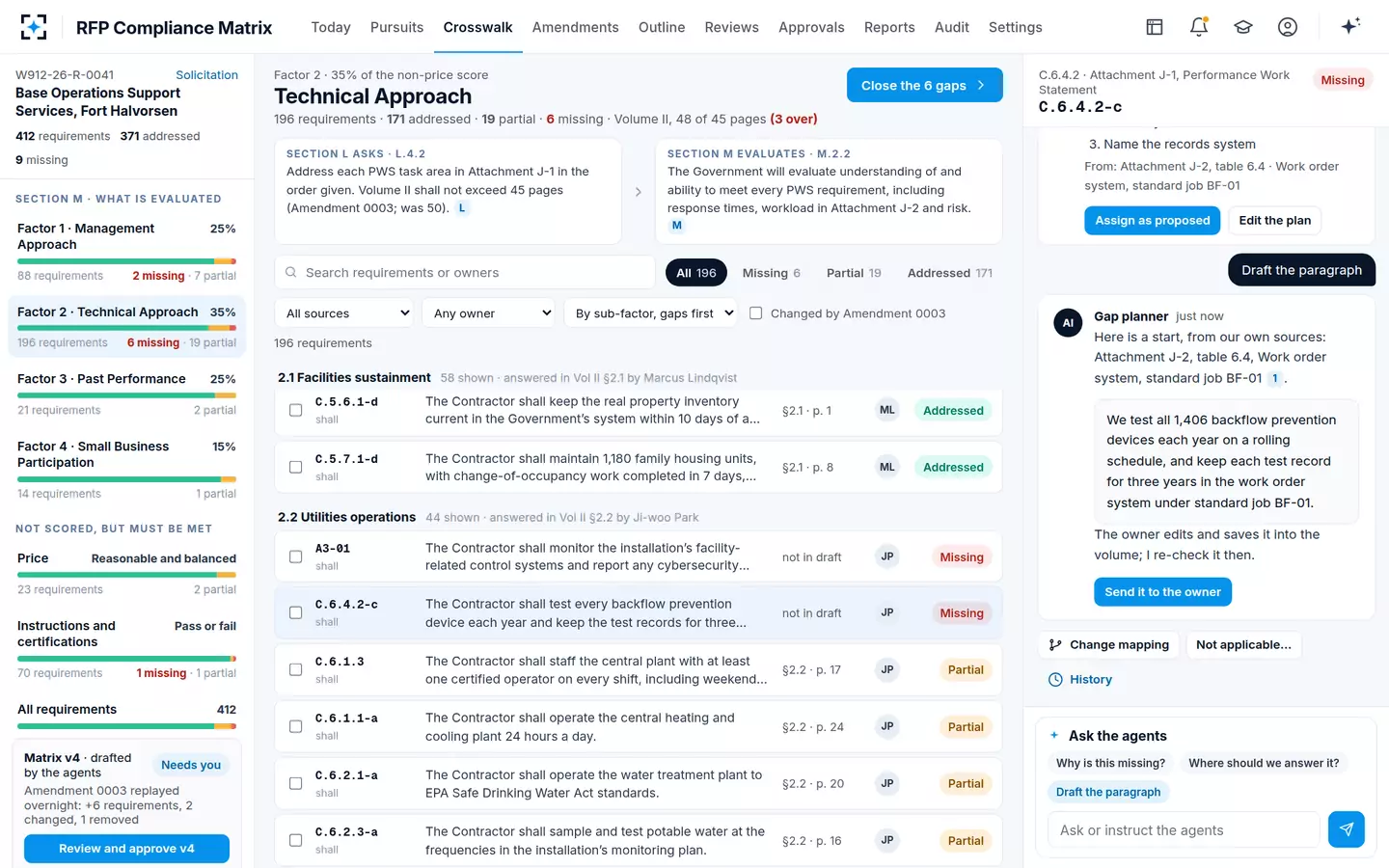

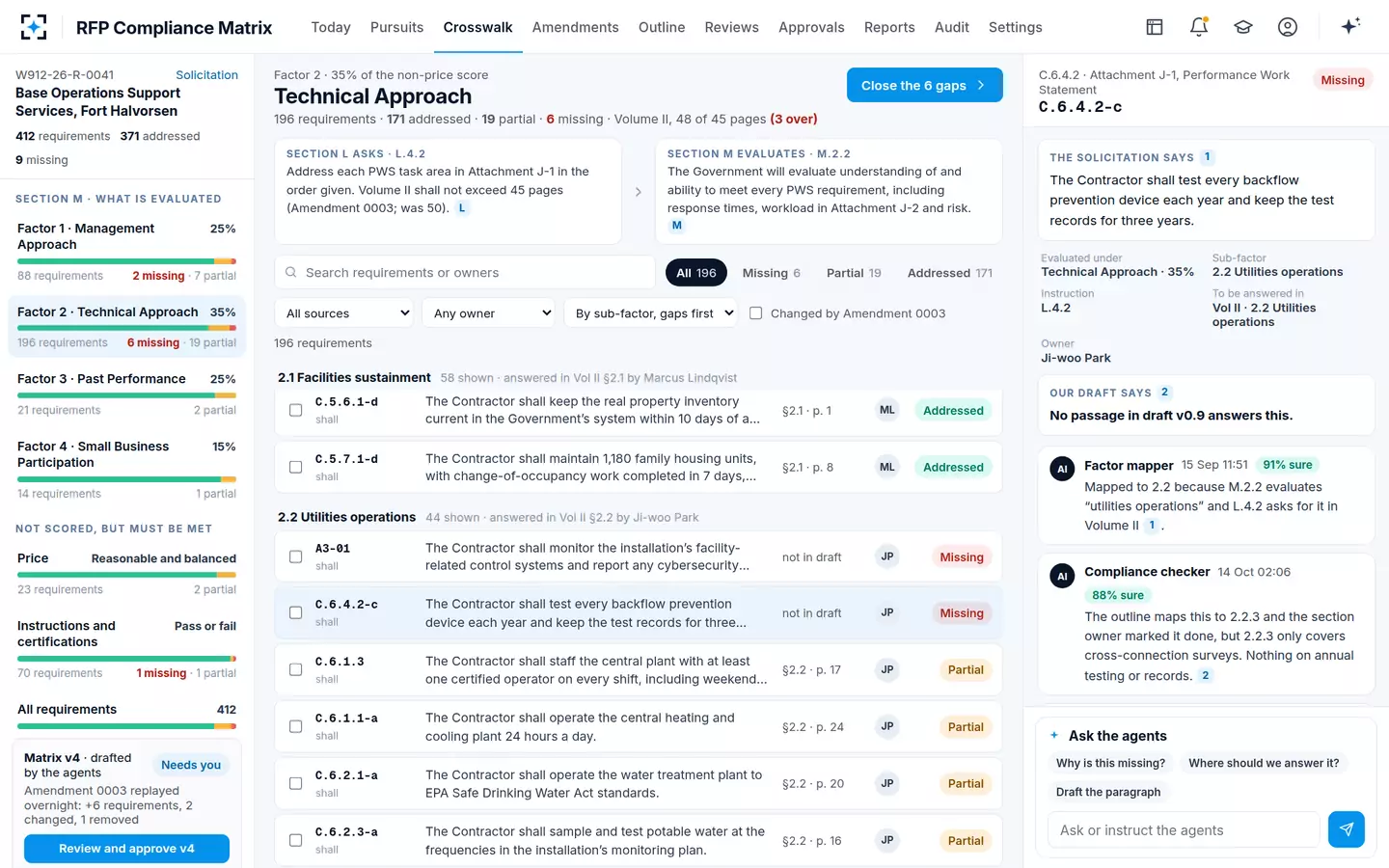

Compliance checkerThe crosswalk puts the Section L instruction beside the Section M criterion for Factor 2, Technical Approach. That factor carries 35% of the non-price score. It has 196 requirements: 171 addressed, 19 partial and 6 missing. The capture manager opens the annual backflow testing requirement. The factor mapper put it in 2.2, Utilities operations, and was 91% sure. A separate agent, the compliance checker, had no part in that mapping. It re-read the draft and found no passage that answers it.
Compliance checker: “The outline maps this to 2.2.3 and the section owner marked it done, but 2.2.3 only covers cross-connection surveys. Nothing on annual testing or records.”
- 0407:43
“Draft the paragraph”, from the company’s own sources
Gap plannerThe capture manager asks the agents to draft it. The gap planner writes a first version from two sources: Attachment J-2, table 6.4, and the backflow standard job in the work order system. Its draft reads: “We test all 1,406 backflow prevention devices each year on a rolling schedule. We keep each test record for three years in the work order system.” One button sends it to the owner of section 2.2.
“The owner edits it and saves it into the volume. I re-check it then.” The gap planner does not write into a volume.
- 05The amendment
What the third amendment means for this bid

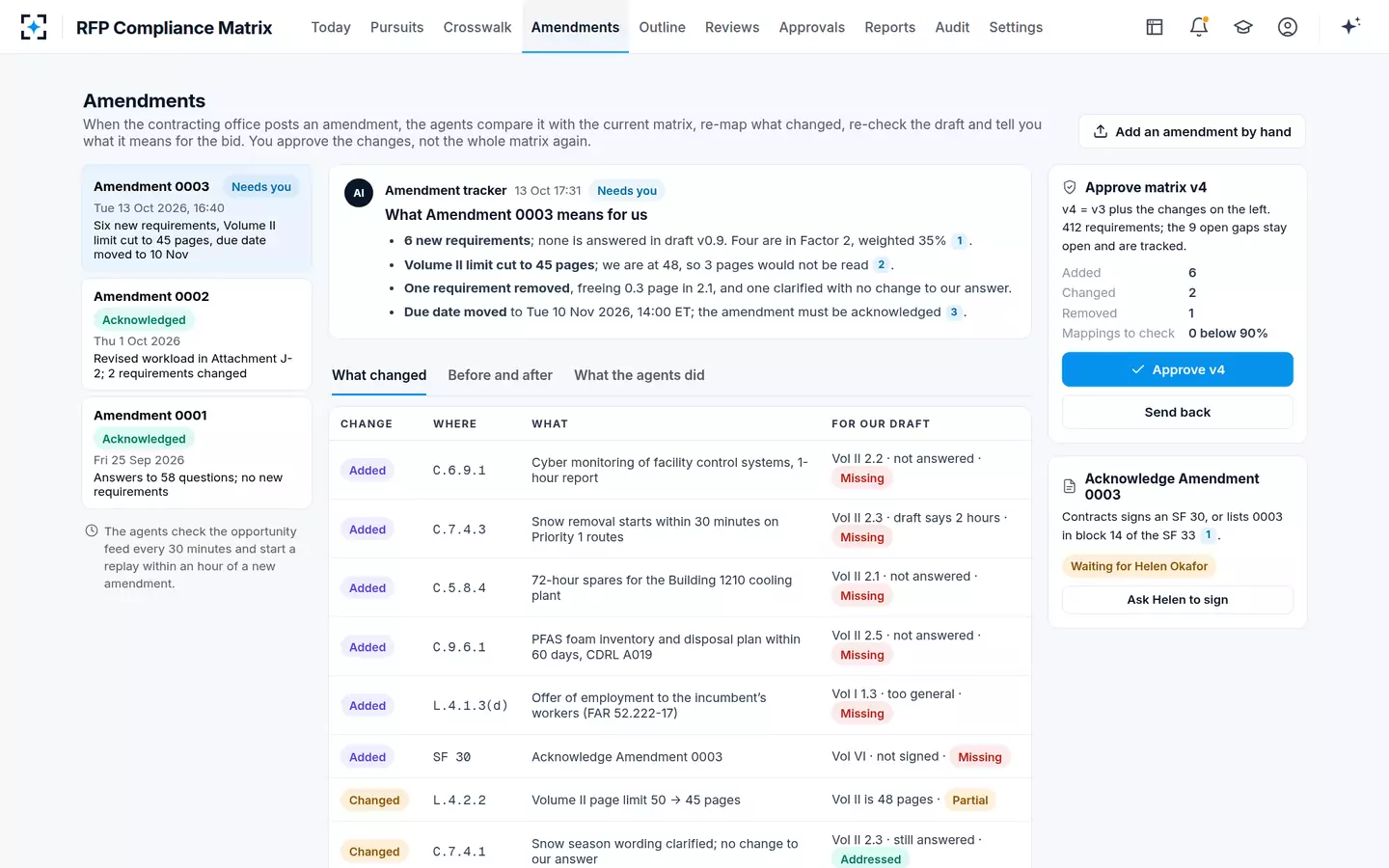

Amendment trackerThe tracker compared the amendment with the approved matrix, paragraph by paragraph. It adds six new requirements. None is answered in draft v0.9, and four of them fall in Factor 2. The Volume II limit is cut from 50 to 45 pages, and the draft is at 48. One paragraph is removed, which frees 0.3 page in 2.1, and the due date moves. Each change shows where it lands in the draft: “Vol II 2.3 · draft says 2 hours · Missing”.
Only the changes need approval. The whole matrix does not have to be approved again.
- 0616:52 to 06:58

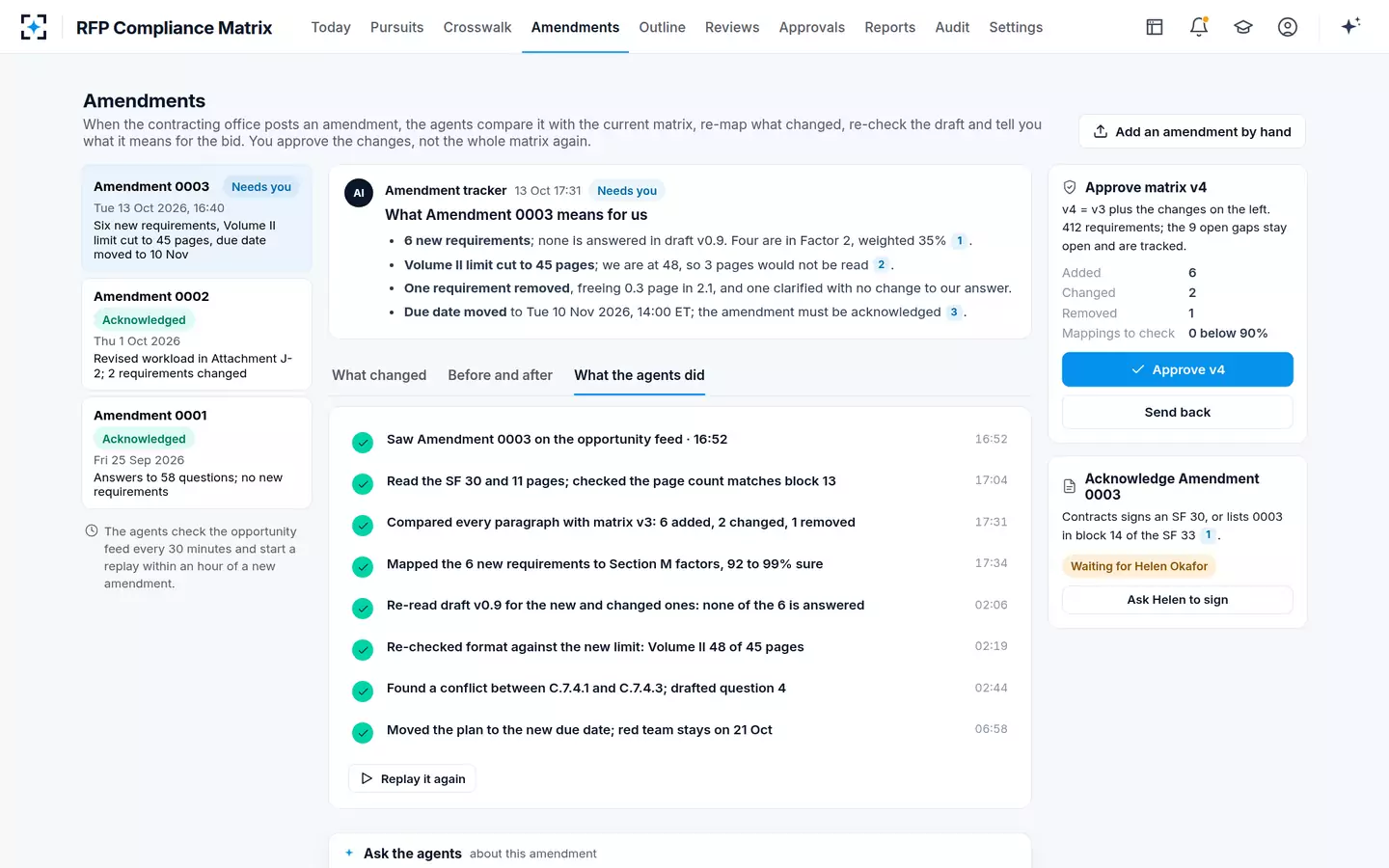

The overnight replay, step by step, with its times
The agentsThe trace shows what was done while the team slept. At 16:52 the agents saw the amendment on the opportunity feed. They read the SF 30, the form that carries an amendment, and 11 pages, and compared each paragraph with matrix v3. They mapped the 6 new requirements to Section M factors, 92 to 99% sure. Then they re-read draft v0.9 and re-checked the format against the new limit. They found a conflict and drafted question 4. Last, they moved the plan to the new due date and left the red team date unchanged.
The agents check the opportunity feed every 30 minutes and start a replay within an hour of a new amendment.
- 0707:44 · Signed

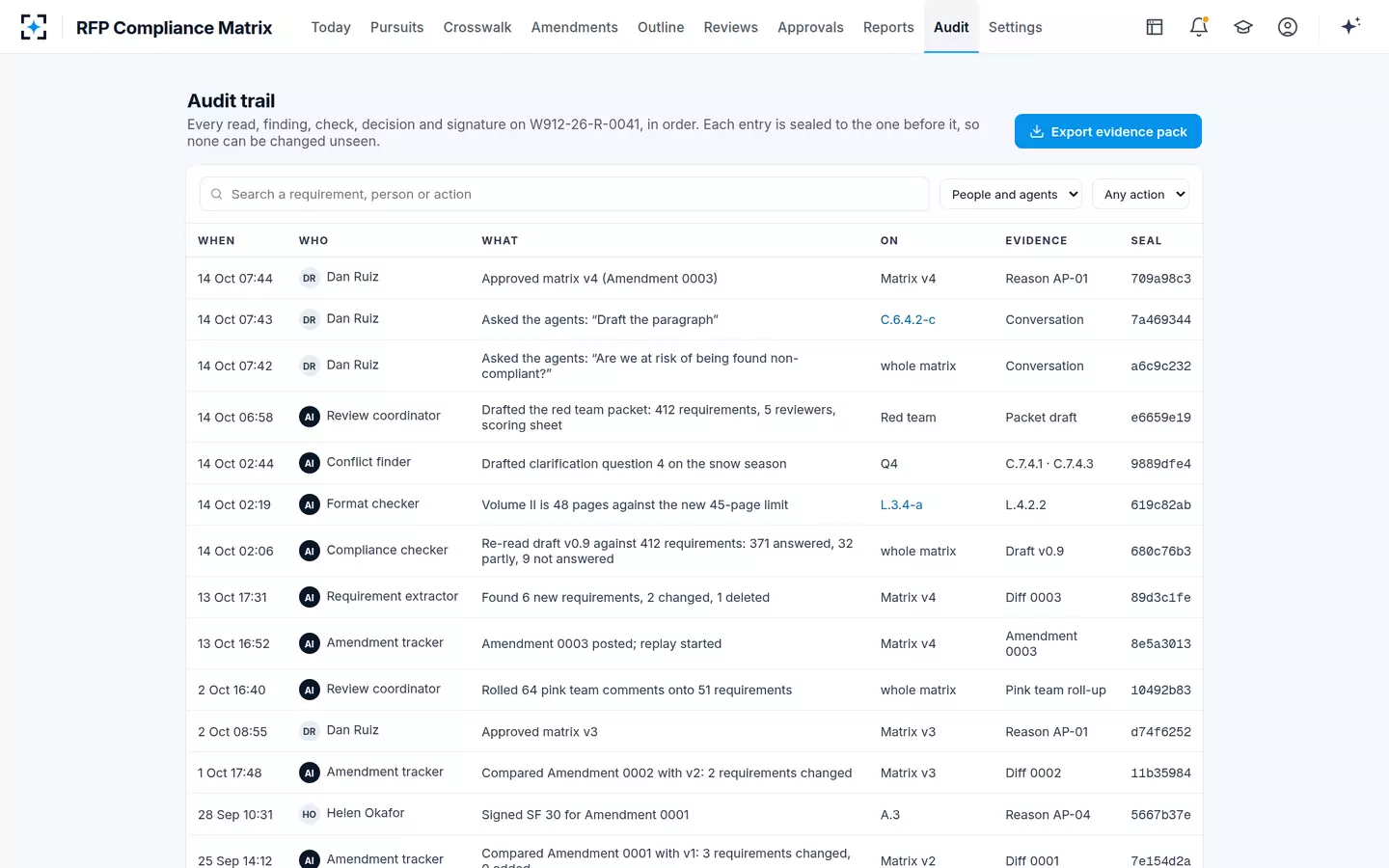

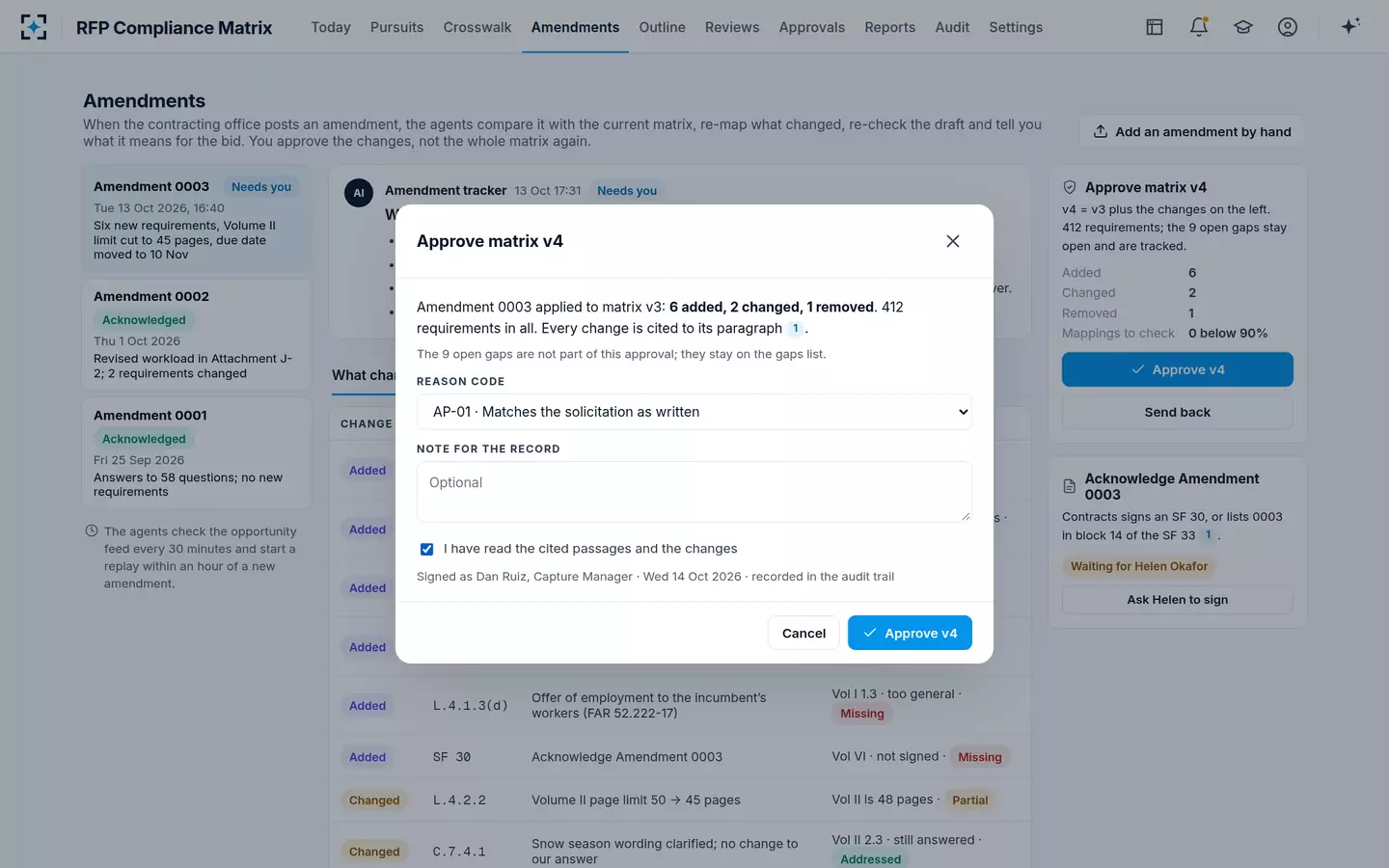

Matrix v4 approved with a reason code
Capture managerMatrix v4 is v3 with 6 added, 2 changed and 1 removed. It holds 412 requirements, each change is cited to its paragraph, and no mapping is below 90%. The capture manager picks the reason code “Matches the solicitation as written” and ticks that the cited passages were read. Outside this approval, the 9 open gaps stay on the gaps list. The acknowledgement itself waits for the contracts manager, who signs the SF 30 for the company.
“Signed by the capture manager · recorded in the audit trail.”

- 08Close the gaps
Nine gaps, one at a time, each with a plan and an owner

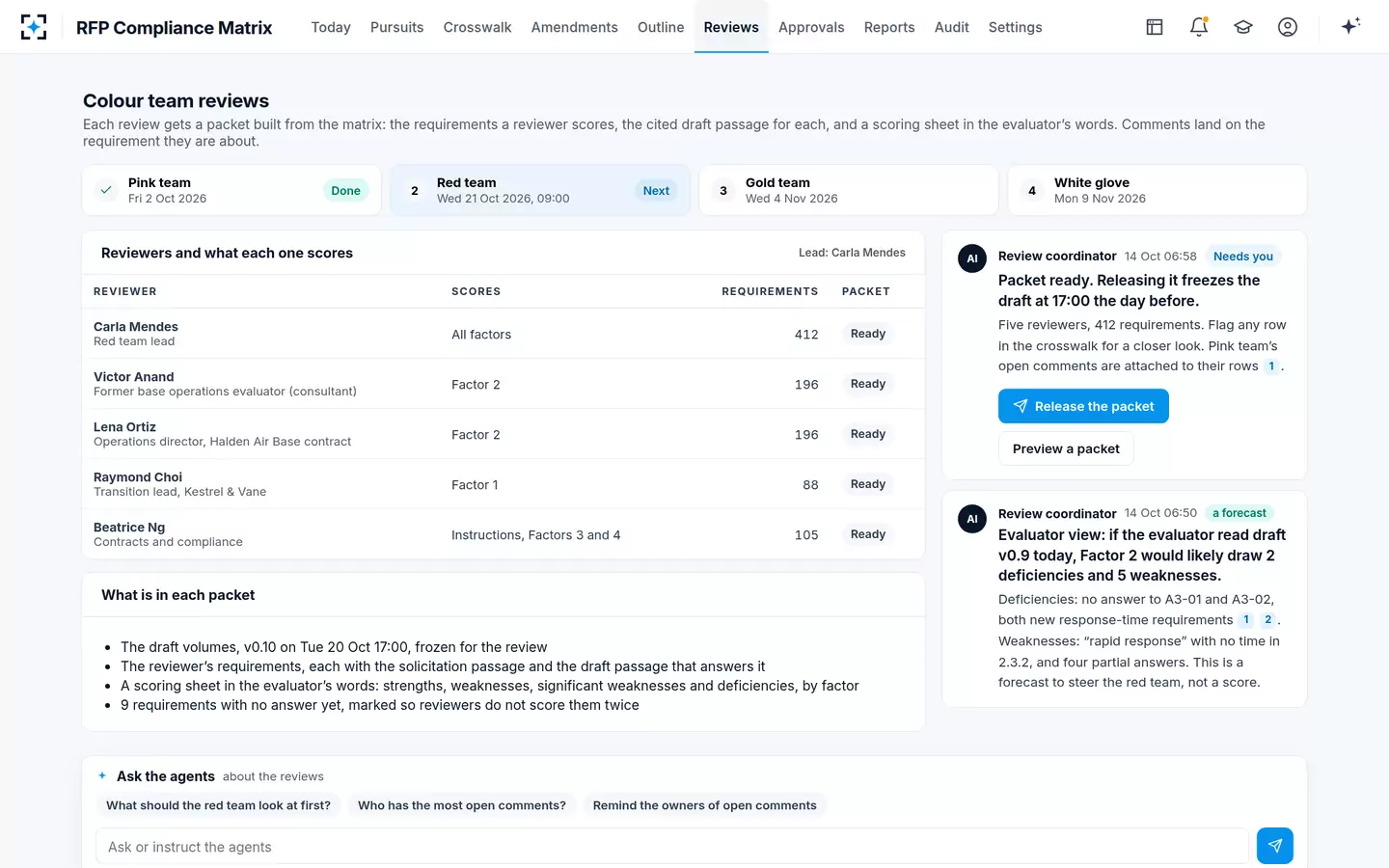

Gap plannerThe list is ranked by risk. Pass-or-fail items come first, then Section M weight. It opens with the unsigned acknowledgement, which goes to the contracts manager to sign. Next is a new requirement to report any cybersecurity event in the installation’s facility control systems within 1 hour. The checker is 96% sure the draft does not answer it. The gap planner proposes where to answer it (Volume II, 2.2), the owner and a three-step plan. It also drafts a starting text from the company’s cyber policy and another installation’s monthly report. The capture manager can assign it, edit it, or mark it as one the company does not answer.
“The owner writes it into the volume. The checker re-reads the section when it is saved.”

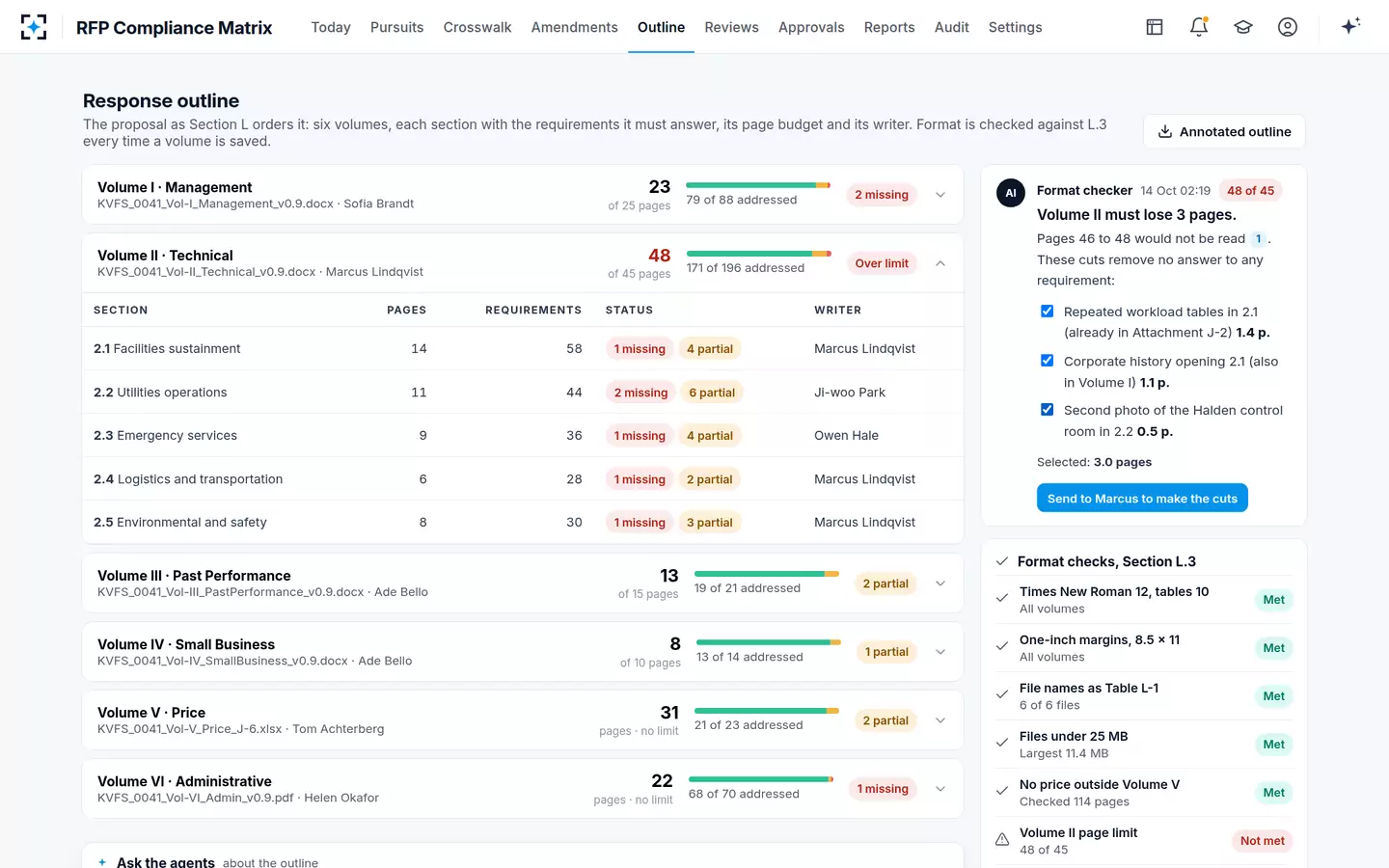

- 09The page limit
Three pages over, and three pages that can go
Format checkerVolume II is 48 pages against the new 45-page limit. So pages 46 to 48 would not be read, and they hold 2.5.3 to 2.5.5, environmental and safety. The format checker proposes 3.0 pages of cuts. The repeated workload tables in 2.1 can go (1.4 pages), since they are already in Attachment J-2. So can the corporate history that opens 2.1 (1.1 pages, also in Volume I) and a second photo in 2.2 (0.5 page). All other Section L format checks are met, from fonts and margins to no price outside Volume V.
“These cuts remove no answer to any requirement.” The volume lead decides what is cut.

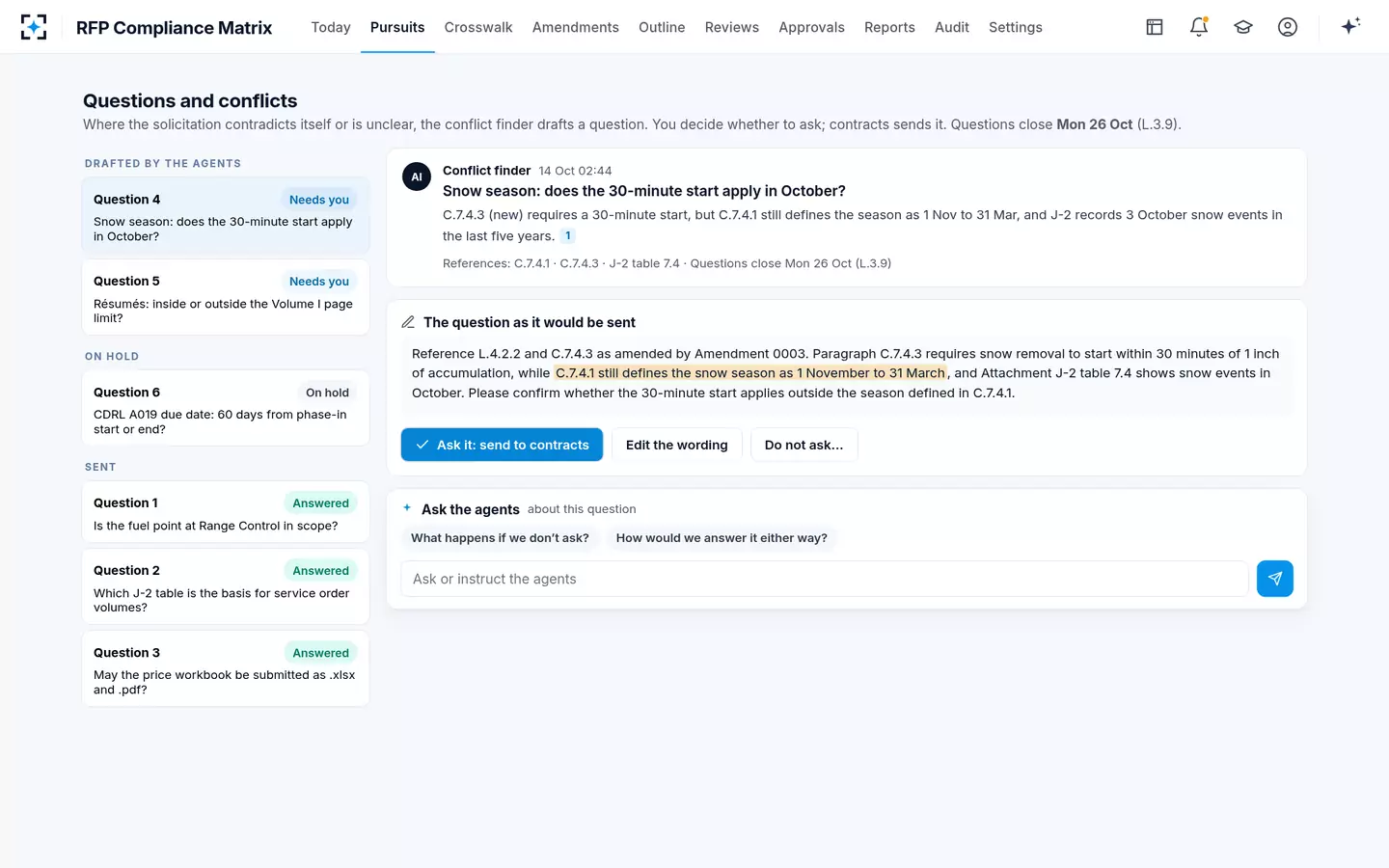

- 10Before questions close
A contradiction found, and the question drafted
Conflict finderA new requirement asks for snow removal to start within 30 minutes. Yet the solicitation still defines the snow season as 1 November to 31 March. Attachment J-2 also records 3 October snow events in the last five years. The conflict finder drafts a neutral question for the contracting officer while the question period is still open. When asked, it explains how the team would answer it either way.
The conflict finder does not send a question. The capture manager decides whether to ask, and the contracts manager sends it.
