- Before
- Wants the best case for and against, and what each costs. Gets a scorecard and a 30-minute meeting instead.
- Now
- Reads two cited cases side by side. Asks the panel what a partner or a capped clause would change, then decides with reason codes and a signature.
An RFP arrives at 21:12, and a signed bid decision follows the next morning
A utility issues an RFP for meter data and field services. It is worth $2.4M over a 3-year base term. The current supplier, or incumbent, has held the work for 7 years. The RFP reaches the company's field and network services business at 21:12 on a Tuesday. Here is what happens next, screen by screen, in the working solution.
A worked example on sample data. Names, IDs and figures on the screens and in this section come from the demo.
- 01The next morning
The VP talks to the agents before reading the scorecard
VP SalesThe VP's Today screen shows the week's RFPs, the proposal team's bookings and three decisions waiting, ranked by deadline. Beside them, the bid team reports in its own words. The intake agent read the utility's RFP overnight, and the sceptic recommends no bid as it stands. The VP asks why the agents disagree, and the advocate answers with both sides of the case, each point cited.
Advocate agent: “I say bid with the partner … The sceptic says no … Open the debate to hear both.”
- 02Overnight
Each page read, and each value tied to its passage

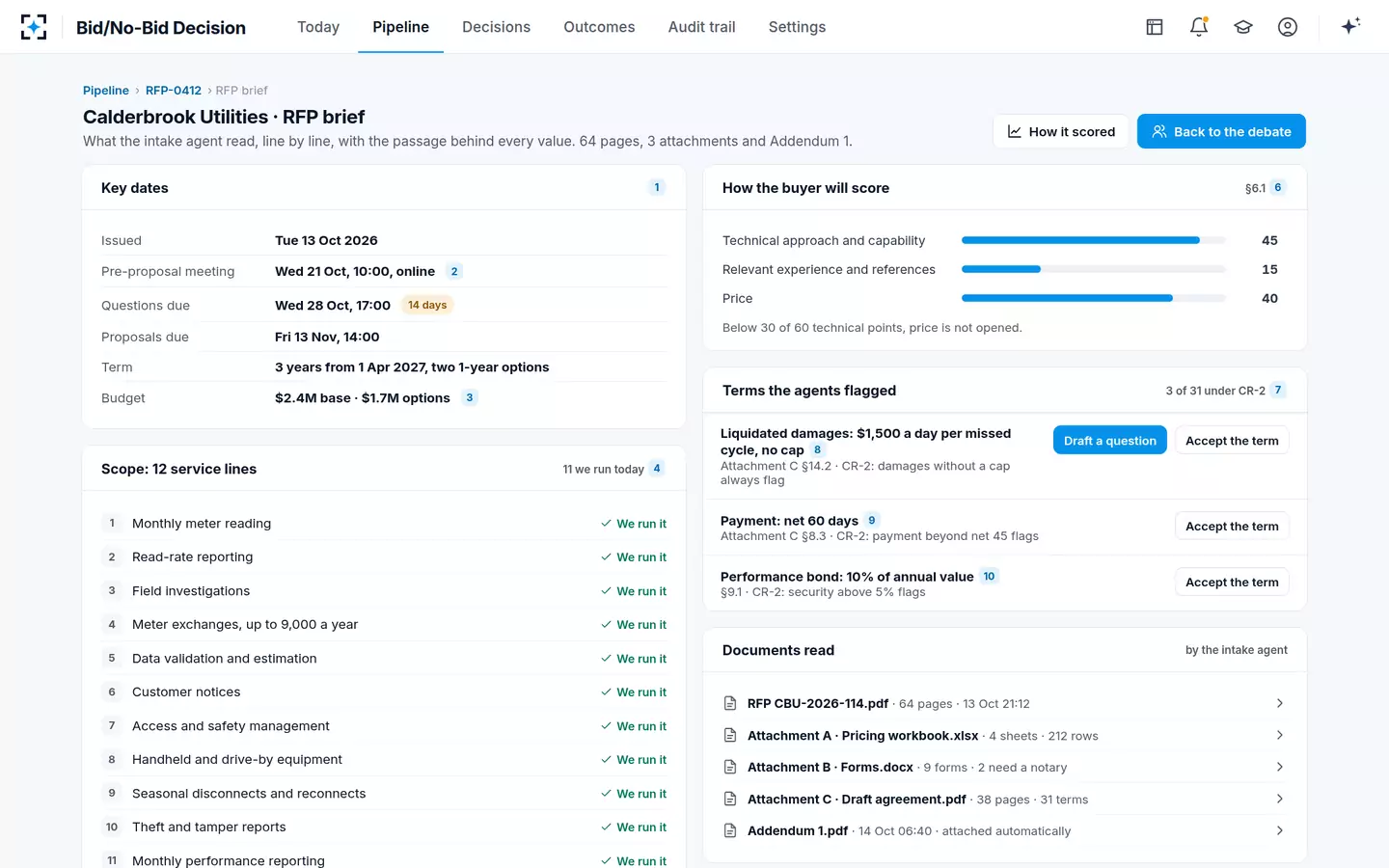

Intake agentThe intake agent read all 64 pages, the pricing workbook, the forms and the draft agreement. Addendum 1 arrived the next morning, covering meter exchanges of up to 9,000 a year. The agent attached it and asked the effort agent to run again. The RFP brief lists the key dates and the 12 service lines, of which the company runs 11 today. It also shows how the buyer will score: 45 points for technical, 15 for experience and 40 for price.
“Below 30 of 60 technical points, price is not opened.”
- 03One click on a citation
The clause nobody had read, found before anyone writes

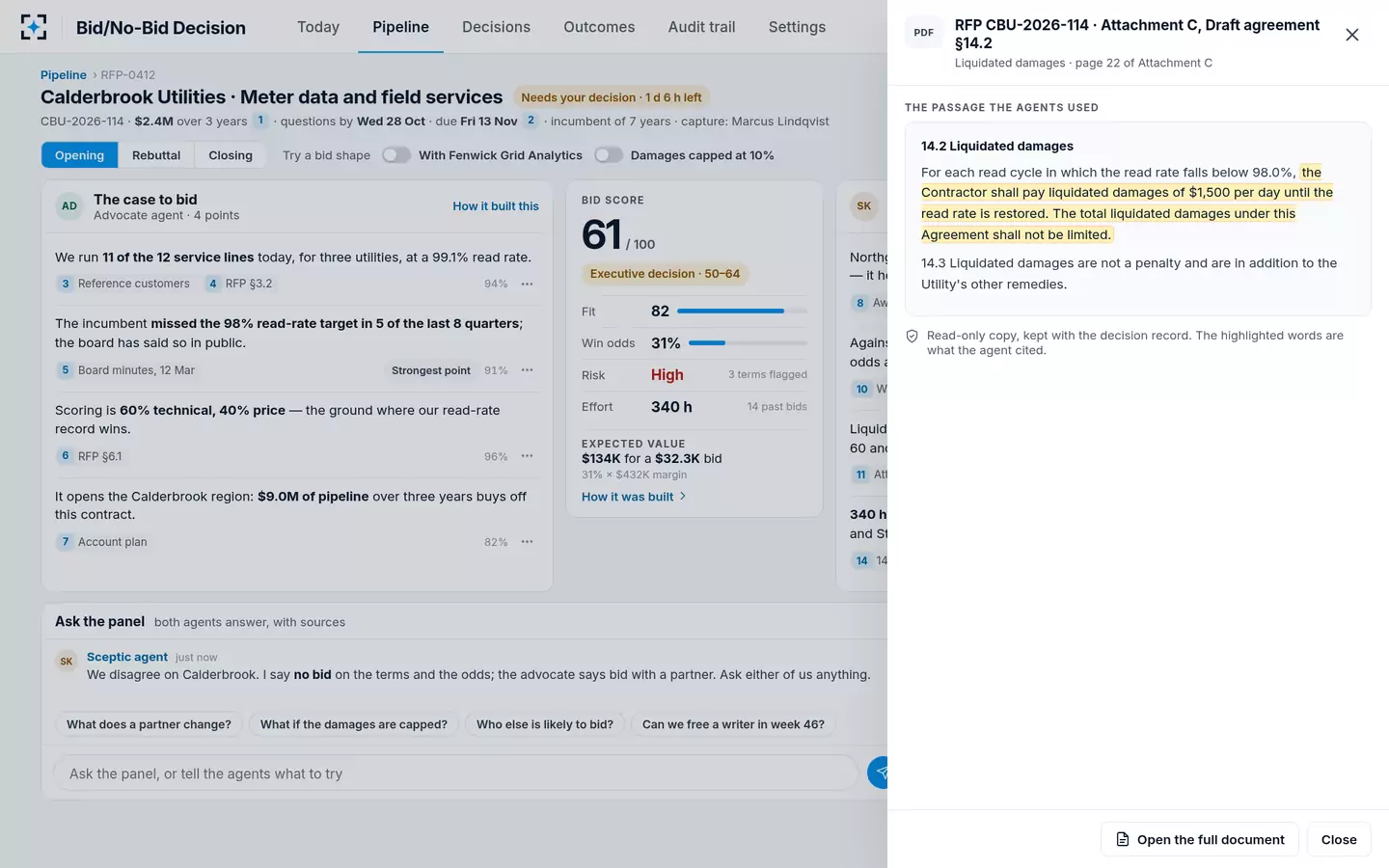

Terms agentThe terms agent checked 31 terms against the commercial risk policy and flagged 3. Liquidated damages, the fixed penalties for missed work, are $1,500 a day for each missed meter read cycle, with no cap. Payment comes 60 days after invoice. And the supplier must post a performance bond of 10% of annual value. Each flag opens the passage it came from. The agent also drafted a question asking the buyer to cap damages at 10% of annual value. A person sends it before the question deadline.
Attachment C §14.2: “The total liquidated damages under this Agreement shall not be limited.”
- 04Before the gate
The yes is priced in the team's real hours

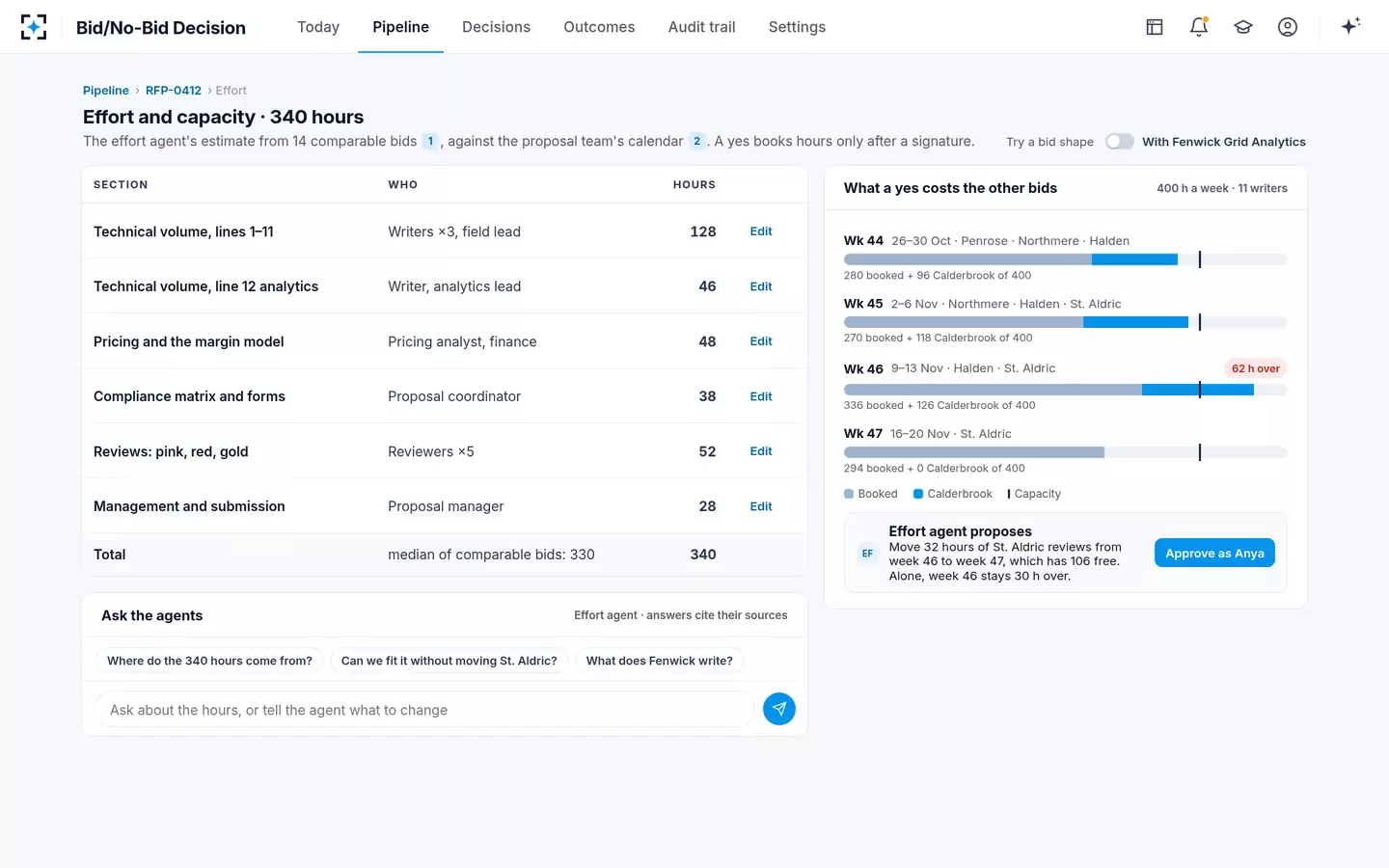

Effort agentThe effort agent looked at 14 comparable bids, with a median of 330 hours. It puts this RFP at 340 hours, split by section and role. Then it lays those hours on the proposal team's calendar, next to two other bids in progress. One week has 64 hours free, but this bid needs 126 there, which is 62 over. The agent proposes moving 32 hours of another bid's reviews to the next week, which has 106 hours free. Without a partner, the first week would still be 30 hours over. The proposal manager approves the move or turns it down.
Effort agent: estimates only. It books hours only after a signed decision.
- 05The debate
Two cited cases on one screen, with the score in the middle

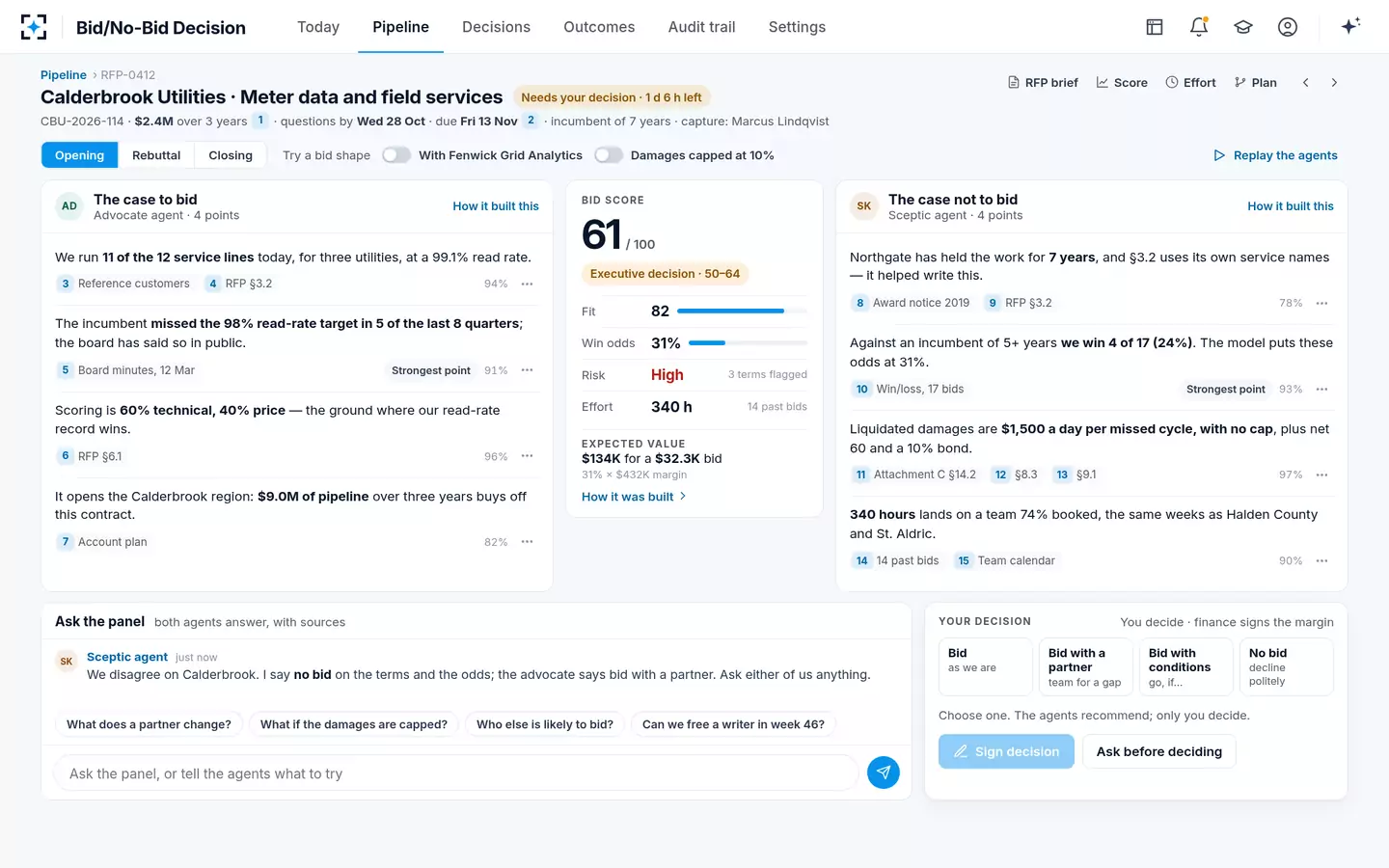

Advocate agent and sceptic agentThe scoring agent gives the RFP 61 under the bid criteria. That is in the executive decision band of 50 to 64. Fit is 82, win odds are 31%, risk is high and effort is 340 hours. The expected value is $134K, for a bid that costs $32.3K. On the left, the advocate makes the case to bid. The company runs 11 of 12 service lines at a 99.1% read rate, and the incumbent missed its target in 5 of 8 quarters. On the right, the sceptic makes the case against. The incumbent has 7 years in the job, and the company has won 4 of 17 bids against incumbents of 5 years or more.
- 06Rebuttal
Each agent must answer the other's strongest point

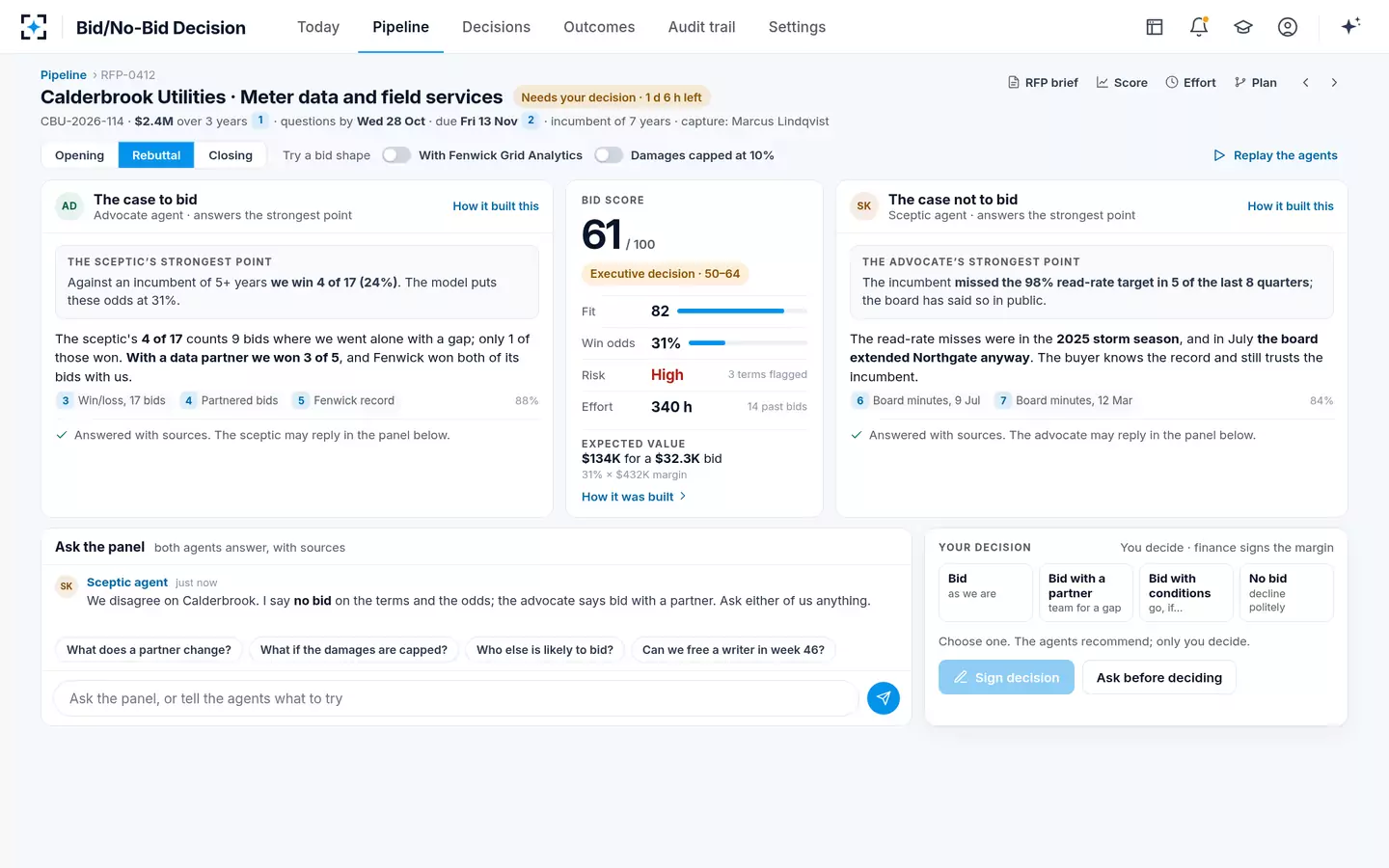

Advocate agent and sceptic agentThe advocate answers the sceptic's 4 of 17. Nine of those bids went in alone, with a gap in what the company could deliver. With a data partner, the team won 3 of 5. The sceptic answers the advocate's point about missed read rates. Those misses fell in last year's storm season, and in July the board extended the incumbent anyway. Neither agent can delete the other's point. The VP can strike one, with a reason kept on the record.
“The buyer knows the record and still trusts the incumbent.”
- 07Ask the panel
“What does a partner change?”

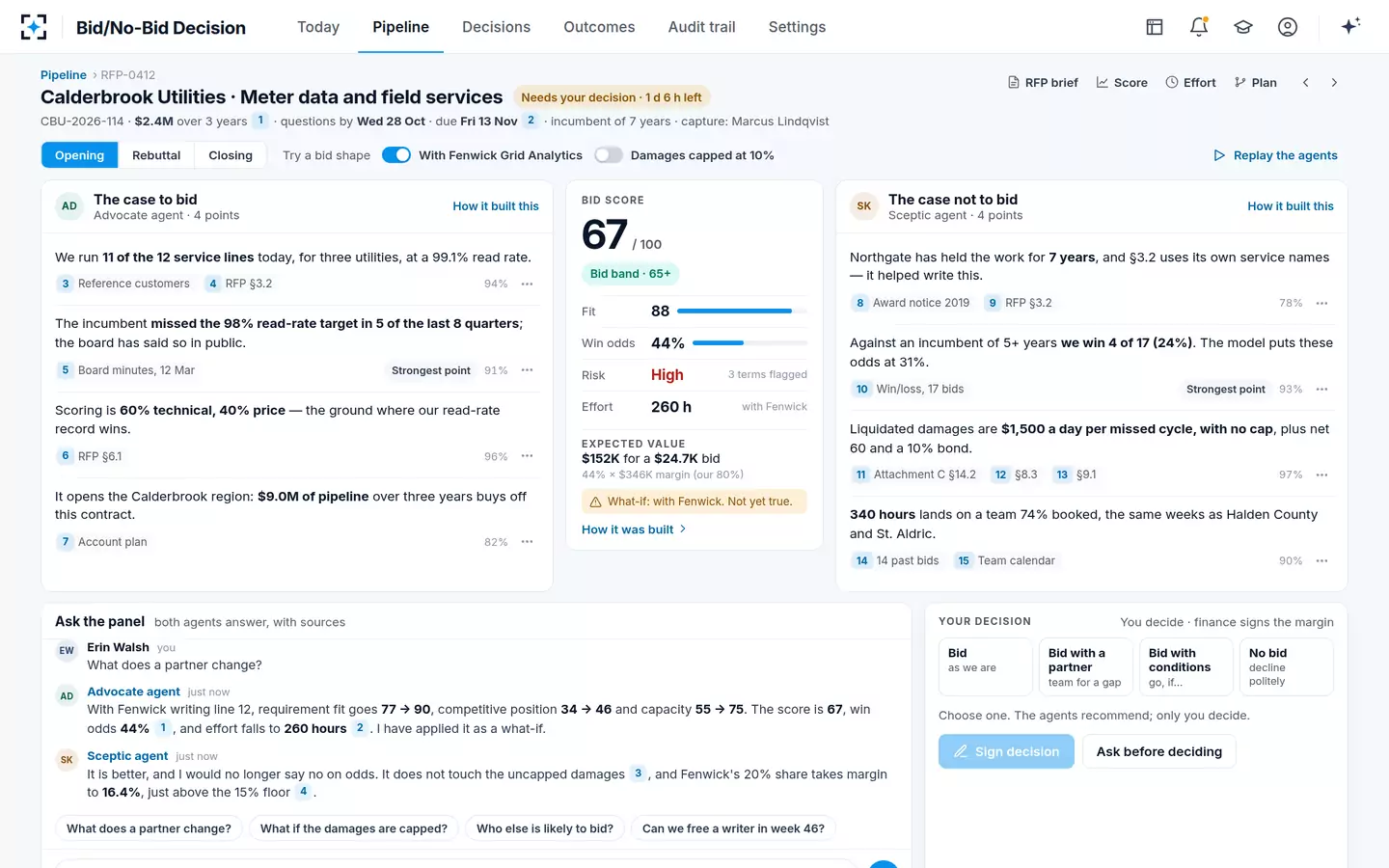

VP SalesThe VP asks, and both agents answer with sources. Suppose a data analytics partner writes line 12, meter data analytics. Then the score rises to 67, win odds rise to 44% and effort falls to 260 hours. The sceptic drops its objection on odds. But it points out that the damages are still uncapped. The partner's 20% share also takes the margin down to 16.4%, just above the 15% floor. The score is marked as a what-if until the VP decides.
“What-if: with the partner. Not yet true.”
- 0809:41
The VP decides, with reason codes and a signature

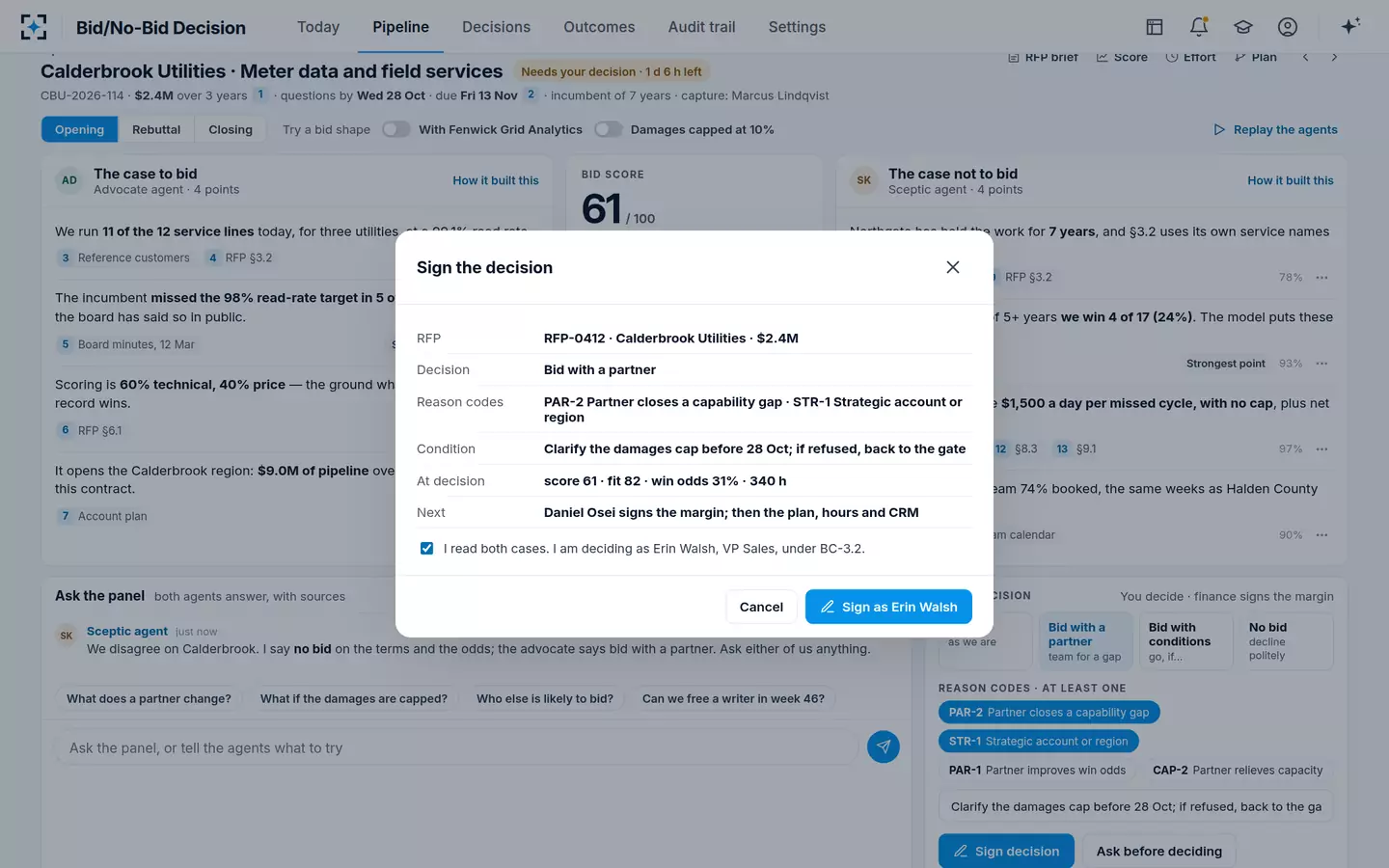

VP SalesThe VP chooses Bid with a partner. Two reason codes go with it: “partner closes a capability gap” and “strategic account or region”. A condition is added too. The damages cap must be clarified before the question deadline, and if the buyer refuses, the bid goes back to the gate. The agents recommend, and only the VP decides.
“I read both cases. I am deciding as VP Sales, under the bid criteria.”
- 09Signed
The bid plan follows the signature

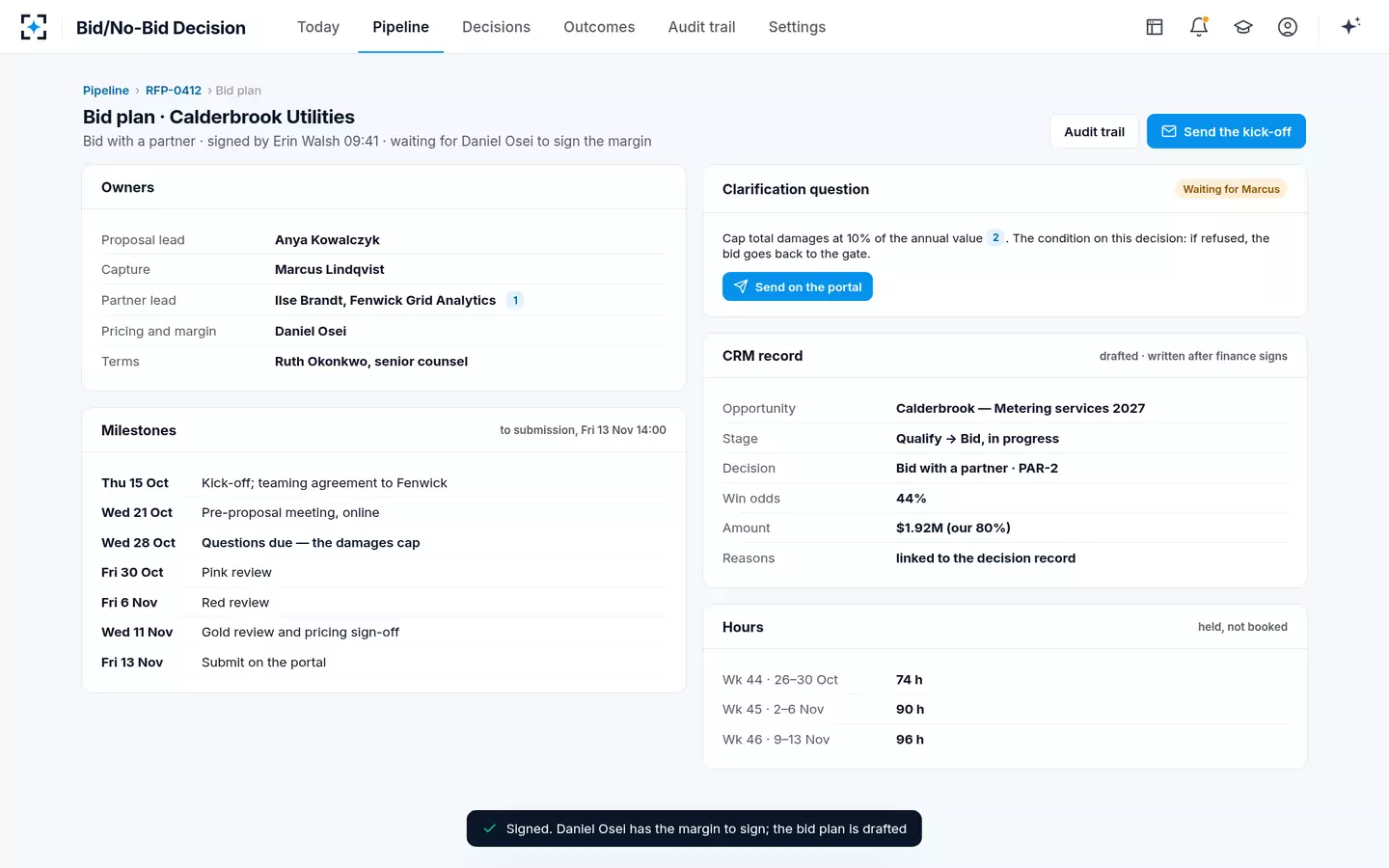

Proposal managerThe plan names the owners for proposal, capture, the partner, pricing and terms. It sets the milestones from kick-off to submission. Hours for the team are held for now, and nothing is booked yet. The CRM update to “Bid, in progress”, with the reasons, is drafted and gets written after finance signs. The clarification question waits for the capture manager to send it on the buyer's portal.
- 10Margin sign-off
From $1M, finance signs the margin

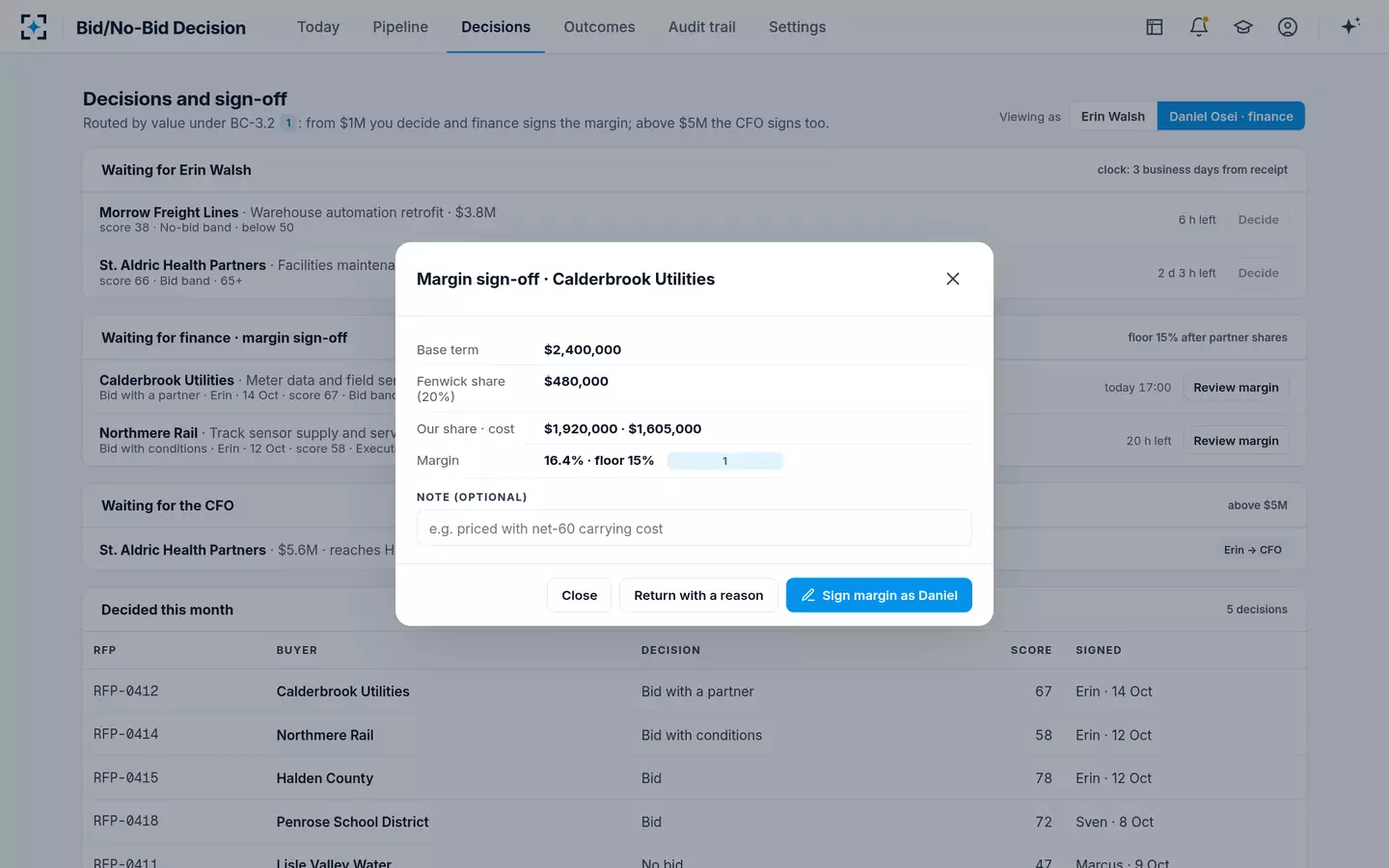

Finance business partnerThe RFP is worth $2.4M, so it goes to the finance business partner. Finance sees the working in the sign-off. The base term is $2,400,000, and the partner's share is $480,000. That leaves the company $1,920,000, against $1,605,000 of cost. The margin is 16.4%, against a floor of 15%. Finance signs or returns it with a reason. Above $5M, the CFO would sign too.

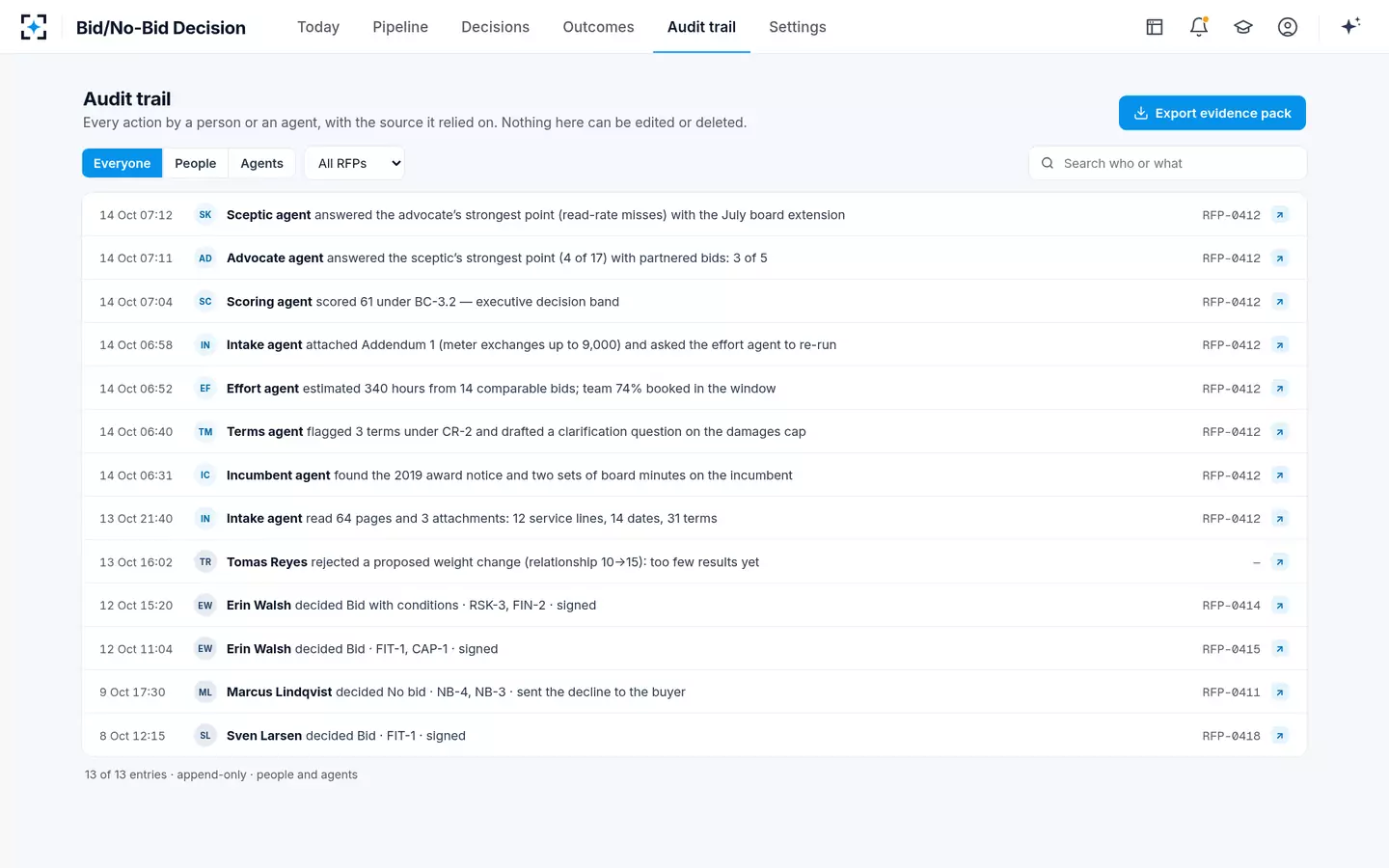

Each source, decision and signature is on the audit trail, which nothing can edit or delete.
