A framework lot three days from its deadline, checked and uploaded early
The company is bidding for Lot 2 of a port authority’s framework for quay wall and fender maintenance. It is worth EUR 18.6 million over four years, under an open procedure, submitted through TenderNed. The deadline is noon on Thursday. In the year before, 3 of the company's 41 bids were set aside on a formality. The causes were an expired ISO 9001, an unsigned Form of Tender and a DOCX file where a PDF was required. It is Monday morning, three days out. Here is how the bid manager works with the agents, screen by screen in the working solution. It shows what the bid manager asks, what they approve and the evidence they see.
A worked example on sample data. Names, IDs and figures on the screens and in this section come from the demo.
- 01Monday, 08:10
Three things need the bid manager, and the agents say why

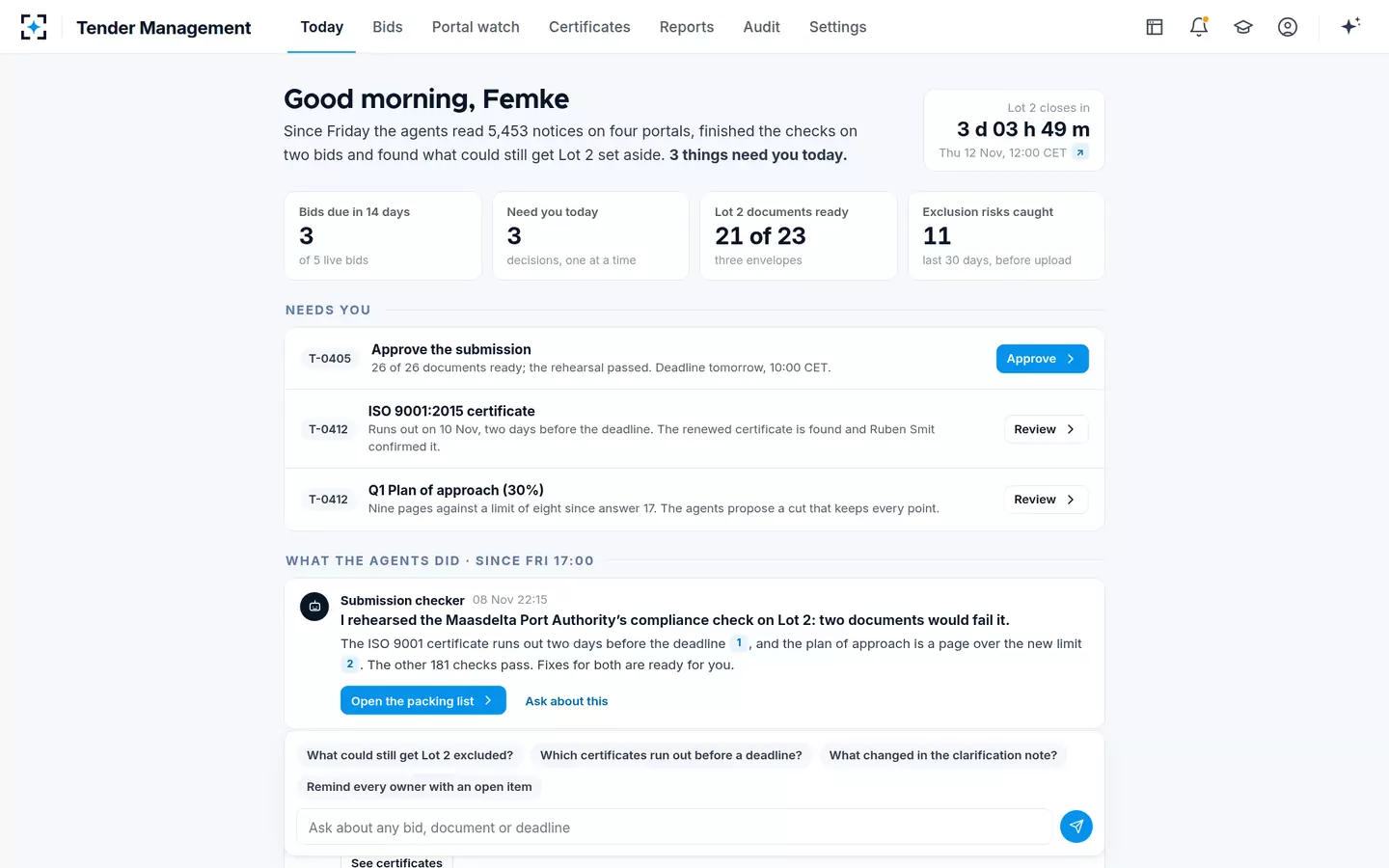

Bid managerSince Friday the agents read 5,453 notices on four portals and finished the checks on two bids. The briefing shows 3 bids due in 14 days and 3 decisions waiting. Lot 2 has 21 of 23 documents ready, under a countdown to the deadline. The submission checker’s note from 22:15 last night leads the thread, with the passages it cites. Below it, the bid manager can ask about any bid, document or deadline.
Submission checker: “I rehearsed the port authority’s compliance check on Lot 2: two documents would fail it.”
- 02Four weeks earlier
The notice is proposed, with its reasons

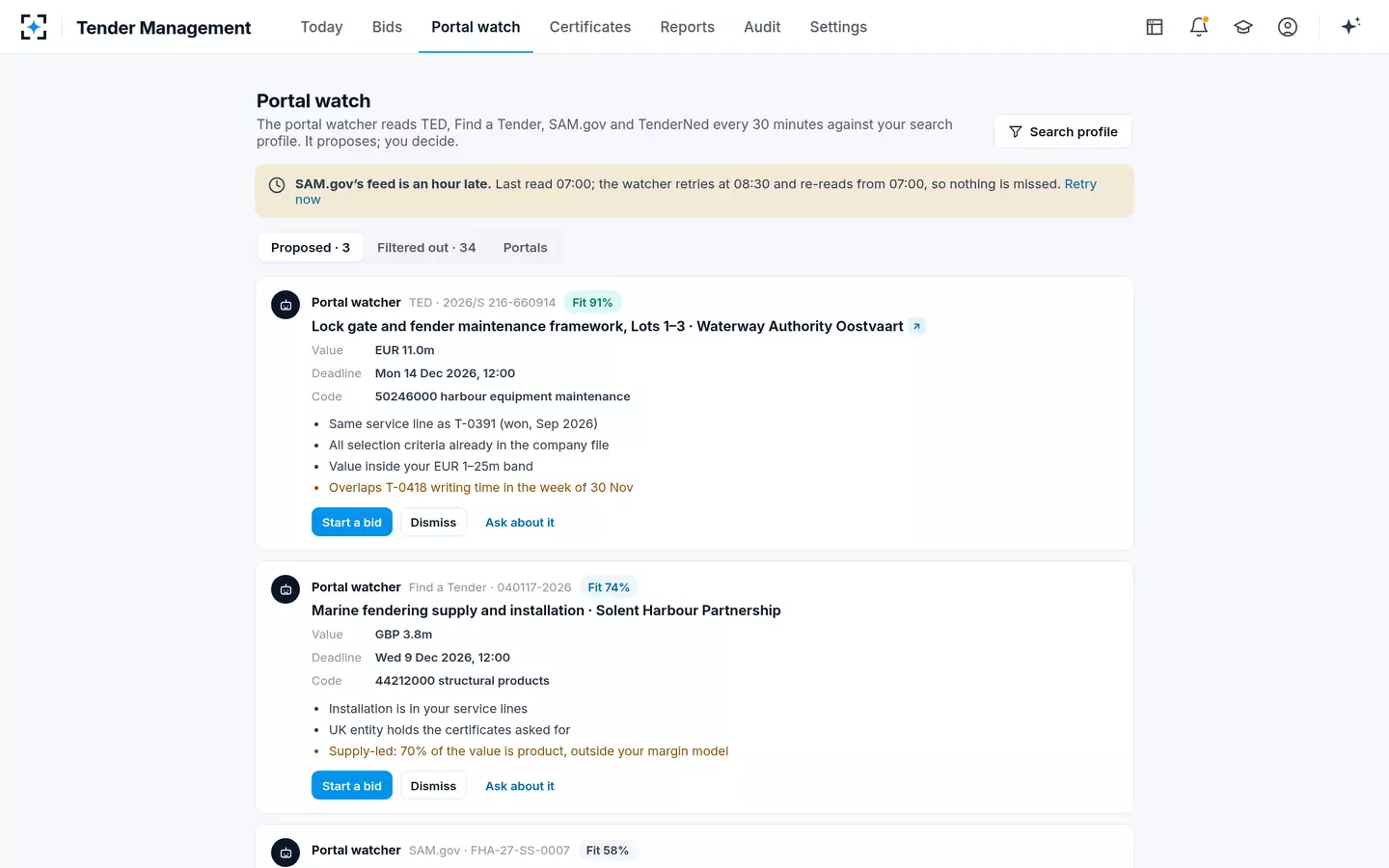

Portal watcherThe portal watcher reads TED, Find a Tender, SAM.gov and TenderNed every 30 minutes against the search profile. At 06:12 it proposed the TED notice for Lot 2, with a fit of 88%. The bid manager started the bid at 08:40, with the reason “core service line”. Each proposal shows its value, deadline, code and what speaks for and against it. Each notice filtered out keeps its reason.
“It proposes; you decide.” The watcher does not register interest or download behind a login before a person starts the bid.
- 03Read and re-read
508 pages, 132 requirements, each with its page

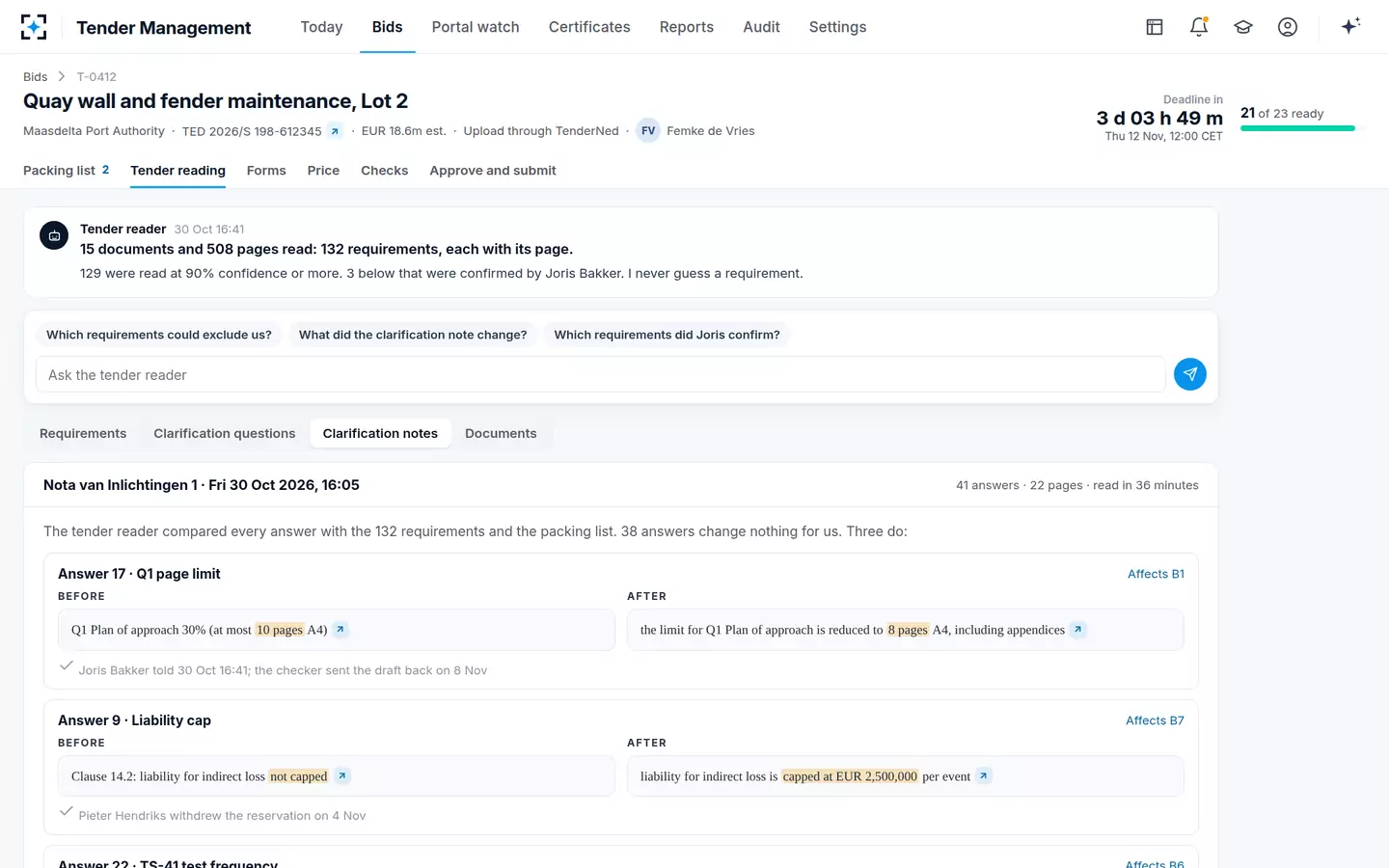

Tender readerThe tender reader read 15 documents. They include the notice, instructions to tenderers, the 128-page Lot 2 specification, contract conditions, price schedule and drawings. The first clarification note (Nota van Inlichtingen) is there too. Of the requirements, 129 were read at 90% confidence or more. The 3 below that went to the bid writer to confirm. The clarification note has 41 answers, and three change the work. Each is shown before and after. Answer 17 cuts the Q1 plan of approach from 10 to 8 pages. Answer 9 caps liability at EUR 2,500,000 per event. Answer 22 sets the fender test frequency.
Tender reader: “I never guess a requirement.”
- 04Last night, 22:15
A rehearsal of the buyer's own compliance check

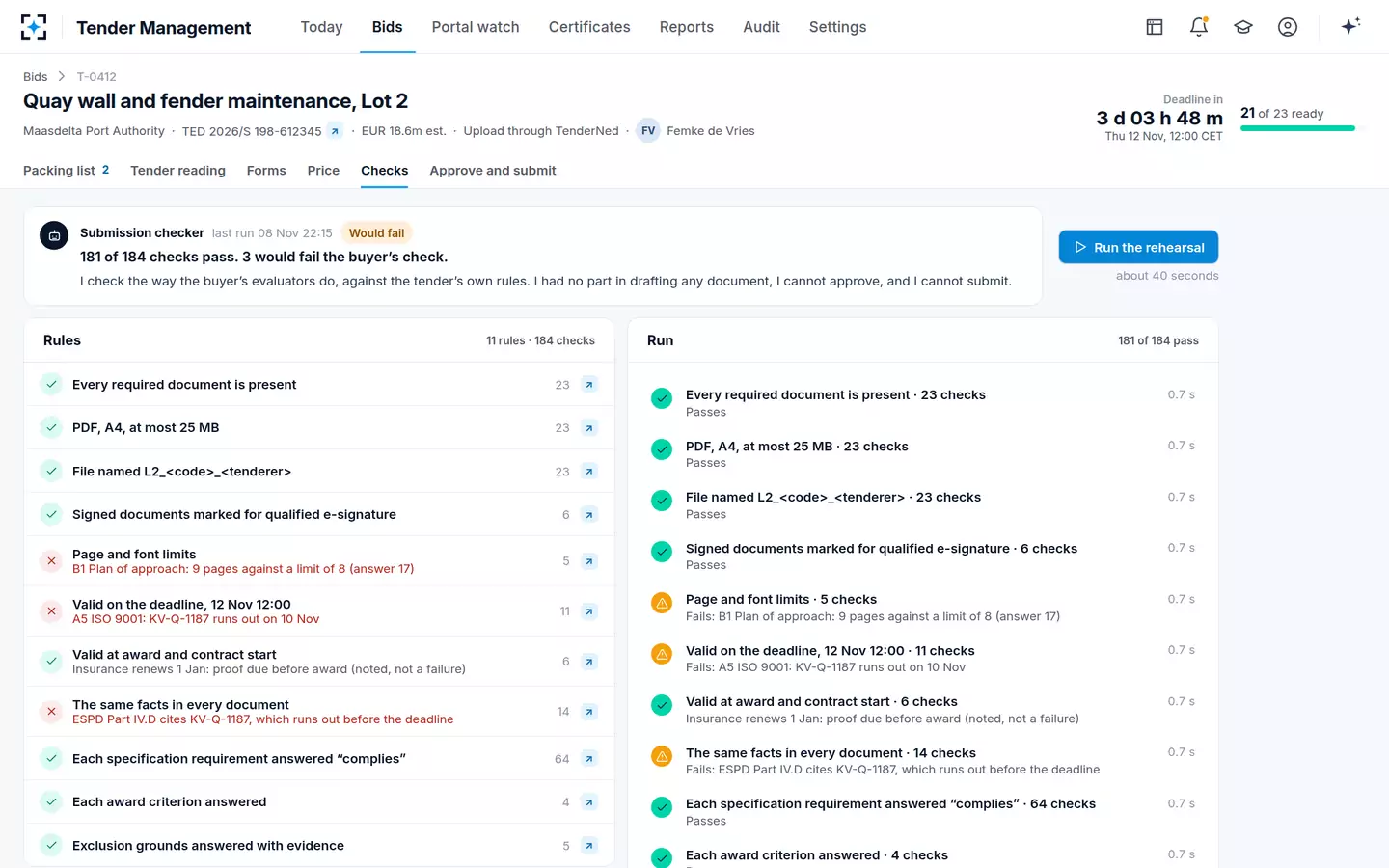

Submission checkerThe submission checker runs the tender’s own rules over the whole packing list. That is 184 checks across 11 rules. They cover presence, PDF and size, file names, qualified e-signatures and page limits. They also cover validity on the deadline and at award, and the same facts in each document. Of the checks, 181 pass and three would fail. The plan of approach is 9 pages against 8. The ISO 9001 certificate runs out two days before the deadline. ESPD Part IV.D cites that same certificate.
“I had no part in drafting any document, I cannot approve, and I cannot submit.”
- 05The bid manager asks
“What could still get Lot 2 excluded?”

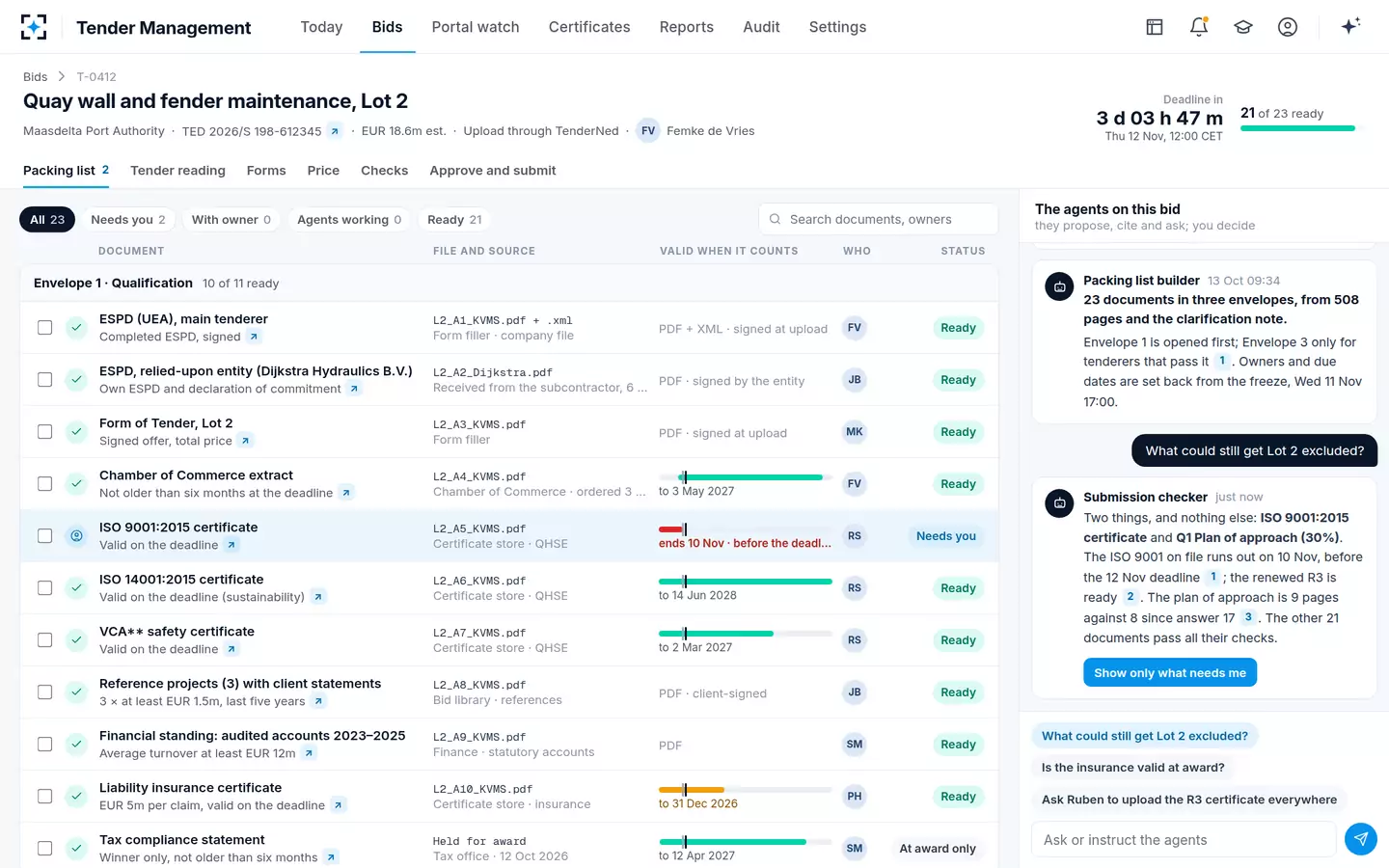

Bid managerThe packing list holds 23 documents in three envelopes. The envelopes are the separate parts of the bid: qualification, technical offer and price. Each document shows its file, source, owner and a bar for whether it is valid when it counts. The bid manager asks the agents beside it. The answer names two things and nothing else, with the passages cited. One click filters the list to what needs the bid manager.
Submission checker: “Two things, and nothing else: ISO 9001:2015 certificate and Q1 Plan of approach (30%). The other 21 documents pass all their checks.”
- 06The ISO item

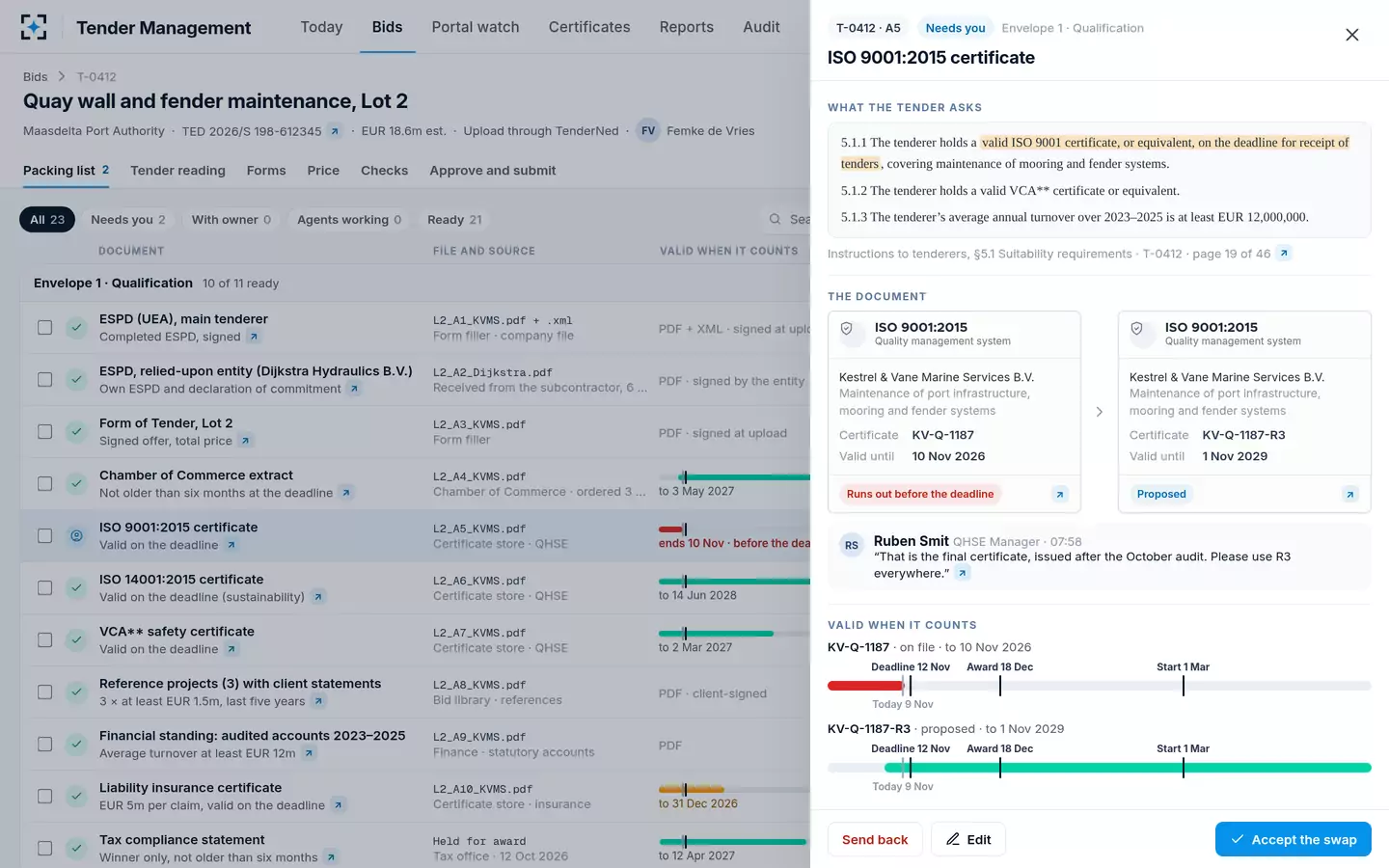

The certificate runs out two days before the deadline

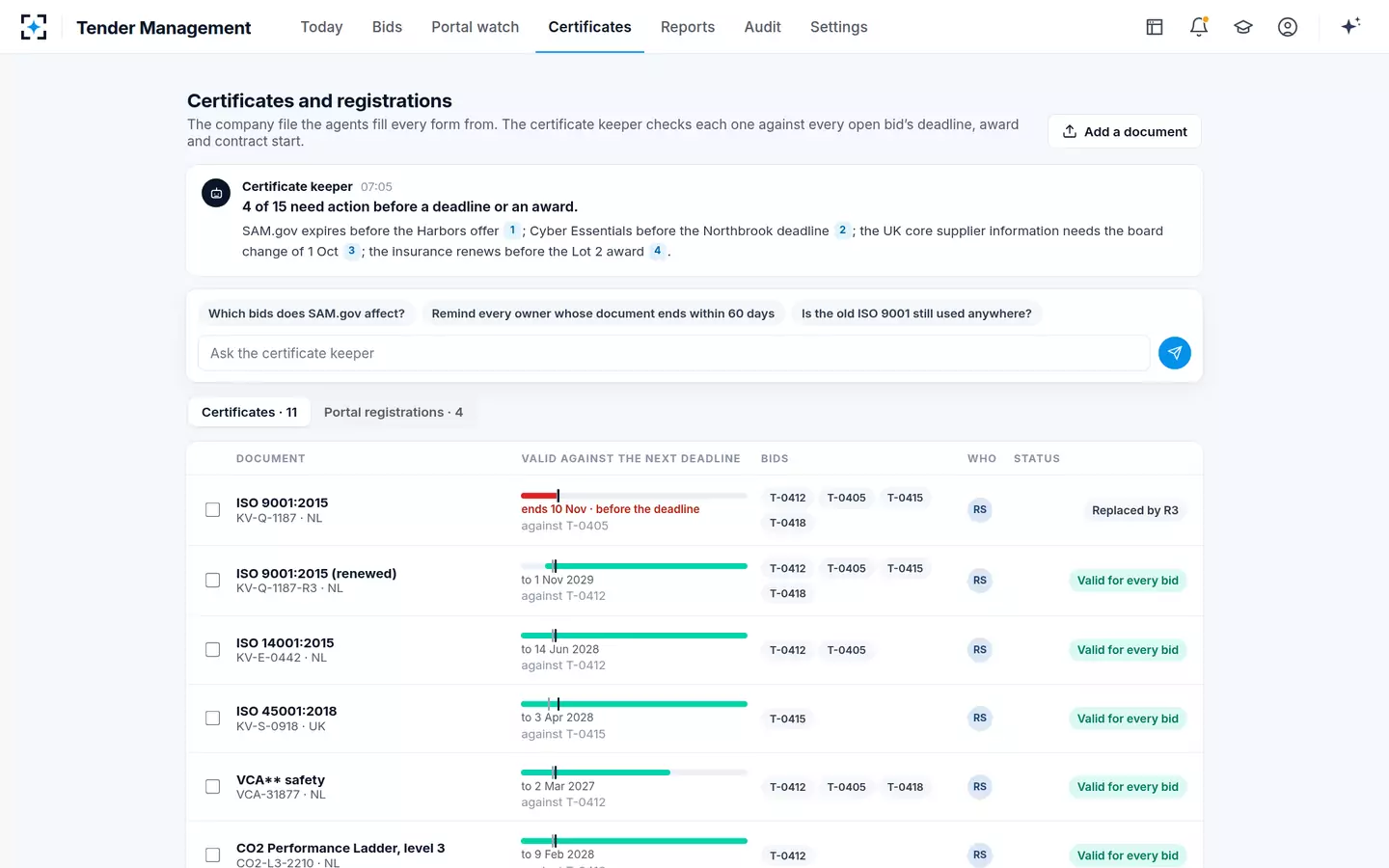

Certificate keeperSection 5.1.1 of the instructions asks for a valid ISO 9001 certificate on the deadline for receipt of tenders. The certificate on file runs out two days before it. The certificate keeper found the renewed certificate, issued after the recertification audit, and asked its owner. Each certificate is checked against three dates. These are the deadline, the planned award and the contract start.
QHSE manager: “That is the final certificate, issued after the audit. Please use it everywhere.”
- 07Accepted

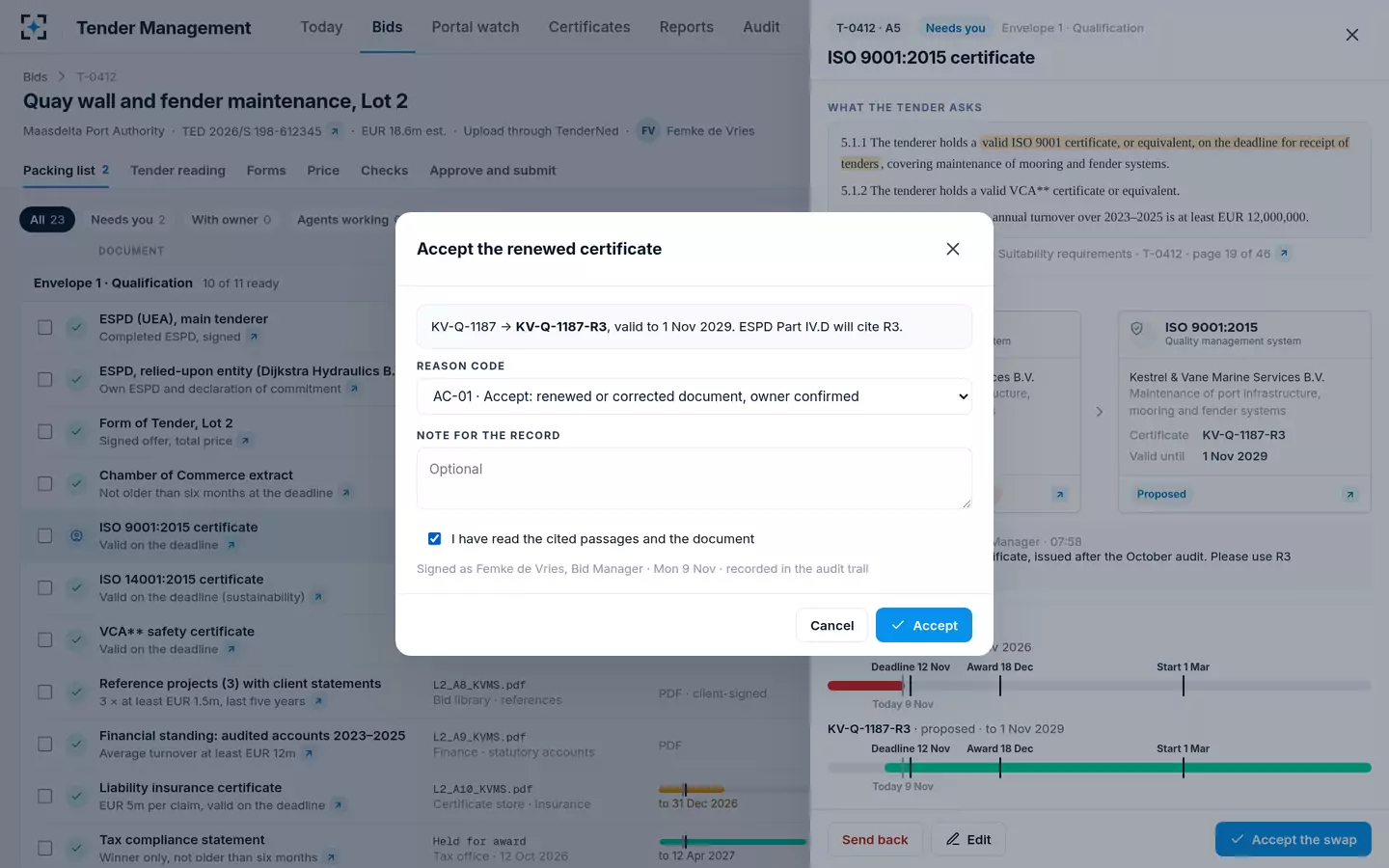

The swap accepted with a reason code

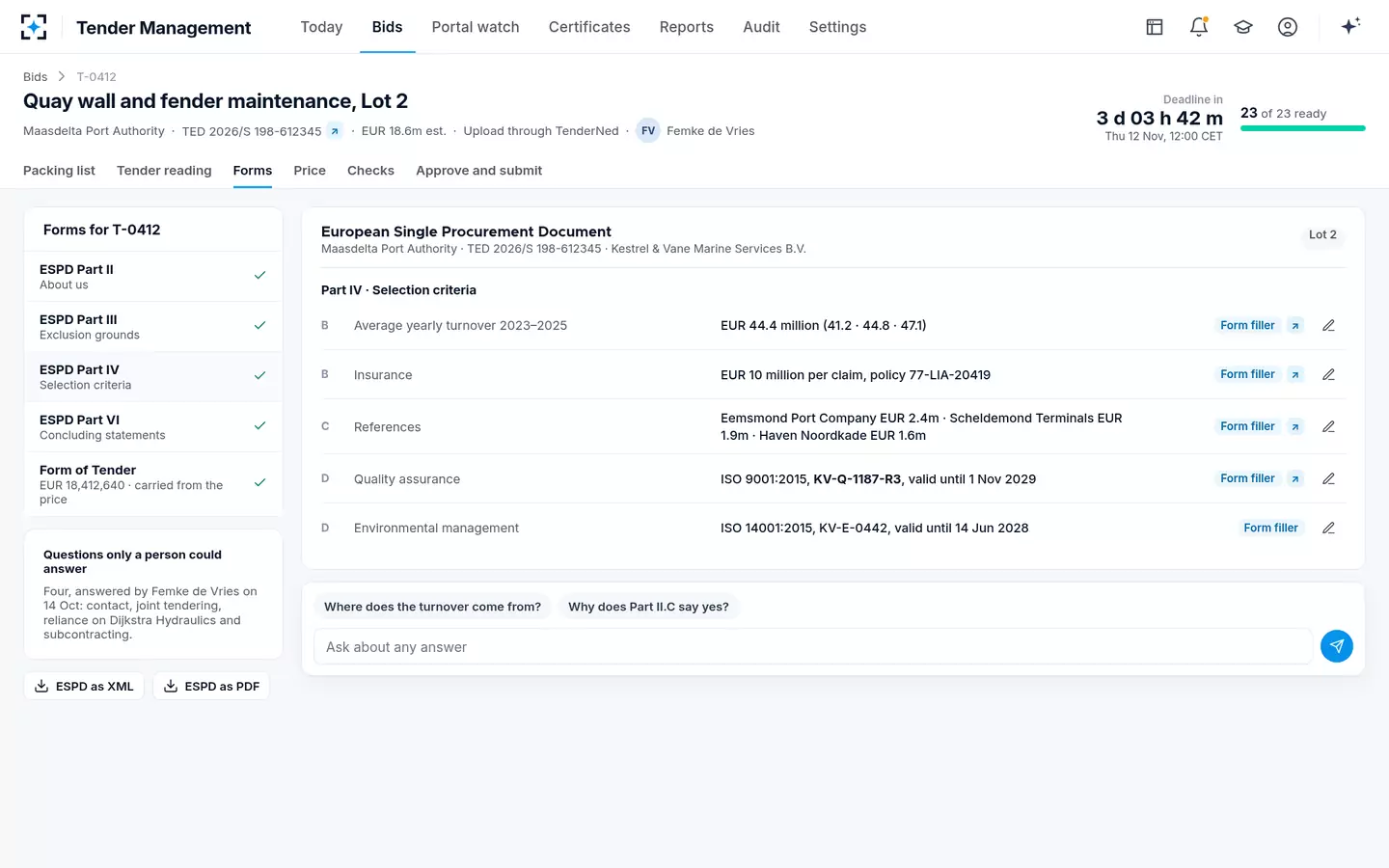

Bid managerThe bid manager picks the reason code “Accept: renewed or corrected document, owner confirmed”. They tick that they read the cited passages and the document. The form filler updates ESPD Part IV.D to the renewed certificate. Then the submission checker re-checks the certificate and the ESPD before the item turns ready.
“Signed by the bid manager · recorded in the audit trail.”
- 08The plan of approach

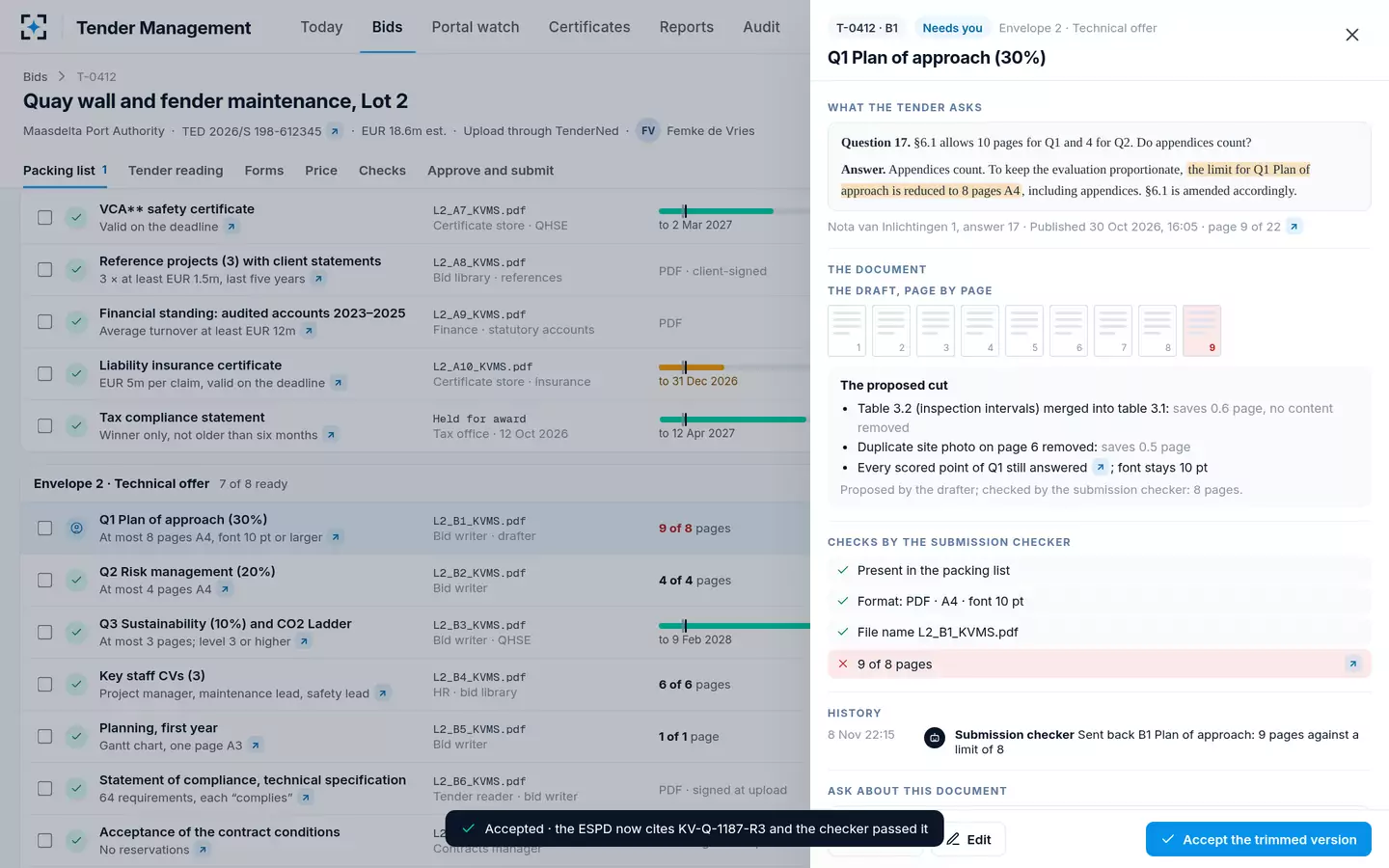

Nine pages against eight, cut without losing a point
Bid drafterSince answer 17, appendices count toward the limit, and Q1 is limited to 8 pages A4. The draft runs to 9. The bid drafter proposes merging two tables and removing a duplicate site photo on page 6. Each scored point of Q1 is still answered, and the font stays 10 pt. The submission checker counts 8 pages, and the bid manager accepts the trimmed version.
The bid drafter does not add a claim without a source, and a person accepts each edit.
- 09Step 3 of 4
The submission approved, one item noted for award

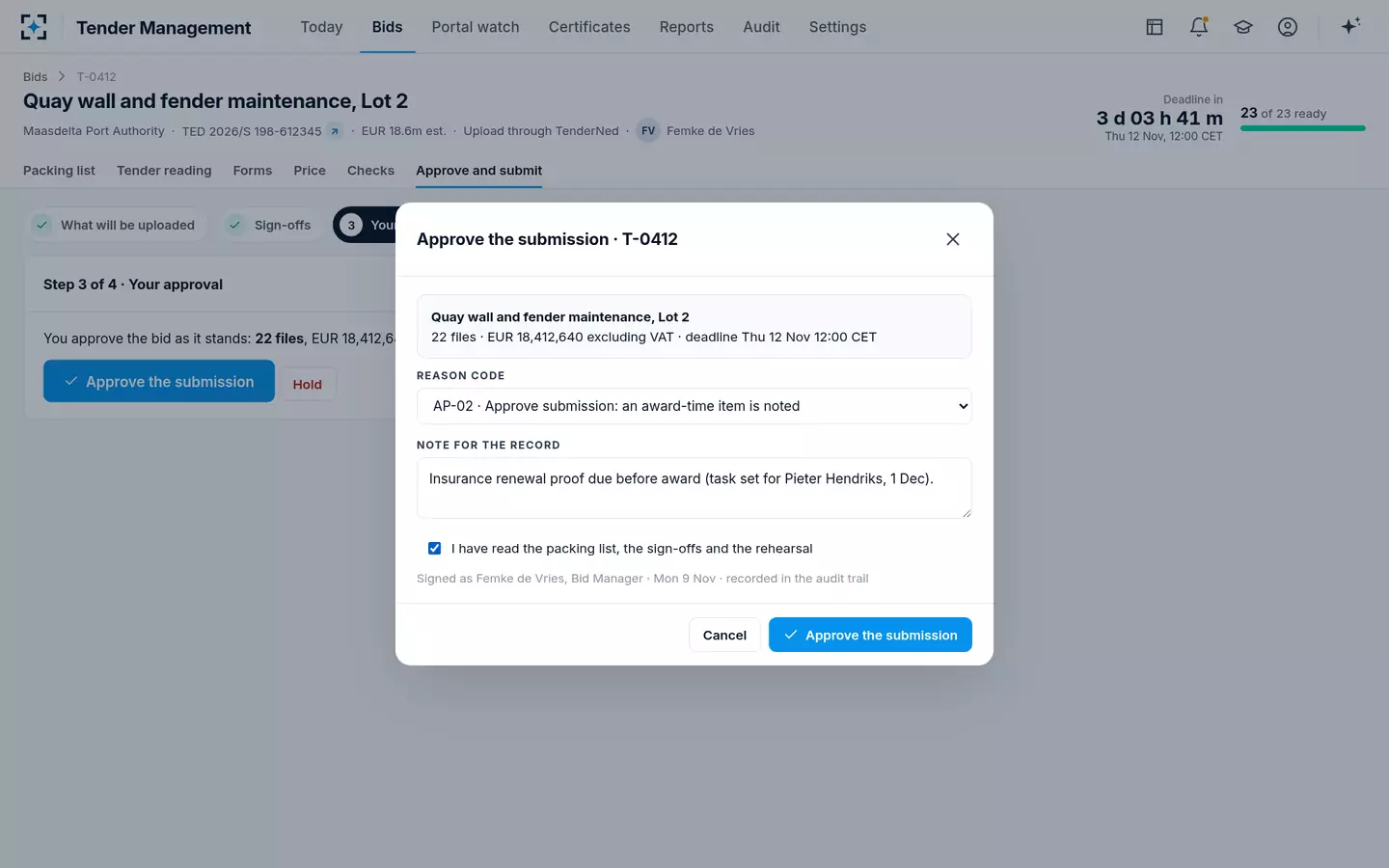

Bid managerThe rehearsal now passes 184 of 184 checks. All sign-offs are in. The finance manager signed the price. The contracts manager confirmed the bid has no reservations, or conditions on the offer, and signed off the exclusion grounds. The QHSE manager signed the renewed certificate. Next, the bid manager approves 22 files at EUR 18,412,640 excluding VAT, with a reason code. A note records that proof of the insurance renewal is due before award.
Approval stays closed while any item is open, and says what is missing.
- 10Received, three days early
Signed and uploaded, with the receipt read back

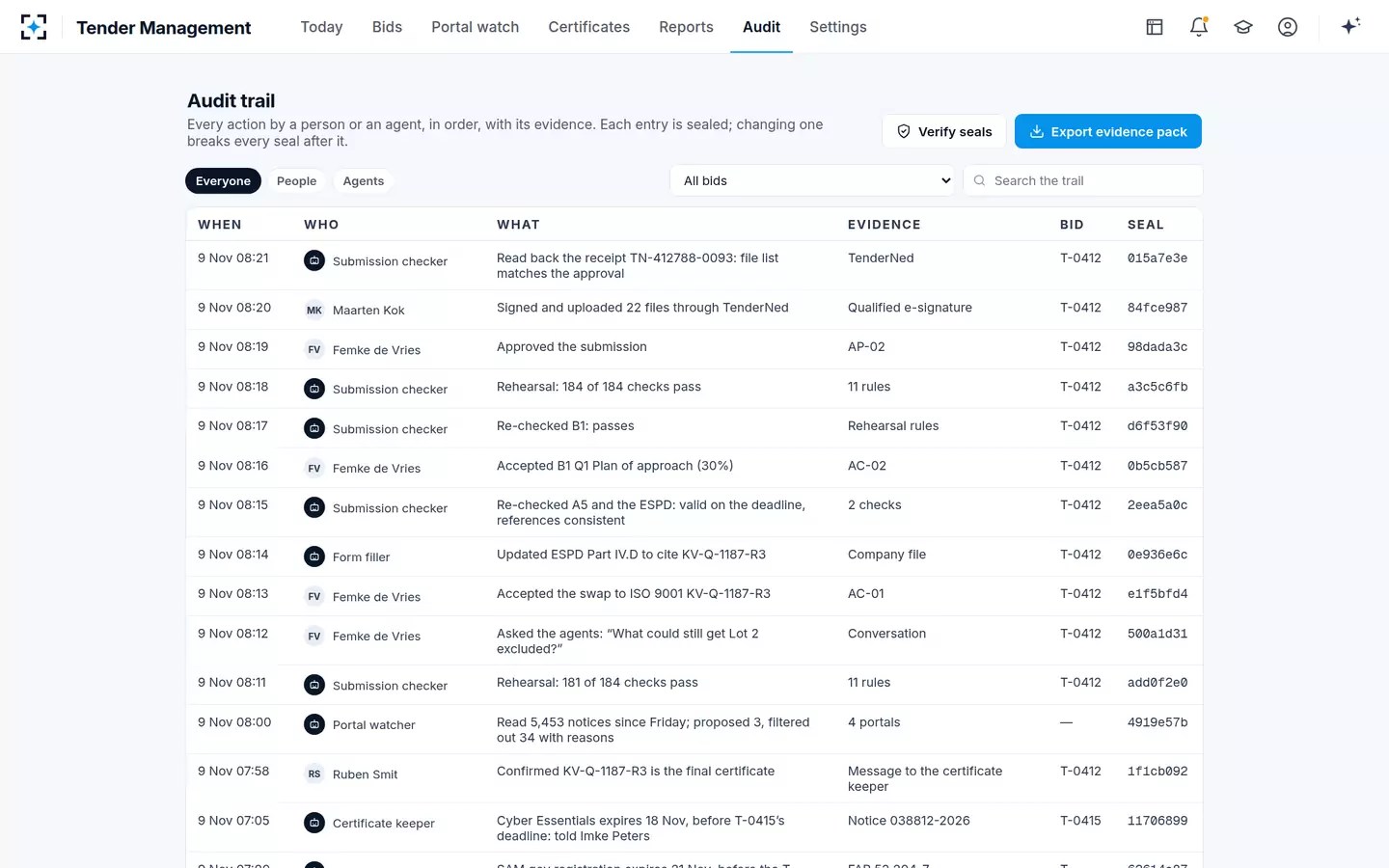

Authorized signatoryThe managing director is the authorized signatory. They sign with a qualified e-signature and upload the 22 files in three envelopes through TenderNed. The tax compliance statement is held for award, as the tender allows. The portal’s receipt is read back and checked against the file list, 3 days 3 hours before the deadline. Each step, by the agents and by each person, is a sealed entry on the audit trail.
“Each entry is sealed; changing one breaks every seal after it.”
