- Before
- Owns this year's program of 48 lots and 6,050 samples. Sees a lot's result only when the annual tables are built, too late to act on a failing lot.
- Now
- Watches each lot's quality score move as results arrive and sees the point where a lot can no longer pass. Signs once to open the replacement program.
A failing 2016 meter lot, signed for replacement
The sample utility has split its electricity and water meters into 48 lots for this year's sample program. One lot is 8,400 single-phase smart meters of one make and model. They were bought in 2016 and are spread across four districts. One Tuesday morning, a test board in the meter shop has 14 new results. Here is what happens next, screen by screen, in the working solution.
A worked example on sample data. Names, IDs and figures on the screens and in this section come from the demo.
- 01Morning

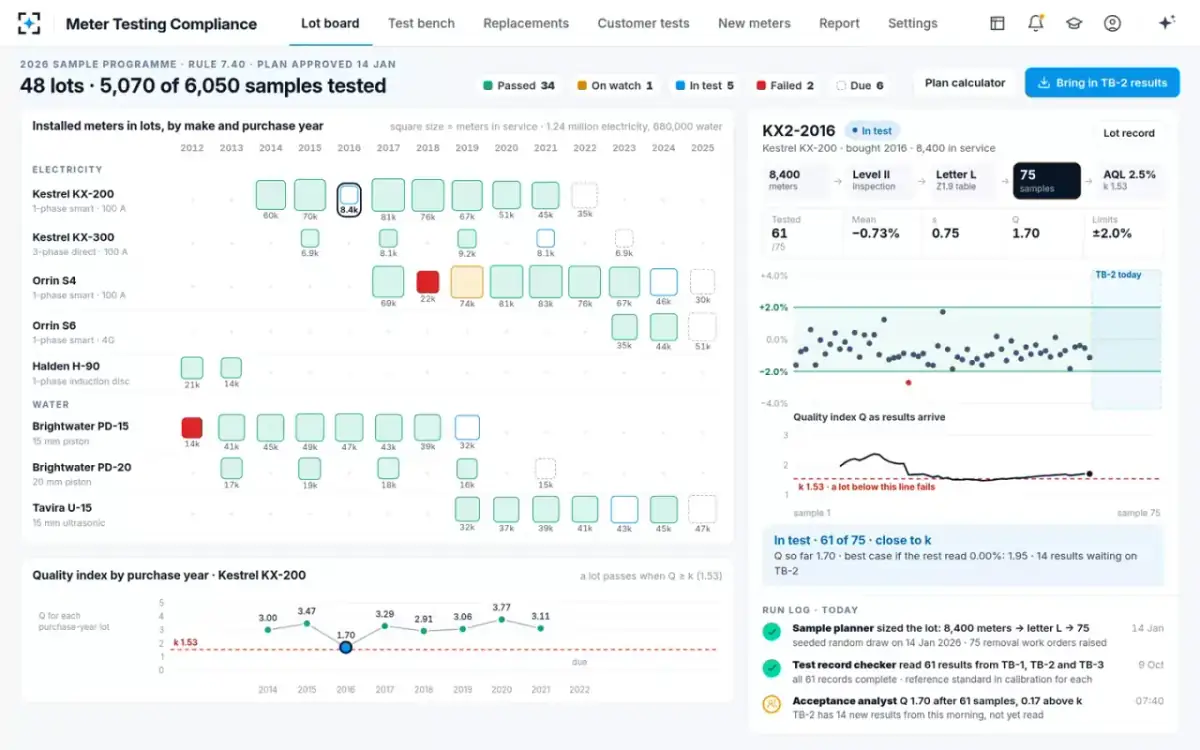

All the meters in service on one lot board
Metering engineerThe metering engineer owns this year's sample program and signs each lot decision. The lot board shows each lot as a square sized to its meters in service. Make runs down the board and purchase year runs across. On the board, 34 lots have passed, 1 is on watch, 5 are in test, 2 have failed and 6 are due. So far 5,070 of 6,050 samples are tested. The 2016 lot is in test at 61 of 75. Its quality score, called Q, is 1.70. To pass, Q must reach the lot's pass mark k, here 1.53.
“In test · 61 of 75 · close to k. Q so far 1.70 · best case if the rest read 0.00%: 1.95. 14 results waiting on the board.”
- 02The sample plan

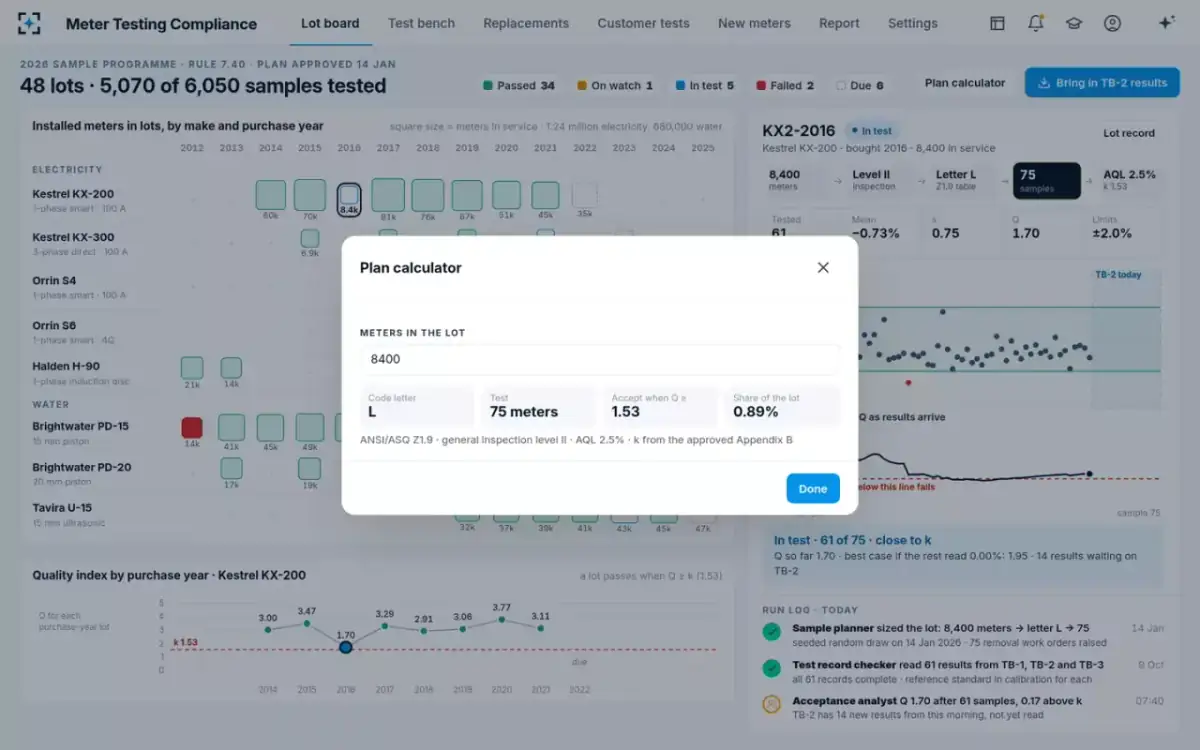

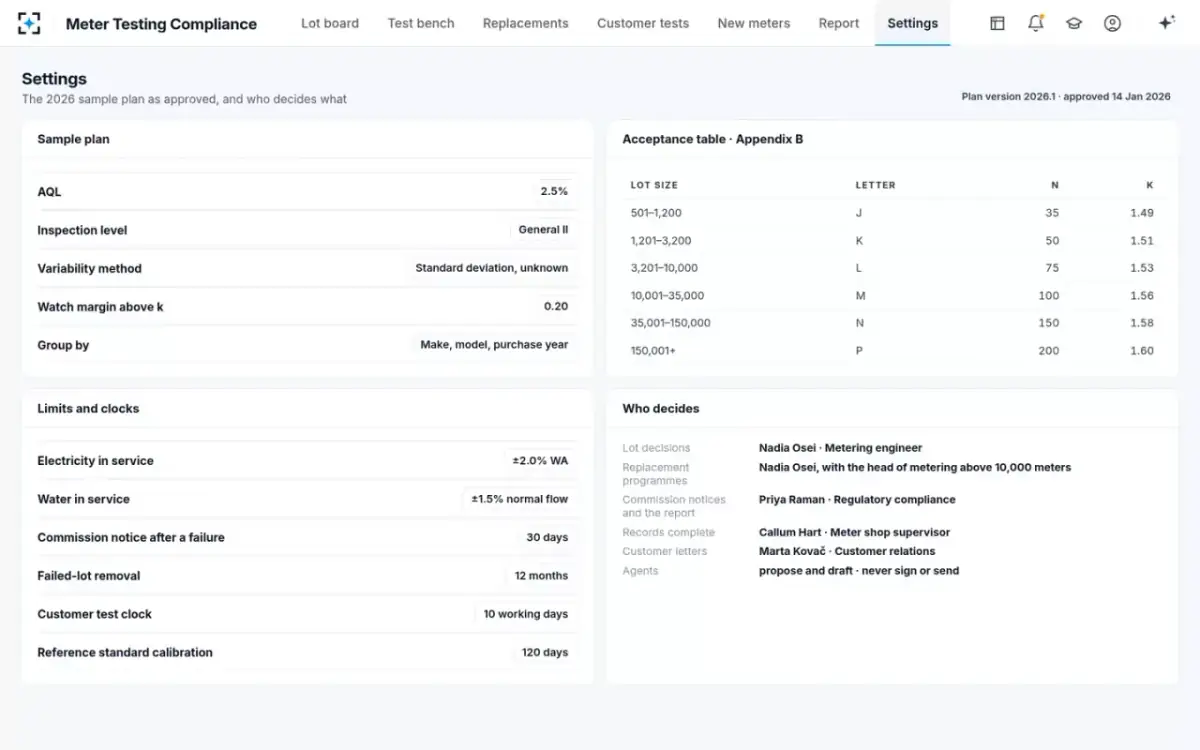

Each lot's sample sized to the standard
Sample plannerThe plan fits on one line. This lot has 8,400 meters, tested at general inspection level II. That gives code letter L from the Z1.9 table, 75 samples, an acceptable quality level of 2.5% and a pass mark k of 1.53. For any lot size, the plan calculator works out the letter, the sample and k from the approved table. The sample was drawn at random early in the year, and 75 removal work orders were raised the same day.
Limit: the sample planner does not redraw a sample once results exist, and the random seed stays on the record.
- 0307:40

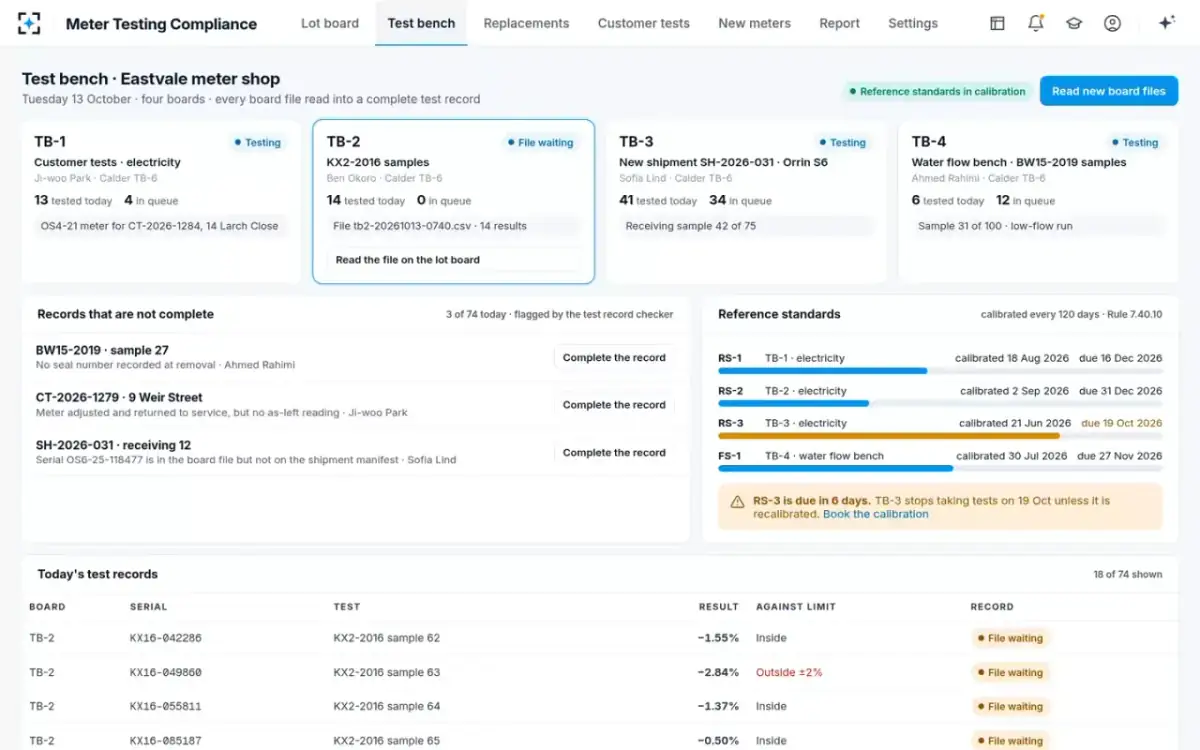

Fourteen results waiting on the test board
Meter technicianThe technician tested 14 samples from the 2016 lot this morning, and the board file is waiting. The other boards are busy. One has customer tests, the next has a new shipment of another model, and the fourth has water samples. The test record checker has flagged 3 of 74 records today as incomplete. One reference standard, the precise meter a board tests against, is due for calibration in 6 days.
“The reference standard is due in 6 days. Its board stops taking tests next week unless it is recalibrated.”
- 0410:16

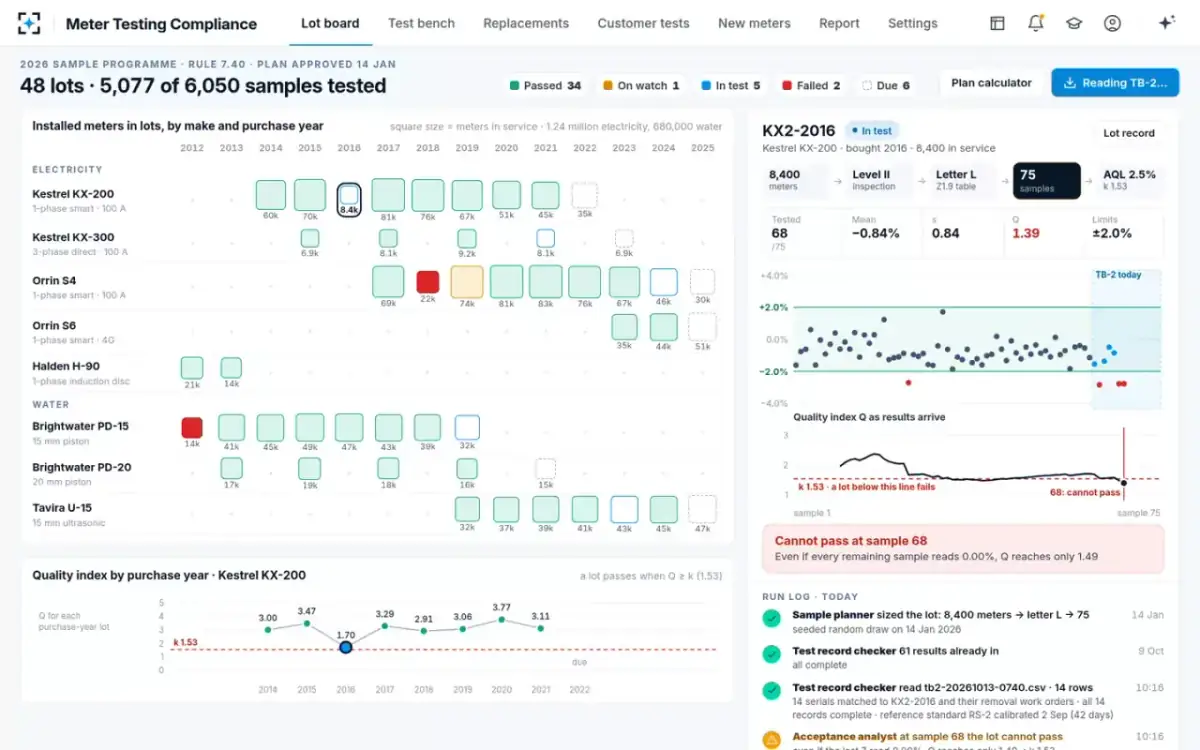

At sample 68, the lot can no longer pass
Test record checker and Acceptance analystThe test record checker reads the file. It has 14 rows, and each serial number matches the lot and its removal work order. All 14 records are complete, and the board's reference standard was calibrated last month. The acceptance analyst plots each result against the ±2% band and redraws the running quality score. Most meters read slow at light load. At sample 68 the analyst shows the lot cannot reach k, whatever the last seven read.
“Cannot pass at sample 68: even if each remaining sample reads 0.00%, Q reaches only 1.49”
- 0510:17

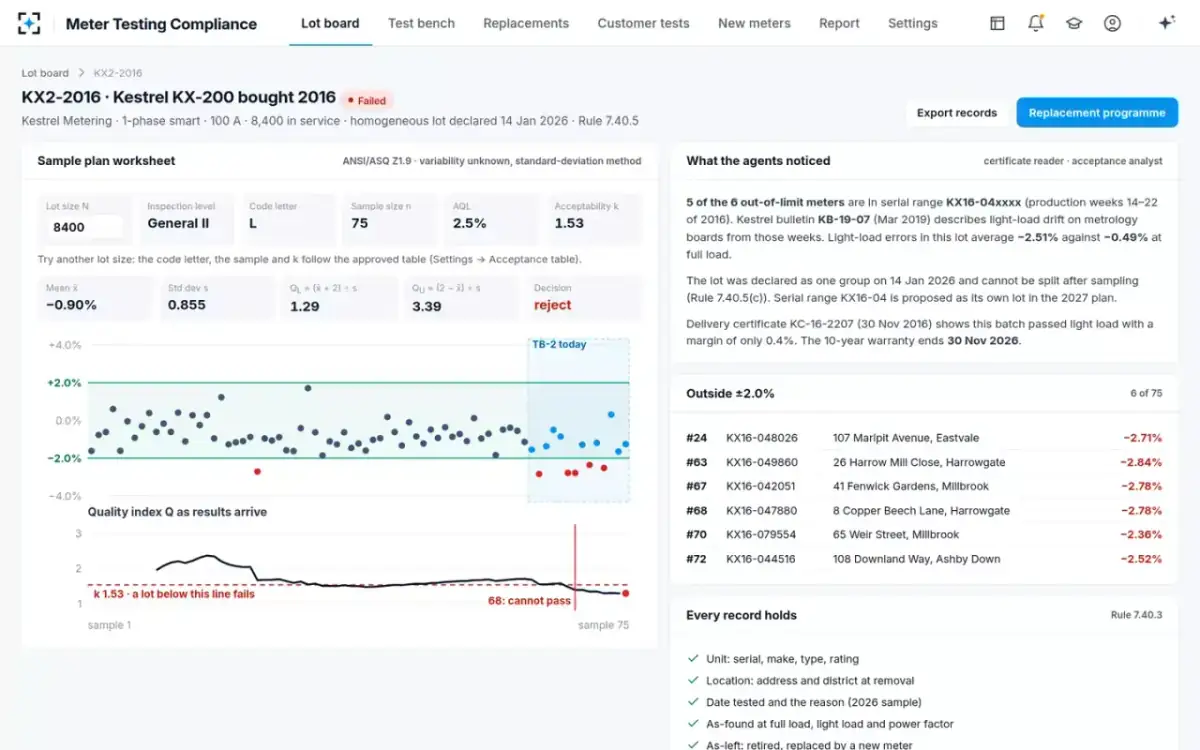

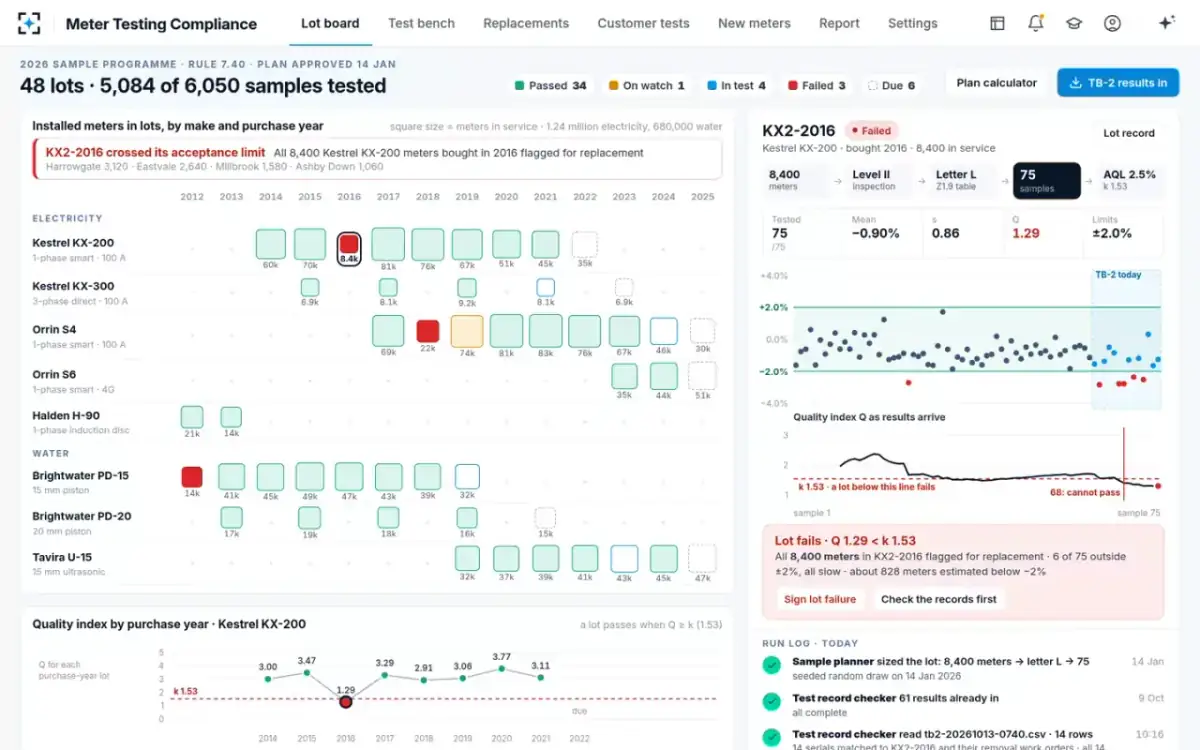

The lot crosses its acceptance limit
Acceptance analystAt 75 of 75 the lot fails. The average error is −0.90%, the spread is 0.86, and Q is 1.29 against a k of 1.53. Six of the 75 meters are outside ±2%, and all of them read slow. About 828 meters in the lot are estimated to read below −2%. The lot turns red on the board. All 8,400 meters are flagged for replacement by district, from 3,120 in the largest to 1,060 in the smallest.

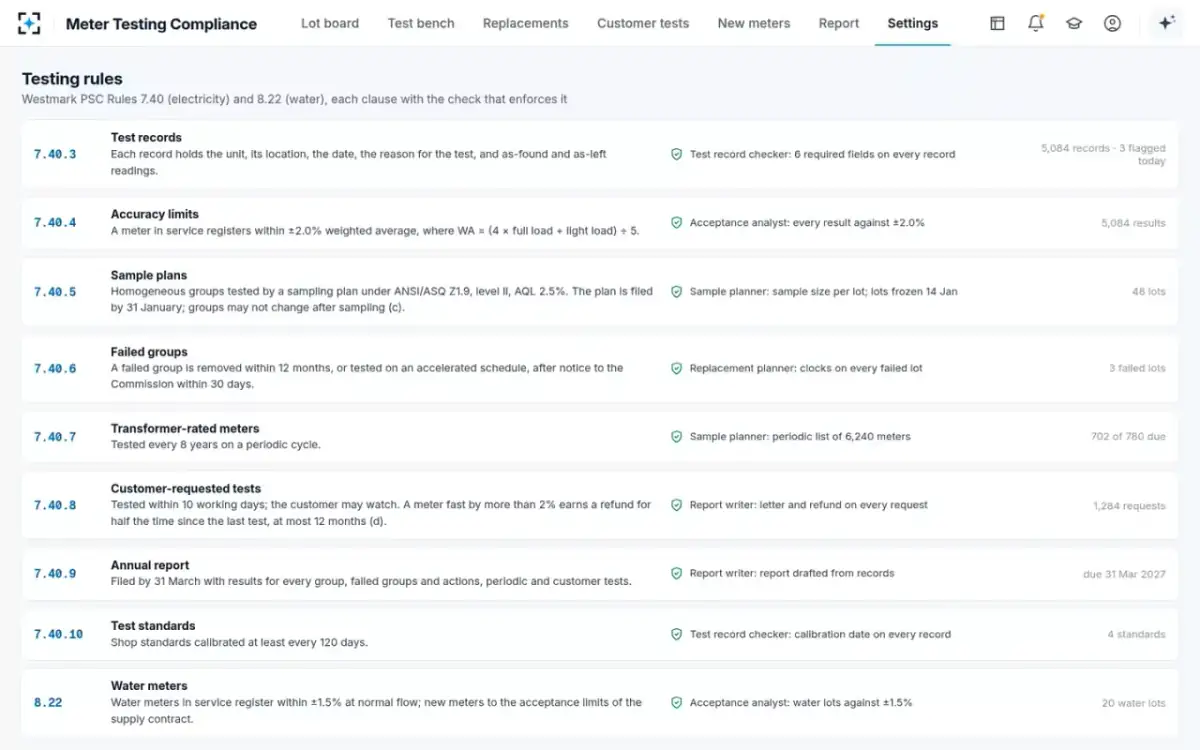

Limit: the acceptance analyst proposes pass or fail and shows its working. It does not sign a lot decision.
- 06Check the records first
The bulletin and certificate behind the drift
Certificate readerThe lot record holds the Z1.9 worksheet, each sample, the list of meters out of limits and the agents' notes. Five of the six meters out of limits share one serial range. They were built in production weeks 14 to 22. A manufacturer bulletin names those weeks for drift at light load. Light-load errors in the lot average −2.51%, against −0.49% at full load. The delivery certificate shows that batch passed its light-load test by only 0.4%.
“The lot was declared as one group before sampling and cannot be split after it, under the commission's rule. The serial range is proposed as its own lot in next year's plan.”
- 0710:21

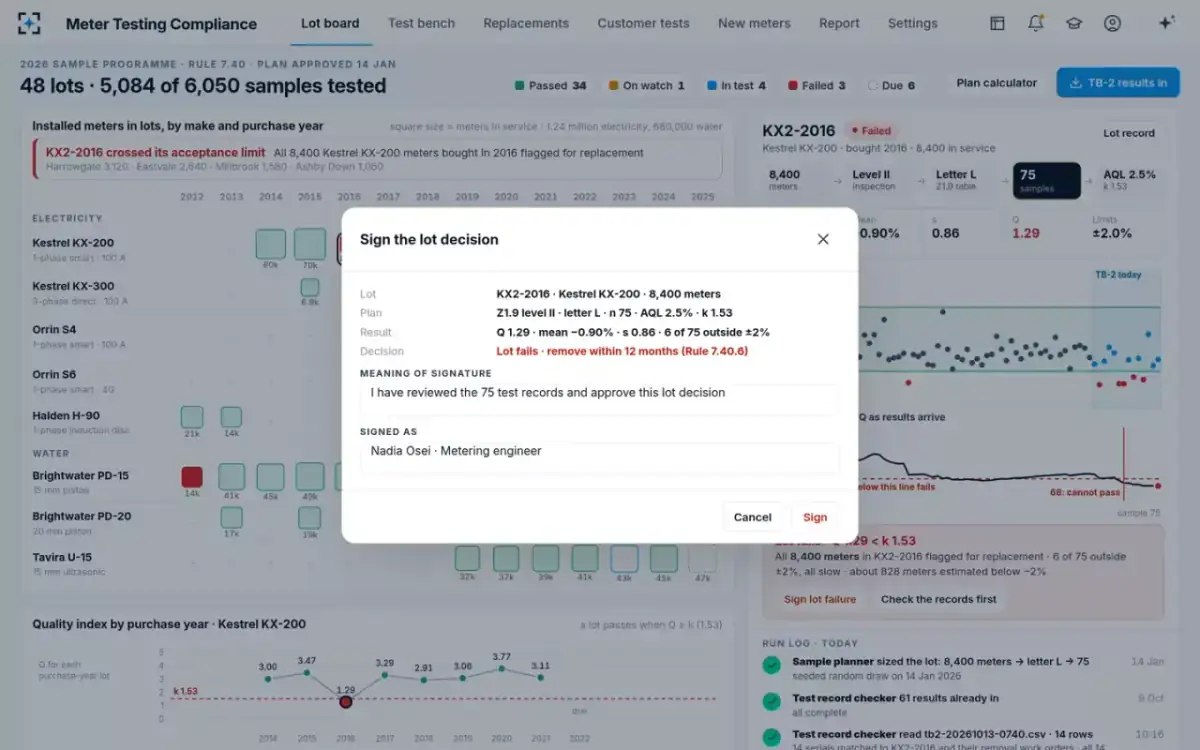

One signature, with its meaning recorded
Metering engineerThe engineer sees the lot, the plan, the result and the decision on one screen. The plan is Z1.9 level II, letter L, 75 samples, an acceptable quality level of 2.5% and k of 1.53. The result is Q 1.29, an average of −0.90%, a spread of 0.86, and 6 of 75 outside ±2%. The decision is that the lot fails and must be removed within 12 months under the commission's rule. The engineer signs as metering engineer.
Meaning of signature: “I have reviewed the 75 test records and approve this lot decision”
- 08Signed

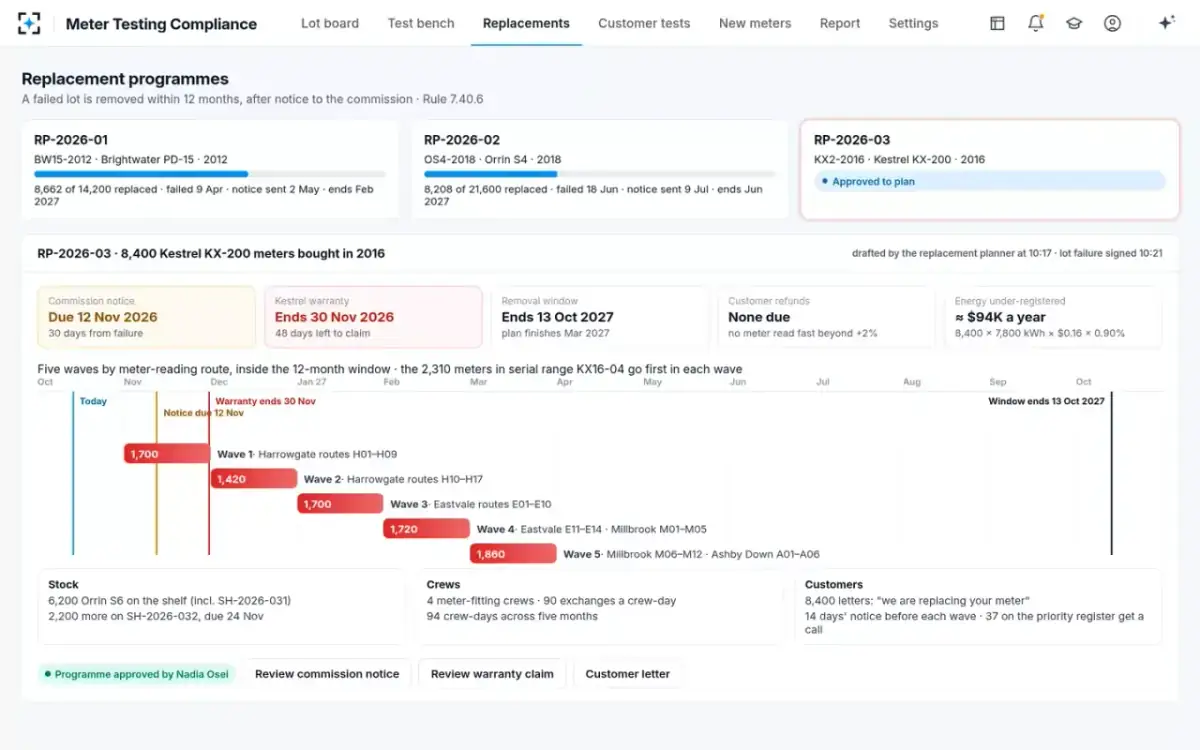

The replacement program, before the warranty ends
Replacement plannerThe replacement program was drafted at 10:17. It has five waves by meter-reading route over five months. In each wave, the 2,310 meters in the drifting serial range go first. The deadlines sit on top. The commission notice is due in 30 days, and 48 days are left to claim on the maker's warranty. There is also the 12-month removal window. No customer refunds are due, because no meter read fast beyond +2%. There are 6,200 replacement meters on the shelf and 2,200 more on order. Four crews each do 90 exchanges a day.
Limit: the replacement planner sends nothing to the commission, a supplier or a customer. The notice, the warranty claim and the 8,400 letters wait for a named person.
- 09Same morning

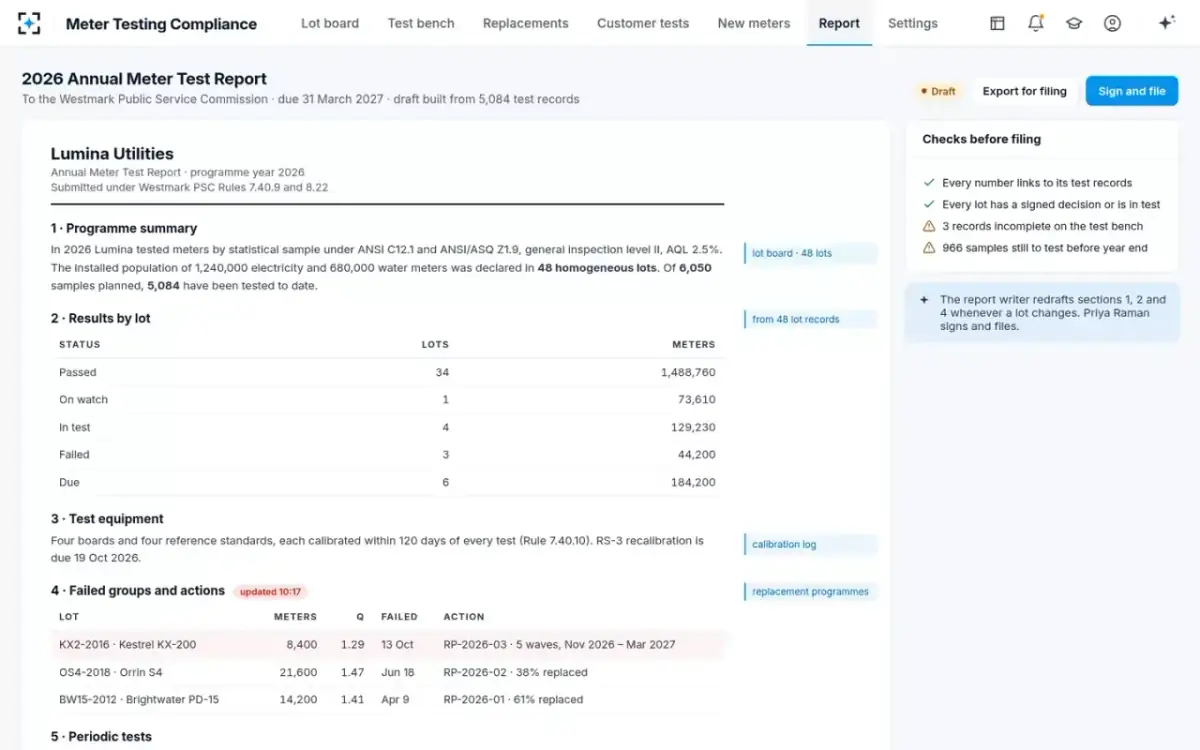

The annual report's failed groups, redrafted from the same records
Regulatory compliance managerThis year's annual meter test report to the commission is a draft built from 5,084 test records. Section 4, Failed groups and actions, now shows the 2016 lot: 8,400 meters, Q 1.29, failed today, replacement in five waves. It sits beside the two lots that failed earlier in the year. Each section carries a note that opens the records behind it.
Checks before filing: “3 records incomplete on the test bench · 966 samples still to test before year end”. The compliance manager signs and files.
