- Before
- Opens 40 to 60 new packs a week, ticks a 14-item checklist by hand and phones installers. Mornings go on finding a missing stamp, and the feeder question waits for the engineer.
- Now
- Opens each pack already checked, with each gap on its page and the feeder answer beside it. Sends one notice with everything missing and the routes that fit.
A 2 MW solar-plus-storage pack with three gaps, and a feeder with room 600 m north
The utility runs interconnection for one district, with 3 substations, 9 feeders and 186 open applications. At 08:06 one morning, a solar installer sends in a project for a cold storage warehouse. It pairs 2,000 kW of solar with a 1,000 kW / 2,000 kWh battery. Here is what happens next, screen by screen, in the working solution.
A worked example on sample data. Names, IDs and figures on the screens and in this section come from the demo.
- 0108:06

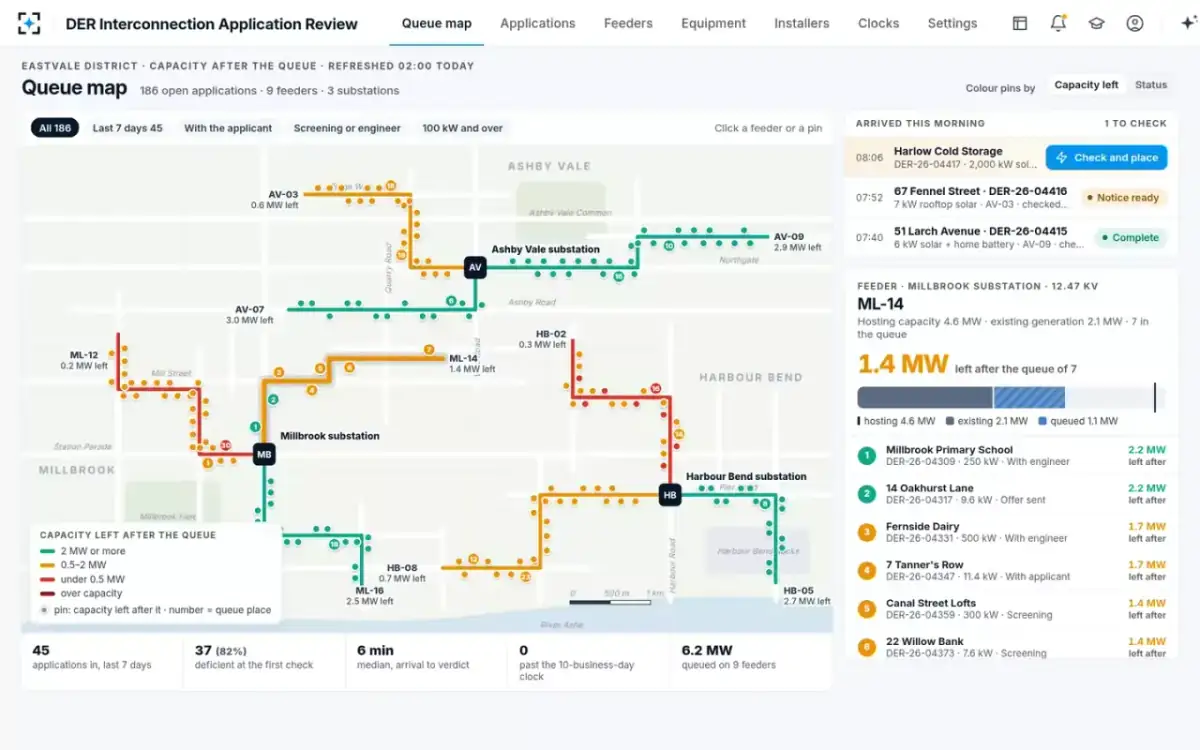

The queue map shows the capacity left after the queue

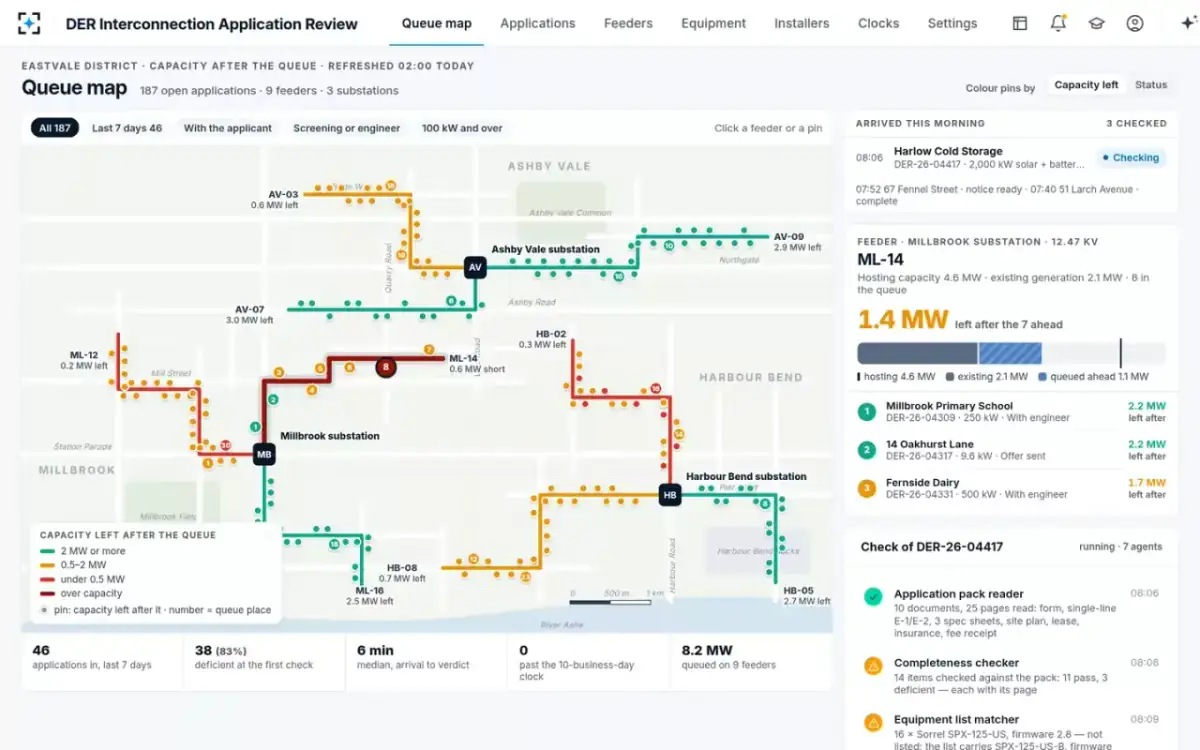

DER interconnection coordinatorThe coordinator's home screen is the district's network drawn as a map. Nine feeders are colored by the capacity left after each queued application. Each open application is a numbered pin in queue order. The new pack waits in the tray, 2,000 kW of solar plus battery on the site's feeder. The rail already shows that feeder. Hosting capacity is 4.6 MW and existing generation 2.1 MW, with seven in the queue and 1.4 MW left.
“1.4 MW left after the queue of 7” is the number a hosting-capacity map alone does not show
- 02One click
Check and place drops the pin and starts seven agents
Application pack readerThe coordinator clicks Check and place. The pin drops onto the feeder at queue place 8, and the run plays in the rail. The application pack reader reads 10 documents, 25 pages in all. They are the form, single-line sheets E-1 and E-2, three spec sheets and the site plan. A site control document, an insurance certificate and the fee receipt complete the pack. The reader records the page for each value it extracts.
The pack reader marks anything unreadable for a person instead of guessing

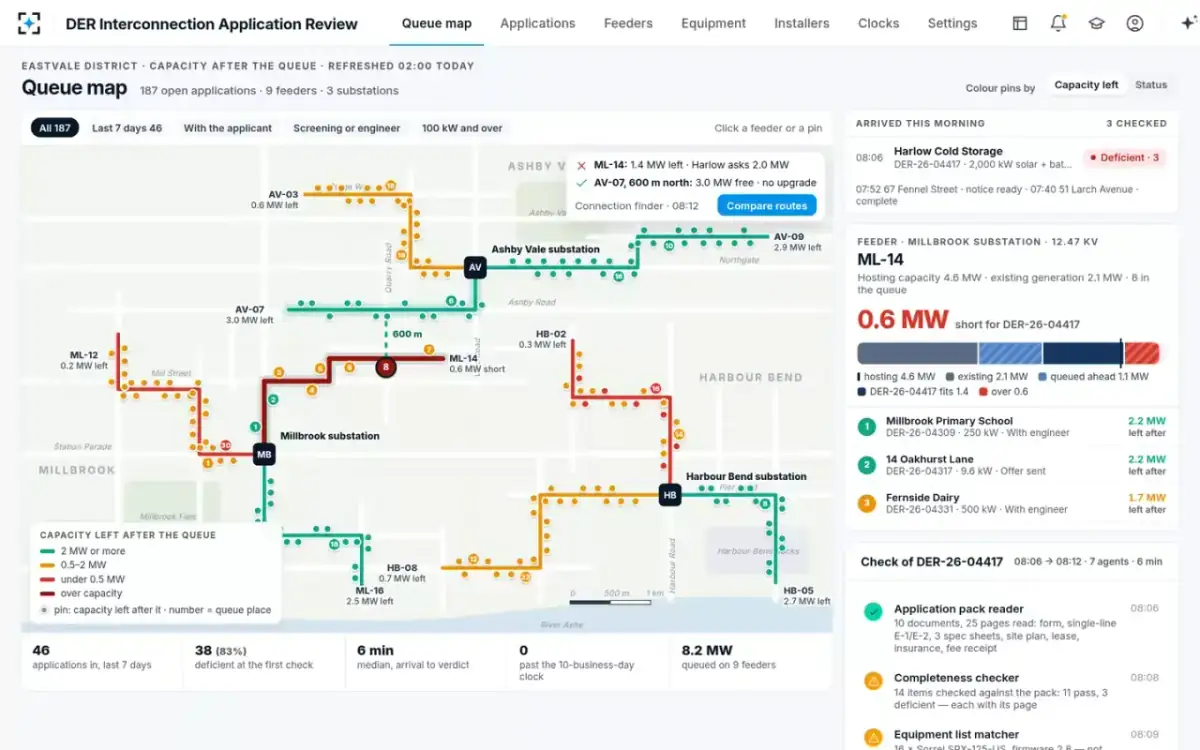

- 0308:11 · 08:12
0.6 MW short on the site's feeder, and room 600 m north
Capacity screener and Connection finderThe capacity screener takes the queue off the feeder's capacity. The feeder can host 4.6 MW. Taking off 2.1 MW of existing generation and 1.1 MW queued in the 7 projects ahead leaves 1.4 MW. The project asks for 2.0 MW, so it is 0.6 MW short and 3 of 6 screens fail. The connection finder searches 4 feeders within 1 km. It draws a dashed route on the map to a feeder 600 m north along the same road, with 3.0 MW free.
“Nearby feeder, 600 m north: 3.0 MW free · no upgrade” · Connection finder, 08:12
- 046 minutes after arrival
Eleven of 14 items pass, and each of the three gaps shows its page

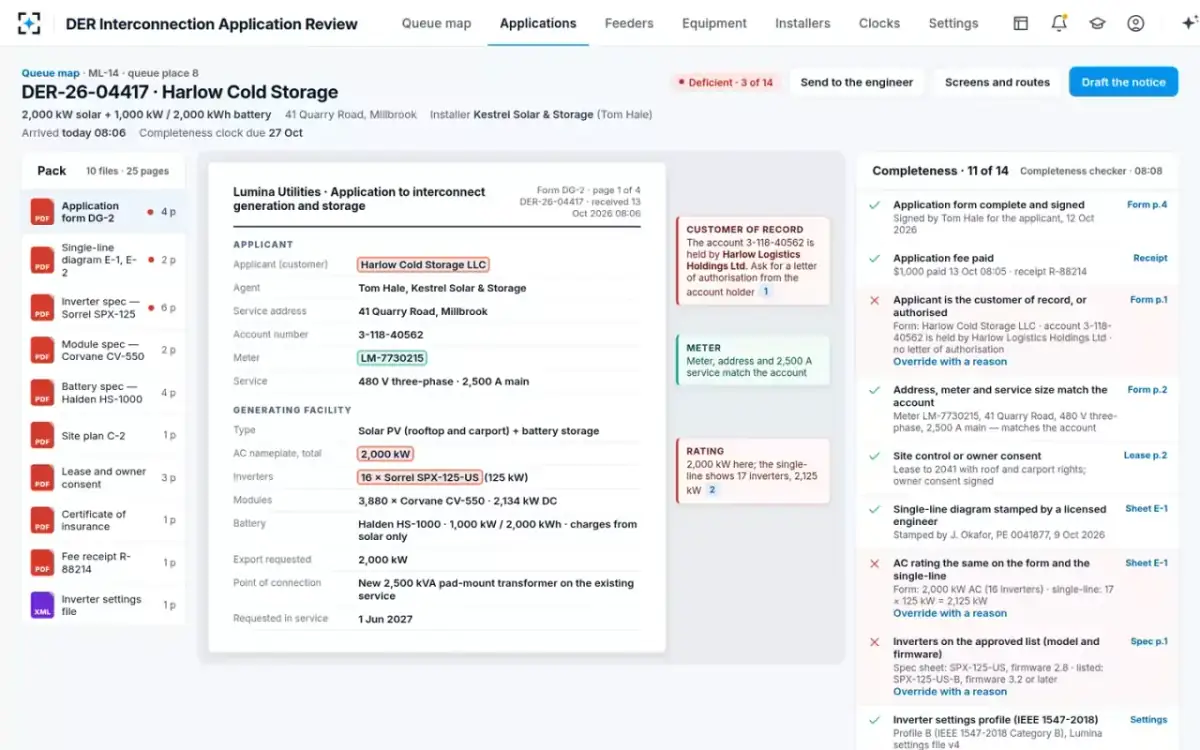

Completeness checker and Account and meter verifierThe pack opens with the form beside the 14-item checklist. The meter, the address and the 2,500 A service match the account. But the form names the business that occupies the site. The account is held by the building owner's holding company, and there is no letter of authorization. Each item carries its evidence and page, such as Form p.1, Sheet E-1 and Spec p.1.
The completeness checker never marks an item complete without the evidence on the page

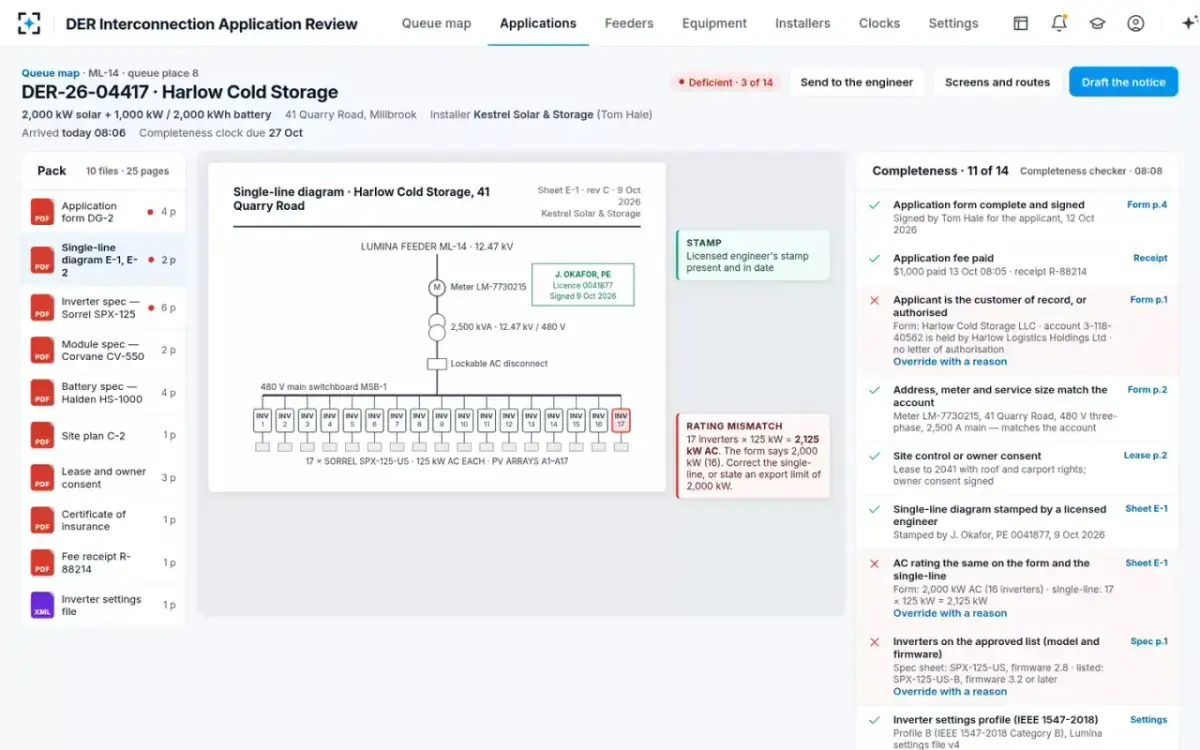

- 05Sheet E-1
The single-line shows 17 inverters where the form says 16
Completeness checkerThe single-line diagram carries a licensed professional engineer's stamp and signature, so that item passes. But sheet E-1 draws 17 inverters at 125 kW each, or 2,125 kW AC. The form says 2,000 kW from 16 inverters. The margin note says what fixes it. Either correct the single-line, or state an export limit of 2,000 kW.
“17 inverters × 125 kW = 2,125 kW AC. The form says 2,000 kW (16).”

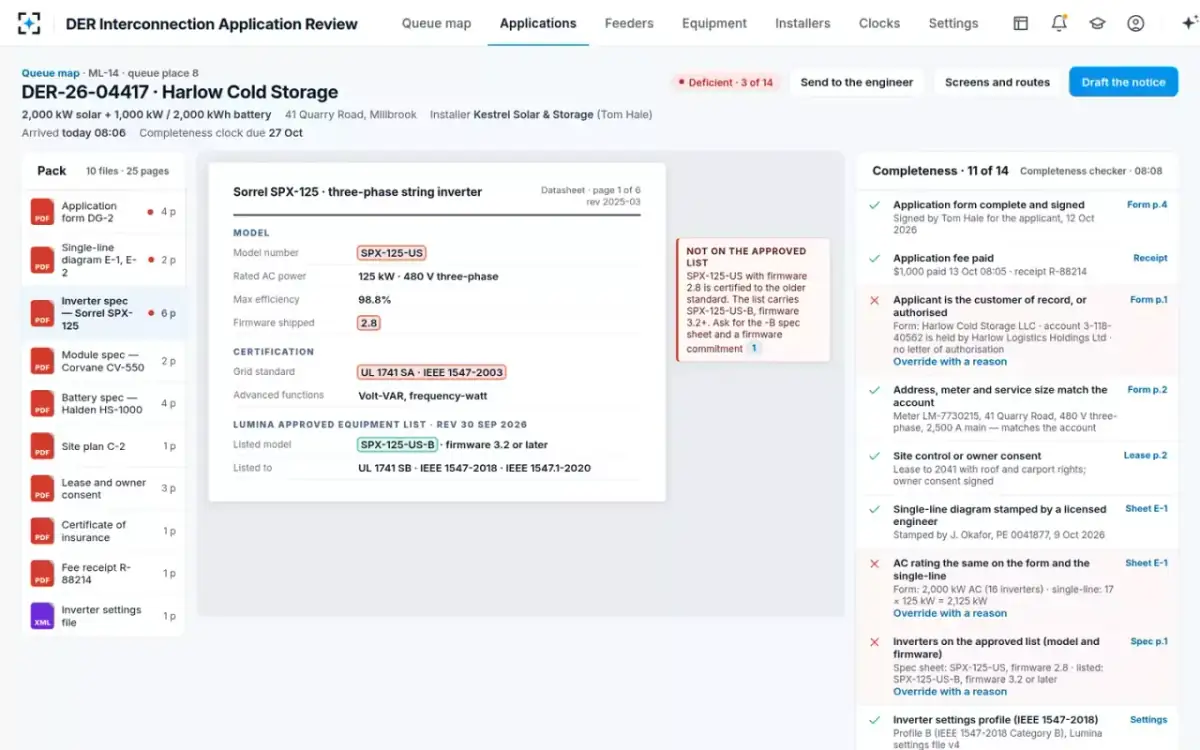

- 06Spec p.1

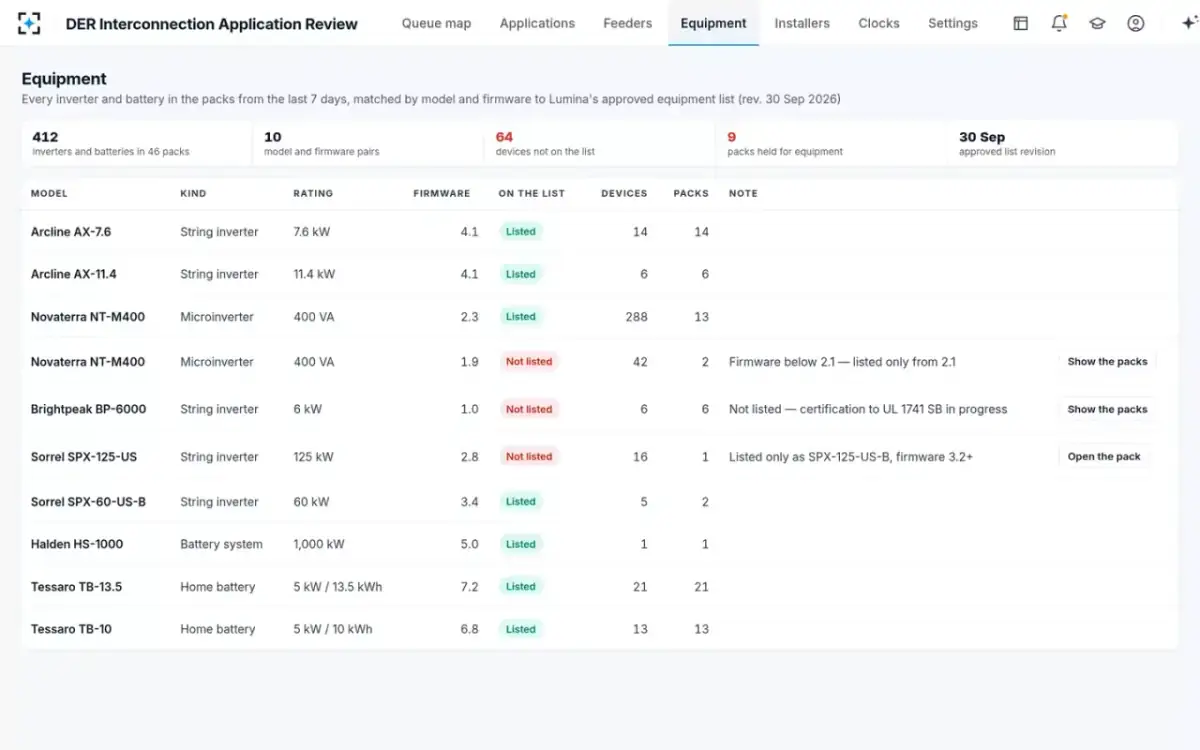

The model family is on the list, but not this model or firmware
Equipment list matcherThe spec sheet is for an inverter on firmware 2.8, certified to UL 1741 SA and IEEE 1547-2003. The utility's approved equipment list, in its current revision, carries only the same model with a -B suffix. That model runs firmware 3.2 or later and is listed to UL 1741 SB, IEEE 1547-2018 and IEEE 1547.1-2020. A different suffix or firmware counts as a mismatch. The matcher names the closest listed model.
The equipment list matcher never accepts an unlisted model or firmware

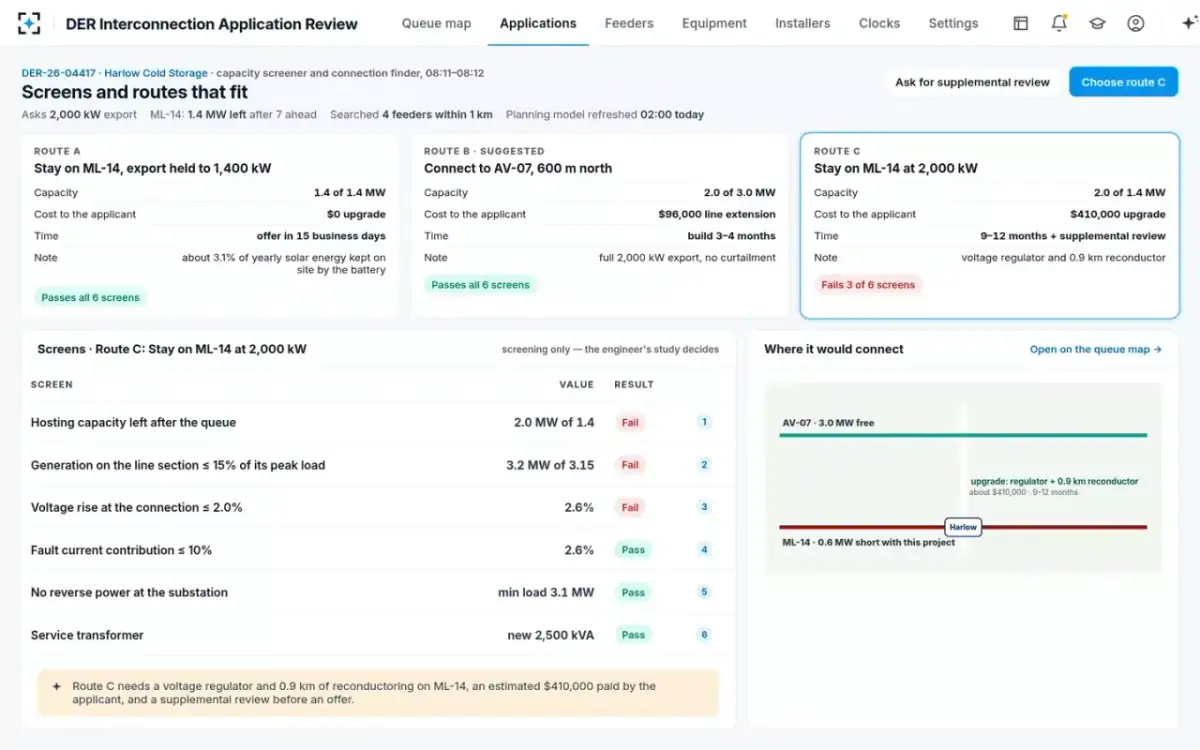

- 07The upgrade route
Route C keeps 2 MW on the site's feeder, at a cost
Distribution planning engineerScreens and routes puts three routes side by side. Route C keeps the full 2,000 kW on the site's feeder. Generation on the line section reaches 3.2 MW. The limit is 15 % of that section's peak load, which here is 3.15 MW. Voltage rise at the connection is 2.6 % against 2.0 %. Route C fails 3 of 6 screens. It needs a voltage regulator, 0.9 km of new, heavier line and a supplemental review. That is an estimated $410,000 and 9 to 12 months.
“screening only: the engineer's study decides”

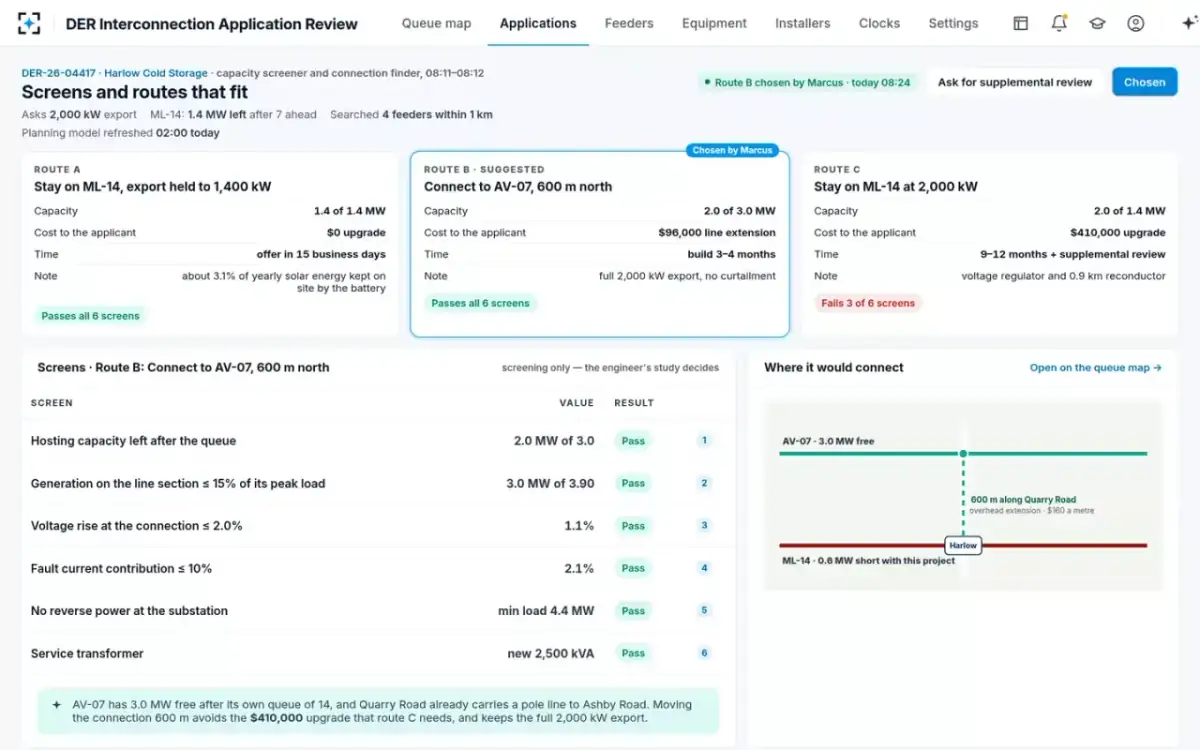

- 0808:24
The engineer chooses route B, the nearby feeder
Distribution planning engineerRoute B connects to the nearby feeder, 600 m north along the same road. It uses 2.0 of 3.0 MW and needs a line extension, estimated at $96,000 and 3 to 4 months. It allows full export with no curtailment, and all 6 screens pass. Route A stays on the site's feeder with export held to 1,400 kW, using the battery for the midday surplus. The engineer chooses B. The notice now recommends it and offers route A as well.
“Moving the connection 600 m avoids the $410,000 upgrade that route C needs, and keeps the full 2,000 kW export.”
- 0908:31

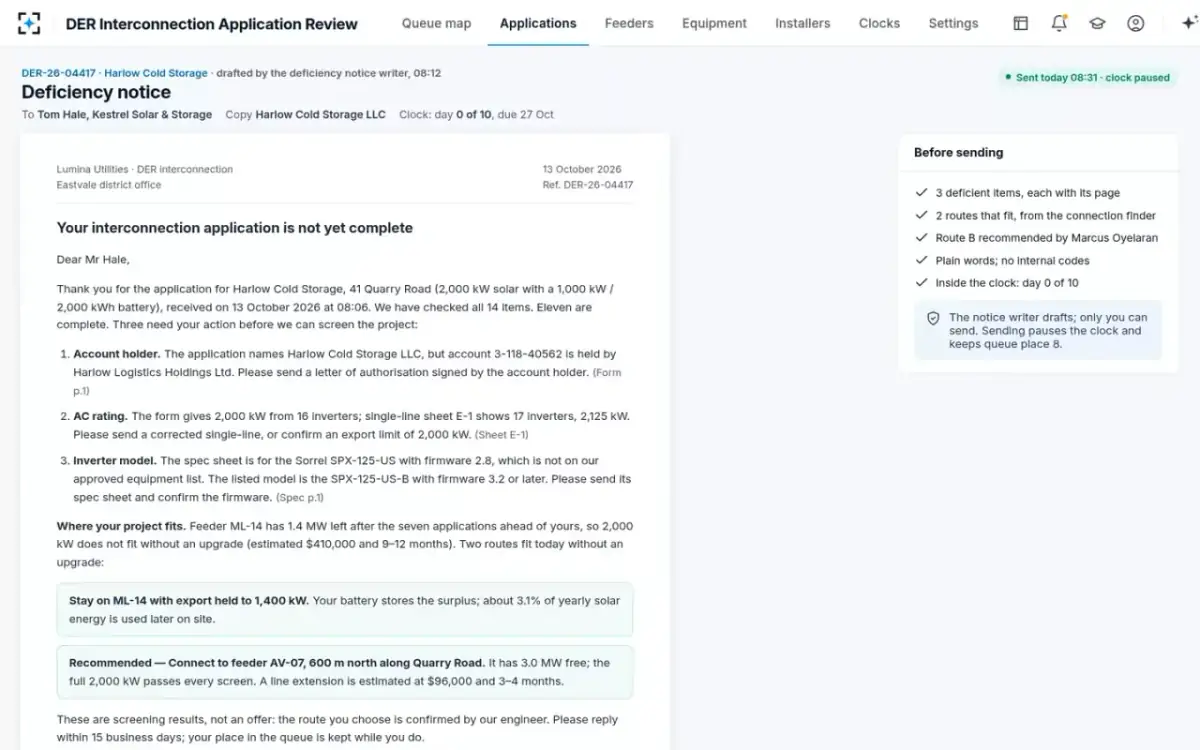

One notice with each gap, and where the project fits
DER interconnection coordinatorThe deficiency notice writer has drafted the letter in plain words. It covers the account holder, the AC rating and the inverter model, each with what to send and its page. Then comes “Where your project fits”, with the two routes. The coordinator reads it and sends it to the developer at 08:31. That is 25 minutes after arrival, on day 0 of 10. The clock pauses and queue place 8 is kept.
“The notice writer drafts; only you can send. Sending pauses the clock and keeps queue place 8.”
- 10This week

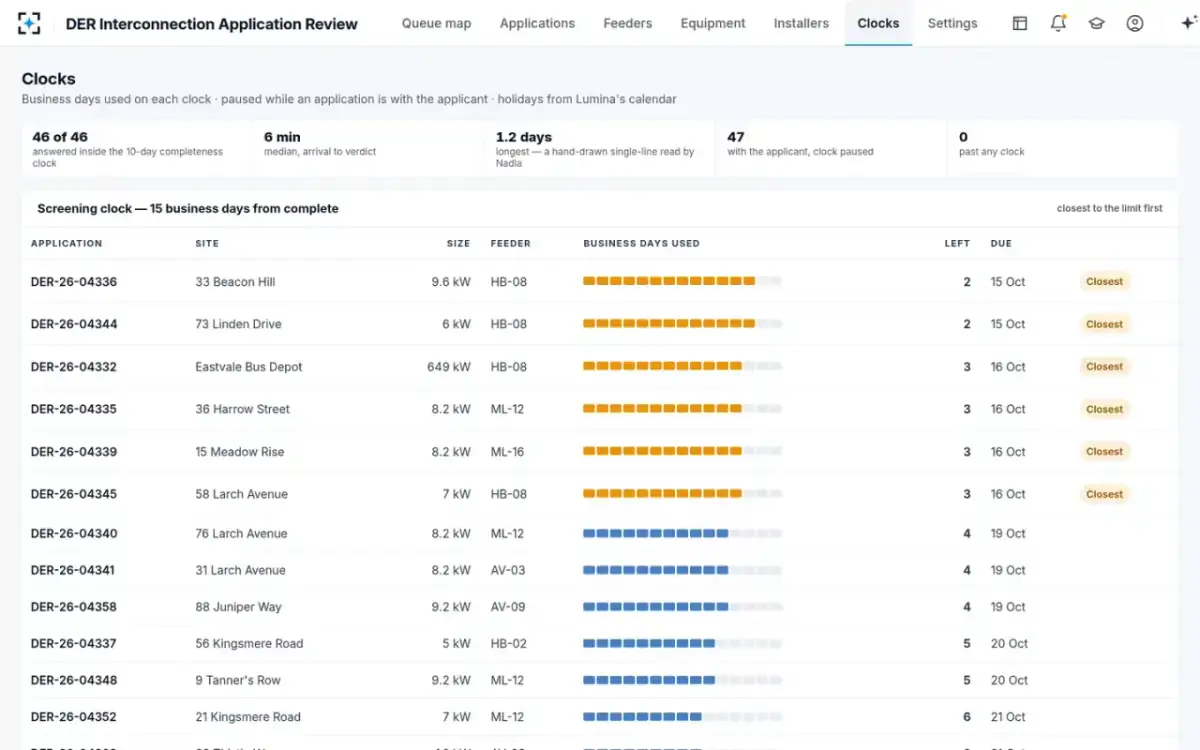

All 46 applications answered inside the completeness clock
Manager, DER interconnectionThe manager owns the clocks. The Clocks screen counts business days on each one, using holidays from the utility's calendar. A clock pauses while an application is with the applicant. This week, 46 of 46 were answered inside the 10-day completeness clock, and 0 are past any clock. The median from arrival to verdict was 6 minutes. The longest took 1.2 days, for a hand-drawn single-line that the coordinator read in person.
Screening clock: 15 business days from complete, with the closest to the limit first
