- Before
- Looks after 184 passports and answers to the HSE director for each contractor on site. Learns that a certificate lapsed when the crew is already in the trench.
- Now
- Opens the passports that need attention first. Each stamp was checked again at 07:00, the reminder is already sent and the work order already marked.
A ten-day insurance warning, a verified renewal and a held water main job
A utility hires 184 contractors for line work, water mains, substations, vegetation, traffic control and plant work. Today one line contractor's insurance has 10 days left. Its crew is booked for energized work on a feeder four days after that. Here is what happens, screen by screen, in the working solution.
A worked example on sample data. Names, IDs and figures on the screens and in this section come from the demo.
- 01Before 07:00

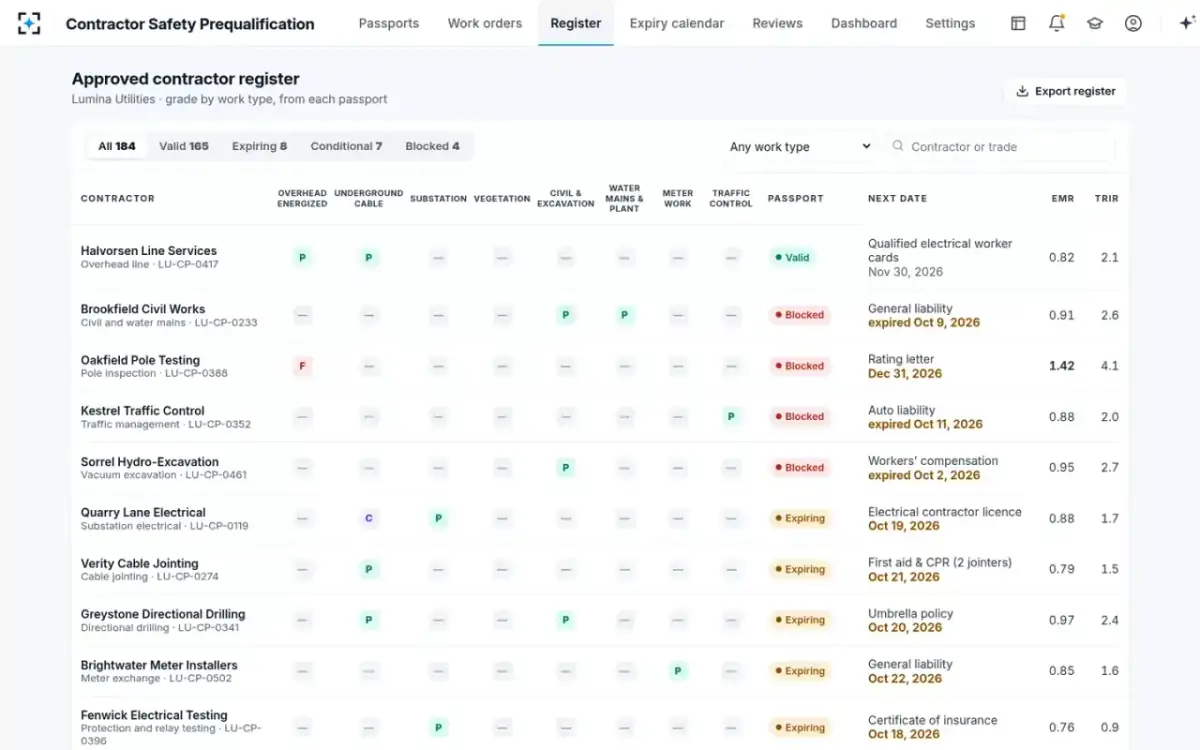

Each contractor has a passport, and each proof is a stamp

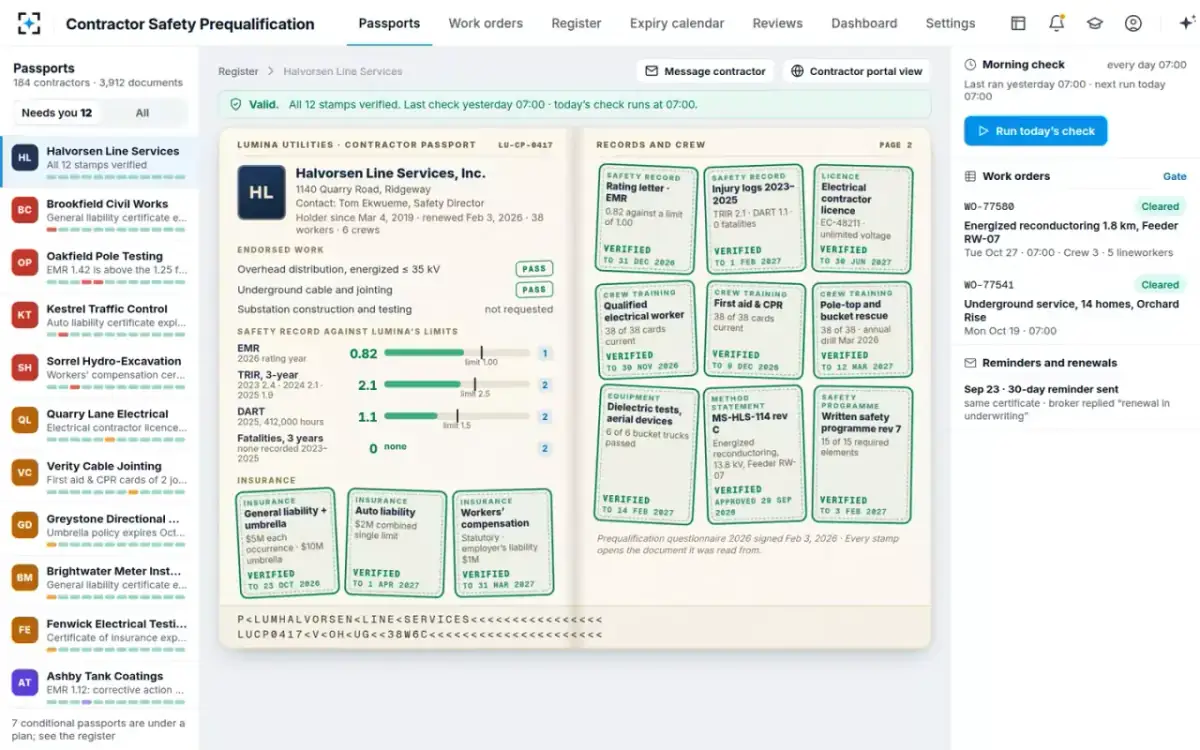

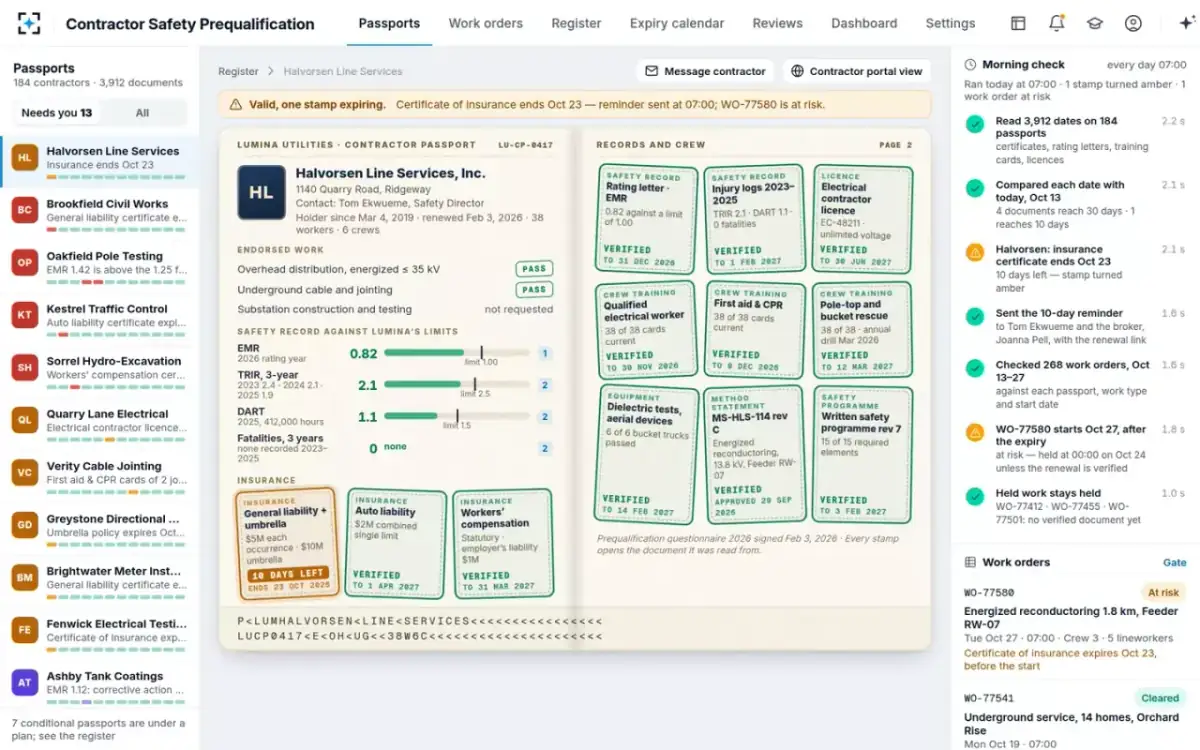

Contractor safety managerEach contractor's record is a passport, and each proof on it is a stamp. The contractor safety manager looks after 184 passports and signs each grade. This line contractor is approved for overhead distribution, energized work up to 35 kV, and underground cable and jointing. Its safety record is inside the utility's limits: EMR 0.82 against 1.00, 3-year TRIR 2.1 against 2.5 and DART 1.1 against 1.5. It has had no deaths at work in three years. All 12 stamps are verified. They cover insurance, the rating letter, injury logs, the license, three crew-training stamps, dielectric tests, the method statement and the safety program.
“Valid. All 12 stamps verified. Last check yesterday 07:00 · today’s check runs at 07:00.”
- 02One click
Each stamp opens the document it was read from

Document readerThe general liability and umbrella stamp opens the certificate from the contractor's insurance broker. It shows one insurer and a general liability policy at $5,000,000 for each occurrence. On top sits an umbrella policy, extra cover, at $10,000,000, with the utility named as an additional insured. The one-year policy period ends in 10 days. That date is highlighted on the page, beside what the agents checked.
What the agents checked: “Each occurrence ≥ $5M ✓ · Umbrella ≥ $10M ✓ · Utility named additional insured ✓ · Expires in 10 days”
- 0307:00
Today's check turns one stamp amber and tells two people

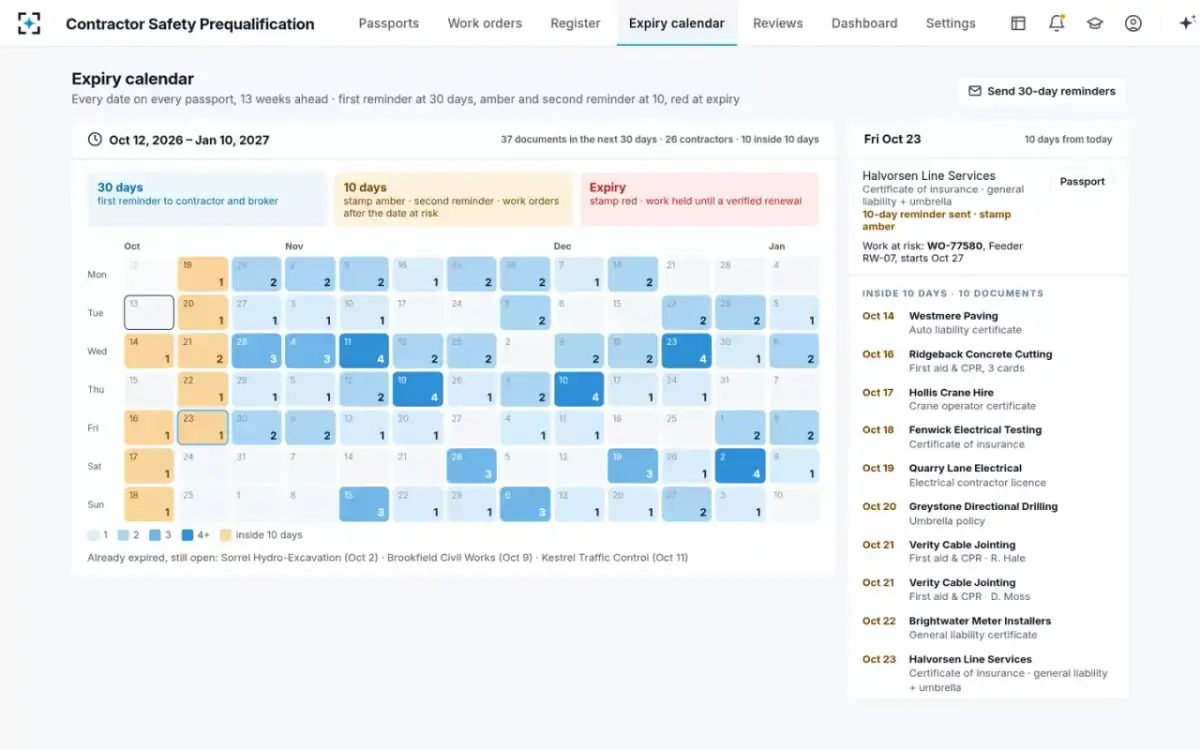

Expiry watcherThe morning check reads 3,912 dates on 184 passports and compares each one with today. Four documents reach 30 days left, and one reaches 10 days. That one is the line contractor's certificate, so its stamp turns amber. The 10-day reminder goes to the contractor's safety director and its broker. It carries the renewal link and the limits the renewal must meet.
From the reminder: “The energized reconductoring work order on the feeder starts four days after your certificate ends. Unless a renewed certificate is verified, it will be held at 00:00 the day after expiry.”
- 0407:01
The feeder job is marked at risk before anyone is dispatched
Work-order gateThe work order is energized reconductoring, replacing the wires on 1.8 km of the feeder, with a crew of five lineworkers. It starts at 07:00, four days after the certificate ends, so the gate marks it at risk. The expiry calendar shows the same picture from the other side. It lists 37 documents expiring in the next 30 days across 26 contractors, and 10 of them within 10 days.
From the run log: “Starts after the expiry · at risk · held at 00:00 the day after expiry unless the renewal is verified.”
- 0510:20
The renewal arrives and the safety manager stamps it again

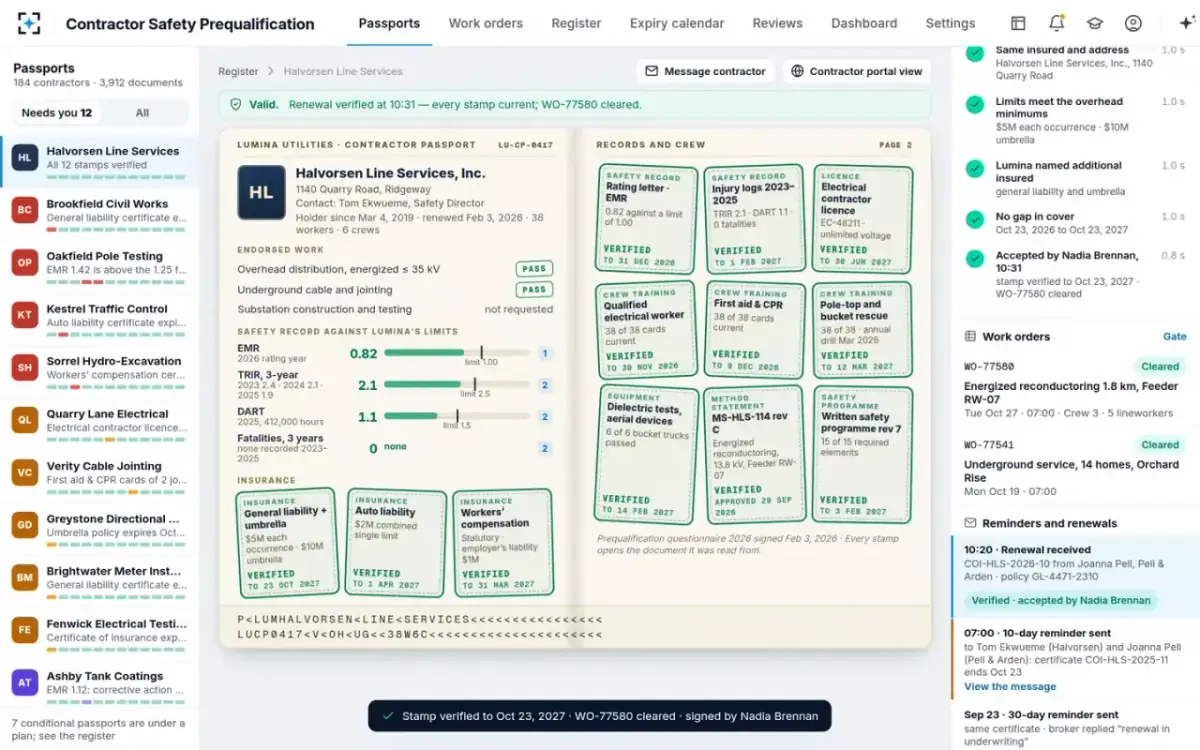

Contractor safety managerThe broker sends the renewed certificate, and the document reader checks it. The insured and address are the same. Cover is $5M for each occurrence with a $10M umbrella, and the utility is named as an additional insured. There is no gap in cover for the next year. At 10:31 the safety manager accepts it. The stamp is verified for another year, and the feeder work order is cleared.
The agents report what they found. Only the safety manager accepts a document.
- 06Same morning
A civil contractor’s cover has lapsed, so tomorrow’s water main job is held

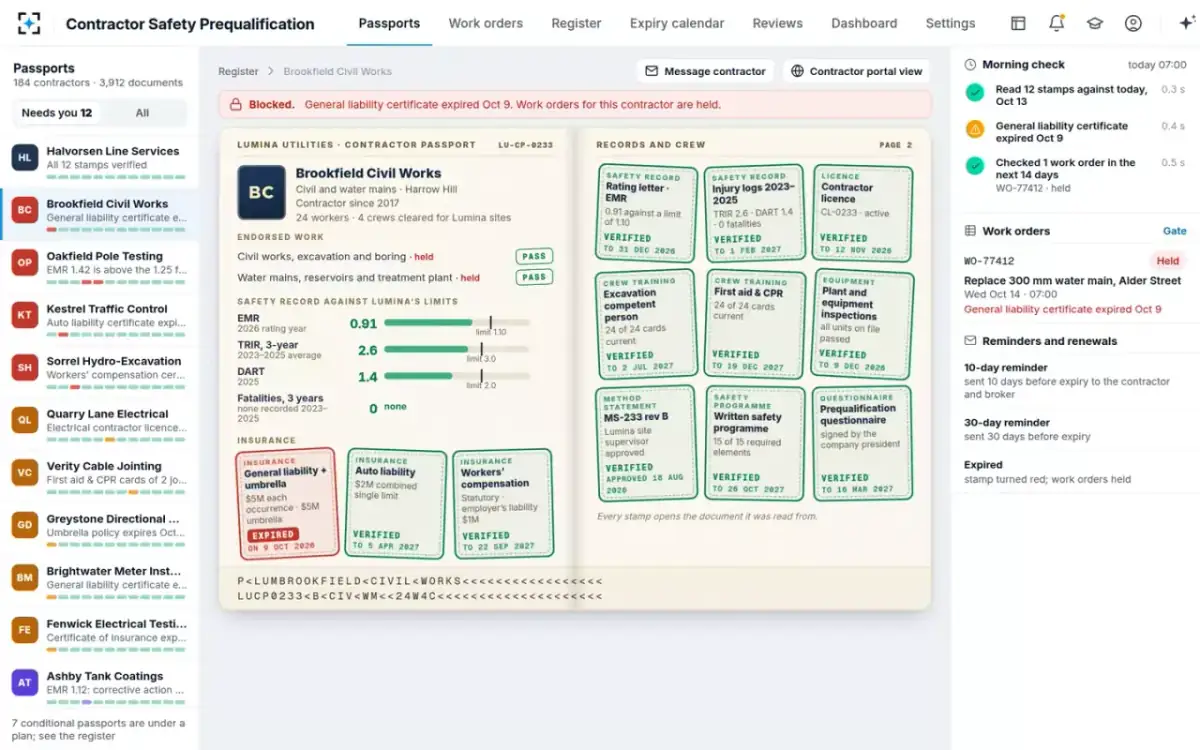

Work-order gateA civil contractor's general liability certificate expired four days ago. The 30-day and 10-day reminders went out, and no renewal came. So its passport is blocked. Its work order, replacing a 300 mm water main from 07:00 tomorrow, is held.
“Blocked. General liability certificate expired. Work orders for this contractor are held.”
- 0707:01, each day
The planners see what can start, and why the rest cannot

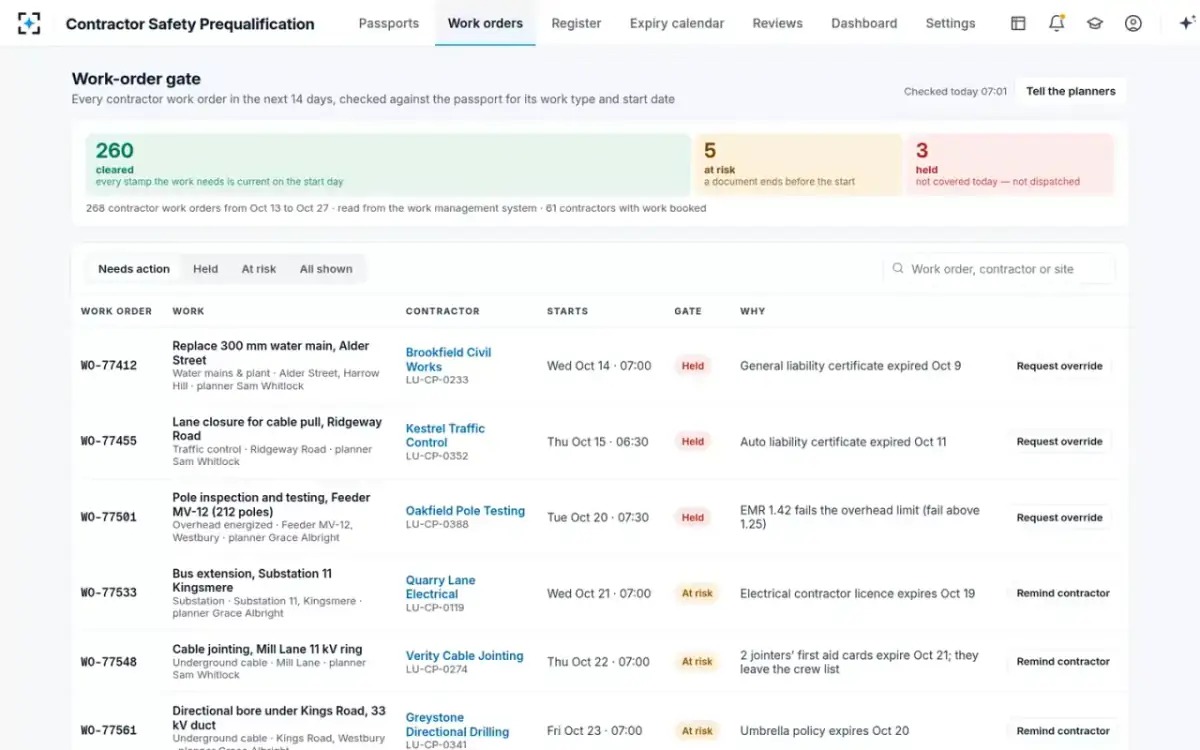

Work plannersEach morning the gate reads every contractor work order for the next two weeks from the work management system. With the line contractor cleared, 260 are cleared, 5 are at risk and 3 are held. One held job is the water main. Another is a traffic contractor's lane closure, on an auto liability certificate that expired two days ago. The third is a pole inspection on another feeder, by a pole-testing contractor whose EMR of 1.42 fails the overhead limit. Each row says why, and at-risk rows carry a reminder button.
“Gate runs at 07:00 and whenever a work order is booked · holds lift only on a verified document or an HSE director override”
- 08If work must go ahead

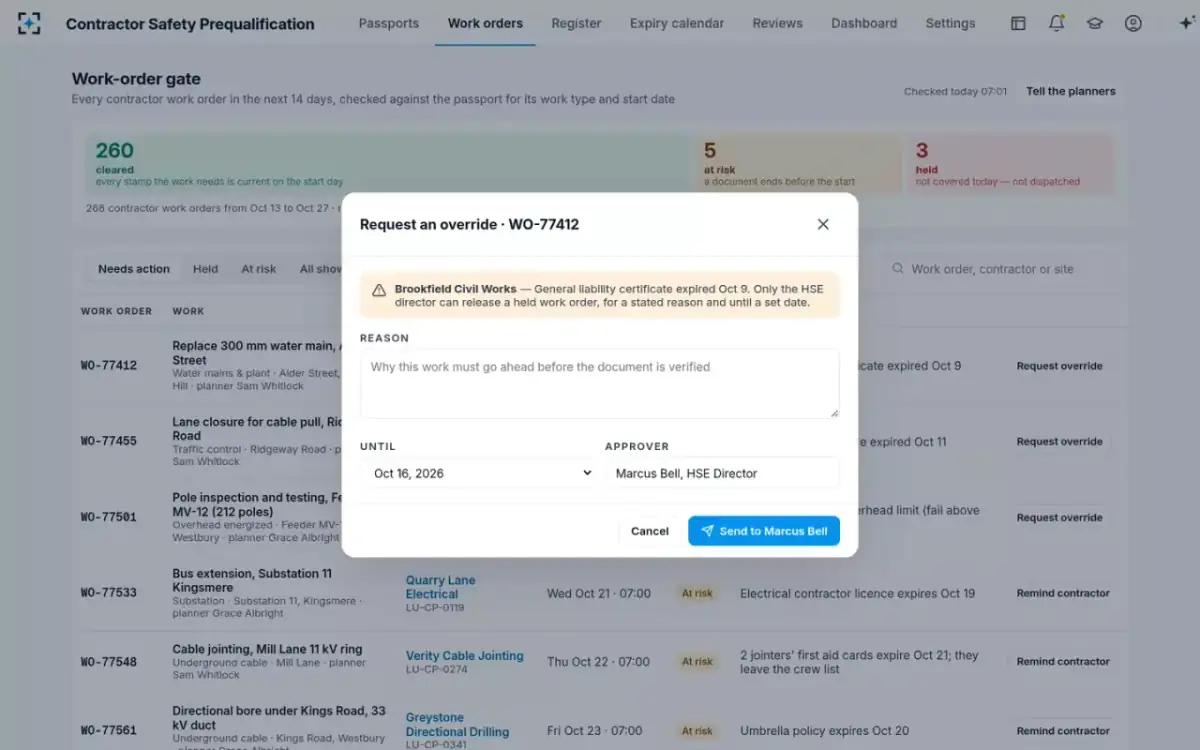

Only the HSE director releases a hold, with a reason and an end date
HSE directorThe safety manager can ask for an override on a held work order. The request goes to the HSE director, the head of health, safety and environment, with a written reason and an end date. Until the director decides, the work order stays held. The day before, the director had already turned one down for the water main job.
The HSE director declined the override for the water main job: “No work without cover.”
- 09A new package
A vegetation contractor’s 11 documents, graded by work type

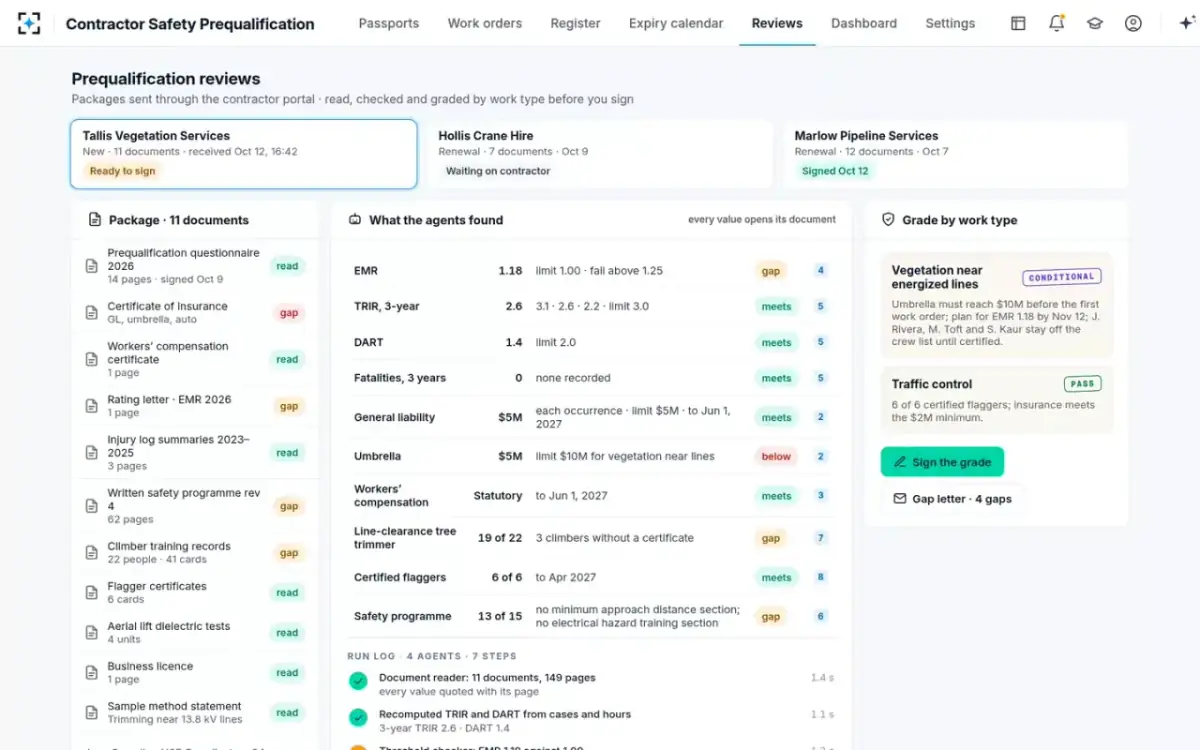

Document reader, Threshold checker, Crew qualification checkerA vegetation contractor sent 11 documents through the contractor portal. It wants to work near energized lines and run its own traffic control. The agents read 149 pages and work out TRIR and DART again from the cases and hours. The results are a 3-year TRIR of 2.6, DART of 1.4 and no deaths. Four things fall short. The EMR is 1.18 against 1.00, and the umbrella is $5M against $10M. Only 19 of 22 climbers hold a line-clearance tree trimmer certificate. And the safety program covers 13 of 15 elements. So the proposed grade is conditional for vegetation work and pass for traffic control.
The safety manager signs the grade with its meaning: “I reviewed the documents and the agents’ checks and approve this grade.”
- 10Signed 11:05

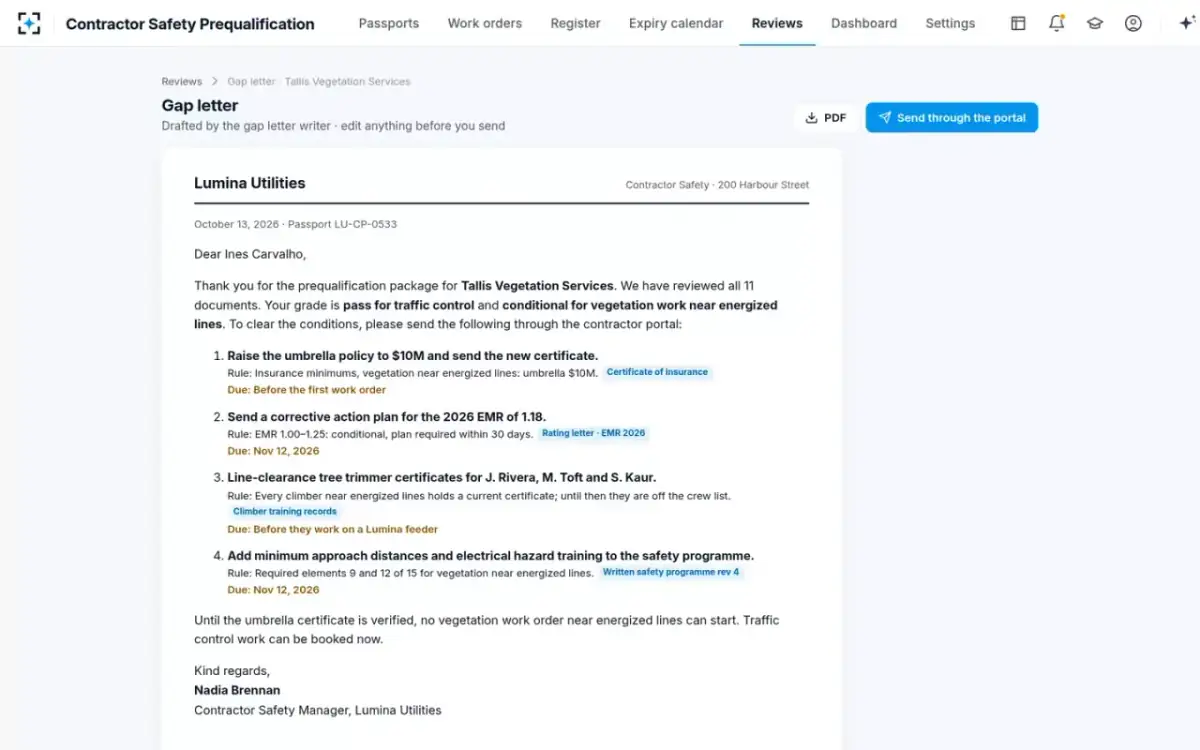

The gap letter lists each gap with its rule, document and due date
Gap letter writerThe letter goes to the vegetation contractor's HSE coordinator and lists four gaps. First, the umbrella must rise to $10M before the first work order. Second, the EMR of 1.18 needs a corrective action plan by a set date. Third, the three climbers need line-clearance tree trimmer certificates before they work on a utility feeder. Last, the safety program must add minimum approach distances and electrical hazard training by the same date. The safety manager can edit anything before sending it through the portal.
“Until the umbrella certificate is verified, no vegetation work order near energized lines can start. Traffic control work can be booked now.”
