- Before
- Rebuilds the month's accruals for three entities on working day 2 from ERP reports, spreadsheets and email replies. Deciding is not the hard part. Rebuilding the evidence each month is.
- Now
- Starts the day with 20 draft entries that need a decision. Each has its sources cited and its duplicate check done. Asks the agents about any entry, then approves, edits or rejects it with a reason code.
Working day 2 of a month-end close, with accrual automation
The company closes the month for three US entities. The cut-off was 18:00 on the last day of the month. It is working day 2, and decisions are due at 14:00. Here is the day, screen by screen, in the working solution.
A worked example on sample data. Names, IDs and figures on the screens and in this section come from the demo.

- 0109:40 · working day 2
The agents gather the evidence before the accountant arrives

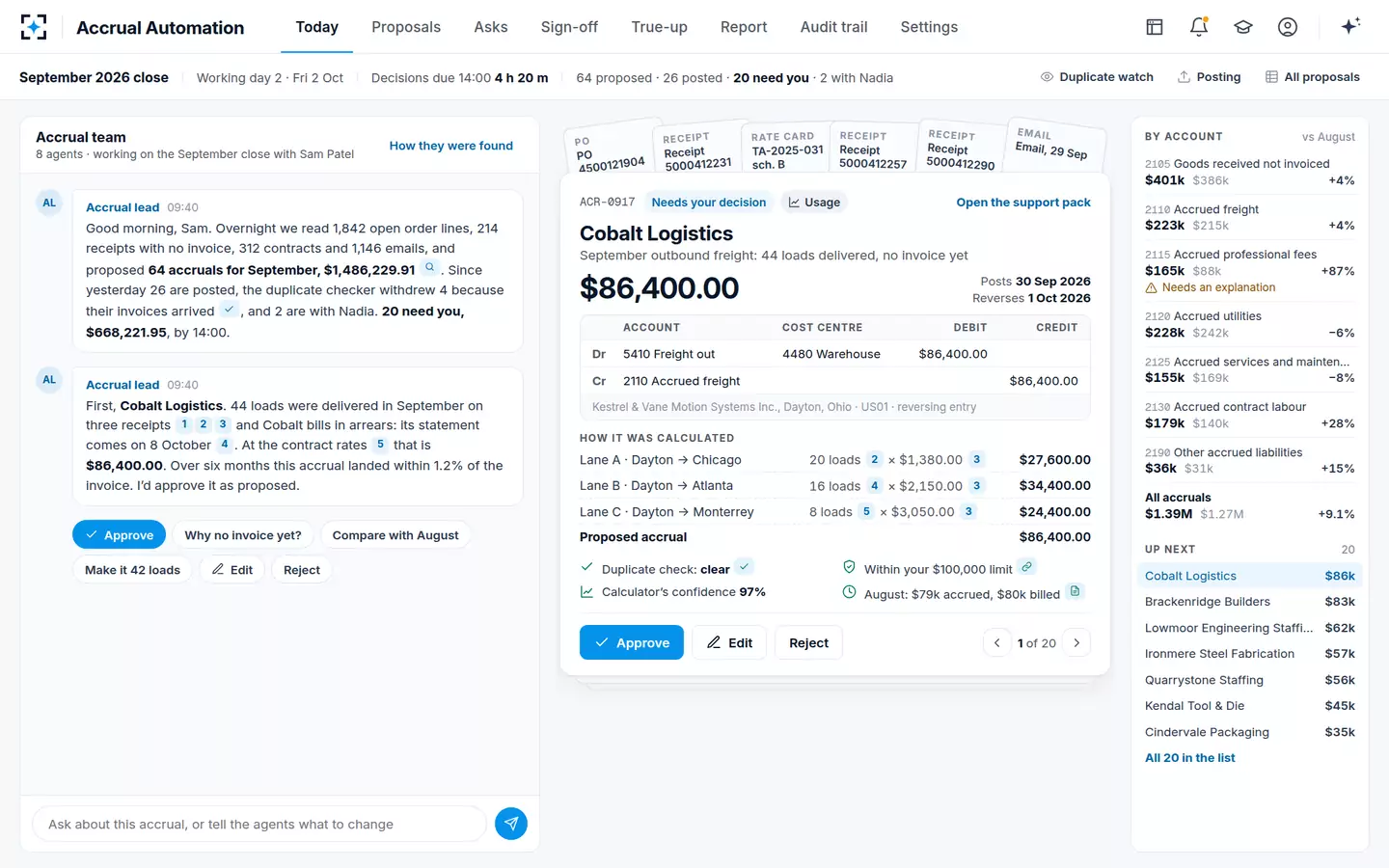

Senior staff accountantThe senior staff accountant opens Today, and the accrual lead reports the night's work. The agents read 1,842 open order lines, 214 receipts with no invoice, 312 contracts and 1,146 emails. They proposed 64 accruals worth $1,486,229.91. Since yesterday, 26 are posted and 2 are with the close manager. The duplicate checker withdrew 4 because their invoices arrived. In the center is a stack of draft journal entries. On the right is each accrued-liability account against last month, with one marked “Needs an explanation”.
Accrual lead: “20 need you, $668,221.95, by 14:00.”

- 02The top entry
A draft entry whose numbers each open their source
Accrual leadThe top entry is the month's outbound freight from the company's carrier, $86,400.00. It debits Freight out, cost center Warehouse, and credits Accrued freight. It posts on the last day of the month and reverses on day 1. The calculation is 20 loads to Chicago at $1,380, 16 to Atlanta at $2,150 and 8 to Monterrey at $3,050. The rates come from schedule B of the transport agreement. Behind the entry sit the PO, three receipts, the rate card and the carrier's email. The accountant clicks “20 loads”, and the delivery receipt opens at the line.
Delivery receipt: “20 loads delivered, each with a signed proof of delivery.”
- 03The support pack
What each agent did, in order
The agentsThe support pack shows the agents' work on the entry, in order. First, the source scanner read 6 documents up to the cut-off. The accrual calculator priced 3 lines, with each input cited at 97% confidence. Next, the policy checker applied the close policy. The entry is above the $2,500 threshold and within a staff accountant's limit. Last, the duplicate checker found no carrier invoice in the AP inbox or posted after the cut-off. It found no open accrual from last month either.
“Agents propose and check. They never approve. Only an approved entry posts, and the posting agent cannot change an amount.”
- 04One question
“Why no invoice yet?” Checked again, live

Duplicate checkerThe accountant asks why there is no invoice yet. The duplicate checker reads the AP inbox for the first two days of the new month: 412 invoices, none from the carrier. It checks the 96 invoices posted to the closing month after the cut-off, and none is for this PO. It also checks last month's accruals, which were reversed on day 1, and the other proposals. The carrier bills in arrears, after the month ends, and its email says the statement comes on the 8th.
Duplicate checker: “I will keep watching until the month locks.”
- 05Decided
Approved with a reason code

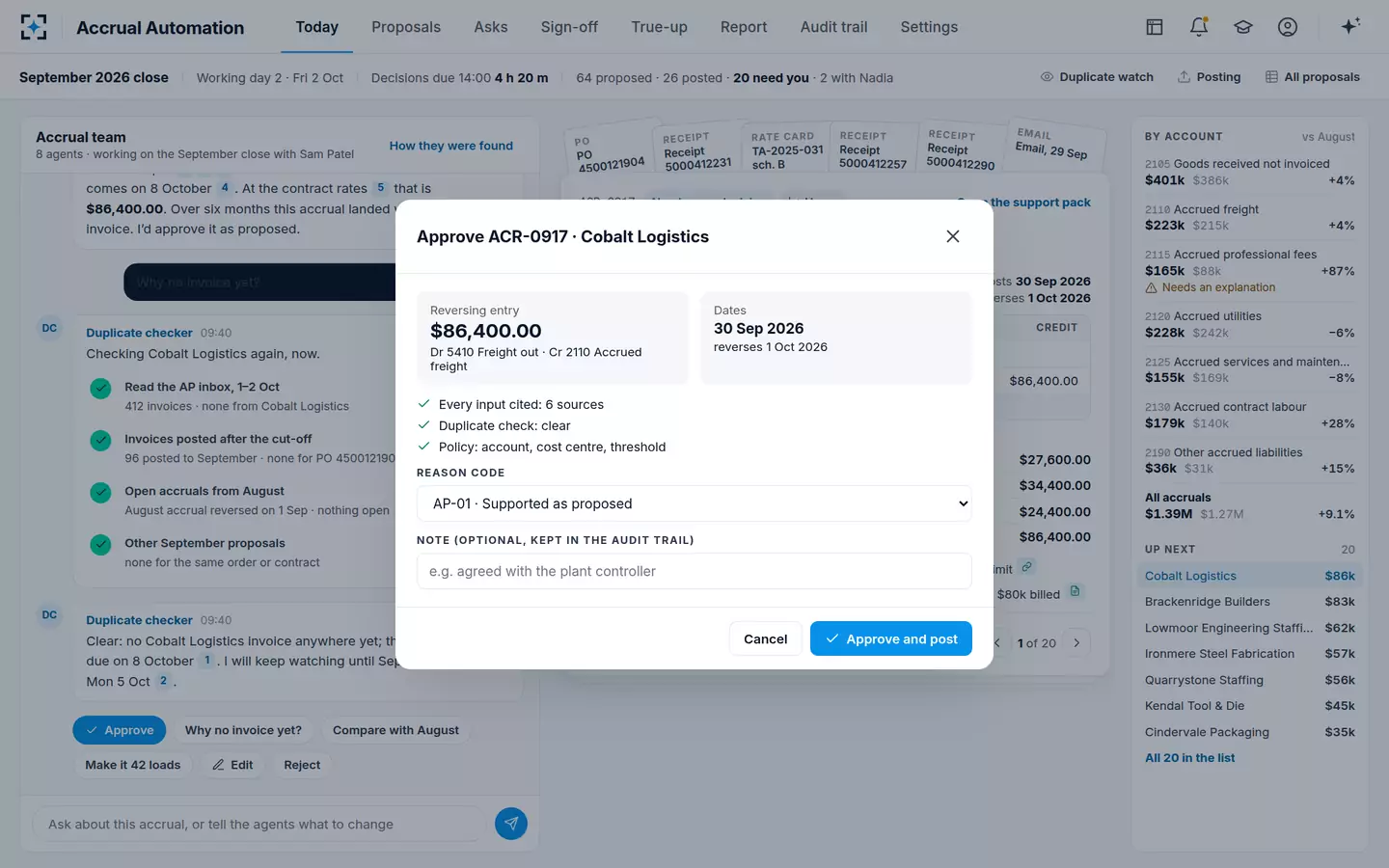

Senior staff accountantOver six months, this accrual has landed within 1.2% of the carrier's invoice. The accrual lead recommends it as proposed, and the accountant approves. The sheet shows each input cited from 6 sources, the duplicate check clear, and the policy check on account, cost center and threshold. The approval sheet asks for a reason code. The accountant picks “Supported as proposed”. A note, if one is written, is kept in the audit trail.
- 06A few seconds later
Posted as a reversing entry, and the next one is up
Posting agentThe posting agent checks that the period is open for the entity. It posts with the support attached and confirms the journal number. Then it schedules the reversal for day 1 of the next period. Next up is a builder's dock extension, certified at 62% complete against 45% billed. That comes to $82,620.00. The policy checker moved it from Repairs to Construction in progress, because it belongs to a capital project.
Posting agent: “It reverses on day 1, so the carrier's invoice will land once, next month.”

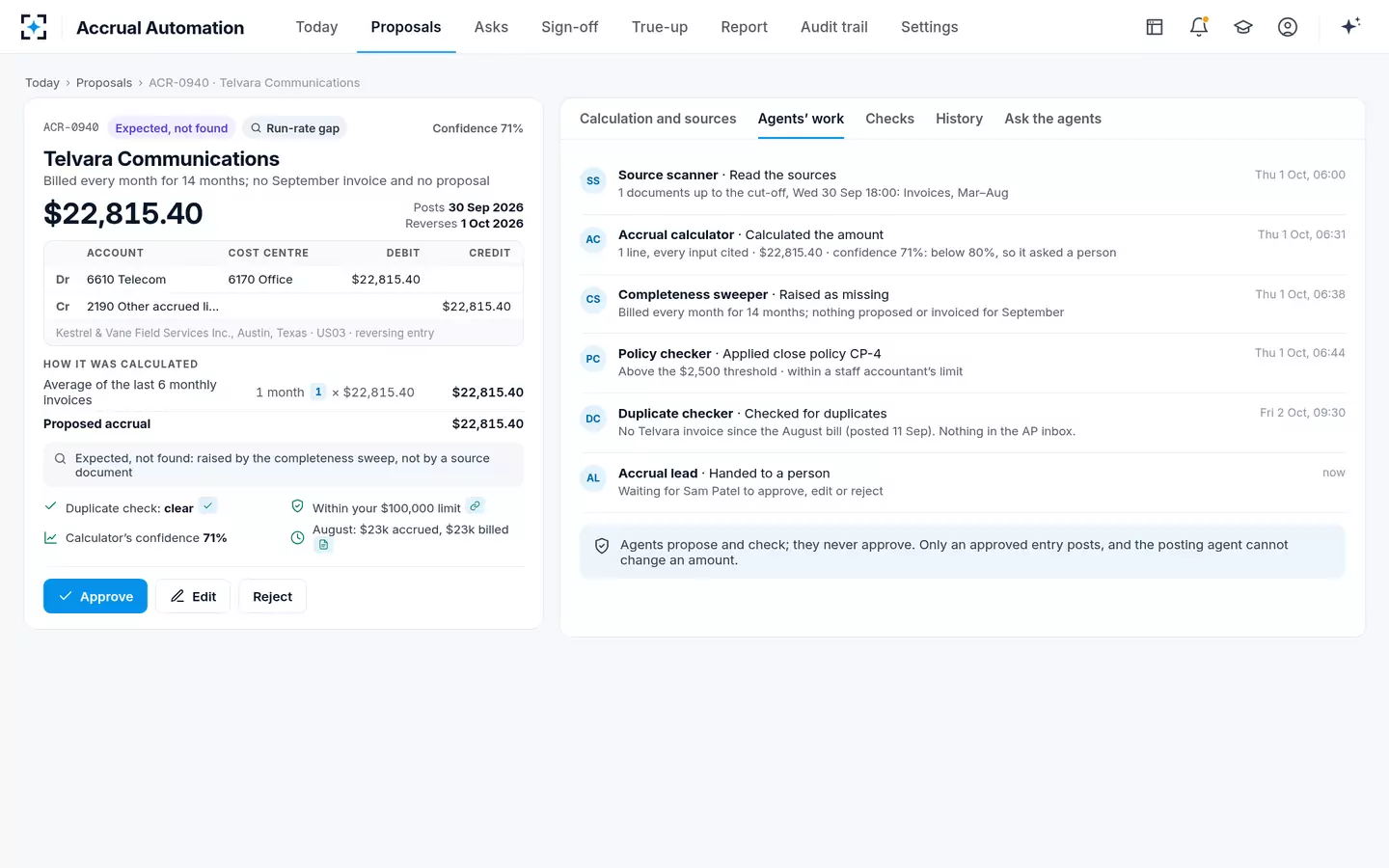

- 07What nobody proposed
A vendor billed monthly, with nothing proposed this month
Completeness sweeperThe completeness sweeper compared 148 vendors billed each month with the proposals, and found one missing. A telecom provider has billed for 14 months, but this month there is no invoice and no proposal. The sweeper raised an accrual of $22,815.40, the average of the last six monthly invoices. It goes to the telecom account for one office. The calculator's confidence was 71%, below the 80% bar, so it asked a person.
“Expected but not found. Raised by the completeness sweep and not by a source document.”
- 08When only a person knows
One clear question, and the answer becomes a source

Accrual calculatorFive questions went out this close, each with the evidence attached and a clock. The AP lead confirmed the telecom bill has not arrived. The provider moved its billing to a new portal this month and has not released the bill, so it should be accrued. A project manager got a question about an engineering firm's milestone 2 design freeze. It is a $64,000 fee, earned on written acceptance under clause 5.2 of the statement of work. The question was whether it was accepted by month-end. The reply is attached to the entry as a cited source.
Project manager: “Yes, accepted by month-end. I accepted the design freeze the day before in the project portal. The signed acceptance is attached.”

- 09Until the period locks
An invoice lands, and the proposal is withdrawn
Duplicate checkerThe duplicate checker compares each open proposal with new invoices every 30 minutes. It keeps going until the month locks at 18:00 on the set date. At 09:48 it finds a tool supplier's invoice, dated the last day of the month for that month's deliveries. The invoice covers the full $44,860.00, so the checker withdraws the proposal. Earlier it withdrew four others and cut one from $38,952.00 to $25,968.00. The accountant can restore any of them, with a reason code.

Duplicate checker: “$117,526.00 that would otherwise have been counted twice. I tell the accountant each time.”

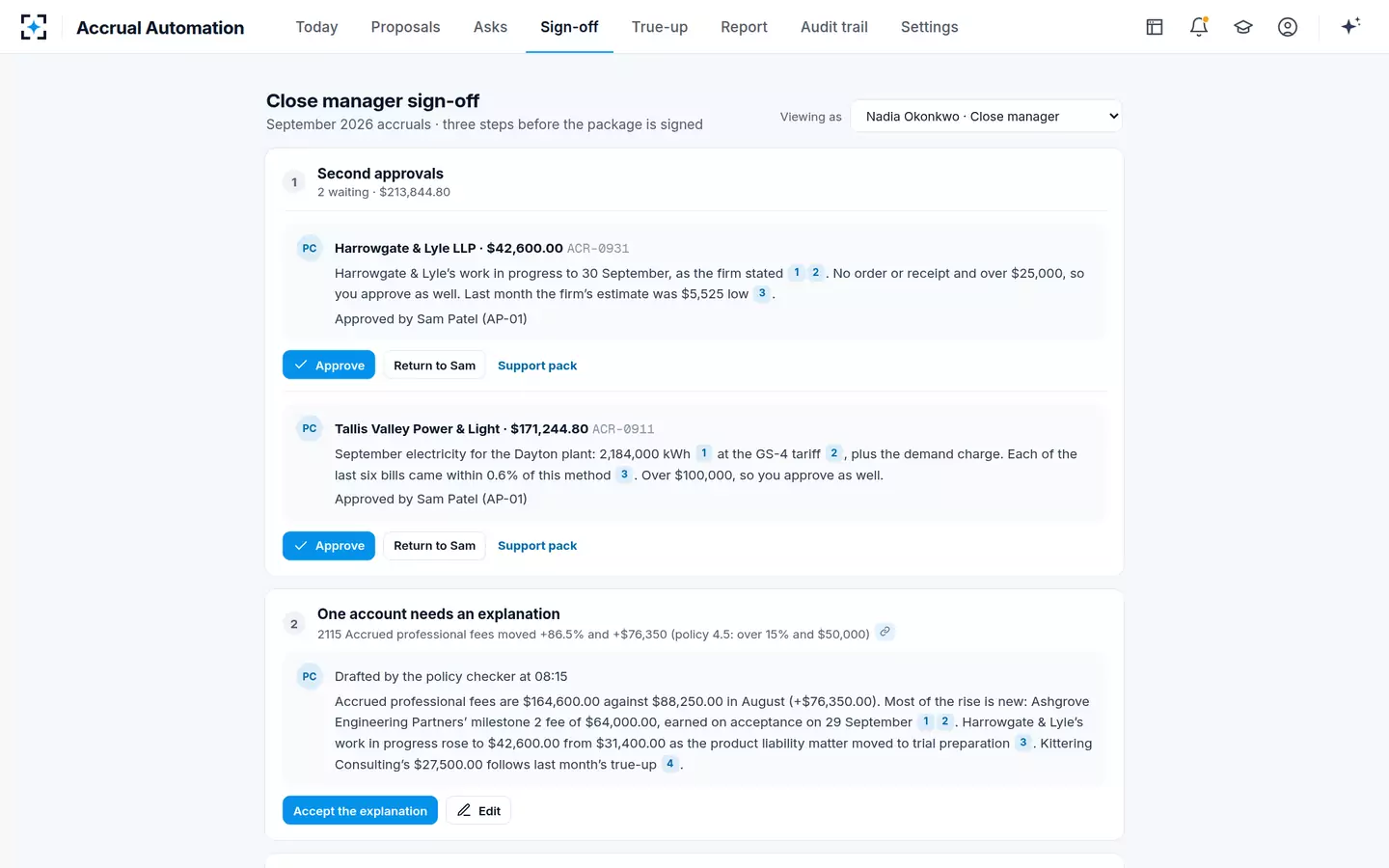

- 10Before the package is signed
Second approvals, one explanation, then the signature
Close managerTwo entries wait for the close manager. One is the power utility's $171,244.80 for 2,184,000 kWh at its tariff, which is over the accountant's $100,000 limit. The other is one vendor's $42,600.00 of work in progress. That is an estimate with no order or receipt, and it is over $25,000. Accrued professional fees moved +86.5%, or +$76,350, so the close policy needs an explanation. The policy checker has drafted one, with citations. Once these are done and the accountants have decided the rest, the month's package opens for the close manager's e-signature.
Drafted by the policy checker: “Most of the rise is new. It is an engineering firm's milestone 2 fee of $64,000.00, earned on acceptance the day before month-end.”
