- Before
- Abstracts 30–45 documents a month by hand on top of the close, and keeps the reasons for each judgment in a spreadsheet.
- Now
- Opens a lease already read, cited and checked twice; spends the time on the one judgment, asks the agents what-if questions, and signs.
Lease abstraction on a new office lease and its First Amendment
The company has signed a 10-year lease for a 24,000 rentable sq ft office floor, and a First Amendment that moves its start. Here is what happens next, screen by screen, in the working solution.
A worked example on sample data. Names, IDs and figures on the screens and in this section come from the demo.

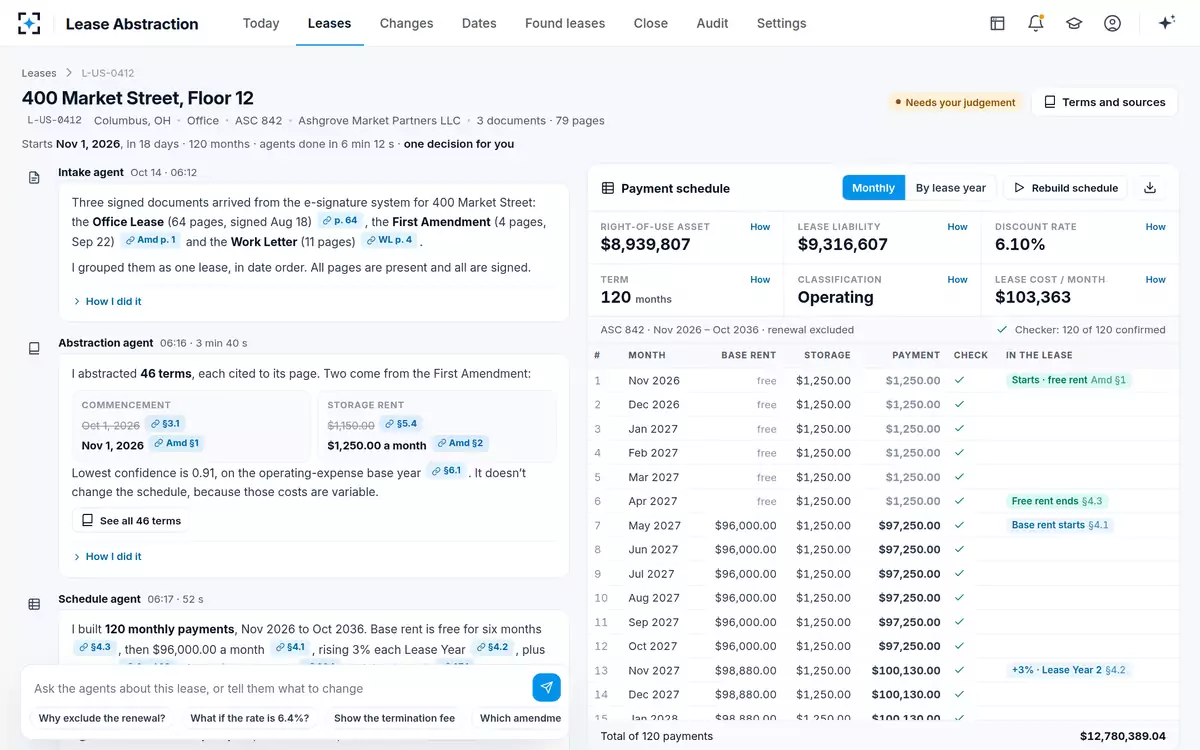

- 01Morning
The agents have already done the reading

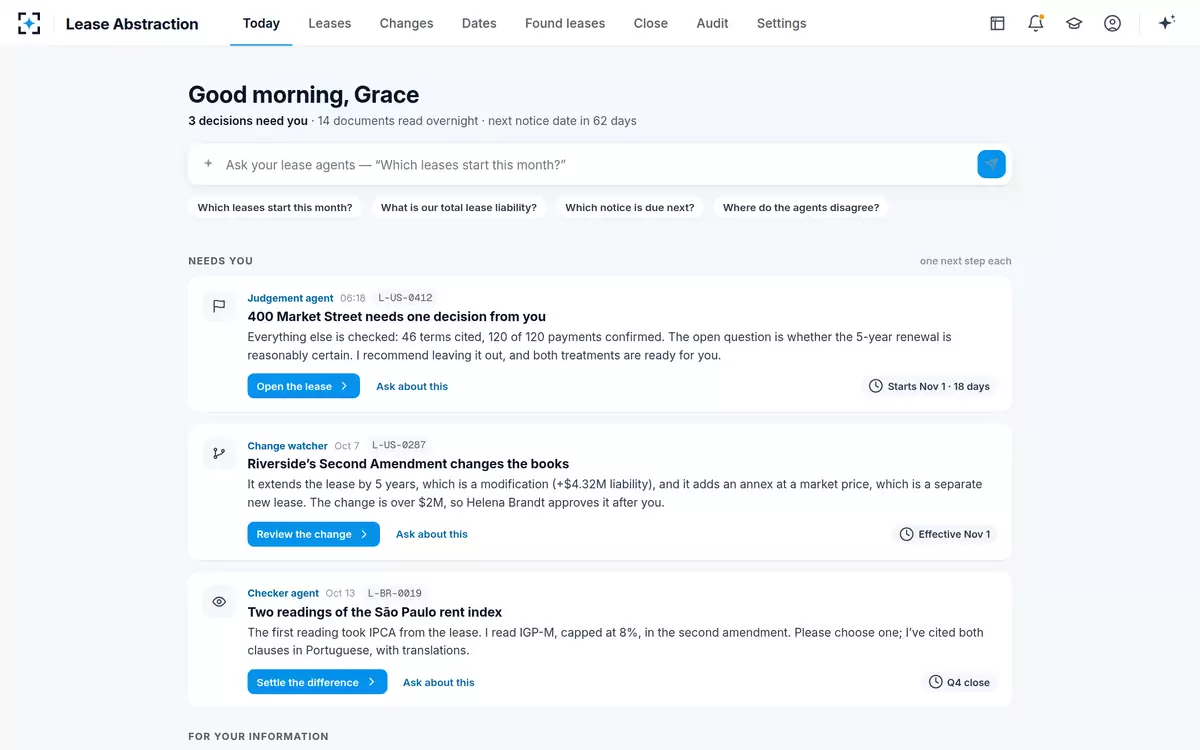

Lease accountantThe lease accountant's day opens as messages from the agents, each with one next step: 3 decisions are waiting, 14 documents were read overnight, and the next notice date is in 62 days. At the top, the judgement agent says the new office lease needs one decision: 46 terms cited, 120 of 120 payments confirmed, and an open question on the renewal.
“Everything else is checked: 46 terms cited, 120 of 120 payments confirmed. The open question is whether the 5-year renewal is reasonably certain.”
- 0206:12 – 06:16
Three documents become one lease, as amended

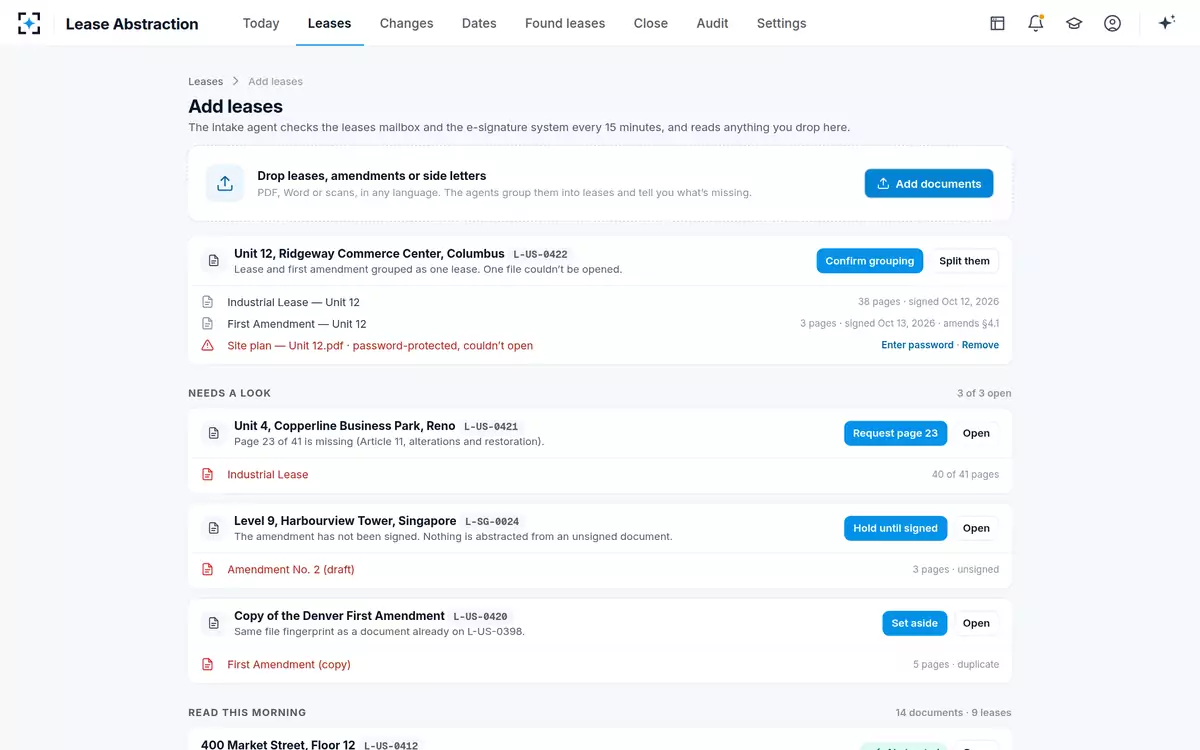

Intake agent and abstraction agentThree signed documents arrive from the e-signature system: the Office Lease (64 pages), the First Amendment (4 pages, signed later) and the Work Letter (11 pages). The intake agent groups them in date order and checks that each page is present and signed. The abstraction agent reads 46 terms in 3 min 40 s; two come from the amendment: commencement moves a month later, and storage rent goes from $1,150 to $1,250 a month.
Lowest confidence is 0.91, on the operating-expense base year. It does not change the schedule, because those costs are variable.
- 03One click
Any number opens the page it came from

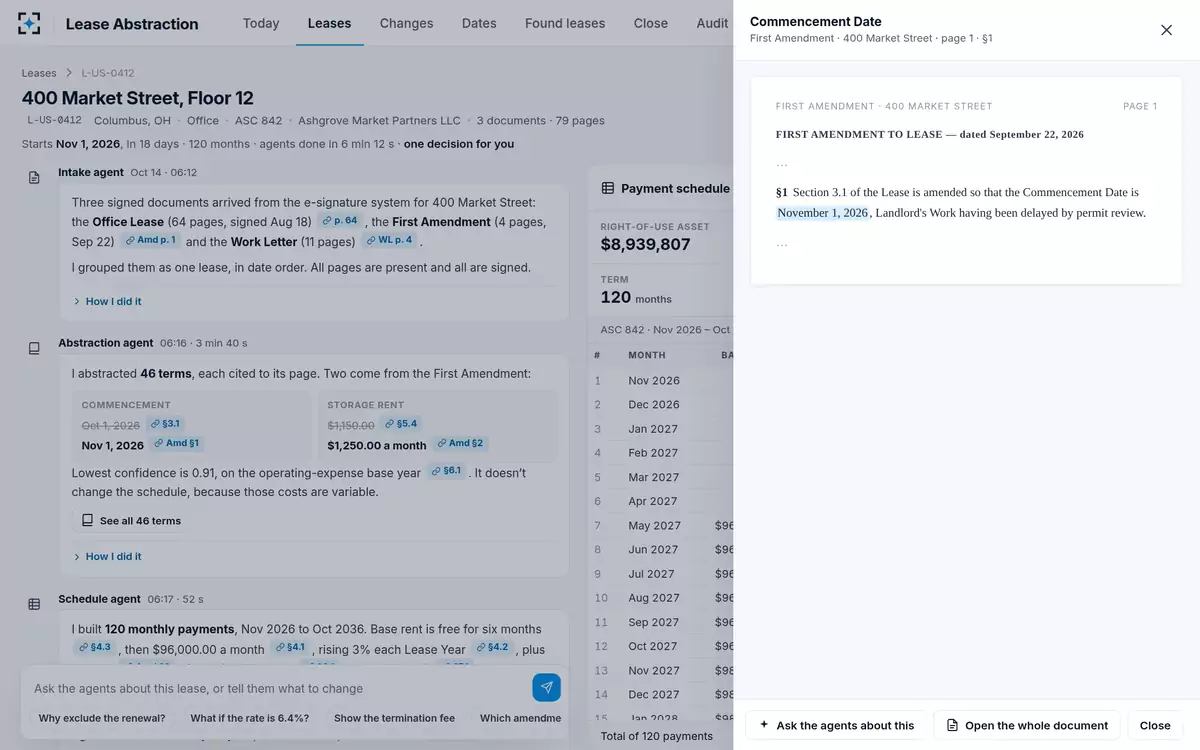

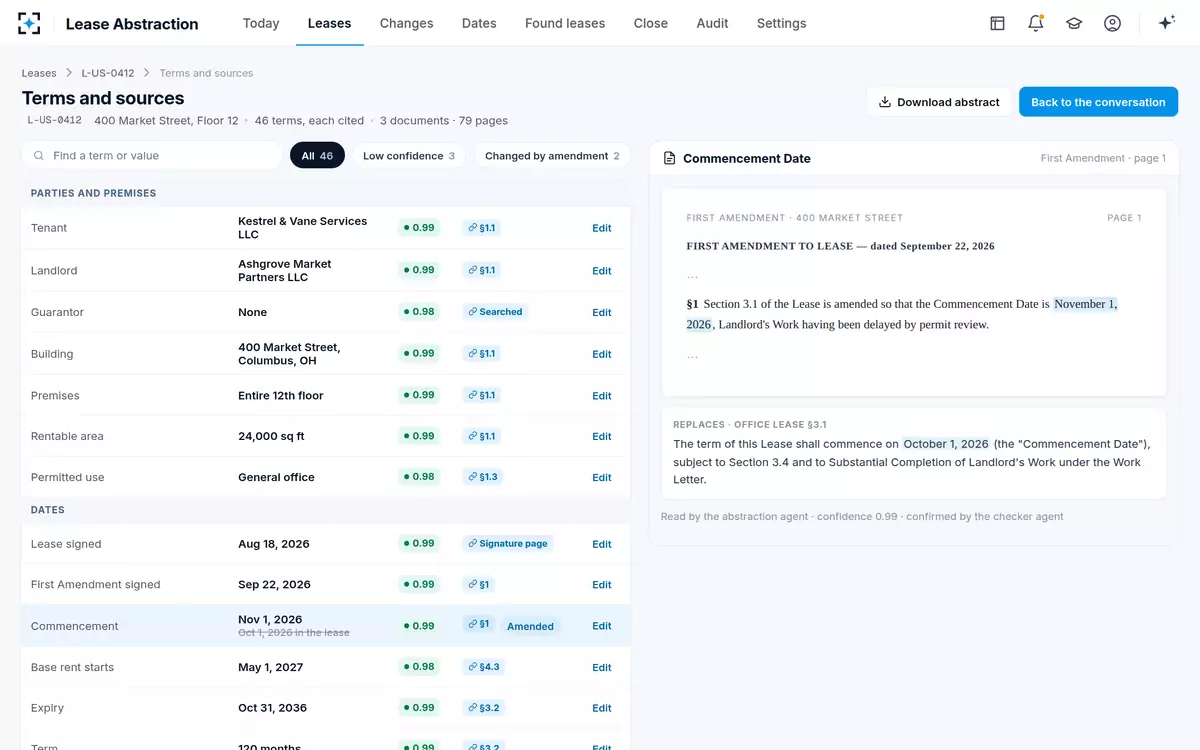

Lease accountantEach value carries a citation. The lease accountant clicks the one on the new commencement date, and the First Amendment opens at page 1, §1, with the passage highlighted: the Commencement Date moves a month later, the landlord's work having been delayed by permit review. From there the accountant can ask the agents about the passage or open the whole document.
- 0452 seconds
The payment schedule builds itself
Schedule agent120 monthly payments over the ten-year term: base rent free for six months (§4.3), then $96,000.00 a month (§4.1), rising 3% each Lease Year (§4.2), plus storage. Free rent, each step, the termination and renewal notices and expiry are marked in the margin, each linked to its clause. At the treasury's 10-year rate of 6.10%, the lease liability is $9,316,607 and the right-of-use asset $8,939,807, after the $376,800 allowance.
Operating expenses and the $192,000 deposit are left out of the schedule: they are not lease payments.
- 051 min 52 s
A second reading, without the first answers
Checker agentThe checker re-reads all three documents on its own: 120 of 120 payments agree, and so do 14 of 14 dates and options. One difference is settled from the documents themselves: the first draft took storage at $1,150 from the lease, but the First Amendment replaced it with $1,250 from commencement. Both readings stay on the record, and the terms screen marks each amended term with both citations.
The checker does not overwrite a value silently. A difference it cannot settle from the documents goes to a person.
- 0606:18
One call needs the lease accountant, with both treatments computed

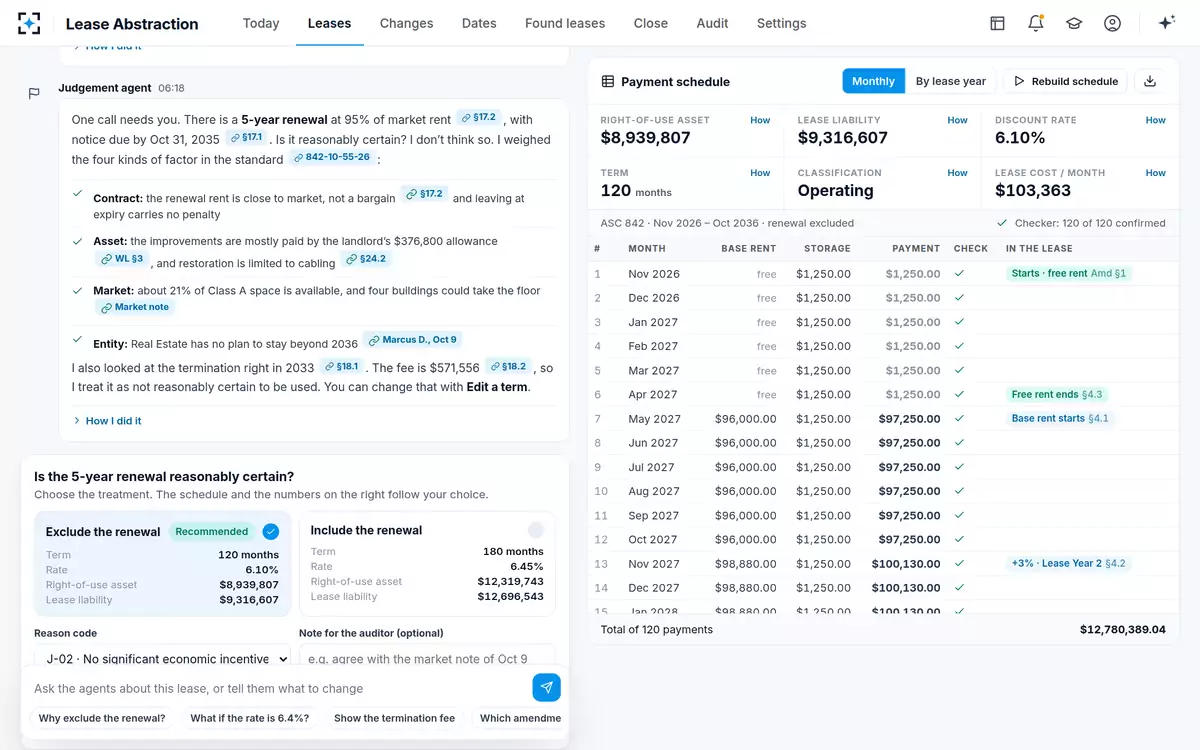

Judgement agentThere is a 5-year renewal at 95% of market rent, with notice due a year before expiry. The agent weighs the four kinds of factor in ASC 842-10-55-26, each cited: the rent is close to market; the landlord's allowance paid for most of the improvements; about 21% of Class A space is available; Real Estate has no plan to stay beyond the lease's end. It recommends leaving the renewal out, and shows both: 120 months at 6.10%, or 180 months at 6.45% with a right-of-use asset of $12,319,743.
The judgement agent does not decide. It shows both treatments, each time.
- 07The accountant asks

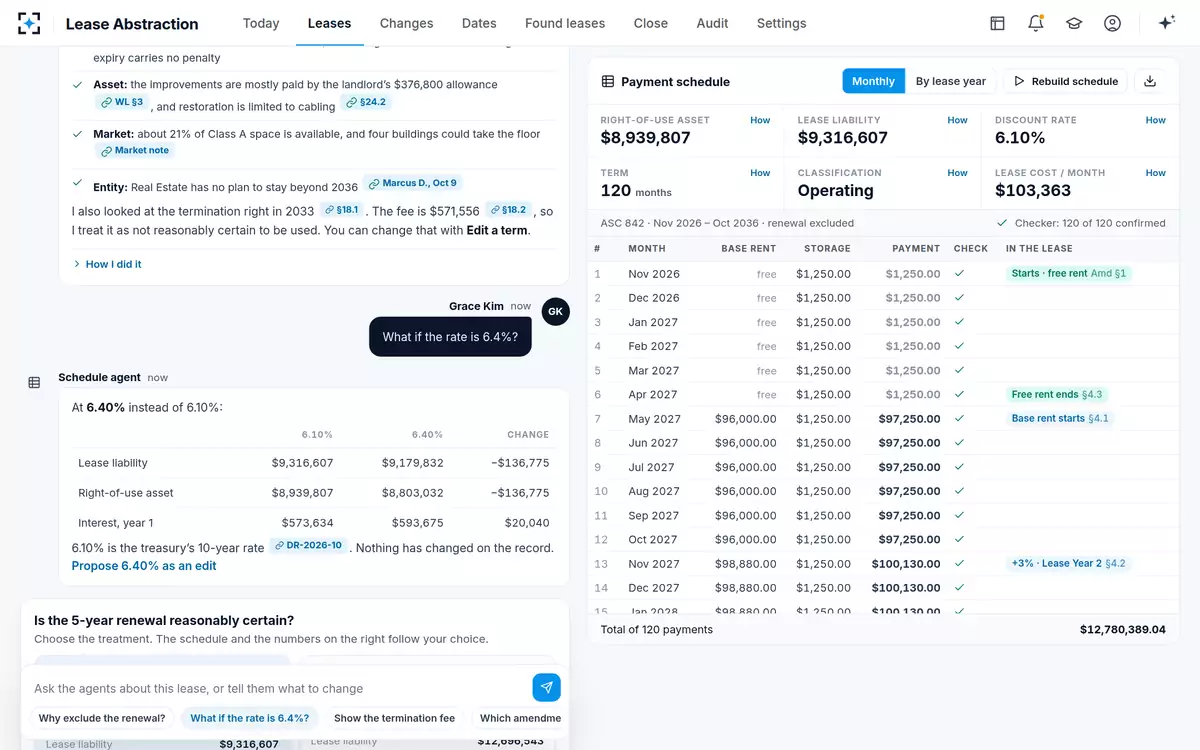

“What if the rate is 6.4%?”
Lease accountantThe lease accountant asks the agents in plain words. The schedule agent answers in the thread: at 6.40% the lease liability would be $9,179,832, $136,775 lower, and year-1 interest $593,675. It points out that 6.10% is the treasury's 10-year rate in this month's rate table, and offers to propose 6.40% as an edit.
“Nothing has changed on the record.”
- 0809:47 · signed
Decided, signed, and the lease is booked

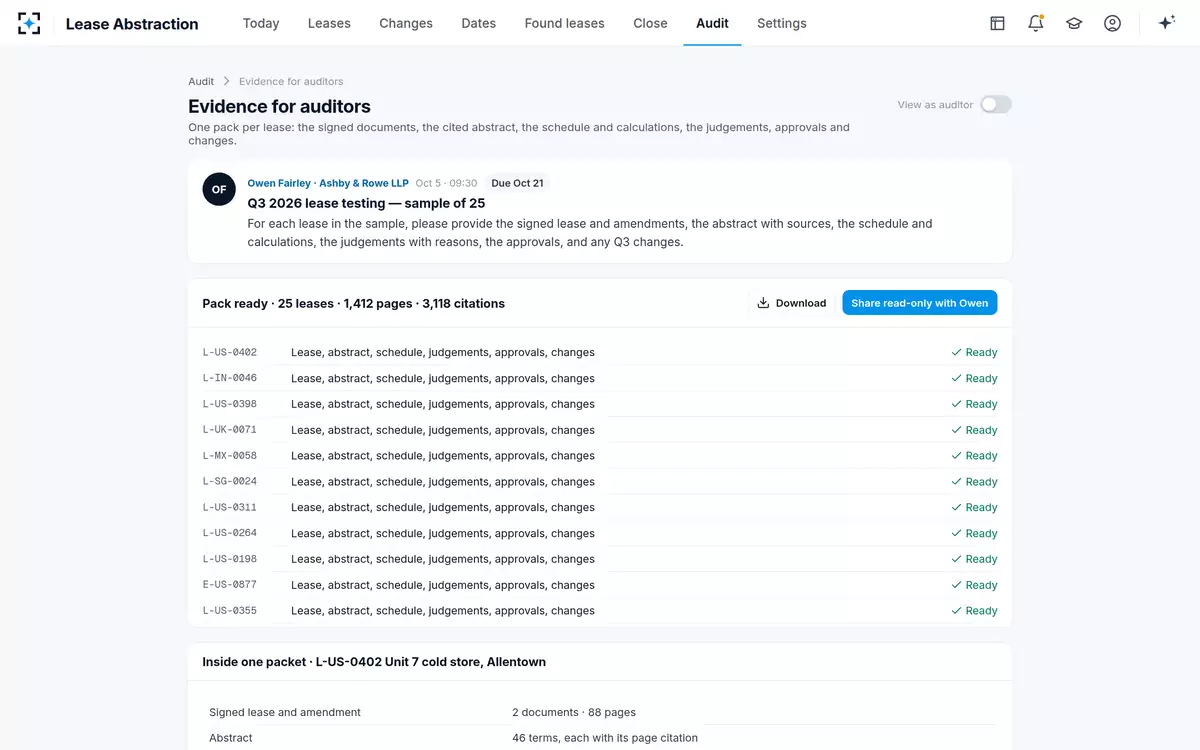

Lease accountantThe lease accountant excludes the renewal with the reason code “No significant economic incentive to renew” and e-signs. Only then do the agents export: the lease is created in the lease subledger, the commencement journal is scheduled for the start date, the notice dates go to the real estate calendar with reminders to the real estate manager, and the evidence is sealed for the auditor: 46 citations, 120 checked payments, the decision and the signature.
“On the books 18 days before the lease starts. Agent time 6 min 12 s, your review 14 minutes.”
- 09Amendment

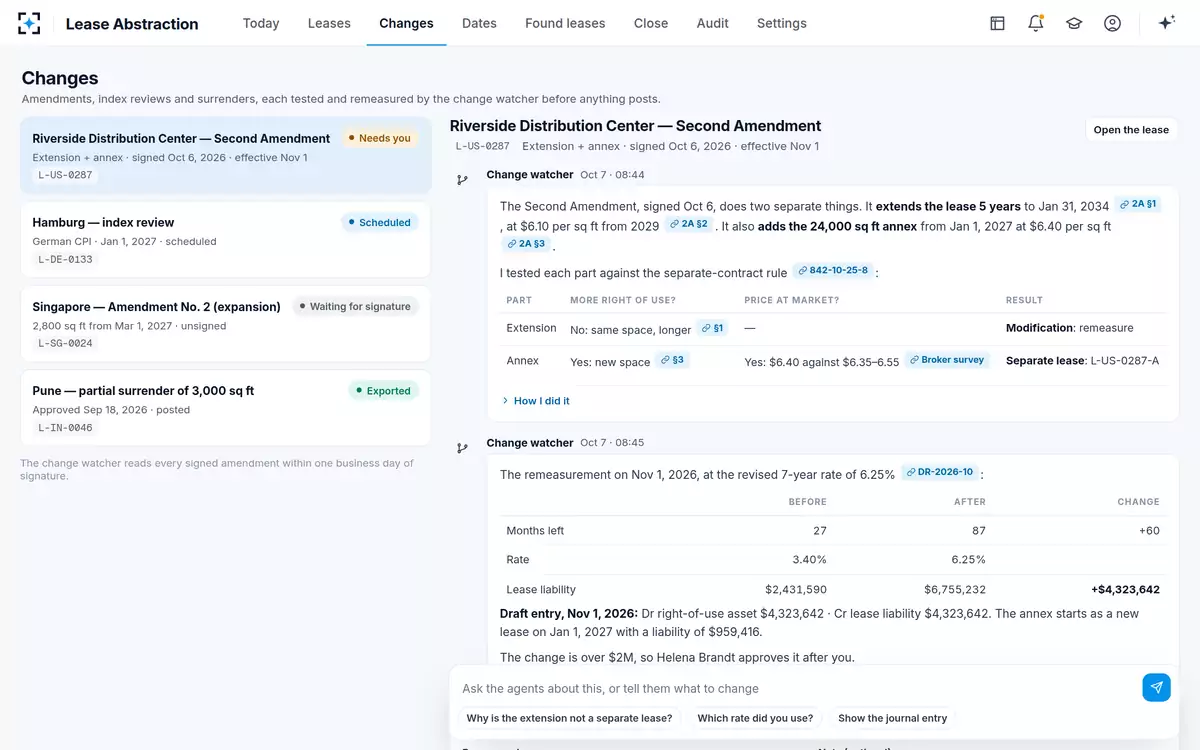

A distribution center's second amendment: part remeasured, part a new lease
Change watcherThe amendment for a distribution center extends the lease 5 years and adds a 24,000 sq ft annex. The change watcher tests each part against ASC 842-10-25-8: the extension adds no right of use, so it is a modification, and the liability goes from $2,431,590 to $6,755,232 at the revised 7-year rate of 6.25%. The annex is new space at $6.40 a sq ft against a broker survey of $6.35–6.55, so it is a separate lease, with a liability of $959,416.
Draft entry, dated the first of next month: Dr right-of-use asset $4,323,642 · Cr lease liability $4,323,642. Nothing posts until a second person signs.
- 10Second approval

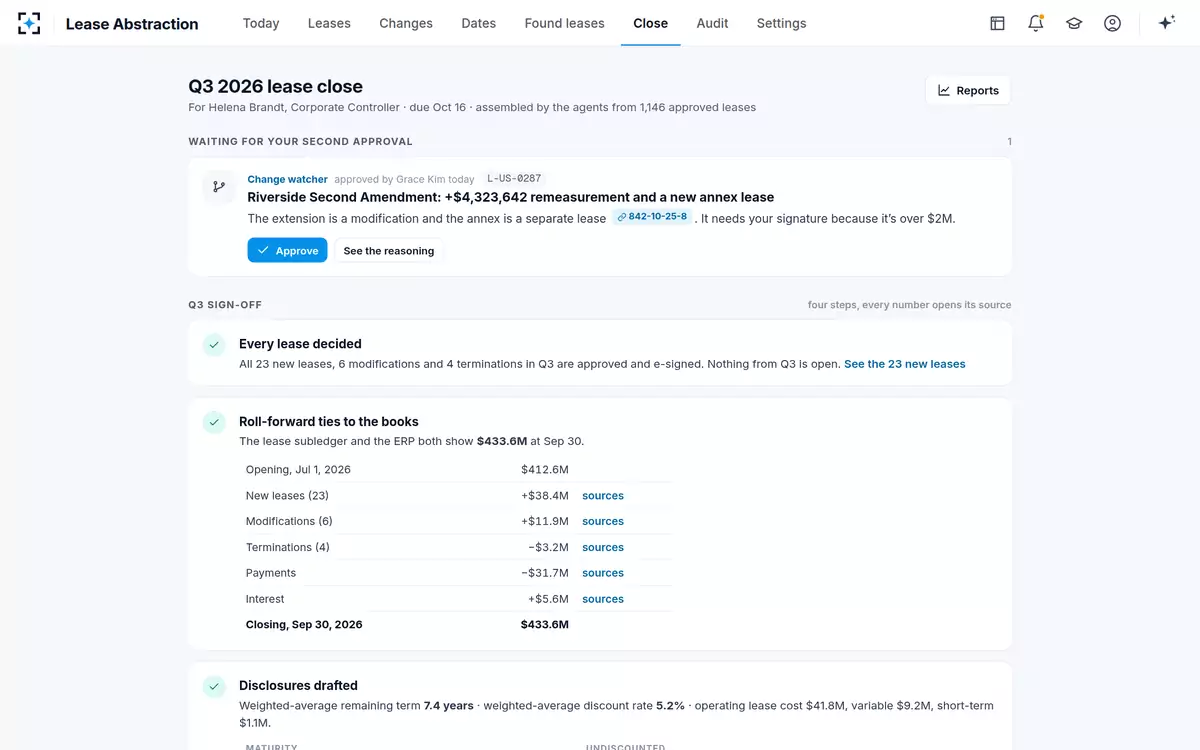

Over $2M, the controller signs too
Corporate controllerThe lease accountant approves the remeasurement with a reason code. Because the change is over $2M, it waits at the top of the controller's quarter close, with the separate-contract test behind it. The same screen shows the quarter's sign-off: each new lease, modification and termination decided, a roll-forward from $412.6M to $433.6M that ties to the subledger and the ERP, and drafted disclosures in which each number opens its source.
