- Before
- Spends days copying setpoints from PDFs into a locked template, and minutes thinking about the test itself.
- Now
- Opens a drafted protocol with each value cited to its page, decides on the one missing value and the one disagreement, and accepts the redraft when a URS changes.
A bioreactor OQ protocol through a URS revision and three rewritten tests
A 500 L stainless-steel bioreactor in one suite at Plant 3 needs its OQ protocol, and its IQ is already approved. On the morning the work starts, a new URS revision arrives. Here is what happens next, screen by screen, in the working solution.
A worked example on sample data. Names, IDs and figures on the screens and in this section come from the demo.
- 01Morning

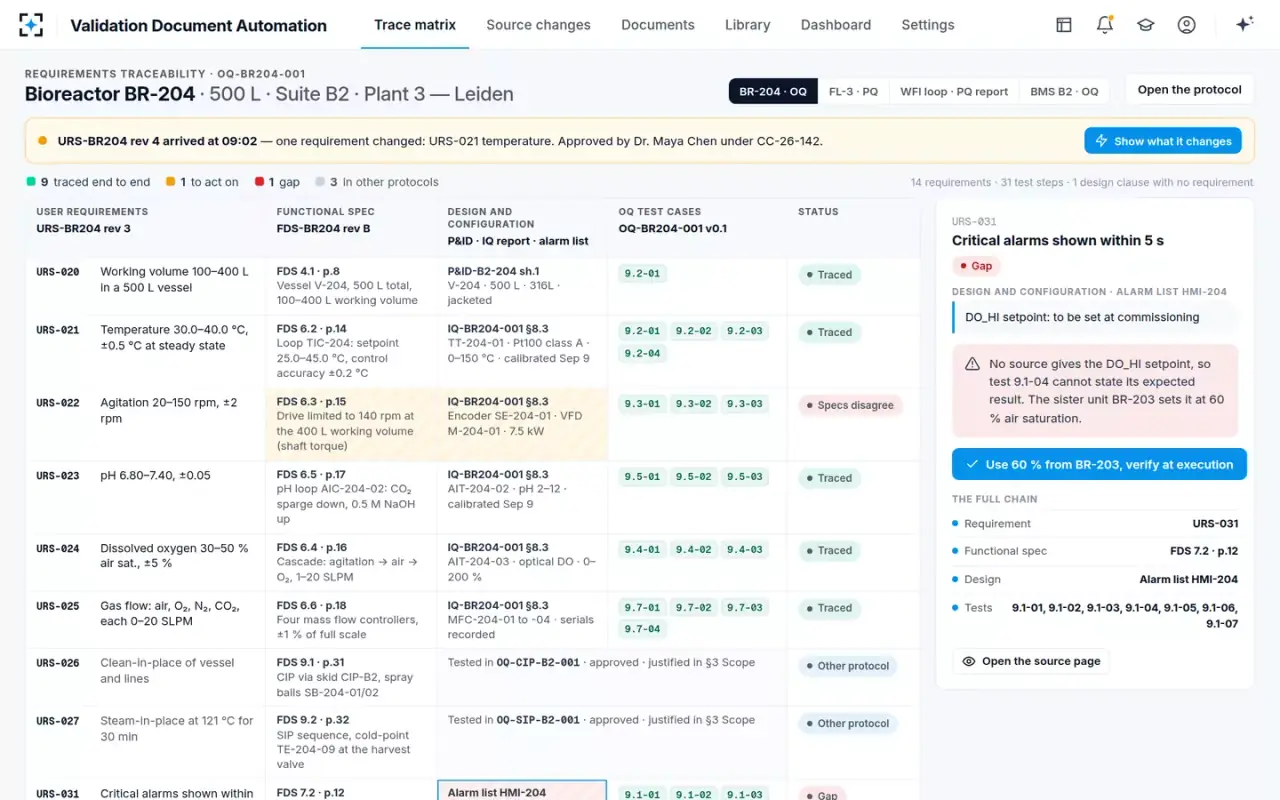

The trace matrix, before a word of the protocol
Validation engineerThe engineer opens the requirements traceability for the bioreactor's OQ protocol. Every user requirement runs across to its functional-spec clause, its design and configuration record and the OQ test cases that prove it: 14 requirements, 31 test steps. Nine are fully traced, one needs a decision, three (clean-in-place, steam-in-place, batch backup) are tested in their own approved protocols, and one is a gap: critical alarms are required within 5 s, but the alarm list leaves the high dissolved-oxygen (DO) setpoint “to be set at commissioning”.
“No source gives the high DO setpoint, so test 9.1-04 cannot state its expected result. The sister unit sets it at 60 % air saturation.”
- 02One click

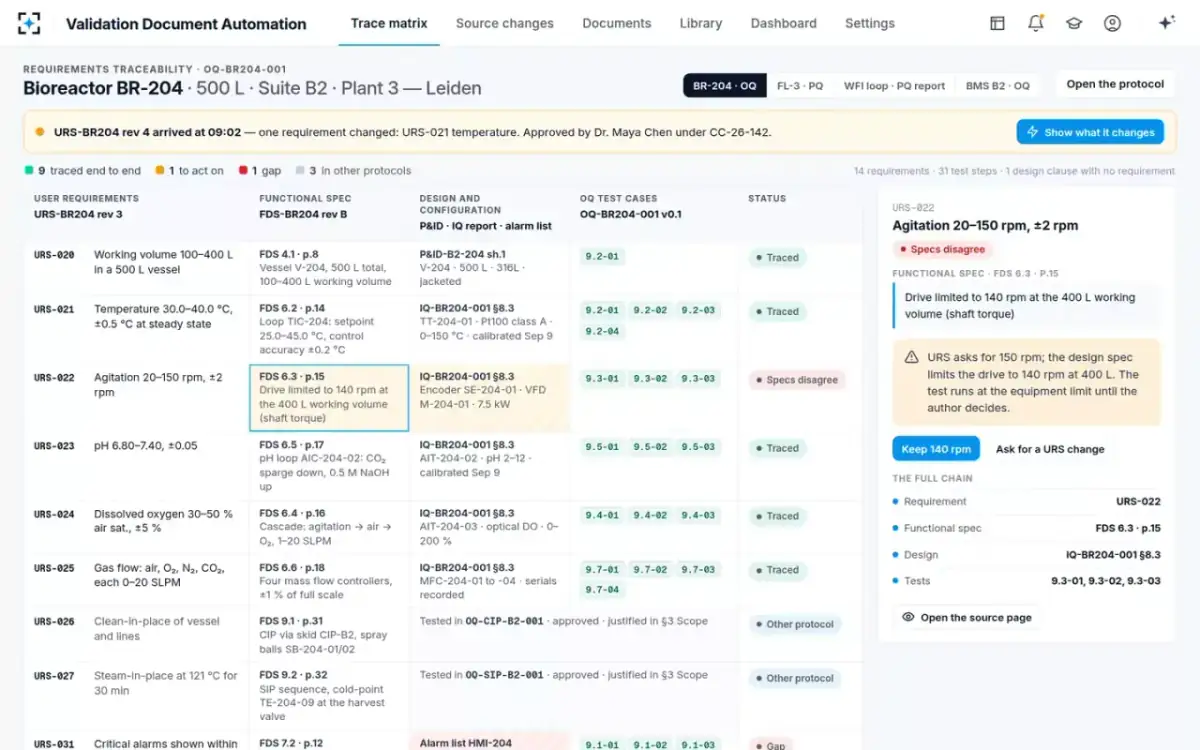

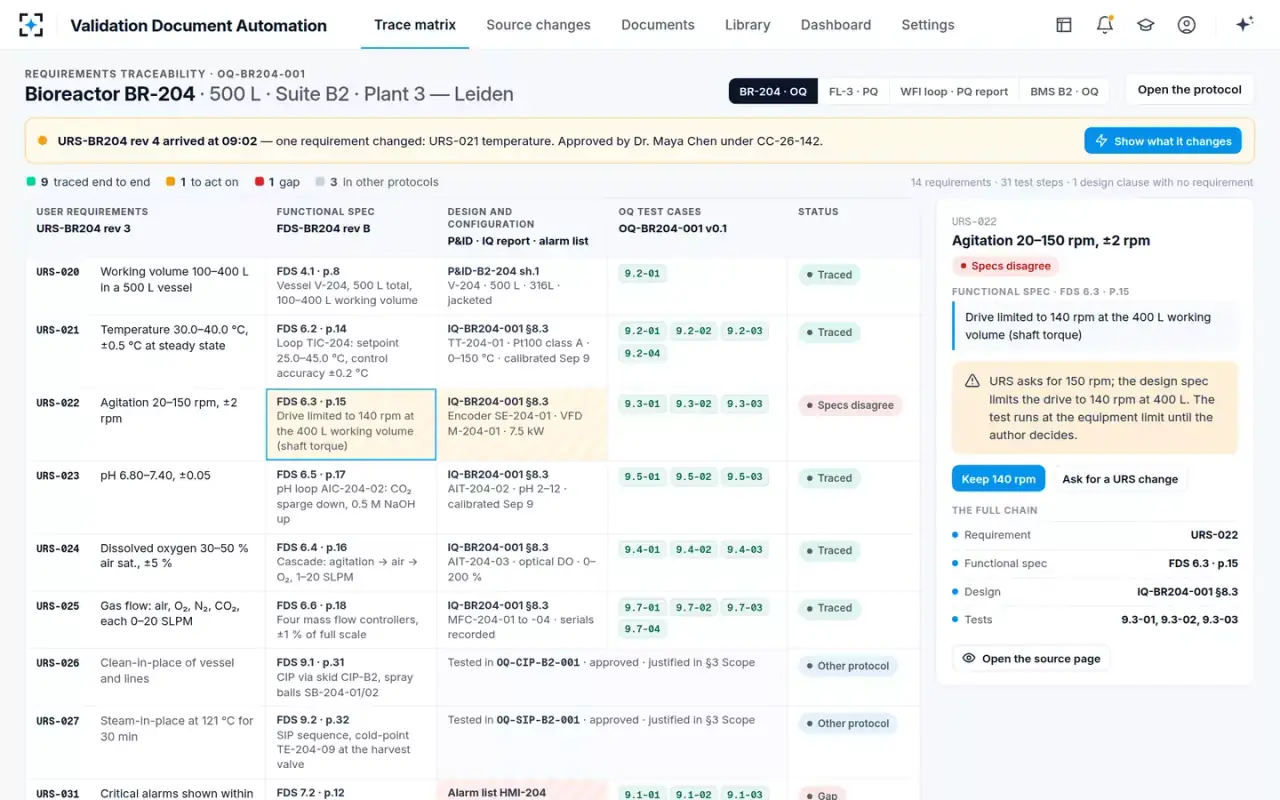

The requirement and the design spec disagree
Consistency checkerThe agitation requirement asks for 20 to 150 rpm, ±2 rpm. The design spec, on page 15, limits the drive to 140 rpm at the 400 L working volume because of shaft torque. The row is marked “Specs disagree”, and the test runs at the equipment limit until the engineer keeps 140 rpm or asks for a URS change. A design clause with no requirement, antifoam dosing, shows too.
“URS asks for 150 rpm; the design spec limits the drive to 140 rpm at 400 L. The test runs at the equipment limit until the author decides.”
- 03Mid-morning

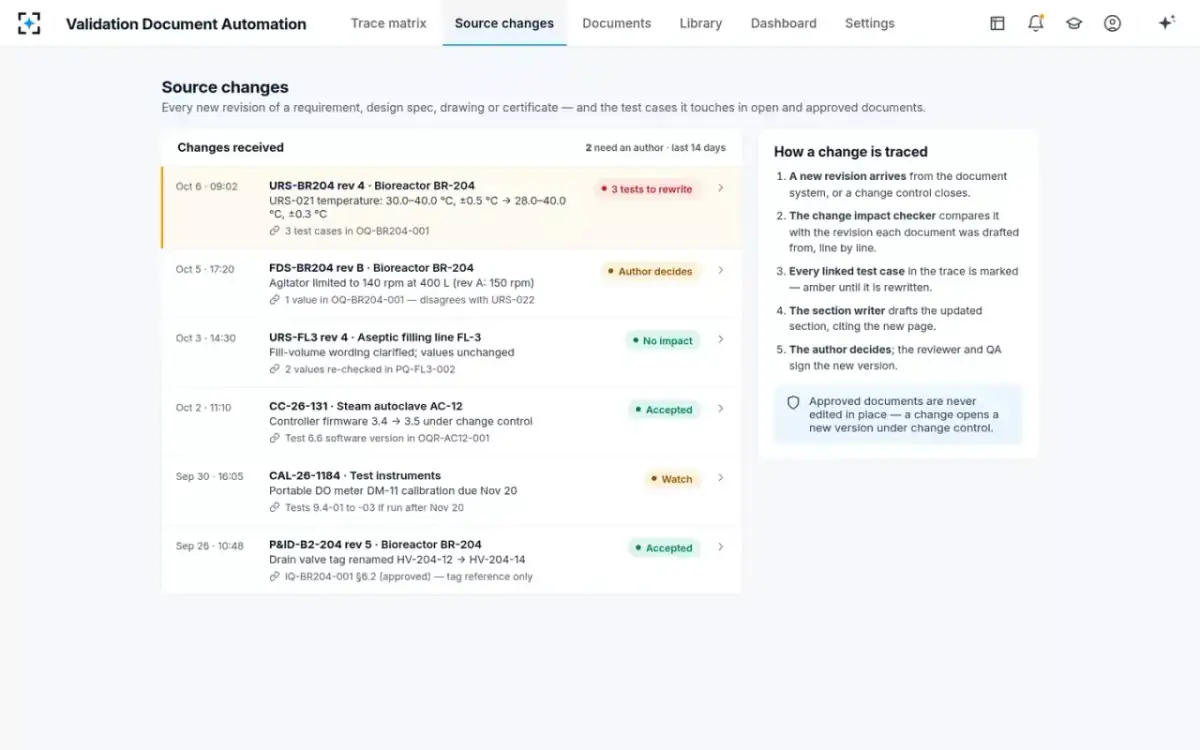

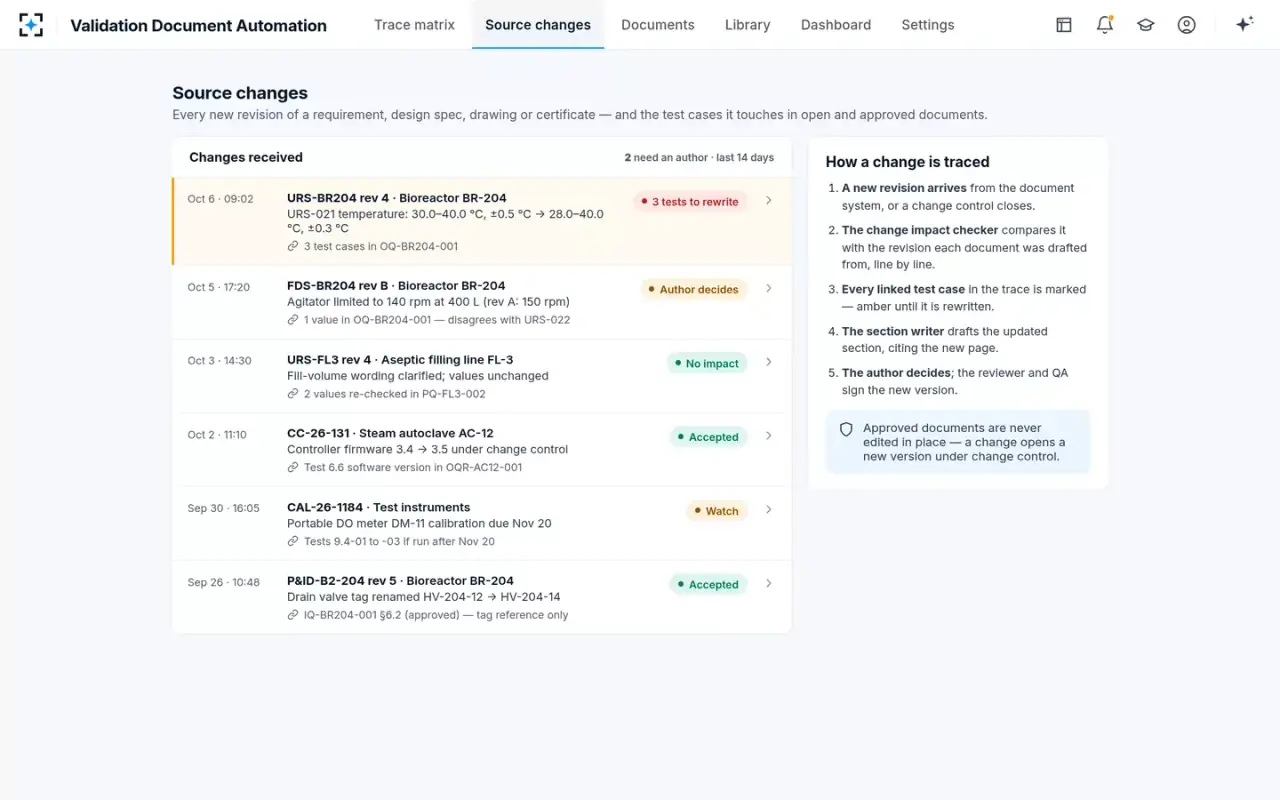

A new URS revision arrives under change control
Change impact checkerThe head of QA has approved URS revision 4 under change control. It sits at the top of six revisions received in 14 days on the Source changes screen, each with what changed and what it touches. Temperature goes from 30.0–40.0 °C, ±0.5 °C to 28.0–40.0 °C, ±0.3 °C: 3 tests to rewrite. An autoclave firmware change, a renamed drain-valve tag and a DO meter's calibration due date are traced the same way.
“Approved documents are never edited in place. A change opens a new version under change control.”

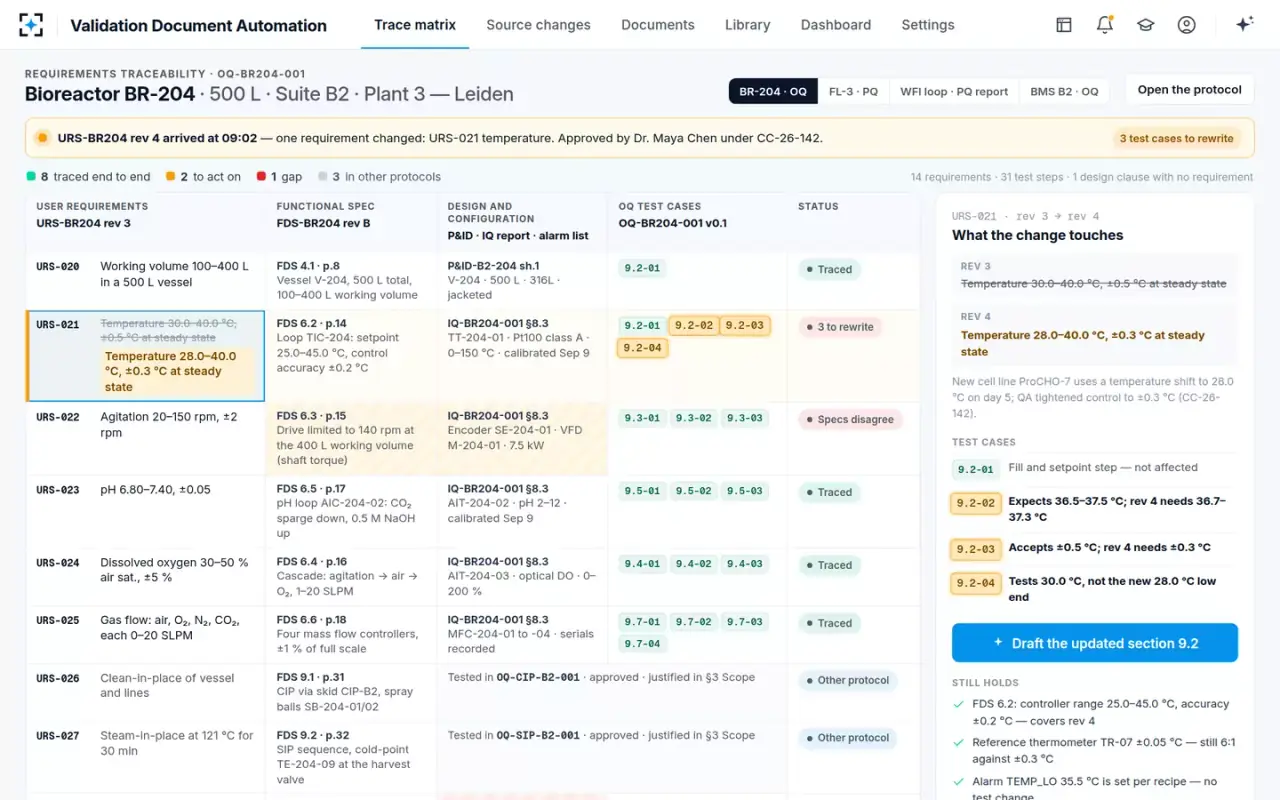

- 04Show what it changes

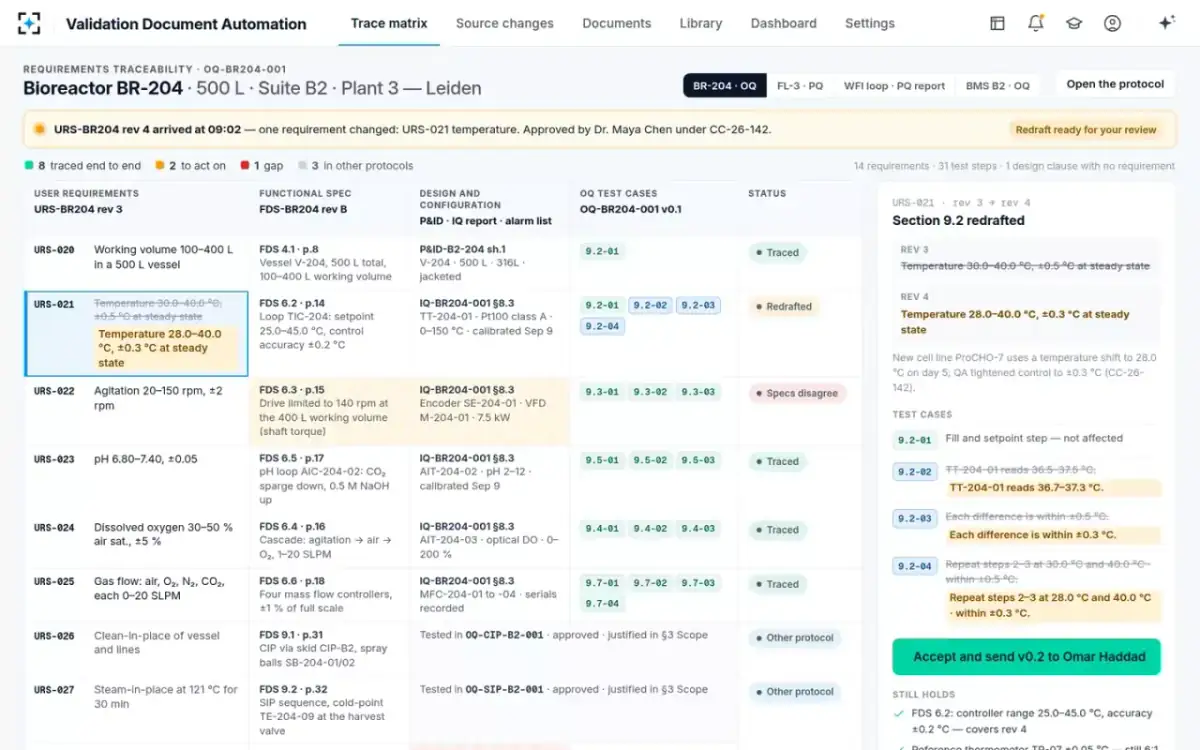

Three test cases turn amber; the first is untouched
Change impact checkerRev 3 and rev 4 sit side by side: the new cell line shifts to 28.0 °C on day 5, and QA tightened control to ±0.3 °C. Test 9.2-02 expects 36.5–37.5 °C where rev 4 needs 36.7–37.3 °C; 9.2-03 accepts ±0.5 °C; 9.2-04 tests 30.0 °C instead of 28.0 °C. Test 9.2-01 is not affected. What still holds is listed: the controller's 25.0–45.0 °C, ±0.2 °C range covers rev 4, and the reference thermometer at ±0.05 °C is still 6:1 against ±0.3 °C.
The change impact checker marks; only a person clears a mark, and approved documents stay as signed.
- 058.4 seconds

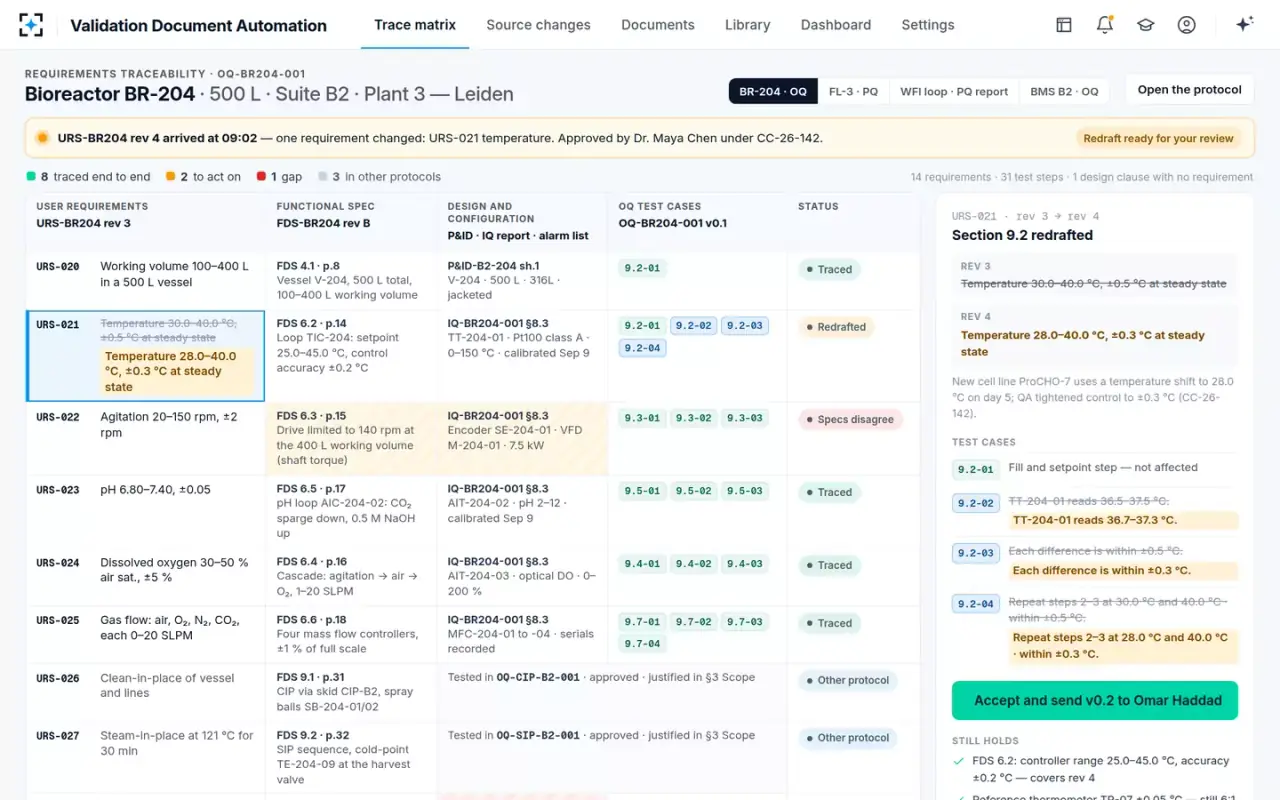

Section 9.2 redrafted, citing the new page
Section writerThe engineer clicks “Draft the updated section 9.2”. The section writer reads page 4 of rev 4, rewrites tests 9.2-02, -03 and -04 in the locked template wording, checks the instrument accuracy and updates the trace from the requirement through the design spec and sensor to its four tests. Old and new expected results sit side by side: 36.7–37.3 °C, with steps 2–3 repeated at 28.0 °C and 40.0 °C within ±0.3 °C.
- 06Accepted
Accepted, and sent to review as v0.2

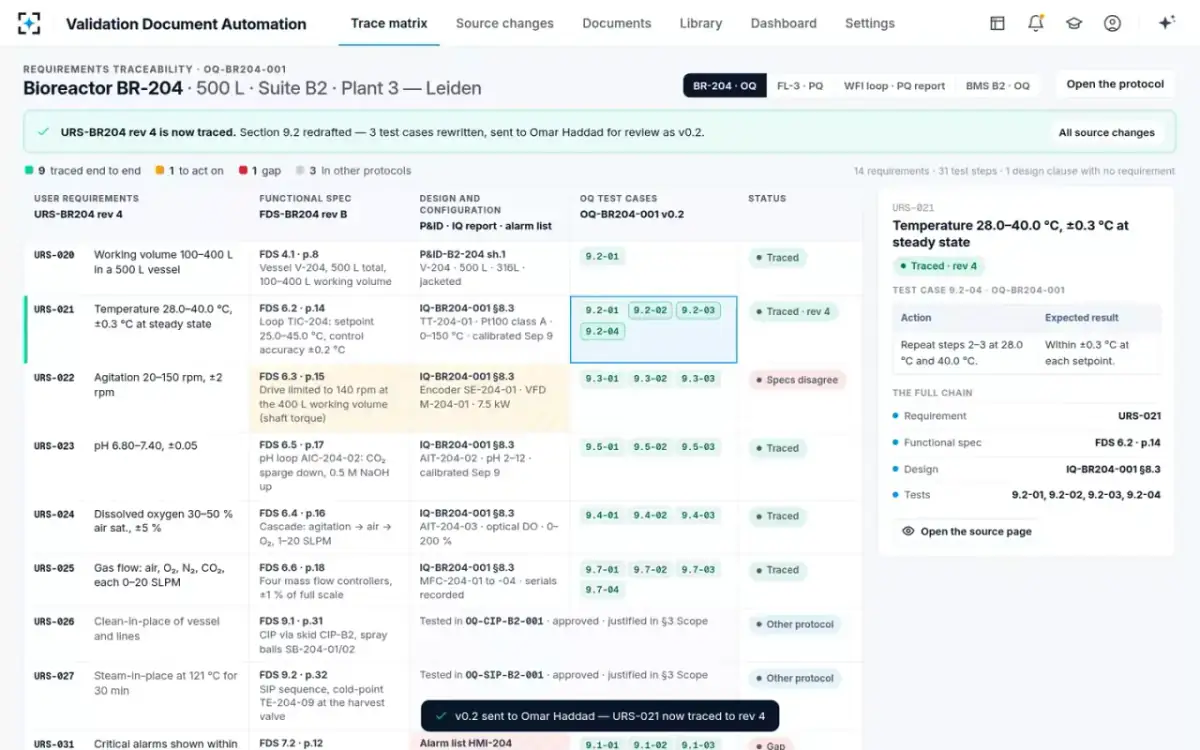

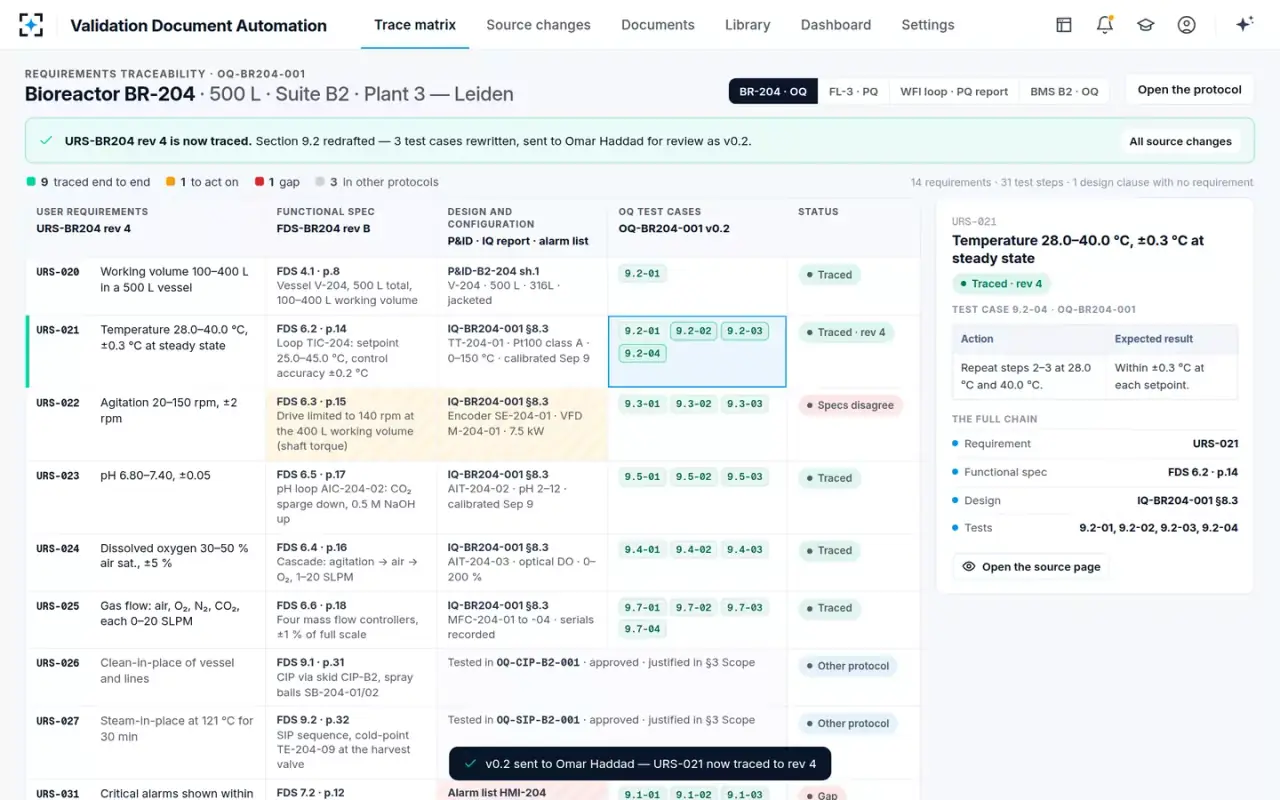

Validation engineerThe engineer reads the redraft and accepts it. The matrix header moves to URS rev 4, the protocol to v0.2, and the temperature requirement shows “Traced · rev 4” with all four test cases green. The protocol goes to the automation engineer for review, and the step is recorded on the activity trail.
“URS rev 4 is now traced. Section 9.2 redrafted: 3 test cases rewritten, sent for review as v0.2.”
- 07Inside the protocol

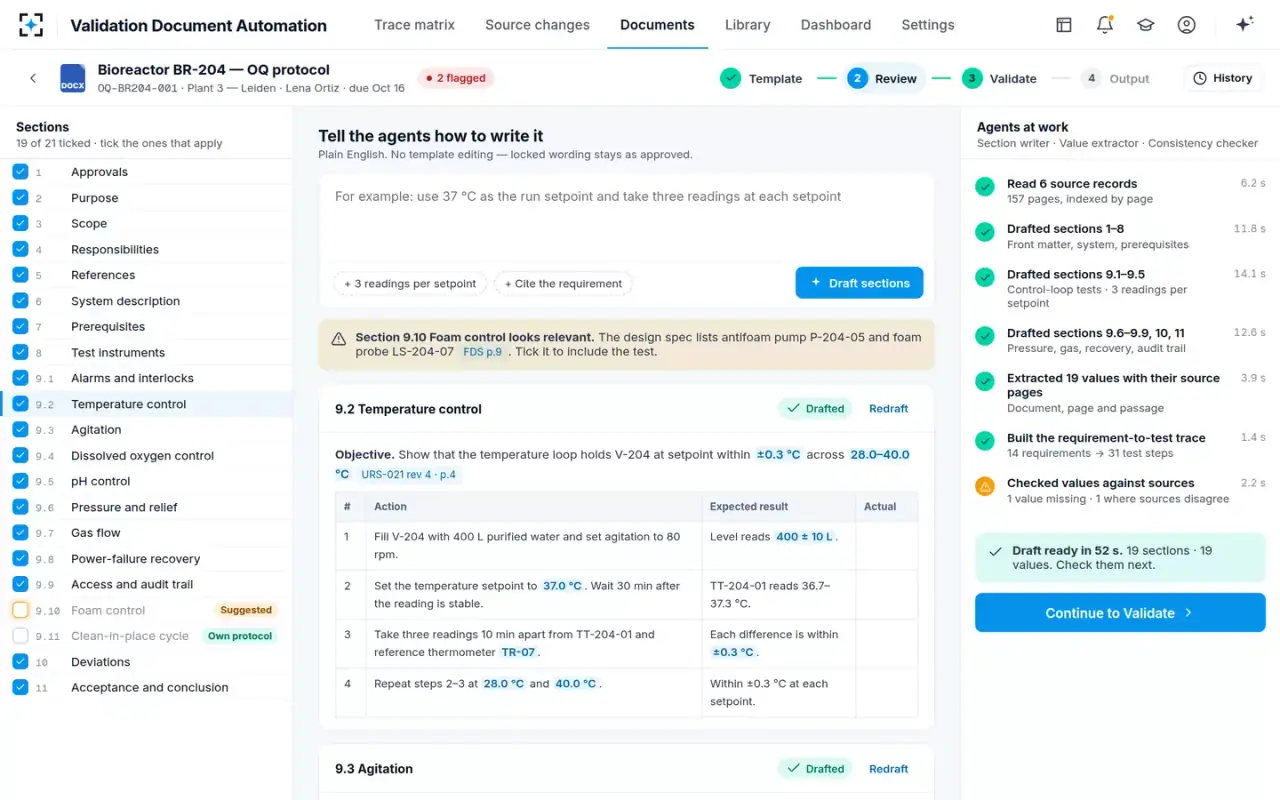

How the draft was written: plain English, locked wording

Section writer · Value extractor · Consistency checkerThe engineer ticks 19 of the 21 template sections and tells the agents how to write them in plain English, with no template editing. The agents read 6 source records, 157 pages indexed by page, draft each ticked section, extract 19 values with their source pages and build the requirement-to-test trace. Draft ready in 52 s. They also suggest a section 9.10 on foam control: the design spec lists an antifoam pump and a foam probe, and the requirements do not.
“Tell the agents how to write it. Plain English. No template editing: locked wording stays as approved.”
- 08Validate

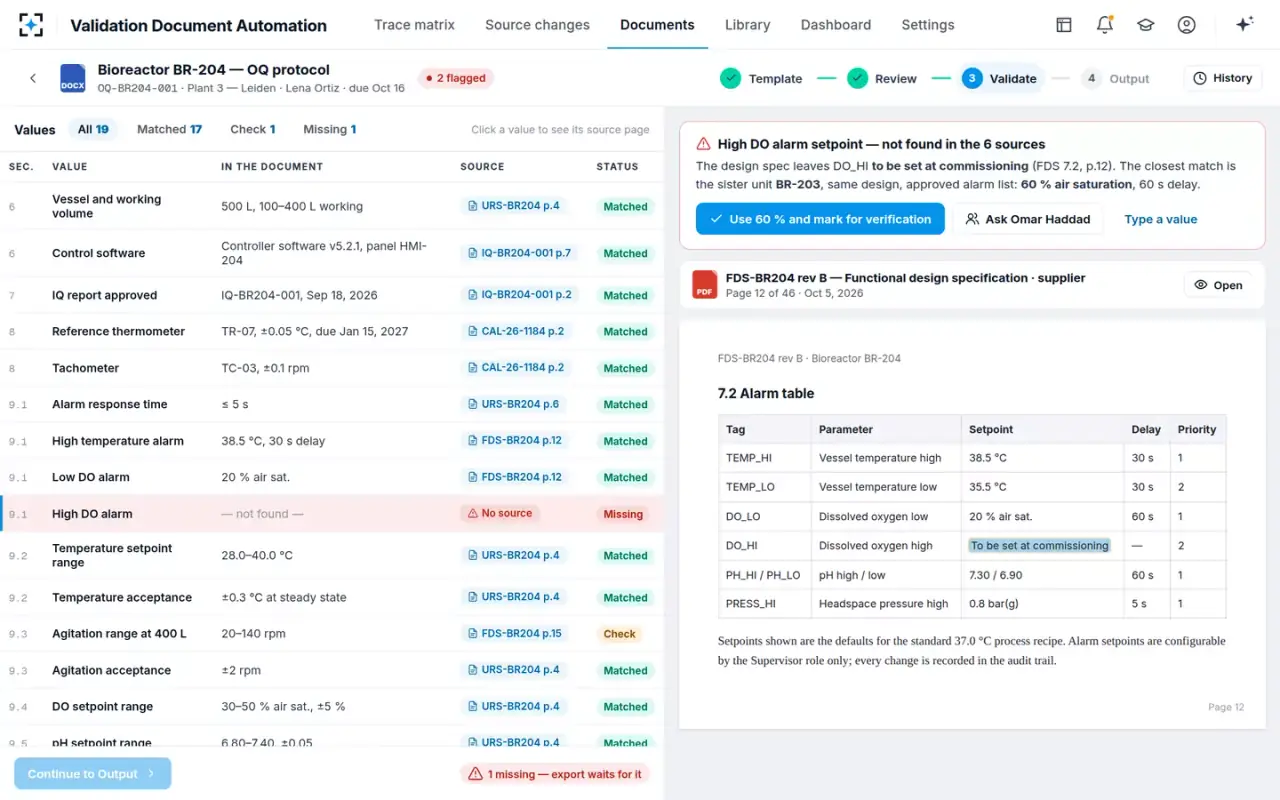

The 19 values, each beside its source page
Validation engineerAll 19 values are listed with their document and page: 17 matched, 1 to check (agitation at 140 rpm) and 1 missing. Page 12 of the design spec shows why the high DO alarm has no source: its alarm table leaves the setpoint “to be set at commissioning”. The engineer can use 60 % from the sister unit marked for verification, ask the automation engineer, or type a value with a reason. Until then, export waits.
The value extractor leaves an unreadable or missing value empty, and the section writer flags it.

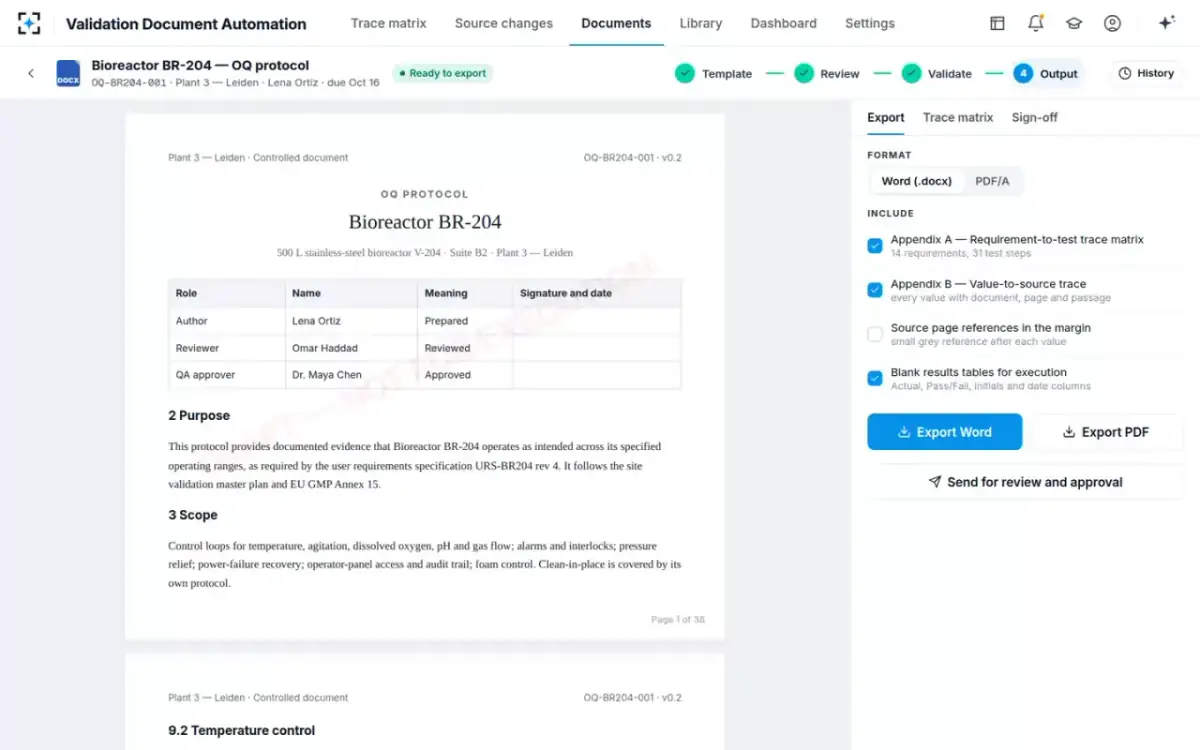

- 09Output

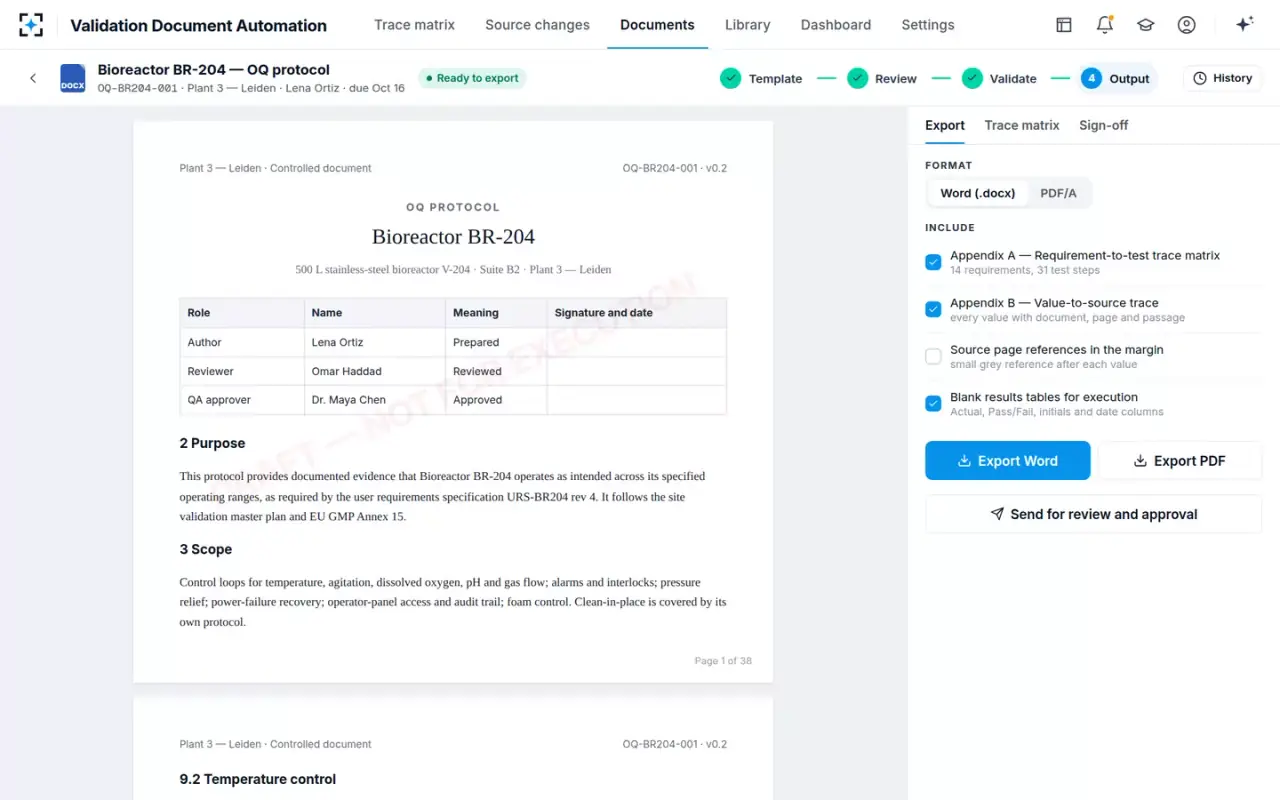

The controlled Word template, with both trace appendices
Document formatterThe engineer takes 60 % air saturation from the sister unit's alarm list, marked for the automation engineer to verify on the operator panel before test 9.1-04. The protocol is written into the Plant 3 controlled document template: 38 pages, with Appendix A, the trace matrix of 14 requirements and 31 test steps, and Appendix B, each value with its document, page and passage. Results tables are blank for execution, and each page is watermarked as a draft until QA signs.
- 10Signed
The reviewer signs, then QA approves for execution

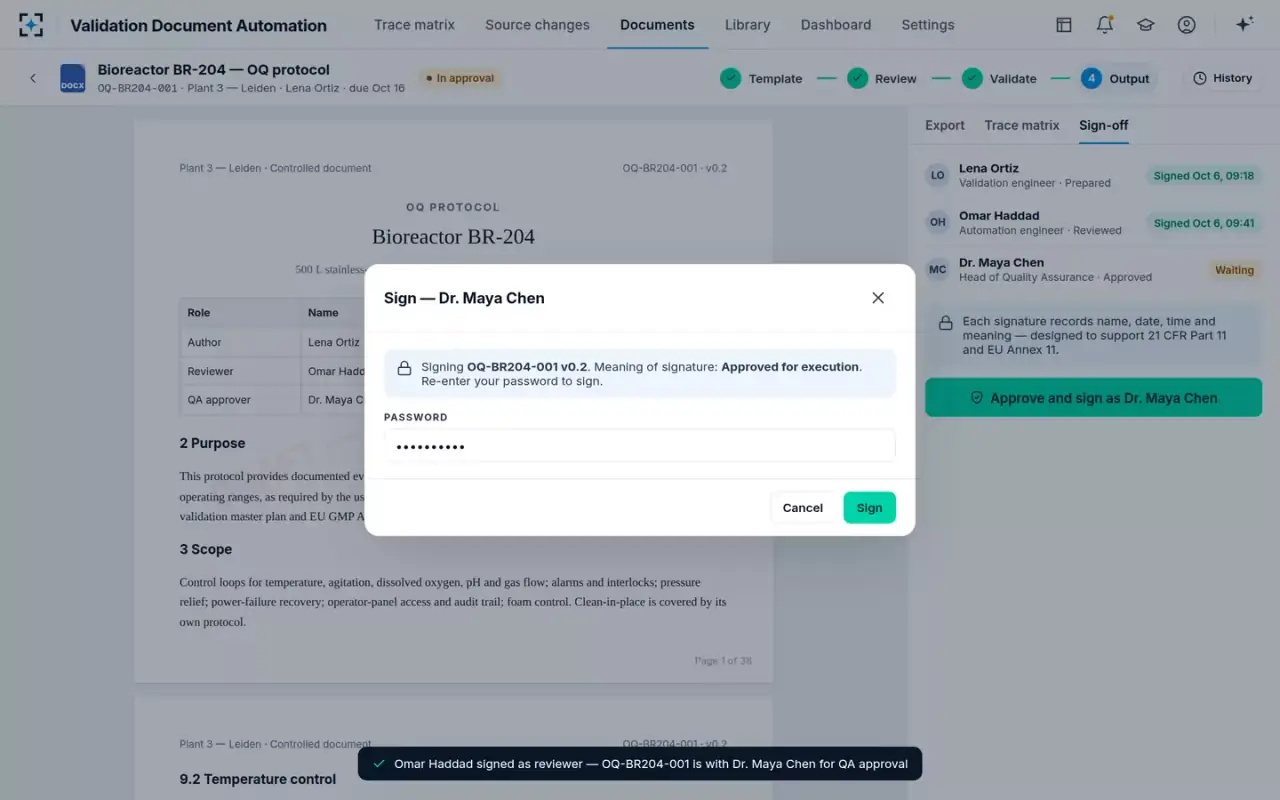

Automation engineer and head of QAThe engineer signs as author. The automation engineer signs next, with the meaning “Reviewed: test content and commissioning values checked”. The head of quality assurance re-enters the password to sign v0.2 with the meaning “Approved for execution”, and v1.0 is released.
“Each signature records name, date, time and meaning.”
