- Before
- Runs several live assessments and a queue of reassessments due within 90 days. Every supplier answers yes, and the job is finding out which yes is true.
- Now
- Opens each answer beside the page that backs or contradicts it. Accepts each verdict, or changes it with a reason, and sends the follow-ups the agents drafted.
An RTU order on hold until 142 supplier answers are checked
The utility is buying remote terminal units (RTUs) for several substations. It is a $3.84M purchase order, and the contract is due to be signed at the end of the week. The RTU supplier returned 142 answers and 14 documents. Here is what happens next, screen by screen, in the working solution.
A worked example on sample data. Names, IDs and figures on the screens and in this section come from the demo.
- 01Tuesday morning

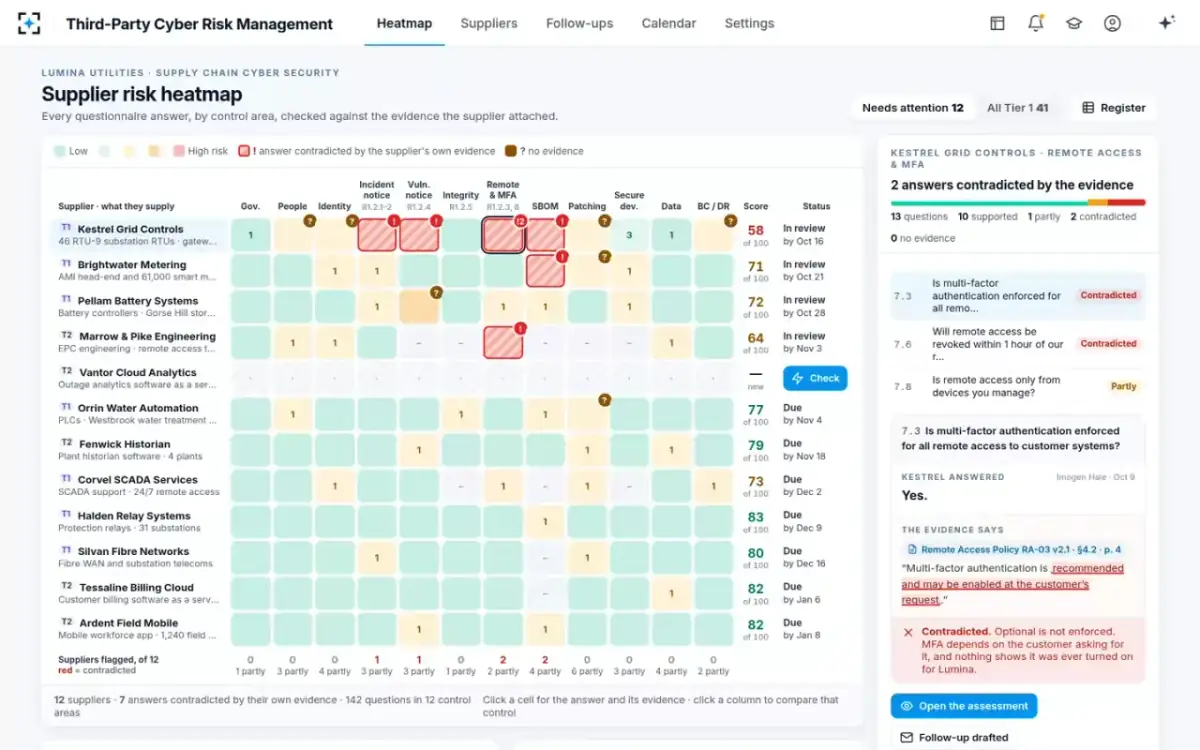

The heatmap opens on the answers that don't hold up
Supply chain security analystEach supplier that needs attention is a row. The 12 control areas are columns, with the CIP-013 R1.2 items under the headers that carry them. Today 12 suppliers need attention, and 7 answers are contradicted by the suppliers' own evidence. The RTU supplier scores 58 of 100. Its struck red cells are incident notice, vulnerability notice, remote access & MFA and the SBOM. The side rail shows its remote access: 13 questions, 10 supported, 1 partly, 2 contradicted.
“Contradicted. Optional is not enforced. MFA depends on the customer asking for it, and nothing shows it was ever turned on for this utility.”
- 0209:12

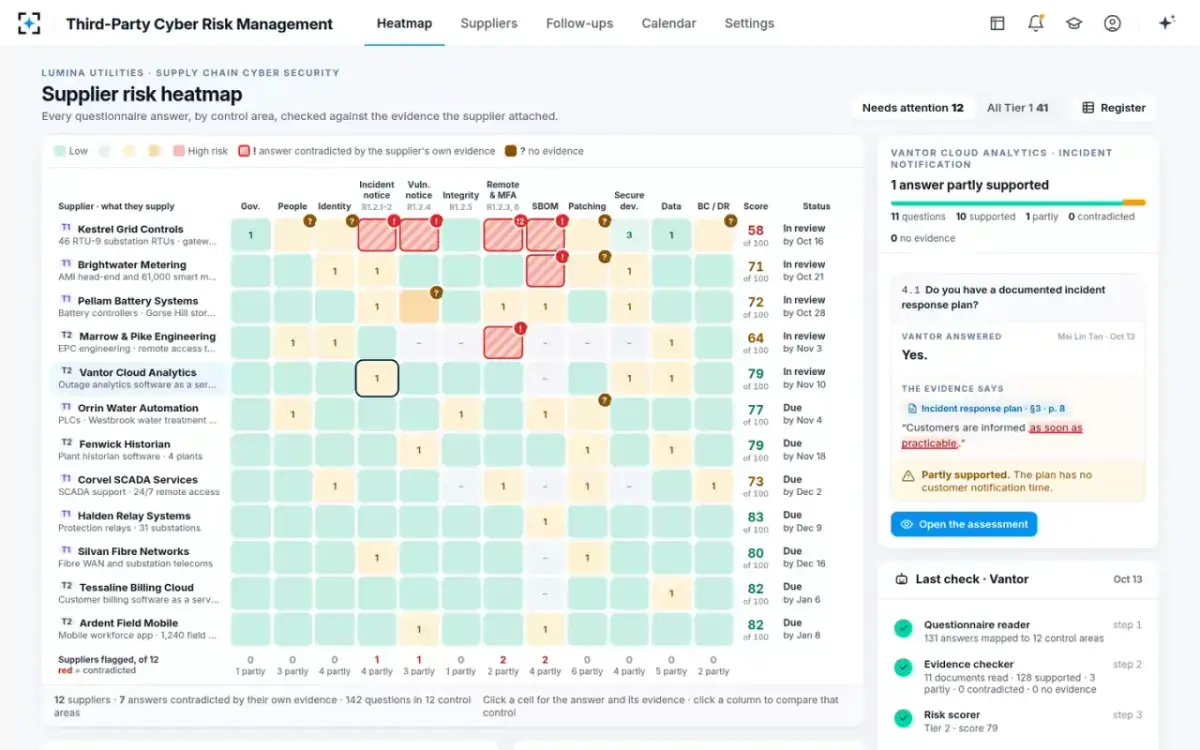

A new questionnaire, checked in one click
Questionnaire reader and Evidence checkerA supplier of hosted outage analytics returned its questionnaire this morning. It sent 131 answers and 11 documents, 204 pages in all. Its row stays grey until the analyst presses Check. The run log streams in the rail, and the row fills in cell by cell. The supplier is Tier 2, because it is hosted analytics with no access to OT, the control systems that run the utility's equipment. It scores 79. Its incident plan only partly supports answer 4.1.
“Customers are informed as soon as practicable.” Partly supported: the plan has no customer notification time.

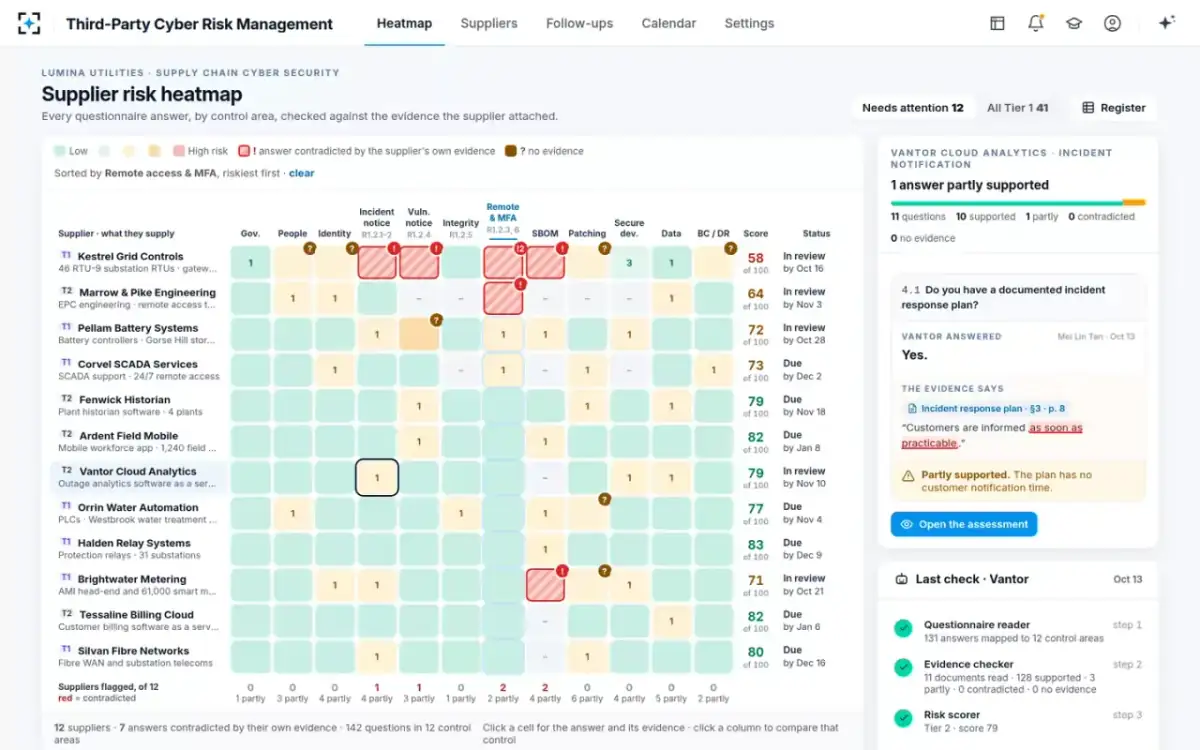

- 03One click
The whole portfolio, compared on remote access
Supply chain security analystThe analyst clicks the Remote access & MFA column, and the heatmap sorts by it, riskiest first. Two are contradicted, the RTU supplier and an engineering firm. That firm answers MFA on all remote access, but its procedure gives each site team one shared token. A SCADA services firm and a battery systems supplier are partly supported. They use MFA only from outside their support jump host, the server support staff log in through.
A metering supplier's reply this week fixed its own gap, and its Remote access cell turned from amber to green.
- 04Checked in 11 minutes

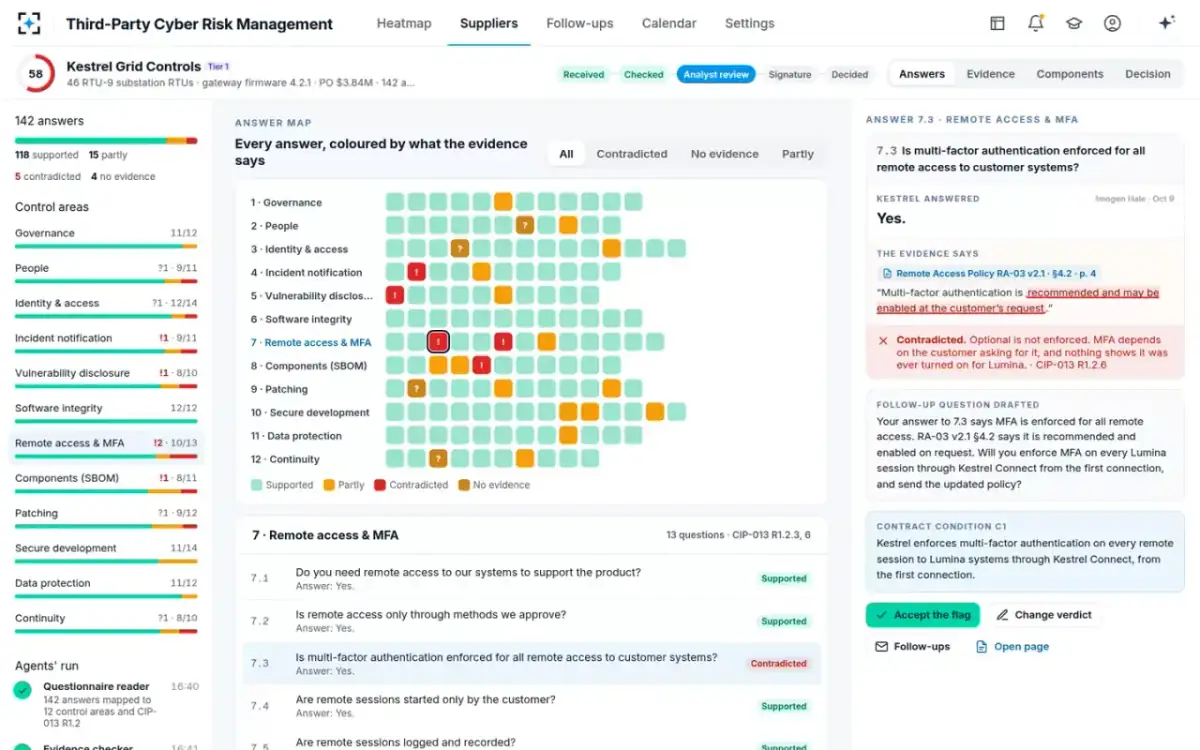

142 answers, each tested against a quoted page

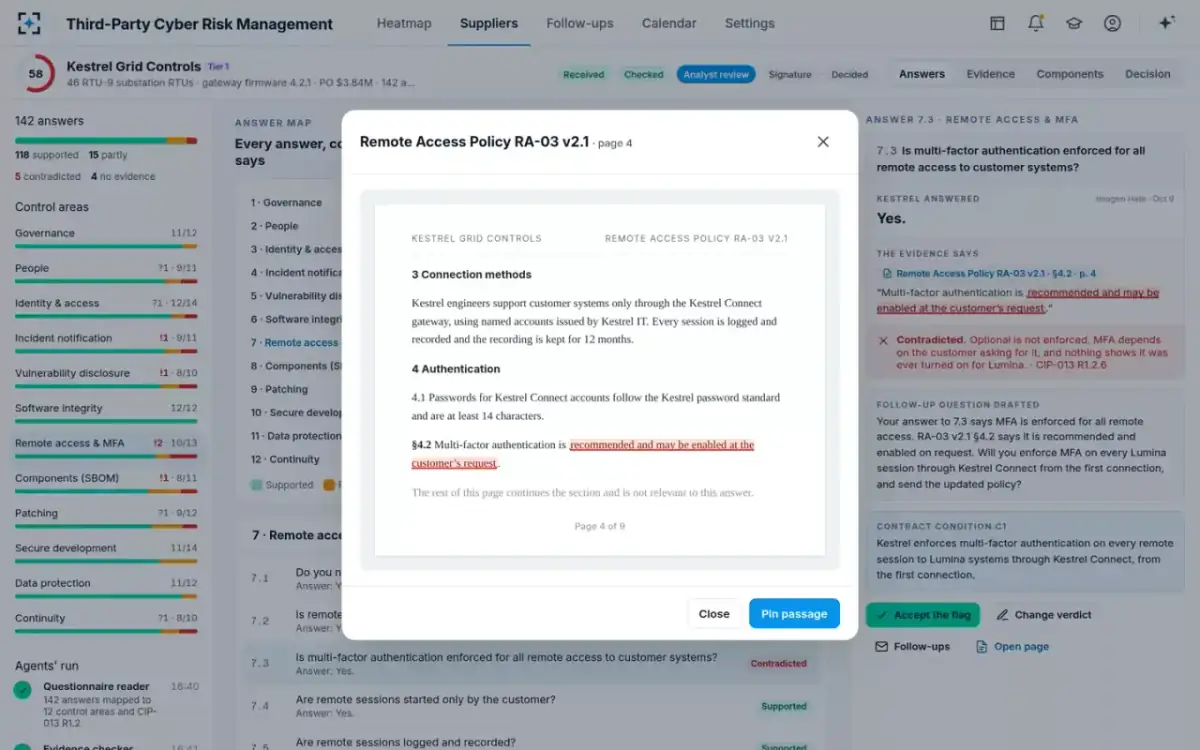

Evidence checkerThe agents read the supplier's 142 answers against 286 pages, from 16:40 to 16:51. The answer map shows each answer by control area. Of the 142, 118 are supported, 15 partly, 5 contradicted and 4 have no evidence. Answer 7.3 asks whether MFA is enforced for all remote access to customer systems. The supplier answered “Yes.” But section 4.2 on page 4 of its remote access policy says otherwise, and the passage opens on the page itself.
Remote access policy, §4.2: “Multi-factor authentication is recommended and may be enabled at the customer's request.”

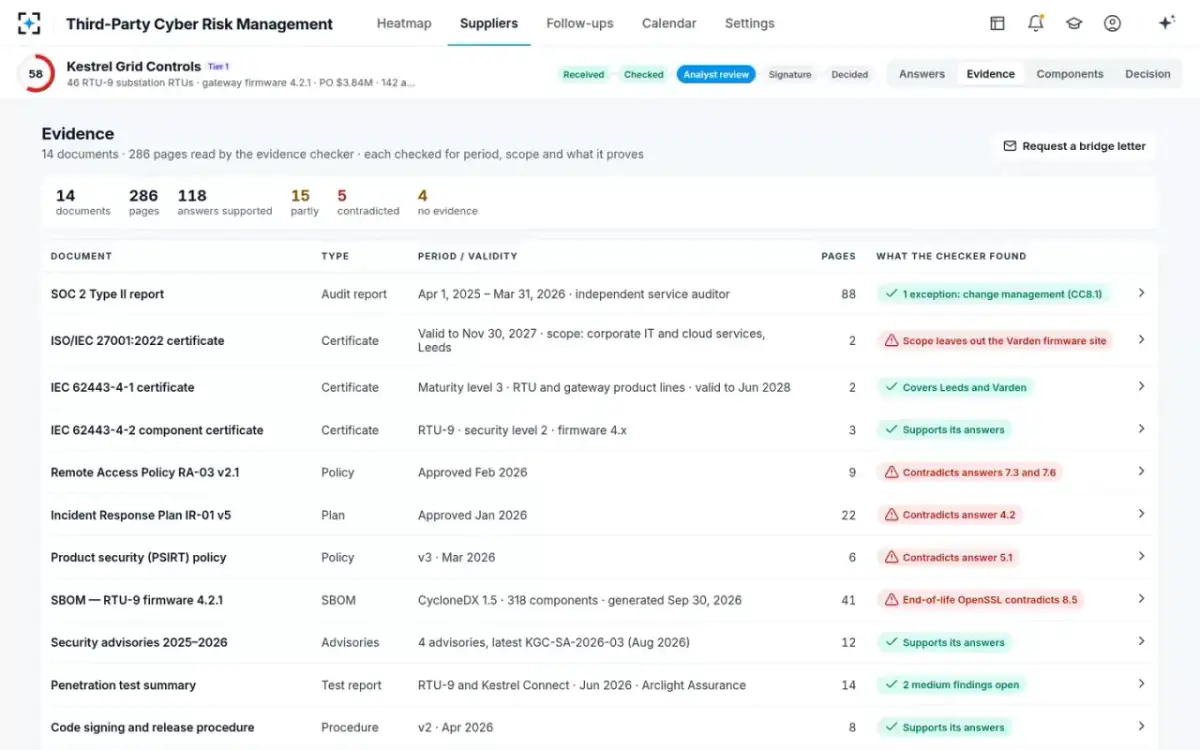

- 05The evidence
Fourteen documents, each checked for period and scope
Evidence checkerThe SOC 2 Type II report covers a 12-month period, with one exception in change management (CC8.1). The ISO/IEC 27001:2022 certificate covers corporate IT and cloud services, and leaves out the firmware site. Answer 4.2 is contradicted by the incident response plan. The plan says 72 hours from confirmation, where the answer said 24. The PSIRT policy, on how the supplier handles security flaws, contradicts 5.1. The policy allows 90 days for coordinated disclosure, where the answer said 30.
“A certificate counts only for sites and products inside its scope.” The utility's evidence rule

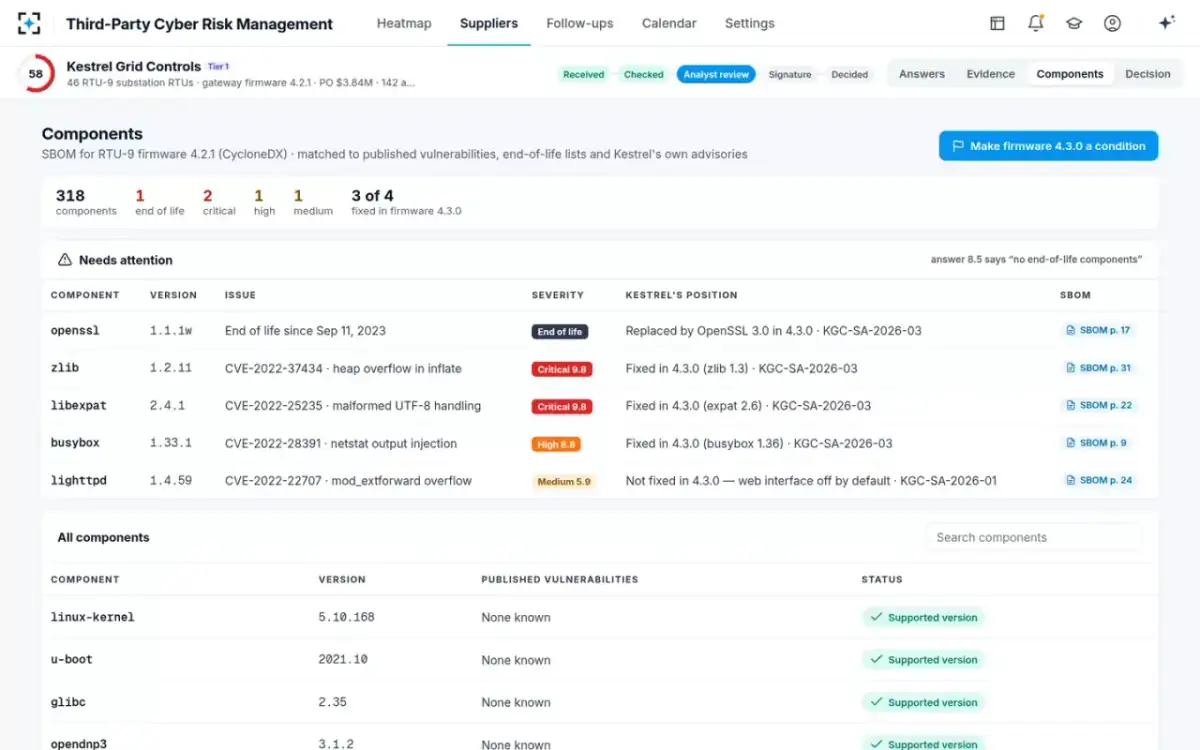

- 06The SBOM
An end-of-life library under an answer that says none
Component scannerThe SBOM for RTU firmware 4.2.1 lists 318 components. OpenSSL 1.1.1w has been end of life since Sep 11, 2023. So answer 8.5, “no end-of-life components”, is contradicted. Four more components carry published vulnerabilities. They are zlib 1.2.11 and libexpat 2.4.1 (critical, 9.8), BusyBox 1.33.1 (high, 8.8) and lighttpd 1.4.59 (medium, 5.9). The supplier's own advisory says firmware 4.3.0 fixes three of the four and replaces OpenSSL with 3.0.
lighttpd: “Not fixed in 4.3.0. The web interface ships turned off.”
- 07Follow-ups

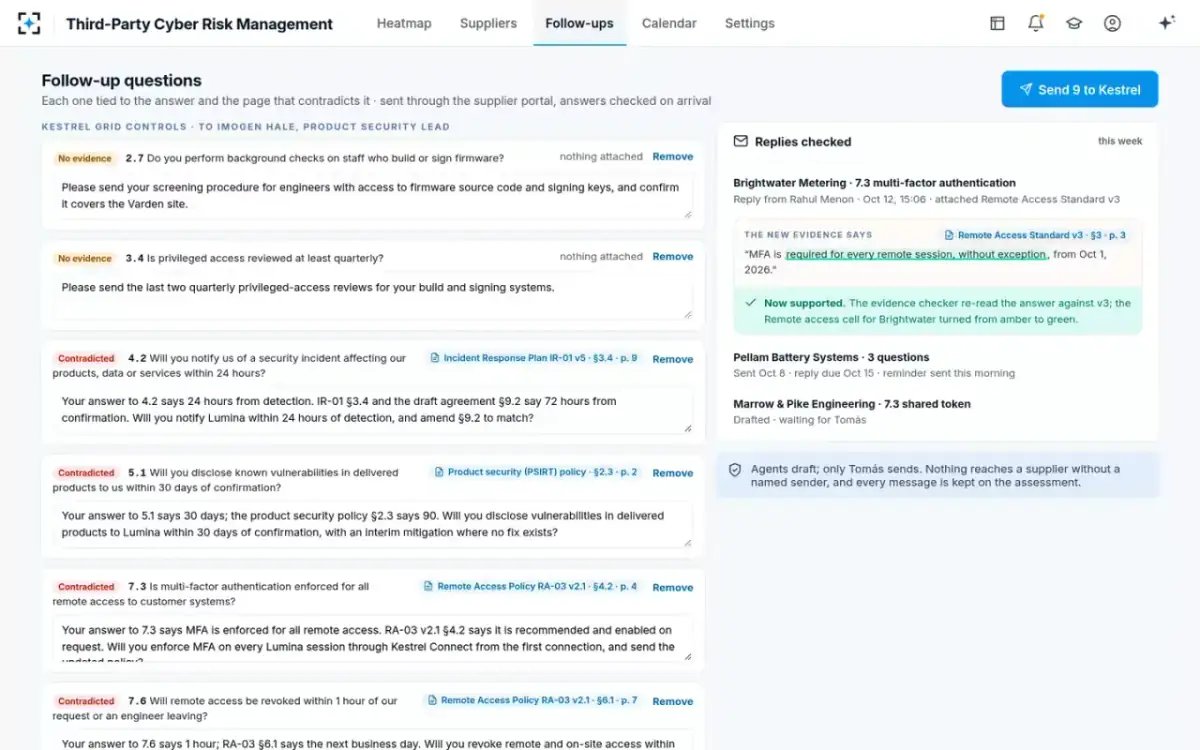

Nine precise questions, each tied to its answer
Follow-up writerThe follow-up writer drafts 9 questions for the supplier's product security lead. Four ask for proof that was never attached. They cover background checks for firmware engineers and quarterly reviews of privileged access. They also cover patch testing on a testbed like the customer's, and a yearly continuity test. The other five quote the answer and the page that contradicts it. The analyst edits, removes or sends them through the supplier portal. Replies are checked when they arrive.
“Agents draft, and only the analyst sends. Nothing reaches a supplier without a named sender, and each message is kept on the assessment.”

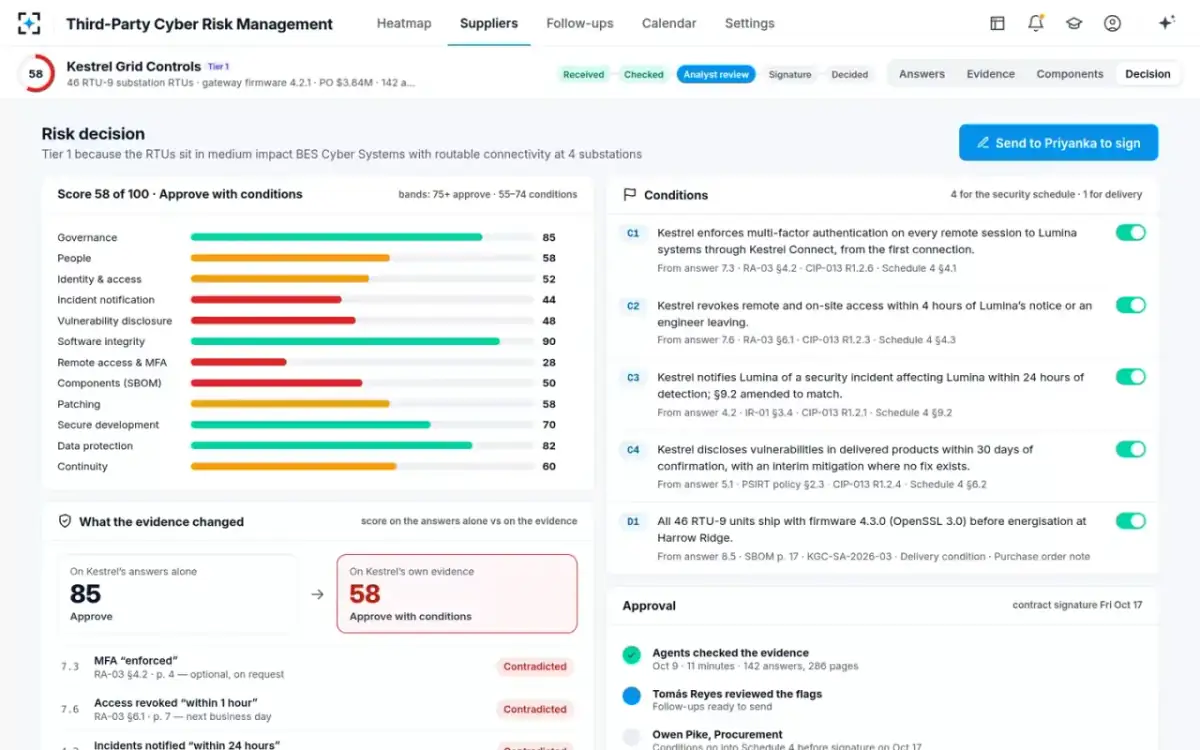

- 08The decision
85 on its answers, 58 on its evidence
Risk scorer and Follow-up writerThe supplier is Tier 1, because the RTUs sit in medium impact BES Cyber Systems with routable connectivity at the substations. BES is the bulk electric system, the high-voltage grid. Remote access & MFA scores 28, incident notification 44 and vulnerability disclosure 48. Four conditions go into Schedule 4 of the agreement, each mapped to CIP-013. They require MFA on each session through the supplier's remote-access service (R1.2.6) and access revoked within 4 hours (R1.2.3). They also require incident notice within 24 hours of detection (R1.2.1) and disclosure within 30 days (R1.2.4). A delivery condition adds firmware 4.3.0 before energization at the first substation.
Risk scorer: never sets a tier below the tier rule, and never approves.
- 09Before the contract date

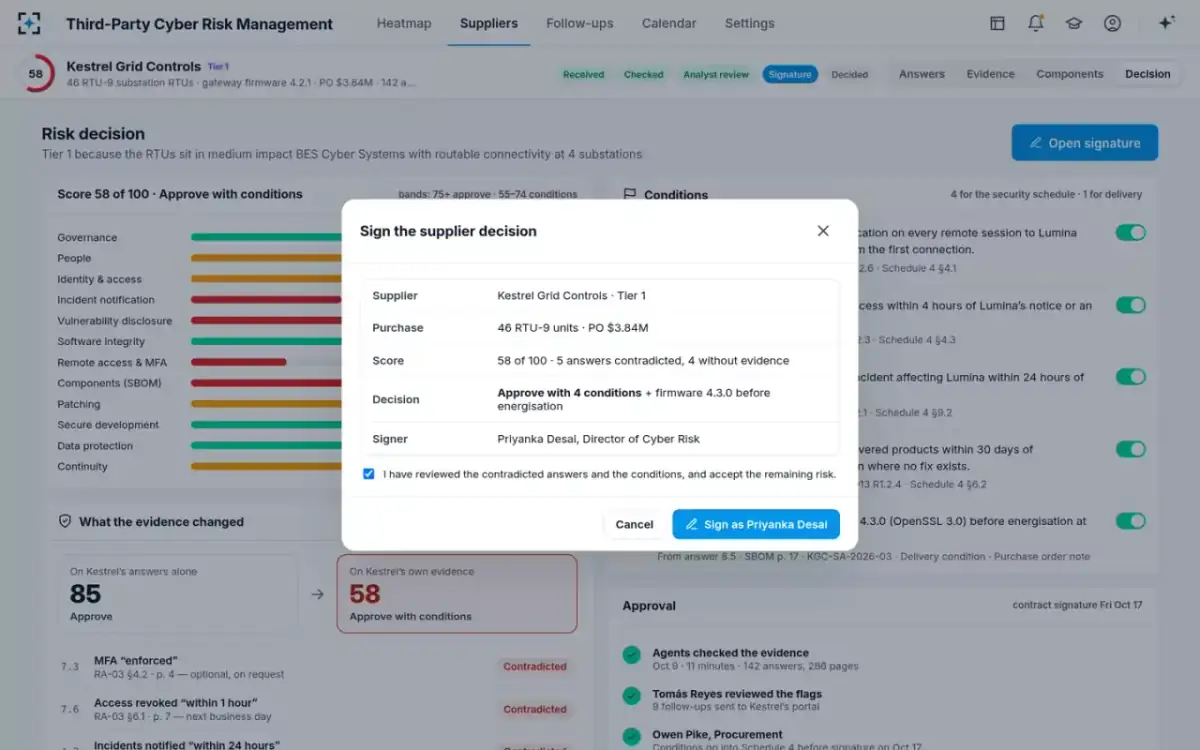

The director signs what is being accepted
Director of Cyber RiskThe analyst has accepted the five contradicted answers and sent the decision on. The director sees the supplier, the purchase and the score, with its 5 contradicted answers and 4 without evidence. The proposed decision is to approve with 4 conditions, plus firmware 4.3.0 before energization. The director confirms the statement and signs in their own name.
“I have reviewed the contradicted answers and the conditions, and accept the remaining risk.”

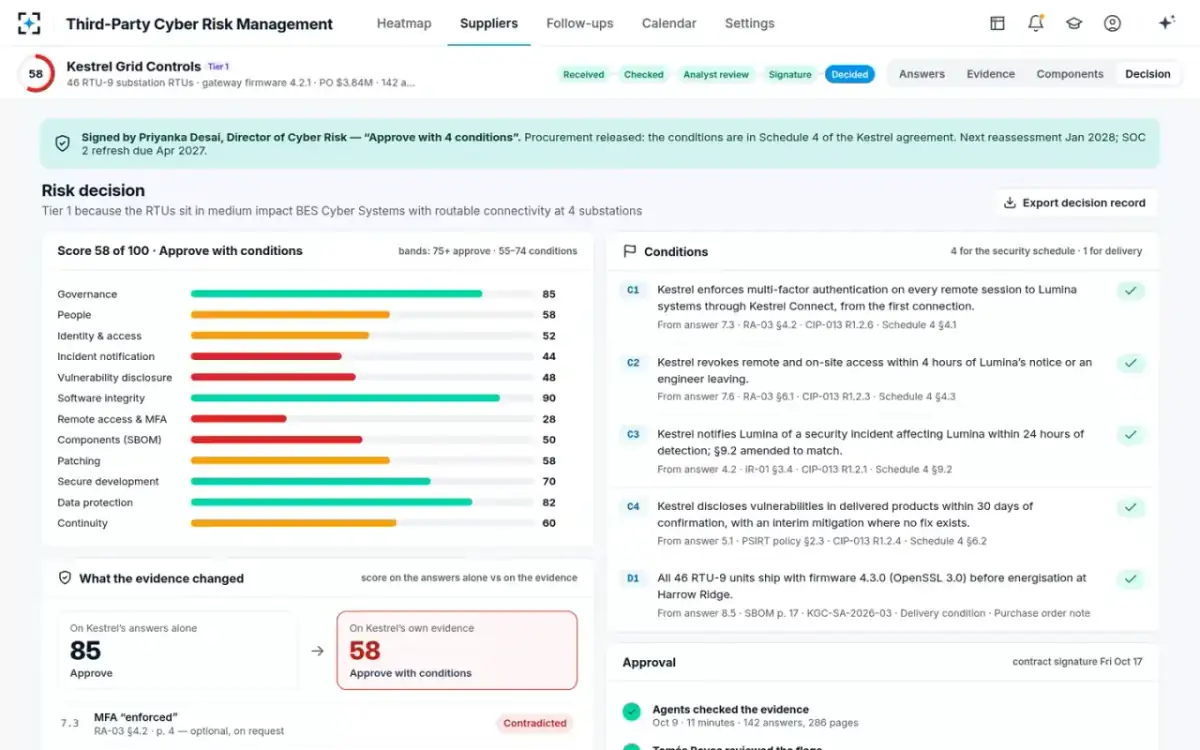

- 10Signed, ahead of the contract
The order goes out with the conditions in the contract

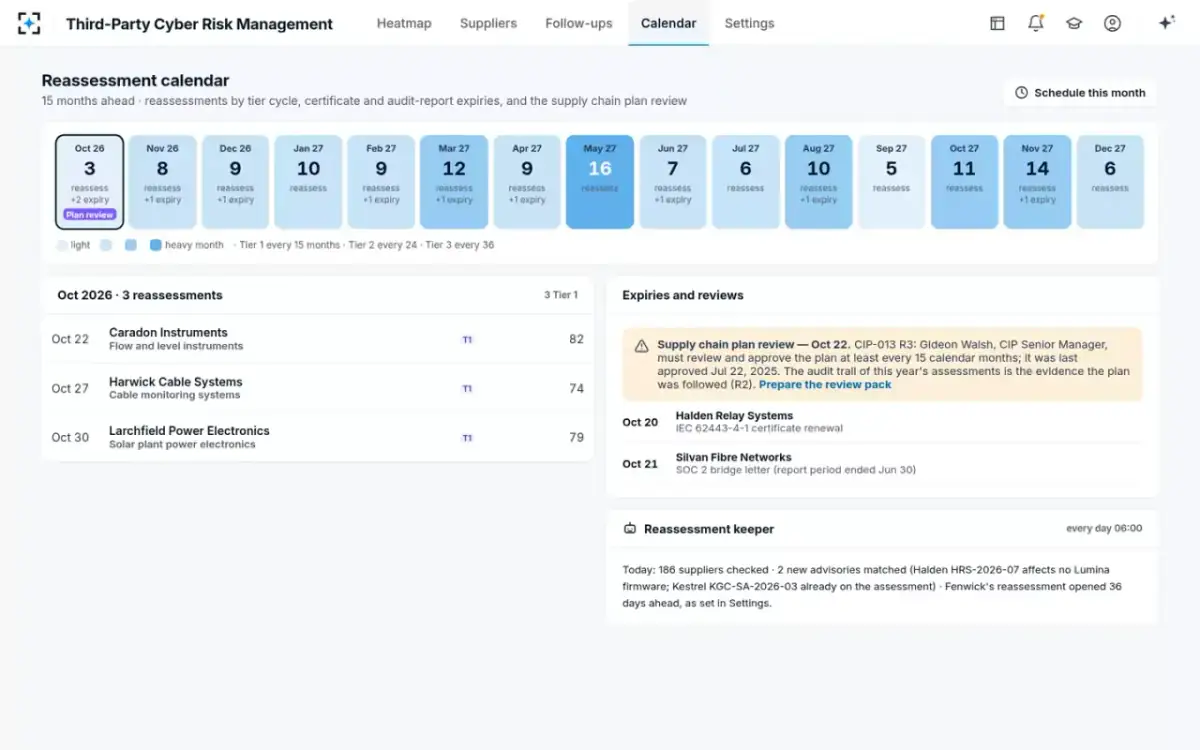

Procurement category managerProcurement is released once the decision is signed. The conditions are already in Schedule 4 of the supply agreement, ahead of signature. Next, the reassessment keeper puts the next reassessment and the SOC 2 refresh on the calendar. The decision record exports with each citation.
“Signed by the Director of Cyber Risk: Approve with 4 conditions. Procurement released.”
