WorkflowIT/OT Security & Compliance

OT Patch Management

OT patch management that runs both 35-day clocks on each patch. Each evaluation is signed in time, and a dated mitigation plan is ready when an install has to wait

See one case, screen by screen ↓
Watch with transcript →

Built forOT security engineersSubstation techniciansCompliance analystsControl-systems engineers

The Problem Today

Utility engineers check many patch sources by hand, each on its own clock, and mitigation plans get written in the last two days.

$220K
settlement for three evaluations done at day 37 instead of 35 published

Four places, checked by hand

  • Portals
  • Email lists
  • Inventory
  • Outages
  • One sentence decides itHidden in a release note behind a supplier login
  • Models with no sourceAdded to the inventory and missed until the audit

The Solution

  1. Notices found each morningPortals, email lists and advisory feeds are read, and release notes downloaded
  2. Matched to each assetBy model, hardware revision and firmware, citing the sentence that decides it
  3. Fitted to the next outageEach install goes in an outage before its deadline, and misses are flagged
  4. The engineer signsThe evaluation and any plan are signed together, and the action clock starts

Built-in controls

  • Each decision cites the supplier's sentence
  • Agents do not touch a device or an outage
  • Dates logged as they happen, with no backdating

What You Get

Compensating controls are planned on the day a patch is evaluated, rather than in the days before the deadline.

  • Warned before the deadlineThe owner is reminded, then escalated, while days remain
  • Unwatched models found earlyUpdateable models with no patch source are flagged daily
  • Plans drafted from templatesSupplier workarounds go in first, with owners and dates filled in
In short

What is OT Patch Management?

OT patch management software tracks each security patch for your control-system assets. These include RTUs, relays, switches, firewalls, DCS, EMS and historians. It follows each patch from the supplier's notice to an install or a dated mitigation plan. OT Patch Management adds six agents. They watch the sources, match each notice to the inventory, draft the decision and any plan, and run the clocks. The OT engineer signs.

How to choose AI solutions for utilities →

Updated

The problem

No one place watches all the patch sources and their 35-day deadlines

Power utilities must keep track of security patches for their Cyber Assets. These are the computers and devices that run the grid. A NERC rule, CIP-007-6 R2, puts two clocks on each patch. First, each source that publishes patches for those assets must be checked at least once every 35 calendar days. Then, within 35 days of that check, each patch that applies must be installed, or a dated mitigation plan written instead. That plan sets out what will protect the device until the install. A utility with substations, a power station and control centers gets notices from many suppliers. They arrive by customer portal, email list, release page and PDF. Each source's cycle started on a different day. Often the only control is a reminder in one engineer's calendar.

Each notice takes work to read. The answer to “does this apply to us?” is usually one sentence in a release note behind a supplier login. It depends on the model, the hardware revision and the firmware branch. Installing is hard too. RTUs link substations to the control room, and a DCS runs a power plant. Both can only be patched in planned outages. When the next outage falls after the deadline, a mitigation plan is owed. It is usually written in the last two days. A model added to the inventory without a tracked source is not evaluated at all. Nobody finds out until the audit. From day 36, lateness is a violation, whatever the reason.

typical$1.58Mthe most a utility can be fined per violation per day under the Federal Power Act ($1,584,648, FERC 2025)
typical$220Ksettlement for three patch evaluations finished at day 37 instead of 35 (SERC, NP18-25-000)
estimated508ICS advisoriespublished in 2025, covering 2,155 CVEs (known security flaws), about 20% more than in 2024 (Forescout)
Where an engineer's hours go in one patch cycleestimated
By hand40 hours
With the solution6 hours
  • Checking 23 supplier portals, email lists and feeds12 → 1 h
  • Reading notices and release notes8 → 1.5 h
  • Matching models, hardware revisions and firmware to the inventory8 → 0.5 h
  • Writing the applicability decision for each asset5 → 1.5 h
  • Fitting installs to outages and writing mitigation plans5 → 1 h
  • Logging dates and collecting evidence2 → 0.5 h

Estimated split of one cycle across 23 sources, in engineer-hours. By hand it takes about 40 hours, the sample utility's own baseline. With the solution, the target is 6 hours.

How it works

From supplier notice to a signed patch decision on two 35-day clocks

What comes in
Patch notices ineach patch source · supplier portals, lists and advisories, plus inventory and outages
Agents at work
Source watcherevery morning
Then
Inventory matchermodel + firmware
Then
Applicability assessorcited per asset
Then
Outage fitter
Mitigation plan drafterfrom the template
Then
Clock keeperday 25, day 31
A person decides
OT security engineersigns, and the delegate approves extensions
What comes out
Decision per asset
Dated mitigation plan
Evidence for audit
One case, step by step

An RTU security notice at day 31, evaluated and planned the same morning

A large utility runs Cyber Assets at substations, a power station, control centers and a water works. Three weeks ago, the RTU supplier posted a security notice on its customer portal. The utility last evaluated that source ten days before that. Here is day 31 of the cycle, screen by screen, in the working solution.

A worked example on sample data. Names, IDs and figures on the screens and in this section come from the demo.

  1. 01Morning

    The queue is a 35-day dial with a bead for each patch

    OT security engineer

    The engineer owns the patch evaluations for the substations and the power station. The home screen is a 35-day dial with a bead for each of the 47 open patches. The inner ring counts the days to evaluate. The outer ring counts the days to install or plan. Days 25 to 30 are amber and days 31 to 35 are red. The severity bands past day 35 are printed under the dial. Below it, a tile for each of the 23 sources shows where its cycle stands.

    “47 patches open · 19 to evaluate · 28 to install or plan · 12 plans running · 0 late this year”

  2. 0206:00 sweep

    The RTU notice reaches day 31 and turns red

    Clock keeper

    The Source watcher found the notice the day it was posted. The Inventory matcher matched 14 RTUs of the affected model. At day 25 the Clock keeper reminded the engineer and the compliance analyst, but there was still no evaluation. At this morning's sweep the hand moves from day 30 to 31. The bead for RTU firmware 4.2.9 turns red. The patch fixes an authentication bypass, a flaw that lets someone skip the login, in the RTU's web configuration screen. It is rated 8.8 on the CVSS severity scale. Four days are left to evaluate.

    “06:00 · the RTU notice reached day 31 with no evaluation: escalated to the OT security engineer and the compliance analyst”

  3. 03One click

    One click on Evaluate now, and the agents draft the whole evaluation

    Source watcher · Inventory matcher · Applicability assessor

    The engineer clicks Evaluate now. The Source watcher reads the 4-page notice signed by the supplier's PSIRT, its product security team. The Inventory matcher lists 14 RTUs of that model across several sites. The Applicability assessor finds 11 affected and 3 not applicable, at 0.96 confidence. The Outage fitter places 7 installs before the action deadline, in outages at three substations. It flags that a fourth substation's next window is 7 days too late.

    “Outage fitter · one substation misses the deadline: next window is the T2 maintenance, 7 days late”

  4. 04The notice

    Each decision rests on a sentence of the supplier's notice

    Applicability assessor

    The patch file shows the supplier's notice. The sentences that decide applicability are marked and numbered, with margin notes beside them. Firmware 4.2.7 and 4.2.8 fall inside the affected range. Two RTUs at another substation and one at the power station run 4.3.0, installed earlier. The note on the fix adds the utility's own operating rule. Losing the RTU's readings at a high-voltage substation needs a planned outage.

    Affected: “Remote Terminal Unit, all hardware revisions, firmware 4.0.0 through 4.2.8.” Not affected: “The issue is resolved in firmware 4.3.0 and later.”

  5. 05Per asset

    Fourteen RTUs, fourteen decisions, each with its reason

    OT security engineer

    The decision table lists each RTU by tag, bay and firmware. Each row shows applicable or not applicable, the reason with its citation, the action and the date. The four RTUs that miss their window go into a mitigation plan, with the install in the T2 maintenance. The other seven are installed at three substations. They go in a bay outage, in feeder maintenance and in planned maintenance. The engineer can change any decision before signing.

    “14 RTUs · 11 applicable · 3 not applicable · drafted · you sign”

  6. 06The outage plan

    Each install placed in the next outage that beats its deadline

    Outage fitter

    Outage fit lays the next 60 days of planned outages at each site against each patch's deadline. Of 15 install groups, 13 fit and are booked into outages before their deadlines. Two miss. The four late RTUs need Bays 1, 2, 5 and 6 out, and the next outage that does that is the T2 transformer maintenance. At the power station, a plant DCS patch misses too, because the Unit 2 outage moved two weeks later.

    “Install or plan by the action deadline; the next window covering Bays 1, 2, 5 and 6 is the T2 maintenance, 7 days after it.”

  7. 0706:03

    The plan template opens already filled in

    Mitigation plan drafter

    The plan is drafted from the RTU template, with controls taken from the supplier's own workarounds. First, turn off the RTU web configuration screen from the substation's engineering workstation within two days. That needs no outage and can be undone, and the substation technician owns it. Second, block TCP 443 to the four RTUs at the substation firewall, owned by the OT security engineer. Third, alert on any connection attempt, owned by security operations. Last, install 4.2.9 in the T2 maintenance.

    “46 days · inside the 60-day limit, so no delegate approval needed”

  8. 0809:41 · day 0

    Signed on day 0 of the action clock

    OT security engineer

    The engineer signs the evaluation and the plan together. The red bead leaves the inner ring and starts again on the outer ring at day 0, with 35 days left to install or plan. The Clock keeper logs the evaluation date and starts the action clock. Each affected RTU is now booked into an outage or covered by a dated plan.

    “Signed on day 0 of the action clock · all 35 days to spare · plan complete in 46 days”

  9. 0910:05

    The plan on record, with its evidence list and approvals

    CIP compliance analyst

    The full plan shows the security patch and why it cannot be installed in time. It lists the four assets, the timeframe and the four actions with owners and dates. The evidence to collect is a configuration export showing the HTTPS server off, the firewall rule export and the monitoring rule ID. It also includes an install record with the firmware version for each RTU. The compliance analyst reviews it at 10:05. The CIP Senior Manager's delegate is needed only for a revision or an extension.

    “The Clock keeper asks for each on its date.”

  10. 10The same morning

    Six GPS clocks with no patch source, found before the audit

    Inventory matcher

    The sweep also compares the inventory's 41 models with the source list. Six GPS clocks at one substation were added by a time-sync upgrade work order. They run updateable firmware 1.4.2 but have no tracked source. The engineer adds the clock maker as a source. Its clock starts, with the first evaluation due on the same action deadline.

    “They are updateable (firmware 1.4.2), so CIP-007-6 R2.1 needs a source. Without one, no evaluation clock starts.”

Who it’s for

Engineers, technicians and the compliance analyst who carry each patch

The same patch seen by five people: their cycle by hand, then with the agents.

OT security engineer
Signs evaluations and plans
Before
Starts with the clocks, checking which patches are near day 35 and which installs missed their outage. Thirty-five days sounds like a lot until a vendor hides the notice in a portal PDF.
Now
Opens a dial where the red sector shows the work. Finds the evaluation and any plan already drafted, with the notice sentence behind each decision, and signs.
Substation technician
Installs firmware in planned outages
Before
Installs firmware during planned outages and records the version. Needs to know which RTU, which version and which outage.
Now
Gets each RTU by tag and bay, with its firmware, the action and the date. Also gets the plan controls they own, such as turning off the late RTUs' web interface within two days.
CIP compliance analyst
Keeps the evidence and answers the auditor
Before
Keeps the evidence for each cycle and each plan. Needs the date each evaluation actually finished, instead of the date someone remembered it.
Now
Sees 759 evaluation cycles by source with their finishing day, and today's records hashed as they are logged. CIP-007-6 R2 is laid out part by part, ready to export for audit.
CIP senior manager's delegate
Approves plan revisions and extensions
Before
Approves plan revisions and extensions. Must sign an extension before the plan's date runs out, never after.
Now
Sees each running plan with its timeframe. Also sees an extension request, raised after the power station's Unit 2 outage moved two weeks later, with its reason and new date.
Control-systems engineer
Owns the DCS and historian patches
Before
Patches the DCS and historian during unit outages, so anything due before the next unit outage needs a plan.
Now
Sees at once that a plant DCS patch's 11 operator stations miss their deadline. Gets a plan drafted from the plant DCS template.
The agents

What each patch agent drafts, and what only an engineer signs

Six agents do the legwork from supplier notice to drafted plan. The OT engineer signs each evaluation and plan.

Source watcher

Checks the 23 patch sources each morning. These are supplier portals, email lists, release pages and the government ICS advisory feed. Downloads each notice and its release notes, and records when and where it was published.

  • Read-only on each source, with a service account, never a person's credentials
  • Never marks a patch evaluated
Inventory matcher

Matches each release to asset models, hardware revisions and firmware branches in the inventory. Each morning it flags any updateable model with no patch source.

  • Never edits the inventory
  • A model without a source goes to the OT security engineer
Applicability assessor

Reads the notice's affected and not-affected sections, fixed versions and workarounds. Drafts applicable or not applicable for each matched asset, citing the sentence and the inventory record behind it.

  • Each decision cites its sentence
  • Below 0.80 confidence, the engineer decides
  • Never closes an evaluation. The OT engineer signs
Outage fitter

Places each install in the next planned outage or maintenance window that covers its bay and beats the action deadline. Says which cannot make it, and checks again when the outage plan changes.

  • Never books or moves an outage
Mitigation plan drafter

Fills the plan template for the asset type, putting the supplier's workarounds first among the controls. It adds owners, dates, a timeframe that ends after the planned install, and the evidence to collect.

  • Never approves a plan
  • A plan over 60 days, a revision or an extension goes to the CIP Senior Manager's delegate
Clock keeper

Runs both 35-day clocks for each patch, and each plan's timeframe. Reminds the owner and the compliance analyst at day 25 and escalates at day 31. Logs each evaluation, install and plan date as evidence.

  • Never extends a deadline
  • Never backdates a record
OT security engineer

Signs evaluations and plans.

Ask in plain words

Ask which patch could miss day 35, with answers cited to the notice and inventory

Ask in plain words, or say what to draft. Each answer points to the notice, the inventory or the outage plan behind it. These answers use the sample data.

Which patches could miss day 35 this week?

One is in the red sector. It is the RTU firmware notice, at day 31 with no evaluation and due in four days. Three vendor rollups are at day 28, drafted and waiting for an engineer's signature. On the action clock, a relay patch is at day 30. Its last 7 relays go in Thursday's Unit 1 outage, before its deadline.

Why are three of the RTUs not applicable?

The notice says “the issue is resolved in firmware 4.3.0 and later”. The inventory shows two RTUs at one substation and the power station's RTU on 4.3.0. The other 11 are on 4.2.7 or 4.2.8, inside “4.0.0 through 4.2.8”.

Which asset models have no patch source?

One: the GPS clocks, 6 at one substation, added with the time-sync upgrade. They are updateable, so CIP-007-6 R2.1 needs a source for them. The other 40 models are covered by 23 sources.

Draft the plan for the four late RTUs

The plan is drafted from the RTU template. It turns off the web interface and blocks TCP 443 at the substation firewall. Both are the supplier's own workarounds. Any attempt raises an alert, and 4.2.9 goes in during the T2 maintenance. The timeframe is 46 days, inside the 60-day limit. It's open for you to sign.

The screens

The 35-day patch dial, the cited notice and the mitigation plan

From the working solution, on its sample data. Pick one to see it large.

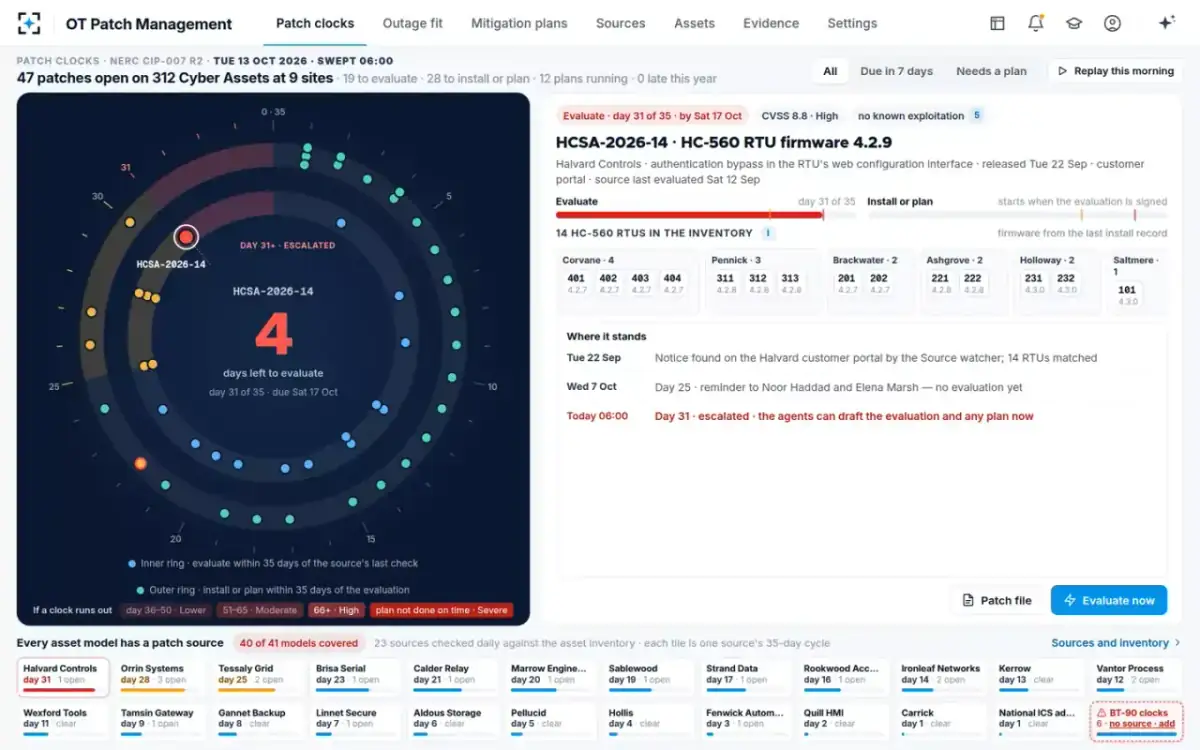

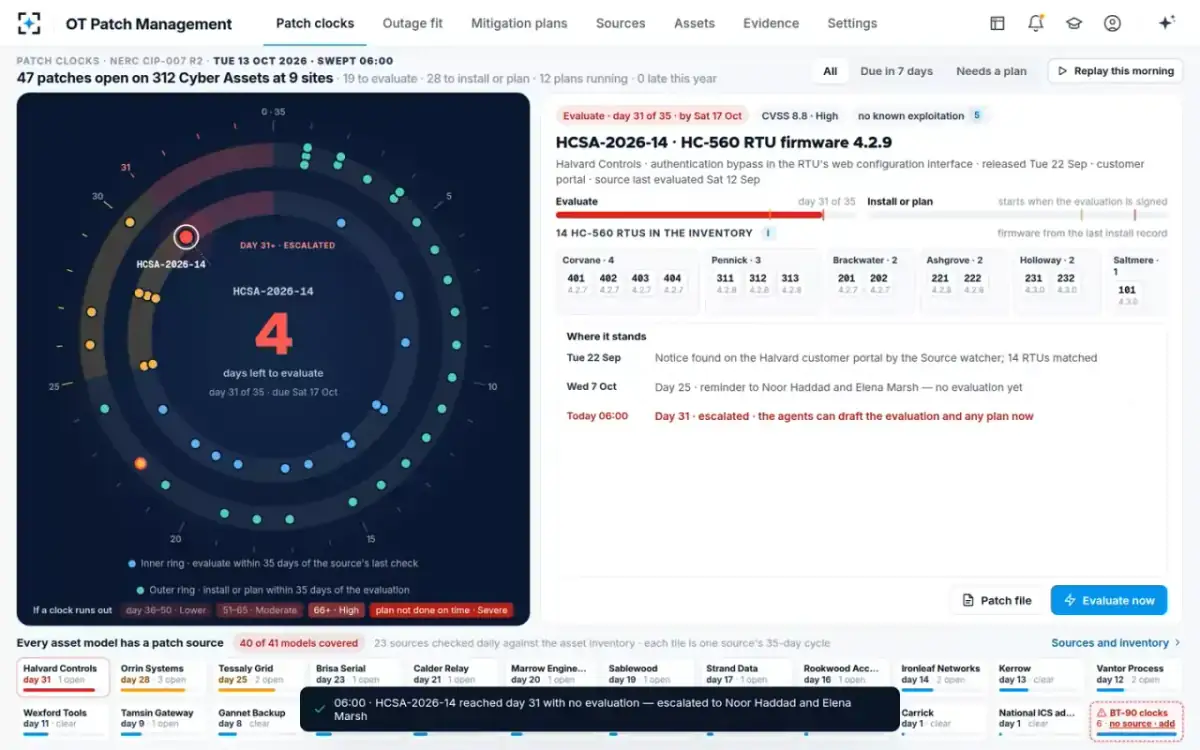

The patch clockAll open patches on a 35-day dial. The inner ring is to evaluate and the outer ring to install or plan. The selected patch shows its assets site by site, with each source's cycle below.
The 06:00 sweepThe hand moves to day 31, the RTU notice turns red, and it is escalated to the engineer and the compliance analyst.

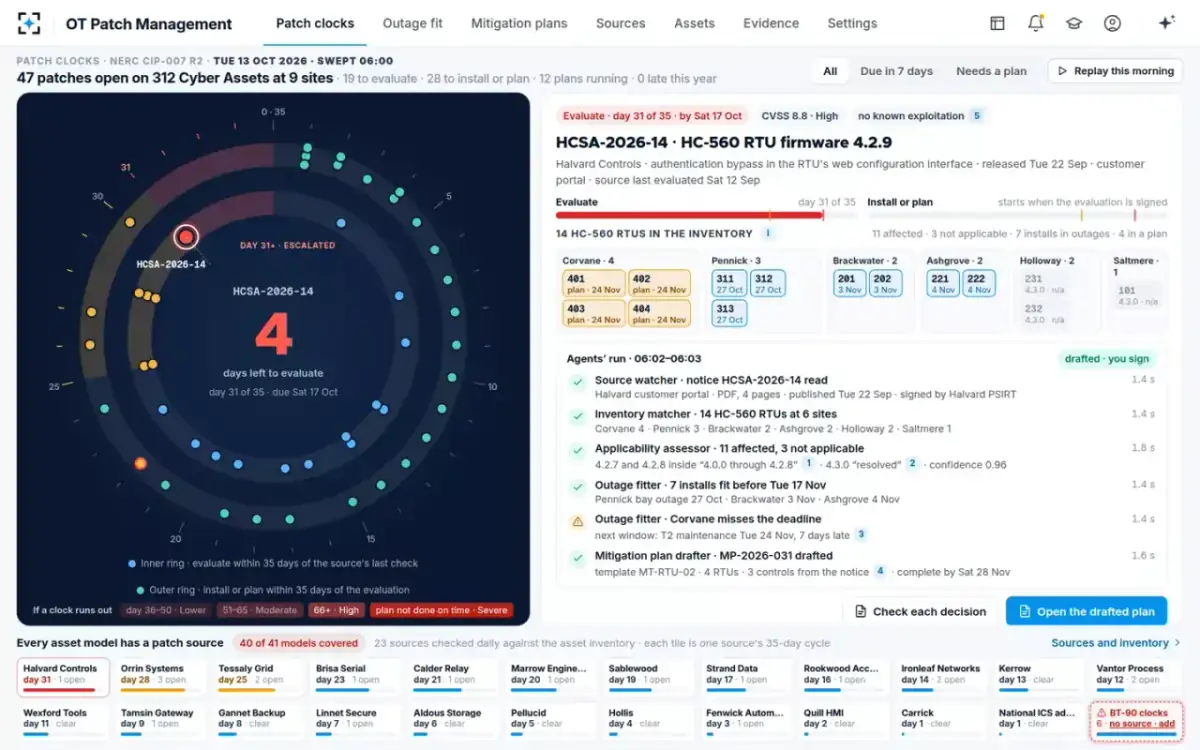

The agents' runThe notice is read and 14 RTUs matched, with 11 affected and 3 not applicable. In all, 7 installs are fitted to outages, and the four late RTUs are flagged for a plan.

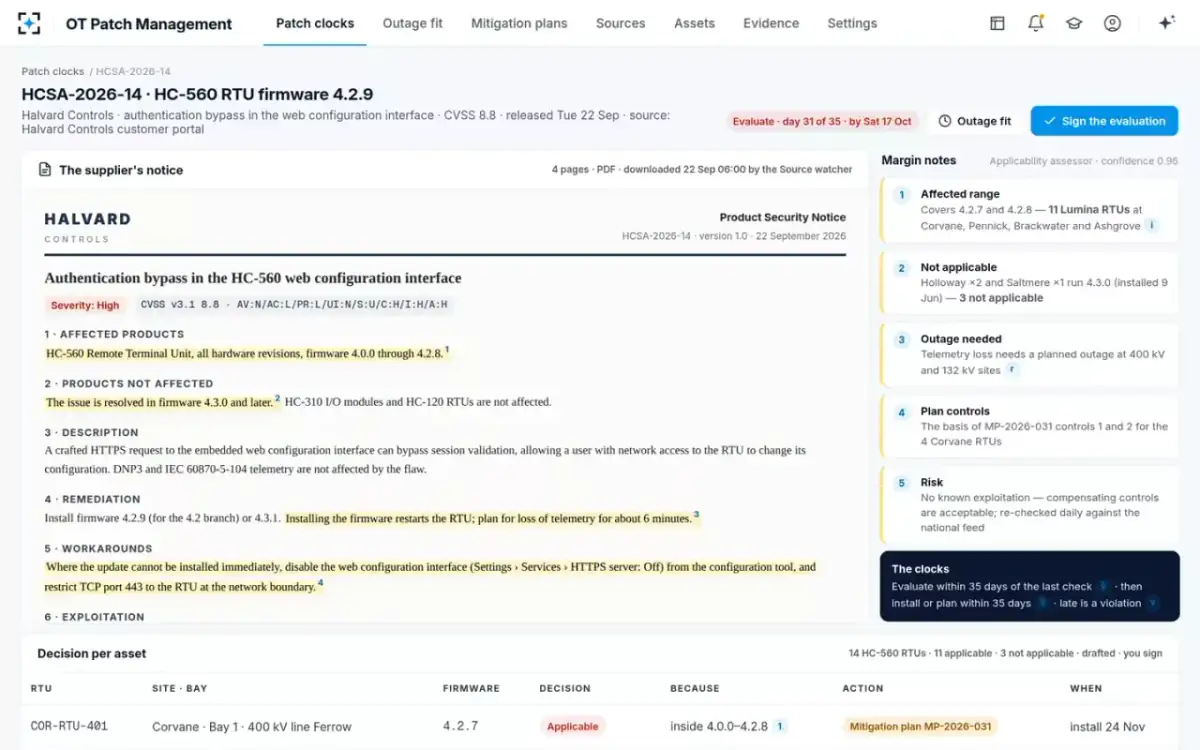

The patch fileThe supplier's notice with the deciding sentences marked. Margin notes show the inventory and operating rule behind them, beside the two clocks.

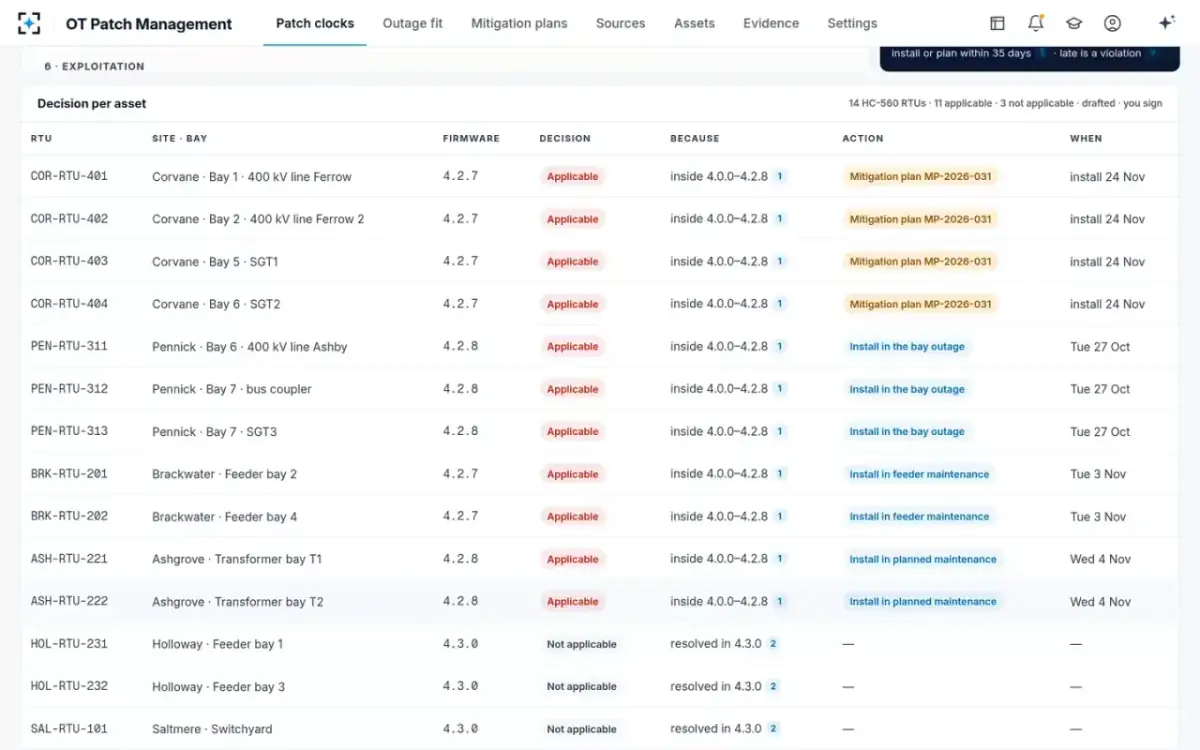

Decision per assetEach RTU by tag, bay and firmware, with applicable or not, the cited reason, the action and the date.

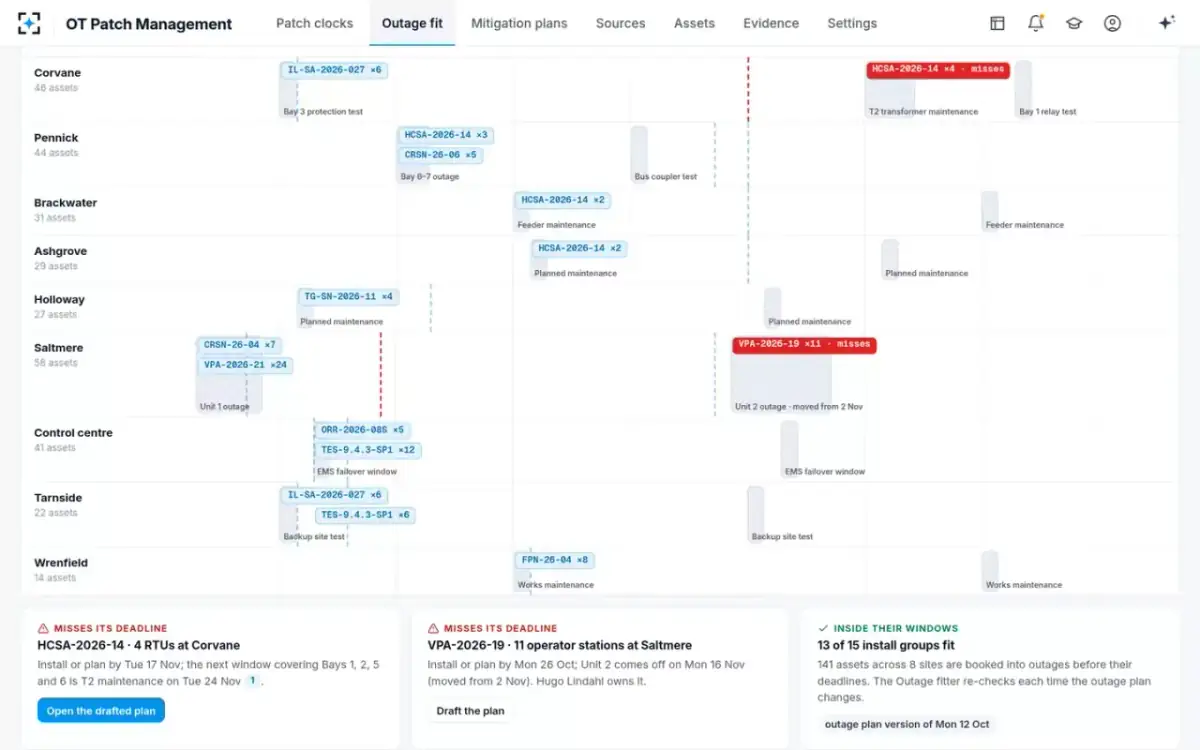

Outage fitSixty days of planned outages at each site against each patch's deadline. Of 15 install groups, 13 fit, and the two that miss are marked.

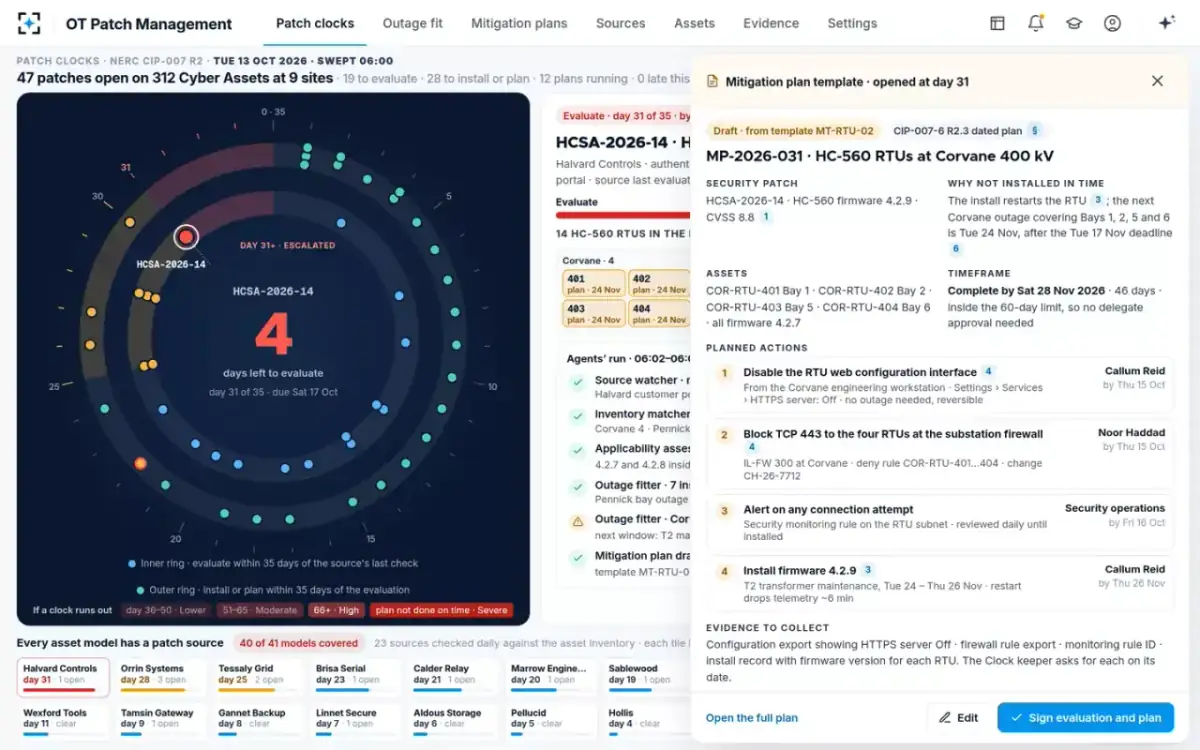

The plan template, filled inThe mitigation plan drafted from the RTU template. It shows why the install waits, the assets, four actions with owners and dates, and the timeframe.

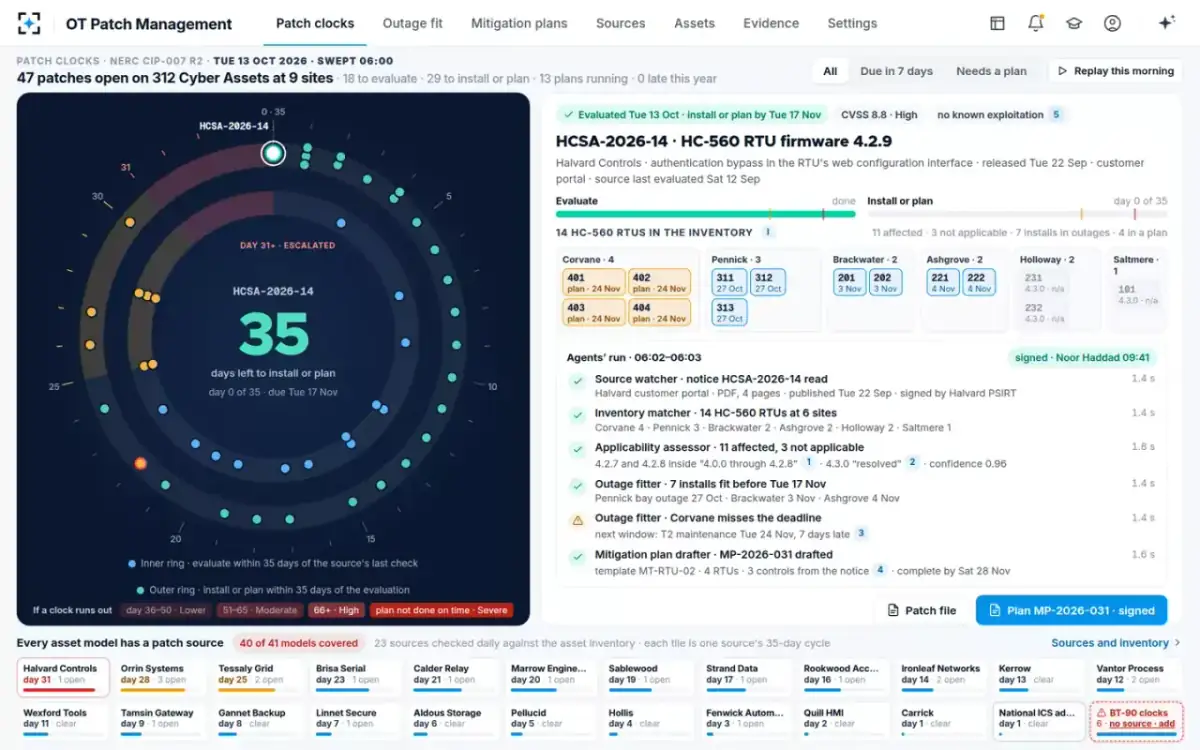

Signed on day 0The evaluation and plan are signed. The patch restarts on the outer ring with all 35 days left to install or plan.

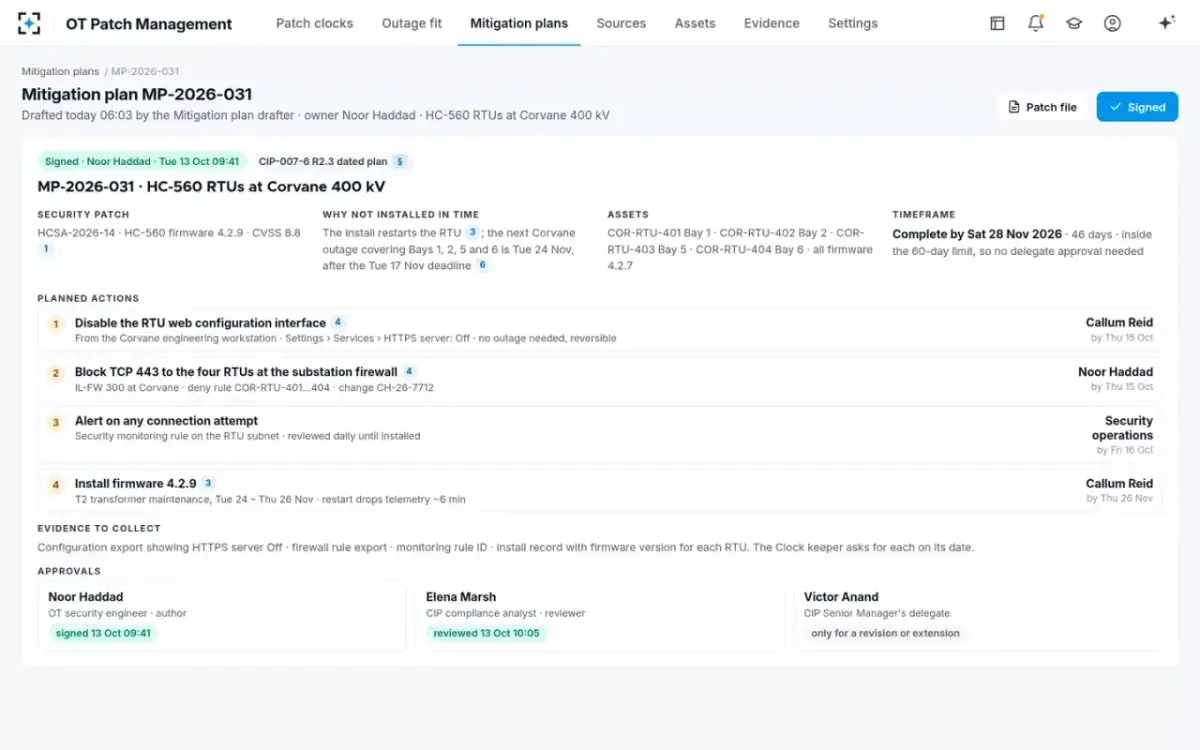

The full mitigation planControls, timeframe, evidence to collect and the approvals. Approvals cover the author, the reviewer and the delegate for any revision or extension.

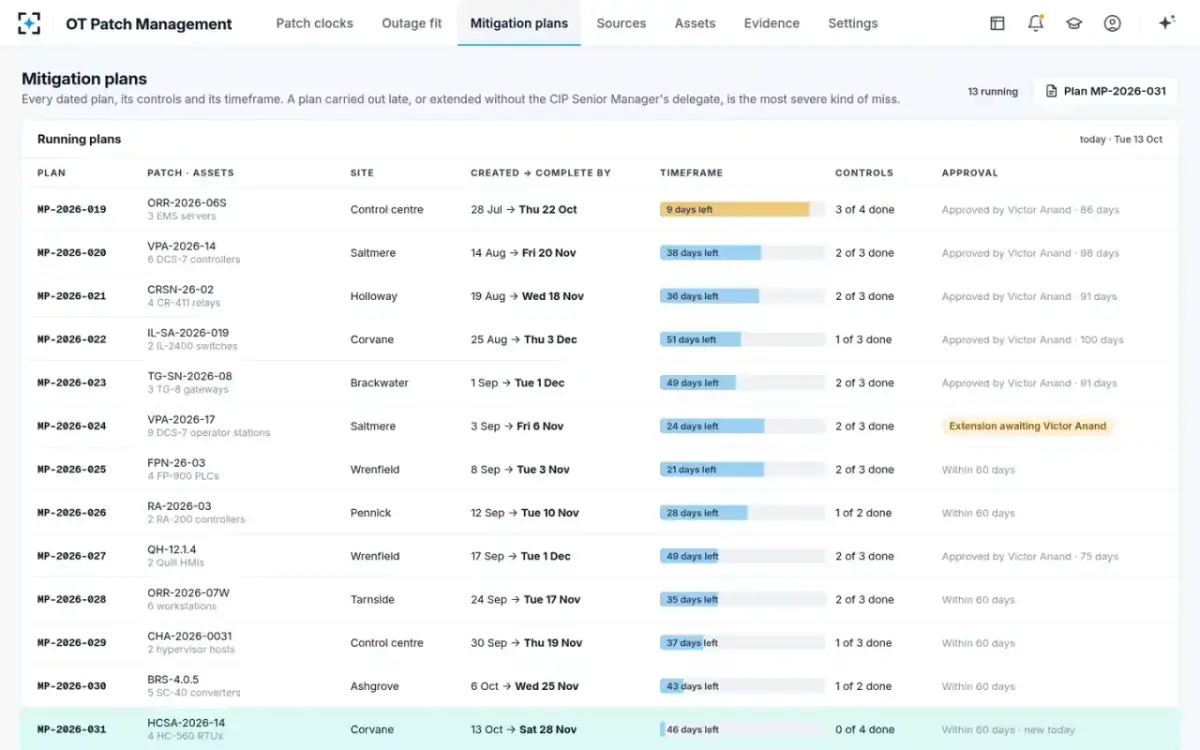

Mitigation plansEach running plan with its timeframe, controls done and approval, including an extension that waits for the delegate.

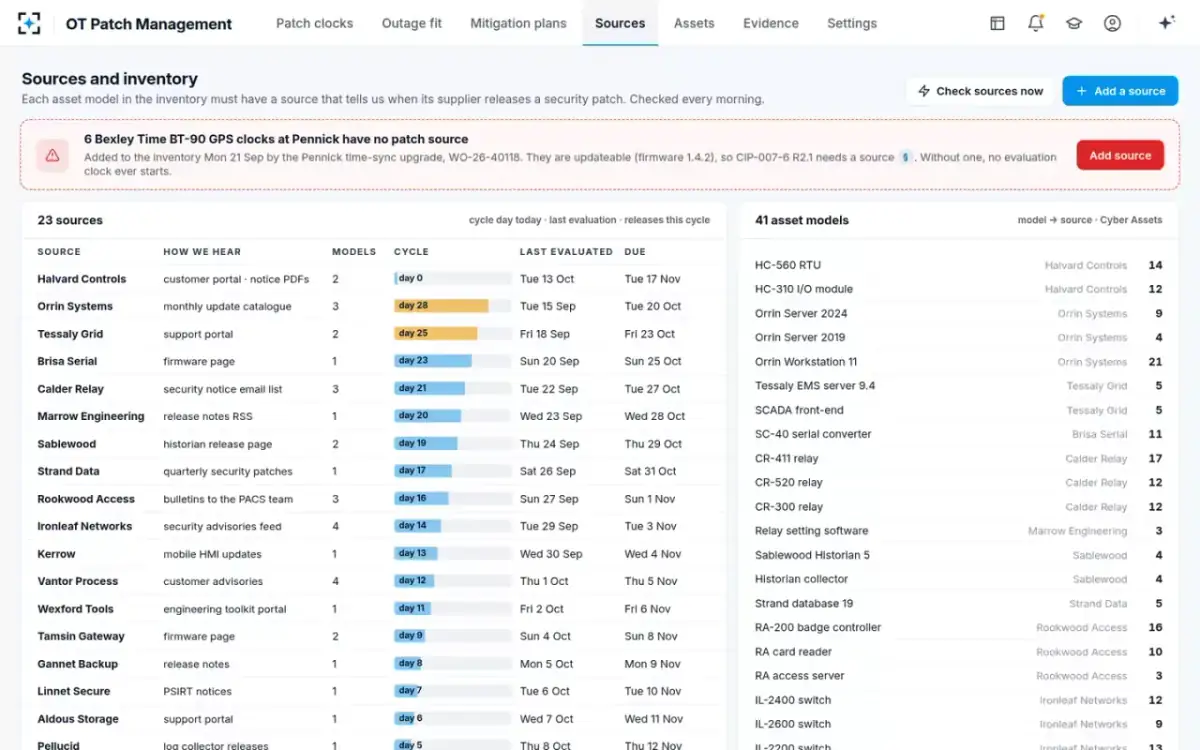

Sources and inventoryAll 23 sources, with how each one is heard, its cycle day and due date. Each asset model is mapped to its source, and the one model without a source stands out.

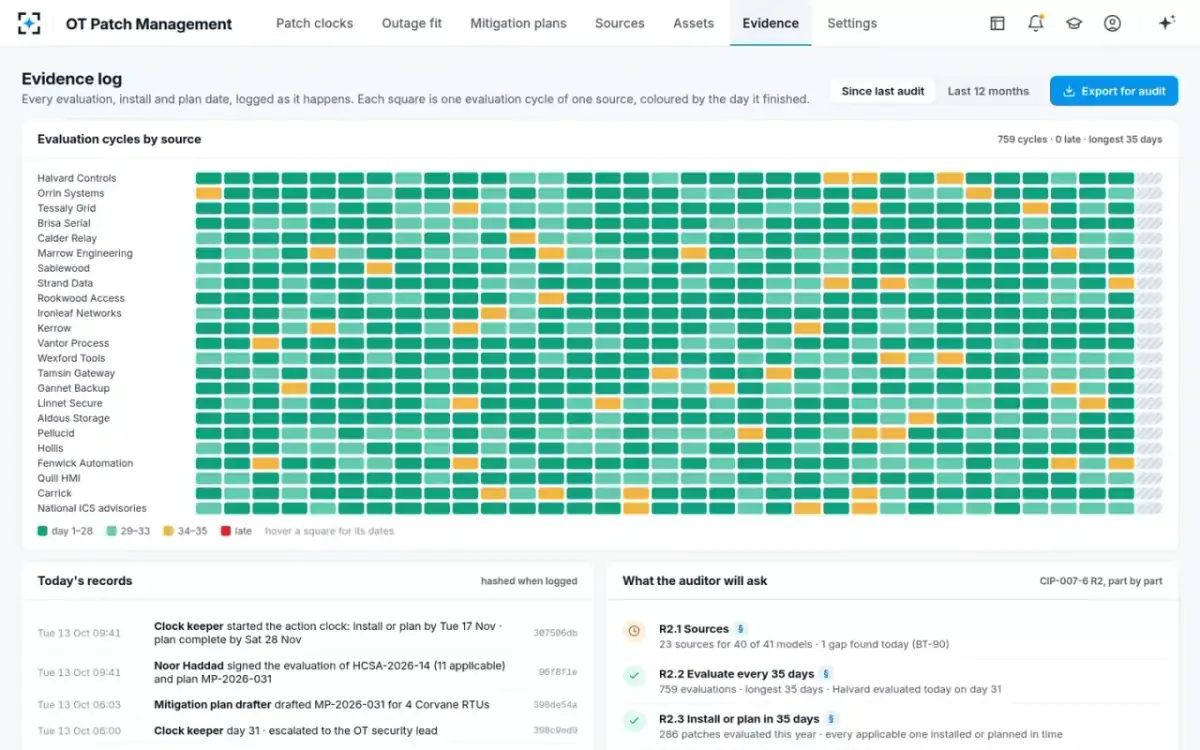

The evidence logThe record holds 759 evaluation cycles by source and today's records, hashed as logged. Beside them is what the auditor will ask, CIP-007-6 R2 part by part.

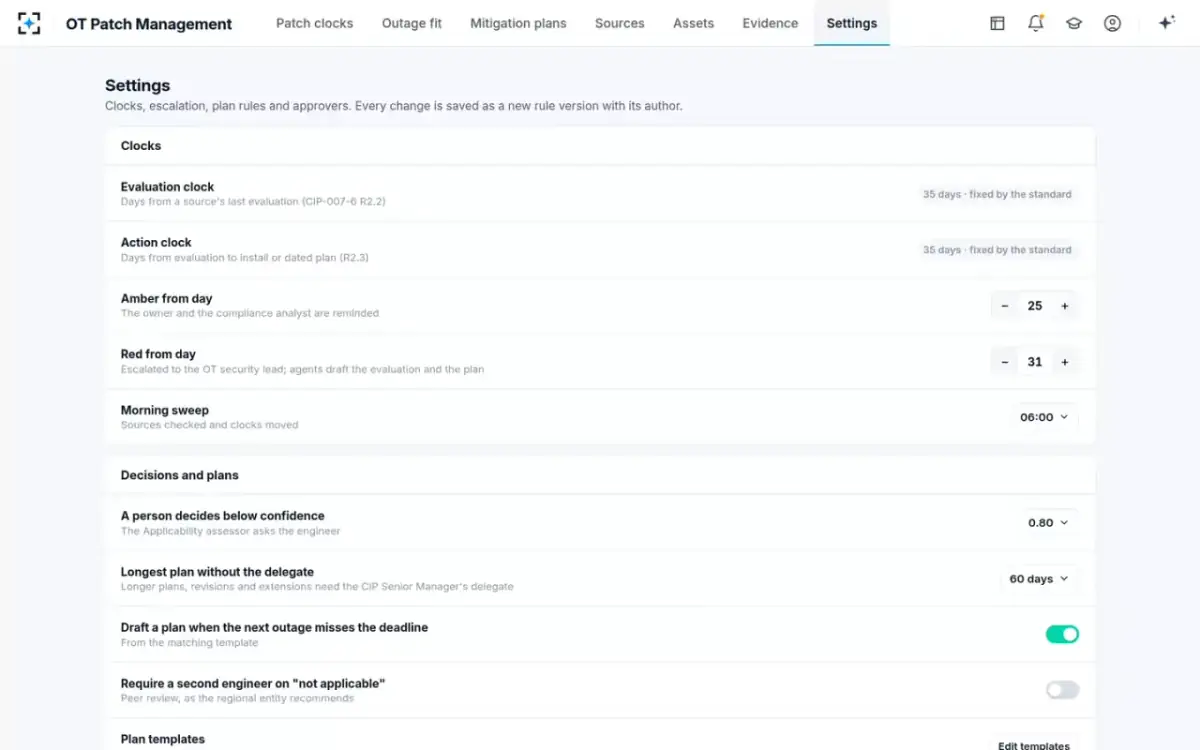

SettingsThe clocks, the escalation days, the morning sweep, the confidence threshold and the plan rules.
Governance

OT patch management with cited decisions, signed plans and dated logs

Each decision cites its sentenceEach applicable or not-applicable decision links to the sentence of the supplier's notice and the inventory record it rests on. Below 0.80 confidence, the Applicability assessor asks the engineer and says why.
The engineer signs, the delegate approvesAgents draft, and a named engineer signs each evaluation and each plan. A plan over 60 days, a revision or an extension needs the CIP Senior Manager's delegate. The delegate must approve before the plan's date.
Dates logged as they happenEvaluation, install and plan dates are logged automatically and sealed with a hash when logged. Nothing is backdated, and no agent can extend a deadline.
Agents stay off the devicesThe agents read supplier portals with a service account. They do not install firmware, change a device's configuration, edit the inventory or book an outage.
A source for each updateable modelEach morning the inventory decides what must be watched, so nothing rests on a person's memory. Any updateable model without a tracked patch source is flagged to the OT security engineer the day it appears.
Evidence ready for the auditorEach agent step and each person's action is on the record. The audit export holds one folder per source and cycle. Evaluations carry their date, decisions, cited notice and signature. Plans carry their controls, evidence and approvals.
Configuration

Patch clocks, escalation days and plan approvers the utility sets

The 35-day clocks are fixed by the standard. The rest is set by the utility, and each change is saved as a new rule version with its author.

SettingDefaultChoose from
Evaluation clock and action clock35 days eachFixed by the standard. One runs from a source's last evaluation (R2.2), the other from evaluation to install or dated plan (R2.3)
Amber from day25Adjustable by day. The owner and the compliance analyst are reminded
Red from day31Adjustable by day. Escalated to the OT security lead, and agents draft the evaluation and the plan
Morning sweep06:0005:00 · 06:00 · 07:00. Sources are checked and clocks moved
A person decides below confidence0.800.75 · 0.80 · 0.85 · 0.90. The Applicability assessor asks the engineer
Longest plan without the delegate60 days45 days · 60 days · 90 days. Longer plans, revisions and extensions need the CIP Senior Manager's delegate
Draft a plan when the next outage misses the deadlineOnOn · Off. Uses the matching template: MT-RTU-02 RTU, MT-NET-01 switch and firewall, MT-DCS-03 plant DCS, MT-WS-01 workstation
Require a second engineer on “not applicable”OffOn · Off. Peer review, as the regional entity recommends
Connections

Supplier patch sources, the firmware inventory and the outage plan

Supplier patch sourcescustomer portals, security notice email lists, release pages, PSIRT notices, update catalogs
National ICS advisoriesthe government advisory feed, as a second source for each model
Asset and firmware inventoryCyber Assets with site, bay, model, hardware revision, firmware and impact rating
Outage planplanned outages and maintenance windows by site and bay, and the operating rules behind them
Mitigation plan templatesone per asset type: RTU, switch and firewall, plant DCS, workstation
Install records and change ticketsthe firmware actually installed, and the changes behind each plan control
What it changes

Patch evaluations inside the window, measured cycle by cycle

Each figure carries its label: a target the solution is built to, an estimate, a typical published result, or a proven one.

target
0
evaluations past day 35, the design goal for each source and patch, with escalation on day 31
Escalated on day 31
drafted and signed before day 35
target
Day 0
of the action clock. Compensating controls for a vulnerable RTU are planned the day its patch is evaluated
Plan written by handday 30 to 34
With agentsday 0
target
6h
of engineer time a cycle, against about 40 by hand in the sample utility's own baseline
By hand≈ 40 h
With agents≈ 6 h

“demo” means seen in the working solution, on its sample utility data. “target” means the design goal, measured in the live solution. “estimated” means our estimate of how one cycle's hours split, from the sample utility's own baseline of about 40 engineer-hours. “typical” means published figures. The FERC civil penalty inflation rule (Federal Register, Jan 14, 2025) sets $1,584,648 per violation per day. SERC settlement NP18-25-000 was $220,000 for three evaluations at 37 days. “estimated” also marks vendor figures. Forescout's report, ICS cybersecurity in 2026, counts 508 ICS advisories and 2,155 CVEs in 2025. The rule named as context is NERC CIP-007-6 R2 and its Violation Severity Levels. Names on the screens are sample data.

Questions

OT patch management and CIP-007 R2 questions from utility engineers

What is OT patch management software?

OT patch management software tracks each security patch for your control-system assets. These include RTUs, relays, switches, firewalls, DCS, EMS and historians. It follows each patch from the supplier's notice to an install or a dated mitigation plan. OT Patch Management adds six agents. They watch the sources, match each notice to the inventory, draft the decision and any plan, and run the clocks. The OT engineer signs.

How does it handle the CIP-007 R2 35-day clocks?

Each patch carries two clocks. The first gives 35 days from its source's last evaluation to evaluate it. The second gives 35 days from the evaluation to install it or write a dated mitigation plan. The Clock keeper moves both at the morning sweep. It reminds the owner and the compliance analyst at day 25, escalates at day 31 and logs each date as it happens.

How does it decide whether a patch applies to our assets?

The Inventory matcher lists the assets of the named models with their hardware revision and installed firmware. The Applicability assessor reads the notice's affected and not-affected sections and drafts a decision per asset, citing the sentence behind it. In the sample case, 11 RTUs on 4.2.7 and 4.2.8 were affected and 3 on 4.3.0 were not.

What happens when an install cannot be done before the deadline?

The Outage fitter places each install in the next planned outage that beats the deadline. When none does, the Mitigation plan drafter fills the template for that asset type. It adds controls from the supplier's workarounds, owners, dates and the evidence to collect. That way the engineer can sign a dated plan the day the patch is evaluated.

Does it find assets that have no patch source?

Yes. Each morning the Inventory matcher compares each model in the inventory with the source list. In the sample case it found six GPS clocks, added in a time-sync upgrade, with no tracked source. Adding the source starts its evaluation clock.

Can an agent sign an evaluation, install firmware or book an outage?

No. The agents draft. They do not sign, install firmware, change a device or book an outage. Below 0.80 confidence a person decides. A named engineer signs each evaluation and plan. Only the CIP Senior Manager's delegate approves a plan over 60 days, a revision or an extension, and must do so before its date.

Can it run the same clocks for sites outside NERC CIP?

Yes. The rules covered are settings. In the sample utility, NERC CIP-007-6 R2 covers the sites with High or Medium Impact BES Cyber Systems. The water works runs on the same clocks under the company's water cyber policy.

Which documents does the OT team provide to set it up?

The Agentic Solution Engine builds and deploys it from your requirements and documents. Those are your patch management procedure, source list, asset inventory, outage plan and mitigation plan templates. It goes live once each quality gate has passed. We will walk you through it first on your own sources and a recent cycle.

Try OT patch management
on your own patch sources.

We'll run OT Patch Management on your own source list, your asset inventory and a recent cycle of supplier notices.
